# Avalanche L1s (/docs/avalanche-l1s) --- title: Avalanche L1s description: Explore the multi-chain architecture of Avalanche ecosystem. --- An Avalanche L1 is a sovereign network which defines its own rules regarding its membership and token economics. It is composed of a dynamic subset of Avalanche validators working together to achieve consensus on the state of one or more blockchains. Each blockchain is validated by exactly one Avalanche L1, while an Avalanche L1 can validate many blockchains. Avalanche's [Primary Network](/docs/primary-network) is a special Avalanche L1 running three blockchains: - The Platform Chain [(P-Chain)](/docs/primary-network#p-chain-platform-chain) - The Contract Chain [(C-Chain)](/docs/primary-network#c-chain-contract-chain) - The Exchange Chain [(X-Chain)](/docs/primary-network#x-chain-exchange-chain) ![image](/images/subnet1.png) Every validator of an Avalanche L1 **must** sync the P-Chain of the Primary Network for interoperability. Node operators that validate an Avalanche L1 with multiple chains do not need to run multiple machines for validation. For example, the Primary Network is an Avalanche L1 with three coexisting chains, all of which can be validated by a single node, or a single machine. ## Advantages ### Independent Networks - Avalanche L1s use virtual machines to specify their own execution logic, determine their own fee regime, maintain their own state, facilitate their own networking, and provide their own security. - Each Avalanche L1's performance is isolated from other Avalanche L1s in the ecosystem, so increased usage on one Avalanche L1 won't affect another. - Avalanche L1s can have their own token economics with their own native tokens, fee markets, and incentives determined by the Avalanche L1 deployer. - One Avalanche L1 can host multiple blockchains with customized [virtual machines](/docs/primary-network/virtual-machines). ### Native Interoperability Avalanche Warp Messaging enables native cross-Avalanche L1 communication and allows Virtual Machine (VM) developers to implement arbitrary communication protocols between any two Avalanche L1s. ### Accommodate App-Specific Requirements Different blockchain-based applications may require validators to have certain properties such as large amounts of RAM or CPU power. an Avalanche L1 could require that validators meet certain [hardware requirements](/docs/nodes/system-requirements#hardware-and-operating-systems) so that the application doesn't suffer from low performance due to slow validators. ### Launch Networks Designed With Compliance Avalanche's L1 architecture makes regulatory compliance manageable. As mentioned above, an Avalanche L1 may require validators to meet a set of requirements. Some examples of requirements the creators of an Avalanche L1 may choose include: - Validators must be located in a given country. - Validators must pass KYC/AML checks. - Validators must hold a certain license. ### Control Privacy of On-Chain Data Avalanche L1s are ideal for organizations interested in keeping their information private. Institutions conscious of their stakeholders' privacy can create a private Avalanche L1 where the contents of the blockchains would be visible only to a set of pre-approved validators. Define this at creation with a [single parameter](/docs/nodes/configure/avalanche-l1-configs#private-avalanche-l1). ### Validator Sovereignty In a heterogeneous network of blockchains, some validators will not want to validate certain blockchains because they simply have no interest in those blockchains. The Avalanche L1 model enables validators to concern themselves only with blockchain networks they choose to participate in. This greatly reduces the computational burden on validators. ## Why Build Your Own Avalanche L1 There are many advantages to running your own Avalanche L1. If you find one or more of these a good match for your project then an Avalanche L1 might be a good solution for you. ### We Want Our Own Gas Token C-Chain is an Ethereum Virtual Machine (EVM) chain; it requires the gas fees to be paid in its native token. That is, the application may create its own utility tokens (ERC-20) on the C-Chain, but the gas must be paid in AVAX. In the meantime, [Subnet-EVM](https://github.com/ava-labs/subnet-evm) effectively creates an application-specific EVM-chain with full control over native(gas) coins. The operator can pre-allocate the native tokens in the chain genesis, and mint more using the [Subnet-EVM](https://github.com/ava-labs/subnet-evm) precompile contract. And these fees can be either burned (as AVAX burns in C-Chain) or configured to be sent to an address which can be a smart contract. Note that the Avalanche L1 gas token is specific to the application in the chain, thus unknown to the external parties. Moving assets to other chains requires trusted bridge contracts (or upcoming cross Avalanche L1 communication feature). ### We Want Higher Throughput The primary goal of the gas limit on C-Chain is to restrict the block size and therefore prevent network saturation. If a block can be arbitrarily large, it takes longer to propagate, potentially degrading the network performance. The C-Chain gas limit acts as a deterrent against any system abuse but can be quite limiting for high throughput applications. Unlike C-Chain, Avalanche L1 can be single-tenant, dedicated to the specific application, and thus host its own set of validators with higher bandwidth requirements, which allows for a higher gas limit thus higher transaction throughput. Plus, [Subnet-EVM](https://github.com/ava-labs/subnet-evm) supports fee configuration upgrades that can be adaptive to the surge in application traffic. Avalanche L1 workloads are isolated from the Primary Network; which means, the noisy neighbor effect of one workload (for example NFT mint on C-Chain) cannot destabilize the Avalanche L1 or surge its gas price. This failure isolation model in the Avalanche L1 can provide higher application reliability. ### We Want Strict Access Control The C-Chain is open and permissionless where anyone can deploy and interact with contracts. However, for regulatory reasons, some applications may need a consistent access control mechanism for all on-chain transactions. With [Subnet-EVM](https://github.com/ava-labs/subnet-evm), an application can require that "only authorized users may deploy contracts or make transactions." Allow-lists are only updated by the administrators, and the allow list itself is implemented within the precompile contract, thus more transparent and auditable for compliance matters. ### We Need EVM Customization If your project is deployed on the C-Chain then your execution environment is dictated by the setup of the C-Chain. Changing any of the execution parameters means that the configuration of the C-Chain would need to change, and that is expensive, complex and difficult to change. So if your project needs some other capabilities, different execution parameters or precompiles that C-Chain does not provide, then Avalanche L1s are a solution you need. You can configure the EVM in an Avalanche L1 to run however you want, adding precompiles, and setting runtime parameters to whatever your project needs. ### We Need Custom Validator Management With the Etna upgrade, L1s can implement their own validator management logic through a _ValidatorManager_ smart contract. This gives you complete control over your validator set, allowing you to define custom staking rules, implement permissionless proof-of-stake with your own token, or create permissioned proof-of-authority networks. The validator management can be handled directly through smart contracts, giving you programmatic control over validator selection and rewards distribution. ### We Want to Build a Sovereign Network L1s on Avalanche are truly sovereign networks that operate independently without relying on other systems. You have complete control over your network's consensus mechanisms, transaction processing, and security protocols. This independence allows you to scale horizontally without dependencies on other networks while maintaining full control over your network parameters and upgrades. This sovereignty is particularly important for projects that need complete autonomy over their blockchain's operation and evolution. ## When to Choose an Avalanche L1 Here we presented some considerations in favor of running your own Avalanche L1 vs. deploying on the C-Chain. If an application has relatively low transaction rate and no special circumstances that would make the C-Chain a non-starter, you can begin with C-Chain deployment to leverage existing technical infrastructure, and later expand to an Avalanche L1. That way you can focus on working on the core of your project and once you have a solid product/market fit and have gained enough traction that the C-Chain is constricting you, plan a move to your own Avalanche L1. Of course, we're happy to talk to you about your architecture and help you choose the best path forward. Feel free to reach out to us on [Discord](https://chat.avalabs.org/) or other [community channels](https://www.avax.network/community) we run. ## Develop Your Own Avalanche L1 Avalanche L1s on Avalanche are deployed by default with [Subnet-EVM](https://github.com/ava-labs/subnet-evm#subnet-evm), a fork of go-ethereum. It implements the Ethereum Virtual Machine and supports Solidity smart contracts as well as most other Ethereum client functionality. To get started, check out our [L1 Toolbox](/tools/l1-toolbox) or the tutorials in the [Avalanche CLI](/docs/tooling/avalanche-cli) section. # Simple VM in Any Language (/docs/avalanche-l1s/simple-vm-any-language) --- title: Simple VM in Any Language description: Learn how to implement a simple virtual machine in any language. --- This is a language-agnostic high-level documentation explaining the basics of how to get started at implementing your own virtual machine from scratch. Avalanche virtual machines are grpc servers implementing Avalanche's [Proto interfaces](https://buf.build/ava-labs/avalanche). This means that it can be done in [any language that has a grpc implementation](https://grpc.io/docs/languages/). ## Minimal Implementation To get the process started, at the minimum, you will to implement the following interfaces: - [`vm.Runtime`](https://buf.build/ava-labs/avalanche/docs/main:vm.runtime) (Client) - [`vm.VM`](https://buf.build/ava-labs/avalanche/docs/main:vm) (Server) To build a blockchain taking advantage of AvalancheGo's consensus to build blocks, you will need to implement: - [AppSender](https://buf.build/ava-labs/avalanche/docs/main:appsender) (Client) - [Messenger](https://buf.build/ava-labs/avalanche/docs/main:messenger) (Client) To have a json-RPC endpoint, `/ext/bc/subnetId/rpc` exposed by AvalancheGo, you will need to implement: - [`Http`](https://buf.build/ava-labs/avalanche/docs/main:http) (Server) You can and should use a tool like `buf` to generate the (Client/Server) code from the interfaces as stated in the [Avalanche module](https://buf.build/ava-labs/avalanche)'s page. There are _server_ and _client_ interfaces to implement. AvalancheGo calls the _server_ interfaces exposed by your VM and your VM calls the _client_ interfaces exposed by AvalancheGo. ## Starting Process Your VM is started by AvalancheGo launching your binary. Your binary is started as a sub-process of AvalancheGo. While launching your binary, AvalancheGo passes an environment variable `AVALANCHE_VM_RUNTIME_ENGINE_ADDR` containing an url. We must use this url to initialize a `vm.Runtime` client. Your VM, after having started a grpc server implementing the VM interface must call the [`vm.Runtime.InitializeRequest`](https://buf.build/ava-labs/avalanche/docs/main:vm.runtime#vm.runtime.InitializeRequest) with the following parameters. - `protocolVersion`: It must match the `supported plugin version` of the [AvalancheGo release](https://github.com/ava-labs/AvalancheGo/releases) you are using. It is always part of the release notes. - `addr`: It is your grpc server's address. It must be in the following format `host:port` (example `localhost:12345`) ## VM Initialization The service methods are described in the same order as they are called. You will need to implement these methods in your server. ### Pre-Initialization Sequence AvalancheGo starts/stops your process multiple times before launching the real initialization sequence. 1. [VM.Version](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Version) - Return: your VM's version. 2. [VM.CreateStaticHandler](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.CreateStaticHandlers) - Return: an empty array - (Not absolutely required). 3. [VM.Shutdown](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Shutdown) - You should gracefully stop your process. - Return: Empty ### Initialization Sequence 1. [VM.CreateStaticHandlers](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.CreateStaticHandlers) - Return an empty array - (Not absolutely required). 2. [VM.Initialize](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Initialize) - Param: an [InitializeRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.InitializeRequest). - You must use this data to initialize your VM. - You should add the genesis block to your blockchain and set it as the last accepted block. - Return: an [InitializeResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.InitializeResponse) containing data about the genesis extracted from the `genesis_bytes` that was sent in the request. 3. [VM.VerifyHeightIndex](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.VerifyHeightIndex) - Return: a [VerifyHeightIndexResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VerifyHeightIndexResponse) with the code `ERROR_UNSPECIFIED` to indicate that no error has occurred. 4. [VM.CreateHandlers](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.CreateHandlers) - To serve json-RPC endpoint, `/ext/bc/subnetId/rpc` exposed by AvalancheGo - See [json-RPC](#json-rpc) for more detail - Create a [`Http`](https://buf.build/ava-labs/avalanche/docs/main:http) server and get its url. - Return: a `CreateHandlersResponse` containing a single item with the server's url. (or an empty array if not implementing the json-RPC endpoint) 5. [VM.StateSyncEnabled](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.StateSyncEnabled) - Return: `true` if you want to enable StateSync, `false` otherwise. 6. [VM.SetState](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetState) _If you had specified `true` in the `StateSyncEnabled` result_ - Param: a [SetStateRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateRequest) with the `StateSyncing` value - Set your blockchain's state to `StateSyncing` - Return: a [SetStateResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateResponse) built from the genesis block. 7. [VM.GetOngoingSyncStateSummary](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.GetOngoingSyncStateSummary) _If you had specified `true` in the `StateSyncEnabled` result_ - Return: a [GetOngoingSyncStateSummaryResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.GetOngoingSyncStateSummaryResponse) built from the genesis block. 8. [VM.SetState](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetState) - Param: a [SetStateRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateRequest) with the `Bootstrapping` value - Set your blockchain's state to `Bootstrapping` - Return: a [SetStateResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateResponse) built from the genesis block. 9. [VM.SetPreference](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetPreference) - Param: `SetPreferenceRequest` containing the preferred block ID - Return: Empty 10. [VM.SetState](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetState) - Param: a [SetStateRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateRequest) with the `NormalOp` value - Set your blockchain's state to `NormalOp` - Return: a [SetStateResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.SetStateResponse) built from the genesis block. 11. [VM.Connected](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Connected) (for every other node validating this Avalanche L1 in the network) - Param: a [ConnectedRequest](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.ConnectedRequest) with the NodeID and the version of AvalancheGo. - Return: Empty 12. [VM.Health](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.Health) - Param: Empty - Return: a [HealthResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.HealthResponse) with an empty `details` property. 13. [VM.ParseBlock](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.ParseBlock) - Param: A byte array containing a Block (the genesis block in this case) - Return: a [ParseBlockResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.ParseBlockResponse) built from the last accepted block. At this point, your VM is fully started and initialized. ### Building Blocks #### Transaction Gossiping Sequence When your VM receives transactions (for example using the [json-RPC](#json-rpc) endpoints), it can gossip them to the other nodes by using the [AppSender](https://buf.build/ava-labs/avalanche/docs/main:appsender) service. Supposing we have a 3 nodes network with nodeX, nodeY, nodeZ. Let's say NodeX has received a new transaction on it's json-RPC endpoint. [`AppSender.SendAppGossip`](https://buf.build/ava-labs/avalanche/docs/main:appsender#appsender.AppSender.SendAppGossip) (_client_): You must serialize your transaction data into a byte array and call the `SendAppGossip` to propagate the transaction. AvalancheGo then propagates this to the other nodes. [VM.AppGossip](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.AppGossip): You must deserialize the transaction and store it for the next block. - Param: A byte array containing your transaction data, and the NodeID of the node which sent the gossip message. - Return: Empty #### Block Building Sequence Whenever your VM is ready to build a new block, it will initiate the block building process by using the [Messenger](https://buf.build/ava-labs/avalanche/docs/main:messenger) service. Supposing that nodeY wants to build the block. you probably will implement some kind of background worker checking every second if there are any pending transactions: _client_ [`Messenger.Notify`](https://buf.build/ava-labs/avalanche/docs/main:messenger#messenger.Messenger.Notify): You must issue a notify request to AvalancheGo by calling the method with the `MESSAGE_BUILD_BLOCK` value. 1. [VM.BuildBlock](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BuildBlock) - Param: Empty - You must build a block with your pending transactions. Serialize it to a byte array. - Store this block in memory as a "pending blocks" - Return: a [BuildBlockResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.BuildBlockResponse) from the newly built block and it's associated data (`id`, `parent_id`, `height`, `timestamp`). 2. [VM.BlockVerify](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockVerify) - Param: The byte array containing the block data - Return: the block's timestamp 3. [VM.SetPreference](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetPreference) - Param: The block's ID - You must mark this block as the next preferred block. - Return: Empty 1. [VM.ParseBlock](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.ParseBlock) - Param: A byte array containing a the newly built block's data - Store this block in memory as a "pending blocks" - Return: a [ParseBlockResponse](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.ParseBlockResponse) built from the last accepted block. 2. [VM.BlockVerify](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockVerify) - Param: The byte array containing the block data - Return: the block's timestamp 3. [VM.SetPreference](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.SetPreference) - Param: The block's ID - You must mark this block as the next preferred block. - Return: Empty [VM.BlockAccept](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockAccept): You must accept this block as your last final block. - Param: The block's ID - Return: Empty #### Managing Conflicts Conflicts happen when two or more nodes propose the next block at the same time. AvalancheGo takes care of this and decides which block should be considered final, and which blocks should be rejected using Snowman consensus. On the VM side, all there is to do is implement the `VM.BlockAccept` and `VM.BlockReject` methods. _nodeX proposes block `0x123...`, nodeY proposes block `0x321...` and nodeZ proposes block `0x456`_ There are three conflicting blocks (different hashes), and if we look at our VM's log files, we can see that AvalancheGo uses Snowman to decide which block must be accepted. ```bash ... snowman/voter.go:58 filtering poll results ... ... snowman/voter.go:65 finishing poll ... ... snowman/voter.go:87 Snowman engine can't quiesce ... ... snowman/voter.go:58 filtering poll results ... ... snowman/voter.go:65 finishing poll ... ... snowman/topological.go:600 accepting block ``` Supposing that AvalancheGo accepts block `0x123...`. The following RPC methods are called on all nodes: 1. [VM.BlockAccept](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockAccept): You must accept this block as your last final block. - Param: The block's ID (`0x123...`) - Return: Empty 2. [VM.BlockReject](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockReject): You must mark this block as rejected. - Param: The block's ID (`0x321...`) - Return: Empty 3. [VM.BlockReject](https://buf.build/ava-labs/avalanche/docs/main:vm#vm.VM.BlockReject): You must mark this block as rejected. - Param: The block's ID (`0x456...`) - Return: Empty ### JSON-RPC To enable your json-RPC endpoint, you must implement the [HandleSimple](https://buf.build/ava-labs/avalanche/docs/main:http#http.HTTP.HandleSimple) method of the [`Http`](https://buf.build/ava-labs/avalanche/docs/main:http) interface. - Param: a [HandleSimpleHTTPRequest](https://buf.build/ava-labs/avalanche/docs/main:http#http.HandleSimpleHTTPRequest) containing the original request's method, url, headers, and body. - Analyze, deserialize and handle the request. For example: if the request represents a transaction, we must deserialize it, check the signature, store it and gossip it to the other nodes using the [messenger client](#block-building-sequence)). - Return the [HandleSimpleHTTPResponse](https://buf.build/ava-labs/avalanche/docs/main:http#http.HandleSimpleHTTPResponse) response that will be sent back to the original sender. This server is registered with AvalancheGo during the [initialization process](#initialization-sequence) when the `VM.CreateHandlers` method is called. You must simply respond with the server's url in the `CreateHandlersResponse` result. # Introduction (/docs/avalanche-l1s/virtual-machines-index) --- title: Introduction description: Learn about the execution layer of a blockchain network. --- A Virtual Machine (VM) is a blueprint for a blockchain. Blockchains are instantiated from a VM, similar to how objects are instantiated from a class definition. VMs can define anything you want, but will generally define transactions that are executed and how blocks are created. ## Blocks and State Virtual Machines deal with blocks and state. The functionality provided by VMs is to: - Define the representation of a blockchain's state - Represent the operations in that state - Apply the operations in that state Each block in the blockchain contains a set of state transitions. Each block is applied in order from the blockchain's initial genesis block to its last accepted block to reach the latest state of the blockchain. ## Blockchain A blockchain relies on two major components: The **Consensus Engine** and the **VM**. The VM defines application specific behavior and how blocks are built and parsed to create the blockchain. All VMs run on top of the Avalanche Consensus Engine, which allows nodes in the network to agree on the state of the blockchain. Here's a quick example of how VMs interact with consensus: 1. A node wants to update the blockchain's state 2. The node's VM will notify the consensus engine that it wants to update the state 3. The consensus engine will request the block from the VM 4. The consensus engine will verify the returned block using the VM's implementation of `Verify()` 5. The consensus engine will get the network to reach consensus on whether to accept or reject the newly verified block. Every virtuous (well-behaved) node on the network will have the same preference for a particular block 6. Depending upon the consensus results, the engine will either accept or reject the block. What happens when a block is accepted or rejected is specific to the implementation of the VM AvalancheGo provides the consensus engine for every blockchain on the Avalanche Network. The consensus engine relies on the VM interface to handle building, parsing, and storing blocks as well as verifying and executing on behalf of the consensus engine. This decoupling between the application and consensus layer allows developers to build their applications quickly by implementing virtual machines, without having to worry about the consensus layer managed by Avalanche which deals with how nodes agree on whether or not to accept a block. ## Installing a VM VMs are supplied as binaries to a node running `AvalancheGo`. These binaries must be named the VM's assigned **VMID**. A VMID is a 32-byte hash encoded in CB58 that is generated when you build your VM. In order to install a VM, its binary must be installed in the `AvalancheGo` plugin path. See [here](/docs/nodes/configure/configs-flags#--plugin-dir-string) for more details. Multiple VMs can be installed in this location. Each VM runs as a separate process from AvalancheGo and communicates with `AvalancheGo` using gRPC calls. This functionality is enabled by **RPCChainVM**, a special VM which wraps around other VM implementations and bridges the VM and AvalancheGo, establishing a standardized communication protocol between them. During VM creation, handshake messages are exchanged via **RPCChainVM** between AvalancheGo and the VM installation. Ensure matching **RPCChainVM** protocol versions to avoid errors, by updating your VM or using a [different version of AvalancheGo](https://github.com/ava-labs/AvalancheGo/releases). Note that some VMs may not support the latest protocol version. ### API Handlers Users can interact with a blockchain and its VM through handlers exposed by the VM's API. VMs expose two types of handlers to serve responses for incoming requests: - **Blockchain Handlers**: Referred to as handlers, these expose APIs to interact with a blockchain instantiated by a VM. The API endpoint will be different for each chain. The endpoint for a handler is `/ext/bc/[chainID]`. - **VM Handlers**: Referred to as static handlers, these expose APIs to interact with the VM directly. One example API would be to parse genesis data to instantiate a new blockchain. The endpoint for a static handler is `/ext/vm/[vmID]`. For any readers familiar with object-oriented programming, static and non-static handlers on a VM are analogous to static and non-static methods on a class. Blockchain handlers can be thought of as methods on an object, whereas VM handlers can be thought of as static methods on a class. ### Instantiate a VM The `vm.Factory` interface is implemented to create new VM instances from which a blockchain can be initialized. The factory's `New` method shown below provides `AvalancheGo` with an instance of the VM. It's defined in the [`factory.go`](https://github.com/ava-labs/timestampvm/blob/main/timestampvm/factory.go) file of the `timestampvm` repository. ```go // Returning a new VM instance from VM's factory func (f *Factory) New(*snow.Context) (interface{}, error) { return &vm.VM{}, nil } ``` ### Initializing a VM to Create a Blockchain Before a VM can run, AvalancheGo will initialize it by invoking its `Initialize` method. Here, the VM will bootstrap itself and sets up anything it requires before it starts running. This might involve setting up its database, mempool, genesis state, or anything else the VM requires to run. ```go if err := vm.Initialize( ctx.Context, vmDBManager, genesisData, chainConfig.Upgrade, chainConfig.Config, msgChan, fxs, sender, ); ``` You can refer to the [implementation](https://github.com/ava-labs/timestampvm/blob/main/timestampvm/vm.go#L75) of `vm.initialize` in the TimestampVM repository. ## Interfaces Every VM should implement the following interfaces: ### `block.ChainVM` To reach a consensus on linear blockchains, Avalanche uses the Snowman consensus engine. To be compatible with Snowman, a VM must implement the `block.ChainVM` interface. For more information, see [here](https://github.com/ava-labs/avalanchego/blob/master/snow/engine/snowman/block/vm.go). ```go title="snow/engine/snowman/block/vm.go" // ChainVM defines the required functionality of a Snowman VM. // // A Snowman VM is responsible for defining the representation of the state, // the representation of operations in that state, the application of operations // on that state, and the creation of the operations. Consensus will decide on // if the operation is executed and the order operations are executed. // // For example, suppose we have a VM that tracks an increasing number that // is agreed upon by the network. // The state is a single number. // The operation is setting the number to a new, larger value. // Applying the operation will save to the database the new value. // The VM can attempt to issue a new number, of larger value, at any time. // Consensus will ensure the network agrees on the number at every block height. type ChainVM interface { common.VM Getter Parser // Attempt to create a new block from data contained in the VM. // // If the VM doesn't want to issue a new block, an error should be // returned. BuildBlock() (snowman.Block, error) // Notify the VM of the currently preferred block. // // This should always be a block that has no children known to consensus. SetPreference(ids.ID) error // LastAccepted returns the ID of the last accepted block. // // If no blocks have been accepted by consensus yet, it is assumed there is // a definitionally accepted block, the Genesis block, that will be // returned. LastAccepted() (ids.ID, error) } // Getter defines the functionality for fetching a block by its ID. type Getter interface { // Attempt to load a block. // // If the block does not exist, an error should be returned. // GetBlock(ids.ID) (snowman.Block, error) } // Parser defines the functionality for fetching a block by its bytes. type Parser interface { // Attempt to create a block from a stream of bytes. // // The block should be represented by the full byte array, without extra // bytes. ParseBlock([]byte) (snowman.Block, error) } ``` ### `common.VM` `common.VM` is a type that every `VM` must implement. For more information, you can see the full file [here](https://github.com/ava-labs/avalanchego/blob/master/snow/engine/common/vm.go). ```go title="snow/engine/common/vm.go" // VM describes the interface that all consensus VMs must implement type VM interface { // Contains handlers for VM-to-VM specific messages AppHandler // Returns nil if the VM is healthy. // Periodically called and reported via the node's Health API. health.Checkable // Connector represents a handler that is called on connection connect/disconnect validators.Connector // Initialize this VM. // [ctx]: Metadata about this VM. // [ctx.networkID]: The ID of the network this VM's chain is running on. // [ctx.chainID]: The unique ID of the chain this VM is running on. // [ctx.Log]: Used to log messages // [ctx.NodeID]: The unique staker ID of this node. // [ctx.Lock]: A Read/Write lock shared by this VM and the consensus // engine that manages this VM. The write lock is held // whenever code in the consensus engine calls the VM. // [dbManager]: The manager of the database this VM will persist data to. // [genesisBytes]: The byte-encoding of the genesis information of this // VM. The VM uses it to initialize its state. For // example, if this VM were an account-based payments // system, `genesisBytes` would probably contain a genesis // transaction that gives coins to some accounts, and this // transaction would be in the genesis block. // [toEngine]: The channel used to send messages to the consensus engine. // [fxs]: Feature extensions that attach to this VM. Initialize( ctx *snow.Context, dbManager manager.Manager, genesisBytes []byte, upgradeBytes []byte, configBytes []byte, toEngine chan<- Message, fxs []*Fx, appSender AppSender, ) error // Bootstrapping is called when the node is starting to bootstrap this chain. Bootstrapping() error // Bootstrapped is called when the node is done bootstrapping this chain. Bootstrapped() error // Shutdown is called when the node is shutting down. Shutdown() error // Version returns the version of the VM this node is running. Version() (string, error) // Creates the HTTP handlers for custom VM network calls. // // This exposes handlers that the outside world can use to communicate with // a static reference to the VM. Each handler has the path: // [Address of node]/ext/VM/[VM ID]/[extension] // // Returns a mapping from [extension]s to HTTP handlers. // // Each extension can specify how locking is managed for convenience. // // For example, it might make sense to have an extension for creating // genesis bytes this VM can interpret. CreateStaticHandlers() (map[string]*HTTPHandler, error) // Creates the HTTP handlers for custom chain network calls. // // This exposes handlers that the outside world can use to communicate with // the chain. Each handler has the path: // [Address of node]/ext/bc/[chain ID]/[extension] // // Returns a mapping from [extension]s to HTTP handlers. // // Each extension can specify how locking is managed for convenience. // // For example, if this VM implements an account-based payments system, // it have an extension called `accounts`, where clients could get // information about their accounts. CreateHandlers() (map[string]*HTTPHandler, error) } ``` ### `snowman.Block` The `snowman.Block` interface It define the functionality a block must implement to be a block in a linear Snowman chain. For more information, you can see the full file [here](https://github.com/ava-labs/avalanchego/blob/master/snow/consensus/snowman/block.go). ```go title="snow/consensus/snowman/block.go" // Block is a possible decision that dictates the next canonical block. // // Blocks are guaranteed to be Verified, Accepted, and Rejected in topological // order. Specifically, if Verify is called, then the parent has already been // verified. If Accept is called, then the parent has already been accepted. If // Reject is called, the parent has already been accepted or rejected. // // If the status of the block is Unknown, ID is assumed to be able to be called. // If the status of the block is Accepted or Rejected; Parent, Verify, Accept, // and Reject will never be called. type Block interface { choices.Decidable // Parent returns the ID of this block's parent. Parent() ids.ID // Verify that the state transition this block would make if accepted is // valid. If the state transition is invalid, a non-nil error should be // returned. // // It is guaranteed that the Parent has been successfully verified. Verify() error // Bytes returns the binary representation of this block. // // This is used for sending blocks to peers. The bytes should be able to be // parsed into the same block on another node. Bytes() []byte // Height returns the height of this block in the chain. Height() uint64 } ``` ### `choices.Decidable` This interface is a superset of every decidable object, such as transactions, blocks, and vertices. For more information, you can see the full file [here](https://github.com/ava-labs/avalanchego/blob/master/snow/choices/decidable.go). ```go title="snow/choices/decidable.go" // Decidable represents element that can be decided. // // Decidable objects are typically thought of as either transactions, blocks, or // vertices. type Decidable interface { // ID returns a unique ID for this element. // // Typically, this is implemented by using a cryptographic hash of a // binary representation of this element. An element should return the same // IDs upon repeated calls. ID() ids.ID // Accept this element. // // This element will be accepted by every correct node in the network. Accept() error // Reject this element. // // This element will not be accepted by any correct node in the network. Reject() error // Status returns this element's current status. // // If Accept has been called on an element with this ID, Accepted should be // returned. Similarly, if Reject has been called on an element with this // ID, Rejected should be returned. If the contents of this element are // unknown, then Unknown should be returned. Otherwise, Processing should be // returned. Status() Status } ``` # WAGMI Avalanche L1 (/docs/avalanche-l1s/wagmi-avalanche-l1) --- title: WAGMI Avalanche L1 description: Learn about the WAGMI Avalanche L1 in this detailed case study. --- This is one of the first cases of using Avalanche L1s as a proving ground for changes in a production VM (Coreth). Many underestimate how useful the isolation of Avalanche L1s is for performing complex VM testing on a live network (without impacting the stability of the primary network). We created a basic WAGMI Explorer [https://subnets-test.avax.network/wagmi](https://subnets-test.avax.network/wagmi) that surfaces aggregated usage statistics about the Avalanche L1. - SubnetID: [28nrH5T2BMvNrWecFcV3mfccjs6axM1TVyqe79MCv2Mhs8kxiY](https://explorer-xp.avax-test.network/avalanche-l1/28nrH5T2BMvNrWecFcV3mfccjs6axM1TVyqe79MCv2Mhs8kxiY?tab=validators) - ChainID: [2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt](https://testnet.avascan.info/blockchain/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt) ### Network Parameters[​](#network-parameters "Direct link to heading") - NetworkID: 11111 - ChainID: 11111 - Block Gas Limit: 20,000,000 (2.5x C-Chain) - 10s Gas Target: 100,000,000 (~6.67x C-Chain) - Min Fee: 1 Gwei (4% of C-Chain) - Target Block Rate: 2s (Same as C-Chain) The genesis file of WAGMI can be found [here](https://github.com/ava-labs/public-chain-assets/blob/1951594346dcc91682bdd8929bcf8c1bf6a04c33/chains/11111/genesis.json). ### Adding WAGMI to Core[​](#adding-wagmi-to-core "Direct link to heading") - Network Name: WAGMI - RPC URL: [https://subnets.avax.network/wagmi/wagmi-chain-testnet/rpc] - WS URL: wss://avalanche-l1s.avax.network/wagmi/wagmi-chain-testnet/ws - Chain ID: 11111 - Symbol: WGM - Explorer: [https://subnets.avax.network/wagmi/wagmi-chain-testnet/explorer] This can be used with other wallets too, such as MetaMask. Case Study: WAGMI Upgrades[​](#case-study-wagmi-upgrades "Direct link to heading") ---------------------------------------------------------------------------------- This case study uses [WAGMI](https://subnets-test.avax.network/wagmi) Avalanche L1 upgrade to show how a network upgrade on an EVM-based (Ethereum Virtual Machine) Avalanche L1 can be done simply, and how the resulting upgrade can be used to dynamically control fee structure on the Avalanche L1. ### Introduction[​](#introduction "Direct link to heading") [Subnet-EVM](https://github.com/ava-labs/subnet-evm) aims to provide an easy to use toolbox to customize the EVM for your blockchain. It is meant to run out of the box for many Avalanche L1s without any modification. But what happens when you want to add a new feature updating the rules of your EVM? Instead of hard coding the timing of network upgrades in client code like most EVM chains, requiring coordinated deployments of new code, [Subnet-EVM v0.2.8](https://github.com/ava-labs/subnet-evm/releases/tag/v0.2.8) introduces the long awaited feature to perform network upgrades by just using a few lines of JSON in a configuration file. ### Network Upgrades: Enable/Disable Precompiles[​](#network-upgrades-enabledisable-precompiles "Direct link to heading") Detailed description of how to do this can be found in [Customize an Avalanche L1](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#network-upgrades-enabledisable-precompiles) tutorial. Here's a summary: 1. Network Upgrade utilizes existing precompiles on the Subnet-EVM: - ContractDeployerAllowList, for restricting smart contract deployers - TransactionAllowList, for restricting who can submit transactions - NativeMinter, for minting native coins - FeeManager, for configuring dynamic fees - RewardManager, for enabling block rewards 2. Each of these precompiles can be individually enabled or disabled at a given timestamp as a network upgrade, or any of the parameters governing its behavior changed. 3. These upgrades must be specified in a file named `upgrade.json` placed in the same directory where [`config.json`](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#avalanchego-chain-configs) resides: `{chain-config-dir}/{blockchainID}/upgrade.json`. ### Preparation[​](#preparation "Direct link to heading") To prepare for the first WAGMI network upgrade, on August 15, 2022, we had announced on [X](https://x.com/AaronBuchwald/status/1559249414102720512) and shared on other social media such as Discord. For the second upgrade, on February 24, 2024, we had another announcement on [X](https://x.com/jceyonur/status/1760777031858745701?s=20). ### Deploying upgrade.json[​](#deploying-upgradejson "Direct link to heading") The content of the `upgrade.json` is: ```json { "precompileUpgrades": [ { "feeManagerConfig": { "adminAddresses": ["0x6f0f6DA1852857d7789f68a28bba866671f3880D"], "blockTimestamp": 1660658400 } }, { "contractNativeMinterConfig": { "blockTimestamp": 1708696800, "adminAddresses": ["0x6f0f6DA1852857d7789f68a28bba866671f3880D"], "managerAddresses": ["0xadFA2910DC148674910c07d18DF966A28CD21331"] } } ] } ``` With the above `upgrade.json`, we intend to perform two network upgrades: 1. The first upgrade is to activate the FeeManager precompile: - `0x6f0f6DA1852857d7789f68a28bba866671f3880D` is named as the new Admin of the FeeManager precompile. - `1660658400` is the [Unix timestamp](https://www.unixtimestamp.com/) for Tue Aug 16 2022 14:00:00 GMT+0000 (future time when we made the announcement) when the new FeeManager change would take effect. 2. The second upgrade is to activate the NativeMinter precompile: - `0x6f0f6DA1852857d7789f68a28bba866671f3880D` is named as the new Admin of the NativeMinter precompile. - `0xadFA2910DC148674910c07d18DF966A28CD21331` is named as the new Manager of the NativeMinter precompile. Manager addresses are enabled after Durango upgrades which occurred on February 13, 2024. - `1708696800` is the [Unix timestamp](https://www.unixtimestamp.com/) for Fri Feb 23 2024 14:00:00 GMT+0000 (future time when we made the announcement) when the new NativeMinter change would take effect. Detailed explanations of feeManagerConfig can be found in [here](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#configuring-dynamic-fees), and for the contractNativeMinterConfig in [here](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#minting-native-coins). We place the `upgrade.json` file in the chain config directory, which in our case is `~/.avalanchego/configs/chains/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt/`. After that, we restart the node so the upgrade file is loaded. When the node restarts, AvalancheGo reads the contents of the JSON file and passes it into Subnet-EVM. We see a log of the chain configuration that includes the updated precompile upgrade. It looks like this: ```bash INFO [02-22|18:27:06.473] <2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt Chain> github.com/ava-labs/subnet-evm/core/blockchain.go:335: Upgrade Config: {"precompileUpgrades":[{"feeManagerConfig":{"adminAddresses":["0x6f0f6da1852857d7789f68a28bba866671f3880d"],"blockTimestamp":1660658400}},{"contractNativeMinterConfig":{"adminAddresses":["0x6f0f6da1852857d7789f68a28bba866671f3880d"],"managerAddresses":["0xadfa2910dc148674910c07d18df966a28cd21331"],"blockTimestamp":1708696800}}]} ``` We note that `precompileUpgrades` correctly shows the upcoming precompile upgrades. Upgrade is locked in and ready. ### Activations[​](#activations "Direct link to heading") When the time passed 10:00 AM EDT August 16, 2022 (Unix timestamp 1660658400), the `upgrade.json` had been executed as planned and the new FeeManager admin address has been activated. From now on, we don't need to issue any new code or deploy anything on the WAGMI nodes to change the fee structure. Let's see how it works in practice! For the second upgrade on February 23, 2024, the same process was followed. The `upgrade.json` had been executed after Durango, as planned, and the new NativeMinter admin and manager addresses have been activated. ### Using Fee Manager[​](#using-fee-manager "Direct link to heading") The owner `0x6f0f6DA1852857d7789f68a28bba866671f3880D` can now configure the fees on the Avalanche L1 as they see fit. To do that, all that's needed is access to the network, the private key for the newly set manager address and making calls on the precompiled contract. We will use [Remix](https://remix.ethereum.org/) online Solidity IDE and the [Core Browser Extension](https://support.avax.network/en/articles/6066879-core-extension-how-do-i-add-the-core-extension). Core comes with WAGMI network built-in. MetaMask will do as well but you will need to [add WAGMI](/docs/avalanche-l1s/wagmi-avalanche-l1) yourself. First using Core, we open the account as the owner `0x6f0f6DA1852857d7789f68a28bba866671f3880D`. Then we connect Core to WAGMI, Switch on the `Testnet Mode` in `Advanced` page in the hamburger menu: ![Core Testnet mode](/images/wagmi1.png) And then open the `Manage Networks` menu in the networks dropdown. Select WAGMI there by clicking the star icon: ![Core network selection](/images/wagmi2.png) We then switch to WAGMI in the networks dropdown. We are ready to move on to Remix now, so we open it in the browser. First, we check that Remix sees the extension and correctly talks to it. We select `Deploy & run transactions` icon on the left edge, and on the Environment dropdown, select `Injected Provider`. We need to approve the Remix network access in the Core browser extension. When that is done, `Custom (11111) network` is shown: ![Injected provider](/images/wagmi3.png) Good, we're talking to WAGMI Avalanche L1. Next we need to load the contracts into Remix. Using 'load from GitHub' option from the Remix home screen we load two contracts: - [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IAllowList.sol) - and [IFeeManager.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IFeeManager.sol). IFeeManager is our precompile, but it references the IAllowList, so we need that one as well. We compile IFeeManager.sol and use deployed contract at the precompile address `0x0200000000000000000000000000000000000003` used on the [Avalanche L1](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/feemanager/module.go#L21). ![Deployed contract](/images/wagmi4.png) Now we can interact with the FeeManager precompile from within Remix via Core. For example, we can use the `getFeeConfig` method to check the current fee configuration. This action can be performed by anyone as it is just a read operation. Once we have the new desired configuration for the fees on the Avalanche L1, we can use the `setFeeConfig` to change the parameters. This action can **only** be performed by the owner `0x6f0f6DA1852857d7789f68a28bba866671f3880D` as the `adminAddress` specified in the [`upgrade.json` above](#deploying-upgradejson). ![setFeeConfig](/images/wagmi5.png) When we call that method by pressing the `transact` button, a new transaction is posted to the Avalanche L1, and we can see it on [the explorer](https://subnets-test.avax.network/wagmi/block/0xad95ccf04f6a8e018ece7912939860553363cc23151a0a31ea429ba6e60ad5a3): ![transaction](/images/wagmi6.png) Immediately after the transaction is accepted, the new fee config takes effect. We can check with the `getFeeCofig` that the values are reflected in the active fee config (again this action can be performed by anyone): ![getFeeConfig](/images/wagmi7.png) That's it, fees changed! No network upgrades, no complex and risky deployments, just making a simple contract call and the new fee configuration is in place! ### Using NativeMinter[​](#using-nativeminter "Direct link to heading") For the NativeMinter, we can use the same process to connect to the Avalanche L1 and interact with the precompile. We can load INativeMinter interface using 'load from GitHub' option from the Remix home screen with following contracts: - [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IAllowList.sol) - and [INativeMinter.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/INativeMinter.sol). We can compile them and interact with the deployed contract at the precompile address `0x0200000000000000000000000000000000000001` used on the [Avalanche L1](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/nativeminter/module.go#L22). ![Deployed contract](/images/wagmi8.png) The native minter precompile is used to mint native coins to specified addresses. The minted coins is added to the current supply and can be used by the recipient to pay for gas fees. For more information about the native minter precompile see [here](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#minting-native-coins). `mintNativeCoin` method can be only called by enabled, manager and admin addresses. For this upgrade we have added both an admin and a manager address in [`upgrade.json` above](#deploying-upgradejson). The manager address was available after Durango upgrades which occurred on February 13, 2024. We will use the manager address `0xadfa2910dc148674910c07d18df966a28cd21331` to mint native coins. ![mintNativeCoin](/images/wagmi9.png) When we call that method by pressing the `transact` button, a new transaction is posted to the Avalanche L1, and we can see it on [the explorer](https://subnets-test.avax.network/wagmi/tx/0xc4aaba7b5863c1b8f6664ac1d483e2d7d392ab58d1a8feb0b6c318cbae7f1e93): ![tx](/images/wagmi10.png) As a result of this transaction, the native minter precompile minted a new native coin (1 WGM) to the recipient address `0xB78cbAa319ffBD899951AA30D4320f5818938310`. The address page on the explorer [here](https://subnets-test.avax.network/wagmi/address/0xB78cbAa319ffBD899951AA30D4320f5818938310) shows no incoming transaction; this is because the 1 WGM was directly minted by the EVM itself, without any sender. ### Conclusion[​](#conclusion "Direct link to heading") Network upgrades can be complex and perilous procedures to carry out safely. Our continuing efforts with Avalanche L1s is to make upgrades as painless and simple as possible. With the powerful combination of stateful precompiles and network upgrades via the upgrade configuration files we have managed to greatly simplify both the network upgrades and network parameter changes. This in turn enables much safer experimentation and many new use cases that were too risky and complex to carry out with high-coordination efforts required with the traditional network upgrade mechanisms. We hope this case study will help spark ideas for new things you may try on your own. We're looking forward to seeing what you have built and how easy upgrades help you in managing your Avalanche L1s! If you have any questions or issues, feel free to contact us on our [Discord](https://chat.avalabs.org/). Or just reach out to tell us what exciting new things you have built! # ACP-103: Dynamic Fees (/docs/acps/103-dynamic-fees) --- title: "ACP-103: Dynamic Fees" description: "Details for Avalanche Community Proposal 103: Dynamic Fees" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/103-dynamic-fees/README.md --- | ACP | 103 | | :--- | :--- | | **Title** | Add Dynamic Fees to the P-Chain | | **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)), Alberto Benegiamo ([@abi87](https://github.com/abi87)), Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/104)) | | **Track** | Standards | ## Abstract Introduce a dynamic fee mechanism to the P-Chain. Preview a future transition to a multidimensional fee mechanism. ## Motivation Blockchains are resource-constrained environments. Users are charged for the execution and inclusion of their transactions based on the blockchain's transaction fee mechanism. The mechanism should fluctuate based on the supply of and demand for said resources to serve as a deterrent against spam and denial-of-service attacks. With a fixed fee mechanism, users are provided with simplicity and predictability but network congestion and resource constraints are not taken into account. There is no incentive for users to withhold transactions since the cost is fixed regardless of the demand. The fee does not adjust the execution and inclusion fee of transactions to the market clearing price. The C-Chain, in [Apricot Phase 3](https://medium.com/avalancheavax/apricot-phase-three-c-chain-dynamic-fees-432d32d67b60), employs a dynamic fee mechanism to raise the price during periods of high demand and lowering the price during periods of low demand. As the price gets too expensive, network utilization will decrease, which drops the price. This ensures the execution and inclusion fee of transactions closely matches the market clearing price. The P-Chain currently operates under a fixed fee mechanism. To more robustly handle spikes in load expected from introducing the improvements in [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md), it should be migrated to a dynamic fee mechanism. The X-Chain also currently operates under a fixed fee mechanism. However, due to the current lower usage and lack of new feature introduction, the migration of the X-Chain to a dynamic fee mechanism is deferred to a later ACP to reduce unnecessary additional technical complexity. ## Specification ### Dimensions There are four dimensions that will be used to approximate the computational cost of, or "gas" consumed in, a transaction: 1. Bandwidth $B$ is the amount of network bandwidth used for transaction broadcast. This is set to the size of the transaction in bytes. 2. Reads $R$ is the number of state/database reads used in transaction execution. 3. Writes $W$ is the number of state/database writes used in transaction execution. 4. Compute $C$ is the total amount of compute used to verify and execute a transaction, measured in microseconds. The gas consumed $G$ in a transaction is: $$G = B + 1000R + 1000W + 4C$$ A future ACP could remove the merging of these dimensions to granularly meter usage of each resource in a multidimensional scheme. ### Mechanism This mechanism aims to maintain a target gas consumption $T$ per second and adjusts the fee based on the excess gas consumption $x$, defined as the difference between the current gas consumption and $T$. Prior to the activation of this mechanism, $x$ is initialized: $$x = 0$$ At the start of building/executing block $b$, $x$ is updated: $$x = \max(x - T \cdot \Delta{t}, 0)$$ Where $\Delta{t}$ is the number of seconds between $b$'s block timestamp and $b$'s parent's block timestamp. The gas price for block $b$ is: $$M \cdot \exp\left(\frac{x}{K}\right)$$ Where: - $M$ is the minimum gas price - $\exp\left(x\right)$ is an approximation of $e^x$ following the EIP-4844 specification ```python # Approximates factor * e ** (numerator / denominator) using Taylor expansion def fake_exponential(factor: int, numerator: int, denominator: int) -> int: i = 1 output = 0 numerator_accum = factor * denominator while numerator_accum > 0: output += numerator_accum numerator_accum = (numerator_accum * numerator) // (denominator * i) i += 1 return output // denominator ``` - $K$ is a constant to control the rate of change of the gas price After processing block $b$, $x$ is updated with the total gas consumed in the block $G$: $$x = x + G$$ Whenever $x$ increases by $K$, the gas price increases by a factor of `~2.7`. If the gas price gets too expensive, average gas consumption drops, and $x$ starts decreasing, dropping the price. The gas price constantly adjusts to make sure that, on average, the blockchain consumes $T$ gas per second. A [token bucket](https://en.wikipedia.org/wiki/Token_bucket) is employed to meter the maximum rate of gas consumption. Define $C$ as the capacity of the bucket, $R$ as the amount of gas to add to the bucket per second, and $r$ as the amount of gas currently in the bucket. Prior to the activation of this mechanism, $r$ is initialized: $$r = 0$$ At the beginning of processing block $b$, $r$ is set: $$r = \min\left(r + R \cdot \Delta{t}, C\right)$$ Where $\Delta{t}$ is the number of seconds between $b$'s block timestamp and $b$'s parent's block timestamp. The maximum gas consumed in a given $\Delta{t}$ is $r + R \cdot \Delta{t}$. The upper bound across all $\Delta{t}$ is $C + R \cdot \Delta{t}$. After processing block $b$, the total gas consumed in $b$, or $G$, will be known. If $G \gt r$, $b$ is considered an invalid block. If $b$ is a valid block, $r$ is updated: $$r = r - G$$ A block gas limit does not need to be set as it is implicitly derived from $r$. The parameters at activation are: | Parameter | P-Chain Configuration| | - | - | | $T$ - target gas consumed per second | 50,000 | | $M$ - minimum gas price | 1 nAVAX | | $K$ - gas price update constant | 2_164_043 | | $C$ - maximum gas capacity | 1,000,000 | | $R$ - gas capacity added per second | 100,000 | $K$ was chosen such that at sustained maximum capacity ($R=100,000$ gas/second), the fee rate will double every ~30 seconds. As the network gains capacity to handle additional load, this algorithm can be tuned to increase the gas consumption rate. #### A note on $e^x$ There is a subtle reason why an exponential adjustment function was chosen: The adjustment function should be _equally_ reactive irrespective of the actual fee. Define $b_n$ as the current block's gas fee, $b_{n+1}$ as the next block's gas fee, and $x$ as the excess gas consumption. Let's use a linear adjustment function: $$b_{n+1} = b_n + 10x$$ Assume $b_n = 100$ and the current block is 1 unit above target utilization, or $x = 1$. Then, $b_{n+1} = 100 + 10 \cdot 1 = 110$, an increase of `10%`. If instead $b_n = 10,000$, $b_{n+1} = 10,000 + 10 \cdot 1 = 10,010$, an increase of `0.1%`. The fee is _less_ reactive as the fee increases. This is because the rate of change _does not scale_ with $x$. Now, let's use an exponential adjustment function: $$b_{n+1} = b_n \cdot e^x$$ Assume $b_n = 100$ and the current block is 1 unit above target utilization, or $x = 1$. Then, $b_{n+1} = 100 \cdot e^1 \approx 271.828$, an increase of `171%`. If instead $b_n = 10,000$, $b_{n+1} = 10,000 \cdot e^1 \approx 27,182.8$, an increase of `171%` again. The fee is _equally_ reactive as the fee increases. This is because the rate of change _scales_ with $x$. ### Block Building Procedure When a transaction is constructed on the P-Chain, the amount of $AVAX burned is given by `sum($AVAX outputs) - sum($AVAX inputs)`. The amount of gas consumed by the transaction can be deterministically calculated after construction. Dividing the amount of $AVAX burned by the amount of gas consumed yields the maximum gas price that the transaction can pay. Instead of using a FIFO queue for the mempool (like the P-Chain does now), the mempool should use a priority queue ordered by the maximum gas price of each transaction. This ensures that higher paying transactions are included first. ## Backwards Compatibility Modification of a fee mechanism is an execution change and requires a mandatory upgrade for activation. Implementers must take care to not alter the execution behavior prior to activation. After this ACP is activated, any transaction issued on the P-Chain must account for the fee mechanism defined above. Users are responsible for reconstructing their transactions to include a larger fee for quicker inclusion when the fee increases. ## Reference Implementation ACP-103 was implemented into AvalancheGo behind the `Etna` upgrade flag. The full body of work can be found tagged with the `acp103` label [here](https://github.com/ava-labs/avalanchego/pulls?q=is%3Apr+label%3Aacp103). ## Security Considerations The current fixed fee mechanism on the X-Chain and P-Chain does not robustly handle spikes in load. Migrating the P-Chain to a dynamic fee mechanism will ensure that any additional load caused by demand for new P-Chain features (such as those introduced in [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md)) is properly priced given allotted processing capacity. The X-Chain, in comparison, currently has significantly lower usage, making it less likely for the demand for blockspace on it to exceed the current static fee rates. If necessary or desired, a future ACP can reuse the mechanism introduced here to add dynamic fee rates to the X-Chain. ## Acknowledgements Thank you to [@aaronbuchwald](https://github.com/aaronbuchwald) and [@patrick-ogrady](https://github.com/patrick-ogrady) for providing feedback prior to publication. Thank you to the authors of [EIP-4844](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-4844.md) for creating the fee design that inspired the above mechanism. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-108: Evm Event Importing (/docs/acps/108-evm-event-importing) --- title: "ACP-108: Evm Event Importing" description: "Details for Avalanche Community Proposal 108: Evm Event Importing" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/108-evm-event-importing/README.md --- | ACP | 108 | | :--- | :--- | | **Title** | EVM Event Importing Standard | | **Author(s)** | Michael Kaplan ([@mkaplan13](https://github.com/mkaplan13)) | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/114)) | | **Track** | Best Practices Track | ## Abstract Defines a standard smart contract interface and abstract implementation for importing EVM events from any blockchain within Avalanche using [Avalanche Warp Messaging](https://docs.avax.network/build/cross-chain/awm/overview). ## Motivation The implementation of Avalanche Warp Messaging within `coreth` and `subnet-evm` exposes a [mechanism for getting authenticated hashes of blocks](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IWarpMessenger.sol#L43) that have been accepted on blockchains within Avalanche. Proofs of acceptance of blocks, such as those introduced in [ACP-75](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/75-acceptance-proofs), can be used to prove arbitrary events and state changes that occured in those blocks. However, there is currently no clear standard for using authenticated block hashes in smart contracts within Avalanche, making it difficult to build applications that leverage this mechanism. In order to make effective use of authenticated block hashes, contracts must be provided encoded block headers that match the authenticated block hashes and also Merkle proofs that are verified against the state or receipts root contained in the block header. With a standard interface and abstract contract implemetation that handles the authentication of block hashes and verification of Merkle proofs, smart contract developers on Avalanche will be able to much more easily create applications that leverage data from other Avalanche blockchains. These type of cross-chain application do not require any direct interaction on the source chain. ## Specification ### Event Importing Interface We propose that smart contracts importing EVM events emitted by other blockchains within Avalanche implement the following interface. #### Methods Imports the EVM event uniquely identified by the source blockchain ID, block header, transaction index, and log index. The `blockHeader` must be validated to match the authenticated block hash from the `sourceBlockchainID`. The specification for EVM block headers can be found [here](https://github.com/ava-labs/subnet-evm/blob/master/core/types/block.go#L73). The `txIndex` identifies the key of receipts trie of the given block header that the `receiptProof` must prove inclusion of. The value obtained by verifying the `receiptProof` for that key is the encoded transaction receipt. The specification for EVM transaction receipts can be found [here](https://github.com/ava-labs/subnet-evm/blob/master/core/types/receipt.go#L62). The `logIndex` identifies which event log from the given transaction receipt is to be imported. Must emit an `EventImported` event upon success. ```solidity function importEvent( bytes32 sourceBlockchainID, bytes calldata blockHeader, uint256 txIndex, bytes[] calldata receiptProof, uint256 logIndex ) external; ``` This interface does not require that the Warp precompile is used to authenticate block hashes. Implementations could: - Use the Warp precompile to authenticate block hashes provided directly in the transaction calling `importEvent`. - Check previously authenticated block hashes using an external contract. - Allows for a block hash to be authenticated once and used in arbitrarily many transactions afterwards. - Allows for alternative authentication mechanisms to be used, such as trusted oracles. #### Events Must trigger when an EVM event is imported. ```solidity event EventImported( bytes32 indexed sourceBlockchainID, bytes32 indexed sourceBlockHash, address indexed loggerAddress, uint256 txIndex, uint256 logIndex ); ``` ### Event Importing Abstract Contract Applications importing EVM events emitted by other blockchains within Avalanche should be able to use a standard abstract implementation of the `importEvent` interface. This abstract implementation must handle: - Authenticating block hashes from other chains. - Verifying that the encoded `blockHeader` matches the imported block hash. - Verifying the Merkle `receiptProof` for the given `txIndex` against the receipt root of the provided `blockHeader`. - Decoding the event log identified by `logIndex` from the receipt obtained from verifying the `receiptProof`. As noted above, implementations could directly use the Warp precompile's `getVerifiedWarpBlockHash` interface method for authenticating block hashes, as is done in the reference implementation [here](https://github.com/ava-labs/event-importer-poc/blob/main/contracts/src/EventImporter.sol#L51). Alternatively, implementations could use the `sourceBlockchainID` and `blockHeader` provided in the parameters to check with an external contract that the block has been accepted on the given chain. The specifics of such an external contract are outside the scope of this ACP, but for illustrative purposes, this could look along the lines of: ```solidity bool valid = blockHashRegistry.checkAuthenticatedBlockHash( sourceBlockchainID, keccack256(blockHeader) ); require(valid, "Invalid block header"); ``` Inheriting contracts should only need to define the logic to be executed when an event is imported. This is done by providing an implementation of the following internal function, called by `importEvent`. ```solidity function _onEventImport(EVMEventInfo memory eventInfo) internal virtual; ``` Where the `EVMEventInfo` struct is defined as: ```solidity struct EVMLog { address loggerAddress; bytes32[] topics; bytes data; } struct EVMEventInfo { bytes32 blockchainID; uint256 blockNumber; uint256 txIndex; uint256 logIndex; EVMLog log; } ``` The `EVMLog` struct is meant to match the `Log` type definition in the EVM [here](https://github.com/ava-labs/subnet-evm/blob/master/core/types/log.go#L39). ## Reference Implementation See reference implementation on [Github here](https://github.com/ava-labs/event-importer-poc). In addition to implementing the interface and abstract contract described above, the reference implementation shows how transactions can be constructed to import events using Warp block hash signatures. ## Open Questions See [here](https://github.com/ava-labs/event-importer-poc?tab=readme-ov-file#open-questions-and-considerations). ## Security Considerations The correctness of a contract using block hashes to prove that a specific event was emitted within that block depends on the correctness of: 1. The mechanism for authenticating that a block hash was finalized on another blockchain. 2. The Merkle proof validation library used to prove that a specific transaction receipt was included in the given block. For considerations on using Avalanche Warp Messaging to authenticate block hashes, see [here](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/30-avalanche-warp-x-evm#security-considerations). To improve confidence in the correctness of the Merkle proof validation used in implementations, well-audited and widely used libraries should be used. ## Acknowledgements Using Merkle proofs to verify events/state against root hashes is not a new idea. Protocols such as [IBC](https://ibc.cosmos.network/v8/), [Rainbow Bridge](https://github.com/Near-One/rainbow-bridge), and [LayerZero](https://layerzero.network/publications/LayerZero_Whitepaper_V1.1.0.pdf), among others, have previously suggested using Merkle proofs in a similar manner. Thanks to [@aaronbuchwald](https://github.com/aaronbuchwald) for proposing the `getVerifiedWarpBlockHash` interface be included in the AWM implemenation within Avalanche EVMs, which enables this type of use case. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-113: Provable Randomness (/docs/acps/113-provable-randomness) --- title: "ACP-113: Provable Randomness" description: "Details for Avalanche Community Proposal 113: Provable Randomness" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/113-provable-randomness/README.md --- | ACP | 113 | | :------------ | :------------------------------------------------------------------------------------ | | **Title** | Provable Virtual Machine Randomness | | **Author(s)** | Tsachi Herman [http://github.com/tsachiherman](http://github.com/tsachiherman) | | **Status** | Stale ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/142)) | | **Track** | Standards | ## Future Work This ACP was marked as stale due to its documented security concerns. In order to safely utilize randomness produced by this mechanism, the consumer of the randomness must: 1. Define a security threshold `x` which is the maximum number of consecutive blocks which can be proposed by a malicious entity. 2. After committing to a request for randomness, the consumer must wait for `x` blocks. 3. After waiting for `x` blocks, the consumer must verify that the randomness was not biased during the `x` blocks. 4. If the randomness was biased, it would be insufficient to request randomness again, as this would allow the malicious block producer to discard any randomness that it did not like. If using the randomness mechanism proposed in this ACP, the consumer of the randomness must be able to terminate the request for randomness in such a way that no participant would desire the outcome. Griefing attacks would likely result from such a construction. ### Alternative Mechanisms There are alternative mechanisms that would not result in such security concerns, such as: - Utilizing a deterministic threshold signature scheme to finalize a block in consensus would allow the threshold signature to be used during the execution of the block. - Utilizing threshold commit-reveal schemes that guarantee that committed values will always be revealed in a timely manner. However, these mechanisms are likely too costly to be introduced into the Avalanche Primary Network due to its validator set size. It is left to a future ACP to specify the implementation of one of these alternative schemes for L1 networks with smaller sized validator sets. ## Abstract Avalanche offers developers flexibility through subnets and EVM-compatible smart contracts. However, the platform's deterministic block execution limits the use of traditional random number generators within these contracts. To address this, a mechanism is proposed to generate verifiable, non-cryptographic random number seeds on the Avalanche platform. This method ensures uniformity while allowing developers to build more versatile applications. ## Motivation Reliable randomness is essential for building exciting applications on Avalanche. Games, participant selection, dynamic content, supply chain management, and decentralized services all rely on unpredictable outcomes to function fairly. Randomness also fuels functionalities like unique identifiers and simulations. Without a secure way to generate random numbers within smart contracts, Avalanche applications become limited. Avalanche's traditional reliance on external oracles for randomness creates complexity and bottlenecks. These oracles inflate costs, hinder transaction speed, and are cumbersome to integrate. As Avalanche scales to more Subnets, this dependence on external systems becomes increasingly unsustainable. A solution for verifiable random number generation within Avalanche solves these problems. It provides fair randomness functionality across the chains, at no additional cost. This paves the way for a more efficient Avalanche ecosystem. ## Specification ### Changes Summary The existing Avalanche protocol breaks the block building into two parts : external and internal. The external block is the Snowman++ block, whereas the internal block is the actual virtual machine block. To support randomness, a BLS based VRF implementation is used, that would be recursively signing its own signatures as its message. Since the BLS signatures are deterministic, they provide a great way to construct a reliable VRF. For proposers that do not have a BLS key associated with their node, the hash of the signature from the previous round is used in place of their signature. In order to bootstrap the signatures chain, a missing signature would be replaced with a byte slice that is the hash product of a verifiable and trustable seed. The changes proposed here would affect the way a blocks are validated. Therefore, when this change gets implemented, it needs to be deployed as a mandatory upgrade. ``` +-----------------------+ +-----------------------+ | Block n | <-------- | Block n+1 | +-----------------------+ +-----------------------+ | VRF-Sig(n) | | VRF-Sig(n+1) | | ... | | ... | +-----------------------+ +-----------------------+ +-----------------------+ +-----------------------+ | VM n | | VM n+1 | +-----------------------+ +-----------------------+ | VRF-Out(n) | | VRF-Out(n+1) | +-----------------------+ +-----------------------+ VRF-Sig(n+1) = Sign(VRF-Sig(n), Block n+1 proposer's BLS key) VRF-Out(n) = Hash(VRF-Sig(n)) ``` ### Changes Details #### Step 1. Adding BLS signature to proposed blocks ```go type statelessUnsignedBlock struct { … vrfSig []byte `serialize:”true”` } ``` #### Step 2. Populate signature When a block proposer attempts to build a new block, it would need to use the parent block as a reference. The `vrfSig` field within each block is going to be daisy-chained to the `vrfSig` field from it's parent block. Populating the `vrfSig` would following this logic: 1. The current proposer has a BLS key a. If the parent block has an empty `vrfSig` signature, the proposer would sign the bootStrappingBlockSignature with its BLS key. See the bootStrappingBlockSignature details below. This is the base case. b. If the parent block does not have an empty `vrfSig` signature, that signature would be signed using the proposer’s BLS key. 2. The current proposer does not have a BLS key a. If the parent block has a non-empty `vrfSig` signature, the proposer would set the proposed block `vrfSig` to the 32 byte hash result of the following preimage: ``` +-------------------------+----------+------------+ | prefix : | [8]byte | "rng-derv" | +-------------------------+----------+------------+ | vrfSig : | [96]byte | 96 bytes | +-------------------------+----------+------------+ ``` b. If the parent block has an empty `vrfSig` signature, the proposer would leave the `vrfSig` on the new block empty. The bootStrappingBlockSignature that would be used above is the hash of the following preimage: ``` +-----------------------+----------+------------+ | prefix : | [8]byte | "rng-root" | +-----------------------+----------+------------+ | networkID: | uint32 | 4 bytes | +-----------------------+----------+------------+ | chainID : | [32]byte | 32 bytes | +-----------------------+----------+------------+ ``` #### Step 3. Signature Verification This signature verification would perform the exact opposite of what was done in step 2, and would verify the cryptographic correctness of the operation. Validating the `vrfSig` would following this logic: 1. The proposer has a BLS key a. If the parent block's `vrfSig` was non-empty , then the `vrfSig` in the proposed block is verified to be a valid BLS signature of the parent block's `vrfSig` value for the proposer's BLS public key. b. If the parent block's `vrfSig` was empty, then a BLS signature verification of the proposed block `vrfSig` against the proposer’s BLS public key and bootStrappingBlockSignature would take place. 2. The proposer does not have a BLS key a. If the parent block had a non-empty `vrfSig`, then the hash of the preimage ( as described above ) would be compared against the proposed `vrfSig`. b. If the parent block has an empty `vrfSig` then the proposer's `vrfSig` would be validated to be empty. #### Step 4. Extract the VRF Out and pass to block builders Calculating the VRF Out would be done by hashing the preimage of the following struct: ``` +-----------------------+----------+------------+ | prefix : | [8]byte | "vrfout " | +-----------------------+----------+------------+ | vrfout: | [96]byte | 96 bytes | +-----------------------+----------+------------+ ``` Before calculating the VRF Out, the method needs to explicitly check the case where the `vrfSig` is empty. In that case, the output of the VRF Out needs to be empty as well. ## Backwards Compatibility The above design has taken backward compatibility considerations. The chain would keep working as before, and at some point, would have the newly added `vrfSig` populated. From usage perspective, each VM would need to make its own decision on whether it should use the newly provided random seed. Initially, this random seed would be all zeros - and would get populated once the feature rolled out to a sufficient number of nodes. Also, as mentioned in the summary, these changes would necessitate a network upgrade. ## Reference Implementation A full reference implementation has not been provided yet. It will be provided once this ACP is considered `Implementable`. ## Security Considerations Virtual machine random seeds, while appearing to offer a source of randomness within smart contracts, fall short when it comes to cryptographic security. Here's a breakdown of the critical issues: - Limited Permutation Space: The number of possible random values is derived from the number of validators. While no validator, nor a validator set, would be able to manipulate the randomness into any single value, a nefarious actor(s) might be able to exclude specific numbers. - Predictability Window: The seed value might be accessible to other parties before the smart contract can benefit from its uniqueness. This predictability window creates a vulnerability. An attacker could potentially observe the seed generation process and predict the sequence of "random" numbers it will produce, compromising the entire cryptographic foundation of your smart contract. Despite these limitations appearing severe, attackers face significant hurdles to exploit them. First, the attacker can't control the random number, limiting the attack's effectiveness to how that number is used. Second, a substantial amount of AVAX is needed. And last, such an attack would likely decrease AVAX's value, hurting the attacker financially. One potential attack vector involves collusion among multiple proposers to manipulate the random number selection. These attackers could strategically choose to propose or abstain from proposing blocks, effectively introducing a bias into the system. By working together, they could potentially increase their chances of generating a random number favorable to their goals. However, the effectiveness of this attack is significantly limited for the following reasons: - Limited options: While colluding attackers expand their potential random number choices, the overall pool remains immense (2^256 possibilities). This drastically reduces their ability to target a specific value. - Protocol's countermeasure: The protocol automatically eliminates any bias introduced by previous proposals once an honest proposer submits their block. - Detectability: Exploitation of this attack vector is readily identifiable. A successful attack necessitates coordinated collusion among multiple nodes to synchronize their proposer slots for a specific block height ( the proposer slot order are known in advance ). Subsequent to this alignment, a designated node constructs the block proposal. The network maintains a record of the proposer slot utilized for each block. A value of zero for the proposer slot unequivocally indicates the absence of an exploit. Increasing values correlate with a heightened risk of exploitation. It is important to note that non-zero slot numbers may also arise from transient network disturbances. While this attack is theoretically possible, its practical impact is negligible due to the vast number of potential outcomes and the protocol's inherent safeguards. ## Open Questions ### How would the proposed changes impact the proposer selection and their inherit bias ? The proposed modifications will not influence the selection process for block proposers. Proposers retain the ability to determine which transactions are included in a block. This inherent proposer bias remains unchanged and is unaffected by the proposed changes. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-118: Warp Signature Request (/docs/acps/118-warp-signature-request) --- title: "ACP-118: Warp Signature Request" description: "Details for Avalanche Community Proposal 118: Warp Signature Request" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/118-warp-signature-request/README.md --- | ACP | 118 | | :--- | :--- | | **Title** | Warp Signature Interface Standard | | **Author(s)** | Cam Schultz ([@cam-schultz](https://github.com/cam-schultz)) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/123)) | | **Track** | Best Practices Track | ## Abstract Proposes a standard [AppRequest](https://github.com/ava-labs/avalanchego/blob/master/proto/p2p/p2p.proto#L385) payload format type for requesting Warp signatures for the provided bytes, such that signatures may be requested in a VM-agnostic manner. To make this concrete, this standard type should be defined in AvalancheGo such that VMs can import it at the source code level. This will simplify signature aggregator implementations by allowing them to depend only on AvalancheGo for message construction, rather than individual VM codecs. ## Motivation Warp message signatures consist of an aggregate BLS signature composed of the individual signatures of a subnet's validators. Individual signatures need to be retreivable by the party that wishes to construct an aggregate signature. At present, this is left to VMs to implement, as is the case with [Subnet EVM](https://github.com/ava-labs/subnet-evm/blob/v0.6.7/plugin/evm/message/signature_request.go#20) and [Coreth](https://github.com/ava-labs/coreth/blob/v0.13.6-rc.0/plugin/evm/message/signature_request.go#L20) This creates friction in applications that are intended to operate across many VMs (or distinct implementations of the same VM). As an example, the reference Warp message relayer implementation, [awm-relayer](https://github.com/ava-labs/awm-relayer), fetches individual signatures from validators and aggregates them before sending the Warp message to its destination chain for verification. However, Subnet EVM and Coreth have distinct codecs, requiring the relayer to [switch](https://github.com/ava-labs/awm-relayer/blob/v1.4.0-rc.0/relayer/application_relayer.go#L372) according to the target codebase. Another example is ACP-75, which aims to implement acceptance proofs using Warp. The signature aggregation mechanism is not [specified](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/75-acceptance-proofs/README.md#signature-aggregation), which is a blocker for that ACP to be marked implementable. Standardizing the Warp Signature Request interface by defining it as a format for `AppRequest` message payloads in AvalancheGo would simplify the implementation of ACP-75, and streamline signature aggregation for out-of-protocol services such as Warp message relayers. ## Specification We propose the following types, implemented as Protobuf types that may be decoded from the `AppRequest`/`AppResponse` `app_bytes` field. By way of example, this approach is currently used to [implement](https://github.com/ava-labs/avalanchego/blob/v1.11.10-status-removal/proto/sdk/sdk.proto#7) and [parse](https://github.com/ava-labs/avalanchego/blob/v1.11.10-status-removal/network/p2p/gossip/message.go#22) gossip `AppRequest` types. - `SignatureRequest` includes two fields. `message` specifies the payload that the returned signature should correspond to, namely a serialized unsigned Warp message. `justification` specifies arbitrary data that the requested node may use to decide whether or not it is willing to sign `message`. `justification` may not be required by every VM implementation, but `message` should always contain the bytes to be signed. It is up to the VM to define the validity requirements for the `message` and `justification` payloads. ```protobuf message SignatureRequest { bytes message = 1; bytes justification = 2; } ``` - `SignatureResponse` is the corresponding `AppResponse` type that returns the requested signature. ```protobuf message SignatureResponse { bytes signature = 1; } ``` ### Handlers For each of the above types, VMs must implement corresponding `AppRequest` and `AppResponse` handlers. The `AppRequest` handler should be [registered](https://github.com/ava-labs/avalanchego/blob/v1.11.10-status-removal/network/p2p/network.go#L173) using the canonical handler ID, defined as `2`. ## Use Cases Generally speaking, `SignatureRequest` can be used to request a signature over a Warp message by serializing the unsigned Warp message into `message`, and populating `justification` as needed. ### Sign a known Warp Message Subnet EVM and Coreth store messages that have been seen (i.e. on-chain message sent through the [Warp Precompile](https://github.com/ava-labs/subnet-evm/tree/v0.6.7/precompile/contracts/warp) and [off-chain](https://github.com/ava-labs/subnet-evm/blob/v0.6.7/plugin/evm/config.go#L226) Warp messages) such that a signature over that message can be provided on request. `SignatureRequest` can be used for this case by specifying the Warp message in `message`. The queried node may then look up the Warp message in its database and return the signature. In this case, `justification` is not needed. ### Attest to an on-chain event Subnet EVM and Coreth also support attesting to block hashes via Warp, by serving signature requests made using the following `AppRequest` type: ``` type BlockSignatureRequest struct { BlockID ids.ID } ``` `SignatureRequest` can achieve this by specifying an unsigned Warp message with the `BlockID` as the payload, and serializing that message into `message`. `justification` may optionally be used to provide additional context, such as a the block height of the given block ID. ### Confirm that an event did not occur With [ACP-77](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets), Subnets will have the ability to manage their own validator sets. The Warp message payload contained in a `RegisterSubnetValidatorTx` includes an `expiry`, after which the specified validation ID (i.e. a unique hash over the Subnet ID, node ID, stake weight, and expiry) becomes invalid. The Subnet needs to know that this validation ID is expired so that it can keep its locally tracked validator set in sync with the P-Chain. We also assume that the P-Chain will not persist expired or invalid validation IDs. We can use `SignatureRequest` to construct a Warp message attesting that the validation ID expired. We do so by serializing an unsigned Warp message containing the validation ID into `message`, and providing the validation ID hash preimage in `justification` for the P-Chain to reconstruct the expired validation ID. ## Security Considerations VMs have full latitude when implementing `SignatureRequest` handlers, and should take careful consideration of what `message` payloads their implementation should be willing to sign, given a `justification`. Some considerations include, but are not limited to: - Input validation. Handlers should validate `message` and `justification` payloads to ensure that they decode to coherent types, and that they contain only expected data. - Signature DoS. AvalancheGo's peer-to-peer networking stack implements message rate limiting to mitigate the risk of DoS, but VMs should also consider the cost of parsing and signing a `message` payload. - Payload collision. `message` payloads should be implemented as distinct types that do not overlap with one another within the context of signed Warp messages from the VM. For instance, a `message` payload specifying 32-byte hash may be interpreted as a transaction hash, a block hash, or a blockchain ID. ## Backwards Compatibility This change is backwards compatible for VMs, as nodes running older versions that do not support the new message types will simply drop incoming messages. ## Reference Implementation A reference implementation containing the Protobuf types and the canonical handler ID can be found [here](https://github.com/ava-labs/avalanchego/pull/3218). ## Acknowledgements Thanks to @joshua-kim, @iansuvak, @aaronbuchwald, @michaelkaplan13, and @StephenButtolph for discussion and feedback on this ACP. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-125: Basefee Reduction (/docs/acps/125-basefee-reduction) --- title: "ACP-125: Basefee Reduction" description: "Details for Avalanche Community Proposal 125: Basefee Reduction" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/125-basefee-reduction/README.md --- | ACP | 125 | | :--- | :--- | | **Title** | Reduce C-Chain minimum base fee from 25 nAVAX to 1 nAVAX | | **Author(s)** | Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Darioush Jalali ([@darioush](https://github.com/darioush)) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/127)) | | **Track** | Standards | ## Abstract Reduce the minimum base fee on the Avalanche C-Chain from 25 nAVAX to 1 nAVAX. ## Motivation With dynamic fees, the gas price is supposed to be a result of a continuous auction such that the consumed gas per second converges to the target gas usage per second. When dynamic fees were first introduced, safeguards were added to ensure the mechanism worked as intended, such as a relatively high minimum gas price and a maximum gas price. The maximum gas price has since been entirely removed. The minimum gas price has been reduced significantly. However, the base fee is often observed pinned to this minimum. This shows that it is higher than what the market demands, and therefore it is artificially reducing network usage. ## Specification The dynamic fee calculation currently must enforce a minimum base fee of 25 nAVAX. This change proposes reducing the minimum base fee to 1 nAVAX upon the next network upgrade activation. ## Backwards Compatibility Modifies the consensus rules for the C-Chain, therefore it requires a network upgrade. ## Reference Implementation A draft implementation of this ACP for the coreth VM can be found [here](https://github.com/ava-labs/coreth/pull/604/files). ## Security Considerations Lower gas costs may increase state bloat. However, we note that the dynamic fee algorithm responded appropriately during periods of high use (such as Dec. 2023), which gives reasonable confidence that enforcing a 25 nAVAX minimum fee is no longer necessary. ## Open Questions N/A ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-13: Subnet Only Validators (/docs/acps/13-subnet-only-validators) --- title: "ACP-13: Subnet Only Validators" description: "Details for Avalanche Community Proposal 13: Subnet Only Validators" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/13-subnet-only-validators/README.md --- | ACP | 13 | | :--- | :--- | | **Title** | Subnet-Only Validators (SOVs) | | **Author(s)** | Patrick O'Grady ([contact@patrickogrady.xyz](mailto:contact@patrickogrady.xyz)) | | **Status** | Stale | | **Track** | Standards | | **Superseded-By** | [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md) | ## Abstract Introduce a new type of staker, Subnet-Only Validators (SOVs), that can validate an Avalanche Subnet and participate in Avalanche Warp Messaging (AWM) without syncing or becoming a Validator on the Primary Network. Require SOVs to pay a refundable fee of 500 $AVAX on the P-Chain to register as a Subnet Validator instead of staking at least 2000 $AVAX, the minimum requirement to become a Primary Network Validator. Preview a future transition to Pay-As-You-Go Subnet Validation and $AVAX-Augmented Subnet Security. _This ACP does not modify/deprecate the existing Subnet Validation semantics for Primary Network Validators._ ## Motivation Each node operator must stake at least 2000 $AVAX ($20k at the time of writing) to first become a Primary Network Validator before they qualify to become a Subnet Validator. Most Subnets aim to launch with at least 8 Subnet Validators, which requires staking 16000 $AVAX ($160k at time of writing). All Subnet Validators, to satisfy their role as Primary Network Validators, must also [allocate 8 AWS vCPU, 16 GB RAM, and 1 TB storage](https://github.com/ava-labs/avalanchego/blob/master/README.md#installation) to sync the entire Primary Network (X-Chain, P-Chain, and C-Chain) and participate in its consensus, in addition to whatever resources are required for each Subnet they are validating. Avalanche Warp Messaging (AWM), the native interoperability mechanism for the Avalanche Network, provides a way for Subnets to communicate with each other/C-Chain without a trusted intermediary. Any Subnet Validator must be able to register a BLS key and participate in AWM, otherwise a Subnet may not be able to generate a BLS Multi-Signature with sufficient participating stake. Regulated entities that are prohibited from validating permissionless, smart contract-enabled blockchains (like the C-Chain) can’t launch a Subnet because they can’t opt-out of Primary Network Validation. This deployment blocker prevents a large cohort of Real World Asset (RWA) issuers from bringing unique, valuable tokens to the Avalanche Ecosystem (that could move between C-Chain <-> Subnets using AWM/Teleporter). A widely validated Subnet that is not properly metered could destabilize the Primary Network if usage spikes unexpectedly. Underprovisioned Primary Network Validators running such a Subnet may exit with an OOM exception, see degraded disk performance, or find it difficult to allocate CPU time to P/X/C-Chain validation. The inverse also holds for Subnets with the Primary Network (where some undefined behavior could bring a Subnet offline). Although the fee paid to the Primary Network to operate a Subnet does not go up with the amount of activity on the Subnet, the fixed, upfront cost of setting up a Subnet Validator on the Primary Network deters new projects that prefer smaller, even variable, costs until demand is observed. _Unlike L2s that pay some increasing fee (usually denominated in units per transaction byte) to an external chain for data availability and security as activity scales, Subnets provide their own security/data availability and the only cost operators must pay from processing more activity is the hardware cost of supporting additional load._ Elastic Subnets allow any community to weight Subnet Validation based on some staking token and reward Subnet Validators with high uptime with said staking token. However, there is no way for $AVAX holders on the Primary Network to augment the security of such Subnets. ## Specification ### Required Changes 1) Introduce a new type of staker, Subnet-Only Validators (SOVs), that can validate an Avalanche Subnet and participate in Avalanche Warp Messaging (AWM) without syncing or becoming a Validator on the Primary Network 2) Introduce a refundable fee (called a "lock") of 500 $AVAX that nodes must pay to become an SOV 3) Introduce a non-refundable fee of 0.1 $AVAX that SOVs must pay to become an SOV 4) Introduce a new transaction type on the P-Chain to register as an SOV (i.e. `AddSubnetOnlyValidatorTx`) 5) Add a mode to ANCs that allows SOVs to optionally disable full Primary Network verification (only need to verify P-Chain) 6) ANCs track IPs for SOVs to ensure Subnet Validators can find peers whether or not they are Primary Network Validators 7) Provide a guaranteed rate limiting allowance for SOVs like Primary Network Validators Because SOVs do not validate the Primary Network, they will not be rewarded with $AVAX for "locking" the 500 $AVAX required to become an SOV. This enables people interested in validating Subnets to opt for a lower upfront $AVAX commitment and lower infrastructure costs instead of $AVAX rewards. Additionally, SOVs will only be required to sync the P-chain (not X/C-Chain) to track any validator set changes in their Subnet and to support Cross-Subnet communication via AWM (see “Primary Network Partial Sync” mode introduced in [Cortina 8](https://github.com/ava-labs/avalanchego/releases/tag/v1.10.8)). The lower resource requirement in this "minimal mode" will provide Subnets with greater flexibility of validation hardware requirements as operators are not required to reserve any resources for C-Chain/X-Chain operation. If an SOV wishes to sync the entire Primary Network, they still can. ### Future Work The previously described specification is a minimal, additive change to Subnet Validation semantics that prepares the Avalanche Network for a more flexible Subnet model. It alone, however, fails to communicate this flexibility nor provides an alternative use of $AVAX that would have otherwise been used to create Subnet Validators. Below are two high-level ideas (Pay-As-You-Go Subnet Validation Registration Fees and $AVAX-Augmented Security) that highlight how this initial change could be extended in the future. If the Avalanche Community is interested in their adoption, they should each be proposed as a unique ACP where they can be properly specified. **These ideas are only suggestions for how the Avalanche Network could be modified in the future if this ACP is adopted. Supporting this ACP does not require supporting these ideas or committing to their rollout.** #### Pay-As-You-Go Subnet Validation Registration Fees _Transition Subnet Validator registration to a dynamically priced, continuously charged fee (that doesn't require locking large amounts of $AVAX upfront)._ While it would be possible to just transition to a lower required "lock" amount, many think that it would be more competitive to transition to a dynamically priced, continuous payment mechanism to register as a Subnet Validator. This new mechanism would target some $Y nAVAX fee that would be paid by each Subnet Validator per Subnet per second (pulling from a "Subnet Validator's Account") instead of requiring a large upfront lockup of $AVAX. The rate of nAVAX/second should be set by the demand for validating Subnets on Avalanche compared to some usage target per Subnet and across all Subnets. This rate should be locked for each Subnet Validation period to ensure operators are not subject to surprise costs if demand rises significantly over time. The optimization work outlined in [BLS Multi-Signature Voting](https://hackmd.io/@patrickogrady/100k-subnets#How-will-BLS-Multi-Signature-uptime-voting-work) should allow the min rate to be set as low as ~512-4096 nAVAX/second (or 1.3-10.6 $AVAX/month). Fees paid to the Avalanche Network for PAYG could be burned, like all other P-Chain, X-Chain, and C-Chain transactions, or they could be partially rewarded to Primary Network Validators as a "boost" over the existing staking rewards. The nice byproduct of the latter approach is that it better aligns Primary Network Validators with the growth of Subnets. #### $AVAX-Augmented Subnet Security _Allow pledging unstaked $AVAX to Subnet Validators on Elastic Subnets that can be slashed if said Subnet Validator commits an attributable fault (i.e. proposes/signs conflicting blocks/AWM payloads). Reward locked $AVAX associated with Subnet Validators that were not slashed with Elastic Subnet staking rewards._ Currently, the only way to secure an Elastic Subnet is to stake its custom staking token (defined in the `TransformSubnetTx`). Many have requested the option to use $AVAX for this token, however, this could easily allow an adversary to take over small Elastic Subnets (where the amount of $AVAX staked may be much less than the circulating supply). $AVAX-Augmented Subnet Security would allow anyone holding $AVAX to lock it to specific Subnet Validators and earn Elastic Subnet reward tokens for supporting honest participants. Recall, all stake management on the Avalanche Network (even for Subnets) occurs on the P-Chain. Thus, staked tokens ($AVAX and/or custom staking tokens used in Elastic Subnets) and stake weights (used for AWM verification) are secured by the full $AVAX stake of the Primary Network. $AVAX-Augmented Subnet Security, like staking, would be implemented on the P-Chain and enjoy the full security of the Primary Network. This approach means locking $AVAX occurs on the Primary Network (no need to transfer $AVAX to a Subnet, which may not be secured by meaningful value yet) and proofs of malicious behavior are processed on the Primary Network (a colluding Subnet could otherwise choose not to process a proof that would lead to their "lockers" being slashed). _This native approach is comparable to the idea of using $ETH to secure DA on [EigenLayer](https://www.eigenlayer.xyz/) (without reusing stake) or $BTC to secure Cosmos Zones on [Babylon](https://babylonchain.io/) (but not using an external ecosystem)._ ## Backwards Compatibility * Existing Subnet Validation semantics for Primary Network Validators are not modified by this ACP. This means that All existing Subnet Validators can continue validating both the Primary Network and whatever Subnets they are validating. This change would just provide a new option for Subnet Validators that allows them to sacrifice their staking rewards for a smaller upfront $AVAX commitment and lower infrastructure costs. * Support for this ACP would require adding a new transaction type to the P-Chain (i.e. `AddSubnetOnlyValidatorTx`). This new transaction is an execution-breaking change that would require a mandatory Avalanche Network upgrade to activate. ## Reference Implementation A full implementation will be provided once this ACP is considered `Implementable`. However, some initial ideas are presented below. ### `AddSubnetOnlyValidatorTx` ```text type AddSubnetOnlyValidatorTx struct { // Metadata, inputs and outputs BaseTx `serialize:"true"` // Describes the validator // The NodeID included in [Validator] must be the Ed25519 public key. Validator `serialize:"true" json:"validator"` // ID of the subnet this validator is validating Subnet ids.ID `serialize:"true" json:"subnetID"` // [Signer] is the BLS key for this validator. // Note: We do not enforce that the BLS key is unique across all validators. // This means that validators can share a key if they so choose. // However, a NodeID does uniquely map to a BLS key Signer signer.Signer `serialize:"true" json:"signer"` // Where to send locked tokens when done validating LockOuts []*avax.TransferableOutput `serialize:"true" json:"lock"` // Where to send validation rewards when done validating ValidatorRewardsOwner fx.Owner `serialize:"true" json:"validationRewardsOwner"` // Where to send delegation rewards when done validating DelegatorRewardsOwner fx.Owner `serialize:"true" json:"delegationRewardsOwner"` // Fee this validator charges delegators as a percentage, times 10,000 // For example, if this validator has DelegationShares=300,000 then they // take 30% of rewards from delegators DelegationShares uint32 `serialize:"true" json:"shares"` } ``` _`AddSubnetOnlyValidatorTx` is almost the same as [`AddPermissionlessValidatorTx`](https://github.com/ava-labs/avalanchego/blob/638000c42e5361e656ffbc27024026f6d8f67810/vms/platformvm/txs/add_permissionless_validator_tx.go#L33-L58), the only exception being that `StakeOuts` are now `LockOuts`._ ### `GetSubnetPeers` To support tracking SOV IPs, a new message should be added to the P2P specification that allows Subnet Validators to request the IP of all peers a node knows about on a Subnet (these Signed IPs won't be gossiped like they are for Primary Network Validators because they don't need to be known by the entire Avalanche Network): ```text message GetSubnetPeers { bytes subnet_id = 1; } ``` _It would be a nice addition if a bloom filter could also be provided here so that an ANC only sends IPs of peers that the original sender does not know._ ANCs should respond to this incoming message with a [`PeerList` message](https://github.com/ava-labs/avalanchego/blob/638000c42e5361e656ffbc27024026f6d8f67810/proto/p2p/p2p.proto#L135-L148). ## Security Considerations * Any Subnet Validator running in "Partial Sync Mode" will not be able to verify Atomic Imports on the P-Chain and will rely entirely on Primary Network consensus to only accept valid P-Chain blocks. * High-throughput Subnets will be better isolated from the Primary Network and should improve its resilience (i.e. surges of traffic on some Subnet cannot destabilize a Primary Network Validator). * Avalanche Network Clients (ANCs) must track IPs and provide allocated bandwidth for SOVs even though they are not Primary Network Validators. ## Open Questions * To help orient the Avalanche Community around this wide-ranging and likely to be long-running conversation around the relationship between the Primary Network and Subnets, should we come up with a project name to describe the effort? I've been casually referring to all of these things as the _Astra Upgrade Track_ but definitely up for discussion (may be more confusing than it is worth to do this). ## Appendix A draft of this ACP was posted on in the ["Ideas" Discussion Board](https://github.com/avalanche-foundation/ACPs/discussions/10#discussioncomment-7373486), as suggested by the [ACP README](https://github.com/avalanche-foundation/ACPs#step-1-post-your-idea-to-github-discussions). Feedback on this draft was collected and addressed on both the "Ideas" Discussion Board and on [HackMD](https://hackmd.io/@patrickogrady/100k-subnets#Feedback-to-Draft-Proposal). ## Acknowledgements Thanks to @luigidemeo1, @stephenbuttolph, @aaronbuchwald, @dhrubabasu, and @abi87 for their feedback on these ideas. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-131: Cancun Eips (/docs/acps/131-cancun-eips) --- title: "ACP-131: Cancun Eips" description: "Details for Avalanche Community Proposal 131: Cancun Eips" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/131-cancun-eips/README.md --- | ACP | 131 | | :--- | :--- | | **Title** | Activate Cancun EIPs on C-Chain and Subnet-EVM chains | | **Author(s)** | Darioush Jalali ([@darioush](https://github.com/darioush)), Ceyhun Onur ([@ceyonur](https://github.com/ceyonur)) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/139)) | | **Track** | Standards, Subnet | ## Abstract Enable new EVM opcodes and opcode changes in accordance with the following EIPs on the Avalanche C-Chain and Subnet-EVM chains: - [EIP-4844: BLOBHASH opcode](https://eips.ethereum.org/EIPS/eip-4844) - [EIP-7516: BLOBBASEFEE opcode](https://eips.ethereum.org/EIPS/eip-7516) - [EIP-1153: Transient storage](https://eips.ethereum.org/EIPS/eip-1153) - [EIP-5656: MCOPY opcode](https://eips.ethereum.org/EIPS/eip-5656) - [EIP-6780: SELFDESTRUCT only in same transaction](https://eips.ethereum.org/EIPS/eip-6780) Note blob transactions from EIP-4844 are excluded and blocks containing them will still be considered invalid. ## Motivation The listed EIPs were activated on Ethereum mainnet as part of the [Cancun upgrade](https://github.com/ethereum/execution-specs/blob/master/network-upgrades/mainnet-upgrades/cancun.md#included-eips). This proposal is to activate them on the Avalanche C-Chain in the next network upgrade, to maintain compatibility with upstream EVM tooling, infrastructure, and developer experience (e.g., Solidity compiler defaults >= [0.8.25](https://github.com/ethereum/solidity/releases/tag/v0.8.25)). Additionally, it recommends the activation of the same EIPs on Subnet-EVM chains. ## Specification & Reference Implementation The opcodes (EVM exceution modifications) and block header modifications should be adopted as specified in the EIPs themselves. Other changes such as enabling new transaction types or mempool modifications are not in scope (specifically blob transactions from EIP-4844 are excluded and blocks containing them are considered invalid). ANCs (Avalanche Network Clients) can adopt the implementation as specified in the [coreth](https://github.com/ava-labs/coreth) repository, which was adopted from the [go-ethereum v1.13.8](https://github.com/ethereum/go-ethereum/releases/tag/v1.13.8) release in this [PR](https://github.com/ava-labs/coreth/pull/550). In particular, note the following code: - [Activation of new opcodes](https://github.com/ava-labs/coreth/blob/7b875dc21772c1bb9e9de5bc2b31e88c53055e26/core/vm/jump_table.go#L93) - Activation of Cancun in next Avalanche upgrade: - [C-Chain](https://github.com/ava-labs/coreth/pull/610) - [Subnet-EVM chains](https://github.com/ava-labs/subnet-evm/blob/fa909031ed148484c5072d949c5ed73d915ce1ed/params/config_extra.go#L186) - `ParentBeaconRoot` is enforced to be included and the zero value [here](https://github.com/ava-labs/coreth/blob/7b875dc21772c1bb9e9de5bc2b31e88c53055e26/plugin/evm/block_verification.go#L287-L288). This field is retained for future use and compatibility with upstream tooling. - Forbids blob transactions by enforcing `BlobGasUsed` to be 0 [here](https://github.com/ava-labs/coreth/pull/611/files#diff-532a2c6a5365d863807de5b435d8d6475552904679fd611b1b4b10d3bf4f5010R267). _Note:_ Subnets are sovereign in regards to their validator set and state transition rules, and can choose to opt out of this proposal by making a code change in their respective Subnet-EVM client. ## Backwards Compatibility The original EIP authors highlighted the following considerations. For full details, refer to the original EIPs: - [EIP-4844](https://eips.ethereum.org/EIPS/eip-4844#backwards-compatibility): Blob transactions are not proposed to be enabled on Avalanche, so concerns related to mempool or transaction data availability are not applicable. - [EIP-6780](https://eips.ethereum.org/EIPS/eip-6780#backwards-compatibility) "Contracts that depended on re-deploying contracts at the same address using CREATE2 (after a SELFDESTRUCT) will no longer function properly if the created contract does not call SELFDESTRUCT within the same transaction." Adoption of this ACP modifies consensus rules for the C-Chain, therefore it requires a network upgrade. It is recommended that Subnet-EVM chains also adopt this ACP and follow the same upgrade time as Avalanche's next network upgrade. ## Security Considerations Refer to the original EIPs for security considerations: - [EIP 1153](https://eips.ethereum.org/EIPS/eip-1153#security-considerations) - [EIP 4788](https://eips.ethereum.org/EIPS/eip-4788#security-considerations) - [EIP 4844](https://eips.ethereum.org/EIPS/eip-4844#security-considerations) - [EIP 5656](https://eips.ethereum.org/EIPS/eip-5656#security-considerations) - [EIP 6780](https://eips.ethereum.org/EIPS/eip-6780#security-considerations) - [EIP 7516](https://eips.ethereum.org/EIPS/eip-7516#security-considerations) ## Open Questions No open questions. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-151: Use Current Block Pchain Height As Context (/docs/acps/151-use-current-block-pchain-height-as-context) --- title: "ACP-151: Use Current Block Pchain Height As Context" description: "Details for Avalanche Community Proposal 151: Use Current Block Pchain Height As Context" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/151-use-current-block-pchain-height-as-context/README.md --- | ACP | 151 | | :------------ | :----------------------------------------------------------------------------------------- | | **Title** | Use current block P-Chain height as context for state verification | | **Author(s)** | Ian Suvak ([@iansuvak](https://github.com/iansuvak)) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/152)) | | **Track** | Standards | ## Abstract Proposes that the ProposerVM passes inner VMs the P-Chain block height of the current block being built rather than the P-Chain block height of the parent block. Inner VMs use this P-Chain height for verifying aggregated signatures of Avalanche Interchain Messages (ICM). This will allow for a more reliable way to determine which validators should participate in signing the message, and remove unnecessary waiting periods. ## Motivation Currently the ProposerVM passes the P-Chain height of the parent block to inner VMs, which use the value to verify ICM messages in the current block. Using the parent block's P-Chain height is necessary for verifying the proposer and reaching consensus on the current block, but it is not necessary for verifying ICM messages within the block. Using the P-Chain height of the current block being built would make operations using ICM messages to modify the validator set, such as ones specified in [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md) be verifiable sooner and more reliably. Currently at least two new P-Chain blocks need to be produced after the relevant state change for it to be reflected for purposes of ICM aggregate signature verification. ## Specification The [block context](https://github.com/ava-labs/avalanchego/blob/d2e9d12ed2a1b6581b8fd414cbfb89a6cfa64551/snow/engine/snowman/block/block_context_vm.go#L14) contains a `PChainHeight` field that is passed from the ProposerVM to the inner VMs building the block. It is later used by the inner VMs to fetch the canonical validator set for verification of ICM aggregated signatures. The `PChainHeight` currently passed in by the ProposerVM is the P-Chain height of the parent block. The proposed change is to instead have the ProposerVM pass in the P-Chain height of the current block. ## Backwards Compatibility This change requires an upgrade to make sure that all validators verifying the validity of the ICM messages use the same P-Chain height and therefore the same validator set. Prior to activation nodes should continue to use P-Chain height of the parent block. ## Reference Implementation An implementation of this ACP for avalanchego can be found [here](https://github.com/ava-labs/avalanchego/pull/3459) ## Security Considerations ProposerVM needs to use the parent block's P-Chain height to verify proposers for security reasons but we don't have such restrictions for verifying ICM message validity in the current block being built. Therefore, this should be a safe change. ## Acknowledgments Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@michaelkaplan13](https://github.com/michaelkaplan13) for discussion and feedback on this ACP. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-176: Dynamic Evm Gas Limit And Price Discovery Updates (/docs/acps/176-dynamic-evm-gas-limit-and-price-discovery-updates) --- title: "ACP-176: Dynamic Evm Gas Limit And Price Discovery Updates" description: "Details for Avalanche Community Proposal 176: Dynamic Evm Gas Limit And Price Discovery Updates" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/176-dynamic-evm-gas-limit-and-price-discovery-updates/README.md --- | ACP | 176 | | :- | :- | | **Title** | Dynamic EVM Gas Limits and Price Discovery Updates | | **Author(s)** | Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/178)) | | **Track** | Standards | ## Abstract Proposes that the C-Chain and Subnet-EVM chains adopt a dynamic fee mechanism similar to the one [introduced on the P-Chain as part of ACP-103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md), with modifications to allow for block proposers (i.e. validators) to dynamically adjust the target gas consumption per unit time. ## Motivation Currently, the C-Chain has a static gas target of [15,000,000 gas](https://github.com/ava-labs/coreth/blob/39ec874505b42a44e452b8809a2cc6d09098e84e/params/avalanche_params.go#L32) per [10 second rolling window](https://github.com/ava-labs/coreth/blob/39ec874505b42a44e452b8809a2cc6d09098e84e/params/avalanche_params.go#L36), and uses a modified version of the [EIP-1559](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-1559.md) dynamic fee mechanism to adjust the base fee of blocks based on the gas consumed in the previous 10 second window. This has two notable drawbacks: 1. The windower mechanism used to determine the base fee of blocks can lead to outsized spikes in the gas price when there is a large block. This is because after a large block that uses all of its gas limit, blocks that follow in the same window continue to result in increased gas prices even if they are relatively small blocks that are under the target gas consumption. 2. The static gas target necessitates a required network upgrade in order to modify. This is cumbersome and makes it difficult for the network to adjust its capacity in response to performance optimizations or hardware requirement increases. To better position Avalanche EVM chains, including the C-Chain, to be able to handle future increases in load, we propose replacing the above mechanism with one that better handles blocks that consume a large amount of gas, and that allows for validators to dynamically adjust the target rate of consumption. ## Specification ### Gas Price Determination The mechanism to determine the base fee of a block is the same as the one used in [ACP-103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md) to determine the gas price of a block on the P-Chain. This mechanism calculates the gas price for a given block $b$ based on the following parameters:
| | | |---|---| | $T$ | the target gas consumed per second | | $M$ | minimum gas price | | $K$ | gas price update constant | | $C$ | maximum gas capacity | | $R$ | gas capacity added per second |
### Making $T$ Dynamic As noted above, the gas price determination mechanism relies on a target gas consumption per second, $T$, in order to calculate the gas price for a given block. $T$ will be adjusted dynamically according to the following specification. Let $q$ be a non-negative integer that is initialized to 0 upon activation of this mechanism. Let the target gas consumption per second be expressed as: $$T = P \cdot e^{\frac{q}{D}}$$ where $P$ is the global minimum allowed target gas consumption rate for the network, and $D$ is a constant that helps control the rate of change of the target gas consumption. After the execution of transactions in block $b$, the value of $q$ can be increased or decreased up to $Q$. It must be the case that $\left|\Delta q\right| \leq Q$, or block $b$ is considered invalid. The amount by which $q$ changes after executing block $b$ is specified by the block builder. Block builders (i.e. validators), may set their desired value for $T$ (i.e. their desired gas consumption rate) in their configuration, and their desired value for $q$ can then be calculated as: $$q_{desired} = D \cdot ln\left(\frac{T_{desired}}{P}\right)$$ Note that since $q_{desired}$ is only used locally and can be different for each node, it is safe for implementations to approximate the value of $ln\left(\frac{T_{desired}}{P}\right)$, and round the resulting value to the nearest integer. When building a block, builders can calculate their next preferred value for $q$ based on the network's current value (`q_current`) according to: ```python # Calculates a node's new desired value for q given for a given block def calc_next_q(q_current: int, q_desired: int, max_change: int) -> int: if q_desired > q_current: return q_current + min(q_desired - q_current, max_change) else: return q_current - min(q_current - q_desired, max_change) ``` As $q$ is updated after the execution of transactions within the block, $T$ is also updated such that $T = P \cdot e^{\frac{q}{D}}$ at all times. As the value of $T$ adjusts, the value of $R$ (capacity added per second) is also updated such that: $$R = 2 \cdot T$$ This ensures that the gas price can increase and decrease at the same rate. The value of $C$ must also adjust proportionately, so we set: $$C = 10 \cdot T$$ This means that the maximum stored gas capacity would be reached after 5 seconds where no blocks have been accepted. In order to keep roughly constant the time it takes for the gas price to double at sustained maximum network capacity usage, the value of $K$ used in the gas price determination mechanism must be updated proportionally to $T$ such that: $$K = 87 \cdot T$$ In order to have the gas price not be directly impacted by the change in $K$, we also update $x$ (excess gas consumption) proportionally. When updating $x$ after executing a block, instead of setting $x = x + G$ as specified in ACP-103, we set: $$x_{n+1} = (x + G) \cdot \frac{K_{n+1}}{K_{n}}$$ Note that the value of $q$ (and thus also $T$, $R$, $C$, $K$, and $x$) are updated **after** the execution of block $b$, which means they only take effect in determining the gas price of block $b+1$. The change to each of these values in block $b$ does not effect the gas price for transactions included in block $b$ itself. Allowing block builders to adjust the target gas consumption rate in blocks that they produce makes it such that the effective target gas consumption rate should converge over time to the point where 50% of the voting stake weight wants it increased and 50% of the voting stake weight wants it decreased. This is because the number of blocks each validator produces is proportional to their stake weight. As noted in ACP-103, the maximum gas consumed in a given period of time $\Delta{t}$, is $r + R \cdot \Delta{t}$, where $r$ is the remaining gas capacity at the end of previous block execution. The upper bound across all $\Delta{t}$ is $C + R \cdot \Delta{t}$. Phrased differently, the maximum amount of gas that can be consumed by any given block $b$ is: $$gasLimit_{b} = min(r + R \cdot \Delta{t}, C)$$ ### Configuration Parameters As noted above, the gas price determination mechanism depends on the values of $T$, $M$, $K$, $C$, and $R$ to be set as parameters. $T$ is adjusted dynamically from its initial value based on $D$ and $P$, and the values of $R$ and $C$ are derived from $T$. Parameters at activation on the C-Chain are:
| Parameter | Description | C-Chain Configuration| | - | - | - | | $P$ | minimum target gas consumption per second | $1,000,000$ | | $D$ | target gas consumption rate update constant | $2^{25}$ | | $Q$ | target gas consumption rate update factor change limit | $2^{15}$ | | $M$ | minimum gas price | $1*10^{-18}$ AVAX | | $K$ | initial gas price update factor | $87,000,000$ |
$P$ was chosen as a safe bound on the minimum target gas usage on the C-Chain. The current gas target of the C-Chain is $1,500,000$ per second. The target gas consumption rate will only stay at $P$ if the majority of stake weight of the network specifies $P$ as their desired gas consumption rate target. $D$ and $Q$ were chosen to give each block builder the ability to adjust the value of $T$ by roughly $\frac{1}{1024}$ of its current value, which matches the [gas limit bound divisor that Ethereum currently uses](https://github.com/ethereum/go-ethereum/blob/52766bedb9316cd6cddacbb282809e3bdfba143e/params/protocol_params.go#L26) to limit the amount that validators can change the execution layer gas limit in a single block. $D$ and $Q$ were scaled up by a factor of $2^{15}$ to provide block builders more granularity in the adjustments to $T$ that they can make. $M$ was chosen as the minimum possible denomination of the native EVM asset, such that the gas price will be more likely to consistently be in a range of price discovery. The price discovery mechanism has already been battle tested on the P-Chain (and prior to that on Ethereum for blob gas prices as defined by EIP-4844), giving confidence that it will correctly react to any increase in network usage in order to prevent a DOS attack. $K$ was chosen such that at sustained maximum capacity ($T*2$ gas/second), the fee rate will double every ~60.3 seconds. For comparison, EIP-1559 can double about ~70 seconds, and the C-Chain's current implementation can double about every ~50 seconds, depending on the time between blocks. The maximum instantaneous price multiplier is: $$e^\frac{C}{K} = e^\frac{10 \cdot T}{87 \cdot T} = e^\frac{10}{87} \simeq 1.12$$ ### Choosing $T_{desired}$ As mentioned above, this new mechanism allows for validators to specify their desired target gas consumption rate ($T_{desired}$) in their configuration, and the value that they set impacts the effective target gas consumption rate of the network over time. The higher the value of $T$, the more resources (storage, compute, etc) that are able to be used by the network. When choosing what value makes sense for them, validators should consider the resources that are required to properly support that level of gas consumption, the utility the network provides by having higher transaction per second throughput, and the stability of network should it reach that level of utilization. While Avalanche Network Clients can set default configuration values for the desired target gas consumption rate, each validator can choose to set this value independently based on their own considerations. ## Backwards Compatibility The changes proposed in this ACP require a required network upgrade in order to take effect. Prior to its activation, the current gas limit and price discovery mechanisms will continue to be used. Its activation should have relatively minor compatibility effects on any developer tooling. Notably, transaction formats, and thus wallets, are not impacted. After its activation, given that the value of $C$ is dynamically adjusted, the maximum possible gas consumed by an individual block, and thus maximum possible consumed by an individual transaction, will also dynamically adjust. The upper bound on the amount of gas consumed by a single transaction fluctuating means that transactions that are considered invalid at one time may be considered valid at a different point in time, and vice versa. While potentially unintuitive, as long as the minimum gas consumption rate is set sufficiently high this should not have significant practical impact, and is also currently the case on the Ethereum mainnet. > [!NOTE] > After the activation of this ACP, concerns were raised around the latency of inclusion for large transactions when the fee is increasing. To address these concerns, block producers SHOULD only produce blocks when there is sufficient capacity to include large transactions. Prior to this ACP, the maximum size of a transaction was $15$ million gas. Therefore, the recommended heuristic is to only produce blocks when there is at least $\min(8 \cdot T, 15 \text{ million})$ capacity. _At the time of writing, this ensures transactions with up to 12.8 million gas will be able to bid for block space._ ## Reference Implementation This ACP was implemented and merged into Coreth behind the `Fortuna` upgrade flag. The full implementation can be found in [coreth@v0.14.1-acp-176.1](https://github.com/ava-labs/coreth/releases/tag/v0.14.1-acp-176.1). ## Security Considerations This ACP changes the mechanism for determining the gas price on Avalanche EVM chains. The gas price is meant to adapt dynamically to respond to changes in demand for using the chain. If it does not react as expected, the chain could be at risk for a DOS attack (if the usage price is too low), or over charge users during period of low activity. This price discovery mechanism has already been employed on the P-Chain, but should again be thoroughly tested for use on the C-Chain prior to activation on the Avalanche Mainnet. Further, this ACP also introduces a mechanism for validators to change the gas limit of the C-Chain. If this limit is set too high, it is possible that validator nodes will not be able to keep up in the processing of blocks. An upper bound on the maximum possible gas limit could be considered to try to mitigate this risk, though it would then take further required network upgrades to scale the network past that limit. ## Acknowledgments Thanks to the following non-exhaustive list of individuals for input, discussion, and feedback on this ACP. - [Emin Gün Sirer](https://x.com/el33th4xor) - [Luigi D'Onorio DeMeo](https://x.com/luigidemeo) - [Darioush Jalali](https://github.com/darioush) - [Aaron Buchwald](https://github.com/aaronbuchwald) - [Geoff Stuart](https://github.com/geoff-vball) - [Meag FitzGerald](https://github.com/meaghanfitzgerald) - [Austin Larson](https://github.com/alarso16) ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-181: P Chain Epoched Views (/docs/acps/181-p-chain-epoched-views) --- title: "ACP-181: P Chain Epoched Views" description: "Details for Avalanche Community Proposal 181: P Chain Epoched Views" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/181-p-chain-epoched-views/README.md --- | ACP | 181 | | :------------ | :----------------------------------------------------------------------------------------- | | **Title** | P-Chain Epoched Views | | **Author(s)** | Cam Schultz [@cam-schultz](https://github.com/cam-schultz) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/211)) | | **Track** | Standards | ## Abstract Proposes a standard P-Chain epoching scheme such that any VM that implements it uses a P-Chain block height known prior to the generation of its next block. This would enable VMs to optimize validator set retrievals, which currently must be done during block execution. This standard does *not* introduce epochs to the P-Chain's VM directly. Instead, it provides a standard that may be implemented by layers that inject P-Chain state into VMs, such as the ProposerVM. ## Motivation The P-Chain maintains a registry of L1 and Subnet validators (including Primary Network validators). Validators are added, removed, or their weights changed by issuing P-Chain transactions that are included in P-Chain blocks. When describing an L1 or Subnet's validator set, what is really being described are the weights, BLS keys, and Node IDs of the active validators at a particular P-Chain height. Use cases that require on-demand views of L1 or Subnet validator sets need to fetch validator sets at arbitrary P-Chain heights, while use cases that require up-to-date views need to fetch them as often as every P-Chain block. Epochs during which the P-Chain height is fixed would widen this window to a predictable epoch duration, allowing these use cases to implement optimizations such as pre-fetching validator sets once per epoch, or allowing more efficient backwards traversal of the P-Chain to fetch historical validator sets. ## Specification ### Assumptions In the following specification, we assume that a block $b_m$ has timestamp $t_m$ and P-Chain height $p_m$. ### Epoch Definition An epoch is defined as a contiguous range of blocks that share the same three values: - An Epoch Number - An Epoch P-Chain Height - An Epoch Start Time Let $E_N$ denote an epoch with epoch number $N$. $E_N$'s start time is denoted as $T_{start}^N$, and its P-Chain height as $P_N$. Let block $b_a$ be the block that activates this ACP. The first epoch ($E_0$) has $T_{start}^0 = t_{a-1}$, and $P_0 = p_{a-1}$. In other words, the first epoch start time is the timestamp of the last block prior to the activation of this ACP, and similarly, the first epoch P-Chain height is the P-Chain height of last block prior to the activation of this ACP. ### Epoch Sealing An epoch $E_N$ is *sealed* by the first block with a timestamp greater than or equal to $T_{start}^N + D$, where $D$ is a constant defined in the network upgrade that activates this ACP. Let $B_{S_N}$ denote the block that sealed $E_N$. The sealing block is defined to be a member of the epoch it seals. This guarantees that every epoch will contain at least one block. ### Advancing an Epoch We advance from the current epoch $E_N$ to the next epoch $E_{N+1}$ when the next block after $B_{S_N}$ is produced. This block will be a member of $E_{N+1}$, and will have the values: - $P_{N+1}$ equal to the P-Chain height of $B_{S_N}$ - $T_{start}^{N+1}$ equal to $B_{S_N}$'s timestamp - The epoch number, $N+1$ increments the previous epoch's epoch number by exactly $1$ ## Properties ### Epoch Duration Bounds Since an epoch's start time is set to the [timestamp of the sealing block of the previous epoch](#advancing-an-epoch), all epochs are guaranteed to have a duration of at least $D$, as measured from the epoch's starting time to the timestamp of the epoch's sealing block. However, since a sealing block is [defined](#epoch-sealing) to be a member of the epoch it seals, there is no upper bound on an epoch's duration, since that sealing block may be produced at any point in the future beyond $T_{start}^N + D$. ### Fixing the P-Chain Height When building a block, Avalanche blockchains use the P-Chain height [embedded in the block](#assumptions) to determine the validator set. If instead the epoch P-Chain height is used, then we can ensure that when a block is built, the validator set to be used for the next block is known. To see this, suppose block $b_m$ seals epoch $E_N$. Then the next block, $b_{m+1}$ will begin a new epoch, $E_{N+1}$ with $P_{N+1}$ equal to $b_m$'s P-Chain height, $p_m$. If instead $b_m$ does not seal $E_N$, then $b_{m+1}$ will continue to use $P_{N}$. Both candidates for $b_{m+1}$'s P-Chain height ($p_m$ and $P_N$) are known at $b_m$ build time. ## Use Cases ### ICM Verification Optimization For a validator to verify an ICM message, the signing L1/Subnet's validator set must be retrieved during block verification by traversing backward from the current P-Chain height to the P-Chain height provided by the ProposerVM. The traversal depth is highly variable, so to account for the worst case, VM implementations charge a large amount of gas to perform this verification. With epochs, validator set retrieval occurs at fixed P-Chain heights that increment at regular intervals, which provides opportunities to optimize this retrieval. For instance, validator retrieval may be done asynchronously from block verification as soon as an epoch has been sealed. Further, validator sets at a given height can be more effectively cached or otherwise kept in memory, because the same height will be used verify all ICM messages for the remainder of an epoch. Each of these VM optimizations allow for the potential of ICM verification costs to be safely reduced by a significant amount within VM implementations. ### Improved Relayer Reliability Current ICM VM implementations verify ICM messages against the local P-Chain state, as determined by the P-Chain height set by the ProposerVM. Off-chain relayers perform the following steps to deliver ICM messages: 1. Fetch the sending chain's validator set at the verifying chain's current proposed height 1. Collect BLS signatures from that validator set to construct the signed ICM message 1. Submit the transaction containing the signed message to the verifying chain If the validator set changes between steps 1 and 3, the ICM message will fail verification. Epochs improve upon this by fixing the P-Chain height used to verify ICM messages for a duration of time that is predictable to off-chain relayers. A relayer should be able to derive the epoch boundaries based on the specification above, or they could retrieve that information via a node API. Relayers could use that information to decide the validator set to query, knowing that it will be stable for the duration of the epoch. Further, VMs could relax the verification rules to allow ICM messages to be verified against the previous epoch as a fallback, eliminating edge cases around the epoch boundary. ## EVM ICM Verification Gas Cost Updates Since the activation of [ACP-30](https://github.com/avalanche-foundation/ACPs/tree/60cbfc32e7ee2cffed33d8daee980d7a85dded48/ACPs/30-avalanche-warp-x-evm#gas-costs), the cost to verify ICM messages in the Avalanche EVM implementations (i.e. `coreth` and `subnet-evm`) using the `WarpPrecompile` have been based on the worst-case verification flow, including the relatively expensive lookup of the source chain's validator set at an aribtrary P-Chain height used by each new block. This ACP allows for optimizing this verification, as described above. Prior to this ACP, the gas costs of relevant `WarpPrecompile` functions were: ``` const ( GetVerifiedWarpMessageBaseCost = 2 GetBlockchainIDGasCost = 2 GasCostPerWarpSigner = 500 GasCostPerWarpMessageChunk = 3_200 GasCostPerSignatureVerification = 200_000 ) ``` With optimizations implemented, based on the results of [new benchmarks](https://github.com/ava-labs/coreth/pull/1331) of the `WarpPrecompile` and roughly targeting processing 150 million gas per second, Avalanche EVM chains with this ACP activated use the following gas costs for the `WarpPrecompile`. ``` const ( GetVerifiedWarpMessageBaseCost = 750 GetBlockchainIDGasCost = 200 GasCostPerWarpSigner = 250 GasCostPerWarpMessageChunk = 512 GasCostPerSignatureVerification = 125_000 ) ``` While the performance of `GetVerifiedWarpMessageBaseCost`, `GetBlockchainIDGasCost`, and `GasCostPerWarpMessageChunk` are not directly impacted by this ACP, updated benchmark numbers show the new gas costs to be better aligned with relative time that the operations take to perform. ## Backwards Compatibility This change requires a network upgrade and is therefore not backwards compatible. Any downstream entities that depend on a VM's view of the P-Chain will also need to account for epoched P-Chain views. For instance, ICM messages are signed by an L1's validator set at a specific P-Chain height. Currently, the constructor of the signed message can in practice use the validator set at the P-Chain tip, since all deployed Avalanche VMs are at most behind the P-Chain by a fixed number of blocks. With epoching, however, the ICM message constructor must take into account the epoch P-Chain height of the verifying chain, which may be arbitrarily far behind the P-Chain tip. ## Reference Implementation The following pseudocode illustrates how an epoch may be calculated for a block: ```go // Epoch Duration const D time.Duration type Epoch struct { PChainHeight uint64 Number uint64 StartTime time.Time } type Block interface { Timestamp() time.Time PChainHeight() uint64 Epoch() Epoch } func GetPChainEpoch(parent Block) Epoch { parentTimestamp := parent.Timestamp() parentEpoch := parent.Epoch() epochEndTime := parentEpoch.StartTime.Add(D) if parentTimestamp.Before(epochEndTime) { // If the parent was issued before the end of its epoch, then it did not // seal the epoch. return parentEpoch } // The parent sealed the epoch, so the child is the first block of the new // epoch. return Epoch{ PChainHeight: parent.PChainHeight(), Number: parentEpoch.Number + 1, StartTime: parentTimestamp, } } ``` - If the parent sealed its epoch, the current block [advances the epoch](#advancing-an-epoch), refreshing the epoch height, incrementing the epoch number, and setting the epoch starting time. - Otherwise, the current block uses the current epoch height, number, and starting time, regardless of whether it seals the epoch. A full reference implementation of this ACP for avalanchego can be found [here](https://github.com/ava-labs/avalanchego/pull/4238). ### Setting the Epoch Duration The epoch duration $D$ is set on a network-wide level. For both Fuji (network ID 5) and Mainnet (network ID 1), $D$ will be set to 5 minutes upon activation of this ACP. Any changes to $D$ in the future would require another network upgrade. #### Changing the Epoch Duration Future network upgrades may change the value of $D$ to some new duration $D'$. $D'$ should not take effect until the end of the current epoch, rather than the activation time of the network upgrade that defines $D'$. This ensures an in progress epoch at the upgrade activation time cannot have a realized duration less than both $D$ and $D'$. ## Security Considerations ### Epoch P-Chain Height Skew Because epochs may have [unbounded duration](#epoch-duration-bounds), it is possible for a block's `PChainEpochHeight` to be arbitrarily far behind the tip of the P-Chain. This does not affect the *validity* of ICM verification within a VM that implements P-Chain epoched views, since the validator set at `PChainEpochHeight` is always known. However, the following considerations should be made under this scenario: 1. As validators exit the validator set, their physical nodes may be unavailable to serve BLS signature requests, making it more difficult to construct a valid ICM message 1. A valid ICM message may represent an attestation by a stale validator set. Signatures from validators that have exited the validator set between `PChainEpochHeight` and the current P-Chain tip will not represent active stake. Both of these scenarios may be mitigated by having shorter epoch lengths, which limit the delay in time between when the P-Chain is updated and when those updates are taken into account for ICM verification on a given L1, and by ensuring consistent block production, so that epochs always advance soon after $D$ time has passed. ### Excessive Validator Churn If an epoched view of the P-Chain is used by the consensus engine, then validator set changes over an epoch's duration will be concentrated into a single block at the epoch's boundary. Excessive validator churn can cause consensus failures and other dangerous behavior, so it is imperative that the amount of validator weight change at the epoch boundary is limited. One strategy to accomplish this is to queue validator set changes and spread them out over multiple epochs. Another strategy is to batch updates to the same validator together such that increases and decreases to that validator's weight cancel each other out. Given the primary use case of ICM verification improvements, which occur at the VM level, mechanisms to mitigate against this are omitted from this ACP. ## Open Questions - What should the epoch duration $D$ be set to? - Is it safe for `PChainEpochHeight` and `PChainHeight` to differ significantly within a block, due to [unbounded epoch duration](#epoch-duration-bounds)? ## Acknowledgements Thanks to [@iansuvak](https://github.com/iansuvak), [@geoff-vball](https://github.com/geoff-vball), [@yacovm](https://github.com/yacovm), [@michaelkaplan13](https://github.com/michaelkaplan13), [@StephenButtolph](https://github.com/StephenButtolph), and [@aaronbuchwald](https://github.com/aaronbuchwald) for discussion and feedback on this ACP. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-191: Seamless L1 Creation (/docs/acps/191-seamless-l1-creation) --- title: "ACP-191: Seamless L1 Creation" description: "Details for Avalanche Community Proposal 191: Seamless L1 Creation" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/191-seamless-l1-creation/README.md --- | ACP | 191 | | :- | :- | | **Title** | Seamless L1 Creations (CreateL1Tx) | | **Author(s)** | Martin Eckardt ([@martineckardt](https://github.com/martineckardt)), Aaron Buchwald ([@aaronbuchwald](https://github.com/aaronbuchwald)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)), Meaghan FitzGerald ([@meaghanfitzgerald](https://github.com/meaghanfitzgerald)) | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/197))| | **Track** | Standards | ## Abstract This ACP introduces a new P-Chain transaction type called `CreateL1Tx` that simplifies the creation of Avalanche L1s. It consolidates three existing transaction types (`CreateSubnetTx`, `CreateChainTx`, and `ConvertSubnetToL1Tx`) into a single atomic operation. This streamlines the L1 creation process, removes the need for the intermediary Subnet creation step, and eliminates the management of temporary `SubnetAuth` credentials. ## Motivation [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md) introduced Avalanche L1s, providing greater sovereignty and flexibility compared to Subnets. However, creating an L1 currently requires a three-step process: 1. `CreateSubnetTx`: Create the Subnet record on the P-Chain and specify the `SubnetAuth` 2. `CreateChainTx`: Add a blockchain to the Subnet (can be called multiple times) 3. `ConvertSubnetToL1Tx`: Convert the Subnet to an L1, specifying the initial validator set and the validator manager location This process has several drawbacks: * It requires orchestrating three separate transactions that could be handled in one. * The `SubnetAuth` must be managed during creation but becomes irrelevant after conversion. * The multi-step process increases complexity and potential for errors. * It introduces unnecessary state transitions and storage overhead on the P-Chain. By introducing a single `CreateL1Tx` transaction, we can simplify the process, reduce overhead, and improve the developer experience for creating L1s. ## Specification ### New Transaction Type The following new transaction type is introduced: ```go // ChainConfig represents the configuration for a chain to be created type ChainConfig struct { // A human readable name for the chain; need not be unique ChainName string `serialize:"true" json:"chainName"` // ID of the VM running on the chain VMID ids.ID `serialize:"true" json:"vmID"` // IDs of the feature extensions running on the chain FxIDs []ids.ID `serialize:"true" json:"fxIDs"` // Byte representation of genesis state of the chain GenesisData []byte `serialize:"true" json:"genesisData"` } // CreateL1Tx is an unsigned transaction to create a new L1 with one or more chains type CreateL1Tx struct { // Metadata, inputs and outputs BaseTx `serialize:"true"` // Chain configurations for the L1 (can be multiple) Chains []ChainConfig `serialize:"true" json:"chains"` // Chain where the L1 validator manager lives ManagerChainID ids.ID `serialize:"true" json:"managerChainID"` // Address of the L1 validator manager ManagerAddress types.JSONByteSlice `serialize:"true" json:"managerAddress"` // Initial pay-as-you-go validators for the L1 Validators []*L1Validator `serialize:"true" json:"validators"` } ``` The `L1Validator` structure follows the same definition as in [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md#convertsubnettol1tx). ### Transaction Processing When a `CreateL1Tx` transaction is processed, the P-Chain performs the following operations atomically: 1. Create a new L1. 2. Create chain records for each chain configuration in the `Chains` array. 3. Set up the L1 validator manager with the specified `ManagerChainID` and `ManagerAddress`. 4. Register the initial validators specified in the `Validators` array. ### IDs * `subnetID`: The `subnetID` of the L1 is the transaction hash. * `blockchainID`: the `blockchainID` for each blockchain is is defined as the SHA256 hash of the 37 bytes resulting from concatenating the 32 byte `subnetID` with the `0x00` byte and the 4 byte `chainIndex` (index in the `Chains` array within the transaction) * `validationID`: The `validationID` for the initial validators added through `CreateL1Tx` is defined as the SHA256 hash of the 36 bytes resulting from concatenating the 32 byte `subnetID` with the 4 byte `validatorIndex` (index in the `Validators` array within the transaction). Note: Even with this updated definition of the `blockchainID`s for chains created using this new flow, the `validationID`s of the L1s initial set of validators is still compatible with the existing reference validator manager contracts as defined [here](https://github.com/ava-labs/icm-contracts/blob/4a897ba913958def3f09504338a1b9cd48fe5b2d/contracts/validator-manager/ValidatorManager.sol#L247). ### Restrictions and Validation The `CreateL1Tx` transaction has the following restrictions and validation criteria: 1. The `Chains` array must contain at least one chain configuration 2. The `ManagerChainID` must be a valid blockchain ID, but cannot be the P-Chain blockchain ID 3. Validator nodes must have unique NodeIDs within the transaction 4. Each validator must have a non-zero weight and a non-zero balance 5. The transaction inputs must provide sufficient AVAX to cover the transaction fee and all validator balances ### Warp Message After the transaction is accepted, the P-Chain must be willing to sign a `SubnetToL1ConversionMessage` with a `conversionID` corresponding to the new L1, similar to what would happen after a `ConvertSubnetToL1Tx`. This ensures compatibility with existing systems that expect this message, such as the validator manager contracts. ## Backwards Compatibility This ACP introduces a new transaction type and does not modify the behavior of existing transaction types. Existing Subnets and L1s created through the three-step process will continue to function as before. This change is purely additive and does not require any changes to existing L1s or Subnets. The existing transactions `CreateSubnetTx`, `CreateChainTx` and `ConvertSubnetToL1Tx` remain unchanged for now, but may be removed in a future ACP to ensure systems have sufficient time to update to the new process. ## Reference Implementation A reference implementation must be provided in order for this ACP to be considered implementable. ## Security Considerations The `CreateL1Tx` transaction follows the same security model as the existing three-step process. By making the L1 creation atomic, it reduces the risk of partial state transitions that could occur if one of the transactions in the three-step process fails. The same continuous fee mechanism introduced in ACP-77 applies to L1s created through this new transaction type, ensuring proper metering of validator resources. The transaction verification process must ensure that all validator properties are properly validated, including unique NodeIDs, valid BLS signatures, and sufficient balances. ## Rationale and Alternatives The primary alternative is to maintain the status quo \- requiring three separate transactions to create an L1. However, this approach has clear disadvantages in terms of complexity, transaction overhead, and user experience. Another alternative would be to modify the existing `ConvertSubnetToL1Tx` to allow specifying chain configurations directly. However, this would complicate the conversion process for existing Subnets and would not fully address the desire to eliminate the Subnet intermediary step for new L1 creation. The chosen approach of introducing a new transaction type provides a clean solution that addresses all identified issues while maintaining backward compatibility. ## Acknowledgements The idea for this PR was originally formulated by Aaron Buchwald in our discussion about the creation of L1s. Special thanks to the authors of ACP-77 for their groundbreaking work on Avalanche L1s, and to the projects that have shared their experiences and challenges with the current validator manager framework. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-194: Streaming Asynchronous Execution (/docs/acps/194-streaming-asynchronous-execution) --- title: "ACP-194: Streaming Asynchronous Execution" description: "Details for Avalanche Community Proposal 194: Streaming Asynchronous Execution" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/194-streaming-asynchronous-execution/README.md --- | ACP | 194 | | :--- | :--- | | **Title** | Streaming Asynchronous Execution | | **Author(s)** | Arran Schlosberg ([@ARR4N](https://github.com/ARR4N)), Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)) | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/196)) | | **Track** | Standards | ## Abstract Streaming Asynchronous Execution (SAE) decouples consensus and execution by introducing a queue upon which consensus is performed. A concurrent execution stream is responsible for clearing the queue and reporting a delayed state root for recording by later rounds of consensus. Validation of transactions to be pushed to the queue is lightweight but guarantees eventual execution. ## Motivation ### Performance improvements 1. Concurrent consensus and execution streams eliminate node context switching, reducing latency caused by each waiting on the other. In particular, "VM time" (akin to CPU time) more closely aligns with wall time since it is no longer eroded by consensus. This increases gas per wall-second even without an increase in gas per VM-second. 2. Lean, execution-only clients can rapidly execute the queue agreed upon by consensus, providing accelerated receipt issuance and state computation. Without the need to compute state _roots_, such clients can eschew expensive Merkle data structures. End users see expedited but identical transaction results. 3. Irregular stop-the-world events like database compaction are amortised over multiple blocks. 4. Introduces additional bursty throughput by eagerly accepting transactions, without a reduction in security guarantees. 5. Third-party accounting of non-data-dependent transactions, such as EOA-to-EOA transfers of value, can be performed prior to execution. ### Future features Performing transaction execution after consensus sequencing allows the usage of consensus artifacts in execution. This unblocks some additional future improvements: 1. Exposing a real-time VRF during transaction execution. 2. Using an encrypted mempool to reduce front-running. This ACP does not introduce these, but some form of asynchronous execution is required to correctly implement them. ### User stories 1. A sophisticated DeFi trader runs a highly optimised execution client, locally clearing the transaction queue well in advance of the network—setting the stage for HFT DeFi. 2. A custodial platform filters the queue for only those transactions sent to one of their EOAs, immediately crediting user balances. ## Description In all execution models, a block is _proposed_ and then verified by validators before being _accepted_. To assess a block's validity in _synchronous_ execution, its transactions are first _executed_ and only then _accepted_ by consensus. This immediately and implicitly _settles_ all of the block's transactions by including their execution results at the time of _acceptance_. E[Executed] --> A[Accepted/Settled]`} /> Under SAE, a block is considered valid if all of its transactions can be paid for when eventually _executed_, after which the block is _accepted_ by consensus. The act of _acceptance_ enqueues the block to be _executed_ asynchronously. In the future, some as-yet-unknown later block will reference the execution results and _settle_ all transactions from the _executed_ block. A[Accepted] A -->|variable delay| E[Executed] E -->|τ seconds| S[Settled] A -. guarantees .-> S`} /> ### Block lifecycle #### Proposing blocks The validator selection mechanism for block production is unchanged. However, block builders are no longer expected to execute transactions during block building. The block builder is expected to include transactions by building upon the most recently settled state and to apply worst-case bounds on the execution of the ancestor blocks prior to the most recently settled block. The worst-case bounds enforce minimum balances of sender accounts and the maximum required base fee. The worst-case bounds are described [below](#block-validity-and-building). Prior to adding a proposed block to consensus, all validators MUST verify that the block builder correctly enforced the worst-case bounds while building the block. This guarantees that the block can be executed successfully if it is accepted. > [!NOTE] > The worst-case bounds guarantee does not provide assurance about whether or not a transaction will revert nor whether its computation will run out of gas by reaching the specified limit. The verification only ensures the transaction is capable of paying for the accrued fees. #### Accepting blocks Once a block is marked as accepted by consensus, the block is put in a FIFO execution queue. #### Executing blocks Each client runs a block executor in parallel, which constantly executes the blocks from the FIFO queue. In addition to executing the blocks, the executor provides deterministic timestamps for the beginning and end of each block's execution. Time is measured two ways by the block executor: 1. The timestamp included in the block header. 2. The amount of gas charged during the execution of blocks. > [!NOTE] > Execution timestamps are more granular than block header timestamps to allow sub-second block execution times. As soon as there is a block available in the execution queue, the block executor starts processing the block. If the executor's current timestamp is prior to the current block's timestamp, the executor's timestamp is advanced to match the block's. Advancing the timestamp in this scenario results in unused gas capacity, reducing the gas _excess_ from which the price is determined. The block is then executed on top of the last executed (not settled) state. After executing the block, the executor advances its timestamp based on the gas usage of the block, also increasing the gas _excess_ for the pricing algorithm. The block's execution time is now timestamped and the block is available to be settled. #### Settling blocks Already-executed blocks are settled once a following block that includes the results of the executed block is accepted. The results are included by setting the state root to that of the last executed block and the receipt root to that of a MPT of all receipts since last settlement, possibly from more than one block. The following block's timestamp is used to determine which blocks to settle—blocks are settled if said timestamp is greater than or equal to the execution time of the executed block plus a constant delay. The additional delay amortises any sporadic slowdowns the block executor may have encountered. ## Specification ### Background ACP-103 introduced the following variables for calculating the gas price:
| | | |---|---| | $T$ | the target gas consumed per second | | $M$ | minimum gas price | | $K$ | gas price update constant | | $R$ | gas capacity added per second |
ACP-176 provided a mechanism to make $T$ dynamic and set: $$ \begin{align} R &= 2 \cdot T \\ K &= 87 \cdot T \end{align} $$ The _excess_ actual consumption $x \ge 0$ beyond the target $T$ is tracked via numerical integration and used to calculate the gas price as: $$M \cdot \exp\left(\frac{x}{K}\right)$$ ### Gas charged We introduce $g_L$, $g_U$, and $g_C$ as the gas _limit_, _used_, and _charged_ per transaction, respectively. We define $$ g_C := \max\left(g_U, \frac{g_L}{\lambda}\right) $$ where $\lambda$ enforces a lower bound on the gas charged based on the gas limit. > [!NOTE] > $\dfrac{g_L}{\lambda}$ is rounded up by actually calculating $\dfrac{g_L + \lambda - 1}{\lambda}$ In all previous instances where execution referenced gas used, from now on, we will reference gas charged. For example, the gas excess $x$ will be modified by $g_C$ rather than $g_U$. ### Block size The constant time delay between block execution and settlement is defined as $\tau$ seconds. The maximum allowed size of a block is defined as: $$ \omega_B ~:= R \cdot \tau \cdot \lambda $$ Any block whose total sum of gas limits for transactions exceed $\omega_B$ MUST be considered invalid. ### Queue size The maximum allowed size of the execution queue _prior_ to adding a new block is defined as: $$ \omega_Q ~:= 2 \cdot \omega_B $$ Any block that attempts to be enqueued while the current size of the queue is larger than $\omega_Q$ MUST be considered invalid. > [!NOTE] > By restricting the size of the queue _prior_ to enqueueing the new block, $\omega_B$ is guaranteed to be the only limitation on block size. ### Block executor During the activation of SAE, the block executor's timestamp $t_e$ is initialised to the timestamp of the last accepted block. Prior to executing a block with timestamp $t_b$, the executor's timestamp and excess is updated: $$ \begin{align} \Delta{t} &~:= \max\left(0, t_b - t_e\right) \\ t_e &~:= t_e + \Delta{t} \\ x &~:= \max\left(x - T \cdot \Delta{t}, 0\right) \\ \end{align} $$ The block is then executed with the gas price calculated from the current value of $x$. After executing a block that charged $g_C$ gas in total, the executor's timestamp and excess is updated: $$ \begin{align} \Delta{t} &~:= \frac{g_C}{R} \\ t_e &~:= t_e + \Delta{t} \\ x &~:= x + \Delta{t} \cdot (R - T) \\ \end{align} $$ > [!NOTE] > The update rule here assumes that $t_e$ is a timestamp that tracks the passage of time both by gas and by wall-clock time. $\frac{g_C}{R}$ MUST NOT be simply rounded. Rather, the gas accumulation MUST be left as a fraction. $t_e$ is now this block's execution timestamp. ### Handling gas target changes When a block is produced that modifies $T$, both the consensus thread and the execution thread will update to the modified $T$ after their own handling of the block. For example, restrictions of the queue size MUST be calculated based on the parent block's $T$. Similarly, the time spent executing a block MUST be calculated based on the parent block's $T$. ### Block settlement For a _proposed_ block that includes timestamp $t_b$, all ancestors whose execution timestamp $t_e$ is $t_e \leq t_b - \tau$ are considered settled. Note that $t_e$ is not an integer as it tracks fractional seconds with gas consumption, which is not the case for $t_b$. The _proposed_ block MUST include the `stateRoot` produced by the execution of the most recently settled block. For any _newly_ settled blocks, the _proposed_ block MUST include all execution artifacts: - `receiptsRoot` - `logsBloom` - `gasUsed` The receipts root MUST be computed as defined in [EIP-2718](https://eips.ethereum.org/EIPS/eip-2718) except that the tree MUST be built from the concatenation of receipts from all blocks being settled. > [!NOTE] > If the block executor has fallen behind, the node may not be able to determine precisely which ancestors should be considered settled. If this occurs, validators MUST allow the block executor to catch up prior to deciding the block's validity. ### Block validity and building After determining which blocks to settle, all remaining ancestors of the new block must be inspected to determine the worst-case bounds on $x$ and account balances. Account nonces are able to be known immediately. The worst-case bound on $x$ can be calculated by following the block executor update rules using $g_L$ rather than $g_C$. The worst-case bound on account balances can be calculated by charging the worst-case gas cost to the sender of a transaction along with deducting the value of the transaction from the sender's account balance. The `baseFeePerGas` field MUST be populated with the gas price based on the worst-case bound on $x$ at the start of block execution. ### Configuration Parameters As noted above, SAE depends on the values of $\tau$ and $\lambda$ to be set as parameters and the values of $\omega_B$ and $\omega_Q$ are derived from $T$. Parameters to specify for the C-Chain are:
| Parameter | Description | C-Chain Configuration| | - | - | - | | $\tau$ | duration between execution and settlement | $5s$ | | $\lambda$ | minimum conversion from gas limit to gas charged | $2$ |
## Backwards Compatibility This ACP modifies the meaning of multiple fields in the block. A comprehensive list of changes will be produced once a reference implementation is available. Likely fields to change include: - `stateRoot` - `receiptsRoot` - `logsBloom` - `gasUsed` - `extraData` ## Reference Implementation A reference implementation is still a work-in-progress. This ACP will be updated to include a reference implementation once one is available. ## Security Considerations ### Worst-case transaction validity To avoid a DoS vulnerability on execution, we require an upper bound on transaction gas cost (i.e. amount $\times$ price) beyond the regular requirements for transaction validity (e.g. nonce, signature, etc.). We therefore introduced "worst-case cost" validity. We can prove that if every transaction were to use its full gas limit this would result in the greatest possible: 1. Consumption of gas units (by definition of the gas limit); and 2. Gas excess $x$ (and therefore gas price) at the time of execution. For a queue of blocks $Q = \\{i\\}_ {i \ge 0}$ the gas excess $x_j$ immediately prior to execution of block $j \in Q$ is a monotonic, non-decreasing function of the gas usage of all preceding blocks in the queue; i.e. $x_j~:=~f(\\{g_i\\}_{i 0$. Hence any decrease of $x$ is $\ge$ predicted. The excess, and hence gas price, for every later block $x_{i>k}$ is therefore reduced: $$ \downarrow g_k \implies \begin{cases} \downarrow \Delta^+x \propto g_k \\ \uparrow \Delta^-x \propto R-g_k \end{cases} \implies \downarrow \Delta x_k \implies \downarrow M \cdot \exp\left(\frac{x_{i>k}}{K}\right) $$ Given maximal gas consumption under (1), the monotonicity of $f$ implies (2). Since we are working with non-negative integers, it follows that multiplying a transaction's gas limit by the hypothetical gas price of (2) results in its worst-case gas cost. Any sender able to pay for this upper bound (in addition to value transfers) is guaranteed to be able to pay for the actual execution cost. Transaction _acceptance_ under worst-case cost validity is therefore a guarantee of _settlement_. ### Queue DoS protection Worst-case cost validity only protects against DoS at the point of execution but leaves the queue vulnerable to high-limit, low-usage transactions. For example, a malicious user could send a transfer-only transaction (21k gas) with a limit set to consume the block's full gas limit. Although they would have to have sufficient funds to theoretically pay for all the reserved gas, they would never actually be charged this amount. Pushing a sufficient number of such transactions to the queue would artificially inflate the worst-case cost of other users. Therefore, the gas charged was modified from being equal to the gas usage to the above $g_C := \max\left(g_U, \frac{g_L}{\lambda}\right)$ The gas limit is typically set higher than the predicted gas consumption to allow for a buffer should the prediction be imprecise. This precludes setting $\lambda := 1$. Conversely, setting $\lambda := \infty$ would allow users to attack the queue with high-limit, low-consumption transactions. Setting $\lambda ~:= 2$ allows for a 100% buffer on gas-usage estimates without penalising the sender, while still disincentivising falsely high limits. #### Upper bound on queue DoS Recall $R$ (gas capacity per second) for rate and $g_C$ (gas charged) as already defined. The actual gas excess $x_A$ has an upper bound of the worst-case excess $x_W$, both of which can be used to calculate respective base fees $f_A$ and $f_W$ (the variable element of gas prices) from the existing exponential function: $$ f := M \cdot \exp\left( \frac{x}{K} \right). $$ Mallory is attempting to maximize the DoS ratio $$ D := \frac{f_W}{f_A} $$ by maximizing $\Sigma_{\forall i} (g_L - g_U)_i$ to maximize $x_W - x_A$. > [!TIP] > Although $D$ shadows a variable in ACP-176, that one is very different to anything here so there won't be confusion. Recall that the increasing excess occurs such that $$ x := x + g \cdot \frac{(R - T)}{R} $$ Since the largest allowed size of the queue when enqueuing a new block is $\omega_Q$, we can derive an upper bound on the difference in the changes to worst-case and actual gas excess caused by the transactions in the queue before the new block is added: $$ \begin{align} \Delta x_A &\ge \frac{\omega_Q}{\lambda} \cdot \frac{(R - T)}{R} \\ \Delta x_W &= \omega_Q \cdot \frac{(R - T)}{R} \\ \Delta x_W - \Delta x_A &\le \omega_Q \cdot \frac{(R - T)}{R} - \frac{\omega_Q}{\lambda} \cdot \frac{(R - T)}{R} \\ &= \omega_Q \cdot \frac{(R - T)}{R} \cdot \left(1-\frac{1}{\lambda}\right) \\ &= \omega_Q \cdot \frac{(2 \cdot T - T)}{2 \cdot T} \cdot \left(1-\frac{1}{\lambda}\right) \\ &= \omega_Q \cdot \frac{T}{2 \cdot T} \cdot \left(1-\frac{1}{\lambda}\right) \\ &= \frac{\omega_Q}{2} \cdot \left(1-\frac{1}{\lambda}\right) \\ &= \frac{2 \cdot \omega_B}{2} \cdot \left(1-\frac{1}{\lambda}\right) \\ &= \omega_B \cdot \left(1-\frac{1}{\lambda}\right) \\ &= R \cdot \tau \cdot \lambda \cdot \left(1-\frac{1}{\lambda}\right) \\ &= R \cdot \tau \cdot (\lambda-1) \\ &= 2 \cdot T \cdot \tau \cdot (\lambda-1) \end{align} $$ Note that we can express Mallory's DoS quotient as: $$ \begin{align} D &= \frac{f_W}{f_A} \\ &= \frac{ M \cdot \exp \left( \frac{x_W}{K} \right)}{ M \cdot \exp \left( \frac{x_A}{K} \right)} \\ & = \exp \left( \frac{x_W - x_A}{K} \right). \end{align} $$ When the queue is empty (i.e. the execution stream has caught up with accepted transactions), the worst-case fee estimate $f_W$ is known to be the actual base fee $f_A$; i.e. $Q = \emptyset \implies D=1$. The previous bound on $\Delta x_W - \Delta x_A$ also bounds Mallory's ability such that: $$ \begin{align} D &\le \exp \left( \frac{2 \cdot T \cdot \tau \cdot (\lambda-1)}{K} \right)\\ &= \exp \left( \frac{2 \cdot T \cdot \tau \cdot (\lambda-1)}{87 \cdot T} \right)\\ &= \exp \left( \frac{2 \cdot \tau \cdot (\lambda-1)}{87} \right)\\ \end{align} $$ Therefore, for the values suggested by this ACP: $$ \begin{align} D &\le \exp \left( \frac{2 \cdot 5 \cdot (2 - 1)}{87} \right)\\ &= \exp \left( \frac{10}{87} \right)\\ &\simeq 1.12\\ \end{align} $$ In summary, Mallory can require users to increase their gas price by at most ~12%. In practice, the gas price often fluctuates more than 12% on a regular basis. Therefore, this does not appear to be a significant attack vector. However, any deviation that dislodges the gas price bidding mechanism from a true bidding mechanism is of note. ## Appendix ### JSON RPC methods Although asynchronous execution decouples the transactions and receipts recorded by a specific block, APIs MUST NOT alter their behavior to mirror this. In particular, the API method `eth_getBlockReceipts` MUST return the receipts corresponding to the block's transactions, not the receipts settled in the block. #### Named blocks The Ethereum Mainnet APIs allow for retrieving blocks by named parameters that the API server resolves based on their consensus mechanism. Other than the _earliest_ (genesis) named block, which MUST be interpreted in the same manner, all other named blocks are mapped to SAE in terms of the _execution_ status of blocks and MUST be interpreted as follows: * _pending_: the most recently _accepted_ block; * _latest_: the block that was most recently _executed_; * _safe_ and _finalized_: the block that was most recently _settled_. > [!NOTE] > The finality guarantees of Snowman consensus remove any distinction between _safe_ and _finalized_. > Furthermore, the _latest_ block is not at risk of re-org, only of a negligible risk of data corruption local to the API node. ### Observations around transaction prioritisation As EOA-to-EOA transfers of value are entirely guaranteed upon _acceptance_, block builders MAY choose to prioritise other transactions for earlier execution. A reliable marker of such transactions is a gas limit of 21,000 as this is an indication from the sender that they do not intend to execute bytecode. However, this could delay the ability to issue transactions that depend on these EOA-to-EOA transfers. Block builders are free to make their own decisions around which transactions to include. ## Acknowledgments Thank you to the following non-exhaustive list of individuals for input, discussion, and feedback on this ACP. * [Aaron Buchwald](https://github.com/aaronbuchwald) * [Angharad Thomas](https://x.com/divergenceharri) * [Martin Eckardt](https://github.com/martineckardt) * [Meaghan FitzGerald](https://github.com/meaghanfitzgerald) * [Michael Kaplan](https://github.com/michaelkaplan13) * [Yacov Manevich](https://github.com/yacovm) ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-20: Ed25519 P2p (/docs/acps/20-ed25519-p2p) --- title: "ACP-20: Ed25519 P2p" description: "Details for Avalanche Community Proposal 20: Ed25519 P2p" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/20-ed25519-p2p/README.md --- | ACP | 20 | | :--- | :--- | | **Title** | Ed25519 p2p | | **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/21))| | **Track** | Standards | ## Abstract Support Ed25519 TLS certificates for p2p communications on the Avalanche network. Permit usage of Ed25519 public keys for Avalanche Network Client (ANC) NodeIDs. Support Ed25519 signatures in the ProposerVM. ## Motivation Avalanche Network Clients (ANCs) rely on TLS handshakes to facilitate p2p communications. AvalancheGo (and by extension, the Avalanche Network) only supports TLS certificates that use RSA or ECDSA as the signing algorithm and explicitly prohibits any other signing algorithms. If a TLS certificate is not present, AvalancheGo will generate and persist to disk a 4096 bit RSA private key on start-up. This key is subsequently used to generate the TLS certificate which is also persisted to disk. Finally, the TLS certificate is hashed to generate a 20 byte NodeID. Authenticated p2p messaging was required when the network started and it was sufficient to simply use a hash of the TLS certificate. With the introduction of Snowman++, validators were then required to produce shareable message signatures. The Snowman++ block headers (specified [here](https://github.com/ava-labs/avalanchego/blob/v1.10.15/vms/proposervm/README.md#snowman-block-extension)) were then required to include the full TLS `Certificate` along with the `Signature`. However, TLS certificates support Ed25519 as their signing algorithm. Ed25519 are IETF recommendations ([RFC8032](https://datatracker.ietf.org/doc/html/rfc8032)) with some very nice properties, a large one being their size: - 32 byte public key - 64 byte private key - 64 byte signature Because of the small size of the public key, it can be used for the NodeID directly with a marginal hit to size (an additional 12 bytes). Additionally, the brittle reliance on static TLS certificates can be removed. Using the Ed25519 private key, a TLS certificate can be generated in-memory on node startup and used for p2p communications. This reduces the maintenance burden on node operators as they will only need to backup the Ed25519 private key instead of the TLS certificate and the RSA private key. Ed25519 has wide adoption, including in the crypto industry. A non-exhaustive list of things that use Ed25519 can be found [here](https://ianix.com/pub/ed25519-deployment.html). More information about the Ed25519 protocol itself can be found [here](https://ed25519.cr.yp.to). ## Specification ### Required Changes 1. Support registration of 32-byte NodeIDs on the P-chain 2. Generate an Ed25519 key by default (`staker.key`) on node startup 3. Use the Ed25519 key to generate a TLS certificate on node startup 4. Add support for Ed25519 keys + signatures to the proposervm 5. Remove the TLS certificate embedding in proposervm blocks when an Ed25519 NodeID is the proposer 6. Add support for Ed25519 in `PeerList` messages Changes to the p2p layer will be minimal as TLS handshakes are used to do p2p communication. Ed25519 will need to be added as a supported algorithm. The P-chain will also need to be modified to support registration of 32-byte NodeIDs. During serialization, the length of the NodeID is not serialized and was assumed to always be 20 bytes. Implementers of this ACP must take care to continue parsing old transactions correctly. This ACP could be implemented by adding a new tx type that requires Ed25519 NodeIDs only. If the implementer chooses to do this, a separate follow-up ACP must be submitted detailing the format of that transaction. ### Future Work In the future, usage of non-Ed25519 TLS certificates should be prohibited to remove any dependency on them. This will further secure the Avalanche network by reducing complexity. The path to doing so is not outlined in this ACP. ## Backwards Compatibility An implementation of this proposal should not introduce any backwards compatibility issues. NodeIDs that are 20 bytes should continue to be treated as hashes of TLS certificates. NodeIDs of 32 bytes (size of Ed25519 public key) should be supported following implementation of this proposal. ## Reference Implementation TLS certificate generation using an Ed25519 private key is standard. The golang standard library has a reference [implementation](https://github.com/golang/go/blob/go1.20.10/src/crypto/tls/generate_cert.go). Parsing TLS certificates and extracting the public key is also standard. AvalancheGo already contains [code](https://github.com/ava-labs/avalanchego/blob/638000c42e5361e656ffbc27024026f6d8f67810/staking/verify.go#L55-L65) to verify the public key from a TLS certificate. ## Security Considerations ### Validation Criteria Although Ed25519 is standardized in [RFC8032](https://datatracker.ietf.org/doc/html/rfc8032), it does not define strict validation criteria. This has led to inconsistencies in the validation criteria across implementations of the signature scheme. This is unacceptable for any protocol that requires participants to reach consensus on signature validity. Henry de Valance highlights the complexity of this issue [here](https://hdevalence.ca/blog/2020-10-04-its-25519am). From [Chalkias et al. 2020](https://eprint.iacr.org/2020/1244.pdf): * The RFC 8032 and the NIST FIPS186-5 draft both require to reject non-canonically encoded points, but not all of the implementations follow those guidelines. * The RFC 8032 allows optionality between using a permissive verification equation and a more strict verification equation. Different implementations use different equations meaning validation results can vary even across implementations that follow RFC 8032. Zcash adopted [ZIP-215](https://zips.z.cash/zip-0215) (proposed by Henry de Valance) to explicitly define the Ed25519 validation criteria. Implementers of this ACP _*must*_ use the ZIP-215 validation criteria. The [`ed25519consensus`](https://github.com/hdevalence/ed25519consensus) golang library is a minimal fork of golang's `crypto/ed25519` package with support for ZIP-215 verification. It is maintained by [Filippo Valsorda](https://github.com/FiloSottile) who also maintains many golang stdlib cryptography packages. It is strongly recommended to use this library for golang implementations. ## Open Questions _Can this Ed25519 key be used in alternative communication protocols?_ Yes. Ed25519 can be used for alternative communication protocols like [QUIC](https://datatracker.ietf.org/group/quic/about) or [NOISE](http://www.noiseprotocol.org/noise.html). This ACP removes the reliance on TLS certificates and associates a Ed25519 public key with NodeIDs. This allows for experimentation with different communication protocols that may be better suited for a high throughput blockchain like Avalanche. _Can this Ed25519 key be used for Verifiable Random Functions?_ Yes. VRFs, as specified in [RFC9381](https://datatracker.ietf.org/doc/html/rfc9381), can be constructed using elliptic curves that are secure in the cryptographic random oracle model. Ed25519 test vectors are provided in the RFC for implementers of an Elliptic Curve VRF (ECVRF). This allows for Avalanche validators to generate a VRF per block using their associated Ed25519 keys, including for Subnets. ## Acknowledgements Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@patrick-ogrady](https://github.com/patrick-ogrady) for their feedback on these ideas. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-204: Precompile Secp256r1 (/docs/acps/204-precompile-secp256r1) --- title: "ACP-204: Precompile Secp256r1" description: "Details for Avalanche Community Proposal 204: Precompile Secp256r1" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/204-precompile-secp256r1/README.md --- # ACP-204: Precompile for secp256r1 Curve Support | ACP | 204 | | :--- | :--- | | **Title** | Precompile for secp256r1 Curve Support | | **Author(s)** | [Santiago Cammi](https://github.com/scammi), [Arran Schlosberg](https://github.com/ARR4N) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/212)) | | **Track** | Standards | ## Abstract This proposal introduces a precompiled contract that performs signature verifications for the secp256r1 elliptic curve on Avalanche's C-Chain. The precompile will be implemented at address `0x0000000000000000000000000000000000000100` and will enable native verification of P-256 signatures, significantly improving gas efficiency for biometric authentication systems, WebAuthn, and modern device-based signing mechanisms. ## Motivation The secp256r1 (P-256) elliptic curve is the standard cryptographic curve used by modern device security systems, including Apple's Secure Enclave, Android Keystore, WebAuthn, and Passkeys. However, Avalanche currently only supports secp256k1 natively, forcing developers to use expensive Solidity-based verification that costs [200k-330k gas per signature verification](https://hackmd.io/@1ofB8klpQky-YoR5pmPXFQ/SJ0nuzD1T#Smart-Contract-Based-Verifiers). This ACP proposes implementing EIP-7951's secp256r1 precompiled contract to unlock significant ecosystem benefits: ### Enterprise & Institutional Adoption - Reduced onboarding friction: Enterprises can leverage existing biometric authentication infrastructure instead of managing seed phrases or hardware wallets - Regulatory compliance: Institutions can utilize their approved device security standards and identity management systems - Cost optimization: ~50x gas reduction (from 200k-330k to 6,900 gas) makes enterprise-scale applications economically viable The 100x gas cost reduction makes these use cases economically viable while maintaining the security properties institutions and users expect from their existing devices. Adding the precompiled contract at the same address as used in [RIP-7212](https://github.com/ethereum/RIPs/blob/master/RIPS/rip-7212.md) provides consistency across ecosystems, and allows for any libraries that have been developed to interact with the precompile to be used unmodified across ecosystems. ## Specification This ACP implements [EIP-7951](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-7951.md) for secp256r1 signature verification on Avalanche. The specification follows EIP-7951 exactly, with the precompiled contract deployed at address `0x0000000000000000000000000000000000000100`. ### Core Functionality - Input: 160 bytes (message hash + signature components r,s + public key coordinates x,y) - Output: success: 32 bytes `0x...01`; failure: no data returned - Gas Cost: 6,900 gas (based on EIP-7951 benchmarking) - Validation: Full compliance with NIST FIPS 186-3 specification ### Activation This precompile may be activated as part of Avalanche's next network upgrade. Individual Avalanche L1s and subnets could adopt this enhancement independently through their respective client software updates. For complete technical specifications, validation requirements, and implementation details, refer to [EIP-7951](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-7951.md). ## Backwards Compatibility This ACP introduces a new precompiled contract and does not modify existing functionality. No backwards compatibility issues are expected since: 1. The precompile uses a previously unused address 2. No existing opcodes or consensus rules are modified 3. The change is additive and opt-in for applications Adoption requires a coordinated network upgrade for the C-Chain. Other EVM L1s can adopt this enhancement independently by upgrading their client software. ## Security Considerations ### Cryptographic Security - The secp256r1 curve is standardized by NIST and widely vetted - Security properties are comparable to secp256k1 (used by ECRECOVER) - Implementation follows NIST FIPS 186-3 specification exactly ### Implementation Security - Signature verification (vs public-key recovery) approach maximizes compatibility with existing P-256 ecosystem - No malleability check included to match NIST specification, but wrapper libraries may choose to add this - Input validation prevents invalid curve points and out-of-range signature components ### Network Security - Gas cost prevents potential DoS attacks through expensive computation - No consensus-level security implications beyond standard precompile considerations ## Reference Implementation The implementation builds upon existing work: 1. EIP-7951 Reference: The [Go-Ethereum implementation]https://github.com/ethereum/go-ethereum/pull/31991) of EIP-7951 provides the foundation 2. Coreth Implementation: Integration with Avalanche's C-Chain (Avalanche's fork of go-ethereum) 3. Cryptographic Library: Implementation utilizes Go's standard library `crypto/ecdsa` and `crypto/elliptic` packages, which implement NIST P-256 per FIPS 186-3 ([Go documentation](https://pkg.go.dev/crypto/elliptic#P256)) The implementation follows established patterns for precompile integration, adding the contract to the precompile registry and implementing the verification logic using established cryptographic libraries. This ACP was implemented and merged into Coreth and Subnet-EVM behind the `Granite` upgrade flag. The full implementation can be found in [coreth@v0.15.4-rc.4](https://github.com/ava-labs/coreth/releases/tag/v0.15.4-rc.4), [subnet-evm@v0.8.0-fuji-rc.2](https://github.com/ava-labs/subnet-evm/releases/tag/v0.8.0-fuji-rc.2) and [libevm@v1.13.14-0.3.0.release](https://github.com/ava-labs/libevm/releases/tag/v1.13.14-0.3.0.release). ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-209: Eip7702 Style Account Abstraction (/docs/acps/209-eip7702-style-account-abstraction) --- title: "ACP-209: Eip7702 Style Account Abstraction" description: "Details for Avalanche Community Proposal 209: Eip7702 Style Account Abstraction" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/209-eip7702-style-account-abstraction/README.md --- | ACP | 209 | | :--- | :--- | | **Title** | EIP-7702-style Set Code for EOAs | | **Author(s)** | Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Arran Schlosberg ([@ARR4N](https://github.com/ARR4N)), Aaron Buchwald ([@aaronbuchwald](https://github.com/aaronbuchwald)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)) | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/216)) | | **Track** | Standards | ## Abstract [EIP-7702](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md) was activated on the Ethereum mainnet in May 2025 as part of the Pectra upgrade, and introduced a new "set code transaction" type that allows Externally Owned Accounts (EOAs) to set the code in their account. This enabled several UX improvements, including batching multiple operations into a single atomic transaction, sponsoring transactions on behalf of another account, and privilege de-escalation for EOAs. This ACP proposes adding a similar transaction type and functionality to Avalanche EVM implementations in order to have them support the same style of UX available on Ethereum. Modifications to the handling of account nonce and balances are required in order for it to be safe when used in conjunction with the streaming asynchronous execution (SAE) mechanism proposed in [ACP-194](https://github.com/avalanche-foundation/ACPs/tree/4a9408346ee408d0ab81050f42b9ac5ccae328bb/ACPs/194-streaming-asynchronous-execution). ## Motivation The motivation for this ACP is the same as the motivation described in [EIP-7702](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md#motivation). However, EIP-7702 as implemented for Ethereum breaks invariants required for EVM chains that use the ACP-194 SAE mechanism. There has been strong community feedback in support of ACP-194 for its potential to: - Allow for increasing the target gas rate of Avalanche EVM chains, including the C-Chain - Enable the use of an encrypted mempool to prevent front-running - Enable the use of real time VRF during transaction execution Given the strong support for ACP-194, bringing EIP-7702-style functionality to Avalanche EVMs requires modifications to preserve its necessary invariants, described below. ### Invariants needed for ACP-194 There are [two invariants explicitly broken by EIP-7702](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md#backwards-compatibility) that are required for SAE. They are: 1. An account balance can only decrease as a result of a transaction originating from that account. 1. An EOA nonce may not increase after transaction execution has begun. These invariants are required for SAE in order to be able to statically analyze (i.e. determine without executing the transaction) that a transaction: - Has the proper nonce - Will have sufficient balance to pay for its worst case transaction fee plus the balance it sends As described in the ACP-194, this lightweight analysis of transactions in blocks allows blocks to be accepted by consensus with the guarantee that they can be executed successfully. Only after block acceptance are the transactions within the block then put into a queue to be executed asynchronously. If the execution of transactions in the queue can decrease an EOA's account balance or change an EOA's current nonce, then block verification is unable to ensure that transactions in the block will be valid when executed. If transactions accepted into blocks can be invalidated prior to their execution, this poses DOS vulnerabilities because the invalidated transactions use up space in the pending execution queue according to their gas limits, but they do not pay any fees. Notably, EIP-7702's violation of these invariants already presents challenges for mempool verification on Ethereum. As [noted in the security considerations section](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md#transaction-propagation), EIP-7702 makes it "possible to cause transactions from other accounts to become stale" and this "poses some challenges for transaction propagation" because nodes now cannot "statically determine the validity of transactions for that account". In synchronous execution environments such as Ethereum, these issues only pose potential DOS risks to the public transaction mempool. Under an asynchronous execution scheme, the issues pose DOS risks to the chain itself since the invalidated transactions can be included in blocks prior to their execution. ## Specification The same [set code transaction as specified in EIP-7702](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md?ref=blockhead.co#set-code-transaction) will be added to Avalanche EVM implementations. The behavior of the transaction is the same as specified in EIP-7702. However, in order to keep the guarantee of transaction validity upon inclusion in an accepted block, two modifications are made to the transaction verification and execution rules. 1. Delegated accounts must maintain a "reserved balance" to ensure they can always pay for the transaction fees and transferred balance of transactions sent from the account. The reserved balances are managed via a new `ReservedBalanceManager` precompile, as specified below. 1. The handling of account nonces during execution is separated from the verification of nonces during block verification, as specified below. ### Reserved balances To ensure that all transactions can cover their worst case transaction fees and transferred balances upon inclusion in an accepted block, a "reserved balance" mechanism is introduced for accounts. Reserved balances are required for delegated accounts to guarantee that subsequent transactions they send after setting code for their account can still cover their fees and transfer amounts, even if transactions from other accounts reduce the account's balance prior to their execution. To allow for managing reserved balances, a new `ReservedBalanceManager` stateful precompile will be added at address `0x0200000000000000000000000000000000000006`. The `ReservedBalanceManager` precompile will have the following interface: ```solidity interface IReservedBalanceManager { /// @dev Emitted whenever an account's reserved balance is modified. event ReservedBalanceUpdated(address indexed account, uint256 newBalance); /// @dev Called to deposit the native token balance provided into the account's /// reserved balance. function depositReservedBalance(address account) external payable; /// @dev Returns the current reserved balance for the given account. function getReservedBalance(address account) external view returns (uint256 balance); } ``` The precompile will maintain a mapping of accounts to their current reserved balances. The precompile itself intentionally only allows for _increasing_ an account's reserved balance. Reducing an account's reserved balance is only ever done by the EVM when a transaction is sent from the account, as specified below. During transaction verification, the following rules are applied: - If the sender EOA account has not set code via an EIP-7702 transaction, no reserved balance is required. - The transaction is confirmed to be able to pay for its worst case transaction fee and transferred balance by looking at the sender account's regular balance and accounting for prior transactions it has sent that are still in the pending execution queue, as specified in ACP-194. - Otherwise, if the sender EOA account has previously been delegated via an EIP-7702 transaction (even if that transaction is still in the pending execution queue), then the account's current "[settled](https://github.com/avalanche-foundation/ACPs/tree/4a9408346ee408d0ab81050f42b9ac5ccae328bb/ACPs/194-streaming-asynchronous-execution#settling-blocks)" reserved balance must be sufficient to cover the sum of the worst case transaction fees and balances sent for all of the transactions in the pending execution queue after the set code transaction. During transaction execution, the following rules are applied: - When initially deducting balance from the sender EOA account for the maximum transaction fee and balance sent with the transaction, the account's regular balance is used first. The account's reserved balance is only reduced if the regular balance is insufficient. - In the execution of code as part of a transaction, only regular account balances are available. The only possible modification to reserved balances during code execution is increases via calls to the `ReservedBalanceManager` precompile `depositReservedBalance` function. - If there is a gas refund at the end of the transaction execution, the balance is first credited to the sender account's reserved balance, up to a maximum of the account's reserved balance prior to the transaction. Any remaining refund is credited to the account's regular balance. ### Handling of nonces To account for EOA account nonces being incremented during contract execution and potentially invalidating transactions from that EOA that have already been accepted, we separate the rules for how nonces are verified during block verification and how they are handled during execution. During block verification, all transactions must be verified to have a correct nonce value based on the latest "settled" state root, as defined in ACP-194, and the number of transactions from the sender account in the pending execution queue. Specifically, the required nonce is derived from the settled state root and incremented by one for each of the sender’s transactions already accepted into the pending execution queue or current block. During execution, the nonce used must be one greater than the latest nonce used by the account, accounting for both all transactions from the account and all contracts created by the account. This means that the actual nonce used by a transaction may differ from the nonce assigned in the raw transaction itself and used in verification. Separating the nonce values used for block verification and execution ensures that transactions accepted in blocks cannot be invalidated by the execution of transactions before them in the pending execution queue. It still provides the same level of replay protection to transactions, as a transaction with a given nonce from an EOA can be accepted at most once. However, this separation has a subtle potential impact on contract creation. Previously, the resulting address of a contract could be deterministically derived from a contract creation transaction based on its sender address and the nonce set in the transaction. Now, since the nonce used in execution is separate from that set in the transaction, this is no longer guaranteed. ## Backwards Compatibility The introduction of EIP-7702 transactions will require a network upgrade to be scheduled. Upon activation, a few invariants will be broken: - (From EIP-7702) `tx.origin == msg.sender` can only be true in the topmost frame of execution. - Once an account has been delegated, it can invoke multiple calls per transaction. - (From EIP-7702) An EOA nonce may not increase after transaction execution has begun. - Once an account has been delegated, the account may call a create operation during execution, causing the nonce to increase. - The contract address of a contract deployed by an EOA (via transaction with an empty "to" address) can be derived from the sender address and the transaction's nonce. - If earlier transactions cause the nonce to increase before execution, the actual nonce used in a contract creation transaction may differ from the one in the transaction payload, altering the resulting contract address. - Note that this can only occur for accounts that have been delegated, and whose delegated code involves contract creation. Additionally, at all points after the acceptance of a set code transaction, an EOA must have sufficient reserved balance to cover the sum of the worst case transactions fees and balances sent for all transactions in the pending execution queue after the set code transaction. Notably, this means that: - If a delegated account has zero reserved balance at any point, it will be unable to send any further transactions until a different account provides it with reserved balance via the `ReservedBalanceManager` precompile. - In order to initially "self-fund" its own reserved balance, an account must deposit reserved balance via the `ReservedBalanceManager` precompile prior to sending a set code transaction. - In order to transfer its full (regular + reserved) account balance, a delegated account must first deposit all of its regular balance into reserved balance. In order to support wallets as seamlessly as possible, the `eth_getBalance` RPC implementations should be updated to return the sum of an accounts regular and reserved balances. Additionally, clients should provide a new `eth_getReservedBalance` RPC method to allow for querying the reserved balance of a given account. ## Reference Implementation A reference implementation is not yet available and must be provided for this ACP to be considered implementable. ## Security Considerations All of the [security considerations from the EIP-7702 specification](https://github.com/ethereum/EIPs/blob/e17d216b4e8b359703ddfbc84499d592d65281fb/EIPS/eip-7702.md?ref=blockhead.co#security-considerations) apply here as well, except for the considerations regarding "sponsored transaction relayers" and "transaction propagation". Those two considerations do not apply here, as they are accounted for by the modifications made to introduce reserved balances and separate the handling of nonces in execution from verification. Additionally, given that an account's reserved balance may need be updated in state when a transfer is sent from the account it must be confirmed that 21,000 gas is still a sufficiently high cost for the potential more expensive operation. Charging more gas for basic transfer transactions in this case could otherwise be an option, but would likely cause further backwards compatibility issues for smart contracts and off-chain services. ## Open Questions 1. Are the implementation and UX complexities regarding the `ReservedBalanceManager` precompile worth the UX improvements introduced by the new set code transaction type? - Except for having a contract spend an account's native token balance, most, if not all, of the UX improvements associated with the new transaction type could theoretically be implemented at the contract layer rather than the protocol layer. However, not all contracts provide support for account abstraction functionality via standards such as [ERC-2771](https://eips.ethereum.org/EIPS/eip-2771). 2. Are the implementation and UX complexities regarding the `ReservedBalanceManager` precompile worth giving delegate contracts the ability to spend native token balances? - An alternative may be to disallow delegate contracts from spending native token balances at all, and revert if they attempt to. They could use "wrapped native token" ERC20 implementations (i.e. WAVAX) to achieve the same effect. However, this may be equally or more complex at the implementation level, and would cause incompatibilies in delegate contract implementations for Ethereum. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-224: Dynamic Gas Limit In Subnet Evm (/docs/acps/224-dynamic-gas-limit-in-subnet-evm) --- title: "ACP-224: Dynamic Gas Limit In Subnet Evm" description: "Details for Avalanche Community Proposal 224: Dynamic Gas Limit In Subnet Evm" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/224-dynamic-gas-limit-in-subnet-evm/README.md --- | ACP | 224 | | :--- | :--- | | **Title** | Introduce ACP-176-Based Dynamic Gas Limits and Fee Manager Precompile in Subnet-EVM | | **Author(s)** | Ceyhun Onur ([@ceyonur](https://github.com/ceyonur)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)) | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/230)) | | **Track** | Standards | ## Abstract Proposes implementing [ACP-176](https://github.com/avalanche-foundation/ACPs/blob/aa3bea24431b2fdf1c79f35a3fd7cc57eeb33108/ACPs/176-dynamic-evm-gas-limit-and-price-discovery-updates/README.md) in Subnet-EVM, along with the addition of a new optional `ACP224FeeManagerPrecompile` that can be used to configure fee parameters on-chain dynamically after activation, in the same way that the existing `FeeManagerPrecompile` can be used today prior to ACP-176. ## Motivation ACP-176 updated the EVM dynamic fee mechanism to more accurately achieve the target gas consumption on-chain. It also added a mechanism for the target gas consumption rate to be dynamically updated. Until now, ACP-176 was only added to Coreth (C-Chain), primarily because most L1s prefer to control their fees and gas targets through the `FeeManagerPrecompile` and `FeeConfig` in genesis chain configuration, and the existing `FeeManagerPrecompile` is not compatible with the ACP-176 fee mechanism. [ACP-194](https://github.com/avalanche-foundation/ACPs/blob/aa3bea24431b2fdf1c79f35a3fd7cc57eeb33108/ACPs/194-streaming-asynchronous-execution/README.md) (SAE) depends on having a gas target and capacity mechanism aligned with ACP-176. Specifically, there must be a known gas capacity added per second, and maximum gas capacity. The existing windower fee mechanism employed by Subnet-EVM does not provide these properties because it does not have a fixed capacity rate, making it difficult to calculate worst-case bounds for gas prices. As such, adding ACP-176 into Subnet-EVM is a functional requirement for L1s to be able to use SAE in the future. Adding ACP-176 fee dynamics to Subnet-EVM also has the added benefit of aligning with Coreth such that only a single mechanism needs to be maintained on a go-forwards basis. While both ACP-176 and ACP-194 will be required upgrades for L1s, this ACP aims to provide similar controls for chains with a new precompile. A new dynamic fee configuration and fee manager precompile that maps well into the ACP-176 mechanism will be added, optionally allowing admins to adjust fee parameters dynamically. ## Specification ### ACP-176 Parameters This ACP uses the same parameters as in the [ACP-176 specification](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/176-dynamic-evm-gas-limit-and-price-discovery-updates/README.md#configuration-parameters), and allows their values to be configured on a chain-by-chain basis. The parameters and their current values used by the C-Chain are as follows: | Parameter | Description | C-Chain Configuration | | :--- | :--- | :--- | | $T$ | target gas consumed per second | dynamic | | $R$ | gas capacity added per second | 2*T | | $C$ | maximum gas capacity | 10*T | | $P$ | minimum target gas consumption per second | 1,000,000 | | $D$ | target gas consumption rate update constant | 2^25 | | $Q$ | target gas consumption rate update factor change limit | 2^15 | | $M$ | minimum gas price | 1x10^-18 AVAX | | $K$ | initial gas price update factor | 87*T | ### Prior Subnet-EVM Fee Configuration Parameters Prior to this ACP, the Subnet-EVM fee configuration and fee manager precompile used the following parameters to control the fee mechanism: **GasLimit**: Sets the max amount of gas consumed per block. **TargetBlockRate**: Sets the target rate of block production in seconds used for fee adjustments. If the actual block rate is faster than this target, block gas cost will be increased, and vice versa. **MinBaseFee**: The minimum base fee sets a lower bound on the EIP-1559 base fee of a block. Since the block's base fee sets the minimum gas price for any transaction included in that block, this effectively sets a minimum gas price for any transaction. **TargetGas**: Specifies the targeted amount of gas (including block gas cost) to consume within a rolling 10s window. When the dynamic fee algorithm observes that network activity is above/below the `TargetGas`, it increases/decreases the base fee proportionally to how far above/below the target actual network activity is. **BaseFeeChangeDenominator**: Divides the difference between actual and target utilization to determine how much to increase/decrease the base fee. A larger denominator indicates a slower changing, stickier base fee, while a lower denominator allows the base fee to adjust more quickly. **MinBlockGasCost**: Sets the minimum amount of gas to charge for the production of a block. **MaxBlockGasCost**: Sets the maximum amount of gas to charge for the production of a block. **BlockGasCostStep**: Determines how much to increase/decrease the block gas cost depending on the amount of time elapsed since the previous block. If the block is produced at the target rate, the block gas cost will stay the same as the block gas cost for the parent block. If it is produced faster/slower, the block gas cost will be increased/decreased by the step value for each second faster/slower than the target block rate accordingly. Note: if the `BlockGasCostStep` is set to a very large number, it effectively requires block production to go no faster than the `TargetBlockRate`. Ex: if a block is produced two seconds faster than the target block rate, the block gas cost will increase by `2 * BlockGasCostStep`. ### ACP-176 Parameters in Subnet-EVM ACP-176 will make `GasLimit` and `BaseFeeChangeDenominator` configurations obsolete in Subnet-EVM. `TargetBlockRate`, `MinBlockGasCost`, `MaxBlockGasCost`, and `BlockGasCostStep` will be also removed by [ACP-226](https://github.com/avalanche-foundation/ACPs/tree/ce51dfab/ACPs/226-dynamic-minimum-block-times). `MinGasPrice` is equivalent to `M` in ACP-176 and will be used to set the minimum gas price for ACP-176. This is similar to `MinBaseFee` in old Subnet-EVM fee configuration, and roughly gives the same effect. Currently the default value is `25 * 10^-18` (25 nAVAX/Gwei). This default will be changed to the minimum possible denomination of the native EVM asset (1 Wei), which is aligned with the C-Chain. `TargetGas` is equivalent to `T` (target gas consumed per second) in ACP-176 and will be used to set the target gas consumed per second for ACP-176. `MaxCapacityFactor` is equivalent to the factor in `C` in ACP-176 and controls the maximum gas capacity (i.e. block gas limit). This determines the `C` as `C = MaxCapacityFactor * T`. The default value will be 10, which is aligned with the C-Chain. `TimeToDouble` will be used to control the speed of the fee adjustment (`K`). This determines the `K` as `K = (RMult * TimeToDouble) / ln(2)`, where `RMult` is the factor in `R` which is defined as 2. The default value for `TimeToDouble` will be 60 (seconds), making `K=~87*T`, which is aligned with the C-Chain. As a result parameters will be set as follows: | Parameter | Description | Default Value | Is Configurable | | :--- | :--- | :--- | :--- | | $T$ | target gas consumed per second | 1,000,000 | :white_check_mark: | | $R$ | gas capacity added per second | 2*T | :x: | $C$ | maximum gas capacity | 10*T | :white_check_mark: Through `MaxCapacityFactor` (default 10) | $P$ | minimum target gas consumption per second | 1,000,000 | :x: | $D$ | target gas consumption rate update constant | 2^25 | :x: | $Q$ | target gas consumption rate update factor change limit | 2^15 | :x: | $M$ | minimum gas price | 1 Wei | :white_check_mark: | $K$ | gas price update constant | ~87*T | :white_check_mark: Through `TimeToDouble` (default 60s) The gas capacity added per second (`R`) always being equal to `2*T` keeps it such that the gas price is capable of increases and decrease at the same rate. The values of `Q` and `D` affect the magnitude of change to `T` that each block can have, and the granularity at which the target gas consumption rate can be updated. The proposed values match the C-Chain, allowing each block to modify the current gas target by roughly $\frac{1}{1024}$ of its current value. This has provided sufficient responsiveness and granularity as is, removing the need to make `D` and `Q` dynamic or configurable. Similarly, 1,000,000 gas/second should be a low enough minimum target gas consumption for any EVM L1. The target gas for a given L1 will be able to be increased from this value dynamically and has no maximum. ### Genesis Configuration There will be a new genesis chain configuration to set the parameters for the chain without requiring the ACP224FeeManager precompile to be activated. This will be similar to the existing fee configuration parameters in chain configuration. If there is no genesis configuration for the new fee parameters the default values for the C-Chain will be used. This will look like the following: ```json { ... "acp224Timestamp": uint64 "acp224FeeConfig": { "minGasPrice": uint64 "maxCapacityFactor": uint64 "timeToDouble": uint64 } } ``` ### Dynamic Gas Target Via Validator Preference For L1s that want their gas target to be dynamically adjusted based on the preferences of their validator sets, the same mechanism introduced on the C-Chain in ACP-176 will be employed. Validators will be able to set their `gas-target` preference in their node's configuration, and block builders can then adjust the target excess in blocks that they propose based on their preference. ### Dynamic Gas Target & Fee Configuration Via `ACP224FeeManagerPrecompile` For L1s that want an "admin" account to be able to dynamically configuration their gas target and other fee parameters, a new optional `ACP224FeeManagerPrecompile` will be introduced and can be activated. The precompile will offer similar controls as the existing `FeeManagerPrecompile` implemented in Subnet-EVM [here](https://github.com/ava-labs/subnet-evm/tree/53f5305/precompile/contracts/feemanager). The solidity interface will be as follows: ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.24; import "./IAllowList.sol"; /// @title ACP-224 Fee Manager Interface /// @notice Interface for managing dynamic gas limit and fee parameters /// @dev Inherits from IAllowList for access control interface IACP224FeeManager is IAllowList { /// @notice Configuration parameters for the dynamic fee mechanism struct FeeConfig { uint256 targetGas; // Target gas consumption per second uint256 minGasPrice; // Minimum gas price in wei uint256 maxCapacityFactor; // Maximum capacity factor (C = factor * T) uint256 timeToDouble; // Time in seconds for gas price to double at max capacity } /// @notice Emitted when fee configuration is updated /// @param sender Address that triggered the update /// @param oldFeeConfig Previous configuration /// @param newFeeConfig New configuration event FeeConfigUpdated(address indexed sender, FeeConfig oldFeeConfig, FeeConfig newFeeConfig); /// @notice Set the fee configuration /// @param config New fee configuration parameters function setFeeConfig(FeeConfig calldata config) external; /// @notice Get the current fee configuration /// @return config Current fee configuration function getFeeConfig() external view returns (FeeConfig memory config); /// @notice Get the block number when fee config was last changed /// @return blockNumber Block number of last configuration change function getFeeConfigLastChangedAt() external view returns (uint256 blockNumber); } ``` For chains with the precompile activated, `setFeeConfig` can be used to dynamically change each of the values in the fee configurations. Importantly, any updates made via calls to `setFeeConfig` in a transaction will take effect only as of _settlement_ of the transaction, not as of _acceptance_ or _execution_ (for transaction life cycles/status, refer to ACP-194 [here](https://github.com/avalanche-foundation/ACPs/tree/61d2a2a/ACPs/194-streaming-asynchronous-execution#description)). This ensures that all nodes apply the same worst-case bounds validation on transactions being accepted into the queue, since the worst-case bounds are affected by changes to the fee configuration. In addition to storing the latest fee configuration to be returned by `getFeeConfig`, the precompile will also maintain state storing the latest values of $q$ and $K$. These values can be derived from the `targetGas` and `timeToDouble` values given to the precompile, respectively. The value of $q$ can be deterministically calculated using the same method as Coreth currently employs to calculate a node's desired target excess [here](https://github.com/ava-labs/coreth/blob/b4c8300490afb7f234df704fdcc446f227e4ec2f/plugin/evm/upgrade/acp176/acp176.go#L170). Similarly, the value of $K$ could be computed directly according to: $$ K = \frac{targetGas \cdot timeToDouble}{ln(2)} $$ However, floating point math may introduce inaccuracies. Instead, a similar approach will be employed using binary search to determine the closest integer solution for $K$. Similar to the [desired target excess calculation in Coreth](https://github.com/ava-labs/coreth/blob/0255516f25964cf4a15668946f28b12935a50e0c/plugin/evm/upgrade/acp176/acp176.go#L170), which takes a node's desired gas target and calculates its desired target excess value, the `ACP224FeeManagerPrecompile` will use binary search to determine the resulting dynamic target excess value given the `targetGas` value passed to `setFeeConfig`. All blocks accepted after the settlement of such a call must have the correct target excess value as derived from the binary search result. Block building logic can follow the below diagram for determining the target excess of blocks. B{Is ACP224FeeManager precompile active?} B -- Yes --> C[Use targetExcess from precompile storage at latest settled root] B -- No --> D{Is gas-target set in node chain config file?} D -- Yes --> E[Calculate targetExcess from configured preference and allowed update bounds] D -- No --> F{Does parent block have ACP176 fields?} F -- Yes --> G[Use parent block ACP176 gas target] F -- No --> H[Use MinTargetPerSecond]`} /> #### Adjustment to ACP-176 calculations for price discovery ACP-176 defines the gas price for a block as: $$gas\_price = M \cdot e^{\frac{x}{K}}$$ Now, whenever $M$ (`minGasPrice`) or $K$ (derived from `timeToDouble`) are changed via the `ACP224FeeManagerPrecompile`, $x$ must also be updated. Specifically, when $M$ is updated from $M_0$ to $M_1$, $x$ must also be updated from $x_0$ (the current excess) to $x_1$. $x_1$ theoretically could be calculated directly as: $$x_1 = ln(\frac{M_0}{M_1}) \cdot K + x_0$$ However, this would introduce floating point inaccuracies. Instead $x_1$ can be approximated using binary search to find the minimum non-negative integer such that the resulting gas price calculated using $M_1$ is greater than or equal to the current gas price prior to the change in $M$. In effect, this means that both reducing the minimum gas price and increasing the minimum gas price to a value less than the current gas price have no immediate effect on the current gas price. However, increasing the minimum gas price to value greater than the current gas price will cause the gas price to immediately step up to the new minimum value. Similarly, when $K$ is updated from $K_0$ to $K_1$, $x$ must also be updated from $x_0$ (the current excess) to $x_1$, where $x_1$ is calculated as: $$x_1 = x_0 \cdot \frac{K_1}{K_0}$$ This makes it such that the current gas price stays the same when $K$ is changed. Changes to $K$ only impact how quickly or slowly the gas price can change going forward based on usage. ## Backwards Compatibility ACP-224 will require a network update in order to activate the new fee mechanism. Another activation will also be required to activate the new fee manager precompile. The activation of precompile should never occur before the activation of ACP-224 (the fee mechanism) since the precompile depends on ACP-224’s fee update logic to function correctly. Activation of ACP-224 mechanism will deactivate the prior fee mechanism and the prior fee manager precompile. This ensures that there is no ambiguity or overlap between legacy and new pricing logic. In order to provide a configuration for existing networks, a network upgrade override for both activation time and ACP-176 configuration parameters will be introduced. These upgrades will be optional at the moment. However, with introduction of ACP-194 (SAE), it will be required to activate this ACP; otherwise the network will not be able to use ACP-194. ## Reference Implementation A reference implementation is not yet available and must be provided for this ACP to be considered implementable. ## Security Considerations Generally, this has the same security considerations as ACP-176. However, due to the dynamic nature of parameters exposed in the `ACP224FeeManagerPrecompile` there is an additional risk of misconfiguration. Misconfiguration of parameters could leave the network vulnerable to a DoS attack or result in higher transaction fees than necessary. ## Open Questions * Should activation of the `ACP224FeeManager` precompile disable the old precompile itself or should we require it to be manually disabled as a separate upgrade? * Should we use `targetGas` in genesis/chain config as an optional field signaling whether the chain config should have a precedence over the validator preferences? * Similarly above, should we have a toggle in `ACP224FeeManager` precompile to give control to validators for `targetGas`? ## Acknowledgements * [Stephen Buttolph](https://github.com/StephenButtolph) * [Arran Schlosberg](https://github.com/ARR4N) * [Austin Larson](https://github.com/alarso16) ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-226: Dynamic Minimum Block Times (/docs/acps/226-dynamic-minimum-block-times) --- title: "ACP-226: Dynamic Minimum Block Times" description: "Details for Avalanche Community Proposal 226: Dynamic Minimum Block Times" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/226-dynamic-minimum-block-times/README.md --- | ACP | 226 | | :- | :- | | **Title** | Dynamic Minimum Block Times | | **Author(s)** | Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/228)) | | **Track** | Standards | ## Abstract Proposes replacing the current block production rate limiting mechanism on Avalanche EVM chains with a new mechanism where validators collectively and dynamically determine the minimum time between blocks. ## Motivation Currently, Avalanche EVM chains employ a mechanism to limit the rate of block production by increasing the "block gas cost" that must be burned if blocks are produced more frequently than the target block rate specified for the chain. The block gas cost is paid by summing the "priority fee" amounts that all transactions included in the block collectively burn. This mechanism has a few notable suboptimal aspects: 1. There is no explicit minimum block delay time. Validators are capable of producing blocks as frequently as they would like by paying the additional fee, and too rapid block production could cause network stability issues. 1. The target block rate can only be changed in a required network upgrade, which makes updates difficult to coordinate and operationalize. 1. The target block rate can only be specified with 1-second granularity, which does not allow for configuring sub-second block times as performance improvements are made to make them feasible. With the prospect of ACP-194 removing block execution from consensus and allowing for increases to the gas target through the dynamic ACP-176 mechanism, Avalanche EVM chains would be better suited by having a dynamic minimum block delay time denominated in milliseconds. This allows networks to ensure that blocks are never produced more frequently than the minimum block delay, and allows validators to dynamically influence the minimum block delay value by setting their preference. ## Specification ### Block Header Changes Upon activation of this ACP, the `blockGasCost` field in block headers will be required to be set to 0. This means that no validation of the cumulative priority fee amounts of transactions within the block exceeding the block gas cost is required. Additionally, two new fields are added to EVM block headers: `timestampMilliseconds` and `minimumBlockDelayExcess`. #### `timestampMilliseconds` The canonical serialization and interpretation of EVM blocks already contains a block timestamp specified in seconds. Altering this would require deep changes to the EVM codebase, as well as cause breaking changes to tooling such as indexers and block explorers. Instead, a new field is added representing the unix timestamp in milliseconds. Header verification should verify the `block.timestamp` (in seconds) is aligned with the `block.timeMilliseconds`, more precisely: `block.timestampMilliseconds / 1000 == block.timestamp`. Existing tools that do not need millisecond granularity do not need to parse the new field, which limits the amount of breaking changes. The `timestampMilliseconds` field is represented in block headers as a `uint64`. #### `minimumBlockDelayExcess` The new `minimumBlockDelayExcess` field in the block header is used to derive the minimum number of milliseconds that must pass before the next block is allowed to be accepted. Specifically, if block $B$ has a `minimumBlockDelayExcess` of $q$, then the effective timestamp of block $B+1$ in milliseconds must be at least $M * e^{\frac{q}{D}}$ greater than the effective timestamp of block $B$ in milliseconds. $M$, $q$, and $D$ are defined below in the mechanism specification. The `minimumBlockDelayExcess` field is represented in block headers as a `uint64`. The value of `minimumBlockDelayExcess` can be updated in each block, similar to the gas target excess field introduced in ACP-176. The mechanism is specified below. ### Dynamic `minimumBlockDelay` mechanism The `minimumBlockDelay` can be defined as: $$ m = M * e^{\frac{q}{D}} $$ Where: - $M$ is the global minimum `minimumBlockDelay` value in milliseconds - $q$ is a non-negative integer that is initialized upon the activation of this mechanism, referred to as the `minimumBlockDelayExcess` - $D$ is a constant that helps control the rate of change of `minimumBlockDelay` After the execution of transactions in block $b$, the value of $q$ can be increased or decreased by up to $Q$. It must be the case that $\left|\Delta q\right| \leq Q$, or block $b$ is considered invalid. The amount by which $q$ changes after executing block $b$ is specified by the block builder. Block builders (i.e., validators) may set their desired value for $M$ (i.e., their desired `minimumBlockDelay`) in their configuration, and their desired value for $q$ can then be calculated as: $$q_{desired} = D \cdot ln\left(\frac{M_{desired}}{M}\right)$$ Note that since $q_{desired}$ is only used locally and can be different for each node, it is safe for implementations to approximate the value of $ln\left(\frac{M_{desired}}{M}\right)$ and round the resulting value to the nearest integer. Alternatively, client implementations can choose to use binary search to find the closest integer solution, as `coreth` [does to calculate a node's desired target excess](https://github.com/ava-labs/coreth/blob/ebaa8e028a3a8747d11e6822088b4af7863451d8/plugin/evm/upgrade/acp176/acp176.go#L170). When building a block, builders can calculate their next preferred value for $q$ based on the network's current value (`q_current`) according to: ```python # Calculates a node's new desired value for q for a given block def calc_next_q(q_current: int, q_desired: int, max_change: int) -> int: if q_desired > q_current: return q_current + min(q_desired - q_current, max_change) else: return q_current - min(q_current - q_desired, max_change) ``` As $q$ is updated after the execution of transactions within the block, $m$ is also updated such that $m = M \cdot e^{\frac{q}{D}}$ at all times. As noted above, the change to $m$ only takes effect for subsequent block production, and cannot change the time at which block $b$ can be produced itself. ### Gas Accounting Updates Currently, the amount of gas capacity available is only incremented on a per second basis, as defined by ACP-176. With this ACP, it is expected for chains to be able to have sub-second block times. However, in the case when a chain's gas capacity is fully consumed (i.e. during period of heavy transaction load), blocks would not be able to produced at sub-second intervals because at least one second would need to elapse for new gas capacity to be added. To correct this, upon activation of this ACP, gas capacity is added on a per millisecond basis. The ACP-176 mechanism for determining the target gas consumption per second remains unchanged, but its result is now used to derive the target gas consumption per millisecond by dividing by 1000, and gas capacity is added at that rate as each block advances time by some number of milliseconds. ### Activation Parameters for the C-Chain Parameters at activation on the C-Chain are:
| Parameter | Description | C-Chain Configuration| | - | - | - | | $M$ | minimum `minimumBlockDelay` value | 1 millisecond | | $q$ | initial `minimumBlockDelayExcess` | 7,970,124 | | $D$ | `minimumBlockDelay` update constant | $2^{20}$ | | $Q$ | `minimumBlockDelay` update factor change limit | 200 |
$M$ was chosen as a lower bound for `minimumBlockDelay` values to allow high-performance Avalanche L1s to be able to realize maximum performance and minimal transaction latency. Based on the 1 millisecond value for $M$, $q$ was chosen such that the effective `minimumBlockDelay` value at time of activation is as close as possible to the current target block rate of the C-Chain, which is 2 seconds. $D$ and $Q$ were chosen such that it takes approximately 3,600 consecutive blocks of the maximum allowed change in $q$ for the effective `minimumBlockDelay` value to either halve or double. ### ProposerVM `MinBlkDelay` The ProposerVM currently offers a static, configurable `MinBlkDelay` seconds for consecutive blocks. With this ACP enforcing a dynamic minimum block delay time, any EVM instance adopting this ACP that also leverages the ProposerVM should ensure that the ProposerVM `MinBlkDelay` is set to 0. ### Note on Block Building While there is no longer a requirement for blocks to burn a minimum block gas cost after the activation of this ACP, block builders should still take priority fees into account when building blocks to allow for transaction prioritization and to maximize the amount of native token (AVAX) burned in the block. From a user (transaction issuer) perspective, this means that a non-zero priority fee would only ever need to be set to ensure inclusion during periods of maximum gas utilization. ## Backwards Compatibility While this proposal requires a network upgrade and updates the EVM block header format, it does so in a way that tries to maintain as much backwards compatibility as possible. Specifically, applications that currently parse and use the existing timestamp field that is denominated in seconds can continue to do so. The `timestampMilliseconds` header value only needs to be used in cases where more granular timestamps are required. ## Reference Implementation This ACP was implemented and merged into Coreth and Subnet-EVM behind the `Granite` upgrade flag. The full implementation can be found in [coreth@v0.15.4-rc.4](https://github.com/ava-labs/coreth/releases/tag/v0.15.4-rc.4) and [subnet-evm@v0.8.0-fuji-rc.0](https://github.com/ava-labs/subnet-evm/releases/tag/v0.8.0-fuji-rc.0). ## Security Considerations Too rapid block production may cause availability issues if validators of the given blockchain are not able to keep up with blocks being proposed to consensus. This new mechanism allows validators to help influence the maximum frequency at which blocks are allowed to be produced, but potential misconfiguration or overly aggressive settings may cause problems for some validators. The mechanism for the minimum block delay time to adapt based on validator preference has already been used previously to allow for dynamic gas targets based on validator preference on the C-Chain, providing more confidence that it is suitable for controlling this network parameter as well. However, because each block is capable of changing the value of the minimum block delay by a certain amount, the lower the minimum block delay is, the more blocks that can be produced in a given time, and the faster the minimum block delay value will be able to change. This creates a dynamic where the mechanism for controlling `minimumBlockDelay` is more reactive at lower values, and less reactive at higher values. The global minimum `minimumBlockDelay` ($M$) provides a lower bound of how quickly blocks can ever be produced, but it is left to validators to ensure that the effective value does not exceed their collective preference. ## Acknowledgments Thanks to [Luigi D'Onorio DeMeo](https://x.com/luigidemeo) for continually bringing up the idea of reducing block times to provide better UX for users of Avalanche blockchains. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-23: P Chain Native Transfers (/docs/acps/23-p-chain-native-transfers) --- title: "ACP-23: P Chain Native Transfers" description: "Details for Avalanche Community Proposal 23: P Chain Native Transfers" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/23-p-chain-native-transfers/README.md --- | ACP | 23 | | :--- | :--- | | **Title** | P-Chain Native Transfers | | **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) | | **Status** | Activated | | **Track** | Standards | ## Abstract Support native transfers on P-chain. This enables users to transfer P-chain assets without leaving the P-chain or using a transaction type that's not meant for native transfers. ## Motivation Currently, the P-chain has no simple transfer transaction type. The X-chain supports this functionality through a `BaseTx`. Although the P-chain contains transaction types that extend `BaseTx`, the `BaseTx` transaction type itself is not a valid transaction. This leads to abnormal implementations of P-chain native transfers like in the AvalancheGo wallet which abuses [`CreateSubnetTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.15/wallet/chain/p/builder.go#L54-L63) to replicate the functionality contained in `BaseTx`. With the growing number of subnets slated for launch on the Avalanche network, simple transfers will be demanded more by users. While there are work-arounds as mentioned before, the network should support it natively to provide a cheaper option for both validators and end-users. ## Specification To support `BaseTx`, Avalanche Network Clients (like AvalancheGo) must register `BaseTx` with the type ID `0x22` in codec version `0x00`. For the specification of the transaction itself, see [here](https://github.com/ava-labs/avalanchego/blob/v1.10.15/vms/platformvm/txs/base_tx.go#L29). Note that most other P-chain transactions extend this type, the only change in this ACP is to register it as a valid transaction itself. ## Backwards Compatibility Adding a new transaction type is an execution change and requires a mandatory upgrade for activation. Implementors must take care to reject this transaction prior to activation. This ACP only details the specification of the added `BaseTx` transaction type. ## Reference Implementation An implementation of `BaseTx` support was created [here](https://github.com/ava-labs/avalanchego/pull/2232) and subsequently merged into AvalancheGo. Since the "D" Upgrade is not activated, this transaction will be rejected by AvalancheGo. If modifications are made to the specification of the transaction as part of the ACP process, the code must be updated prior to activation. ## Security Considerations The P-chain has fixed fees which does not place any limits on chain throughput. A potentially popular transaction type like `BaseTx` may cause periods of high usage. The reference implementation in AvalancheGo sets the transaction fee to 0.001 AVAX as a deterrent (equivalent to `ImportTx` and `ExportTx`). This should be sufficient for the time being but a dynamic fee mechanism will need to be added to the P-chain in the future to mitigate this security concern. This is not addressed in this ACP as it requires a larger change to the fee dynamics on the P-chain as a whole. ## Open Questions No open questions. ## Acknowledgements Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@abi87](https://github.com/abi87) for their feedback on the reference implementation. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-236: Continuous Staking (/docs/acps/236-continuous-staking) --- title: "ACP-236: Continuous Staking" description: "Details for Avalanche Community Proposal 236: Continuous Staking" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/236-continuous-staking/README.md --- | ACP | 236 | |:--------------|:------------------------------------------------------------| | **Title** | Continuous Staking | | **Author(s)** | Razvan Angheluta ([@rrazvan1](https://github.com/rrazvan1)) | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/244)) | | **Track** | Standards | ## Abstract This proposal introduces continuous staking for validators on the Avalanche P-Chain. Validators can stake their tokens continuously, allowing their stake to compound over time, accruing rewards once per specified cycle. Note that this mechanism applies only to primary network validation. It does not apply to L1 validators or to legacy subnet validators. ## Motivation The current staking system on the Avalanche P-Chain restricts flexibility for stakers by requiring them to specify an explicit end time for their stake and by enforcing minimum and maximum staking durations, limiting their ability to respond to changing market conditions or liquidity needs. Managing a large number of nodes is also challenging, as re-staking at the end of each period is labor-intensive, time-consuming, and poses security risks due to the required transaction signing. Additionally, tokens can remain idle at the end of a staking period until stakers initiate the necessary transactions to stake them again. ## Specification Continuous staking introduces a mechanism that allows validators to remain staked indefinitely, without having to manually submit new staking transactions at the end of each period. Instead of committing to a fixed endtime upfront, validators specify a cycle duration (period) and an `AutoRenewRewardsShares` value when they submit an `AddContinuousValidatorTx`. At the end of each cycle, the validator is automatically restaked for a new cycle of the same duration, unless the validator submits a `SetAutoRenewPolicyTx` with `AutoRenewRewardsShares` set to the sentinel value `MaxUint64`. If a validator submits such a `SetAutoRenewPolicyTx` during a cycle, the validator will continue validating until the end of the current cycle, at which point the validator exits and the funds are unlocked. Both `AddContinuousValidatorTx` and `SetAutoRenewPolicyTx` include the `AutoRenewRewardsShares` field, which controls the automatic restaking or withdrawal behavior of the rewards at the end of each cycle. The minimum and maximum cycle lengths follow the same protocol parameters as before (`MinStakeDuration` and `MaxStakeDuration`). Note: On mainnet, the current configuration is: `MinStakeDuration = 14 days` and `MaxStakeDuration = 365 days`. Clarification: In the rewards formula, `StakingPeriod` is the cycle’s duration, not the total accumulated time across cycles. Each cycle is treated separately when computing rewards. Delegator interaction remains unchanged, and the same constraints apply: a delegation period must fit entirely within the validator’s cycle. Delegators cannot delegate across multiple cycles, since there is no guarantee that a validator will continue validating after the current cycle. Essentially, it is not possible to delegate continuously. Rewards are accrued once per cycle and are managed according to the `AutoRenewRewardsShares` value: the specified portion is restaked and the remainder withdrawn. If the updated stake weight (previous stake + staking rewards + delegatee rewards) exceeds `MaxStakeLimit`, only the excess above `MaxStakeLimit` is withdrawn and distributed to `ValidatorRewardsOwner` and `DelegatorRewardsOwner`. Because of the way `RewardValidatorTx` is structured, multiple instances cannot be issued without resulting in identical transaction IDs. To resolve this, a new transaction type has been introduced for both rewarding and stopping continuous validators: `RewardContinuousValidatorTx`. Along with the validator’s creation transaction ID, it also includes a timestamp. Continuous validators follow the existing uptime requirements. The main difference is that uptime is measured separately for each cycle. At the end of every cycle, the validator’s uptime during that specific period is evaluated to determine eligibility for rewards. When a new cycle begins, uptime tracking resets and starts again for the next period. Note: Submitting an `AddContinuousValidatorTx` immediately followed by a `SetAutoRenewPolicyTx` (with `AutoRenewRewardsShares = MaxUint32`) replicates the behavior of the current staking system. ### Auto-Renew Policy The `PolicyOwner` field defines who is authorized to modify the validator's auto-renew policy. Only those specified as the `PolicyOwner` can update the auto-renew policy or signal the validator to exit at the end of a cycle. To support flexible reward withdrawal while keeping UX simple, continuous validators include an auto-renew policy field at creation called `AutoRenewRewardsShares`. This value specifies, in millionths (percentage * 10_000), what portion of earned rewards should be automatically restaked at the end of each cycle. The remaining portion of the rewards will be withdrawn. Using a sentinel value of `MaxUint64` signals that the validator should exit at the end of the current cycle. For example, a value of 300,000, restakes 30% of the rewards and withdraws 70%. ### New P-Chain Transaction Types The following new transaction types will be introduced to the P-Chain to support this functionality: #### AddContinuousValidatorTx ```go type AddContinuousValidatorTx struct { // Metadata, inputs and outputs BaseTx `serialize:"true"` // Node ID of the validator ValidatorNodeID ids.NodeID `serialize:"true" json:"nodeID"` // Period (in seconds). Period uint64 `serialize:"true" json:"period"` // [Signer] is the BLS key for this validator. Signer signer.Signer `serialize:"true" json:"signer"` // Where to send staked tokens when done validating StakeOuts []*avax.TransferableOutput `serialize:"true" json:"stake"` // Where to send validation rewards when done validating ValidatorRewardsOwner fx.Owner `serialize:"true" json:"validationRewardsOwner"` // Where to send delegation rewards when done validating DelegatorRewardsOwner fx.Owner `serialize:"true" json:"delegationRewardsOwner"` // Who is authorized to modify the auto renew rewards shares PolicyOwner fx.Owner `serialize:"true" json:"policyOwner"` // Fee this validator charges delegators as a percentage, times 10,000 // For example, if this validator has DelegationShares=300,000 then they // take 30% of rewards from delegators DelegationShares uint32 `serialize:"true" json:"shares"` // Weight of this validator used when sampling Wght uint64 `serialize:"true" json:"weight"` // Auto-renew policy for rewards, expressed in percentage, times 10,000. // Range [0..1_000_000] means the percentage of cycle rewards to auto-restake: // 0 = restake principal only; withdraw 100% of rewards // 300_000 = restake 30% of rewards; withdraw 70% // 1_000_000 = restake 100% of rewards; withdraw 0% // Sentinel value MaxUint64 indicates "stop at the end of current cycle". AutoRenewRewardsShares uint32 `serialize:"true" json:"autoRenewRewardsShares"` } ``` #### SetAutoRenewPolicyTx ```go type SetAutoRenewPolicyTx struct { // Metadata, inputs and outputs BaseTx `serialize:"true"` // ID of the tx that created the continuous validator. TxID ids.ID `serialize:"true" json:"txID"` // Authorizes this validator to be updated. Auth verify.Verifiable `serialize:"true" json:"auth"` // Auto-renew policy for rewards, expressed in percentage, times 10,000. // Range [0..1_000_000] means the percentage of cycle rewards to auto-restake: // 0 = restake principal only; withdraw 100% of rewards // 300_000 = restake 30% of rewards; withdraw 70% // 1_000_000 = restake 100% of rewards; withdraw 0% // Sentinel value MaxUint64 indicates "stop at the end of current cycle". AutoRenewRewardsShares uint32 `serialize:"true" json:"autoRenewRewardsShares"` } ``` #### RewardContinuousValidatorTx ```go type RewardContinuousValidatorTx struct { // ID of the tx that created the validator being removed/rewarded TxID ids.ID `serialize:"true" json:"txID"` // End time of the validation cycle. Timestamp uint64 `serialize:"true" json:"timestamp"` unsignedBytes []byte // Unsigned byte representation of this data } ``` ## Backwards Compatibility This change requires a network upgrade to make sure that all validators are able to verify and execute the new introduced transactions. ## Considerations Continuous staking makes it easier for users to keep their funds staked longer than with fixed-period staking, since it involves fewer transactions, lower friction, and reduced risks. Greater staking participation leads to stronger overall network security. Validators benefit by not having to manually restart at the end of each cycle, which reduces transaction volume and the risk of network congestion. However, the uptime risk per cycle slightly increases depending on cycle length and validator performance. For example, missing five days in a one-year cycle will still yield validation rewards, whereas missing five days in a two-week cycle may affect rewards. ## Flow of a Continuous Validator B[Validator active] B -->|Optional during cycle| C[Issue SetAutoRenewPolicyTx to update AutoRenewRewardsShares or request stop] B --> D[Cycle endtime reached] D --> E[Block builder issues RewardContinuousValidatorTx] E --> F[Compute cycle rewards] F --> G{Stop requested?} G -->|Yes| H[Withdraw rewards and unlock principal] H --> I[Validator exits] G -->|No| J[Apply auto-renew policy and split rewards into restake and withdrawal] J --> K{New stake exceeds MaxStakeLimit?} K -->|Yes| L[Withdraw excess above MaxStakeLimit] K -->|No| N[Start new cycle] L --> N[Start new cycle] N --> B`} /> ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-24: Shanghai Eips (/docs/acps/24-shanghai-eips) --- title: "ACP-24: Shanghai Eips" description: "Details for Avalanche Community Proposal 24: Shanghai Eips" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/24-shanghai-eips/README.md --- | ACP | 24 | | :--- | :--- | | **Title** | Activate Shanghai EIPs on C-Chain | | **Author(s)** | Darioush Jalali ([@darioush](https://github.com/darioush)) | | **Status** | Activated | | **Track** | Standards | ## Abstract This ACP proposes the adoption of the following EIPs on the Avalanche C-Chain network: - [EIP-3651: Warm COINBASE](https://eips.ethereum.org/EIPS/eip-3651) - [EIP-3855: PUSH0 instruction](https://eips.ethereum.org/EIPS/eip-3855) - [EIP-3860: Limit and meter initcode](https://eips.ethereum.org/EIPS/eip-3860) - [EIP-6049: Deprecate SELFDESTRUCT](https://eips.ethereum.org/EIPS/eip-6049) ## Motivation The listed EIPs were activated on Ethereum mainnet as part of the [Shanghai upgrade](https://github.com/ethereum/execution-specs/blob/master/network-upgrades/mainnet-upgrades/shanghai.md#included-eips). This ACP proposes their activation on the Avalanche C-Chain in the next network upgrade. This maintains compatibility with upstream EVM tooling, infrastructure, and developer experience (e.g., Solidity compiler >= [0.8.20](https://github.com/ethereum/solidity/releases/tag/v0.8.20)). ## Specification & Reference Implementation This ACP proposes the EIPs be adopted as specified in the EIPs themselves. ANCs (Avalanche Network Clients) can adopt the implementation as specified in the [coreth](https://github.com/ava-labs/coreth) repository, which was adopted from the [go-ethereum v1.12.0](https://github.com/ethereum/go-ethereum/releases/tag/v1.12.0) release in this [PR](https://github.com/ava-labs/coreth/pull/277). In particular, note the following code: - [Activation of new opcode and dynamic gas calculations](https://github.com/ava-labs/coreth/blob/bf2051729c7aa0c4ed8848ad3a78e241a791b968/core/vm/jump_table.go#L92) - [EIP-3860 intrinsic gas calculations](https://github.com/ava-labs/coreth/blob/bf2051729c7aa0c4ed8848ad3a78e241a791b968/core/state_transition.go#L112-L113) - [EIP-3651 warm coinbase](https://github.com/ava-labs/coreth/blob/bf2051729c7aa0c4ed8848ad3a78e241a791b968/core/state/statedb.go#L1197-L1199) - Note EIP-6049 marks SELFDESTRUCT as deprecated, but does not remove it. The implementation in coreth is unchanged. ## Backwards Compatibility The following backward compatibility considerations were highlighted by the original EIP authors: - [EIP-3855](https://eips.ethereum.org/EIPS/eip-3855#backwards-compatibility): "... introduces a new opcode which did not exist previously. Already deployed contracts using this opcode could change their behaviour after this EIP". - [EIP-3860](https://eips.ethereum.org/EIPS/eip-3860#backwards-compatibility) "Already deployed contracts should not be effected, but certain transactions (with initcode beyond the proposed limit) would still be includable in a block, but result in an exceptional abort." Adoption of this ACP modifies consensus rules for the C-Chain, therefore it requires a network upgrade. ## Security Considerations Refer to the original EIPs for security considerations: - [EIP 3855](https://eips.ethereum.org/EIPS/eip-3855#security-considerations) - [EIP 3860](https://eips.ethereum.org/EIPS/eip-3860#security-considerations) ## Open Questions No open questions. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-247: Delegation Multiplier Increase Maximum Validator Weight Reduction (/docs/acps/247-delegation-multiplier-increase-maximum-validator-weight-reduction) --- title: "ACP-247: Delegation Multiplier Increase Maximum Validator Weight Reduction" description: "Details for Avalanche Community Proposal 247: Delegation Multiplier Increase Maximum Validator Weight Reduction" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/247-delegation-multiplier-increase-maximum-validator-weight-reduction/README.md --- | ACP | 247 | | :--- | :--- | | **Title** | Delegation Multiplier Increase & Maximum Validator Weight Reduction | | **Authors** | Giacomo Barbieri ([@ijaack94](https://x.com/ijaack94)), BENQI ([@benqifinance](https://x.com/benqifinance)) | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/248)) | | **Track** | Standards | ## Abstract This Avalanche Community Proposal advocates for two targeted adjustments to Primary Network validator staking parameters: (1) reducing the maximum validator weight from 3,000,000 AVAX to **1,000,000 AVAX** to prevent excessive stake concentration; and (2) increasing the delegation multiplier from 5x to **24x** to enable validators to efficiently serve larger delegated bases within the new weight constraint. These changes maintain the 2,000 AVAX minimum validator stake and focus on improving capital efficiency for existing, well-capitalized validators rather than broadening participation. ## Motivation ### Current Capital Efficiency Problem The Avalanche Primary Network currently limits validators to a **4x delegation multiplier**, creating suboptimal infrastructure utilization. A validator with 2,000 AVAX self-stake can accept only 8,000 AVAX in delegations (4x multiplier), yielding a total weight of 10,000 AVAX. **Economic Reality at Current 4x Multiplier** (at $20 AVAX, 8.25% APY, 5% delegation fee): | Metric | Value | |--------|-------| | Self-stake | 2,000 AVAX | | Max delegations | 8,000 AVAX | | Total weight | 10,000 AVAX | | Monthly rewards | $1,375 | | Validator self-share (20% of weight) | $275 | | Delegation fee income (5%) | $55 | | **Total validator monthly income** | **$330** | | **Monthly operational costs** | **$150** | | **Net monthly profit** | **$180** | This marginal profitability (~55% margin) creates structural problems: - Many validators operate below capacity (not 8,000 AVAX fully delegated) - Some validators forced to run multiple nodes to achieve sufficient scale - Infrastructure investment is heavily underutilized - Validator economics are fragile, attracting only well-funded entities - Sensitive to delegation fee pressure (any reduction below 5% hurts profitability) ### Real Network Evidence: Validator Underutilization Real validator distribution data (as of October 28, 2025) provides empirical evidence of the problem: | Metric | Count | Percentage | |--------|-------|-----------| | **Total validators** | 854 | 100% | | **Validators with ZERO delegations** | 451 | **52.8%** | | **Validators with <1k AVAX delegated** | 501 | **58.7%** | | **Validators with 100+ delegations** | 105 | 12.3% | | **Validators with 1-5 delegations** | 138 | 16.2% | **Critical Finding**: Over half of all validators have zero delegations despite having the technical capacity for up to 8,000 AVAX under current 4x multiplier. This reveals: 1. **Validators don't put much effort into collecting delegations** because they can't really make a business out of it 2. **Delegation is highly concentrated** among only ~100 top-performing validators 3. **Current system severely underutilizes validator infrastructure** across the network 4. **Small validators (2k-5k AVAX self-stake)** cannot compete for delegations **Validator Self-Stake Distribution**: - 447 validators (52.3%) have only 2k-5k AVAX self-stake - Most of these are probably unprofitable or barely breaking even - They cannot attract delegations at current economics - Our profitability calculations ($180/month) match their behavior ### Maximum Validator Weight Centralization Risk The current 3,000,000 AVAX maximum weight limit allows individual validators to accumulate excessive stake (0.42% of 720M AVAX total supply). **Proposed 1,000,000 AVAX cap would reduce this to 0.14% per validator**, promoting more distribution in both self- and delegated stake. ### Proposed Solution Implement two complementary changes: 1. **Reduce maximum validator weight to 1,000,000 AVAX** - Prevents dangerous concentration 2. **Increase delegation multiplier to 24x** - Increases the maximum _potential_ rewards that validators could receive from delegations, not changing any of the underlying incentives of delegation if not flipping the perception of maximum rewards for validators on Avalanche. **Resulting Economics at 24x Multiplier** (at $20 AVAX, 2,000 AVAX self-stake, 8.25% APY, 5% delegation fee): | Metric | Current (4x) | Proposed (24x) | Change | |--------|-------------|---|---| | Max delegations | 8,000 AVAX | 48,000 AVAX | +500% | | Total weight | 10,000 AVAX | 50,000 AVAX | +400% | | Monthly rewards total | $1,375 | $6,875 | +400% | | Validator income | $330 | $605 | +83% | | Net monthly profit | $180 | $455 | +153% | | Profit margin | 55% | 75% | +20 pp | This transformation: - **Makes validators economically viable** at 50%+ delegation capacity - **Eliminates need for multi-node operations** for profitability - **Unlocks dormant validator capacity** (current 52.8% with zero delegations) - **Enables sustainable single-node operations** at scale ## Specification ### Technical Changes #### Change 1: Maximum Validator Weight Reduction **Current Parameter**: ``` MaxValidatorStake = 3,000,000 AVAX ``` **Proposed Parameter**: ``` MaxValidatorStake = 1,000,000 AVAX ``` **Implementation Details**: - Affects calculation of maximum validator weight (stake + delegations) - Existing validators exceeding 1,000,000 AVAX weight are **not immediately affected** - New delegations to validators at or above 1,000,000 AVAX total weight are **rejected by consensus** - Validators already exceeding 1,000,000 AVAX continue earning rewards until staking period ends - Upon period end, rewards paid and stake returned; new staking cannot exceed 1,000,000 AVAX **Rationale**: Prevents single validators from accumulating excessive network influence while allowing existing large positions to mature naturally. #### Change 2: Delegation Multiplier Increase **Current Parameter**: ``` DelegationMultiplier = 4 ``` **Proposed Parameter**: ``` DelegationMultiplier = 24 ``` **Calculation Formula**: ``` MaxDelegatorStake(validator) = Min(ValidatorStake * 24, MaxValidatorWeight - ValidatorStake) Example for 2,000 AVAX validator: MaxDelegatorStake = Min(2,000 * 24, 1,000,000 - 2,000) MaxDelegatorStake = Min(48,000, 998,000) MaxDelegatorStake = 48,000 AVAX ``` **Implementation Details**: - Applies uniformly to all validators - Only validators with 40,000+ AVAX self-stake cannot utilize full 24x due to 1M weight cap - All 2,000 AVAX validators can deploy full 24x multiplier - Non-breaking for existing delegation relationships #### Unchanged Parameters The following parameters remain **UNCHANGED**: | Parameter | Value | Notes | |-----------|-------|-------| | Minimum validator stake | 2,000 AVAX | No reduction | | Minimum delegator stake | 25 AVAX | Unchanged | | Minimum staking duration | 2 weeks | Unchanged | | Maximum staking duration | 1 year | Unchanged | | Uptime requirement | 80% | Unchanged | | Slashing penalty | None | Unchanged | | Reward formula | Same | APY calculations unchanged | ## Economic Impact Analysis ### Validator Profitability Scenarios All scenarios calculated at: - **AVAX Price**: $20 USD - **Annual APY**: 8.25% (average, varies by network conditions) - **Delegation Fee**: 5% (fee validator charges on delegator rewards) - **Monthly operational costs**: $150 (cloud hosting, bandwidth, monitoring) #### Scenario 1: Solo Validator (No Delegation) | Metric | Current (4x) | Proposed (24x) | |--------|-------------|---| | Self-stake | 2,000 AVAX | 2,000 AVAX | | Delegations | 0 | 0 | | Total weight | 2,000 AVAX | 2,000 AVAX | | Monthly rewards | $275 | $275 | | Monthly costs | $150 | $150 | | **Net profit** | **$125** | **$125** | **Conclusion**: Solo operation equally profitable in both cases; validators must attract delegations for profitability. #### Scenario 2: 50% Delegation Capacity | Metric | Current (4x) | Proposed (24x) | |--------|-------------|---| | Self-stake | 2,000 AVAX | 2,000 AVAX | | Delegations | 4,000 AVAX | 24,000 AVAX | | Total weight | 6,000 AVAX | 26,000 AVAX | | Monthly rewards | $825 | $3,575 | | Validator income | $302.50 | $440 | | Monthly costs | $150 | $150 | | **Net profit** | **$152.50** | **$290** | **Conclusion**: 24x multiplier increases profitability by **90.2%** at 50% delegation capacity. Validators reach break-even and profitability much more easily. **Real Network Impact**: Current data shows 52.8% of validators (451) have ZERO delegations. At 50% capacity with 24x, these validators become economically viable, incentivizing them to accept delegations. #### Scenario 3: Full Delegation Capacity (100%) | Metric | Current (4x) | Proposed (24x) | |--------|-------------|---| | Self-stake | 2,000 AVAX | 2,000 AVAX | | Delegations | 8,000 AVAX | 48,000 AVAX | | Total weight | 10,000 AVAX | 50,000 AVAX | | Monthly rewards | $1,375 | $6,875 | | Validator self-share | $275 | $275 | | Delegation fee income (5%) | $55 | $330 | | Total validator income | $330 | $605 | | Monthly costs | $150 | $150 | | **Net profit** | **$180** | **$455** | **Conclusion**: 24x multiplier increases profitability by **+152.8%** at full delegation. Transforms validators from barely-profitable to highly profitable operations. ### Sensitivity Analysis: Impact of Different Delegation Fees **With 50% delegation capacity filled:** | Delegation Fee | Current (4x) | Proposed (24x) | Multiplier Advantage | |---|---|---|---| | 2% (minimum) | $89.38 | $185 | 2.07x | | 3% | $96.88 | $245 | 2.53x | | 5% (assumed) | **$152.50** | **$290** | 1.90x | | 7% | $208.13 | $335 | 1.61x | | 10% (high) | $271.88 | $425 | 1.56x | **Key insight**: 24x multiplier provides 1.5-2.5x better economics across all fee rates. Current model is highly sensitive to fee compression; 24x multiplier provides a financial buffer. ### Fee Market Implications **Current 4x Model**: - Validators barely profitable even at 5% fees - Significant pressure to accept low fees to attract delegations - Unsustainable economics push toward multi-node operations - 52.8% of validators choose NOT to accept delegations (uneconomical) **Proposed 24x Model**: - Validators achieve healthy profits at standard 5% fees - Can sustain competitive fee discovery without margin pressure - Enables single-node operations at scale - Market-based fee competition works as intended - Expected outcome: More validators accept delegations, earning fees ## Network Impact Analysis ### P-Chain Load Considerations The 24x multiplier change has **minimal impact** on P-Chain resources: | Resource | Current State | Projected (24x) | Change | |----------|---|---|---| | Validator registry size | ~854 validators | ~854 validators | No change | | Delegation transactions | Existing pattern | More delegations expected | Variable | | BLS signature aggregation | Baseline | Baseline | Minimal | | Storage requirements | Baseline | Baseline | Negligible | **Why minimal impact?** - Validator count unchanged (no new validators) - Each validator has same duty requirements - Delegations already tracked; multiplier doesn't add overhead - Maximum weight cap prevents runaway growth ### Consensus Security **Sybil Resistance**: Unchanged - 2,000 AVAX minimum stake maintained - Economic cost to create malicious validator unchanged **Centralization Risk**: **Improved** - 1M AVAX maximum weight reduces concentration - Individual validators limited to 0.14% of maximum supply (vs 0.42% current) - Prevents dangerous mega-validators ## Consequences Analysis ### Positive Consequences **1. Validator Capital Efficiency Improves** (Very High probability, High severity) - Single validators serve 6x larger delegated bases (8K -> 48K AVAX) - Infrastructure investment better utilized - Eliminates need for multiple-node operations **2. Validator Profitability Increases Substantially** (Very High probability, High severity) - Fully delegated validators earn 152.8% more ($180 -> $455/month) - At 50% delegation: +90.2% improvement - Makes validator operations genuinely profitable - Attracts professional infrastructure operators **3. Unlocks Dormant Validator Capacity** (Very High probability, High severity) - 52.8% of validators (451) currently have zero delegations - Improved economics incentivize these validators to accept delegations - Converts uneconomical validators into active, capital-efficient operations - Significantly increases network capital deployment **4. Fee Market Stabilizes** (High probability, Medium severity) - Validators can maintain 5%+ fees without margin pressure - Sustainable economics support long-term operations - Delegators benefit from stable, profitable validators - Competitive fee discovery enabled **5. Prevents Dangerous Centralization** (Very High probability, High severity) - 1M AVAX cap prevents mega-validators - Individual validator influence limited to 0.14% (vs 0.42% current) - Maintains security through diversification - Real data confirms no validators exceed 2.5% currently **6. Minimal Network Disruption** (Very High probability, Medium severity) - No new validator cohort entering (no min stake change) - Validator count unchanged (~854) - P-Chain load impact minimal - Easy implementation (2 parameters only) ### Negative Consequences **1. Delegation Concentration Risk Increases** (High probability, Medium severity) - Larger multiplier enables validators to accumulate more delegations - Top performers may attract disproportionate share - Network vulnerable to large validator failures **Mitigation**: 1M AVAX weight cap prevents validators from becoming too large. Current 2.5% max means risk is contained. **2. Geographic Diversity Unchanged** (High probability, Low severity) - Entry barrier remains $40,000 (unchanged) - Validator count unlikely to increase (~854 baseline) - Cloud provider concentration persists **Mitigation**: This proposal optimizes efficiency only; separate initiatives address diversity. **3. Fee Market Competition May Decrease** (Medium probability, Low severity) - Fewer new validators entering (no min stake reduction) - Existing validators less pressured on fees - Delegators have same validator options **Mitigation**: 24x efficiency enables competitive fee discovery without external pressure. **4. Network Accessibility Unchanged** (Very High probability, Low severity) - $40,000 entry barrier maintained - Small token holders cannot become validators - No improvement for less wealthy participants **Mitigation**: This proposal optimizes efficiency, not accessibility. Different ACPs can address participation barriers. ## Backwards Compatibility ### Breaking Changes: None This proposal maintains full backwards compatibility: 1. **Existing Validators**: All continue operating normally 2. **Existing Delegations**: No modifications required 3. **Reward Calculations**: Formula unchanged 4. **Staking Durations**: All parameters unchanged 5. **Uptime Requirements**: 80% threshold unchanged ### Transition Mechanism **Phase 1 - Activation**: - New parameters take effect at specified block height - Existing validators with weight > 1M AVAX continue operating - New delegations to validators > 1M AVAX weight are rejected **Phase 2 - Maturation**: - Existing large validators' delegations mature naturally - Upon maturation, new stakes must comply with 1M AVAX cap - Validators rebalance to optimize under new parameters **Phase 3 - Equilibrium**: - Network reaches new steady state - Validators optimize delegation capacity within constraints - Fee market establishes new equilibrium ## Open Questions **Core Question**: "Should Avalanche prioritize validator capital efficiency through multiplier increase and weight cap reduction?" **Supporting Questions**: 1. Is 24x multiplier appropriate? 2. Is 1M AVAX the right weight cap? 3. Should minimum stake remain at 2,000 AVAX? - YES: Maintain current barrier (approved) - NO: Lower it (pursue separate ACP) ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-25: Vm Application Errors (/docs/acps/25-vm-application-errors) --- title: "ACP-25: Vm Application Errors" description: "Details for Avalanche Community Proposal 25: Vm Application Errors" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/25-vm-application-errors/README.md --- | ACP | 25 | | :--- | :--- | | **Title** | Virtual Machine Application Errors | | **Author(s)** | Joshua Kim ([@joshua-kim](https://github.com/joshua-kim)) | | **Status** | Activated | | **Track** | Standards | ## Abstract Support a way for a Virtual Machine (VM) to signal application-defined error conditions to another VM. ## Motivation VMs are able to build their own peer-to-peer application protocols using the `AppRequest`, `AppResponse`, and `AppGossip` primitives. `AppRequest` is a message type that requires a corresponding `AppResponse` to indicate a successful response. In the unhappy path where an `AppRequest` is unable to be served, there currently is no native way for a peer to signal an error condition. VMs currently resort to timeouts in failure cases, where a client making a request will fallback to marking its request as failed after some timeout period has expired. Having a native application error type would offer a more powerful abstraction where Avalanche nodes would be able to score peers based on perceived errors. This is not currently possible because Avalanche networking isn't aware of the specific implementation details of the messages being delivered to VMs. A native application error type would also guarantee that all clients can potentially expect an `AppError` message to unblock an unsuccessful `AppRequest` and only rely on a timeout when absolutely necessary, significantly decreasing the latency for a client to unblock its request in the unhappy path. ## Specification ### Message This modifies the p2p specification by introducing a new [protobuf](https://protobuf.dev/) message type: ``` message AppError { bytes chain_id = 1; uint32 request_id = 2; uint32 error_code = 3; string error_message = 4; } ``` 1. `chain_id`: Reserves field 1. Senders **must** use the same chain id of from the original `AppRequest` this `AppError` message is being sent in response to. 2. `request_id`: Reserves field 2. Senders **must** use the same request id from the original `AppRequest` this `AppError` message is being sent in response to. 3. `error_code`: Reserves field 3. Application defined error code. Implementations _should_ use the same error codes for the same conditions to allow clients to error match. Negative error codes are reserved for protocol defined errors. VMs may reserve any error code greater than zero. 4. `error_message`: Reserves field 4. Application defined human-readable error message that _should not_ be used for error matching. For error matching, use `error_code`. ### Reserved Errors The following error codes are currently reserved by the Avalanche protocol: | Error Code | Description | | ---------- | --------------- | | 0 | undefined | | -1 | network timeout | ### Handling Clients **must** respond to an inbound `AppRequest` message with either a corresponding `AppResponse` to indicate a successful response, or an `AppError` to indicate an error condition by the requested `deadline` in the original `AppRequest`. ## Backwards Compatibility This new message type requires a network activation to require either an `AppResponse` or an `AppError` as a required response to an `AppRequest`. ## Reference Implementation - Message definition: https://github.com/ava-labs/avalanchego/pull/2111 - Handling: https://github.com/ava-labs/avalanchego/pull/2248 ## Security Considerations Optional section that discusses the security implications/considerations relevant to the proposed change. Clients should be aware that peers can arbitrarily send `AppError` messages to invoke error handling logic in a VM. ## Open Questions Optional section that lists any concerns that should be resolved prior to implementation. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-30: Avalanche Warp X Evm (/docs/acps/30-avalanche-warp-x-evm) --- title: "ACP-30: Avalanche Warp X Evm" description: "Details for Avalanche Community Proposal 30: Avalanche Warp X Evm" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/30-avalanche-warp-x-evm/README.md --- | ACP | 30 | | :--- | :--- | | **Title** | Integrate Avalanche Warp Messaging into the EVM | | **Author(s)** | Aaron Buchwald ([aaron.buchwald56@gmail.com](mailto:aaron.buchwald56@gmail.com)) | | **Status** | Activated | | **Track** | Standards | ## Abstract Integrate Avalanche Warp Messaging into the C-Chain and Subnet-EVM in order to bring Cross-Subnet Communication to the EVM on Avalanche. ## Motivation Avalanche Subnets enable the creation of independent blockchains within the Avalanche Network. Each Avalanche Subnet registers its validator set on the Avalanche P-Chain, which serves as an effective "membership chain" for the entire Avalanche Ecosystem. By providing read access to the validator set of every Subnet on the Avalanche Network, any Subnet can look up the validator set of any other Subnet within the Avalanche Ecosystem to verify an Avalanche Warp Message, which replaces the need for point-to-point exchange of validator set info between Subnets. This enables a light weight protocol that allows seamless, on-demand communication between Subnets. For more information on the Avalanche Warp Messaging message and payload formats see here: - [AWM Message Format](https://github.com/ava-labs/avalanchego/tree/v1.10.15/vms/platformvm/warp/README.md) - [Payload Format](https://github.com/ava-labs/avalanchego/tree/v1.10.15/vms/platformvm/warp/payload/README.md) This ACP proposes to activate Avalanche Warp Messaging on the C-Chain and offer compatible support in Subnet-EVM to provide the first standard implementation of AWM in production on the Avalanche Network. ## Specification The specification will be broken down into the Solidity interface of the Warp Precompile, a Golang example implementation, the predicate verification, and the proposed gas costs for the Warp Precompile. The Warp Precompile address is `0x0200000000000000000000000000000000000005`. ### Precompile Solidity Interface ```solidity // (c) 2022-2023, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. // SPDX-License-Identifier: MIT pragma solidity ^0.8.0; struct WarpMessage { bytes32 sourceChainID; address originSenderAddress; bytes payload; } struct WarpBlockHash { bytes32 sourceChainID; bytes32 blockHash; } interface IWarpMessenger { event SendWarpMessage(address indexed sender, bytes32 indexed messageID, bytes message); // sendWarpMessage emits a request for the subnet to send a warp message from [msg.sender] // with the specified parameters. // This emits a SendWarpMessage log from the precompile. When the corresponding block is accepted // the Accept hook of the Warp precompile is invoked with all accepted logs emitted by the Warp // precompile. // Each validator then adds the UnsignedWarpMessage encoded in the log to the set of messages // it is willing to sign for an off-chain relayer to aggregate Warp signatures. function sendWarpMessage(bytes calldata payload) external returns (bytes32 messageID); // getVerifiedWarpMessage parses the pre-verified warp message in the // predicate storage slots as a WarpMessage and returns it to the caller. // If the message exists and passes verification, returns the verified message // and true. // Otherwise, returns false and the empty value for the message. function getVerifiedWarpMessage(uint32 index) external view returns (WarpMessage calldata message, bool valid); // getVerifiedWarpBlockHash parses the pre-verified WarpBlockHash message in the // predicate storage slots as a WarpBlockHash message and returns it to the caller. // If the message exists and passes verification, returns the verified message // and true. // Otherwise, returns false and the empty value for the message. function getVerifiedWarpBlockHash( uint32 index ) external view returns (WarpBlockHash calldata warpBlockHash, bool valid); // getBlockchainID returns the snow.Context BlockchainID of this chain. // This blockchainID is the hash of the transaction that created this blockchain on the P-Chain // and is not related to the Ethereum ChainID. function getBlockchainID() external view returns (bytes32 blockchainID); } ``` ### Warp Predicates and Pre-Verification Signed Avalanche Warp Messages are encoded in the [EIP-2930 Access List](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-2930.md) of a transaction, so that they can be pre-verified before executing the transactions in the block. The access list can specify any number of access tuples: a pair of an address and an array of storage slots in EIP-2930. Warp Predicate verification borrows this functionality to encode signed warp messages according to the serialization format defined [here](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/predicate/Predicate.md). Each Warp specific access tuple included in the access list specifies the Warp Precompile address as the address. The first tuple that specifies the Warp Precompile address is considered to be at index. Each subsequent access tuple that specifies the Warp Precompile address increases the Warp Message index by 1. Access tuples that specify any other address are not included in calculating the index for a specific warp message. Avalanche Warp Messages are pre-verified (prior to block execution), and outputs a bitset for each transaction where a 1 indicates an Avalanche Warp Message that failed verification at that index. Throughout the EVM execution, the Warp Precompile checks the status of the resulting bit set to determine whether pre-verified messages are considered valid. This has the additional benefit of encoding the Warp pre-verification results in the block, so that verifying a historical block can use the encoded results instead of needing to access potentially old P-Chain state. The result bitset is encoded in the block according to the predicate result specification [here](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/predicate/Results.md). Each Warp Message in the access list is charged gas to pay for verifying the Warp Message (gas costs are covered below) and is verified with the following steps (see [here](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/config.go#L218) for reference implementation): 1. Unpack the predicate bytes 2. Parse the signed Avalanche Warp Message 3. Verify the signature according to the AWM spec in AvalancheGo [here](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/config.go#L218) (the quorum numerator/denominator for the C-Chain is 67/100 and is configurable in Subnet-EVM) ### Precompile Implementation All types, events, and function arguments/outputs are encoded using the ABI package according to the official [Solidity ABI Specification](https://docs.soliditylang.org/en/latest/abi-spec.html). When the precompile is invoked with a given `calldata` argument, the first four bytes (`calldata[0:4]`) are read as the [function selector](https://docs.soliditylang.org/en/latest/abi-spec.html#function-selector). If the function selector matches the function selector of one of the functions defined by the Solidity interface, the contract invokes the corresponding execution function with the remaining calldata ie. `calldata[4:]`. For the full specification of the execution functions defined in the Solidity interface, see the reference implementation here: - [sendWarpMessage](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/contract.go#L226) - [getVerifiedWarpMessage](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/contract.go#L187) - [getVerifiedWarpBlockHash](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/contract.go#L145) - [getBlockchainID](https://github.com/ava-labs/subnet-evm/blob/v0.5.9/x/warp/contract.go#L96) ### Gas Costs The Warp Precompile charges gas during the verification of included Avalanche Warp Messages, which is included in the intrinsic gas cost of the transaction, and during the execution of the precompile. #### Verification Gas Costs Pre-verification charges the following costs for each Avalanche Warp Message: - GasCostPerSignatureVerification: 20000 - GasCostPerWarpMessageBytes: 100 - GasCostPerWarpSigner: 500 These numbers were determined experimentally using the benchmarks available [here](https://github.com/ava-labs/subnet-evm/blob/master/x/warp/predicate_test.go#L687) to target approximately the same mgas/s as existing precompile benchmarks in the EVM, which ranges between 50-200 mgas/s. In addition to the benchmarks, the following assumptions and goals were taken into account: - BLS Public Key Aggregation is extremely fast, resulting in charging more for the base cost of a single BLS Multi-Signature Verification than for adding an additional public key - The cost per byte included in the transaction should be strictly higher for including Avalanche Warp Messages than via transaction calldata, so that the Warp Precompile does not change the worst case maximum block size #### Execution Gas Costs The execution gas costs were determined by summing the cost of the EVM operations that are performed throughout the execution of the precompile with special consideration for added functionality that does not have an existing corollary within the EVM. ##### sendWarpMessage `sendWarpMessage` charges a base cost of 41,500 gas + 8 gas / payload byte This is comprised of charging for the following components: - 375 gas / log operation - 3 topics * 375 gas / topic - 20k gas to produce and serve a BLS Signature - 20k gas to store the Unsigned Warp Message - 8 gas / payload byte This charges 20k gas for storing an Unsigned Warp Message although the message is stored in an independent key-value database instead of the active state. This makes it less expensive to store, so 20k gas is a conservative estimate. Additionally, the cost of serving valid signatures is significantly cheaper than serving state sync and bootstrapping requests, so the cost to validators of serving signatures over time is not considered a significant concern. `sendWarpMessage` also charges for the log operation it includes commensurate with the gas cost of a standard log operation in the EVM. A single `SendWarpMessage` log is charged: - 375 gas base cost - 375 gas per topic (`eventID`, `sender`, `messageID`) - 8 byte per / payload byte encoded in the `message` field Topics are indexed fields encoded as 32 byte values to support querying based on given specified topic values. ##### getBlockchainID `getBlockchainID` charges 2 gas to serve an already in-memory 32 byte valu commensurate with existing in-memory operations. ##### getVerifiedWarpBlockHash / getVerifiedWarpMessage `GetVerifiedWarpMessageBaseCost` charges 2 gas for serving a Warp Message (either payload type). Warp message are already in-memory, so it charges 2 gas for access. `GasCostPerWarpMessageBytes` charges 100 gas per byte of the Avalanche Warp Message that is unpacked into a Solidity struct. ## Backwards Compatibility Existing EVM opcodes and precompiles are not modified by activating Avalanche Warp Messaging in the EVM. This is an additive change to activate a Warp Precompile on the Avalanche C-Chain and can be scheduled for activation in any VM running on Avalanche Subnets that are capable of sending / verifying the specified payload types. ## Reference Implementation A full reference implementation can be found in Subnet-EVM v0.5.9 [here](https://github.com/ava-labs/subnet-evm/tree/v0.5.9/x/warp). ## Security Considerations Verifying an Avalanche Warp Message requires reading the source subnet's validator set at the P-Chain height specified in the [Snowman++ Block Extension](https://github.com/ava-labs/avalanchego/blob/v1.10.15/vms/proposervm/README.md#snowman-block-extension). The Avalanche PlatformVM provides the current state of the Avalanche P-Chain and maintains reverse diff-layers in order to compute Subnets' validator sets at historical points in time. As a result, verifying a historical Avalanche Warp Message that references an old P-Chain height requires applying diff-layers from the current state back to the referenced P-Chain height. As Subnets and the P-Chain continue to produce and accept new blocks, verifying the Warp Messages in historical blocks becomes increasingly expensive. To efficiently handle historical blocks containing Avalanche Warp Messages, the EVM uses the result bitset encoded in the block to determine the validity of Avalanche Warp Messages without requiring a historical P-Chain state lookup. This is considered secure because the network already verified the Avalanche Warp Messages when they were originally verified and accepted. ## Open Questions _How should validator set lookups in Warp Message verification be effectively charged for gas?_ The verification cost of performing a validator set lookup on the P-Chain is currently excluded from the implementation. The cost of this lookup is variable depending on how old the referenced P-Chain height is from the perspective of each validator. [Ongoing work](https://github.com/ava-labs/avalanchego/pull/1611) can parallelize P-Chain validator set lookups and message verification to reduce the impact on block verification latency to be negligible and reduce costs to reflect the additional bandwidth of encoding Avalanche Warp Messages in the transaction. ## Acknowledgements Avalanche Warp Messaging and this effort to integrate it into the EVM has been a monumental effort. Thanks to all of the contributors who contributed their ideas, feedback, and development to this effort. @stephenbuttolph @patrick-ogrady @michaelkaplan13 @minghinmatthewlam @cam-schultz @xanderdunn @darioush @ceyonur ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-31: Enable Subnet Ownership Transfer (/docs/acps/31-enable-subnet-ownership-transfer) --- title: "ACP-31: Enable Subnet Ownership Transfer" description: "Details for Avalanche Community Proposal 31: Enable Subnet Ownership Transfer" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/31-enable-subnet-ownership-transfer/README.md --- | ACP | 31 | | :--- | :--- | | **Title** | Enable Subnet Ownership Transfer | | **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) | | **Status** | Activated | | **Track** | Standards | ## Abstract Allow the current owner of a Subnet to transfer ownership to a new owner. ## Motivation Once a Subnet is created on the P-chain through a [CreateSubnetTx](https://github.com/ava-labs/avalanchego/blob/v1.10.15/vms/platformvm/txs/create_subnet_tx.go#L14-L19), the `Owner` of the subnet is currently immutable. Subnet operators may want to transition ownership of the Subnet to a new owner for a number of reasons, not least of all being rotating their control key(s) periodically. ## Specification Implement a new transaction type (`TransferSubnetOwnershipTx`) that: 1. Takes in a `Subnet` 2. Verifies that the `SubnetAuth` has the right to remove the node from the subnet by verifying it against the `Owner` field in the `CreateSubnetTx` that created the `Subnet`. 3. Takes in a new `Owner` and assigning it as the new owner of `Subnet` This transaction type should have the following format (code below is presented in Golang): ```go type TransferSubnetOwnershipTx struct { // Metadata, inputs and outputs BaseTx `serialize:"true"` // ID of the subnet this tx is modifying Subnet ids.ID `serialize:"true" json:"subnetID"` // Proves that the issuer has the right to remove the node from the subnet. SubnetAuth verify.Verifiable `serialize:"true" json:"subnetAuthorization"` // Who is now authorized to manage this subnet Owner fx.Owner `serialize:"true" json:"newOwner"` } ``` This transaction type should have type ID `0x21` in codec version `0x00`. This transaction type should have a fee of `0.001 AVAX`, equivalent to adding a subnet validator/delegator. ## Backwards Compatibility Adding a new transaction type is an execution change and requires a mandatory upgrade for activation. Implementors must take care to reject this transaction prior to activation. This ACP only details the specification of the `TransferSubnetOwnershipTx` type. ## Reference Implementation An implementation of `TransferSubnetOwnershipTx` was created [here](https://github.com/ava-labs/avalanchego/pull/2178) and subsequently merged into AvalancheGo. Since the "D" Upgrade is not activated, this transaction will be rejected by AvalancheGo. If modifications are made to the specification of the transaction as part of the ACP process, the code must be updated prior to activation. ## Security Considerations No security considerations. ## Open Questions No open questions. ## Acknowledgements Thank you [@friskyfoxdk](https://github.com/friskyfoxdk) for filing an [issue](https://github.com/ava-labs/avalanchego/issues/1946) requesting this feature. Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@abi87](https://github.com/abi87) for their feedback on the reference implementation. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-41: Remove Pending Stakers (/docs/acps/41-remove-pending-stakers) --- title: "ACP-41: Remove Pending Stakers" description: "Details for Avalanche Community Proposal 41: Remove Pending Stakers" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/41-remove-pending-stakers/README.md --- | ACP | 41 | | :--- | :--- | | **Title** | Remove Pending Stakers | | **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) | | **Status** | Activated | | **Track** | Standards | ## Abstract Remove user-specified `StartTime` for stakers. Start the staking period for a staker as soon as their staking transaction is accepted. This greatly reduces the computational load on the P-chain, increasing the efficiency of all Avalanche Network validators. ## Motivation Stakers currently set a `StartTime` for their staking period. This means that Avalanche Network Clients, like AvalancheGo, need to maintain a pending set of all stakers that have not yet started. This places a nontrivial amount of work on the P-chain: - When a new delegator transaction is verified, the pending set needs to be checked to ensure that the validator they are delegating to will not exceed `MaxValidatorStake` while they are active - When a new staker transaction is accepted, it gets added to the pending set - When time is advanced on the P-chain, any stakers in the pending set whose `StartTime <= CurrentTime` need to be moved to the current set By immediately starting every staker on acceptance, the validators do not have to do the above work when validating the P-chain. `MaxValidatorStake` will become an `O(1)` operation as only the current stake of the validator needs to be checked. The pending set can be fully removed. ## Specification 1. When adding a new staker, the current on-chain time should be used for the staker's start time. 2. When determining when to remove the staker from the staker set, the `EndTime` specified in the transaction should continue to be used. Staking transactions should now be rejected if it does not satisfy `MinStakeDuration <= EndTime - CurrentTime <= MaxStakeDuration`. `StartTime` will no longer be validated. ## Backwards Compatibility Modifying the state transition of a transaction type is an execution change and requires a mandatory upgrade for activation. Implementors must take care to not alter the execution behavior prior to activation. This ACP only details the new state transition. Current wallet implementations will continue to work as-is post-activation of this ACP since no transaction formats are modified or added. Wallet implementations may run into issues with their txs being rejected as a result of this ACP if `EndTime >= CurrentChainTime + MaxStakeDuration`. `CurrentChainTime` is guaranteed to be >= the latest block timestamp on the P-chain. ## Reference Implementation A reference implementation has not been created for this ACP since it deals with state management. Each ANC will need to adjust their execution step to follow the Specification detailed above. For AvalancheGo, this work is tracked in this PR: https://github.com/ava-labs/avalanchego/pull/2175 If modifications are made to the specification of the new execution behavior as part of the ACP process, the code must be updated prior to activation. ## Security Considerations No security considerations. ## Open Questions _How will stakers stake for `MaxStakeDuration` if they cannot determine their `StartTime`?_ As mentioned above, the beginning of your staking period is the block acceptance timestamp. Unless you can accurately predict the block timestamp, you will *not* be able to fully stake for `MaxStakeDuration`. This is an explicit trade-off to guarantee that stakers will receive their original stake + any staking rewards at `EndTime`. Delegators can maximize their staking period by setting the same `EndTime` as the Validator they are delegating to. ## Acknowledgements Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@abi87](https://github.com/abi87) for their feedback on these ideas. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-62: Disable Addvalidatortx And Adddelegatortx (/docs/acps/62-disable-addvalidatortx-and-adddelegatortx) --- title: "ACP-62: Disable Addvalidatortx And Adddelegatortx" description: "Details for Avalanche Community Proposal 62: Disable Addvalidatortx And Adddelegatortx" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/62-disable-addvalidatortx-and-adddelegatortx/README.md --- | ACP | 62 | | :--- | :--- | | **Title** | Disable `AddValidatorTx` and `AddDelegatorTx` | | **Author(s)** | Jacob Everly ([@JacobEv3rly](https://twitter.com/JacobEv3rly)), Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) | | **Status** | Activated | | **Track** | Standards | ## Abstract Disable `AddValidatorTx` and `AddDelegatorTx` to push all new stakers to use `AddPermissionlessValidatorTx` and `AddPermissionlessDelegatorTx`. `AddPermissionlessValidatorTx` requires validators to register a BLS key. Wide adoption of registered BLS keys accelerates the timeline for future P-Chain upgrades. Additionally, this reduces the number of ways to participate in Primary Network validation from two to one. ## Motivation `AddPermissionlessValidatorTx` and `AddPermissionlessDelegatorTx` were activated on the Avalanche Network in October 2022 with Banff (v1.9.0). This unlocked the ability for Subnet creators to activate Proof-of-Stake validation using their own token on their own Subnet. See more details about Banff [here](https://medium.com/avalancheavax/banff-elastic-subnets-44042f41e34c). These new transaction types can also be used to register a Primary Network validator, leaving two redundant transactions: `AddValidatorTx` and `AddDelegatorTx`. [`AddPermissionlessDelegatorTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.18/vms/platformvm/txs/add_permissionless_delegator_tx.go#L25-L37) contains the same fields as [`AddDelegatorTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.18/vms/platformvm/txs/add_delegator_tx.go#L29-L39) with an additional `Subnet` field. [`AddPermissionlessValidatorTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.18/vms/platformvm/txs/add_permissionless_validator_tx.go#L35-L59) contains the same fields as [`AddValidatorTx`](https://github.com/ava-labs/avalanchego/blob/v1.10.18/vms/platformvm/txs/add_validator_tx.go#L29-L42) with additional `Subnet` and `Signer` fields. `RewardsOwner` was also split into `ValidationRewardsOwner` and `DelegationRewardsOwner` letting validators divert rewards they receive from delegators into a separate rewards owner. By disabling support of `AddValidatorTx`, all new validators on the Primary Network must use `AddPermissionlessValidatorTx` and register a BLS key with their NodeID. As more validators attach BLS keys to their nodes, future upgrades using these BLS keys can be activated through the ACP process. BLS keys can be used to efficiently sign a common message via [Public Key Aggregation](https://crypto.stanford.edu/~dabo/pubs/papers/BLSmultisig.html). Applications of this include, but are not limited to: - **Arbitrary Subnet Rewards**: The P-Chain currently restricts Elastic Subnets to follow the reward curve defined in a `TransformSubnetTx`. With sufficient BLS key adoption, Elastic Subnets can define their own reward curve and reward conditions. The P-Chain can be modified to take in a message indicating if a Subnet validator should be rewarded with how many tokens signed with a BLS Multi-Signature. - **Subnet Attestations**: Elastic Subnets can attest to the state of their Subnet with a BLS Multi-Signature. This can enable clients to fetch the current state of the Subnet without syncing the entire Subnet. `StateSync` enables clients to download chain state from peers up to a recent block near tip. However, it is up to the client to query these peers and resolve any potential conflicts in the responses. With Subnet Attestations, clients can query an API node to prove information about a Subnet without querying the Subnet's validators. This can especially be useful for [Subnet-Only Validators](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/62-disable-addvalidatortx-and-adddelegatortx/13-subnet-only-validators.md) to prove information about the C-Chain. To accelerate future BLS-powered advancements in the Avalanche Network, this ACP aims to disable `AddValidatorTx` and `AddDelegatorTx` in Durango. ## Specification `AddValidatorTx` and `AddDelegatorTx` should be marked as dropped when added to the mempool after activation. Any blocks including these transactions should be considered invalid. ## Backwards Compatibility Disabling a transaction type is an execution change and requires a mandatory upgrade for activation. Implementers must take care to not alter the execution behavior prior to activation. After this ACP is activated, any new issuance of `AddValidatorTx` or `AddDelegatorTx` will be considered invalid and dropped by the network. Any consumers of these transactions must transition to using `AddPermissionlessValidatorTx` and `AddPermissionlessDelegatorTx` to participate in Primary Network validation. The [Avalanche Ledger App](https://github.com/LedgerHQ/app-avalanche) supports both of these transaction types. Note that `AddSubnetValidatorTx` and `RemoveSubnetValidatorTx` are unchanged by this ACP. ## Reference Implementation An implementation disabling `AddValidatorTx` and `AddDelegatorTx` was created [here](https://github.com/ava-labs/avalanchego/pull/2662). Until activation, these transactions will continue to be accepted by AvalancheGo. If modifications are made to the specification as part of the ACP process, the code must be updated prior to activation. ## Security Considerations No security considerations. ## Open Questions ## Acknowledgements Thanks to [@StephenButtolph](https://github.com/StephenButtolph) and [@patrick-ogrady](https://github.com/patrick-ogrady) for their feedback on these ideas. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-75: Acceptance Proofs (/docs/acps/75-acceptance-proofs) --- title: "ACP-75: Acceptance Proofs" description: "Details for Avalanche Community Proposal 75: Acceptance Proofs" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/75-acceptance-proofs/README.md --- | ACP | 75 | | :--- | :--- | | **Title** | Acceptance Proofs | | **Author(s)** | Joshua Kim | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/82)) | | **Track** | Standards | ## Abstract Introduces support for a proof of a block’s acceptance in consensus. ## Motivation Subnets are able to prove arbitrary events using warp messaging, but native support for proving block acceptance at the protocol layer enables more utility. Acceptance proofs are introduced to prove that a block has been accepted by a subnet. One example use case for acceptance proofs is to provide stronger fault isolation guarantees from the primary network to subnets. Subnets use the [ProposerVM](https://github.com/ava-labs/avalanchego/blob/416fbdf1f783c40f21e7009a9f06d192e69ba9b5/vms/proposervm/README.md) to implement soft leader election for block proposal. The ProposerVM determines the block producer schedule from a randomly shuffled validator set at a specified P-Chain block height. Validators are therefore required to have the P-Chain block referenced in a block's header to verify the block producer against the expected block producer schedule. If a block's header specifies a P-Chain height that has not been accepted yet, the block is treated as invalid. If a block referencing an unknown P-Chain height was produced virtuously, it is expected that the validator will eventually discover the block as its P-Chain height advances and accept the block. If many validators disagree about the current tip of the P-Chain, it can lead to a liveness concern on the subnet where block production entirely stalls. In practice, this almost never occurs because nodes produce blocks with a lagging P-Chain height because it’s likely that most nodes will have accepted a sufficiently stale block. This however, relies on an assumption that validators are constantly making progress in consensus on the P-Chain to prevent the subnet from stalling. This leaves an open concern where the P-Chain stalling on a node would prevent it from verifying any blocks, leading to a subnet unable to produce blocks if many validators stalled at different P-Chain heights. --- Figure 1: A Validator that has synced P-Chain blocks `A` and `B` fails verification of a block proposed at block `C`. figure 1 --- We introduce "acceptance proofs", so that a peer can verify any block accepted by consensus. In the aforementioned use-case, if a P-Chain block is unknown by a peer, it can request the block and proof at the provided height from a peer. If a block's proof is valid, the block can be executed to advance the local P-Chain and verify the proposed subnet block. Peers can request blocks from any peer without requiring consensus locally or communication with a validator. This has the added benefit of reducing the number of required connections and p2p message load served by P-Chain validators. --- Figure 2: A Validator is verifying a subnet’s block `Z` which references an unknown P-Chain block `C` in its block header figure 2 Figure 3: A Validator requests the blocks and proofs for `B` and `C` from a peer figure 3 Figure 4: The Validator accepts the P-Chain blocks and is now able to verify `Z` figure 4 --- ## Specification Note: The following is pseudocode. ### P2P #### Aggregation ```diff + message GetAcceptanceSignatureRequest { + bytes chain_id = 1; + uint32 request_id = 2; + bytes block_id = 3; + } ``` The `GetAcceptanceSignatureRequest` message is sent to a peer to request their signature for a given block id. ```diff + message GetAcceptanceSignatureResponse { + bytes chain_id = 1; + uint32 request_id = 2; + bytes bls_signature = 3; + } ``` `GetAcceptanceSignatureResponse` is sent to a peer as a response for `GetAcceptanceSignatureRequest`. `bls_signature` is the peer’s signature using their registered primary network BLS staking key over the requested `block_id`. An empty `bls_signature` field indicates that the block was not accepted yet. ## Security Considerations Nodes that bootstrap using state sync may not have the entire history of the P-Chain and therefore will not be able to provide the entire history for a block that is referenced in a block that they propose. This would be needed to unblock a node that is attempting to fast-forward their P-Chain, as they require the entire ancestry between their current accepted tip and the block they are attempting to forward to. It is assumed that nodes will have some minimum amount of recent state so that the requester can eventually be unblocked by retrying, as only one node with the requested ancestry is required to unblock the requester. An alternative is to make a churn assumption and validate the proposed block's proof with a stale validator set to avoid complexity, but this introduces more security concerns. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-77: Reinventing Subnets (/docs/acps/77-reinventing-subnets) --- title: "ACP-77: Reinventing Subnets" description: "Details for Avalanche Community Proposal 77: Reinventing Subnets" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/77-reinventing-subnets/README.md --- | ACP | 77 | | :------------ | :---------------------------------------------------------------------------------------- | | **Title** | Reinventing Subnets | | **Author(s)** | Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)) | | **Status** | Activated ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/78)) | | **Track** | Standards | | **Replaces** | [ACP-13](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/13-subnet-only-validators/README.md) | ## Abstract Overhaul Subnet creation and management to unlock increased flexibility for Subnet creators by: - Separating Subnet validators from Primary Network validators (Primary Network Partial Sync, Removal of 2000 $AVAX requirement) - Moving ownership of Subnet validator set management from P-Chain to Subnets (ERC-20/ERC-721/Arbitrary Staking, Staking Reward Management) - Introducing a continuous P-Chain fee mechanism for Subnet validators (Continuous Subnet Staking) This ACP supersedes [ACP-13](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/13-subnet-only-validators/README.md) and borrows some of its language. ## Motivation Each node operator must stake at least 2000 $AVAX ($70k at time of writing) to first become a Primary Network validator before they qualify to become a Subnet validator. Most Subnets aim to launch with at least 8 Subnet validators, which requires staking 16000 $AVAX ($560k at time of writing). All Subnet validators, to satisfy their role as Primary Network validators, must also [allocate 8 AWS vCPU, 16 GB RAM, and 1 TB storage](https://github.com/ava-labs/avalanchego/blob/master/README.md#installation) to sync the entire Primary Network (X-Chain, P-Chain, and C-Chain) and participate in its consensus, in addition to whatever resources are required for each Subnet they are validating. Regulated entities that are prohibited from validating permissionless, smart contract-enabled blockchains (like the C-Chain) cannot launch a Subnet because they cannot opt-out of Primary Network Validation. This deployment blocker prevents a large cohort of Real World Asset (RWA) issuers from bringing unique, valuable tokens to the Avalanche Ecosystem (that could move between C-Chain <-> Subnets using Avalanche Warp Messaging/Teleporter). A widely validated Subnet that is not properly metered could destabilize the Primary Network if usage spikes unexpectedly. Underprovisioned Primary Network validators running such a Subnet may exit with an OOM exception, see degraded disk performance, or find it difficult to allocate CPU time to P/X/C-Chain validation. The inverse also holds for Subnets with the Primary Network (where some undefined behavior could bring a Subnet offline). Although the fee paid to the Primary Network to operate a Subnet does not go up with the amount of activity on the Subnet, the fixed, upfront cost of setting up a Subnet validator on the Primary Network deters new projects that prefer smaller, even variable, costs until demand is observed. _Unlike L2s that pay some increasing fee (usually denominated in units per transaction byte) to an external chain for data availability and security as activity scales, Subnets provide their own security/data availability and the only cost operators must pay from processing more activity is the hardware cost of supporting additional load._ Elastic Subnets, introduced in [Banff](https://medium.com/avalancheavax/banff-elastic-subnets-44042f41e34c), enabled Subnet creators to activate Proof-of-Stake validation and uptime-based rewards using their own token. However, this token is required to be an ANT (created on the X-Chain) and locked on the P-Chain. All staking rewards were distributed on the P-Chain with the reward curve being defined in the `TransformSubnetTx` and, once set, was unable to be modified. With no Elastic Subnets live on Mainnet, it is clear that Permissionless Subnets as they stand today could be more desirable. There are many successful Permissioned Subnets in production but many Subnet creators have raised the above as points of concern. In summary, the Avalanche community could benefit from a more flexible and affordable mechanism to launch Permissionless Subnets. ### A Note on Nomenclature Avalanche Subnets are subnetworks validated by a subset of the Primary Network validator set. The new network creation flow outlined in this ACP does not require any intersection between the new network's validator set and the Primary Network's validator set. Moreover, the new networks have greater functionality and sovereignty than Subnets. To distinguish between these two kinds of networks, the community has been referring to these new networks as _Avalanche Layer 1s_, or L1s for short. All networks created through the old network creation flow will continue to be referred to as Avalanche Subnets. ## Specification At a high-level, L1s can manage their validator sets externally to the P-Chain by setting the blockchain ID and address of their _validator manager_. The P-Chain will consume Warp messages that modify the L1's validator set. To confirm modification of the L1's validator set, the P-Chain will also produce Warp messages. L1 validators are not required to validate the Primary Network, and do not have the same 2000 $AVAX stake requirement that Subnet validators have. To maintain an active L1 validator, a continuous fee denominated in $AVAX is assessed. L1 validators are only required to sync the P-Chain (not X/C-Chain) in order to track validator set changes and support cross-L1 communication. ### P-Chain Warp Message Payloads To enable management of an L1's validator set externally to the P-Chain, Warp message verification will be added to the [`PlatformVM`](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm). For a Warp message to be considered valid by the P-Chain, at least 67% of the `sourceChainID`'s weight must have participated in the aggregate BLS signature. This is equivalent to the threshold set for the C-Chain. A future ACP may be proposed to support modification of this threshold on a per-L1 basis. The following Warp message payloads are introduced on the P-Chain: - `SubnetToL1ConversionMessage` - `RegisterL1ValidatorMessage` - `L1ValidatorRegistrationMessage` - `L1ValidatorWeightMessage` The method of requesting signatures for these messages is left unspecified. A viable option for supporting this functionality is laid out in [ACP-118](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/118-warp-signature-request/README.md) with the `SignatureRequest` message. All node IDs contained within the message specifications are represented as variable length arrays such that they can support new node IDs types should the P-Chain add support for them in the future. The serialization of each of these messages is as follows. #### `SubnetToL1ConversionMessage` The P-Chain can produce a `SubnetToL1ConversionMessage` for consumers (i.e. validator managers) to be aware of the initial validator set. The following serialization is defined as the `ValidatorData`: | Field | Type | Size | | -------------: | ---------: | -----------------------: | | `nodeID` | `[]byte` | 4 + len(`nodeID`) bytes | | `blsPublicKey` | `[48]byte` | 48 bytes | | `weight` | `uint64` | 8 bytes | | | | 60 + len(`nodeID`) bytes | The following serialization is defined as the `ConversionData`: | Field | Type | Size | | ---------------: | ----------------: | ---------------------------------------------------------: | | `codecID` | `uint16` | 2 bytes | | `subnetID` | `[32]byte` | 32 bytes | | `managerChainID` | `[32]byte` | 32 bytes | | `managerAddress` | `[]byte` | 4 + len(`managerAddress`) bytes | | `validators` | `[]ValidatorData` | 4 + sum(`validatorLengths`) bytes | | | | 74 + len(`managerAddress`) + sum(`validatorLengths`) bytes | - `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000` - `sum(validatorLengths)` is the sum of the lengths of `ValidatorData` serializations included in `validators`. - `subnetID` identifies the Subnet that is being converted to an L1 (described further below). - `managerChainID` and `managerAddress` identify the validator manager for the newly created L1. This is the (blockchain ID, address) tuple allowed to send Warp messages to modify the L1's validator set. - `validators` are the initial continuous-fee-paying validators for the given L1. The `SubnetToL1ConversionMessage` is specified as an `AddressedCall` with `sourceChainID` set to the P-Chain ID, the `sourceAddress` set to an empty byte array, and a payload of: | Field | Type | Size | | -------------: | ---------: | -------: | | `codecID` | `uint16` | 2 bytes | | `typeID` | `uint32` | 4 bytes | | `conversionID` | `[32]byte` | 32 bytes | | | | 38 bytes | - `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000` - `typeID` is the payload type identifier and is `0x00000000` for this message - `conversionID` is the SHA256 hash of the `ConversionData` from a given `ConvertSubnetToL1Tx` #### `RegisterL1ValidatorMessage` The P-Chain can consume a `RegisterL1ValidatorMessage` from validator managers through a `RegisterL1ValidatorTx` to register an addition to the L1's validator set. The following is the serialization of a `PChainOwner`: | Field | Type | Size | | ----------: | -----------: | -------------------------------: | | `threshold` | `uint32` | 4 bytes | | `addresses` | `[][20]byte` | 4 + len(`addresses`) \\* 20 bytes | | | | 8 + len(`addresses`) \\* 20 bytes | - `threshold` is the number of `addresses` that must provide a signature for the `PChainOwner` to authorize an action. - Validation criteria: - If `threshold` is `0`, `addresses` must be empty - `threshold` <= len(`addresses`) - Entries of `addresses` must be unique and sorted in ascending order The `RegisterL1ValidatorMessage` is specified as an `AddressedCall` with a payload of: | Field | Type | Size | | ----------------------: | ------------: | ------------------------------------------------------------------------: | | `codecID` | `uint16` | 2 bytes | | `typeID` | `uint32` | 4 bytes | | `subnetID` | `[32]byte` | 32 bytes | | `nodeID` | `[]byte` | 4 + len(`nodeID`) bytes | | `blsPublicKey` | `[48]byte` | 48 bytes | | `expiry` | `uint64` | 8 bytes | | `remainingBalanceOwner` | `PChainOwner` | 8 + len(`addresses`) \\* 20 bytes | | `disableOwner` | `PChainOwner` | 8 + len(`addresses`) \\* 20 bytes | | `weight` | `uint64` | 8 bytes | | | | 122 + len(`nodeID`) + (len(`addresses1`) + len(`addresses2`)) \\* 20 bytes | - `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000` - `typeID` is the payload type identifier and is `0x00000001` for this payload - `subnetID`, `nodeID`, `weight`, and `blsPublicKey` are for the validator being added - `expiry` is the time at which this message becomes invalid. As of a P-Chain timestamp `>= expiry`, this Avalanche Warp Message can no longer be used to add the `nodeID` to the validator set of `subnetID` - `remainingBalanceOwner` is the P-Chain owner where leftover $AVAX from the validator's Balance will be issued to when this validator it is removed from the validator set. - `disableOwner` is the only P-Chain owner allowed to disable the validator using `DisableL1ValidatorTx`, specified below. #### `L1ValidatorRegistrationMessage` The P-Chain can produce an `L1ValidatorRegistrationMessage` for consumers to verify that a validation period has either begun or has been invalidated. The `L1ValidatorRegistrationMessage` is specified as an `AddressedCall` with `sourceChainID` set to the P-Chain ID, the `sourceAddress` set to an empty byte array, and a payload of: | Field | Type | Size | | -------------: | ---------: | -------: | | `codecID` | `uint16` | 2 bytes | | `typeID` | `uint32` | 4 bytes | | `validationID` | `[32]byte` | 32 bytes | | `registered` | `bool` | 1 byte | | | | 39 bytes | - `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000` - `typeID` is the payload type identifier and is `0x00000002` for this message - `validationID` identifies the validator for the message - `registered` is a boolean representing the status of the `validationID`. If true, the `validationID` corresponds to a validator in the current validator set. If false, the `validationID` does not correspond to a validator in the current validator set, and never will in the future. #### `L1ValidatorWeightMessage` The P-Chain can consume an `L1ValidatorWeightMessage` through a `SetL1ValidatorWeightTx` to update the weight of an existing validator. The P-Chain can also produce an `L1ValidatorWeightMessage` for consumers to verify that the validator weight update has been effectuated. The `L1ValidatorWeightMessage` is specified as an `AddressedCall` with the following payload. When sent from the P-Chain, the `sourceChainID` is set to the P-Chain ID, and the `sourceAddress` is set to an empty byte array. | Field | Type | Size | | -------------: | ---------: | -------: | | `codecID` | `uint16` | 2 bytes | | `typeID` | `uint32` | 4 bytes | | `validationID` | `[32]byte` | 32 bytes | | `nonce` | `uint64` | 8 bytes | | `weight` | `uint64` | 8 bytes | | | | 54 bytes | - `codecID` is the codec version used to serialize the payload, and is hardcoded to `0x0000` - `typeID` is the payload type identifier and is `0x00000003` for this message - `validationID` identifies the validator for the message - `nonce` is a strictly increasing number that denotes the latest validator weight update and provides replay protection for this transaction - `weight` is the new `weight` of the validator ### New P-Chain Transaction Types Both before and after this ACP, to create a Subnet, a `CreateSubnetTx` must be issued on the P-Chain. This transaction includes an `Owner` field which defines the key that today can be used to authorize any validator set additions (`AddSubnetValidatorTx`) or removals (`RemoveSubnetValidatorTx`). To be considered a permissionless network, or Avalanche Layer 1: - This `Owner` key must no longer have the ability to modify the validator set. - New transaction types must support modification of the validator set via Warp messages. The following new transaction types are introduced on the P-Chain to support this functionality: - `ConvertSubnetToL1Tx` - `RegisterL1ValidatorTx` - `SetL1ValidatorWeightTx` - `DisableL1ValidatorTx` - `IncreaseL1ValidatorBalanceTx` #### `ConvertSubnetToL1Tx` To convert a Subnet into an L1, a `ConvertSubnetToL1Tx` must be issued to set the `(chainID, address)` pair that will manage the L1's validator set. The `Owner` key defined in `CreateSubnetTx` must provide a signature to authorize this conversion. The `ConvertSubnetToL1Tx` specification is: ```go type PChainOwner struct { // The threshold number of `Addresses` that must provide a signature in order for // the `PChainOwner` to be considered valid. Threshold uint32 `json:"threshold"` // The 20-byte addresses that are allowed to sign to authenticate a `PChainOwner`. // Note: It is required for: // - len(Addresses) == 0 if `Threshold` is 0. // - len(Addresses) >= `Threshold` // - The values in Addresses to be sorted in ascending order. Addresses []ids.ShortID `json:"addresses"` } type L1Validator struct { // NodeID of this validator NodeID []byte `json:"nodeID"` // Weight of this validator used when sampling Weight uint64 `json:"weight"` // Initial balance for this validator Balance uint64 `json:"balance"` // [Signer] is the BLS public key and proof-of-possession for this validator. // Note: We do not enforce that the BLS key is unique across all validators. // This means that validators can share a key if they so choose. // However, a NodeID + L1 does uniquely map to a BLS key Signer signer.ProofOfPossession `json:"signer"` // Leftover $AVAX from the [Balance] will be issued to this // owner once it is removed from the validator set. RemainingBalanceOwner PChainOwner `json:"remainingBalanceOwner"` // The only owner allowed to disable this validator on the P-Chain. DisableOwner PChainOwner `json:"disableOwner"` } type ConvertSubnetToL1Tx struct { // Metadata, inputs and outputs BaseTx // ID of the Subnet to transform // Restrictions: // - Must not be the Primary Network ID Subnet ids.ID `json:"subnetID"` // BlockchainID where the validator manager lives ChainID ids.ID `json:"chainID"` // Address of the validator manager Address []byte `json:"address"` // Initial continuous-fee-paying validators for the L1 Validators []L1Validator `json:"validators"` // Authorizes this conversion SubnetAuth verify.Verifiable `json:"subnetAuthorization"` } ``` After this transaction is accepted, `CreateChainTx` and `AddSubnetValidatorTx` are disabled on the Subnet. The only action that the `Owner` key is able to take is removing Subnet validators with `RemoveSubnetValidatorTx` that had been added using `AddSubnetValidatorTx`. Unless removed by the `Owner` key, any Subnet validators added previously with an `AddSubnetValidatorTx` will continue to validate the Subnet until their [`End`](https://github.com/ava-labs/avalanchego/blob/a1721541754f8ee23502b456af86fea8c766352a/vms/platformvm/txs/validator.go#L27) time is reached. Once all Subnet validators added with `AddSubnetValidatorTx` are no longer in the validator set, the `Owner` key is powerless. `RegisterL1ValidatorTx` and `SetL1ValidatorWeightTx` must be used to manage the L1's validator set. The `validationID` for validators added through `ConvertSubnetToL1Tx` is defined as the SHA256 hash of the 36 bytes resulting from concatenating the 32 byte `subnetID` with the 4 byte `validatorIndex` (index in the `Validators` array within the transaction). Once this transaction is accepted, the P-Chain must be willing sign a `SubnetToL1ConversionMessage` with a `conversionID` corresponding to `ConversionData` populated with the values from this transaction. #### `RegisterL1ValidatorTx` After a `ConvertSubnetToL1Tx` has been accepted, new validators can only be added by using a `RegisterL1ValidatorTx`. The specification of this transaction is: ```go type RegisterL1ValidatorTx struct { // Metadata, inputs and outputs BaseTx // Balance <= sum($AVAX inputs) - sum($AVAX outputs) - TxFee. Balance uint64 `json:"balance"` // [Signer] is a BLS signature proving ownership of the BLS public key specified // below in `Message` for this validator. // Note: We do not enforce that the BLS key is unique across all validators. // This means that validators can share a key if they so choose. // However, a NodeID + L1 does uniquely map to a BLS key Signer [96]byte `json:"signer"` // A RegisterL1ValidatorMessage payload Message warp.Message `json:"message"` } ``` The `validationID` of validators added via `RegisterL1ValidatorTx` is defined as the SHA256 hash of the `Payload` of the `AddressedCall` in `Message`. When a `RegisterL1ValidatorTx` is accepted on the P-Chain, the validator is added to the L1's validator set. A `minNonce` field corresponding to the `validationID` will be stored on addition to the validator set (initially set to `0`). This field will be used when validating the `SetL1ValidatorWeightTx` defined below. This `validationID` will be used for replay protection. Used `validationID`s will be stored on the P-Chain. If a `RegisterL1ValidatorTx`'s `validationID` has already been used, the transaction will be considered invalid. To prevent storing an unbounded number of `validationID`s, the `expiry` of the `RegisterL1ValidatorMessage` is required to be no more than 24 hours in the future of the time the transaction is issued on the P-Chain. Any `validationIDs` corresponding to an expired timestamp can be flushed from the P-Chain's state. L1s are responsible for defining the procedure on how to retrieve the above information from prospective validators. An EVM-compatible L1 may choose to implement this step like so: - Use the number of tokens the user has staked into a smart contract on the L1 to determine the weight of their validator - Require the user to submit an on-chain transaction with their validator information - Generate the Warp message For a `RegisterL1ValidatorTx` to be valid, `Signer` must be a valid proof-of-possession of the `blsPublicKey` defined in the `RegisterL1ValidatorMessage` contained in the transaction. After a `RegisterL1ValidatorTx` is accepted, the P-Chain must be willing to sign an `L1ValidatorRegistrationMessage` for the given `validationID` with `registered` set to `true`. This remains the case until the time at which the validator is removed from the validator set using a `SetL1ValidatorWeightTx`, as described below. When it is known that a given `validationID` _is not and never will be_ registered, the P-Chain must be willing to sign an `L1ValidatorRegistrationMessage` for the `validationID` with `registered` set to `false`. This could be the case if the `expiry` time of the message has passed prior to the message being delivered in a `RegisterL1ValidatorTx`, or if the validator was successfully registered and then later removed. This enables the P-Chain to prove to validator managers that a validator has been removed or never added. The P-Chain must refuse to sign any `L1ValidatorRegistrationMessage` where the `validationID` does not correspond to an active validator and the `expiry` is in the future. #### `SetL1ValidatorWeightTx` `SetL1ValidatorWeightTx` is used to modify the voting weight of a validator. The specification of this transaction is: ```go type SetL1ValidatorWeightTx struct { // Metadata, inputs and outputs BaseTx // An L1ValidatorWeightMessage payload Message warp.Message `json:"message"` } ``` Applications of this transaction could include: - Increase the voting weight of a validator if a delegation is made on the L1 - Increase the voting weight of a validator if the stake amount is increased (by staking rewards for example) - Decrease the voting weight of a misbehaving validator - Remove an inactive validator The validation criteria for `L1ValidatorWeightMessage` is: - `nonce >= minNonce`. Note that `nonce` is not required to be incremented by `1` with each successive validator weight update. - When `minNonce == MaxUint64`, `nonce` must be `MaxUint64` and `weight` must be `0`. This prevents L1s from being unable to remove `nodeID` in a subsequent transaction. - If `weight == 0`, the validator being removed must not be the last one in the set. If all validators are removed, there are no valid Warp messages that can be produced to register new validators through `RegisterL1ValidatorMessage`. With no validators, block production will halt and the L1 is unrecoverable. This validation criteria serves as a guardrail against this situation. A future ACP can remove this guardrail as users get more familiar with the new L1 mechanics and tooling matures to fork an L1. When `weight != 0`, the weight of the validator is updated to `weight` and `minNonce` is updated to `nonce + 1`. When `weight == 0`, the validator is removed from the validator set. All state related to the validator, including the `minNonce` and `validationID`, are reaped from the P-Chain state. Tracking these post-removal is not required since `validationID` can never be re-initialized due to the replay protection provided by `expiry` in `RegisterL1ValidatorTx`. Any unspent $AVAX in the validator's `Balance` will be issued in a single UTXO to the `RemainingBalanceOwner` for this validator. Recall that `RemainingBalanceOwner` is specified when the validator is first added to the L1's validator set (in either `ConvertSubnetToL1Tx` or `RegisterL1ValidatorTx`). Note: There is no explicit `EndTime` for L1 validators added in a `ConvertSubnetToL1Tx` or `RegisterL1ValidatorTx`. The only time when L1 validators are removed from the L1's validator set is through this transaction when `weight == 0`. #### `DisableL1ValidatorTx` L1 validators can use `DisableL1ValidatorTx` to mark their validator as inactive. The specification of this transaction is: ```go type DisableL1ValidatorTx struct { // Metadata, inputs and outputs BaseTx // ID corresponding to the validator ValidationID ids.ID `json:"validationID"` // Authorizes this validator to be disabled DisableAuth verify.Verifiable `json:"disableAuthorization"` } ``` The `DisableOwner` specified for this validator must sign the transaction. Any unspent $AVAX in the validator's `Balance` will be issued in a single UTXO to the `RemainingBalanceOwner` for this validator. Recall that both `DisableOwner` and `RemainingBalanceOwner` are specified when the validator is first added to the L1's validator set (in either `ConvertSubnetToL1Tx` or `RegisterL1ValidatorTx`). For full removal from an L1's validator set, a `SetL1ValidatorWeightTx` must be issued with weight `0`. To do so, a Warp message is required from the L1's validator manager. However, to support the ability to claim the unspent `Balance` for a validator without authorization is critical for failed L1s. Note that this does not modify an L1's total staking weight. This transaction marks the validator as inactive, but does not remove it from the L1's validator set. Inactive validators can re-activate at any time by increasing their balance with an `IncreaseL1ValidatorBalanceTx`. L1 creators should be aware that there is no notion of `MinStakeDuration` that is enforced by the P-Chain. It is expected that L1s who choose to enforce a `MinStakeDuration` will lock the validator's Stake for the L1's desired `MinStakeDuration`. #### `IncreaseL1ValidatorBalanceTx` L1 validators are required to maintain a non-zero balance used to pay the continuous fee on the P-Chain in order to be considered active. The `IncreaseL1ValidatorBalanceTx` can be used by anybody to add additional $AVAX to the `Balance` to a validator. The specification of this transaction is: ```go type IncreaseL1ValidatorBalanceTx struct { // Metadata, inputs and outputs BaseTx // ID corresponding to the validator ValidationID ids.ID `json:"validationID"` // Balance <= sum($AVAX inputs) - sum($AVAX outputs) - TxFee Balance uint64 `json:"balance"` } ``` If the validator corresponding to `ValidationID` is currently inactive (`Balance` was exhausted or `DisableL1ValidatorTx` was issued), this transaction will move them back to the active validator set. Note: The $AVAX added to `Balance` can be claimed at any time by the validator using `DisableL1ValidatorTx`. ### Bootstrapping L1 Nodes Bootstrapping a node/validator is the process of securely recreating the latest state of the blockchain locally. At the end of this process, the local state of a node/validator must be in sync with the local state of other virtuous nodes/validators. The node/validator can then verify new incoming transactions and reach consensus with other nodes/validators. To bootstrap a node/validator, a few critical questions must be answered: How does one discover peers in the network? How does one determine that a discovered peer is honestly participating in the network? For standalone networks like the Avalanche Primary Network, this is done by connecting to a hardcoded [set](https://github.com/ava-labs/avalanchego/blob/master/genesis/bootstrappers.json) of trusted bootstrappers to then discover new peers. Ethereum calls their set [bootnodes](https://ethereum.org/developers/docs/nodes-and-clients/bootnodes). Since L1 validators are not required to be Primary Network validators, a list of validator IPs to connect to (the functional bootstrappers of the L1) cannot be provided by simply connecting to the Primary Network validators. However, the Primary Network can enable nodes tracking an L1 to seamlessly connect to the validators by tracking and gossiping L1 validator IPs. L1s will not need to operate and maintain a set of bootstrappers and can rely on the Primary Network for peer discovery. ### Sidebar: L1 Sovereignty After this ACP is activated, the P-Chain will no longer support staking of any assets other than $AVAX for the Primary Network. The P-Chain will not support the distribution of staking rewards for L1s. All staking-related operations for L1 validation must be managed by the L1's validator manager. The P-Chain simply requires a continuous fee per validator. If an L1 would like to manage their validator's balances on the P-Chain, it can cover the cost for all L1 validators by posting the $AVAX balance on the P-Chain. L1s can implement any mechanism they want to pay the continuous fee charged by the P-Chain for its participants. The L1 has full ownership over its validator set, not the P-Chain. There are no restrictions on what requirements an L1 can have for validators to join. Any stake that is required to join the L1's validator set is not locked on the P-Chain. If a validator is removed from the L1's validator set via a `SetL1ValidatorWeightTx` with weight `0`, the stake will continue to be locked outside of the P-Chain. How each L1 handles stake associated with the validator is entirely left up to the L1 and can be treated independently to what happens on the P-Chain. The relationship between the P-Chain and L1s provides a dynamic where L1s can use the P-Chain as an impartial judge to modify parameters (in addition to its existing role of helping to validate incoming Avalanche Warp Messages). If a validator is misbehaving, the L1 validators can collectively generate a BLS multisig to reduce the voting weight of a misbehaving validator. This operation is fully secured by the Avalanche Primary Network (225M $AVAX or $8.325B at the time of writing). Follow-up ACPs could extend the P-Chain <-> L1 relationship to include parametrization of the 67% threshold to enable L1s to choose a different threshold based on their security model (e.g. a simple majority of 51%). ### Continuous Fee Mechanism Every additional validator on the P-Chain adds persistent load to the Avalanche Network. When a validator transaction is issued on the P-Chain, it is charged for the computational cost of the transaction itself but is not charged for the cost of an active validator over the time they are validating on the network (which may be indefinitely). This is a common problem in blockchains, spawning many state rent proposals in the broader blockchain space to address it. The following fee mechanism takes advantage of the fact that each L1 validator uses the same amount of computation and charges each L1 validator the dynamic base fee for every discrete unit of time it is active. To charge each L1 validator, the notion of a `Balance` is introduced. The `Balance` of a validator will be continuously charged during the time they are active to cover the cost of storing the associated validator properties (BLS key, weight, nonce) in memory and to track IPs (in addition to other services provided by the Primary Network). This `Balance` is initialized with the `RegisterL1ValidatorTx` that added them to the active validator set. `Balance` can be increased at any time using the `IncreaseL1ValidatorBalanceTx`. When this `Balance` reaches `0`, the validator will be considered "inactive" and will no longer participate in validating the L1. Inactive validators can be moved back to the active validator set at any time using the same `IncreaseL1ValidatorBalanceTx`. Once a validator is considered inactive, the P-Chain will remove these properties from memory and only retain them on disk. All messages from that validator will be considered invalid until it is revived using the `IncreaseL1ValidatorBalanceTx`. L1s can reduce the amount of inactive weight by removing inactive validators with the `SetL1ValidatorWeightTx` (`Weight` = 0). Since each L1 validator is charged the same amount at each point in time, tracking the fees for the entire validator set is straight-forward. The accumulated dynamic base fee for the entire network is tracked in a single uint. This accumulated value should be equal to the fee charged if a validator was active from the time the accumulator was instantiated. The validator set is maintained in a priority queue. A pseudocode implementation of the continuous fee mechanism is provided below. ```python # Pseudocode class ValidatorQueue: def __init__(self, fee_getter): self.acc = 0 self.queue = PriorityQueue() self.fee_getter = fee_getter # At each time period, increment the accumulator and # pop all validators from the top of the queue that # ran out of funds. # Note: The amount of work done in a single block # should be bounded to prevent a large number of # validator operations from happening at the same # time. def time_elapse(self, t): self.acc = self.acc + self.fee_getter(t) while True: vdr = self.queue.peek() if vdr.balance < self.acc: self.queue.pop() continue return # Validator was added def validator_enter(self, vdr): vdr.balance = vdr.balance + self.acc self.queue.add(vdr) # Validator was removed def validator_remove(self, vdrNodeID): vdr = find_and_remove(self.queue, vdrNodeID) vdr.balance = vdr.balance - self.acc vdr.refund() # Refund [vdr.balance] to [RemainingBalanceOwner] self.queue.remove() # Validator's balance was topped up def validator_increase(self, vdrNodeID, balance): vdr = find_and_remove(self.queue, vdrNodeID) vdr.balance = vdr.balance + balance self.queue.add(vdr) ``` #### Fee Algorithm [ACP-103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md) proposes a dynamic fee mechanism for transactions on the P-Chain. This mechanism is repurposed with minor modifications for the active L1 validator continuous fee. At activation, the number of excess active L1 validators $x$ is set to `0`. The fee rate per second for an active L1 validator is: $$M \cdot \exp\left(\frac{x}{K}\right)$$ Where: - $M$ is the minimum price for an active L1 validator - $\exp\left(x\right)$ is an approximation of $e^x$ following the EIP-4844 specification ```python # Approximates factor * e ** (numerator / denominator) using Taylor expansion def fake_exponential(factor: int, numerator: int, denominator: int) -> int: i = 1 output = 0 numerator_accum = factor * denominator while numerator_accum > 0: output += numerator_accum numerator_accum = (numerator_accum * numerator) // (denominator * i) i += 1 return output // denominator ``` - $K$ is a constant to control the rate of change for the L1 validator price After every second, $x$ will be updated: $$x = \max(x + (V - T), 0)$$ Where: - $V$ is the number of active L1 validators - $T$ is the target number of active L1 validators Whenever $x$ increases by $K$, the price per active L1 validator increases by a factor of `~2.7`. If the price per active L1 validator gets too expensive, some active L1 validators will exit the active validator set, decreasing $x$, dropping the price. The price per active L1 validator constantly adjusts to make sure that, on average, the P-Chain has no more than $T$ active L1 validators. #### Block Processing Before processing the transactions inside a block, all validators that no longer have a sufficient (non-zero) balance are deactivated. After processing the transactions inside a block, all validators that do not have a sufficient balance for the next second are deactivated. ##### Block Timestamp Validity Change To ensure that validators are charged accurately, blocks are only considered valid if advancing the chain times would not cause a validator to have a negative balance. This upholds the expectation that the number of L1 validators remains constant between blocks. The block building protocol is modified to account for this change by first checking if the wall clock time removes any validator due to a lack of funds. If the wall clock time does not remove any L1 validators, the wall clock time is used to build the block. If it does, the time at which the first validator gets removed is used. ##### Fee Calculation The total validator fee assessed in $\Delta t$ is: ```python # Calculate the fee to charge over Δt def cost_over_time(V:int, T:int, x:int, Δt: int) -> int: cost = 0 for _ in range(Δt): x = max(x + V - T, 0) cost += fake_exponential(M, x, K) return cost ``` #### Parameters The parameters at activation are: | Parameter | Definition | Value | | --------- | ------------------------------------------- | ------------- | | $T$ | target number of validators | 10_000 | | $C$ | capacity number of validators | 20_000 | | $M$ | minimum fee rate | 512 nAVAX/s | | $K$ | constant to control the rate of fee changes | 1_246_488_515 | An $M$ of 512 nAVAX/s equates to ~1.33 AVAX/month to run an L1 validator, so long as the total number of continuous-fee-paying L1 validators stays at or below $T$. $K$ was chosen to set the maximum fee doubling rate to ~24 hours. This is in the extreme case that the network has $C$ validators for prolonged periods of time; if the network has $T$+1 validators for example, the fee rate would double every ~27 years. A future ACP can adjust the parameters to increase $T$, reduce $M$, and/or modify $K$. #### User Experience L1 validators are continuously charged a fee, albeit a small one. This poses a challenge for L1 validators: How do they maintain the balance over time? Node clients should expose an API to track how much balance is remaining in the validator's account. This will provide a way for L1 validators to track how quickly it is going down and top-up when needed. A nice byproduct of the above design is the balance in the validator's account is claimable. This means users can top-up as much $AVAX as they want and rest-assured knowing they can always retrieve it if there is an excessive amount. The expectation is that most users will not interact with node clients or track when or how much they need to top-up their validator account. Wallet providers will abstract away most of this process. For users who desire more convenience, L1-as-a-Service providers will abstract away all of this process. ## Backwards Compatibility This new design for Subnets proposes a large rework to all L1-related mechanics. Rollout should be done on a going-forward basis to not cause any service disruption for live Subnets. All current Subnet validators will be able to continue validating both the Primary Network and whatever Subnets they are validating. Any state execution changes must be coordinated through a mandatory upgrade. Implementors must take care to continue to verify the existing ruleset until the upgrade is activated. After activation, nodes should verify the new ruleset. Implementors must take care to only verify the presence of 2000 $AVAX prior to activation. ### Deactivated Transactions - P-Chain - `TransformSubnetTx` After this ACP is activated, Elastic Subnets will be disabled. `TransformSubnetTx` will not be accepted post-activation. As there are no Mainnet Elastic Subnets, there should be no production impact with this deactivation. ### New Transactions - P-Chain - `ConvertSubnetToL1Tx` - `RegisterL1ValidatorTx` - `SetL1ValidatorWeightTx` - `DisableL1ValidatorTx` - `IncreaseL1ValidatorBalanceTx` ## Reference Implementation ACP-77 was implemented and will be merged into AvalancheGo behind the `Etna` upgrade flag. The full body of work can be found tagged with the `acp77` label [here](https://github.com/ava-labs/avalanchego/issues?q=sort%3Aupdated-desc+label%3Aacp77). Since Etna is not yet activated, all new transactions introduced in ACP-77 will be rejected by AvalancheGo. If any modifications are made to ACP-77 as part of the ACP process, the implementation must be updated prior to activation. ## Security Considerations This ACP introduces Avalanche Layer 1s, a new network type that costs significantly less than Avalanche Subnets. This can lead to a large increase in the number of networks and, by extension, the number of validators. Each additional validator adds consistent RAM usage to the P-Chain. However, this should be appropriately metered by the continuous fee mechanism outlined above. With the sovereignty L1s have from the P-Chain, L1 staking tokens are not locked on the P-Chain. This poses a security consideration for L1 validators: Malicious chains can choose to remove validators at will and take any funds that the validator has locked on the L1. The P-Chain only provides the guarantee that L1 validators can retrieve the remaining $AVAX Balance for their validator via a `DisableL1ValidatorTx`. Any assets on the L1 is entirely under the purview of the L1. The onus is on L1 validators to vet the L1's security for any assets transferred onto the L1. With a long window of expiry (24 hours) for the Warp message in `RegisterL1ValidatorTx`, spam of validator registration could lead to high memory pressure on the P-Chain. A future ACP can reduce the window of expiry if 24 hours proves to be a problem. NodeIDs can be added to an L1's validator set involuntarily. However, it is important to note that any stake/rewards are _not_ at risk. For a node operator who was added to a validator set involuntarily, they would only need to generate a new NodeID via key rotation as there is no lock-up of any stake to create a NodeID. This is an explicit tradeoff for easier on-boarding of NodeIDs. This mirrors the Primary Network validators guarantee of no stake/rewards at risk. The continuous fee mechanism outlined above does not apply to inactive L1 validators since they are not stored in memory. However, inactive L1 validators are persisted on disk which can lead to persistent P-Chain state growth. A future ACP can introduce a mechanism to decrease the rate of P-Chain state growth or provide a state expiry path to reduce the amount of P-Chain state. ## Acknowledgements Special thanks to [@StephenButtolph](https://github.com/StephenButtolph), [@aaronbuchwald](https://github.com/aaronbuchwald), and [@patrick-ogrady](https://github.com/patrick-ogrady) for their feedback on these ideas. Thank you to the broader Ava Labs Platform Engineering Group for their feedback on this ACP prior to publication. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-83: Dynamic Multidimensional Fees (/docs/acps/83-dynamic-multidimensional-fees) --- title: "ACP-83: Dynamic Multidimensional Fees" description: "Details for Avalanche Community Proposal 83: Dynamic Multidimensional Fees" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/83-dynamic-multidimensional-fees/README.md --- | ACP | 83 | | :--- | :--- | | **Title** | Dynamic multidimensional fees for P-chain and X-chain | | **Author(s)** | Alberto Benegiamo ([@abi87](https://github.com/abi87)) | | **Status** | Stale | | **Track** | Standards | | **Superseded-By** | [ACP-103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md) | ## Abstract Introduce a dynamic and multidimensional fees scheme for the P-chain and X-chain. Dynamic fees helps to preserve the stability of the chain as it provides a feedback mechanism that increases the cost of resources when the network operates above its target utilization. Multidimensional fees ensures that high demand for orthogonal resources does not drive up the price of underutilized resources. For example, networks provide and consume orthogonal resources including, but not limited to, bandwidth, chain state, read/write throughput, and CPU. By independently metering each resource, they can be granularly priced and stay closer to optimal resource utilization. ## Motivation The P-Chain and X-Chain currently have fixed fees and in some cases those fees are fixed to zero. This makes transaction issuance predictable, but does not provide feedback mechanism to preserve chain stability under high load. In contrast, the C-Chain, which has the highest and most regular load among the chains on the Primary Network, already supports dynamic fees. This ACP proposes to introduce a similar dynamic fee mechanism for the P-Chain and X-Chain to further improve the Primary Network's stability and resilience under load. However, unlike the C-Chain, we propose a multidimensional fee scheme with an exponential update rule for each fee dimension. The [HyperSDK](https://github.com/ava-labs/hypersdk) already utilizes a multidimensional fee scheme with optional priority fees and its efficiency is backed by [academic research](https://arxiv.org/abs/2208.07919). Finally, we split the fee into two parts: a `base fee` and a `priority fee`. The `base fee` is calculated by the network each block to accurately price each resource at a given point in time. Whatever amount greater than the base fee is burnt is treated as the `priority fee` to prioritize faster transaction inclusion. ## Specification We introduce the multidimensional scheme first and then how to apply the dynamic fee update rule for each fee dimension. Finally we list the new block verification rules, valid once the new fee scheme activates. ### Multidimensional scheme components We define four fee dimensions, `Bandwidth`, `Reads`, `Writes`, `Compute`, to describe transactions complexity. In more details: - `Bandwidth` measures the transaction size in bytes, as encoded by the AvalancheGo codec. Byte length is a proxy for the network resources needed to disseminate the transaction. - `Reads` measures the number of DB reads needed to verify the transactions. DB reads include UTXOs reads and any other state quantity relevant for the specific transaction. - `Writes` measures the number of DB writes following the transaction verification. DB writes include UTXOs generated as outputs of the transactions and any other state quantity relevant for the specific transaction. - `Compute` measures the number of signatures to be verified, including UTXOs ones and those related to authorization of specific operations. For each fee dimension $i$, we define: - *fee rate* $r_i$ as the price, denominated in AVAX, to be paid for a transaction with complexity $u_i$ along the fee dimension $i$. - *base fee* as the minimal fee needed to accept a transaction. Base fee is given be the formula $$base \ fee = \sum_{i=0}^3 r_i \times u_i$$ - *priority fee* as an optional fee paid on top of the base fee to speed up the transaction inclusion in a block. ### Dynamic scheme components Fee rates are updated in time, to allow a fee increase when network is getting congested. Each new block is a potential source of congestion, as its transactions carry complexity that each validator must process to verify and eventually accept the block. The more complexity carries a block, and the more rapidly blocks are produced, the higher the congestion. We seek a scheme that rapidly increases the fees when blocks complexity goes above a defined threshold and that equally rapidly decreases the fees once complexity goes down (because blocks carry less/simpler transactions, or because they are produced more slowly). We define the desired threshold as a *target complexity rate* $T$: we would want to process every second a block whose complexity is $T$. Any complexity more than that causes some congestion that we want to penalize via fees. In order to update fees rates we track, per each block and each fee dimension, a parameter called cumulative excess complexity. Fee rates applied to a block will be defined in terms of cumulative excess complexity as we show in the following. Suppose that a block $B_t$ is the current chain tip. $B_t$ has the following features: - $t$ is its timestamp. - $\Delta C_t$ is the cumulative excess complexity along fee dimension $i$. Say a new block $B_{t + \Delta T}$ is built on top of $B$, with the following features: - $t + \Delta T$ is its timestamp - $C_{t + \Delta T}$ is its complexity along fee dimension $i$. Then the fee rate $r_{t + \Delta T}$ applied for the block $B_{t + \Delta T}$ along dimension $i$ will be: $$ r_{t + \Delta T} = r^{min} \times e^{\frac{max(0, \Delta C_t - T \times \Delta T)}{Denom}} $$ where - $r^{min}$ is the minimal fee rate along fee dimension $i$ - $T$ is the target complexity rate along fee dimension $i$ - $Denom$ is a normalization constant for the fee dimension $i$ Moreover, once the block $B_{t + \Delta T}$ is accepted, the cumulative excess complexity is updated as follows: $$\Delta C_{t + \Delta T} = max\large(0, \Delta C_{t} - T \times \Delta T\large) + C_{t + \Delta T}$$ The fee rate update formula guarantees that fee rates increase if incoming blocks are complex (large $C_{t + \Delta T}$) and if blocks are emitted rapidly (small $\Delta T$). Symmetrically, fee rates decrease to the minimum if incoming blocks are less complex and if blocks are produced less frequently. The update formula has a few paramenters to be tuned, independently, for each fee dimension. We defer discussion about tuning to the [implementation section](#tuning-the-update-formula). ## Block verification rules Upon activation of the dynamic multidimensional fees scheme we modify block processing as follows: - **Bound block complexity**. For each fee dimension $i$, we define a *maximal block complexity* $Max$. A block is only valid if the block complexity $C$ is less than the maximum block complexity: $C \leq Max$. - **Verify transaction fee**. When verifying each transaction in a block, we confirm that it can cover its own base fee. Note that both base fee and optional priority fees are burned. ## User Experience ### How will the wallets estimate the fees? AvalancheGo nodes will provide new APIs exposing the current and expected fee rates, as they are likely to change block by block. Wallets can then use the fees rates to select UTXOs to pay the transaction fees. Moreover, the AvalancheGo implementation proposed above offers a `fees.Calculator` struct that can be reused by wallets and downstream projects to evaluate calculate fees. ### How will wallets be able to re-issue Txs at a higher fee? Wallets should be able to simply re-issue the transaction since current AvalancheGo implementation drops mempool transactions whose fee rate is lower than current one. More specifically, a transaction may be valid the moment it enters the mempool and it won’t be re-verified as long as it stays in there. However, as soon as the transaction is selected to be included in the next block, it is re-verified against the latest preferred tip. If fees are not enough by this time, the transaction is dropped and the wallet can simply re-issue it at a higher fee, or wait for the fee rate to go down. Note that priority fees offer some buffer space against an increase in the fee rate. A transaction paying just the base fee will be evicted from the mempool in the face of a fee rate increase, while a transaction paying some extra priority fee may have enough buffer room to stay valid after some amount of fee increase. ### How does priority fees guarantee a faster block inclusion? AvalancheGo mempool will be restructured to order transactions by priority fees. Transactions paying priority fees will be selected for block inclusion first, without violating any spend dependency. ## Backwards Compatibility Modifying the fee scheme for P-Chain and X-Chain requires a mandatory upgrade for activation. Moreover, wallets must be modified to properly handle the new fee scheme once activated. ## Reference Implementation The implementation is split across multiple PRs: - P-Chain work is tracked in this issue: [https://github.com/ava-labs/avalanchego/issues/2707](https://github.com/ava-labs/avalanchego/issues/2707) - X-Chain work is tracked in this issue: [https://github.com/ava-labs/avalanchego/issues/2708](https://github.com/ava-labs/avalanchego/issues/2708) A very important implementation step is tuning the update formula parameters for each chain and each fee dimension. We show here the principles we followed for tuning and a simulation based on historical data. ### Tuning the update formula The basic idea is to measure the complexity of blocks already accepted and derive the parameters from it. You can find the historical data in [this repo](https://github.com/abi87/complexities). To simplify the exposition I am purposefully ignoring chain specifics (like P-chain proposal blocks). We can account for chain specifics while processing the historical data. Here are the principles: - **Target block complexity rate $T$**: calculate the distribution of block complexity and pick a high enough quantile. - **Max block complexity $Max$**: this is probably the trickiest parameter to set. Historically we had [pretty big transactions](https://subnets.avax.network/p-chain/tx/27pjHPRCvd3zaoQUYMesqtkVfZ188uP93zetNSqk3kSH1WjED1) (more than $1.000$ referenced utxos). Setting a max block complexity so high that these big transactions are allowed is akin to setting no complexity cap. On the other side, we still want to allow, even encourage, UTXO consolidation, so we may want to allow transactions [like this](https://subnets.avax.network/p-chain/tx/2LxyHzbi2AGJ4GAcHXth6pj5DwVLWeVmog2SAfh4WrqSBdENhV). A principled way to set max block complexity may be the following: - calculate the target block complexity rate (see previous point) - calculate the median time elapsed among consecutive blocks - The product of these two quantities should gives us something like a target block complexity. - Set the max block complexity to say $\times 50$ the target value. - **Normalization coefficient $Denom$**: I suggest we size it as follows: - Find the largest historical peak, i.e. the sequence of consecutive blocks which contained the most complexity in the shortest period of time - Tune $Denom$ so that it would cause a $\times 10000$ increase in the fee rate for such a peak. This increase would push fees from the milliAVAX we normally pay under stable network condition up to tens of AVAX. - **Minimal fee rates $r^{min}$**: we could size them so that transactions fees do not change very much with respect to the currently fixed values. We simulate below how the update formula would behave on an peak period from Avalanche mainnet.

/> />

Figure 1 shows a peak period, starting with block [wqKJcvEv86TBpmJY2pAY7X65hzqJr3VnHriGh4oiAktWx5qT1](https://subnets.avax.network/p-chain/block/wqKJcvEv86TBpmJY2pAY7X65hzqJr3VnHriGh4oiAktWx5qT1) and going for roughly 30 blocks. We only show `Bandwidth` for clarity, but other fees dimensions have similar behaviour. The network load is much larger than target and sustained. Figure 2 show the fee dynamic in response to the peak: fees scale up from a few milliAVAX up to around 25 AVAX. Moreover as soon as the peak is over, and complexity goes back to the target value, fees are reduced very rapidly. ## Security Considerations The new fee scheme is expected to help network stability as it offers economic incentives to users to hold transactions issuance in times of high load. While fees are expected to remain generally low when the system is not loaded, a sudden load increase, with fuller blocks, would push the dynamic fees algo to increase fee rates. The increase is expected to continue until the load is reduced. Load reduction happens by both dropping unconfirmed transactions whose fee-rate is not sufficient anymore and by pushing users that optimize their transactions costs to delay transaction issuance until the fee rate goes down to an acceptable level. Note finally that the exponential fee update mechanism detailed above is [proven](https://ethresear.ch/t/multidimensional-eip-1559/11651) to be robust against strategic behaviors of users delaying transactions issuance and then suddenly push a bulk of transactions once the fee rate is low enough. ## Acknowledgements Thanks to @StephenButtolph @patrick-ogrady and @dhrubabasu for their feedback on these ideas. ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-84: Table Preamble (/docs/acps/84-table-preamble) --- title: "ACP-84: Table Preamble" description: "Details for Avalanche Community Proposal 84: Table Preamble" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/84-table-preamble/README.md --- | ACP | 84 | | :--- | :--- | | **Title** | Table Preamble for ACPs | | **Author(s)** | Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon)) | | **Status** | Activated | | **Track** | Meta | ## Abstract The current ACP template features a plain-text code block containing "RFC 822 style headers" as `Preamble` (see [What belongs in a successful ACP?](https://github.com/avalanche-foundation/ACPs?tab=readme-ov-file#what-belongs-in-a-successful-acp)). This header includes multiple links to discussions, authors, and other ACPs. This ACP proposes to replace the `Preamble` code block with a Markdown table format (similar to what is used in [Ethereum EIPs](https://github.com/ethereum/EIPs/blob/master/EIPS/eip-1.md)). ## Motivation The current ACPs `Preamble` is (i) not very readable and (ii) not user-friendly as links are not clickable. The proposed table format aims to fix these issues. ## Specification The following Markdown table format is proposed: | ACP | PR Number | | :----------------------------- | :-------------------------------------------------------------------------------------------------------------------------------------------------- | | **Title** | ACP title | | **Author(s)** | A list of the author's name(s) and optionally contact info: FirstName LastName ([@GitHubUsername](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md) or [email@address.com](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md)) | | **Status** | Proposed, Implementable, Activated, Stale ([Discussion](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md)) | | **Track** | Standards, Best Practices, Meta, Subnet | | **Replaces (\\*optional)** | [ACP-XX](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md) | | **Superseded-By (\\*optional)** | [ACP-XX](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md) | It features all the existing fields of the current ACP template, and would replace the current `Preamble` code block in [ACPs/TEMPLATE.md](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/TEMPLATE.md). ## Backwards Compatibility Existing ACPs could be updated to use the new table format, but it is not mandatory. ## Reference Implementation For this ACP, the table would look like this: | ACP | 84 | | :------------ | :----------------------------------------------------------------------------------- | | **Title** | Table Preamble for ACPs | | **Author(s)** | Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon)) | | **Status** | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/86)) | | **Track** | Meta | ## Security Considerations NA ## Open Questions NA ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # ACP-99: Validatorsetmanager Contract (/docs/acps/99-validatorsetmanager-contract) --- title: "ACP-99: Validatorsetmanager Contract" description: "Details for Avalanche Community Proposal 99: Validatorsetmanager Contract" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/ACPs/99-validatorsetmanager-contract/README.md --- | ACP | 99 | | :----------- | :-------------------------------------------------------------------------------------------------------------------------- | | Title | Validator Manager Solidity Standard | | Author(s) | Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon)), Cam Schultz ([@cam-schultz](https://github.com/cam-schultz)) | | Status | Proposed ([Discussion](https://github.com/avalanche-foundation/ACPs/discussions/165)) | | Track | Best Practices | | Dependencies | [ACP-77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md) | ## Abstract Define a standard Validator Manager Solidity smart contract to be deployed on any Avalanche EVM chain. This ACP relies on concepts introduced in [ACP-77 (Reinventing Subnets)](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets). It depends on it to be marked as `Implementable`. ## Motivation [ACP-77 (Reinventing Subnets)](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets) opens the door to managing an L1 validator set (stored on the P-Chain) from any chain on the Avalanche Network. The P-Chain allows a Subnet to specify a "validator manager" if it is converted to an L1 using `ConvertSubnetToL1Tx`. This `(blockchainID, address)` pair is responsible for sending ICM messages contained within `RegisterL1ValidatorTx` and `SetL1ValidatorWeightTx` on the P-Chain. This enables an on-chain program to add, modify the weight of, and remove validators. On each validator set change, the P-Chain is willing to sign an `AddressedCall` to notify any on-chain program tracking the validator set. On-chain programs must be able to interpret this message, so they can trigger the appropriate action. The 2 kinds of `AddressedCall`s [defined in ACP-77](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#p-chain-warp-message-payloads) are `L1ValidatorRegistrationMessage` and `L1ValidatorWeightMessage`. Given these assumptions and the fact that most of the active blockchains on Avalanche Mainnet are EVM-based, we propose `ACP99Manager` as the standard Solidity contract specification that can: 1. Hold relevant information about the current L1 validator set 2. Send validator set updates to the P-Chain by generating `AdressedCall`s defined in ACP-77 3. Correctly update the validator set by interpreting notification messages received from the P-Chain 4. Be easily integrated into validator manager implementations that utilize various security models (e.g. Proof-of-Stake). Having an audited and open-source reference implementation freely available will contribute to lowering the cost of launching L1s on Avalanche. Once deployed, the `ACP99Manager` implementation contract can be used as the `Address` in the [`ConvertSubnetToL1Tx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#convertsubnettol1tx). ## Specification > **Note:**: The naming convention followed for the interfaces and contracts are inspired from the way [OpenZeppelin Contracts](https://docs.openzeppelin.com/contracts/5.x/) are named after ERC standards, using `ACP` instead of `ERC`. ### Type Definitions The following type definitions are used in the function signatures described in [Contract Specification](#contract-specification) ```solidity /** * @notice Description of the conversion data used to convert * a subnet to an L1 on the P-Chain. * This data is the pre-image of a hash that is authenticated by the P-Chain * and verified by the Validator Manager. */ struct ConversionData { bytes32 subnetID; bytes32 validatorManagerBlockchainID; address validatorManagerAddress; InitialValidator[] initialValidators; } /// @notice Specifies an initial validator, used in the conversion data. struct InitialValidator { bytes nodeID; bytes blsPublicKey; uint64 weight; } /// @notice L1 validator status. enum ValidatorStatus { Unknown, PendingAdded, Active, PendingRemoved, Completed, Invalidated } /** * @notice Specifies the owner of a validator's remaining balance or disable owner on the P-Chain. * P-Chain addresses are also 20-bytes, so we use the address type to represent them. */ struct PChainOwner { uint32 threshold; address[] addresses; } /** * @notice Contains the active state of a Validator. * @param status The validator status. * @param nodeID The NodeID of the validator. * @param startingWeight The weight of the validator at the time of registration. * @param sentNonce The current weight update nonce sent by the manager. * @param receivedNonce The highest nonce received from the P-Chain. * @param weight The current weight of the validator. * @param startTime The start time of the validator. * @param endTime The end time of the validator. */ struct Validator { ValidatorStatus status; bytes nodeID; uint64 startingWeight; uint64 sentNonce; uint64 receivedNonce; uint64 weight; uint64 startTime; uint64 endTime; } ``` #### About `Validator`s A `Validator` represents the continuous time frame during which a node is part of the validator set. Each `Validator` is identified by its `validationID`. If a validator was added as part of the initial set of continuous dynamic fee paying validators, its `validationID` is the SHA256 hash of the 36 bytes resulting from concatenating the 32 byte `ConvertSubnetToL1Tx` transaction ID and the 4 byte index of the initial validator within the transaction. If a validator was added to the L1's validator set post-conversion, its `validationID` is the SHA256 of the payload of the `AddressedCall` in the `RegisterL1ValidatorTx` used to add it, as defined in ACP-77. ### Contract Specification The standard `ACP99Manager` functionality is defined by a set of events, public methods, and private methods that must be included by a compliant implementation. For a full implementation, please see the [Reference Implementation](#reference-implementation) #### Events ```solidity /** * @notice Emitted when an initial validator is registered. * @notice The field index is the index of the initial validator in the conversion data. * This is used along with the subnetID as the ACP-118 justification in * signature requests to P-Chain validators over a L1ValidatorRegistrationMessage * when removing the validator */ event RegisteredInitialValidator( bytes32 indexed validationID, bytes20 indexed nodeID, bytes32 indexed subnetID, uint64 weight, uint32 index ); /// @notice Emitted when a validator registration to the L1 is initiated. event InitiatedValidatorRegistration( bytes32 indexed validationID, bytes20 indexed nodeID, bytes32 registrationMessageID, uint64 registrationExpiry, uint64 weight ); /// @notice Emitted when a validator registration to the L1 is completed. event CompletedValidatorRegistration(bytes32 indexed validationID, uint64 weight); /// @notice Emitted when removal of an L1 validator is initiated. event InitiatedValidatorRemoval( bytes32 indexed validationID, bytes32 validatorWeightMessageID, uint64 weight, uint64 endTime ); /// @notice Emitted when removal of an L1 validator is completed. event CompletedValidatorRemoval(bytes32 indexed validationID); /// @notice Emitted when a validator weight update is initiated. event InitiatedValidatorWeightUpdate( bytes32 indexed validationID, uint64 nonce, bytes32 weightUpdateMessageID, uint64 weight ); /// @notice Emitted when a validator weight update is completed. event CompletedValidatorWeightUpdate(bytes32 indexed validationID, uint64 nonce, uint64 weight); ``` #### Public Methods ```solidity /// @notice Returns the SubnetID of the L1 tied to this manager function subnetID() public view returns (bytes32 id); /// @notice Returns the validator details for a given validation ID. function getValidator(bytes32 validationID) public view returns (Validator memory validator); /// @notice Returns the total weight of the current L1 validator set. function l1TotalWeight() public view returns (uint64 weight); /** * @notice Verifies and sets the initial validator set for the chain by consuming a * SubnetToL1ConversionMessage from the P-Chain. * * Emits a {RegisteredInitialValidator} event for each initial validator in {conversionData}. * * @param conversionData The Subnet conversion message data used to recompute and verify against the ConversionID. * @param messsageIndex The index that contains the SubnetToL1ConversionMessage ICM message containing the * ConversionID to be verified against the provided {conversionData}. */ function initializeValidatorSet( ConversionData calldata conversionData, uint32 messsageIndex ) public; /** * @notice Completes the validator registration process by returning an acknowledgement of the registration of a * validationID from the P-Chain. The validator should not be considered active until this method is successfully called. * * Emits a {CompletedValidatorRegistration} event on success. * * @param messageIndex The index of the L1ValidatorRegistrationMessage to be received providing the acknowledgement. * @return validationID The ID of the registered validator. */ function completeValidatorRegistration(uint32 messageIndex) public returns (bytes32 validationID); /** * @notice Completes validator removal by consuming an RegisterL1ValidatorMessage from the P-Chain acknowledging * that the validator has been removed. * * Emits a {CompletedValidatorRemoval} on success. * * @param messageIndex The index of the RegisterL1ValidatorMessage. */ function completeValidatorRemoval(uint32 messageIndex) public returns (bytes32 validationID); /** * @notice Completes the validator weight update process by consuming an L1ValidatorWeightMessage from the P-Chain * acknowledging the weight update. The validator weight change should not have any effect until this method is successfully called. * * Emits a {CompletedValidatorWeightUpdate} event on success. * * @param messageIndex The index of the L1ValidatorWeightMessage message to be received providing the acknowledgement. * @return validationID The ID of the validator, retreived from the L1ValidatorWeightMessage. * @return nonce The nonce of the validator, retreived from the L1ValidatorWeightMessage. */ function completeValidatorWeightUpdate(uint32 messageIndex) public returns (bytes32 validationID, uint64 nonce); ``` >Note: While `getValidator` provides a way to fetch a `Validator` based on its `validationID`, no method that returns all active validators is specified. This is because a `mapping` is a reasonable way to store active validators internally, and Solidity `mapping`s are not iterable. This can be worked around by storing additional indexing metadata in the contract, but not all applications may wish to incur that added complexity. #### Private Methods The following methods are specified as `internal` to account for different semantics of initiating validator set changes, such as checking uptime attested to via ICM message, or transferring funds to be locked as stake. Rather than broaden the definitions of these functions to cover all use cases, we leave it to the implementer to define a suitable external interface and call the appropriate `ACP99Manager` function internally. ```solidity /** * @notice Initiates validator registration by issuing a RegisterL1ValidatorMessage. The validator should * not be considered active until completeValidatorRegistration is called. * * Emits an {InitiatedValidatorRegistration} event on success. * * @param nodeID The ID of the node to add to the L1. * @param blsPublicKey The BLS public key of the validator. * @param remainingBalanceOwner The remaining balance owner of the validator. * @param disableOwner The disable owner of the validator. * @param weight The weight of the node on the L1. * @return validationID The ID of the registered validator. */ function _initiateValidatorRegistration( bytes memory nodeID, bytes memory blsPublicKey, PChainOwner memory remainingBalanceOwner, PChainOwner memory disableOwner, uint64 weight ) internal returns (bytes32 validationID); /** * @notice Initiates validator removal by issuing a L1ValidatorWeightMessage with the weight set to zero. * The validator should be considered inactive as soon as this function is called. * * Emits an {InitiatedValidatorRemoval} on success. * * @param validationID The ID of the validator to remove. */ function _initiateValidatorRemoval(bytes32 validationID) internal; /** * @notice Initiates a validator weight update by issuing an L1ValidatorWeightMessage with a nonzero weight. * The validator weight change should not have any effect until completeValidatorWeightUpdate is successfully called. * * Emits an {InitiatedValidatorWeightUpdate} event on success. * * @param validationID The ID of the validator to modify. * @param weight The new weight of the validator. * @return nonce The validator nonce associated with the weight change. * @return messageID The ID of the L1ValidatorWeightMessage used to update the validator's weight. */ function _initiateValidatorWeightUpdate( bytes32 validationID, uint64 weight ) internal returns (uint64 nonce, bytes32 messageID); ``` ##### About `DisableL1ValidatorTx` In addition to calling `_initiateValidatorRemoval`, a validator may be disabled by issuing a `DisableL1ValidatorTx` on the P-Chain. This transaction allows the `DisableOwner` of a validator to disable it directly from the P-Chain to claim the unspent `Balance` linked to the validator of a failed L1. Therefore it is not meant to be called in the `Manager` contract. ## Backwards Compatibility `ACP99Manager` is a reference specification. As such, it doesn't have any impact on the current behavior of the Avalanche protocol. ## Reference Implementation A reference implementation will be provided in Ava Labs' [ICM Contracts](https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager) repository. This reference implementation will need to be updated to conform to `ACP99Manager` before this ACP may be marked `Implementable`. ### Example Integrations `ACP99Manager` is designed to be easily incorporated into any architecture. Two example integrations are included in this ACP, each of which uses a different architecture. #### Multi-contract Design The multi-contract design consists of a contract that implements `ACP99Manager`, and separate "security module" contracts that implement security models, such as PoS or PoA. Each `ACP99Manager` implementation contract is associated with one or more "security modules" that are the only contracts allowed to call the `ACP99Manager` functions that initiate validator set changes (`initiateValidatorRegistration`, and `initiateValidatorWeightUpdate`). Every time a validator is added/removed or a weight change is initiated, the `ACP99Manager` implementation will, in turn, call the corresponding function of the "security module" (`handleValidatorRegistration` or `handleValidatorWeightChange`). We recommend that the "security modules" reference an immutable `ACP99Manager` contract address for security reasons. It is up to the "security module" to decide what action to take when a validator is added/removed or a weight change is confirmed by the P-Chain. Such actions could be starting the withdrawal period and allocating rewards in a PoS L1. |Own| SecurityModule Safe -.->|Own| Manager SecurityModule <-.->|Reference| Manager Safe -->|addValidator| SecurityModule SecurityModule -->|initiateValidatorRegistration| Manager Manager -->|sendWarpMessage| P P -->|completeValidatorRegistration| Manager Manager -->|handleValidatorRegistration| SecurityModule`} /> "Security modules" could implement PoS, Liquid PoS, etc. The specification of such smart contracts is out of the scope of this ACP. A work in progress implementation is available in the [Suzaku Contracts Library](https://github.com/suzaku-network/suzaku-contracts-library/blob/main/README.md#acp99-contracts-library) repository. It will be updated until this ACP is considered `Implementable` based on the outcome of the discussion. Ava Labs' V2 Validator Manager also implements this architecture for a Proof-of-Stake security module, and is available in their [ICM Contracts Repository](https://github.com/ava-labs/icm-contracts/tree/validator-manager-v2.0.0/contracts/validator-manager/StakingManager.sol). #### Single-contract Design The single-contract design consists of a class hierarchy with the base class implementing `ACP99Manager`. The `PoAValidatorManager` child class in the below diagram may be swapped out for another class implementing a different security model, such as PoS. > ACP99Manager class ValidatorManager { completeValidatorRegistration } <> ValidatorManager class PoAValidatorManager { initiateValidatorRegistration initiateEndValidation completeEndValidation } ACP99Manager <|--ValidatorManager ValidatorManager <|-- PoAValidatorManager`} /> No reference implementation is provided for this architecture in particular, but Ava Labs' V1 [Validator Manager](https://github.com/ava-labs/icm-contracts/tree/validator-manager-v1.0.0/contracts/validator-manager) implements much of the functional behavior described by the specification. It predates the specification, however, so there are some deviations. It should at most be treated as a model of an approximate implementation of this standard. ## Security Considerations The audit process of `ACP99Manager` and reference implementations is of the utmost importance for the future of the Avalanche ecosystem as most L1s would rely upon it to secure their L1. ## Open Questions ### Is there an interest to keep historical information about the validator set on the manager chain? It is left to the implementor to decide if `getValidator` should return information about historical validators. Information about past validator performance may not be relevant for all applications (e.g. PoA has no need to know about past validator's uptimes). This information will still be available in archive nodes and offchain tools (e.g. explorers), but it is not enforced at the contract level. ### Should `ACP99Manager` include a churn control mechanism? The Ava Labs [implementation](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/ValidatorManager.sol) of the `ValidatorManager` contract includes a churn control mechanism that prevents too much weight from being added or removed from the validator set in a short amount of time. Excessive churn can cause consensus failures, so it may be appropriate to require that churn tracking is implemented in some capacity. ## Acknowledgments Special thanks to [@leopaul36](https://github.com/leopaul36), [@aaronbuchwald](https://github.com/aaronbuchwald), [@dhrubabasu](https://github.com/dhrubabasu), [@minghinmatthewlam](https://github.com/minghinmatthewlam) and [@michaelkaplan13](https://github.com/michaelkaplan13) for their reviews of previous versions of this ACP! ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). # Avalanche Community Proposals (ACPs) (/docs/acps) --- title: "Avalanche Community Proposals (ACPs)" description: "Official framework for proposing improvements and gathering consensus around changes to the Avalanche Network" edit_url: https://github.com/avalanche-foundation/ACPs/edit/main/README.md ---
>
## What is an Avalanche Community Proposal (ACP)? An Avalanche Community Proposal is a concise document that introduces a change or best practice for adoption on the [Avalanche Network](https://www.avax.com). ACPs should provide clear technical specifications of any proposals and a compelling rationale for their adoption. ACPs are an open framework for proposing improvements and gathering consensus around changes to the Avalanche Network. ACPs can be proposed by anyone and will be merged into this repository as long as they are well-formatted and coherent. Once an overwhelming majority of the Avalanche Network/Community have [signaled their support for an ACP](https://docs.avax.network/nodes/configure/avalanchego-config-flags#avalanche-community-proposals), it may be scheduled for activation on the Avalanche Network by Avalanche Network Clients (ANCs). It is ultimately up to members of the Avalanche Network/Community to adopt ACPs they support by running a compatible ANC, such as [AvalancheGo](https://github.com/ava-labs/avalanchego). ## ACP Tracks There are three kinds of ACP: * A `Standards Track` ACP describes a change to the design or function of the Avalanche Network, such as a change to the P2P networking protocol, P-Chain design, Subnet architecture, or any change/addition that affects the interoperability of Avalanche Network Clients (ANCs). * A `Best Practices Track` ACP describes a design pattern or common interface that should be used across the Avalanche Network to make it easier to integrate with Avalanche or for Subnets to interoperate with each other. This would include things like proposing a smart contract interface, not proposing a change to how smart contracts are executed. * A `Meta Track` ACP describes a change to the ACP process or suggests a new way for the Avalanche Community to collaborate. * A `Subnet Track` ACP describes a change to a particular Subnet. This would include things like configuration changes or coordinated Subnet upgrades. ## ACP Statuses There are four statuses of an ACP: * A `Proposed` ACP has been merged into the main branch of the ACP repository. It is actively being discussed by the Avalanche Community and may be modified based on feedback. * An `Implementable` ACP is considered "ready for implementation" by the author(s) and will no longer change meaningfully from its current form (which would require a new ACP). * An `Activated` ACP has been activated on the Avalanche Network via a coordinated upgrade by the Avalanche Community. Once an ACP is `Activated`, it is locked. * A `Stale` ACP has been abandoned by its author(s) because it is not supported by the Avalanche Community or has been replaced with another ACP. ## ACP Workflow ### Step 0: Think of a Novel Improvement to Avalanche The ACP process begins with a new idea for Avalanche. Each potential ACP must have an author(s): someone who writes the ACP using the style and format described below, shepherds the associated GitHub Discussion, and attempts to build consensus around the idea. Note that ideas and any resulting ACP is public. Authors should not post any ideas or anything in an ACP that the Author wants to keep confidential or to keep ownership rights in (such as intellectual property rights). ### Step 1: Post Your Idea to [GitHub Discussions](https://github.com/avalanche-foundation/ACPs/discussions/categories/ideas) The author(s) should first attempt to ascertain whether there is support for their idea by posting in the "Ideas" category of GitHub Discussions. Vetting an idea publicly before going as far as writing an ACP is meant to save both the potential author(s) and the wider Avalanche Community time. Asking the Avalanche Community first if an idea is original helps prevent too much time being spent on something that is guaranteed to be rejected based on prior discussions (searching the Internet does not always do the trick). It also helps to make sure the idea is applicable to the entire community and not just the author(s). Small enhancements or patches often don't need standardization between multiple projects; these don't need an ACP and should be injected into the relevant development workflow with a patch submission to the applicable ANC issue tracker. ### Step 2: Propose an ACP via [Pull Request](https://github.com/avalanche-foundation/ACPs/pulls) Once the author(s) feels confident that an idea has a decent chance of acceptance, an ACP should be drafted and submitted as a pull request (PR). This draft must be written in ACP style as described below. It is highly recommended that a single ACP contain a single key proposal or new idea. The more focused the ACP, the more successful it tends to be. If in doubt, split your ACP into several well-focused ones. The PR number of the ACP will become its assigned number. ### Step 3: Build Consensus on [GitHub Discussions](https://github.com/avalanche-foundation/ACPs/discussions/categories/discussion) and Provide an Implementation (if Applicable) ACPs will be merged by ACP maintainers if the proposal is generally well-formatted and coherent. ACP editors will attempt to merge anything worthy of discussion, regardless of feasibility or complexity, that is not a duplicate or incomplete. After an ACP is merged, an official GitHub Discussion will be opened for the ACP and linked to the proposal for community discussion. It is recommended for author(s) or supportive Avalanche Community members to post an accompanying non-technical overview of their ACP for general consumption in this GitHub Discussion. The ACP should be reviewed and broadly supported before a reference implementation is started, again to avoid wasting the author(s) and the Avalanche Community's time, unless a reference implementation will aid people in studying the ACP. ### Step 4: Mark ACP as `Implementable` via [Pull Request](https://github.com/avalanche-foundation/ACPs/pulls) Once an ACP is considered complete by the author(s), it should be marked as `Implementable`. At this point, all open questions should be addressed and an associated reference implementation should be provided (if applicable). As mentioned earlier, the Avalanche Foundation meets periodically to recommend the ratification of specific ACPs but it is ultimately up to members of the Avalanche Network/Community to adopt ACPs they support by running a compatible Avalanche Network Client (ANC), such as [AvalancheGo](https://github.com/ava-labs/avalanchego). ### [Optional] Step 5: Mark ACP as `Stale` via [Pull Request](https://github.com/avalanche-foundation/ACPs/pulls) An ACP can be superseded by a different ACP, rendering the original obsolete. If this occurs, the original ACP will be marked as `Stale`. ACPs may also be marked as `Stale` if the author(s) abandon work on it for a prolonged period of time (12+ months). ACPs may be reopened and moved back to `Proposed` if the author(s) restart work. ### Maintenance ACP maintainers will only merge PRs updating an ACP if it is created or approved by at least one of the author(s). ACP maintainers are not responsible for ensuring ACP author(s) approve the PR. ACP author(s) are expected to review PRs that target their unlocked ACP (`Proposed` or `Implementable`). Any PRs opened against a locked ACP (`Activated` or `Stale`) will not be merged by ACP maintainers. ## What belongs in a successful ACP? Each ACP must have the following parts: * `Preamble`: Markdown table containing metadata about the ACP, including the ACP number, a short descriptive title, the author(s), and optionally the contact info for each author, etc. * `Abstract`: Concise (~200 word) description of the ACP * `Motivation`: Rationale for adopting the ACP and the specific issue/challenge/opportunity it addresses * `Specification`: Complete description of the semantics of any change should allow any ANC/Avalanche Community member to implement the ACP * `Security Considerations`: Security implications of the proposed ACP Each ACP can have the following parts: * `Open Questions`: Questions that should be resolved before implementation Each `Standards Track` ACP must have the following parts: * `Backwards Compatibility`: List of backwards incompatible changes required to implement the ACP and their impact on the Avalanche Community * `Reference Implementation`: Code, documentation, and telemetry (from a local network) of the ACP change Each `Best Practices Track` ACP can have the following parts: * `Backwards Compatibility`: List of backwards incompatible changes required to implement the ACP and their impact on the Avalanche Community * `Reference Implementation`: Code, documentation, and telemetry (from a local network) of the ACP change ### ACP Formats and Templates Each ACP is allocated a unique subdirectory in the `ACPs` directory. The name of this subdirectory must be of the form `N-T` where `N` is the ACP number and `T` is the ACP title with any spaces replaced by hyphens. ACPs must be written in [markdown](https://daringfireball.net/projects/markdown/syntax) format and stored at `ACPs/N-T/README.md`. Please see the [ACP template](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/TEMPLATE.md) for an example of the correct layout. ### Auxiliary Files ACPs may include auxiliary files such as diagrams or code snippets. Such files should be stored in the ACP's subdirectory (`ACPs/N-T/*`). There is no required naming convention for auxiliary files. ### Waived Copyright ACP authors must waive any copyright claims before an ACP will be merged into the repository. This can be done by including the following text in an ACP: ```text ## Copyright Copyright and related rights waived via [CC0](https://creativecommons.org/publicdomain/zero/1.0/). ``` ## Proposals _You can view the status of each ACP on the [ACP Tracker](https://github.com/orgs/avalanche-foundation/projects/1/views/1)._ | Number | Title | Author(s) | Type | |:-------|:------|:-------|:-----| |[13](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/13-subnet-only-validators/README.md)|Subnet-Only Validators (SOVs)|Patrick O'Grady (contact@patrickogrady.xyz)|Standards| |[20](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/20-ed25519-p2p/README.md)|Ed25519 p2p|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards| |[23](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/23-p-chain-native-transfers/README.md)|P-Chain Native Transfers|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards| |[24](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/24-shanghai-eips/README.md)|Activate Shanghai EIPs on C-Chain|Darioush Jalali ([@darioush](https://github.com/darioush))|Standards| |[25](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/25-vm-application-errors/README.md)|Virtual Machine Application Errors|Joshua Kim ([@joshua-kim](https://github.com/joshua-kim))|Standards| |[30](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/30-avalanche-warp-x-evm/README.md)|Integrate Avalanche Warp Messaging into the EVM|Aaron Buchwald (aaron.buchwald56@gmail.com)|Standards| |[31](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/31-enable-subnet-ownership-transfer/README.md)|Enable Subnet Ownership Transfer|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards| |[41](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/41-remove-pending-stakers/README.md)|Remove Pending Stakers|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards| |[62](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/62-disable-addvalidatortx-and-adddelegatortx/README.md)|Disable `AddValidatorTx` and `AddDelegatorTx`|Jacob Everly (https://twitter.com/JacobEv3rly), Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards| |[75](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/75-acceptance-proofs/README.md)|Acceptance Proofs|Joshua Kim ([@joshua-kim](https://github.com/joshua-kim))|Standards| |[77](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/77-reinventing-subnets/README.md)|Reinventing Subnets|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu))|Standards| |[83](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/83-dynamic-multidimensional-fees/README.md)|Dynamic Multidimensional Fees for P-Chain and X-Chain|Alberto Benegiamo ([@abi87](https://github.com/abi87))|Standards| |[84](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/84-table-preamble/README.md)|Table Preamble for ACPs|Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon))|Meta| |[99](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/99-validatorsetmanager-contract/README.md)|Validator Manager Solidity Standard|Gauthier Leonard ([@Nuttymoon](https://github.com/Nuttymoon)), Cam Schultz ([@cam-schultz](https://github.com/cam-schultz))|Best Practices| |[103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md)|Add Dynamic Fees to the X-Chain and P-Chain|Dhruba Basu ([@dhrubabasu](https://github.com/dhrubabasu)), Alberto Benegiamo ([@abi87](https://github.com/abi87)), Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph))|Standards| |[108](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/108-evm-event-importing/README.md)|EVM Event Importing|Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Best Practices| |[113](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/113-provable-randomness/README.md)|Provable Virtual Machine Randomness|Tsachi Herman ([@tsachiherman](https://github.com/tsachiherman))|Standards| |[118](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/118-warp-signature-request/README.md)|Standardized P2P Warp Signature Request Interface|Cam Schultz ([@cam-schultz](https://github.com/cam-schultz))|Best Practices| |[125](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/125-basefee-reduction/README.md)|Reduce C-Chain minimum base fee from 25 nAVAX to 1 nAVAX|Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Darioush Jalali ([@darioush](https://github.com/darioush))|Standards| |[131](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/131-cancun-eips/README.md)|Activate Cancun EIPs on C-Chain and Subnet-EVM chains|Darioush Jalali ([@darioush](https://github.com/darioush)), Ceyhun Onur ([@ceyonur](https://github.com/ceyonur))|Standards| |[151](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/151-use-current-block-pchain-height-as-context/README.md)|Use current block P-Chain height as context for state verification|Ian Suvak ([@iansuvak](https://github.com/iansuvak))|Standards| |[176](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/176-dynamic-evm-gas-limit-and-price-discovery-updates/README.md)|Dynamic EVM Gas Limits and Price Discovery Updates|Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Standards| |[181](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/181-p-chain-epoched-views/README.md)|P-Chain Epoched Views|Cam Schultz ([@cam-schultz](https://github.com/cam-schultz))|Standards| |[191](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/191-seamless-l1-creation/README.md)|Seamless L1 Creations (CreateL1Tx)|Martin Eckardt ([@martineckardt](https://github.com/martineckardt)), Aaron Buchwald ([aaronbuchwald](https://github.com/aaronbuchwald)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13)), Meag FitzGerald ([@meaghanfitzgerald](https://github.com/meaghanfitzgerald))|Standards| |[194](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/194-streaming-asynchronous-execution/README.md)|Streaming Asynchronous Execution|Arran Schlosberg ([@ARR4N](https://github.com/ARR4N)), Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph))|Standards| |[204](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/204-precompile-secp256r1/README.md)|Precompile for secp256r1 Curve Support|Santiago Cammi ([@scammi](https://github.com/scammi)), Arran Schlosberg ([@ARR4N](https://github.com/ARR4N))|Standards| |[209](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/209-eip7702-style-account-abstraction/README.md)|EIP-7702-style Set Code for EOAs|Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Arran Schlosberg ([@ARR4N](https://github.com/ARR4N)), Aaron Buchwald ([aaronbuchwald](https://github.com/aaronbuchwald)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Standards| |[224](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/224-dynamic-gas-limit-in-subnet-evm/README.md)|Introduce ACP-176-Based Dynamic Gas Limits and Fee Manager Precompile in Subnet-EVM|Ceyhun Onur ([@ceyonur](https://github.com/ceyonur), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Standards| |[226](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/226-dynamic-minimum-block-times/README.md)|Dynamic Minimum Block Times|Stephen Buttolph ([@StephenButtolph](https://github.com/StephenButtolph)), Michael Kaplan ([@michaelkaplan13](https://github.com/michaelkaplan13))|Standards| |[236](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/236-continuous-staking/README.md)|Continuous Staking |Razvan Angheluta ([@rrazvan1](https://github.com/rrazvan1))|Standards| |[247](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/247-delegation-multiplier-increase-maximum-validator-weight-reduction/README.md)|Delegation Multiplier Increase & Maximum Validator Weight Reduction|Giacomo Barbieri ([@ijaack94](https://x.com/ijaack94)), BENQI ([@benqifinance](https://x.com/benqifinance))|Standards| ## Contributing Before contributing to ACPs, please read the [ACP Terms of Contribution](https://github.com/avalanche-foundation/ACPs/blob/main/CONTRIBUTING.md). # Asset Requirements (/docs/builderkit/asset-requirements) --- title: Asset Requirements description: "Required assets and file structure for chain and token logos." --- # Asset Requirements BuilderKit requires specific asset files for displaying chain and token logos. These assets should follow a standardized file structure and naming convention. ## Chain Logos Chain logos are used by components like `ChainIcon`, `ChainDropdown`, and `TokenIconWithChain`. ### File Structure Chain logos should be placed at: ``` /chains/logo/{chain_id}.png ``` ### Examples ``` /chains/logo/43114.png // Avalanche C-Chain /chains/logo/43113.png // Fuji Testnet /chains/logo/173750.png // Echo L1 ``` ### Requirements - Format: PNG with transparency - Dimensions: 32x32px (minimum) - Background: Transparent - Shape: Circular or square with rounded corners - File size: < 100KB ## Token Logos Token logos are used by components like `TokenIcon`, `TokenChip`, and `TokenRow`. ### File Structure Token logos should be placed at: ``` /tokens/logo/{chain_id}/{address}.png ``` ### Examples ``` /tokens/logo/43114/0x1234567890123456789012345678901234567890.png // Token on C-Chain /tokens/logo/43113/0x5678901234567890123456789012345678901234.png // Token on Fuji ``` ### Requirements - Format: PNG with transparency - Dimensions: 32x32px (minimum) - Background: Transparent - Shape: Circular or square with rounded corners - File size: < 100KB ## Directory Structure Your public assets directory should look like this: ``` public/ ├── chains/ │ └── logo/ │ ├── 43114.png │ ├── 43113.png │ └── 173750.png └── tokens/ └── logo/ ├── 43114/ │ ├── 0x1234....png │ └── 0x5678....png └── 43113/ ├── 0x9012....png └── 0xabcd....png ``` # Custom Chain Setup (/docs/builderkit/chains) --- title: Custom Chain Setup description: "Configure custom Avalanche L1 chains in your application." --- # Custom Chain Setup Learn how to configure custom Avalanche L1 chains in your BuilderKit application. ## Chain Definition Define your custom L1 chain using `viem`'s `defineChain`: ```tsx import { defineChain } from "viem"; export const myL1 = defineChain({ id: 173750, // Your L1 chain ID name: 'My L1', // Display name network: 'my-l1', // Network identifier nativeCurrency: { decimals: 18, name: 'Token', symbol: 'TKN', }, rpcUrls: { default: { http: ['https://api.avax.network/ext/L1/rpc'] }, }, blockExplorers: { default: { name: 'Explorer', url: 'https://explorer.avax.network/my-l1' }, }, // Optional: Custom metadata iconUrl: "/chains/logo/my-l1.png", icm_registry: "0x..." // ICM registry contract }); ``` ## Provider Configuration Add your custom L1 chain to the Web3Provider: ```tsx import { Web3Provider } from '@avalabs/builderkit'; import { avalanche } from '@wagmi/core/chains'; import { myL1 } from './chains/definitions/my-l1'; function App() { return ( ); } ``` ## Required Properties | Property | Type | Description | |----------|------|-------------| | `id` | `number` | Unique L1 chain identifier | | `name` | `string` | Human-readable chain name | | `network` | `string` | Network identifier | | `nativeCurrency` | `object` | Chain's native token details | | `rpcUrls` | `object` | RPC endpoint configuration | | `blockExplorers` | `object` | Block explorer URLs | ## Optional Properties | Property | Type | Description | |----------|------|-------------| | `iconUrl` | `string` | Chain logo URL | | `icm_registry` | `string` | ICM registry contract address | | `testnet` | `boolean` | Whether the chain is a testnet | ## Example: Echo L1 Here's a complete example using the Echo L1: ```tsx import { defineChain } from "viem"; export const echo = defineChain({ id: 173750, name: 'Echo L1', network: 'echo', nativeCurrency: { decimals: 18, name: 'Ech', symbol: 'ECH', }, rpcUrls: { default: { http: ['https://subnets.avax.network/echo/testnet/rpc'] }, }, blockExplorers: { default: { name: 'Explorer', url: 'https://subnets-test.avax.network/echo' }, }, iconUrl: "/chains/logo/173750.png", icm_registry: "0xF86Cb19Ad8405AEFa7d09C778215D2Cb6eBfB228" }); ``` # Contribute (/docs/builderkit/contribute) --- title: Contribute description: "Guide for contributing to BuilderKit by building hooks, components, and flows." --- # Contributing to BuilderKit We welcome contributions to BuilderKit! Whether you're fixing bugs, adding new features, or improving documentation, your help makes BuilderKit better for everyone. ## What You Can Contribute ### Hooks Build reusable hooks that handle common Web3 functionality: - Chain data management - Token interactions - Contract integrations - State management - API integrations ### Components Create new UI components or enhance existing ones: - Form elements - Display components - Interactive elements - Layout components - Utility components ### Flows Design complete user journeys by combining components: - Token swaps - NFT minting - Governance voting - Staking interfaces - Custom protocols # Getting Started (/docs/builderkit/getting-started) --- title: Getting Started description: "Quick setup guide for BuilderKit in your React application." --- Get started with BuilderKit in your React application. ## Installation ```bash npm install @avalabs/builderkit # or yarn add @avalabs/builderkit ``` ## Provider Setup Wrap your application with the Web3Provider to enable wallet connections and chain management: ```tsx import { Web3Provider } from '@avalabs/builderkit'; import { avalanche, avalancheFuji } from '@wagmi/core/chains'; import { echo } from './chains/definitions/echo'; import { dispatch } from './chains/definitions/dispatch'; // Configure chains const chains = [avalanche, avalancheFuji, echo, dispatch]; function App() { return ( ); } ``` ## Next Steps - Learn about [Token Configuration](/docs/builderkit/tokens) - Explore [Core Components](/docs/builderkit/components/control) - Check out [Pre-built Flows](/docs/builderkit/flows/ictt) # Introduction (/docs/builderkit) --- title: Introduction description: "A comprehensive React component library for building Web3 applications on Avalanche." --- BuilderKit is a powerful collection of React components and hooks designed specifically for building Web3 applications on Avalanche. It provides everything you need to create modern, user-friendly blockchain applications with minimal effort. ## Ready to Use Components BuilderKit offers a comprehensive set of components that handle common Web3 functionalities: - **Control Components**: Buttons, forms, and wallet connection interfaces - **Identity Components**: Address displays and domain name resolution - **Token Components**: Balance displays, inputs, and price conversions - **Input Components**: Specialized form inputs for Web3 data types - **Chain Components**: Network selection and chain information displays - **Transaction Components**: Transaction submission and status tracking - **Collectibles Components**: NFT displays and collection management ## Powerful Hooks BuilderKit provides hooks for seamless integration with Avalanche's ecosystem: ### Blockchain Interaction Access and manage blockchain data, tokens, and cross-chain operations with hooks for chains, tokens, DEX interactions, and inter-chain transfers. ### Precompile Integration Easily integrate with Avalanche's precompiled contracts for access control, fee management, native minting, rewards, and cross-chain messaging. ## Getting Started Get started quickly by installing BuilderKit in your React application: ```bash npm install @avalabs/builderkit # or yarn add @avalabs/builderkit ``` Check out our [Getting Started](/docs/builderkit/getting-started) guide to begin building your Web3 application. # Token Configuration (/docs/builderkit/tokens) --- title: Token Configuration description: "Guide for configuring tokens in BuilderKit flows." --- # Token Configuration BuilderKit flows require proper token configuration to function correctly. This guide explains the required fields for different token configurations. ## Basic Token Structure All tokens in BuilderKit share a common base structure with these required fields: ```typescript interface BaseToken { // Contract address of the token, use "native" for native chain token address: string; // Human-readable name of the token name: string; // Token symbol/ticker symbol: string; // Number of decimal places the token uses decimals: number; // ID of the chain where this token exists chain_id: number; } ``` ## ICTT Token Fields ICTT tokens extend the base structure with additional fields for cross-chain functionality: ```typescript interface ICTTToken extends BaseToken { // Whether this token can be used with ICTT supports_ictt: boolean; // Address of the contract that handles transfers transferer?: string; // Whether this token instance is a transferer is_transferer?: boolean; // Information about corresponding tokens on other chains mirrors: { // Contract address of the mirrored token address: string; // Transferer contract on the mirror chain transferer: string; // Chain ID where the mirror exists chain_id: number; // Decimal places of the mirrored token decimals: number; // Whether this is the home/original chain home?: boolean; }[]; } ``` ## Field Requirements ### Base Token Fields - `address`: Must be a valid contract address or "native" - `name`: Should be human-readable - `symbol`: Should match the token's trading symbol - `decimals`: Must match the token's contract configuration - `chain_id`: Must be a valid chain ID ### ICTT-Specific Fields - `supports_ictt`: Required for ICTT functionality - `transferer`: Required if token supports ICTT - `is_transferer`: Optional, indicates if token is a transferer - `mirrors`: Required for ICTT, must contain at least one mirror configuration ### Mirror Configuration Fields - `address`: Required, contract address on mirror chain - `transferer`: Required, transferer contract on mirror chain - `chain_id`: Required, must be different from token's chain_id - `decimals`: Required, must match token contract - `home`: Optional, indicates original/home chain # Snowman Consensus (/docs/primary-network/avalanche-consensus) --- title: Snowman Consensus description: Learn about the Snowman Consensus protocol. --- Consensus is the task of getting a group of computers (a.k.a. nodes) to come to an agreement on a decision. In blockchain, this means that all the participants in a network have to agree on the changes made to the shared ledger. This agreement is reached through a specific process, a consensus protocol, that ensures that everyone sees the same information and that the information is accurate and trustworthy. ## Snowman Consensus Snowman Consensus is a consensus protocol that is scalable, robust, and decentralized. It combines features of both classical and Nakamoto consensus mechanisms to achieve high throughput, fast finality, and energy efficiency. For the whitepaper, see [here](https://www.avalabs.org/whitepapers). Key Features Include: - Speed: Snowman Consensus provides sub-second, immutable finality, ensuring that transactions are quickly confirmed and irreversible. - Scalability: Snowman Consensus enables high network throughput while ensuring low latency. - Energy Efficiency: Unlike other popular consensus protocols, participation in Snowman Consensus is neither computationally intensive nor expensive. - Adaptive Security: Snowman Consensus is designed to resist various attacks, including sybil attacks, distributed denial-of-service (DDoS) attacks, and collusion attacks. Its probabilistic nature ensures that the consensus outcome converges to the desired state, even when the network is under attack. ## Conceptual Overview Consensus protocols in the Avalanche family operate through repeated sub-sampled voting. When a node is determining whether a [transaction](http://support.avalabs.org/en/articles/4587384-what-is-a-transaction) should be accepted, it asks a small, random subset of [validator nodes](http://support.avalabs.org/en/articles/4064704-what-is-a-blockchain-validator) for their preference. Each queried validator replies with the transaction that it prefers, or thinks should be accepted. Consensus will never include a transaction that is determined to be **invalid**. For example, if you were to submit a transaction to send 100 AVAX to a friend, but your wallet only has 2 AVAX, this transaction is considered **invalid** and will not participate in consensus. If a sufficient majority of the validators sampled reply with the same preferred transaction, this becomes the preferred choice of the validator that inquired. In the future, this node will reply with the transaction preferred by the majority. The node repeats this sampling process until the validators queried reply with the same answer for a sufficient number of consecutive rounds. - The number of validators required to be considered a "sufficient majority" is referred to as "α" (_alpha_). - The number of consecutive rounds required to reach consensus, a.k.a. the "Confidence Threshold," is referred to as "β" (_beta_). - Both α and β are configurable. When a transaction has no conflicts, finalization happens very quickly. When conflicts exist, honest validators quickly cluster around conflicting transactions, entering a positive feedback loop until all correct validators prefer that transaction. This leads to the acceptance of non-conflicting transactions and the rejection of conflicting transactions. ![How Snowman Consensus Works](/images/avalanche-consensus1.png) Snowman Consensus guarantees that if any honest validator accepts a transaction, all honest validators will come to the same conclusion. For a great visualization, check out [this demo](https://tedyin.com/archive/snow-bft-demo/#/snow). ## Deep Dive Into Snowman Consensus ### Intuition First, let's develop some intuition about the protocol. Imagine a room full of people trying to agree on what to get for lunch. Suppose it's a binary choice between pizza and barbecue. Some people might initially prefer pizza while others initially prefer barbecue. Ultimately, though, everyone's goal is to achieve **consensus**. Everyone asks a random subset of the people in the room what their lunch preference is. If more than half say pizza, the person thinks, "OK, looks like things are leaning toward pizza. I prefer pizza now." That is, they adopt the _preference_ of the majority. Similarly, if a majority say barbecue, the person adopts barbecue as their preference. Everyone repeats this process. Each round, more and more people have the same preference. This is because the more people that prefer an option, the more likely someone is to receive a majority reply and adopt that option as their preference. After enough rounds, they reach consensus and decide on one option, which everyone prefers. ### Snowball The intuition above outlines the Snowball Algorithm, which is a building block of Snowman Consensus. Let's review the Snowball algorithm. #### Parameters - _n_: number of participants - _k_ (sample size): between 1 and _n_ - α (quorum size): between 1 and _k_ - β (decision threshold): >= 1 #### Algorithm ``` preference := pizza consecutiveSuccesses := 0 while not decided: ask k random people their preference if >= α give the same response: preference := response with >= α if preference == old preference: consecutiveSuccesses++ else: consecutiveSuccesses = 1 else: consecutiveSuccesses = 0 if consecutiveSuccesses > β: decide(preference) ``` #### Algorithm Explained Everyone has an initial preference for pizza or barbecue. Until someone has _decided_, they query _k_ people (the sample size) and ask them what they prefer. If α or more people give the same response, that response is adopted as the new preference. α is called the _quorum size_. If the new preference is the same as the old preference, the `consecutiveSuccesses` counter is incremented. If the new preference is different then the old preference, the `consecutiveSuccesses` counter is set to `1`. If no response gets a quorum (an α majority of the same response) then the `consecutiveSuccesses` counter is set to `0`. Everyone repeats this until they get a quorum for the same response β times in a row. If one person decides pizza, then every other person following the protocol will eventually also decide on pizza. Random changes in preference, caused by random sampling, cause a network preference for one choice, which begets more network preference for that choice until it becomes irreversible and then the nodes can decide. In our example, there is a binary choice between pizza or barbecue, but Snowball can be adapted to achieve consensus on decisions with many possible choices. The liveness and safety thresholds are parameterizable. As the quorum size, α, increases, the safety threshold increases, and the liveness threshold decreases. This means the network can tolerate more byzantine (deliberately incorrect, malicious) nodes and remain safe, meaning all nodes will eventually agree whether something is accepted or rejected. The liveness threshold is the number of malicious participants that can be tolerated before the protocol is unable to make progress. These values, which are constants, are quite small on the Avalanche Network. The sample size, _k_, is `20`. So when a node asks a group of nodes their opinion, it only queries `20` nodes out of the whole network. The quorum size, α, is `14`. So if `14` or more nodes give the same response, that response is adopted as the querying node's preference. The decision threshold, β, is `20`. A node decides on choice after receiving `20` consecutive quorum (α majority) responses. Snowball is very scalable as the number of nodes on the network, _n_, increases. Regardless of the number of participants in the network, the number of consensus messages sent remains the same because in a given query, a node only queries `20` nodes, even if there are thousands of nodes in the network. Everything discussed to this point is how Avalanche is described in [the Avalanche white-paper](https://assets-global.website-files.com/5d80307810123f5ffbb34d6e/6009805681b416f34dcae012_Avalanche%20Consensus%20Whitepaper.pdf). The implementation of the Snowman Consensus protocol by Ava Labs (namely in AvalancheGo) has some optimizations for latency and throughput. ### Blocks A block is a fundamental component that forms the structure of a blockchain. It serves as a container or data structure that holds a collection of transactions or other relevant information. Each block is cryptographically linked to the previous block, creating a chain of blocks, hence the term "blockchain." In addition to storing a reference of its parent, a block contains a set of transactions. These transactions can represent various types of information, such as financial transactions, smart contract operations, or data storage requests. If a node receives a vote for a block, it also counts as a vote for all of the block's ancestors (its parent, the parents' parent, etc.). ### Finality Snowman Consensus is probabilistically safe up to a safety threshold. That is, the probability that a correct node accepts a transaction that another correct node rejects can be made arbitrarily low by adjusting system parameters. In Nakamoto consensus protocol (as used in Bitcoin and Ethereum, for example), a block may be included in the chain but then be removed and not end up in the canonical chain. This means waiting an hour for transaction settlement. In Avalanche, acceptance/rejection are **final and irreversible** and only take a few seconds. ### Optimizations It's not safe for nodes to just ask, "Do you prefer this block?" when they query validators. In Ava Labs' implementation, during a query a node asks, "Given that this block exists, which block do you prefer?" Instead of getting back a binary yes/no, the node receives the other node's preferred block. Nodes don't only query upon hearing of a new block; they repeatedly query other nodes until there are no blocks processing. Nodes may not need to wait until they get all _k_ query responses before registering the outcome of a poll. If a block has already received _alpha_ votes, then there's no need to wait for the rest of the responses. ### Validators If it were free to become a validator on the Avalanche network, that would be problematic because a malicious actor could start many, many nodes which would get queried very frequently. The malicious actor could make the node act badly and cause a safety or liveness failure. The validators, the nodes which are queried as part of consensus, have influence over the network. They have to pay for that influence with real-world value in order to prevent this kind of ballot stuffing. This idea of using real-world value to buy influence over the network is called Proof of Stake. To become a validator, a node must **bond** (stake) something valuable (**AVAX**). The more AVAX a node bonds, the more often that node is queried by other nodes. When a node samples the network it's not uniformly random. Rather, it's weighted by stake amount. Nodes are incentivized to be validators because they get a reward if, while they validate, they're sufficiently correct and responsive. Avalanche doesn't have slashing. If a node doesn't behave well while validating, such as giving incorrect responses or perhaps not responding at all, its stake is still returned in whole, but with no reward. As long as a sufficient portion of the bonded AVAX is held by correct nodes, then the network is safe, and is live for virtuous transactions. ### Big Ideas Two big ideas in Avalanche are **subsampling** and **transitive voting**. Subsampling has low message overhead. It doesn't matter if there are twenty validators or two thousand validators; the number of consensus messages a node sends during a query remains constant. Transitive voting, where a vote for a block is a vote for all its ancestors, helps with transaction throughput. Each vote is actually many votes in one. ### Loose Ends Transactions are created by users which call an API on an [AvalancheGo](https://github.com/ava-labs/avalanchego) full node or create them using a library such as [AvalancheJS](https://github.com/ava-labs/avalanchejs). ### Other Observations Conflicting transactions are not guaranteed to be live. That's not really a problem because if you want your transaction to be live then you should not issue a conflicting transaction. Snowman is the name of Ava Labs' implementation of the Snowman Consensus protocol for linear chains. If there are no undecided transactions, the Snowman Consensus protocol _quiesces_. That is, it does nothing if there is no work to be done. This makes Avalanche more sustainable than Proof-of-work where nodes need to constantly do work. Avalanche has no leader. Any node can propose a transaction and any node that has staked AVAX can vote on every transaction, which makes the network more robust and decentralized. ## Why Do We Care? Avalanche is a general consensus engine. It doesn't matter what type of application is put on top of it. The protocol allows the decoupling of the application layer from the consensus layer. If you're building a dapp on Avalanche then you just need to define a few things, like how conflicts are defined and what is in a transaction. You don't need to worry about how nodes come to an agreement. The consensus protocol is a black box that put something into it and it comes back as accepted or rejected. Avalanche can be used for all kinds of applications, not just P2P payment networks. Avalanche's Primary Network has an instance of the Ethereum Virtual Machine, which is backward compatible with existing Ethereum Dapps and dev tooling. The Ethereum consensus protocol has been replaced with Snowman Consensus to enable lower block latency and higher throughput. Avalanche is very performant. It can process thousands of transactions per second with one to two second acceptance latency. ## Summary Snowman Consensus is a radical breakthrough in distributed systems. It represents as large a leap forward as the classical and Nakamoto consensus protocols that came before it. Now that you have a better understanding of how it works, check out other documentations for building game-changing Dapps and financial instruments on Avalanche. # AVAX Token (/docs/primary-network/avax-token) --- title: AVAX Token description: Learn about the native token of Avalanche Primary Network. --- AVAX is the native utility token of Avalanche. It's a hard-capped, scarce asset that is used to pay for fees, secure the platform through staking, and provide a basic unit of account between the multiple Avalanche L1s created on Avalanche. `1 nAVAX` is equal to `0.000000001 AVAX`. Use the [AVAX Unit Converter](/console/primary-network/unit-converter) to convert between different AVAX denominations. ## Utility AVAX is a capped-supply (up to 720M) resource in the Avalanche ecosystem that's used to power the network. AVAX is used to secure the ecosystem through staking and for day-to-day operations like issuing transactions. AVAX represents the weight that each node has in network decisions. No single actor owns the Avalanche Network, so each validator in the network is given a proportional weight in the network's decisions corresponding to the proportion of total stake that they own through proof of stake (PoS). Any entity trying to execute a transaction on Avalanche Primary Network pays a corresponding fee (commonly known as "gas") to run it on the network. The fees used to execute a transaction on Avalanche is burned, or permanently removed from circulating supply. ## Tokenomics A fixed amount of 360M AVAX was minted at genesis, but a small amount of AVAX is constantly minted as a reward to validators. The protocol rewards validators for good behavior by minting them AVAX rewards at the end of their staking period. The minting process offsets the AVAX burned by transactions fees. While AVAX is still far away from its supply cap, it will almost always remain an inflationary asset. Avalanche does not take away any portion of a validator's already staked tokens (commonly known as "slashing") for negligent/malicious staking periods, however this behavior is disincentivized as validators who attempt to do harm to the network would expend their node's computing resources for no reward. AVAX is minted according to the following formula, where $R_j$ is the total number of tokens at year $j$, with $R_1 = 360M$, and $R_l$ representing the last year that the values of $\gamma,\lambda \in \R$ were changed; $c_j$ is the yet un-minted supply of coins to reach $720M$ at year $j$ such that $c_j \leq 360M$; $u$ represents a staker, with $u.s_{amount}$ representing the total amount of stake that $u$ possesses, and $u.s_{time}$ the length of staking for $u$. AVAX is minted according to the following formula, where $R_j$ is the total number of tokens at: $$ R_j = R_l + \sum_{\forall u} \rho(u.s_{amount}, u.s_{time}) \times \frac{c_j}{L} \times \left( \sum_{i=0}^{j}\frac{1}{\left(\gamma + \frac{1}{1 + i^\lambda}\right)^i} \right) $$ where, $$ L = \left(\sum_{i=0}^{\infty} \frac{1}{\left(\gamma + \frac{1}{1 + i^\lambda} \right)^i} \right) $$ At genesis, $c_1 = 360M$. The values of $\gamma$ and $\lambda$ are governable, and if changed, the function is recomputed with the new value of $c_*$. We have that $\sum_{*}\rho(*) \le 1$. $\rho(*)$ is a linear function that can be computed as follows ($u.s_{time}$ is measured in weeks, and $u.s_{amount}$ is measured in AVAX tokens): $$ \rho(u.s_{amount}, u.s_{time}) = (0.002 \times u.s_{time} + 0.896) \times \frac{u.s_{amount}}{R_j} $$ If the entire supply of tokens at year $j$ is staked for the maximum amount of staking time (one year, or 52 weeks), then $\sum_{\forall u}\rho(u.s_{amount}, u.s_{time}) = 1$. If, instead, every token is staked continuously for the minimal stake duration of two weeks, then $\sum_{\forall u}\rho(u.s_{amount}, u.s_{time}) = 0.9$. Therefore, staking for the maximum amount of time incurs an additional 11.11% of tokens minted, incentivizing stakers to stake for longer periods. Due to the capped-supply, the above function guarantees that AVAX will never exceed a total of $720M$ tokens, or $\lim_{j \to \infty} R(j) = 720M$. # Exchange Integration (/docs/primary-network/exchange-integration) --- title: Exchange Integration description: Learn how to integrate your exchange with the EVM-Compatible Avalanche C-Chain. --- ## Overview The objective of this document is to provide a brief overview of how to integrate with the EVM-Compatible Avalanche C-Chain. For teams that already support ETH, supporting the C-Chain is as straightforward as spinning up an Avalanche node (which has the [same API](https://ethereum.org/en/developers/docs/apis/json-rpc/) as [`go-ethereum`](https://geth.ethereum.org/docs/rpc/server)) and populating Avalanche's ChainID (43114) when constructing transactions. Additionally, Ava Labs maintains an implementation of the [Rosetta API](https://docs.cdp.coinbase.com/mesh/docs/welcome) for the C-Chain called [avalanche-rosetta](https://github.com/ava-labs/avalanche-rosetta). You can learn more about this standardized integration path on the attached Rosetta API website. ## Integration Using EVM Endpoints ### Running an Avalanche Node If you want to build your node form source or include it in a docker image, reference the [AvalancheGo GitHub repository](https://github.com/ava-labs/avalanchego). To quickly get up and running, you can use the [node installation script](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) that automates installing and updating AvalancheGo node as a `systemd` service on Linux, using prebuilt binaries. ### Configuring an Avalanche Node All configuration options and their default values are described [here](/docs/nodes/configure/configs-flags). You can supply configuration options on the command line, or use a config file, which can be easier to work with when supplying many options. You can specify the config file location with `—config-file=config.json`, where `config.json` is a JSON file whose keys and values are option names and values. Individual chains, including the C-Chain, have their own configuration options which are separate from the node-level options. These can also be specified in a config file. For more details, see [here](/docs/nodes/chain-configs/primary-network/c-chain). The C-Chain config file should be at `$HOME/.avalanchego/configs/chains/C/config.json`. You can also tell AvalancheGo to look somewhere else for the C-Chain config file with option `--chain-config-dir`. An example C-Chain config file: If you need Ethereum's [Archive Node](https://ethereum.org/en/developers/docs/nodes-and-clients/#archive-node) functionality, you need to disable C-Chain pruning, which has been enabled by default since AvalancheGo v1.4.10. To disable pruning, include `"pruning-enabled": false` in the C-Chain config file as shown below. ```json { "snowman-api-enabled": false, "coreth-admin-api-enabled": false, "local-txs-enabled": true, "pruning-enabled": false, "eth-apis": [ "internal-eth", "internal-blockchain", "internal-transaction", "internal-tx-pool", "internal-account", "internal-personal", "debug-tracer", "web3", "eth", "eth-filter", "admin", "net" ] } ``` ### Interacting with the C-Chain Interacting with the C-Chain is identical to interacting with [`go-ethereum`](https://geth.ethereum.org/). You can find the reference material for C-Chain API [here](/docs/rpcs/c-chain). Please note that `personal_` namespace is turned off by default. To turn it on, you need to pass the appropriate command line switch to your node, like in the above config example. ## Integration Using Rosetta [Rosetta](https://docs.cdp.coinbase.com/mesh/docs/welcome) is an open-source specification and set of tools that makes integrating with different blockchain networks easier by presenting the same set of APIs for every network. The Rosetta API is made up of 2 core components, the [Data API](https://docs.cdp.coinbase.com/mesh/docs/api-data) and the [Construction API](https://docs.cdp.coinbase.com/mesh/docs/api-construction). Together, these APIs allow for anyone to read and write to blockchains in a standard format over a standard communication protocol. The specifications for these APIs can be found in the [rosetta-specifications](https://github.com/coinbase/rosetta-specifications) repository. You can find the Rosetta server implementation for Avalanche C-Chain [here](https://github.com/ava-labs/avalanche-rosetta), all you need to do is install and run the server with proper configuration. It comes with a `Dockerfile` that packages both the server and the Avalanche client. Detailed instructions can be found in the linked repository. ## Constructing Transactions Avalanche C-Chain transactions are identical to standard EVM transactions with 2 exceptions: - They must be signed with Avalanche's ChainID (43114). - The detailed dynamic gas fee can be found [here](/docs/rpcs/other/guides/txn-fees#c-chain-fees). For development purposes, Avalanche supports all the popular tooling for Ethereum, so developers familiar with Ethereum and Solidity can feel right at home. Popular development environments include: - [Remix IDE](https://remix.ethereum.org/) - [thirdweb](https://thirdweb.com/) - [Hardhat](https://hardhat.org/) ## Ingesting On-Chain Data You can use any standard way of ingesting on-chain data you use for Ethereum network. ### Determining Finality Avalanche consensus provides fast and irreversible finality with 1-2 seconds. To query the most up-to-date finalized block, query any value (that is block, balance, state, etc) with the `latest` parameter. If you query above the last finalized block (that is eth_blockNumber returns 10 and you query 11), an error will be thrown indicating that unfinalized data cannot be queried (as of `avalanchego@v1.3.2`). ### (Optional) Custom Golang SDK If you plan on extracting data from the C-Chain into your own systems using Golang, we recommend using our custom [`ethclient`](https://github.com/ava-labs/coreth/tree/master/ethclient). The standard `go-ethereum` Ethereum client does not compute block hashes correctly (when you call `block.Hash()`) because it doesn't take into account the added [ExtDataHash](https://github.com/ava-labs/coreth/blob/2c3cfac5f766ce5f32a2eddc43451bdb473b84f1/core/types/block.go#L98) header field in Avalanche C-Chain blocks, which is used move AVAX between chains (X-Chain and P-Chain). You can read more about our multi-chain abstraction [here](/docs/primary-network) (out of scope for a normal C-Chain integration). If you plan on reading JSON responses directly or use web3.js (doesn't recompute hash received over the wire) to extract on-chain transaction data/logs/receipts, you shouldn't have any issues! ## Support If you have any problems or questions, reach out either directly to our developers, or on our public [Discord](https://chat.avalabs.org/) server. # Primary Network (/docs/primary-network) --- title: Primary Network description: Learn about the Avalanche Primary Network and its three blockchains. --- import { Network, Layers, Terminal, ArrowRight, Database, Package } from 'lucide-react'; Avalanche is a heterogeneous network of blockchains. As opposed to homogeneous networks, where all applications reside in the same chain, heterogeneous networks allow separate chains to be created for different applications. ![Primary Network Architecture](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/multi-chain-architecture/multi-chain.png) The Primary Network is a special [Avalanche L1](/docs/avalanche-l1s) that runs three blockchains: - The Contract Chain [(C-Chain)](/docs/primary-network#c-chain-contract-chain) - The Platform Chain [(P-Chain)](/docs/primary-network#p-chain-platform-chain) - The Exchange Chain [(X-Chain)](/docs/primary-network#x-chain-exchange-chain) Primary Network"] PN ==> XC["Exchange (X) Chain
━━━━━━━━━━━━━━━
Snowman Consensus Protocol"] PN ==> PC["Platform (P) Chain
━━━━━━━━━━━━━━━
Snowman Consensus Protocol"] PN ==> CC["Contract (C) Chain
━━━━━━━━━━━━━━━
Snowman Consensus Protocol"] XC --> XF1["Creates Assets"] XC --> XF2["Exchanges Assets"] PC --> PF1["Validator Registry"] PC --> PF2["Creates Subnets / Layer 1s"] CC --> CF1["Executes EVM Contracts"] CC --> CF2["Smart Contracts"] XF1 -.-> A1["Asset 1"] XF1 -.-> A2["Asset 2"] XF2 -.-> AV["AVAX"] PF2 -.-> C1["Custom Chain 1"] PF2 -.-> C2["Custom Chain 2"] CF2 -.-> N1["NFT"] CF2 -.-> E1["ERC20"] CF2 -.-> D1["DAPP"] style PN fill:#e74c3c,stroke:#c0392b,stroke-width:4px,color:#fff,rx:15,ry:15 style XC fill:#3498db,stroke:#2980b9,stroke-width:3px,color:#fff,rx:10,ry:10 style PC fill:#9b59b6,stroke:#8e44ad,stroke-width:3px,color:#fff,rx:10,ry:10 style CC fill:#16a085,stroke:#138d75,stroke-width:3px,color:#fff,rx:10,ry:10 style XF1 fill:#5dade2,stroke:#3498db,stroke-width:2px,color:#fff,rx:8,ry:8 style XF2 fill:#5dade2,stroke:#3498db,stroke-width:2px,color:#fff,rx:8,ry:8 style PF1 fill:#bb8fce,stroke:#9b59b6,stroke-width:2px,color:#fff,rx:8,ry:8 style PF2 fill:#bb8fce,stroke:#9b59b6,stroke-width:2px,color:#fff,rx:8,ry:8 style CF1 fill:#52be80,stroke:#16a085,stroke-width:2px,color:#fff,rx:8,ry:8 style CF2 fill:#52be80,stroke:#16a085,stroke-width:2px,color:#fff,rx:8,ry:8 style A1 fill:#85c1e9,stroke:#5dade2,stroke-width:1px,color:#2c3e50,rx:5,ry:5 style A2 fill:#85c1e9,stroke:#5dade2,stroke-width:1px,color:#2c3e50,rx:5,ry:5 style AV fill:#85c1e9,stroke:#5dade2,stroke-width:1px,color:#2c3e50,rx:5,ry:5 style C1 fill:#d7bde2,stroke:#bb8fce,stroke-width:1px,color:#2c3e50,rx:5,ry:5 style C2 fill:#d7bde2,stroke:#bb8fce,stroke-width:1px,color:#2c3e50,rx:5,ry:5 style N1 fill:#a3e4d7,stroke:#52be80,stroke-width:1px,color:#2c3e50,rx:5,ry:5 style E1 fill:#a3e4d7,stroke:#52be80,stroke-width:1px,color:#2c3e50,rx:5,ry:5 style D1 fill:#a3e4d7,stroke:#52be80,stroke-width:1px,color:#2c3e50,rx:5,ry:5 `} /> Avalanche Mainnet is comprised of the Primary Network and all deployed Avalanche L1s. A node can become a validator for the Primary Network by staking at least **2,000 AVAX**. ### C-Chain (Contract Chain) The **C-Chain** is an implementation of the Ethereum Virtual Machine (EVM). The [C-Chain's API](/docs/rpcs/c-chain) supports Geth's API and supports the deployment and execution of smart contracts written in Solidity. The C-Chain is an instance of the [Coreth](https://github.com/ava-labs/coreth) Virtual Machine. | Property | Mainnet | Fuji Testnet | |----------|---------|--------------| | **Network Name** | Avalanche C-Chain | Avalanche Fuji C-Chain | | **Chain ID** | 43114 (0xA86A) | 43113 (0xA869) | | **Currency** | AVAX | AVAX | | **RPC URL** | https://api.avax.network/ext/bc/C/rpc | https://api.avax-test.network/ext/bc/C/rpc | | **Explorer** | https://subnets.avax.network/c-chain | https://subnets-test.avax.network/c-chain | | **Faucet** | - | [Get Test AVAX](/console/primary-network/faucet) | | **Add to Wallet** | | | ### P-Chain (Platform Chain) The **P-Chain** is responsible for all validator and Avalanche L1-level operations. The [P-Chain API](/docs/rpcs/p-chain) supports the creation of new blockchains and Avalanche L1s, the addition of validators to Avalanche L1s, staking operations, and other platform-level operations. The P-Chain is an instance of the [Platform Virtual Machine](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm). | Property | Mainnet | Fuji Testnet | |----------|---------|--------------| | **RPC URL** | https://api.avax.network/ext/bc/P | https://api.avax-test.network/ext/bc/P | | **Currency** | AVAX | AVAX | | **Explorer** | https://subnets.avax.network/p-chain | https://subnets-test.avax.network/p-chain | ### X-Chain (Exchange Chain) The **X-Chain** is responsible for operations on digital smart assets known as **Avalanche Native Tokens**. A smart asset is a representation of a real-world resource (for example, equity, or a bond) with sets of rules that govern its behavior, like "can't be traded until tomorrow." The [X-Chain API](/docs/rpcs/x-chain) supports the creation and trade of Avalanche Native Tokens. One asset traded on the X-Chain is AVAX. When you issue a transaction to a blockchain on Avalanche, you pay a fee denominated in AVAX. The X-Chain is an instance of the Avalanche Virtual Machine (AVM). | Property | Mainnet | Fuji Testnet | |----------|---------|--------------| | **RPC URL** | https://api.avax.network/ext/bc/X | https://api.avax-test.network/ext/bc/X | | **Currency** | AVAX | AVAX | | **Explorer** | https://subnets.avax.network/x-chain | https://subnets-test.avax.network/x-chain | ## Explore More # Virtual Machines (/docs/primary-network/virtual-machines) --- title: Virtual Machines description: Learn about blockchain VMs and how you can build a custom VM-enabled blockchain in Avalanche. --- A **Virtual Machine** (VM) is the blueprint for a blockchain, meaning it defines a blockchain's complete application logic by specifying the blockchain's state, state transitions, transaction rules, and API interface. Developers can use the same VM to create multiple blockchains, each of which follows identical rules but is independent of all others. All Avalanche validators of the **Avalanche Primary Network** are required to run three VMs: - **Coreth**: Defines the Contract Chain (C-Chain); supports smart contract functionality and is EVM-compatible. - **Platform VM**: Defines the Platform Chain (P-Chain); supports operations on staking and Avalanche L1s. - **Avalanche VM**: Defines the Exchange Chain (X-Chain); supports operations on Avalanche Native Tokens. All three can easily be run on any computer with [AvalancheGo](/docs/nodes). ## Custom VMs on Avalanche Developers with advanced use-cases for utilizing distributed ledger technology are often forced to build everything from scratch - networking, consensus, and core infrastructure - before even starting on the actual application. Avalanche eliminates this complexity by: - Providing VMs as simple blueprints for defining blockchain behavior - Supporting development in any programming language with familiar tools - Handling all low-level infrastructure automatically This lets developers focus purely on building their dApps, ecosystems, and communities, rather than wrestling with blockchain fundamentals. ### How Custom VMs Work Customized VMs can communicate with Avalanche over a language agnostic request-response protocol known as [RPC](https://en.wikipedia.org/wiki/Remote_procedure_call). This allows the VM framework to open a world of endless possibilities, as developers can implement their dApps using the languages, frameworks, and libraries of their choice. Validators can install additional VMs on their node to validate additional [Avalanche L1s](/docs/avalanche-l1s) in the Avalanche ecosystem. In exchange, validators receive staking rewards in the form of a reward token determined by the Avalanche L1s. ## Building a Custom VM You can start building your first custom virtual machine in two ways: 1. Use the ready-to-deploy Subnet-EVM for Solidity-based development 2. Create a custom VM in Golang, Rust, or your preferred language The choice depends on your needs. Subnet-EVM provides a quick start with Ethereum compatibility, while custom VMs offer maximum flexibility. ### Golang Examples See here for a tutorial on [How to Build a Simple Golang VM](/docs/avalanche-l1s/golang-vms/simple-golang-vm). ### Rust Examples See here for a tutorial on [How to Build a Simple Rust VM](/docs/avalanche-l1s/rust-vms/setting-up-environment). # Introduction (/docs/nodes) --- title: Introduction description: A brief introduction to the concepts of nodes and validators within the Avalanche ecosystem. --- The Avalanche network is a decentralized platform designed for high throughput and low latency, enabling a wide range of applications. At the core of the network are nodes and validators, which play vital roles in maintaining the network's security, reliability, and performance. ## What is a Node? A node in the Avalanche network is any computer that participates in the network by maintaining a copy of the blockchain, relaying information, and validating transactions. Nodes can be of different types depending on their role and level of participation in the network’s operations. ### Types of Nodes - **Full Node**: Stores the entire blockchain data and helps propagate transactions and blocks across the network. It does not participate directly in consensus but is crucial for the network's health and decentralization. **Archival full nodes** store the entire blockchain ledger, including all transactions from the beginning to the most recent. **Pruned full nodes** download the blockchain ledger, then delete blocks starting with the oldest to save memory. - **Validator Node**: A specialized type of full node that actively participates in the consensus process by validating transactions, producing blocks, and securing the network. Validator nodes are required to stake AVAX tokens as collateral to participate in the consensus mechanism. - **RPC (Remote Procedure Call) Node**: These nodes act as an interface, enabling third-party applications to query and interact with the blockchain. ## More About Validator Nodes A validator node participates in the network's consensus protocol by validating transactions and creating new blocks. Validators play a critical role in ensuring the integrity, security, and decentralization of the network. #### Key Functions of Validators: - **Transaction Validation**: Validators verify the legitimacy of transactions before they are added to the blockchain. - **Block Production**: Validators produce and propose new blocks to the network. This involves reaching consensus with other validators to agree on which transactions should be included in the next block. - **Security and Consensus**: Validators work together to secure the network and ensure that only valid transactions are confirmed. This is done through the Avalanche Consensus protocol, which allows validators to achieve agreement quickly and with high security. ### Primary Network Validators To become a validator on the Primary Network, you must stake **2,000 AVAX**. This will grant you the ability to validate transactions across all three chains in the Primary Network: the P-Chain, C-Chain, and X-Chain. ### Avalanche L1 Validator To become a validator on an Avalanche L1, you must meet the specific validator management criteria for that network. If the L1 operates on a Proof-of-Stake (PoS) model, you will need to stake the required amount of tokens to be eligible. In addition to meeting these criteria, there is a monthly fee of **1.33 AVAX** per validator. # System Requirements (/docs/nodes/system-requirements) --- title: System Requirements description: This document provides information about the system and networking requirements for running an AvalancheGo node. --- ## Hardware and Operating Systems Avalanche is an incredibly lightweight protocol, so nodes can run on commodity hardware. Note that as network usage increases, hardware requirements may change. - **CPU**: Equivalent of 8 AWS vCPU - **RAM**: 8 GiB (16 GiB recommended) - **Storage**: 1 TiB SSD - **OS**: Ubuntu 22.04 or MacOS >= 12 Nodes which choose to use a HDD may get poor and random read/write latencies, therefore reducing performance and reliability. An SSD is strongly suggested. ## Networking To run successfully, AvalancheGo needs to accept connections from the Internet on the network port `9651`. Before you proceed with the installation, you need to determine the networking environment your node will run in. ### On a Cloud Provider If your node is running on a cloud provider computer instance, it will have a static IP. Find out what that static IP is, or set it up if you didn't already. ### On a Home Connection If you're running a node on a computer that is on a residential internet connection, you have a dynamic IP; that is, your IP will change periodically. **For the sake of demonstration, you can ignore the following information.** Otherwise, you will need to set up inbound port forwarding of port `9651` from the internet to the computer the node is installed on. As there are too many models and router configurations, we cannot provide instructions on what exactly to do, but there are online guides to be found (like [this](https://www.noip.com/support/knowledgebase/general-port-forwarding-guide/), or [this](https://www.howtogeek.com/66214/how-to-forward-ports-on-your-router/) ), and your service provider support might help too. Please note that a fully connected Avalanche node maintains and communicates over a couple of thousand of live TCP connections. For some under-powered and older home routers, that might be too much to handle. If that is the case, you may experience lagging on other computers connected to the same router, node getting benched, or failing to sync and similar issues. # Introduction (/docs/cross-chain) --- title: Introduction description: Learn about different interoperability protocols in the Avalanche ecosystem. --- # RPC APIs (/docs/rpcs) --- title: RPC APIs description: AvalancheGo RPC API References for interacting with Avalanche nodes --- # RPC APIs This section contains comprehensive documentation for all RPC (Remote Procedure Call) APIs available in the Avalanche ecosystem. ## Chain-Specific APIs ### C-Chain (Contract Chain) The C-Chain is an instance of the Ethereum Virtual Machine (EVM). Documentation for C-Chain RPC methods and transaction formats. ### P-Chain (Platform Chain) The P-Chain manages validators, staking, and subnets. Documentation for P-Chain RPC methods and transaction formats. ### X-Chain (Exchange Chain) The X-Chain is responsible for asset creation and trading. Documentation for X-Chain RPC methods and transaction formats. ### Subnet-EVM The Subnet-EVM is an instance of the EVM for Subnet / Layer 1 chains. Documentation for Subnet-EVM RPC methods and transaction formats. ## Other APIs Additional RPC APIs for node administration, health monitoring, indexing, metrics, and more. # CLI Commands (/docs/tooling/cli-commands) --- title: "CLI Commands" description: "Complete list of Avalanche CLI commands and their usage." edit_url: https://github.com/ava-labs/avalanche-cli/edit/main/cmd/commands.md --- ## avalanche blockchain The blockchain command suite provides a collection of tools for developing and deploying Blockchains. To get started, use the blockchain create command wizard to walk through the configuration of your very first Blockchain. Then, go ahead and deploy it with the blockchain deploy command. You can use the rest of the commands to manage your Blockchain configurations and live deployments. **Usage:** ```bash avalanche blockchain [subcommand] [flags] ``` **Subcommands:** - [`addValidator`](#avalanche-blockchain-addvalidator): The blockchain addValidator command adds a node as a validator to an L1 of the user provided deployed network. If the network is proof of authority, the owner of the validator manager contract must sign the transaction. If the network is proof of stake, the node must stake the L1's staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain. This command currently only works on Blockchains deployed to either the Fuji Testnet or Mainnet. - [`changeOwner`](#avalanche-blockchain-changeowner): The blockchain changeOwner changes the owner of the deployed Blockchain. - [`changeWeight`](#avalanche-blockchain-changeweight): The blockchain changeWeight command changes the weight of a L1 Validator. The L1 has to be a Proof of Authority L1. - [`configure`](#avalanche-blockchain-configure): AvalancheGo nodes support several different configuration files. Each network (a Subnet or an L1) has their own config which applies to all blockchains/VMs in the network (see https://build.avax.network/docs/nodes/configure/avalanche-l1-configs) Each blockchain within the network can have its own chain config (see https://build.avax.network/docs/nodes/chain-configs/c-chain https://github.com/ava-labs/subnet-evm/blob/master/plugin/evm/config/config.go for subnet-evm options). A chain can also have special requirements for the AvalancheGo node configuration itself (see https://build.avax.network/docs/nodes/configure/configs-flags). This command allows you to set all those files. - [`create`](#avalanche-blockchain-create): The blockchain create command builds a new genesis file to configure your Blockchain. By default, the command runs an interactive wizard. It walks you through all the steps you need to create your first Blockchain. The tool supports deploying Subnet-EVM, and custom VMs. You can create a custom, user-generated genesis with a custom VM by providing the path to your genesis and VM binaries with the --genesis and --vm flags. By default, running the command with a blockchainName that already exists causes the command to fail. If you'd like to overwrite an existing configuration, pass the -f flag. - [`delete`](#avalanche-blockchain-delete): The blockchain delete command deletes an existing blockchain configuration. - [`deploy`](#avalanche-blockchain-deploy): The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet. At the end of the call, the command prints the RPC URL you can use to interact with the Subnet. Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call avalanche network clean to reset all deployed chain state. Subsequent local deploys redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks, so you can take your locally tested Blockchain and deploy it on Fuji or Mainnet. - [`describe`](#avalanche-blockchain-describe): The blockchain describe command prints the details of a Blockchain configuration to the console. By default, the command prints a summary of the configuration. By providing the --genesis flag, the command instead prints out the raw genesis file. - [`export`](#avalanche-blockchain-export): The blockchain export command write the details of an existing Blockchain deploy to a file. The command prompts for an output path. You can also provide one with the --output flag. - [`import`](#avalanche-blockchain-import): Import blockchain configurations into avalanche-cli. This command suite supports importing from a file created on another computer, or importing from blockchains running public networks (e.g. created manually or with the deprecated subnet-cli) - [`join`](#avalanche-blockchain-join): The blockchain join command configures your validator node to begin validating a new Blockchain. To complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can generate or update your node's config file automatically. Alternatively, the command can print the necessary instructions to update your node manually. To complete the validation process, the Blockchain's admins must add the NodeID of your validator to the Blockchain's allow list by calling addValidator with your NodeID. After you update your validator's config, you need to restart your validator manually. If you provide the --avalanchego-config flag, this command attempts to edit the config file at that path. This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet. - [`list`](#avalanche-blockchain-list): The blockchain list command prints the names of all created Blockchain configurations. Without any flags, it prints some general, static information about the Blockchain. With the --deployed flag, the command shows additional information including the VMID, BlockchainID and SubnetID. - [`publish`](#avalanche-blockchain-publish): The blockchain publish command publishes the Blockchain's VM to a repository. - [`removeValidator`](#avalanche-blockchain-removevalidator): The blockchain removeValidator command stops a whitelisted blockchain network validator from validating your deployed Blockchain. To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass these prompts by providing the values with flags. - [`stats`](#avalanche-blockchain-stats): The blockchain stats command prints validator statistics for the given Blockchain. - [`upgrade`](#avalanche-blockchain-upgrade): The blockchain upgrade command suite provides a collection of tools for updating your developmental and deployed Blockchains. - [`validators`](#avalanche-blockchain-validators): The blockchain validators command lists the validators of a blockchain and provides several statistics about them. - [`vmid`](#avalanche-blockchain-vmid): The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain. **Flags:** ```bash -h, --help help for blockchain --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### addValidator The blockchain addValidator command adds a node as a validator to an L1 of the user provided deployed network. If the network is proof of authority, the owner of the validator manager contract must sign the transaction. If the network is proof of stake, the node must stake the L1's staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain. This command currently only works on Blockchains deployed to either the Fuji Testnet or Mainnet. **Usage:** ```bash avalanche blockchain addValidator [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Debug") --aggregator-log-to-stdout use stdout for signature aggregator logs --balance float set the AVAX balance of the validator that will be used for continuous fee on P-Chain --blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's registration (blockchain gas token) --blockchain-key string CLI stored key to use to pay fees for completing the validator's registration (blockchain gas token) --blockchain-private-key string private key to use to pay fees for completing the validator's registration (blockchain gas token) --bls-proof-of-possession string set the BLS proof of possession of the validator to add --bls-public-key string set the BLS public key of the validator to add --cluster string operate on the given cluster --create-local-validator create additional local validator and add it to existing running local node --default-duration (for Subnets, not L1s) set duration so as to validate until primary validator ends its period --default-start-time (for Subnets, not L1s) use default start time for subnet validator (5 minutes later for fuji & mainnet, 30 seconds later for devnet) --default-validator-params (for Subnets, not L1s) use default weight/start/duration params for subnet validator --delegation-fee uint16 (PoS only) delegation fee (in bips) (default 100) --devnet operate on a devnet network --disable-owner string P-Chain address that will able to disable the validator with a P-Chain transaction --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet only] -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for addValidator -k, --key string select the key to use [fuji/devnet only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-endpoint string gather node id/bls from publicly available avalanchego apis on the given endpoint --node-id string node-id of the validator to add --output-tx-path string (for Subnets, not L1s) file path of the add validator tx --partial-sync set primary network partial sync for new validators (default true) --remaining-balance-owner string P-Chain address that will receive any leftover AVAX from the validator when it is removed from Subnet --rpc string connect to validator manager at the given rpc endpoint --stake-amount uint (PoS only) amount of tokens to stake --staking-period duration how long this validator will be staking --start-time string (for Subnets, not L1s) UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format --subnet-auth-keys strings (for Subnets, not L1s) control keys that will be used to authenticate add validator tx -t, --testnet fuji operate on testnet (alias to fuji) --wait-for-tx-acceptance (for Subnets, not L1s) just issue the add validator tx, without waiting for its acceptance (default true) --weight uint set the staking weight of the validator to add (default 20) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### changeOwner The blockchain changeOwner changes the owner of the deployed Blockchain. **Usage:** ```bash avalanche blockchain changeOwner [subcommand] [flags] ``` **Flags:** ```bash --auth-keys strings control keys that will be used to authenticate transfer blockchain ownership tx --cluster string operate on the given cluster --control-keys strings addresses that may make blockchain changes --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet] -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for changeOwner -k, --key string select the key to use [fuji/devnet] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --output-tx-path string file path of the transfer blockchain ownership tx -s, --same-control-key use the fee-paying key as control key -t, --testnet fuji operate on testnet (alias to fuji) --threshold uint32 required number of control key signatures to make blockchain changes --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### changeWeight The blockchain changeWeight command changes the weight of a L1 Validator. The L1 has to be a Proof of Authority L1. **Usage:** ```bash avalanche blockchain changeWeight [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet only] -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for changeWeight -k, --key string select the key to use [fuji/devnet only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-endpoint string gather node id/bls from publicly available avalanchego apis on the given endpoint --node-id string node-id of the validator -t, --testnet fuji operate on testnet (alias to fuji) --weight uint set the new staking weight of the validator --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### configure AvalancheGo nodes support several different configuration files. Each network (a Subnet or an L1) has their own config which applies to all blockchains/VMs in the network (see https://build.avax.network/docs/nodes/configure/avalanche-l1-configs) Each blockchain within the network can have its own chain config (see https://build.avax.network/docs/nodes/chain-configs/c-chain https://github.com/ava-labs/subnet-evm/blob/master/plugin/evm/config/config.go for subnet-evm options). A chain can also have special requirements for the AvalancheGo node configuration itself (see https://build.avax.network/docs/nodes/configure/configs-flags). This command allows you to set all those files. **Usage:** ```bash avalanche blockchain configure [subcommand] [flags] ``` **Flags:** ```bash --chain-config string path to the chain configuration -h, --help help for configure --node-config string path to avalanchego node configuration --per-node-chain-config string path to per node chain configuration for local network --subnet-config string path to the subnet configuration --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### create The blockchain create command builds a new genesis file to configure your Blockchain. By default, the command runs an interactive wizard. It walks you through all the steps you need to create your first Blockchain. The tool supports deploying Subnet-EVM, and custom VMs. You can create a custom, user-generated genesis with a custom VM by providing the path to your genesis and VM binaries with the --genesis and --vm flags. By default, running the command with a blockchainName that already exists causes the command to fail. If you'd like to overwrite an existing configuration, pass the -f flag. **Usage:** ```bash avalanche blockchain create [subcommand] [flags] ``` **Flags:** ```bash --custom use a custom VM template --custom-vm-branch string custom vm branch or commit --custom-vm-build-script string custom vm build-script --custom-vm-path string file path of custom vm to use --custom-vm-repo-url string custom vm repository url --debug enable blockchain debugging (default true) --evm use the Subnet-EVM as the base template --evm-chain-id uint chain ID to use with Subnet-EVM --evm-defaults deprecation notice: use '--production-defaults' --evm-token string token symbol to use with Subnet-EVM --external-gas-token use a gas token from another blockchain -f, --force overwrite the existing configuration if one exists --from-github-repo generate custom VM binary from github repository --genesis string file path of genesis to use -h, --help help for create --icm interoperate with other blockchains using ICM --icm-registry-at-genesis setup ICM registry smart contract on genesis [experimental] --latest use latest Subnet-EVM released version, takes precedence over --vm-version --pre-release use latest Subnet-EVM pre-released version, takes precedence over --vm-version --production-defaults use default production settings for your blockchain --proof-of-authority use proof of authority(PoA) for validator management --proof-of-stake use proof of stake(PoS) for validator management --proxy-contract-owner string EVM address that controls ProxyAdmin for TransparentProxy of ValidatorManager contract --reward-basis-points uint (PoS only) reward basis points for PoS Reward Calculator (default 100) --sovereign set to false if creating non-sovereign blockchain (default true) --teleporter interoperate with other blockchains using ICM --test-defaults use default test settings for your blockchain --validator-manager-owner string EVM address that controls Validator Manager Owner --vm string file path of custom vm to use. alias to custom-vm-path --vm-version string version of Subnet-EVM template to use --warp generate a vm with warp support (needed for ICM) (default true) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### delete The blockchain delete command deletes an existing blockchain configuration. **Usage:** ```bash avalanche blockchain delete [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for delete --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy The blockchain deploy command deploys your Blockchain configuration to Local Network, to Fuji Testnet, DevNet or to Mainnet. At the end of the call, the command prints the RPC URL you can use to interact with the L1 / Subnet. When deploying an L1, Avalanche-CLI lets you use your local machine as a bootstrap validator, so you don't need to run separate Avalanche nodes. This is controlled by the --use-local-machine flag (enabled by default on Local Network). If --use-local-machine is set to true: - Avalanche-CLI will call CreateSubnetTx, CreateChainTx, ConvertSubnetToL1Tx, followed by syncing the local machine bootstrap validator to the L1 and initialize Validator Manager Contract on the L1 If using your own Avalanche Nodes as bootstrap validators: - Avalanche-CLI will call CreateSubnetTx, CreateChainTx, ConvertSubnetToL1Tx - You will have to sync your bootstrap validators to the L1 - Next, Initialize Validator Manager contract on the L1 using avalanche contract initValidatorManager [L1_Name] Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent attempts to deploy the same Blockchain to the same network (Local Network, Fuji, Mainnet) aren't allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call avalanche network clean to reset all deployed chain state. Subsequent local deploys redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks, so you can take your locally tested Blockchain and deploy it on Fuji or Mainnet. **Usage:** ```bash avalanche blockchain deploy [subcommand] [flags] ``` **Flags:** ```bash --convert-only avoid node track, restart and poa manager setup -e, --ewoq use ewoq key [local/devnet deploy only] -h, --help help for deploy -k, --key string select the key to use [fuji/devnet deploy only] -g, --ledger use ledger instead of key --ledger-addrs strings use the given ledger addresses --mainnet-chain-id uint32 use different ChainID for mainnet deployment --output-tx-path string file path of the blockchain creation tx (for multi-sig signing) -u, --subnet-id string do not create a subnet, deploy the blockchain into the given subnet id --subnet-only command stops after CreateSubnetTx and returns SubnetID Network Flags (Select One): --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --fuji operate on fuji (alias to `testnet`) --local operate on a local network --mainnet operate on mainnet --testnet operate on testnet (alias to `fuji`) Bootstrap Validators Flags: --balance float64 set the AVAX balance of each bootstrap validator that will be used for continuous fee on P-Chain (setting balance=1 equals to 1 AVAX for each bootstrap validator) --bootstrap-endpoints stringSlice take validator node info from the given endpoints --bootstrap-filepath string JSON file path that provides details about bootstrap validators --change-owner-address string address that will receive change if node is no longer L1 validator --generate-node-id set to true to generate Node IDs for bootstrap validators when none are set up. Use these Node IDs to set up your Avalanche Nodes. --num-bootstrap-validators int number of bootstrap validators to set up in sovereign L1 validator) Local Machine Flags (Use Local Machine as Bootstrap Validator): --avalanchego-path string use this avalanchego binary path --avalanchego-version string use this version of avalanchego (ex: v1.17.12) --http-port uintSlice http port for node(s) --partial-sync set primary network partial sync for new validators --staking-cert-key-path stringSlice path to provided staking cert key for node(s) --staking-port uintSlice staking port for node(s) --staking-signer-key-path stringSlice path to provided staking signer key for node(s) --staking-tls-key-path stringSlice path to provided staking TLS key for node(s) --use-local-machine use local machine as a blockchain validator Local Network Flags: --avalanchego-path string use this avalanchego binary path --avalanchego-version string use this version of avalanchego (ex: v1.17.12) --num-nodes uint32 number of nodes to be created on local network deploy Non Subnet-Only-Validators (Non-SOV) Flags: --auth-keys stringSlice control keys that will be used to authenticate chain creation --control-keys stringSlice addresses that may make blockchain changes --same-control-key use the fee-paying key as control key --threshold uint32 required number of control key signatures to make blockchain changes ICM Flags: --cchain-funding-key string key to be used to fund relayer account on cchain --cchain-icm-key string key to be used to pay for ICM deploys on C-Chain --icm-key string key to be used to pay for ICM deploys --icm-version string ICM version to deploy --relay-cchain relay C-Chain as source and destination --relayer-allow-private-ips allow relayer to connec to private ips --relayer-amount float64 automatically fund relayer fee payments with the given amount --relayer-key string key to be used by default both for rewards and to pay fees --relayer-log-level string log level to be used for relayer logs --relayer-path string relayer binary to use --relayer-version string relayer version to deploy --skip-icm-deploy Skip automatic ICM deploy --skip-relayer skip relayer deploy --teleporter-messenger-contract-address-path string path to an ICM Messenger contract address file --teleporter-messenger-deployer-address-path string path to an ICM Messenger deployer address file --teleporter-messenger-deployer-tx-path string path to an ICM Messenger deployer tx file --teleporter-registry-bytecode-path string path to an ICM Registry bytecode file Proof Of Stake Flags: --pos-maximum-stake-amount uint64 maximum stake amount --pos-maximum-stake-multiplier uint8 maximum stake multiplier --pos-minimum-delegation-fee uint16 minimum delegation fee --pos-minimum-stake-amount uint64 minimum stake amount --pos-minimum-stake-duration uint64 minimum stake duration (in seconds) --pos-weight-to-value-factor uint64 weight to value factor Signature Aggregator Flags: --aggregator-log-level string log level to use with signature aggregator --aggregator-log-to-stdout use stdout for signature aggregator logs ``` ### describe The blockchain describe command prints the details of a Blockchain configuration to the console. By default, the command prints a summary of the configuration. By providing the --genesis flag, the command instead prints out the raw genesis file. **Usage:** ```bash avalanche blockchain describe [subcommand] [flags] ``` **Flags:** ```bash -g, --genesis Print the genesis to the console directly instead of the summary -h, --help help for describe --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### export The blockchain export command write the details of an existing Blockchain deploy to a file. The command prompts for an output path. You can also provide one with the --output flag. **Usage:** ```bash avalanche blockchain export [subcommand] [flags] ``` **Flags:** ```bash --custom-vm-branch string custom vm branch --custom-vm-build-script string custom vm build-script --custom-vm-repo-url string custom vm repository url -h, --help help for export -o, --output string write the export data to the provided file path --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### import Import blockchain configurations into avalanche-cli. This command suite supports importing from a file created on another computer, or importing from blockchains running public networks (e.g. created manually or with the deprecated subnet-cli) **Usage:** ```bash avalanche blockchain import [subcommand] [flags] ``` **Subcommands:** - [`file`](#avalanche-blockchain-import-file): The blockchain import command will import a blockchain configuration from a file or a git repository. To import from a file, you can optionally provide the path as a command-line argument. Alternatively, running the command without any arguments triggers an interactive wizard. To import from a repository, go through the wizard. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. - [`public`](#avalanche-blockchain-import-public): The blockchain import public command imports a Blockchain configuration from a running network. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. **Flags:** ```bash -h, --help help for import --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### import file The blockchain import command will import a blockchain configuration from a file or a git repository. To import from a file, you can optionally provide the path as a command-line argument. Alternatively, running the command without any arguments triggers an interactive wizard. To import from a repository, go through the wizard. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. **Usage:** ```bash avalanche blockchain import file [subcommand] [flags] ``` **Flags:** ```bash --blockchain string the blockchain configuration to import from the provided repo --branch string the repo branch to use if downloading a new repo -f, --force overwrite the existing configuration if one exists -h, --help help for file --repo string the repo to import (ex: ava-labs/avalanche-plugins-core) or url to download the repo from --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### import public The blockchain import public command imports a Blockchain configuration from a running network. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. **Usage:** ```bash avalanche blockchain import public [subcommand] [flags] ``` **Flags:** ```bash --blockchain-id string the blockchain ID --cluster string operate on the given cluster --custom use a custom VM template --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --evm import a subnet-evm --force overwrite the existing configuration if one exists -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for public -l, --local operate on a local network -m, --mainnet operate on mainnet --node-url string [optional] URL of an already running validator -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### join The blockchain join command configures your validator node to begin validating a new Blockchain. To complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can generate or update your node's config file automatically. Alternatively, the command can print the necessary instructions to update your node manually. To complete the validation process, the Blockchain's admins must add the NodeID of your validator to the Blockchain's allow list by calling addValidator with your NodeID. After you update your validator's config, you need to restart your validator manually. If you provide the --avalanchego-config flag, this command attempts to edit the config file at that path. This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet. **Usage:** ```bash avalanche blockchain join [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-config string file path of the avalanchego config file --cluster string operate on the given cluster --data-dir string path of avalanchego's data dir directory --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force-write if true, skip to prompt to overwrite the config file -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for join -k, --key string select the key to use [fuji only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-id string set the NodeID of the validator to check --plugin-dir string file path of avalanchego's plugin directory --print if true, print the manual config without prompting --stake-amount uint amount of tokens to stake on validator --staking-period duration how long validator validates for after start time --start-time string start time that validator starts validating -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### list The blockchain list command prints the names of all created Blockchain configurations. Without any flags, it prints some general, static information about the Blockchain. With the --deployed flag, the command shows additional information including the VMID, BlockchainID and SubnetID. **Usage:** ```bash avalanche blockchain list [subcommand] [flags] ``` **Flags:** ```bash --deployed show additional deploy information -h, --help help for list --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### publish The blockchain publish command publishes the Blockchain's VM to a repository. **Usage:** ```bash avalanche blockchain publish [subcommand] [flags] ``` **Flags:** ```bash --alias string We publish to a remote repo, but identify the repo locally under a user-provided alias (e.g. myrepo). --force If true, ignores if the blockchain has been published in the past, and attempts a forced publish. -h, --help help for publish --no-repo-path string Do not let the tool manage file publishing, but have it only generate the files and put them in the location given by this flag. --repo-url string The URL of the repo where we are publishing --subnet-file-path string Path to the Blockchain description file. If not given, a prompting sequence will be initiated. --vm-file-path string Path to the VM description file. If not given, a prompting sequence will be initiated. --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### removeValidator The blockchain removeValidator command stops a whitelisted blockchain network validator from validating your deployed Blockchain. To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass these prompts by providing the values with flags. **Usage:** ```bash avalanche blockchain removeValidator [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Debug") --aggregator-log-to-stdout use stdout for signature aggregator logs --auth-keys strings (for non-SOV blockchain only) control keys that will be used to authenticate the removeValidator tx --blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's removal (blockchain gas token) --blockchain-key string CLI stored key to use to pay fees for completing the validator's removal (blockchain gas token) --blockchain-private-key string private key to use to pay fees for completing the validator's removal (blockchain gas token) --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force force validator removal even if it's not getting rewarded -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for removeValidator -k, --key string select the key to use [fuji deploy only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-endpoint string remove validator that responds to the given endpoint --node-id string node-id of the validator --output-tx-path string (for non-SOV blockchain only) file path of the removeValidator tx --rpc string connect to validator manager at the given rpc endpoint -t, --testnet fuji operate on testnet (alias to fuji) --uptime uint validator's uptime in seconds. If not provided, it will be automatically calculated --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### stats The blockchain stats command prints validator statistics for the given Blockchain. **Usage:** ```bash avalanche blockchain stats [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for stats -l, --local operate on a local network -m, --mainnet operate on mainnet -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### upgrade The blockchain upgrade command suite provides a collection of tools for updating your developmental and deployed Blockchains. **Usage:** ```bash avalanche blockchain upgrade [subcommand] [flags] ``` **Subcommands:** - [`apply`](#avalanche-blockchain-upgrade-apply): Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade. For public networks (Fuji Testnet or Mainnet), to complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can manipulate your node's configuration automatically. Alternatively, the command can print the necessary instructions to upgrade your node manually. After you update your validator's configuration, you need to restart your validator manually. If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path. Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation. - [`export`](#avalanche-blockchain-upgrade-export): Export the upgrade bytes file to a location of choice on disk - [`generate`](#avalanche-blockchain-upgrade-generate): The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It guides the user through the process using an interactive wizard. - [`import`](#avalanche-blockchain-upgrade-import): Import the upgrade bytes file into the local environment - [`print`](#avalanche-blockchain-upgrade-print): Print the upgrade.json file content - [`vm`](#avalanche-blockchain-upgrade-vm): The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet. The command walks the user through an interactive wizard. The user can skip the wizard by providing command line flags. **Flags:** ```bash -h, --help help for upgrade --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade apply Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade. For public networks (Fuji Testnet or Mainnet), to complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can manipulate your node's configuration automatically. Alternatively, the command can print the necessary instructions to upgrade your node manually. After you update your validator's configuration, you need to restart your validator manually. If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path. Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation. **Usage:** ```bash avalanche blockchain upgrade apply [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-chain-config-dir string avalanchego's chain config file directory (default "/home/runner/.avalanchego/chains") --config create upgrade config for future subnet deployments (same as generate) --force If true, don't prompt for confirmation of timestamps in the past --fuji fuji apply upgrade existing fuji deployment (alias for `testnet`) -h, --help help for apply --local local apply upgrade existing local deployment --mainnet mainnet apply upgrade existing mainnet deployment --print if true, print the manual config without prompting (for public networks only) --testnet testnet apply upgrade existing testnet deployment (alias for `fuji`) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade export Export the upgrade bytes file to a location of choice on disk **Usage:** ```bash avalanche blockchain upgrade export [subcommand] [flags] ``` **Flags:** ```bash --force If true, overwrite a possibly existing file without prompting -h, --help help for export --upgrade-filepath string Export upgrade bytes file to location of choice on disk --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade generate The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It guides the user through the process using an interactive wizard. **Usage:** ```bash avalanche blockchain upgrade generate [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for generate --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade import Import the upgrade bytes file into the local environment **Usage:** ```bash avalanche blockchain upgrade import [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for import --upgrade-filepath string Import upgrade bytes file into local environment --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade print Print the upgrade.json file content **Usage:** ```bash avalanche blockchain upgrade print [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for print --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade vm The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet. The command walks the user through an interactive wizard. The user can skip the wizard by providing command line flags. **Usage:** ```bash avalanche blockchain upgrade vm [subcommand] [flags] ``` **Flags:** ```bash --binary string Upgrade to custom binary --config upgrade config for future subnet deployments --fuji fuji upgrade existing fuji deployment (alias for `testnet`) -h, --help help for vm --latest upgrade to latest version --local local upgrade existing local deployment --mainnet mainnet upgrade existing mainnet deployment --plugin-dir string plugin directory to automatically upgrade VM --print print instructions for upgrading --testnet testnet upgrade existing testnet deployment (alias for `fuji`) --version string Upgrade to custom version --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### validators The blockchain validators command lists the validators of a blockchain and provides several statistics about them. **Usage:** ```bash avalanche blockchain validators [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for validators -l, --local operate on a local network -m, --mainnet operate on mainnet -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### vmid The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain. **Usage:** ```bash avalanche blockchain vmid [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for vmid --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche config Customize configuration for Avalanche-CLI **Usage:** ```bash avalanche config [subcommand] [flags] ``` **Subcommands:** - [`authorize-cloud-access`](#avalanche-config-authorize-cloud-access): set preferences to authorize access to cloud resources - [`metrics`](#avalanche-config-metrics): set user metrics collection preferences - [`migrate`](#avalanche-config-migrate): migrate command migrates old ~/.avalanche-cli.json and ~/.avalanche-cli/config to /.avalanche-cli/config.json.. - [`snapshotsAutoSave`](#avalanche-config-snapshotsautosave): set user preference between auto saving local network snapshots or not - [`update`](#avalanche-config-update): set user preference between update check or not **Flags:** ```bash -h, --help help for config --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### authorize-cloud-access set preferences to authorize access to cloud resources **Usage:** ```bash avalanche config authorize-cloud-access [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for authorize-cloud-access --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### metrics set user metrics collection preferences **Usage:** ```bash avalanche config metrics [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for metrics --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### migrate migrate command migrates old ~/.avalanche-cli.json and ~/.avalanche-cli/config to /.avalanche-cli/config.json.. **Usage:** ```bash avalanche config migrate [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for migrate --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### snapshotsAutoSave set user preference between auto saving local network snapshots or not **Usage:** ```bash avalanche config snapshotsAutoSave [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for snapshotsAutoSave --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### update set user preference between update check or not **Usage:** ```bash avalanche config update [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for update --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche contract The contract command suite provides a collection of tools for deploying and interacting with smart contracts. **Usage:** ```bash avalanche contract [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-contract-deploy): The contract command suite provides a collection of tools for deploying smart contracts. - [`initValidatorManager`](#avalanche-contract-initvalidatormanager): Initializes Proof of Authority(PoA) or Proof of Stake(PoS)Validator Manager contract on a Blockchain and sets up initial validator set on the Blockchain. For more info on Validator Manager, please head to https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager **Flags:** ```bash -h, --help help for contract --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy The contract command suite provides a collection of tools for deploying smart contracts. **Usage:** ```bash avalanche contract deploy [subcommand] [flags] ``` **Subcommands:** - [`erc20`](#avalanche-contract-deploy-erc20): Deploy an ERC20 token into a given Network and Blockchain **Flags:** ```bash -h, --help help for deploy --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### deploy erc20 Deploy an ERC20 token into a given Network and Blockchain **Usage:** ```bash avalanche contract deploy erc20 [subcommand] [flags] ``` **Flags:** ```bash --blockchain string deploy the ERC20 contract into the given CLI blockchain --blockchain-id string deploy the ERC20 contract into the given blockchain ID/Alias --c-chain deploy the ERC20 contract into C-Chain --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --funded string set the funded address --genesis-key use genesis allocated key as contract deployer -h, --help help for erc20 --key string CLI stored key to use as contract deployer -l, --local operate on a local network -m, --mainnet operate on mainnet --private-key string private key to use as contract deployer --rpc string deploy the contract into the given rpc endpoint --supply uint set the token supply --symbol string set the token symbol -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### initValidatorManager Initializes Proof of Authority(PoA) or Proof of Stake(PoS)Validator Manager contract on a Blockchain and sets up initial validator set on the Blockchain. For more info on Validator Manager, please head to https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager **Usage:** ```bash avalanche contract initValidatorManager [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Debug") --aggregator-log-to-stdout dump signature aggregator logs to stdout --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key as contract deployer -h, --help help for initValidatorManager --key string CLI stored key to use as contract deployer -l, --local operate on a local network -m, --mainnet operate on mainnet --pos-maximum-stake-amount uint (PoS only) maximum stake amount (default 1000) --pos-maximum-stake-multiplier uint8 (PoS only )maximum stake multiplier (default 1) --pos-minimum-delegation-fee uint16 (PoS only) minimum delegation fee (default 1) --pos-minimum-stake-amount uint (PoS only) minimum stake amount (default 1) --pos-minimum-stake-duration uint (PoS only) minimum stake duration (in seconds) (default 100) --pos-reward-calculator-address string (PoS only) initialize the ValidatorManager with reward calculator address --pos-weight-to-value-factor uint (PoS only) weight to value factor (default 1) --private-key string private key to use as contract deployer --rpc string deploy the contract into the given rpc endpoint -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche help Help provides help for any command in the application. Simply type avalanche help [path to command] for full details. **Usage:** ```bash avalanche help [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for help --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche icm The messenger command suite provides a collection of tools for interacting with ICM messenger contracts. **Usage:** ```bash avalanche icm [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-icm-deploy): Deploys ICM Messenger and Registry into a given L1. - [`sendMsg`](#avalanche-icm-sendmsg): Sends and wait reception for a ICM msg between two blockchains. **Flags:** ```bash -h, --help help for icm --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy Deploys ICM Messenger and Registry into a given L1. For Local Networks, it also deploys into C-Chain. **Usage:** ```bash avalanche icm deploy [subcommand] [flags] ``` **Flags:** ```bash --blockchain string deploy ICM into the given CLI blockchain --blockchain-id string deploy ICM into the given blockchain ID/Alias --c-chain deploy ICM into C-Chain --cchain-key string key to be used to pay fees to deploy ICM to C-Chain --cluster string operate on the given cluster --deploy-messenger deploy ICM Messenger (default true) --deploy-registry deploy ICM Registry (default true) --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force-registry-deploy deploy ICM Registry even if Messenger has already been deployed -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key to fund ICM deploy -h, --help help for deploy --include-cchain deploy ICM also to C-Chain --key string CLI stored key to use to fund ICM deploy -l, --local operate on a local network -m, --mainnet operate on mainnet --messenger-contract-address-path string path to a messenger contract address file --messenger-deployer-address-path string path to a messenger deployer address file --messenger-deployer-tx-path string path to a messenger deployer tx file --private-key string private key to use to fund ICM deploy --registry-bytecode-path string path to a registry bytecode file --rpc-url string use the given RPC URL to connect to the subnet -t, --testnet fuji operate on testnet (alias to fuji) --version string version to deploy (default "latest") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### sendMsg Sends and wait reception for a ICM msg between two blockchains. **Usage:** ```bash avalanche icm sendMsg [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --dest-rpc string use the given destination blockchain rpc endpoint --destination-address string deliver the message to the given contract destination address --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key as message originator and to pay source blockchain fees -h, --help help for sendMsg --hex-encoded given message is hex encoded --key string CLI stored key to use as message originator and to pay source blockchain fees -l, --local operate on a local network -m, --mainnet operate on mainnet --private-key string private key to use as message originator and to pay source blockchain fees --source-rpc string use the given source blockchain rpc endpoint -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche ictt The ictt command suite provides tools to deploy and manage Interchain Token Transferrers. **Usage:** ```bash avalanche ictt [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-ictt-deploy): Deploys a Token Transferrer into a given Network and Subnets **Flags:** ```bash -h, --help help for ictt --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy Deploys a Token Transferrer into a given Network and Subnets **Usage:** ```bash avalanche ictt deploy [subcommand] [flags] ``` **Flags:** ```bash --c-chain-home set the Transferrer's Home Chain into C-Chain --c-chain-remote set the Transferrer's Remote Chain into C-Chain --cluster string operate on the given cluster --deploy-erc20-home string deploy a Transferrer Home for the given Chain's ERC20 Token --deploy-native-home deploy a Transferrer Home for the Chain's Native Token --deploy-native-remote deploy a Transferrer Remote for the Chain's Native Token --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for deploy --home-blockchain string set the Transferrer's Home Chain into the given CLI blockchain --home-genesis-key use genesis allocated key to deploy Transferrer Home --home-key string CLI stored key to use to deploy Transferrer Home --home-private-key string private key to use to deploy Transferrer Home --home-rpc string use the given RPC URL to connect to the home blockchain -l, --local operate on a local network -m, --mainnet operate on mainnet --remote-blockchain string set the Transferrer's Remote Chain into the given CLI blockchain --remote-genesis-key use genesis allocated key to deploy Transferrer Remote --remote-key string CLI stored key to use to deploy Transferrer Remote --remote-private-key string private key to use to deploy Transferrer Remote --remote-rpc string use the given RPC URL to connect to the remote blockchain --remote-token-decimals uint8 use the given number of token decimals for the Transferrer Remote [defaults to token home's decimals (18 for a new wrapped native home token)] --remove-minter-admin remove the native minter precompile admin found on remote blockchain genesis -t, --testnet fuji operate on testnet (alias to fuji) --use-home string use the given Transferrer's Home Address --version string tag/branch/commit of Avalanche Interchain Token Transfer (ICTT) to be used (defaults to main branch) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche interchain The interchain command suite provides a collection of tools to set and manage interoperability between blockchains. **Usage:** ```bash avalanche interchain [subcommand] [flags] ``` **Subcommands:** - [`messenger`](#avalanche-interchain-messenger): The messenger command suite provides a collection of tools for interacting with ICM messenger contracts. - [`relayer`](#avalanche-interchain-relayer): The relayer command suite provides a collection of tools for deploying and configuring an ICM relayers. - [`tokenTransferrer`](#avalanche-interchain-tokentransferrer): The tokenTransfer command suite provides tools to deploy and manage Token Transferrers. **Flags:** ```bash -h, --help help for interchain --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### messenger The messenger command suite provides a collection of tools for interacting with ICM messenger contracts. **Usage:** ```bash avalanche interchain messenger [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-interchain-messenger-deploy): Deploys ICM Messenger and Registry into a given L1. - [`sendMsg`](#avalanche-interchain-messenger-sendmsg): Sends and wait reception for a ICM msg between two blockchains. **Flags:** ```bash -h, --help help for messenger --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### messenger deploy Deploys ICM Messenger and Registry into a given L1. For Local Networks, it also deploys into C-Chain. **Usage:** ```bash avalanche interchain messenger deploy [subcommand] [flags] ``` **Flags:** ```bash --blockchain string deploy ICM into the given CLI blockchain --blockchain-id string deploy ICM into the given blockchain ID/Alias --c-chain deploy ICM into C-Chain --cchain-key string key to be used to pay fees to deploy ICM to C-Chain --cluster string operate on the given cluster --deploy-messenger deploy ICM Messenger (default true) --deploy-registry deploy ICM Registry (default true) --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force-registry-deploy deploy ICM Registry even if Messenger has already been deployed -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key to fund ICM deploy -h, --help help for deploy --include-cchain deploy ICM also to C-Chain --key string CLI stored key to use to fund ICM deploy -l, --local operate on a local network -m, --mainnet operate on mainnet --messenger-contract-address-path string path to a messenger contract address file --messenger-deployer-address-path string path to a messenger deployer address file --messenger-deployer-tx-path string path to a messenger deployer tx file --private-key string private key to use to fund ICM deploy --registry-bytecode-path string path to a registry bytecode file --rpc-url string use the given RPC URL to connect to the subnet -t, --testnet fuji operate on testnet (alias to fuji) --version string version to deploy (default "latest") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### messenger sendMsg Sends and wait reception for a ICM msg between two blockchains. **Usage:** ```bash avalanche interchain messenger sendMsg [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --dest-rpc string use the given destination blockchain rpc endpoint --destination-address string deliver the message to the given contract destination address --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key as message originator and to pay source blockchain fees -h, --help help for sendMsg --hex-encoded given message is hex encoded --key string CLI stored key to use as message originator and to pay source blockchain fees -l, --local operate on a local network -m, --mainnet operate on mainnet --private-key string private key to use as message originator and to pay source blockchain fees --source-rpc string use the given source blockchain rpc endpoint -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### relayer The relayer command suite provides a collection of tools for deploying and configuring an ICM relayers. **Usage:** ```bash avalanche interchain relayer [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-interchain-relayer-deploy): Deploys an ICM Relayer for the given Network. - [`logs`](#avalanche-interchain-relayer-logs): Shows pretty formatted AWM relayer logs - [`start`](#avalanche-interchain-relayer-start): Starts AWM relayer on the specified network (Currently only for local network). - [`stop`](#avalanche-interchain-relayer-stop): Stops AWM relayer on the specified network (Currently only for local network, cluster). **Flags:** ```bash -h, --help help for relayer --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### relayer deploy Deploys an ICM Relayer for the given Network. **Usage:** ```bash avalanche interchain relayer deploy [subcommand] [flags] ``` **Flags:** ```bash --allow-private-ips allow relayer to connec to private ips (default true) --amount float automatically fund l1s fee payments with the given amount --bin-path string use the given relayer binary --blockchain-funding-key string key to be used to fund relayer account on all l1s --blockchains strings blockchains to relay as source and destination --cchain relay C-Chain as source and destination --cchain-amount float automatically fund cchain fee payments with the given amount --cchain-funding-key string key to be used to fund relayer account on cchain --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for deploy --key string key to be used by default both for rewards and to pay fees -l, --local operate on a local network --log-level string log level to use for relayer logs -t, --testnet fuji operate on testnet (alias to fuji) --version string version to deploy (default "latest-prerelease") --config string config file (default is $HOME/.avalanche-cli/config.json) --skip-update-check skip check for new versions ``` #### relayer logs Shows pretty formatted AWM relayer logs **Usage:** ```bash avalanche interchain relayer logs [subcommand] [flags] ``` **Flags:** ```bash --endpoint string use the given endpoint for network operations --first uint output first N log lines -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for logs --last uint output last N log lines -l, --local operate on a local network --raw raw logs output -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### relayer start Starts AWM relayer on the specified network (Currently only for local network). **Usage:** ```bash avalanche interchain relayer start [subcommand] [flags] ``` **Flags:** ```bash --bin-path string use the given relayer binary --cluster string operate on the given cluster --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for start -l, --local operate on a local network -t, --testnet fuji operate on testnet (alias to fuji) --version string version to use (default "latest-prerelease") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### relayer stop Stops AWM relayer on the specified network (Currently only for local network, cluster). **Usage:** ```bash avalanche interchain relayer stop [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for stop -l, --local operate on a local network -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### tokenTransferrer The tokenTransfer command suite provides tools to deploy and manage Token Transferrers. **Usage:** ```bash avalanche interchain tokenTransferrer [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-interchain-tokentransferrer-deploy): Deploys a Token Transferrer into a given Network and Subnets **Flags:** ```bash -h, --help help for tokenTransferrer --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### tokenTransferrer deploy Deploys a Token Transferrer into a given Network and Subnets **Usage:** ```bash avalanche interchain tokenTransferrer deploy [subcommand] [flags] ``` **Flags:** ```bash --c-chain-home set the Transferrer's Home Chain into C-Chain --c-chain-remote set the Transferrer's Remote Chain into C-Chain --cluster string operate on the given cluster --deploy-erc20-home string deploy a Transferrer Home for the given Chain's ERC20 Token --deploy-native-home deploy a Transferrer Home for the Chain's Native Token --deploy-native-remote deploy a Transferrer Remote for the Chain's Native Token --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for deploy --home-blockchain string set the Transferrer's Home Chain into the given CLI blockchain --home-genesis-key use genesis allocated key to deploy Transferrer Home --home-key string CLI stored key to use to deploy Transferrer Home --home-private-key string private key to use to deploy Transferrer Home --home-rpc string use the given RPC URL to connect to the home blockchain -l, --local operate on a local network -m, --mainnet operate on mainnet --remote-blockchain string set the Transferrer's Remote Chain into the given CLI blockchain --remote-genesis-key use genesis allocated key to deploy Transferrer Remote --remote-key string CLI stored key to use to deploy Transferrer Remote --remote-private-key string private key to use to deploy Transferrer Remote --remote-rpc string use the given RPC URL to connect to the remote blockchain --remote-token-decimals uint8 use the given number of token decimals for the Transferrer Remote [defaults to token home's decimals (18 for a new wrapped native home token)] --remove-minter-admin remove the native minter precompile admin found on remote blockchain genesis -t, --testnet fuji operate on testnet (alias to fuji) --use-home string use the given Transferrer's Home Address --version string tag/branch/commit of Avalanche Interchain Token Transfer (ICTT) to be used (defaults to main branch) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche key The key command suite provides a collection of tools for creating and managing signing keys. You can use these keys to deploy Subnets to the Fuji Testnet, but these keys are NOT suitable to use in production environments. DO NOT use these keys on Mainnet. To get started, use the key create command. **Usage:** ```bash avalanche key [subcommand] [flags] ``` **Subcommands:** - [`create`](#avalanche-key-create): The key create command generates a new private key to use for creating and controlling test Subnets. Keys generated by this command are NOT cryptographically secure enough to use in production environments. DO NOT use these keys on Mainnet. The command works by generating a secp256 key and storing it with the provided keyName. You can use this key in other commands by providing this keyName. If you'd like to import an existing key instead of generating one from scratch, provide the --file flag. - [`delete`](#avalanche-key-delete): The key delete command deletes an existing signing key. To delete a key, provide the keyName. The command prompts for confirmation before deleting the key. To skip the confirmation, provide the --force flag. - [`export`](#avalanche-key-export): The key export command exports a created signing key. You can use an exported key in other applications or import it into another instance of Avalanche-CLI. By default, the tool writes the hex encoded key to stdout. If you provide the --output flag, the command writes the key to a file of your choosing. - [`list`](#avalanche-key-list): The key list command prints information for all stored signing keys or for the ledger addresses associated to certain indices. - [`transfer`](#avalanche-key-transfer): The key transfer command allows to transfer funds between stored keys or ledger addresses. **Flags:** ```bash -h, --help help for key --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### create The key create command generates a new private key to use for creating and controlling test Subnets. Keys generated by this command are NOT cryptographically secure enough to use in production environments. DO NOT use these keys on Mainnet. The command works by generating a secp256 key and storing it with the provided keyName. You can use this key in other commands by providing this keyName. If you'd like to import an existing key instead of generating one from scratch, provide the --file flag. **Usage:** ```bash avalanche key create [subcommand] [flags] ``` **Flags:** ```bash --file string import the key from an existing key file -f, --force overwrite an existing key with the same name -h, --help help for create --skip-balances do not query public network balances for an imported key --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### delete The key delete command deletes an existing signing key. To delete a key, provide the keyName. The command prompts for confirmation before deleting the key. To skip the confirmation, provide the --force flag. **Usage:** ```bash avalanche key delete [subcommand] [flags] ``` **Flags:** ```bash -f, --force delete the key without confirmation -h, --help help for delete --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### export The key export command exports a created signing key. You can use an exported key in other applications or import it into another instance of Avalanche-CLI. By default, the tool writes the hex encoded key to stdout. If you provide the --output flag, the command writes the key to a file of your choosing. **Usage:** ```bash avalanche key export [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for export -o, --output string write the key to the provided file path --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### list The key list command prints information for all stored signing keys or for the ledger addresses associated to certain indices. **Usage:** ```bash avalanche key list [subcommand] [flags] ``` **Flags:** ```bash -a, --all-networks list all network addresses --blockchains strings blockchains to show information about (p=p-chain, x=x-chain, c=c-chain, and blockchain names) (default p,x,c) -c, --cchain list C-Chain addresses (default true) --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for list --keys strings list addresses for the given keys -g, --ledger uints list ledger addresses for the given indices (default []) -l, --local operate on a local network -m, --mainnet operate on mainnet --pchain list P-Chain addresses (default true) --subnets strings subnets to show information about (p=p-chain, x=x-chain, c=c-chain, and blockchain names) (default p,x,c) -t, --testnet fuji operate on testnet (alias to fuji) --tokens strings provide balance information for the given token contract addresses (Evm only) (default [Native]) --use-gwei use gwei for EVM balances -n, --use-nano-avax use nano Avax for balances --xchain list X-Chain addresses (default true) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### transfer The key transfer command allows to transfer funds between stored keys or ledger addresses. **Usage:** ```bash avalanche key transfer [subcommand] [flags] ``` **Flags:** ```bash -o, --amount float amount to send or receive (AVAX or TOKEN units) --c-chain-receiver receive at C-Chain --c-chain-sender send from C-Chain --cluster string operate on the given cluster -a, --destination-addr string destination address --destination-key string key associated to a destination address --destination-subnet string subnet where the funds will be sent (token transferrer experimental) --destination-transferrer-address string token transferrer address at the destination subnet (token transferrer experimental) --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for transfer -k, --key string key associated to the sender or receiver address -i, --ledger uint32 ledger index associated to the sender or receiver address (default 32768) -l, --local operate on a local network -m, --mainnet operate on mainnet --origin-subnet string subnet where the funds belong (token transferrer experimental) --origin-transferrer-address string token transferrer address at the origin subnet (token transferrer experimental) --p-chain-receiver receive at P-Chain --p-chain-sender send from P-Chain --receiver-blockchain string receive at the given CLI blockchain --receiver-blockchain-id string receive at the given blockchain ID/Alias --sender-blockchain string send from the given CLI blockchain --sender-blockchain-id string send from the given blockchain ID/Alias -t, --testnet fuji operate on testnet (alias to fuji) --x-chain-receiver receive at X-Chain --x-chain-sender send from X-Chain --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche network The network command suite provides a collection of tools for managing local Blockchain deployments. When you deploy a Blockchain locally, it runs on a local, multi-node Avalanche network. The blockchain deploy command starts this network in the background. This command suite allows you to shutdown, restart, and clear that network. This network currently supports multiple, concurrently deployed Blockchains. **Usage:** ```bash avalanche network [subcommand] [flags] ``` **Subcommands:** - [`clean`](#avalanche-network-clean): The network clean command shuts down your local, multi-node network. All deployed Subnets shutdown and delete their state. You can restart the network by deploying a new Subnet configuration. - [`start`](#avalanche-network-start): The network start command starts a local, multi-node Avalanche network on your machine. By default, the command loads the default snapshot. If you provide the --snapshot-name flag, the network loads that snapshot instead. The command fails if the local network is already running. - [`status`](#avalanche-network-status): The network status command prints whether or not a local Avalanche network is running and some basic stats about the network. - [`stop`](#avalanche-network-stop): The network stop command shuts down your local, multi-node network. All deployed Subnets shutdown gracefully and save their state. If you provide the --snapshot-name flag, the network saves its state under this named snapshot. You can reload this snapshot with network start --snapshot-name `snapshotName`. Otherwise, the network saves to the default snapshot, overwriting any existing state. You can reload the default snapshot with network start. **Flags:** ```bash -h, --help help for network --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### clean The network clean command shuts down your local, multi-node network. All deployed Subnets shutdown and delete their state. You can restart the network by deploying a new Subnet configuration. **Usage:** ```bash avalanche network clean [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for clean --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### start The network start command starts a local, multi-node Avalanche network on your machine. By default, the command loads the default snapshot. If you provide the --snapshot-name flag, the network loads that snapshot instead. The command fails if the local network is already running. **Usage:** ```bash avalanche network start [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-path string use this avalanchego binary path --avalanchego-version string use this version of avalanchego (ex: v1.17.12) (default "latest-prerelease") -h, --help help for start --num-nodes uint32 number of nodes to be created on local network (default 2) --relayer-path string use this relayer binary path --relayer-version string use this relayer version (default "latest-prerelease") --snapshot-name string name of snapshot to use to start the network from (default "default") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### status The network status command prints whether or not a local Avalanche network is running and some basic stats about the network. **Usage:** ```bash avalanche network status [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for status --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### stop The network stop command shuts down your local, multi-node network. All deployed Subnets shutdown gracefully and save their state. If you provide the --snapshot-name flag, the network saves its state under this named snapshot. You can reload this snapshot with network start --snapshot-name `snapshotName`. Otherwise, the network saves to the default snapshot, overwriting any existing state. You can reload the default snapshot with network start. **Usage:** ```bash avalanche network stop [subcommand] [flags] ``` **Flags:** ```bash --dont-save do not save snapshot, just stop the network -h, --help help for stop --snapshot-name string name of snapshot to use to save network state into (default "default") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche node The node command suite provides a collection of tools for creating and maintaining validators on Avalanche Network. To get started, use the node create command wizard to walk through the configuration to make your node a primary validator on Avalanche public network. You can use the rest of the commands to maintain your node and make your node a Subnet Validator. **Usage:** ```bash avalanche node [subcommand] [flags] ``` **Subcommands:** - [`addDashboard`](#avalanche-node-adddashboard): (ALPHA Warning) This command is currently in experimental mode. The node addDashboard command adds custom dashboard to the Grafana monitoring dashboard for the cluster. - [`create`](#avalanche-node-create): (ALPHA Warning) This command is currently in experimental mode. The node create command sets up a validator on a cloud server of your choice. The validator will be validating the Avalanche Primary Network and Subnet of your choice. By default, the command runs an interactive wizard. It walks you through all the steps you need to set up a validator. Once this command is completed, you will have to wait for the validator to finish bootstrapping on the primary network before running further commands on it, e.g. validating a Subnet. You can check the bootstrapping status by running avalanche node status The created node will be part of group of validators called `clusterName` and users can call node commands with `clusterName` so that the command will apply to all nodes in the cluster - [`destroy`](#avalanche-node-destroy): (ALPHA Warning) This command is currently in experimental mode. The node destroy command terminates all running nodes in cloud server and deletes all storage disks. If there is a static IP address attached, it will be released. - [`devnet`](#avalanche-node-devnet): (ALPHA Warning) This command is currently in experimental mode. The node devnet command suite provides a collection of commands related to devnets. You can check the updated status by calling avalanche node status `clusterName` - [`export`](#avalanche-node-export): (ALPHA Warning) This command is currently in experimental mode. The node export command exports cluster configuration and its nodes config to a text file. If no file is specified, the configuration is printed to the stdout. Use --include-secrets to include keys in the export. In this case please keep the file secure as it contains sensitive information. Exported cluster configuration without secrets can be imported by another user using node import command. - [`import`](#avalanche-node-import): (ALPHA Warning) This command is currently in experimental mode. The node import command imports cluster configuration and its nodes configuration from a text file created from the node export command. Prior to calling this command, call node whitelist command to have your SSH public key and IP whitelisted by the cluster owner. This will enable you to use avalanche-cli commands to manage the imported cluster. Please note, that this imported cluster will be considered as EXTERNAL by avalanche-cli, so some commands affecting cloud nodes like node create or node destroy will be not applicable to it. - [`list`](#avalanche-node-list): (ALPHA Warning) This command is currently in experimental mode. The node list command lists all clusters together with their nodes. - [`loadtest`](#avalanche-node-loadtest): (ALPHA Warning) This command is currently in experimental mode. The node loadtest command suite starts and stops a load test for an existing devnet cluster. - [`local`](#avalanche-node-local): The node local command suite provides a collection of commands related to local nodes - [`refresh-ips`](#avalanche-node-refresh-ips): (ALPHA Warning) This command is currently in experimental mode. The node refresh-ips command obtains the current IP for all nodes with dynamic IPs in the cluster, and updates the local node information used by CLI commands. - [`resize`](#avalanche-node-resize): (ALPHA Warning) This command is currently in experimental mode. The node resize command can change the amount of CPU, memory and disk space available for the cluster nodes. - [`scp`](#avalanche-node-scp): (ALPHA Warning) This command is currently in experimental mode. The node scp command securely copies files to and from nodes. Remote source or destionation can be specified using the following format: [clusterName|nodeID|instanceID|IP]:/path/to/file. Regular expressions are supported for the source files like /tmp/*.txt. File transfer to the nodes are parallelized. IF source or destination is cluster, the other should be a local file path. If both destinations are remote, they must be nodes for the same cluster and not clusters themselves. For example: $ avalanche node scp [cluster1|node1]:/tmp/file.txt /tmp/file.txt $ avalanche node scp /tmp/file.txt [cluster1|NodeID-XXXX]:/tmp/file.txt $ avalanche node scp node1:/tmp/file.txt NodeID-XXXX:/tmp/file.txt - [`ssh`](#avalanche-node-ssh): (ALPHA Warning) This command is currently in experimental mode. The node ssh command execute a given command [cmd] using ssh on all nodes in the cluster if ClusterName is given. If no command is given, just prints the ssh command to be used to connect to each node in the cluster. For provided NodeID or InstanceID or IP, the command [cmd] will be executed on that node. If no [cmd] is provided for the node, it will open ssh shell there. - [`status`](#avalanche-node-status): (ALPHA Warning) This command is currently in experimental mode. The node status command gets the bootstrap status of all nodes in a cluster with the Primary Network. If no cluster is given, defaults to node list behaviour. To get the bootstrap status of a node with a Blockchain, use --blockchain flag - [`sync`](#avalanche-node-sync): (ALPHA Warning) This command is currently in experimental mode. The node sync command enables all nodes in a cluster to be bootstrapped to a Blockchain. You can check the blockchain bootstrap status by calling avalanche node status `clusterName` --blockchain `blockchainName` - [`update`](#avalanche-node-update): (ALPHA Warning) This command is currently in experimental mode. The node update command suite provides a collection of commands for nodes to update their avalanchego or VM config. You can check the status after update by calling avalanche node status - [`upgrade`](#avalanche-node-upgrade): (ALPHA Warning) This command is currently in experimental mode. The node update command suite provides a collection of commands for nodes to update their avalanchego or VM version. You can check the status after upgrade by calling avalanche node status - [`validate`](#avalanche-node-validate): (ALPHA Warning) This command is currently in experimental mode. The node validate command suite provides a collection of commands for nodes to join the Primary Network and Subnets as validators. If any of the commands is run before the nodes are bootstrapped on the Primary Network, the command will fail. You can check the bootstrap status by calling avalanche node status `clusterName` - [`whitelist`](#avalanche-node-whitelist): (ALPHA Warning) The whitelist command suite provides a collection of tools for granting access to the cluster. Command adds IP if --ip params provided to cloud security access rules allowing it to access all nodes in the cluster via ssh or http. It also command adds SSH public key to all nodes in the cluster if --ssh params is there. If no params provided it detects current user IP automaticaly and whitelists it **Flags:** ```bash -h, --help help for node --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### addDashboard (ALPHA Warning) This command is currently in experimental mode. The node addDashboard command adds custom dashboard to the Grafana monitoring dashboard for the cluster. **Usage:** ```bash avalanche node addDashboard [subcommand] [flags] ``` **Flags:** ```bash --add-grafana-dashboard string path to additional grafana dashboard json file -h, --help help for addDashboard --subnet string subnet that the dasbhoard is intended for (if any) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### create (ALPHA Warning) This command is currently in experimental mode. The node create command sets up a validator on a cloud server of your choice. The validator will be validating the Avalanche Primary Network and Subnet of your choice. By default, the command runs an interactive wizard. It walks you through all the steps you need to set up a validator. Once this command is completed, you will have to wait for the validator to finish bootstrapping on the primary network before running further commands on it, e.g. validating a Subnet. You can check the bootstrapping status by running avalanche node status The created node will be part of group of validators called `clusterName` and users can call node commands with `clusterName` so that the command will apply to all nodes in the cluster **Usage:** ```bash avalanche node create [subcommand] [flags] ``` **Flags:** ```bash --add-grafana-dashboard string path to additional grafana dashboard json file --alternative-key-pair-name string key pair name to use if default one generates conflicts --authorize-access authorize CLI to create cloud resources --auto-replace-keypair automatically replaces key pair to access node if previous key pair is not found --avalanchego-version-from-subnet string install latest avalanchego version, that is compatible with the given subnet, on node/s --aws create node/s in AWS cloud --aws-profile string aws profile to use (default "default") --aws-volume-iops int AWS iops (for gp3, io1, and io2 volume types only) (default 3000) --aws-volume-size int AWS volume size in GB (default 1000) --aws-volume-throughput int AWS throughput in MiB/s (for gp3 volume type only) (default 125) --aws-volume-type string AWS volume type (default "gp3") --bootstrap-ids stringArray nodeIDs of bootstrap nodes --bootstrap-ips stringArray IP:port pairs of bootstrap nodes --cluster string operate on the given cluster --custom-avalanchego-version string install given avalanchego version on node/s --devnet operate on a devnet network --enable-monitoring set up Prometheus monitoring for created nodes. This option creates a separate monitoring cloud instance and incures additional cost --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --gcp create node/s in GCP cloud --gcp-credentials string use given GCP credentials --gcp-project string use given GCP project --genesis string path to genesis file --grafana-pkg string use grafana pkg instead of apt repo(by default), for example https://dl.grafana.com/oss/release/grafana_10.4.1_amd64.deb -h, --help help for create --latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s --latest-avalanchego-version install latest avalanchego release version on node/s -m, --mainnet operate on mainnet --node-type string cloud instance type. Use 'default' to use recommended default instance type --num-apis ints number of API nodes(nodes without stake) to create in the new Devnet --num-validators ints number of nodes to create per region(s). Use comma to separate multiple numbers for each region in the same order as --region flag --partial-sync primary network partial sync (default true) --public-http-port allow public access to avalanchego HTTP port --region strings create node(s) in given region(s). Use comma to separate multiple regions --ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used -t, --testnet fuji operate on testnet (alias to fuji) --upgrade string path to upgrade file --use-ssh-agent use ssh agent(ex: Yubikey) for ssh auth --use-static-ip attach static Public IP on cloud servers (default true) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### destroy (ALPHA Warning) This command is currently in experimental mode. The node destroy command terminates all running nodes in cloud server and deletes all storage disks. If there is a static IP address attached, it will be released. **Usage:** ```bash avalanche node destroy [subcommand] [flags] ``` **Flags:** ```bash --all destroy all existing clusters created by Avalanche CLI --authorize-access authorize CLI to release cloud resources -y, --authorize-all authorize all CLI requests --authorize-remove authorize CLI to remove all local files related to cloud nodes --aws-profile string aws profile to use (default "default") -h, --help help for destroy --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### devnet (ALPHA Warning) This command is currently in experimental mode. The node devnet command suite provides a collection of commands related to devnets. You can check the updated status by calling avalanche node status `clusterName` **Usage:** ```bash avalanche node devnet [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-node-devnet-deploy): (ALPHA Warning) This command is currently in experimental mode. The node devnet deploy command deploys a subnet into a devnet cluster, creating subnet and blockchain txs for it. It saves the deploy info both locally and remotely. - [`wiz`](#avalanche-node-devnet-wiz): (ALPHA Warning) This command is currently in experimental mode. The node wiz command creates a devnet and deploys, sync and validate a subnet into it. It creates the subnet if so needed. **Flags:** ```bash -h, --help help for devnet --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### devnet deploy (ALPHA Warning) This command is currently in experimental mode. The node devnet deploy command deploys a subnet into a devnet cluster, creating subnet and blockchain txs for it. It saves the deploy info both locally and remotely. **Usage:** ```bash avalanche node devnet deploy [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for deploy --no-checks do not check for healthy status or rpc compatibility of nodes against subnet --subnet-aliases strings additional subnet aliases to be used for RPC calls in addition to subnet blockchain name --subnet-only only create a subnet --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### devnet wiz (ALPHA Warning) This command is currently in experimental mode. The node wiz command creates a devnet and deploys, sync and validate a subnet into it. It creates the subnet if so needed. **Usage:** ```bash avalanche node devnet wiz [subcommand] [flags] ``` **Flags:** ```bash --add-grafana-dashboard string path to additional grafana dashboard json file --alternative-key-pair-name string key pair name to use if default one generates conflicts --authorize-access authorize CLI to create cloud resources --auto-replace-keypair automatically replaces key pair to access node if previous key pair is not found --aws create node/s in AWS cloud --aws-profile string aws profile to use (default "default") --aws-volume-iops int AWS iops (for gp3, io1, and io2 volume types only) (default 3000) --aws-volume-size int AWS volume size in GB (default 1000) --aws-volume-throughput int AWS throughput in MiB/s (for gp3 volume type only) (default 125) --aws-volume-type string AWS volume type (default "gp3") --chain-config string path to the chain configuration for subnet --custom-avalanchego-version string install given avalanchego version on node/s --custom-subnet use a custom VM as the subnet virtual machine --custom-vm-branch string custom vm branch or commit --custom-vm-build-script string custom vm build-script --custom-vm-repo-url string custom vm repository url --default-validator-params use default weight/start/duration params for subnet validator --deploy-icm-messenger deploy Interchain Messenger (default true) --deploy-icm-registry deploy Interchain Registry (default true) --deploy-teleporter-messenger deploy Interchain Messenger (default true) --deploy-teleporter-registry deploy Interchain Registry (default true) --enable-monitoring set up Prometheus monitoring for created nodes. Please note that this option creates a separate monitoring instance and incures additional cost --evm-chain-id uint chain ID to use with Subnet-EVM --evm-defaults use default production settings with Subnet-EVM --evm-production-defaults use default production settings for your blockchain --evm-subnet use Subnet-EVM as the subnet virtual machine --evm-test-defaults use default test settings for your blockchain --evm-token string token name to use with Subnet-EVM --evm-version string version of Subnet-EVM to use --force-subnet-create overwrite the existing subnet configuration if one exists --gcp create node/s in GCP cloud --gcp-credentials string use given GCP credentials --gcp-project string use given GCP project --grafana-pkg string use grafana pkg instead of apt repo(by default), for example https://dl.grafana.com/oss/release/grafana_10.4.1_amd64.deb -h, --help help for wiz --icm generate an icm-ready vm --icm-messenger-contract-address-path string path to an icm messenger contract address file --icm-messenger-deployer-address-path string path to an icm messenger deployer address file --icm-messenger-deployer-tx-path string path to an icm messenger deployer tx file --icm-registry-bytecode-path string path to an icm registry bytecode file --icm-version string icm version to deploy (default "latest") --latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s --latest-avalanchego-version install latest avalanchego release version on node/s --latest-evm-version use latest Subnet-EVM released version --latest-pre-released-evm-version use latest Subnet-EVM pre-released version --node-config string path to avalanchego node configuration for subnet --node-type string cloud instance type. Use 'default' to use recommended default instance type --num-apis ints number of API nodes(nodes without stake) to create in the new Devnet --num-validators ints number of nodes to create per region(s). Use comma to separate multiple numbers for each region in the same order as --region flag --public-http-port allow public access to avalanchego HTTP port --region strings create node/s in given region(s). Use comma to separate multiple regions --relayer run AWM relayer when deploying the vm --ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used. --subnet-aliases strings additional subnet aliases to be used for RPC calls in addition to subnet blockchain name --subnet-config string path to the subnet configuration for subnet --subnet-genesis string file path of the subnet genesis --teleporter generate an icm-ready vm --teleporter-messenger-contract-address-path string path to an icm messenger contract address file --teleporter-messenger-deployer-address-path string path to an icm messenger deployer address file --teleporter-messenger-deployer-tx-path string path to an icm messenger deployer tx file --teleporter-registry-bytecode-path string path to an icm registry bytecode file --teleporter-version string icm version to deploy (default "latest") --use-ssh-agent use ssh agent for ssh --use-static-ip attach static Public IP on cloud servers (default true) --validators strings deploy subnet into given comma separated list of validators. defaults to all cluster nodes --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### export (ALPHA Warning) This command is currently in experimental mode. The node export command exports cluster configuration and its nodes config to a text file. If no file is specified, the configuration is printed to the stdout. Use --include-secrets to include keys in the export. In this case please keep the file secure as it contains sensitive information. Exported cluster configuration without secrets can be imported by another user using node import command. **Usage:** ```bash avalanche node export [subcommand] [flags] ``` **Flags:** ```bash --file string specify the file to export the cluster configuration to --force overwrite the file if it exists -h, --help help for export --include-secrets include keys in the export --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### import (ALPHA Warning) This command is currently in experimental mode. The node import command imports cluster configuration and its nodes configuration from a text file created from the node export command. Prior to calling this command, call node whitelist command to have your SSH public key and IP whitelisted by the cluster owner. This will enable you to use avalanche-cli commands to manage the imported cluster. Please note, that this imported cluster will be considered as EXTERNAL by avalanche-cli, so some commands affecting cloud nodes like node create or node destroy will be not applicable to it. **Usage:** ```bash avalanche node import [subcommand] [flags] ``` **Flags:** ```bash --file string specify the file to export the cluster configuration to -h, --help help for import --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### list (ALPHA Warning) This command is currently in experimental mode. The node list command lists all clusters together with their nodes. **Usage:** ```bash avalanche node list [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for list --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### loadtest (ALPHA Warning) This command is currently in experimental mode. The node loadtest command suite starts and stops a load test for an existing devnet cluster. **Usage:** ```bash avalanche node loadtest [subcommand] [flags] ``` **Subcommands:** - [`start`](#avalanche-node-loadtest-start): (ALPHA Warning) This command is currently in experimental mode. The node loadtest command starts load testing for an existing devnet cluster. If the cluster does not have an existing load test host, the command creates a separate cloud server and builds the load test binary based on the provided load test Git Repo URL and load test binary build command. The command will then run the load test binary based on the provided load test run command. - [`stop`](#avalanche-node-loadtest-stop): (ALPHA Warning) This command is currently in experimental mode. The node loadtest stop command stops load testing for an existing devnet cluster and terminates the separate cloud server created to host the load test. **Flags:** ```bash -h, --help help for loadtest --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### loadtest start (ALPHA Warning) This command is currently in experimental mode. The node loadtest command starts load testing for an existing devnet cluster. If the cluster does not have an existing load test host, the command creates a separate cloud server and builds the load test binary based on the provided load test Git Repo URL and load test binary build command. The command will then run the load test binary based on the provided load test run command. **Usage:** ```bash avalanche node loadtest start [subcommand] [flags] ``` **Flags:** ```bash --authorize-access authorize CLI to create cloud resources --aws create loadtest node in AWS cloud --aws-profile string aws profile to use (default "default") --gcp create loadtest in GCP cloud -h, --help help for start --load-test-branch string load test branch or commit --load-test-build-cmd string command to build load test binary --load-test-cmd string command to run load test --load-test-repo string load test repo url to use --node-type string cloud instance type for loadtest script --region string create load test node in a given region --ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used --use-ssh-agent use ssh agent(ex: Yubikey) for ssh auth --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### loadtest stop (ALPHA Warning) This command is currently in experimental mode. The node loadtest stop command stops load testing for an existing devnet cluster and terminates the separate cloud server created to host the load test. **Usage:** ```bash avalanche node loadtest stop [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for stop --load-test strings stop specified load test node(s). Use comma to separate multiple load test instance names --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### local The node local command suite provides a collection of commands related to local nodes **Usage:** ```bash avalanche node local [subcommand] [flags] ``` **Subcommands:** - [`destroy`](#avalanche-node-local-destroy): Cleanup local node. - [`start`](#avalanche-node-local-start): The node local start command creates Avalanche nodes on the local machine. Once this command is completed, you will have to wait for the Avalanche node to finish bootstrapping on the primary network before running further commands on it, e.g. validating a Subnet. You can check the bootstrapping status by running avalanche node status local. - [`status`](#avalanche-node-local-status): Get status of local node. - [`stop`](#avalanche-node-local-stop): Stop local node. - [`track`](#avalanche-node-local-track): Track specified blockchain with local node - [`validate`](#avalanche-node-local-validate): Use Avalanche Node set up on local machine to set up specified L1 by providing the RPC URL of the L1. This command can only be used to validate Proof of Stake L1. **Flags:** ```bash -h, --help help for local --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local destroy Cleanup local node. **Usage:** ```bash avalanche node local destroy [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for destroy --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local start The node local start command creates Avalanche nodes on the local machine. Once this command is completed, you will have to wait for the Avalanche node to finish bootstrapping on the primary network before running further commands on it, e.g. validating a Subnet. You can check the bootstrapping status by running avalanche node status local. **Usage:** ```bash avalanche node local start [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-path string use this avalanchego binary path --bootstrap-id stringArray nodeIDs of bootstrap nodes --bootstrap-ip stringArray IP:port pairs of bootstrap nodes --cluster string operate on the given cluster --custom-avalanchego-version string install given avalanchego version on node/s --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --genesis string path to genesis file -h, --help help for start --latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s (default true) --latest-avalanchego-version install latest avalanchego release version on node/s -l, --local operate on a local network -m, --mainnet operate on mainnet --node-config string path to common avalanchego config settings for all nodes --num-nodes uint32 number of Avalanche nodes to create on local machine (default 1) --partial-sync primary network partial sync (default true) --staking-cert-key-path string path to provided staking cert key for node --staking-signer-key-path string path to provided staking signer key for node --staking-tls-key-path string path to provided staking tls key for node -t, --testnet fuji operate on testnet (alias to fuji) --upgrade string path to upgrade file --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local status Get status of local node. **Usage:** ```bash avalanche node local status [subcommand] [flags] ``` **Flags:** ```bash --blockchain string specify the blockchain the node is syncing with -h, --help help for status --l1 string specify the blockchain the node is syncing with --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local stop Stop local node. **Usage:** ```bash avalanche node local stop [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for stop --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local track Track specified blockchain with local node **Usage:** ```bash avalanche node local track [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-path string use this avalanchego binary path --custom-avalanchego-version string install given avalanchego version on node/s -h, --help help for track --latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s (default true) --latest-avalanchego-version install latest avalanchego release version on node/s --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local validate Use Avalanche Node set up on local machine to set up specified L1 by providing the RPC URL of the L1. This command can only be used to validate Proof of Stake L1. **Usage:** ```bash avalanche node local validate [subcommand] [flags] ``` **Flags:** ```bash --aggregator-log-level string log level to use with signature aggregator (default "Debug") --aggregator-log-to-stdout use stdout for signature aggregator logs --balance float amount of AVAX to increase validator's balance by --blockchain string specify the blockchain the node is syncing with --delegation-fee uint16 delegation fee (in bips) (default 100) --disable-owner string P-Chain address that will able to disable the validator with a P-Chain transaction -h, --help help for validate --l1 string specify the blockchain the node is syncing with --minimum-stake-duration uint minimum stake duration (in seconds) (default 100) --remaining-balance-owner string P-Chain address that will receive any leftover AVAX from the validator when it is removed from Subnet --rpc string connect to validator manager at the given rpc endpoint --stake-amount uint amount of tokens to stake --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### refresh-ips (ALPHA Warning) This command is currently in experimental mode. The node refresh-ips command obtains the current IP for all nodes with dynamic IPs in the cluster, and updates the local node information used by CLI commands. **Usage:** ```bash avalanche node refresh-ips [subcommand] [flags] ``` **Flags:** ```bash --aws-profile string aws profile to use (default "default") -h, --help help for refresh-ips --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### resize (ALPHA Warning) This command is currently in experimental mode. The node resize command can change the amount of CPU, memory and disk space available for the cluster nodes. **Usage:** ```bash avalanche node resize [subcommand] [flags] ``` **Flags:** ```bash --aws-profile string aws profile to use (default "default") --disk-size string Disk size to resize in Gb (e.g. 1000Gb) -h, --help help for resize --node-type string Node type to resize (e.g. t3.2xlarge) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### scp (ALPHA Warning) This command is currently in experimental mode. The node scp command securely copies files to and from nodes. Remote source or destionation can be specified using the following format: [clusterName|nodeID|instanceID|IP]:/path/to/file. Regular expressions are supported for the source files like /tmp/*.txt. File transfer to the nodes are parallelized. IF source or destination is cluster, the other should be a local file path. If both destinations are remote, they must be nodes for the same cluster and not clusters themselves. For example: $ avalanche node scp [cluster1|node1]:/tmp/file.txt /tmp/file.txt $ avalanche node scp /tmp/file.txt [cluster1|NodeID-XXXX]:/tmp/file.txt $ avalanche node scp node1:/tmp/file.txt NodeID-XXXX:/tmp/file.txt **Usage:** ```bash avalanche node scp [subcommand] [flags] ``` **Flags:** ```bash --compress use compression for ssh -h, --help help for scp --recursive copy directories recursively --with-loadtest include loadtest node for scp cluster operations --with-monitor include monitoring node for scp cluster operations --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### ssh (ALPHA Warning) This command is currently in experimental mode. The node ssh command execute a given command [cmd] using ssh on all nodes in the cluster if ClusterName is given. If no command is given, just prints the ssh command to be used to connect to each node in the cluster. For provided NodeID or InstanceID or IP, the command [cmd] will be executed on that node. If no [cmd] is provided for the node, it will open ssh shell there. **Usage:** ```bash avalanche node ssh [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for ssh --parallel run ssh command on all nodes in parallel --with-loadtest include loadtest node for ssh cluster operations --with-monitor include monitoring node for ssh cluster operations --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### status (ALPHA Warning) This command is currently in experimental mode. The node status command gets the bootstrap status of all nodes in a cluster with the Primary Network. If no cluster is given, defaults to node list behaviour. To get the bootstrap status of a node with a Blockchain, use --blockchain flag **Usage:** ```bash avalanche node status [subcommand] [flags] ``` **Flags:** ```bash --blockchain string specify the blockchain the node is syncing with -h, --help help for status --subnet string specify the blockchain the node is syncing with --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### sync (ALPHA Warning) This command is currently in experimental mode. The node sync command enables all nodes in a cluster to be bootstrapped to a Blockchain. You can check the blockchain bootstrap status by calling avalanche node status `clusterName` --blockchain `blockchainName` **Usage:** ```bash avalanche node sync [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for sync --no-checks do not check for bootstrapped/healthy status or rpc compatibility of nodes against subnet --subnet-aliases strings subnet alias to be used for RPC calls. defaults to subnet blockchain ID --validators strings sync subnet into given comma separated list of validators. defaults to all cluster nodes --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### update (ALPHA Warning) This command is currently in experimental mode. The node update command suite provides a collection of commands for nodes to update their avalanchego or VM config. You can check the status after update by calling avalanche node status **Usage:** ```bash avalanche node update [subcommand] [flags] ``` **Subcommands:** - [`subnet`](#avalanche-node-update-subnet): (ALPHA Warning) This command is currently in experimental mode. The node update subnet command updates all nodes in a cluster with latest Subnet configuration and VM for custom VM. You can check the updated subnet bootstrap status by calling avalanche node status `clusterName` --subnet `subnetName` **Flags:** ```bash -h, --help help for update --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### update subnet (ALPHA Warning) This command is currently in experimental mode. The node update subnet command updates all nodes in a cluster with latest Subnet configuration and VM for custom VM. You can check the updated subnet bootstrap status by calling avalanche node status `clusterName` --subnet `subnetName` **Usage:** ```bash avalanche node update subnet [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for subnet --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### upgrade (ALPHA Warning) This command is currently in experimental mode. The node update command suite provides a collection of commands for nodes to update their avalanchego or VM version. You can check the status after upgrade by calling avalanche node status **Usage:** ```bash avalanche node upgrade [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for upgrade --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### validate (ALPHA Warning) This command is currently in experimental mode. The node validate command suite provides a collection of commands for nodes to join the Primary Network and Subnets as validators. If any of the commands is run before the nodes are bootstrapped on the Primary Network, the command will fail. You can check the bootstrap status by calling avalanche node status `clusterName` **Usage:** ```bash avalanche node validate [subcommand] [flags] ``` **Subcommands:** - [`primary`](#avalanche-node-validate-primary): (ALPHA Warning) This command is currently in experimental mode. The node validate primary command enables all nodes in a cluster to be validators of Primary Network. - [`subnet`](#avalanche-node-validate-subnet): (ALPHA Warning) This command is currently in experimental mode. The node validate subnet command enables all nodes in a cluster to be validators of a Subnet. If the command is run before the nodes are Primary Network validators, the command will first make the nodes Primary Network validators before making them Subnet validators. If The command is run before the nodes are bootstrapped on the Primary Network, the command will fail. You can check the bootstrap status by calling avalanche node status `clusterName` If The command is run before the nodes are synced to the subnet, the command will fail. You can check the subnet sync status by calling avalanche node status `clusterName` --subnet `subnetName` **Flags:** ```bash -h, --help help for validate --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### validate primary (ALPHA Warning) This command is currently in experimental mode. The node validate primary command enables all nodes in a cluster to be validators of Primary Network. **Usage:** ```bash avalanche node validate primary [subcommand] [flags] ``` **Flags:** ```bash -e, --ewoq use ewoq key [fuji/devnet only] -h, --help help for primary -k, --key string select the key to use [fuji only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses --stake-amount uint how many AVAX to stake in the validator --staking-period duration how long validator validates for after start time --start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### validate subnet (ALPHA Warning) This command is currently in experimental mode. The node validate subnet command enables all nodes in a cluster to be validators of a Subnet. If the command is run before the nodes are Primary Network validators, the command will first make the nodes Primary Network validators before making them Subnet validators. If The command is run before the nodes are bootstrapped on the Primary Network, the command will fail. You can check the bootstrap status by calling avalanche node status `clusterName` If The command is run before the nodes are synced to the subnet, the command will fail. You can check the subnet sync status by calling avalanche node status `clusterName` --subnet `subnetName` **Usage:** ```bash avalanche node validate subnet [subcommand] [flags] ``` **Flags:** ```bash --default-validator-params use default weight/start/duration params for subnet validator -e, --ewoq use ewoq key [fuji/devnet only] -h, --help help for subnet -k, --key string select the key to use [fuji/devnet only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses --no-checks do not check for bootstrapped status or healthy status --no-validation-checks do not check if subnet is already synced or validated (default true) --stake-amount uint how many AVAX to stake in the validator --staking-period duration how long validator validates for after start time --start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format --validators strings validate subnet for the given comma separated list of validators. defaults to all cluster nodes --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### whitelist (ALPHA Warning) The whitelist command suite provides a collection of tools for granting access to the cluster. Command adds IP if --ip params provided to cloud security access rules allowing it to access all nodes in the cluster via ssh or http. It also command adds SSH public key to all nodes in the cluster if --ssh params is there. If no params provided it detects current user IP automaticaly and whitelists it **Usage:** ```bash avalanche node whitelist [subcommand] [flags] ``` **Flags:** ```bash -y, --current-ip whitelist current host ip -h, --help help for whitelist --ip string ip address to whitelist --ssh string ssh public key to whitelist --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche primary The primary command suite provides a collection of tools for interacting with the Primary Network **Usage:** ```bash avalanche primary [subcommand] [flags] ``` **Subcommands:** - [`addValidator`](#avalanche-primary-addvalidator): The primary addValidator command adds a node as a validator in the Primary Network - [`describe`](#avalanche-primary-describe): The subnet describe command prints details of the primary network configuration to the console. **Flags:** ```bash -h, --help help for primary --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### addValidator The primary addValidator command adds a node as a validator in the Primary Network **Usage:** ```bash avalanche primary addValidator [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --delegation-fee uint32 set the delegation fee (20 000 is equivalent to 2%) --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for addValidator -k, --key string select the key to use [fuji only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses -m, --mainnet operate on mainnet --nodeID string set the NodeID of the validator to add --proof-of-possession string set the BLS proof of possession of the validator to add --public-key string set the BLS public key of the validator to add --staking-period duration how long this validator will be staking --start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format -t, --testnet fuji operate on testnet (alias to fuji) --weight uint set the staking weight of the validator to add --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### describe The subnet describe command prints details of the primary network configuration to the console. **Usage:** ```bash avalanche primary describe [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster -h, --help help for describe -l, --local operate on a local network --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche transaction The transaction command suite provides all of the utilities required to sign multisig transactions. **Usage:** ```bash avalanche transaction [subcommand] [flags] ``` **Subcommands:** - [`commit`](#avalanche-transaction-commit): The transaction commit command commits a transaction by submitting it to the P-Chain. - [`sign`](#avalanche-transaction-sign): The transaction sign command signs a multisig transaction. **Flags:** ```bash -h, --help help for transaction --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### commit The transaction commit command commits a transaction by submitting it to the P-Chain. **Usage:** ```bash avalanche transaction commit [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for commit --input-tx-filepath string Path to the transaction signed by all signatories --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### sign The transaction sign command signs a multisig transaction. **Usage:** ```bash avalanche transaction sign [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for sign --input-tx-filepath string Path to the transaction file for signing -k, --key string select the key to use [fuji only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche update Check if an update is available, and prompt the user to install it **Usage:** ```bash avalanche update [subcommand] [flags] ``` **Flags:** ```bash -c, --confirm Assume yes for installation -h, --help help for update -v, --version version for update --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche validator The validator command suite provides a collection of tools for managing validator balance on P-Chain. Validator's balance is used to pay for continuous fee to the P-Chain. When this Balance reaches 0, the validator will be considered inactive and will no longer participate in validating the L1 **Usage:** ```bash avalanche validator [subcommand] [flags] ``` **Subcommands:** - [`getBalance`](#avalanche-validator-getbalance): This command gets the remaining validator P-Chain balance that is available to pay P-Chain continuous fee - [`increaseBalance`](#avalanche-validator-increasebalance): This command increases the validator P-Chain balance - [`list`](#avalanche-validator-list): This command gets a list of the validators of the L1 **Flags:** ```bash -h, --help help for validator --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### getBalance This command gets the remaining validator P-Chain balance that is available to pay P-Chain continuous fee **Usage:** ```bash avalanche validator getBalance [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for getBalance --l1 string name of L1 -l, --local operate on a local network -m, --mainnet operate on mainnet --node-id string node ID of the validator -t, --testnet fuji operate on testnet (alias to fuji) --validation-id string validation ID of the validator --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### increaseBalance This command increases the validator P-Chain balance **Usage:** ```bash avalanche validator increaseBalance [subcommand] [flags] ``` **Flags:** ```bash --balance float amount of AVAX to increase validator's balance by --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for increaseBalance -k, --key string select the key to use [fuji/devnet deploy only] --l1 string name of L1 (to increase balance of bootstrap validators only) -l, --local operate on a local network -m, --mainnet operate on mainnet --node-id string node ID of the validator -t, --testnet fuji operate on testnet (alias to fuji) --validation-id string validationIDStr of the validator --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### list This command gets a list of the validators of the L1 **Usage:** ```bash avalanche validator list [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for list -l, --local operate on a local network -m, --mainnet operate on mainnet -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` # Getting Started (/docs/api-reference/metrics-api/getting-started) --- title: Getting Started description: Getting Started with the Metrics API icon: Rocket --- The Metrics API is designed to be simple and accessible, requiring no authentication to get started. Just choose your endpoint, make your query, and instantly access on-chain data and analytics to power your applications. The following query retrieves the daily count of active addresses on the Avalanche C-Chain(43114) over the course of one month (from August 1, 2024 12:00:00 AM to August 31, 2024 12:00:00 AM), providing insights into user activity on the chain for each day during that period. With this data you can use JavaScript visualization tools like Chart.js, D3.js, Highcharts, Plotly.js, or Recharts to create interactive and insightful visual representations. ```bash curl --request GET \ --url 'https://metrics.avax.network/v2/chains/43114/metrics/activeAddresses?startTimestamp=1722470400&endTimestamp=1725062400&timeInterval=day&pageSize=31' ``` Response: ```json { "results": [ { "value": 37738, "timestamp": 1724976000 }, { "value": 53934, "timestamp": 1724889600 }, { "value": 58992, "timestamp": 1724803200 }, { "value": 73792, "timestamp": 1724716800 }, { "value": 70057, "timestamp": 1724630400 }, { "value": 46452, "timestamp": 1724544000 }, { "value": 46323, "timestamp": 1724457600 }, { "value": 73399, "timestamp": 1724371200 }, { "value": 52661, "timestamp": 1724284800 }, { "value": 52497, "timestamp": 1724198400 }, { "value": 50574, "timestamp": 1724112000 }, { "value": 46999, "timestamp": 1724025600 }, { "value": 45320, "timestamp": 1723939200 }, { "value": 54964, "timestamp": 1723852800 }, { "value": 60251, "timestamp": 1723766400 }, { "value": 48493, "timestamp": 1723680000 }, { "value": 71091, "timestamp": 1723593600 }, { "value": 50456, "timestamp": 1723507200 }, { "value": 46989, "timestamp": 1723420800 }, { "value": 50984, "timestamp": 1723334400 }, { "value": 46988, "timestamp": 1723248000 }, { "value": 66943, "timestamp": 1723161600 }, { "value": 64209, "timestamp": 1723075200 }, { "value": 57478, "timestamp": 1722988800 }, { "value": 80553, "timestamp": 1722902400 }, { "value": 70472, "timestamp": 1722816000 }, { "value": 53678, "timestamp": 1722729600 }, { "value": 70818, "timestamp": 1722643200 }, { "value": 99842, "timestamp": 1722556800 }, { "value": 76515, "timestamp": 1722470400 } ] } ``` Congratulations! You’ve successfully made your first query to the Metrics API. 🚀🚀🚀 # Metrics API (/docs/api-reference/metrics-api) --- title: Metrics API description: Access real-time and historical metrics for Avalanche networks icon: ChartLine --- ### What is the Metrics API? The Metrics API equips web3 developers with a robust suite of tools to access and analyze on-chain activity across Avalanche’s primary network, Avalanche L1s, and other supported EVM chains. This API delivers comprehensive metrics and analytics, enabling you to seamlessly integrate historical data on transactions, gas consumption, throughput, staking, and more into your applications. The Metrics API, along with the [Data API](/docs/api-reference/data-api) are the driving force behind every graph you see on the [Avalanche Explorer](https://explorer.avax.network/). From transaction trends to staking insights, the visualizations and data presented are all powered by these APIs, offering real-time and historical insights that are essential for building sophisticated, data-driven blockchain products.. ### Features * **Chain Throughput:** Retrieve detailed metrics on gas consumption, Transactions Per Second (TPS), and gas prices, including rolling windows of data for granular analysis. * **Cumulative Metrics:** Access cumulative data on addresses, contracts, deployers, and transaction counts, providing insights into network growth over time. * **Staking Information:** Obtain staking-related data, including the number of validators and delegators, along with their respective weights, across different subnets. * **Blockchains and Subnets:** Get information about supported blockchains, including EVM Chain IDs, blockchain IDs, and subnet associations, facilitating multi-chain analytics. * **Composite Queries:** Perform advanced queries by combining different metric types and conditions, enabling detailed and customizable data retrieval. The Metrics API is designed to provide developers with powerful tools to analyze and monitor on-chain activity across Avalanche’s primary network, Avalanche L1s, and other supported EVM chains. Below is an overview of the key features available: ### Chain Throughput Metrics * **Gas Consumption**
Track the average and maximum gas consumption per second, helping to understand network performance and efficiency. * **Transactions Per Second (TPS)**
Monitor the average and peak TPS to assess the network’s capacity and utilization. * **Gas Prices**
Analyze average and maximum gas prices over time to optimize transaction costs and predict fee trends. Monitor the average and peak TPS to assess the network’s capacity and utilization. ### Cumulative Metrics * **Address Growth**
Access the cumulative number of active addresses on a chain, providing insights into network adoption and user activity. * **Contract Deployment**
Monitor the cumulative number of smart contracts deployed, helping to gauge developer engagement and platform usage. * **Transaction Count**
Track the cumulative number of transactions, offering a clear view of network activity and transaction volume. ### Staking Information * **Validator and Delegator Counts**
Retrieve the number of active validators and delegators for a given L1, crucial for understanding network security and decentralization. * **Staking Weights**
Access the total stake weight of validators and delegators, helping to assess the distribution of staked assets across the network. ### Rolling Window Analytics * **Short-Term and Long-Term Metrics:** Perform rolling window analysis on various metrics like gas used, TPS, and gas prices, allowing for both short-term and long-term trend analysis. * **Customizable Time Frames:** Choose from different time intervals (hourly, daily, monthly) to suit your specific analytical needs. ### Blockchain and L1 Information * **Chain and L1 Mapping:** Get detailed information about EVM chains and their associated L1s, including chain IDs, blockchain IDs, and subnet IDs, facilitating cross-chain analytics. ### Advanced Composite Queries * **Custom Metrics Combinations**: Combine multiple metrics and apply logical operators to perform sophisticated queries, enabling deep insights and tailored analytics. * **Paginated Results:** Handle large datasets efficiently with paginated responses, ensuring seamless data retrieval in your applications. The Metrics API equips developers with the tools needed to build robust analytics, monitoring, and reporting solutions, leveraging the full power of multi-chain data across the Avalanche ecosystem and beyond. # Rate Limits (/docs/api-reference/metrics-api/rate-limits) --- title: Rate Limits description: Rate Limits for the Metrics API icon: Clock --- # Rate Limits Rate limiting is managed through a weighted scoring system, known as Compute Units (CUs). Each API request consumes a specified number of CUs, determined by the complexity of the request. This system is designed to accommodate basic requests while efficiently handling more computationally intensive operations. ## Rate Limit Tiers The maximum CUs (rate-limiting score) for a user depends on their subscription level and is delineated in the following table: | Subscription Level | Per Minute Limit (CUs) | Per Day Limit (CUs) | | :----------------- | :--------------------- | :------------------ | | Free | 8,000 | 1,200,000 | > We are working on new subscription tiers with higher rate limits to support even greater request volumes. ## Rate Limit Categories The CUs for each category are defined in the following table: | Weight | CU Value | | :----- | :------- | | Free | 1 | | Small | 20 | | Medium | 100 | | Large | 500 | | XL | 1000 | | XXL | 3000 | ## Rate Limits for Metrics Endpoints The CUs for each route are defined in the table below: | Endpoint | Method | Weight | CU Value | | :---------------------------------------------------------- | :----- | :----- | :------- | | `/v2/health-check` | GET | Free | 1 | | `/v2/chains` | GET | Free | 1 | | `/v2/chains/{chainId}` | GET | Free | 1 | | `/v2/chains/{chainId}/metrics/{metric}` | GET | Medium | 100 | | `/v2/chains/{chainId}/teleporterMetrics/{metric}` | GET | Medium | 100 | | `/v2/chains/{chainId}/rollingWindowMetrics/{metric}` | GET | Medium | 100 | | `/v2/networks/{network}/metrics/{metric}` | GET | Medium | 100 | | `/v2/chains/{chainId}/contracts/{address}/nfts:listHolders` | GET | Large | 500 | | `/v2/chains/{chainId}/contracts/{address}/balances` | GET | XL | 1000 | | `/v2/chains/43114/btcb/bridged:getAddresses` | GET | Large | 500 | | `/v2/subnets/{subnetId}/validators:getAddresses` | GET | Large | 500 | | `/v2/lookingGlass/compositeQuery` | POST | XXL | 3000 | All rate limits, weights, and CU values are subject to change. # Usage Guide (/docs/api-reference/metrics-api/usage-guide) --- title: Usage Guide description: Usage Guide for the Metrics API icon: Code --- The Metrics API does not require authentication, making it straightforward to integrate into your applications. You can start making API requests without the need for an API key or any authentication headers. #### Making Requests You can interact with the Metrics API by sending HTTP GET requests to the provided endpoints. Below is an example of a simple `curl` request. ```bash curl -H "Content-Type: Application/json" "https://metrics.avax.network/v1/avg_tps/{chainId}" ``` In the above request Replace `chainId` with the specific chain ID you want to query. For example, to retrieve the average transactions per second (TPS) for a specific chain (in this case, chain ID 43114), you can use the following endpoint: ```bash curl "https://metrics.avax.network/v1/avg_tps/43114" ``` The API will return a JSON response containing the average TPS for the specified chain over a series of timestamps and `lastRun` is a timestamp indicating when the last data point was updated: ```json { "results": [ {"timestamp": 1724716800, "value": 1.98}, {"timestamp": 1724630400, "value": 2.17}, {"timestamp": 1724544000, "value": 1.57}, {"timestamp": 1724457600, "value": 1.82}, // Additional data points... ], "status": 200, "lastRun": 1724780812 } ``` ### Rate Limits Even though the Metrics API does not require authentication, it still enforces rate limits to ensure stability and performance. If you exceed these limits, the server will respond with a 429 Too Many Requests HTTP response code. ### Error Types The API generates standard error responses along with error codes based on provided requests and parameters. Typically, response codes within the `2XX` range signifies successful requests, while those within the `4XX` range points to errors originating from the client's side. Meanwhile, response codes within the `5XX` range indicates problems on the server's side. The error response body is formatted like this: ```json { "message": ["Invalid address format"], // route specific error message "error": "Bad Request", // error type "statusCode": 400 // http response code } ``` Let's go through every error code that we can respond with: | Error Code | Error Type | Description | | ---------- | --------------------- | ----------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------- | | **400** | Bad Request | Bad requests generally mean the client has passed invalid or malformed parameters. Error messages in the response could help in evaluating the error. | | **401** | Unauthorized | When a client attempts to access resources that require authorization credentials but the client lacks proper authentication in the request, the server responds with 401. | | **403** | Forbidden | When a client attempts to access resources with valid credentials but doesn't have the privilege to perform that action, the server responds with 403. | | **404** | Not Found | The 404 error is mostly returned when the client requests with either mistyped URL, or the passed resource is moved or deleted, or the resource doesn't exist. | | **500** | Internal Server Error | The 500 error is a generic server-side error that is returned for any uncaught and unexpected issues on the server side. This should be very rare, and you may reach out to us if the problem persists for a longer duration. | | **502** | Bad Gateway | This is an internal error indicating invalid response received by the client-facing proxy or gateway from the upstream server. | | **503** | Service Unavailable | The 503 error is returned for certain routes on a particular Subnet. This indicates an internal problem with our Subnet node, and may not necessarily mean the Subnet is down or affected. | ### Pagination For endpoints that return large datasets, the Metrics API employs pagination to manage the results. When querying for lists of data, you may receive a nextPageToken in the response, which can be used to request the next page of data. Example response with pagination: ```json { "results": [...], "nextPageToken": "3d22deea-ea64-4d30-8a1e-c2a353b67e90" } ``` To retrieve the next set of results, include the nextPageToken in your subsequent request: ```bash curl -H "Content-Type: Application/json" \ "https://metrics.avax.network/v1/avg_tps/{chainId}?pageToken=3d22deea-ea64-4d30-8a1e-c2a353b67e90" ``` ### Pagination Details #### Page Token Structure The `nextPageToken` is a UUID-based token provided in the response when additional pages of data are available. This token serves as a pointer to the next set of data. * **UUID Generation**: The `nextPageToken` is generated uniquely for each pagination scenario, ensuring security and ensuring predictability. * **Expiration**: The token is valid for 24 hours from the time it is generated. After this period, the token will expire, and a new request starting from the initial page will be required. * **Presence**: The token is only included in the response when there is additional data available. If no more data exists, the token will not be present. #### Integration and Usage To use the pagination system effectively: * Check if the `nextPageToken` is present in the response. * If present, include this token in the subsequent request to fetch the next page of results. * Ensure that the follow-up request is made within the 24-hour window after the token was generated to avoid token expiration. By utilizing the pagination mechanism, you can efficiently manage and navigate through large datasets, ensuring a smooth data retrieval process. ### Swagger API Reference You can explore the full API definitions and interact with the endpoints in the Swagger documentation at: [https://metrics.avax.network/api](https://metrics.avax.network/api) # Webhooks API (/docs/api-reference/webhook-api) --- title: Webhooks API description: Real-time notifications for blockchain events on Avalanche networks icon: Webhook --- ### What is the Webhooks API? The Webhooks API lets you monitor real-time events on the Avalanche ecosystem, including the C-chain, L1s, and the Platform Chain (P/X chains). By subscribing to specific events, you can receive instant notifications for on-chain occurrences without continuously polling the network. webhooks ### Key Features: * **Real-time notifications:** Receive immediate updates on specified on-chain activities without polling. * **Customizable:** Specify the desired event type to listen for, customizing notifications based on your individual requirements. * **Secure:** Employ shared secrets and signature-based verification to ensure that notifications originate from a trusted source. * **Broad Coverage:** * **C-chain:** Mainnet and testnet, covering smart contract events, NFT transfers, and wallet-to-wallet transactions. * **Platform Chain (P and X chains):** Address and validator events, staking activities, and other platform-level transactions. By supporting both the C-chain and the Platform Chain, you can monitor an even wider range of Avalanche activities. ### Use cases * **NFT marketplace transactions**: Get alerts for NFT minting, transfers, auctions, bids, sales, and other interactions within NFT marketplaces. * **Wallet notifications**: Receive alerts when an address performs actions such as sending, receiving, swapping, or burning assets. * **DeFi activities**: Receive notifications for various DeFi activities such as liquidity provisioning, yield farming, borrowing, lending, and liquidations. * **Staking rewards:** Get real-time notifications when a validator stakes, receives delegation, or earns staking rewards on the P-Chain, enabling seamless monitoring of validator earnings and participation. ## APIs for continuous polling vs. Webhooks for events data The following example uses the address activity webhook topic to illustrate the difference between polling an API for wallet event data versus subscribing to a webhook topic to receive wallet events. webhooks ### Continous polling Continuous polling is a method where your application repeatedly sends requests to an API at fixed intervals to check for new data or events. Think of it like checking your mailbox every five minutes to see if new mail has arrived, whether or not anything is there. * You want to track new transactions for a specific wallet. * Your application calls an API every few seconds (e.g., every 5 seconds) with a query like, “Are there any new transactions for this wallet since my last check?” * The API responds with either new transaction data or a confirmation that nothing has changed. **Downsides of continuous polling** * **Inefficiency:** Your app makes requests even when no new transactions occur, wasting computational resources, bandwidth, and potentially incurring higher API costs. For example, if no transactions happen for an hour, your app still sends hundreds of unnecessary requests. * **Delayed updates:** Since polling happens at set intervals, there’s a potential delay in detecting events. If a transaction occurs just after a poll, your app won’t know until the next check—up to 5 seconds later in our example. This lag can be critical for time-sensitive applications, like trading or notifications. * **Scalability challenges:** Monitoring one wallet might be manageable, but if you’re tracking dozens or hundreds of wallets, the number of requests multiplies quickly. ### Webhook subscription Webhooks are an event-driven alternative where your application subscribes to specific events, and the Avalanche service notifies you instantly when those events occur. It’s like signing up for a delivery alert—when the package (event) arrives, you get a text message right away, instead of checking the tracking site repeatedly. * Your app registers a webhook specifying an endpoint (e.g., `https://your-app.com/webhooks/transactions`) and the event type (e.g., `address_activity`). * When a new transaction occurs we send a POST request to your endpoint with the transaction details. * Your app receives the data only when something happens, with no need to ask repeatedly. **Benefits of Avalanche webhooks** * **Real-Time updates:** Notifications arrive the moment a transaction is processed, eliminating delays inherent in polling. This is ideal for applications needing immediate responses, like alerting users or triggering automated actions. * **Efficiency:** Your app doesn’t waste resources making requests when there’s no new data. Data flows only when events occur. This reduces server load, bandwidth usage, and API call quotas. * **Scalability:** You can subscribe to events for multiple wallets or event types (e.g., transactions, smart contract calls) without increasing the number of requests your app makes. We handle the event detection and delivery, so your app scales effortlessly as monitoring needs grow. ## Event payload structure The Event structure always begins with the following parameters: ```json theme={null} { "webhookId": "6d1bd383-aa8d-47b5-b793-da6d8a115fde", "eventType": "address_activity", "messageId": "8e4e7284-852a-478b-b425-27631c8d22d2", "event": { } } ``` **Parameters:** * `webhookId`: Unique identifier for the webhook in your account. * `eventType`: The event that caused the webhook to be triggered. In the future, there will be multiple types of events, for the time being only the address\_activity event is supported. The address\_activity event gets triggered whenever the specified addresses participate in a token or AVAX transaction. * `messageId`: Unique identifier per event sent. * `event`: Event payload. It contains details about the transaction, logs, and traces. By default logs and internal transactions are not included, if you want to include them use `"includeLogs": true`, and `"includeInternalTxs": true`. ### Address Activity webhook The address activity webhook allows you to track any interaction with an address (any address). Here is an example of this type of event: ```json theme={null} { "webhookId": "263942d1-74a4-4416-aeb4-948b9b9bb7cc", "eventType": "address_activity", "messageId": "94df1881-5d93-49d1-a1bd-607830608de2", "event": { "transaction": { "blockHash": "0xbd093536009f7dd785e9a5151d80069a93cc322f8b2df63d373865af4f6ee5be", "blockNumber": "44568834", "from": "0xf73166f0c75a3DF444fAbdFDC7e5EE4a73fA51C7", "gas": "651108", "gasPrice": "31466275484", "maxFeePerGas": "31466275484", "maxPriorityFeePerGas": "31466275484", "txHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4", "txStatus": "1", "input": "0xb80c2f090000000000000000000000000000000000000000000000000000000000000000000000000000000000000000eeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeeee000000000000000000000000b97ef9ef8734c71904d8002f8b6bc66dd9c48a6e000000000000000000000000000000000000000000000000006ca0c737b131f2000000000000000000000000000000000000000000000000000000000011554e000000000000000000000000000000000000000000000000000000006627dadc0000000000000000000000000000000000000000000000000000000000000120000000000000000000000000000000000000000000000000000000000000016000000000000000000000000000000000000000000000000000000000000004600000000000000000000000000000000000000000000000000000000000000001000000000000000000000000000000000000000000000000006ca0c737b131f2000000000000000000000000000000000000000000000000000000000000000100000000000000000000000000000000000000000000000000000000000000200000000000000000000000000000000000000000000000000000000000000001000000000000000000000000000000000000000000000000000000000000002000000000000000000000000000000000000000000000000000000000000000a000000000000000000000000000000000000000000000000000000000000000e000000000000000000000000000000000000000000000000000000000000001200000000000000000000000000000000000000000000000000000000000000160000000000000000000000000b31f66aa3c1e785363f0875a1b74e27b85fd66c70000000000000000000000000000000000000000000000000000000000000001000000000000000000000000be882fb094143b59dc5335d32cecb711570ebdd40000000000000000000000000000000000000000000000000000000000000001000000000000000000000000be882fb094143b59dc5335d32cecb711570ebdd400000000000000000000000000000000000000000000000000000000000000010000000000000000000027100e663593657b064e1bae76d28625df5d0ebd44210000000000000000000000000000000000000000000000000000000000000001000000000000000000000000000000000000000000000000000000000000002000000000000000000000000000000000000000000000000000000000000000c0000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000000400000000000000000000000000000000000000000000000000000000000000060000000000000000000000000b31f66aa3c1e785363f0875a1b74e27b85fd66c7000000000000000000000000b97ef9ef8734c71904d8002f8b6bc66dd9c48a6e0000000000000000000000000000000000000000000000000000000000000bb80000000000000000000000000000000000000000000000000000000000000000", "nonce": "4", "to": "0x1dac23e41fc8ce857e86fd8c1ae5b6121c67d96d", "transactionIndex": 0, "value": "30576074978046450", "type": 0, "chainId": "43114", "receiptCumulativeGasUsed": "212125", "receiptGasUsed": "212125", "receiptEffectiveGasPrice": "31466275484", "receiptRoot": "0xf355b81f3e76392e1b4926429d6abf8ec24601cc3d36d0916de3113aa80dd674", "erc20Transfers": [ { "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4", "type": "ERC20", "from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d", "to": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4", "value": "30576074978046450", "blockTimestamp": 1713884373, "logIndex": 2, "erc20Token": { "address": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7", "name": "Wrapped AVAX", "symbol": "WAVAX", "decimals": 18, "valueWithDecimals": "0.030576074978046448" } }, { "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4", "type": "ERC20", "from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421", "to": "0xf73166f0c75a3DF444fAbdFDC7e5EE4a73fA51C7", "value": "1195737", "blockTimestamp": 1713884373, "logIndex": 3, "erc20Token": { "address": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "name": "USD Coin", "symbol": "USDC", "decimals": 6, "valueWithDecimals": "1.195737" } }, { "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4", "type": "ERC20", "from": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4", "to": "0x0E663593657B064e1baE76d28625Df5D0eBd4421", "value": "30576074978046450", "blockTimestamp": 1713884373, "logIndex": 4, "erc20Token": { "address": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7", "name": "Wrapped AVAX", "symbol": "WAVAX", "decimals": 18, "valueWithDecimals": "0.030576074978046448" } } ], "erc721Transfers": [], "erc1155Transfers": [], "internalTransactions": [ { "from": "0xf73166f0c75a3DF444fAbdFDC7e5EE4a73fA51C7", "to": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d", "internalTxType": "CALL", "value": "30576074978046450", "gasUsed": "212125", "gasLimit": "651108", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d", "to": "0xF2781Bb34B6f6Bb9a6B5349b24de91487E653119", "internalTxType": "DELEGATECALL", "value": "30576074978046450", "gasUsed": "176417", "gasLimit": "605825", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d", "to": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "internalTxType": "STATICCALL", "value": "0", "gasUsed": "9750", "gasLimit": "585767", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "to": "0x30DFE0469803BcE76F8F62aC24b18d33D3d6FfE6", "internalTxType": "DELEGATECALL", "value": "0", "gasUsed": "2553", "gasLimit": "569571", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d", "to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7", "internalTxType": "CALL", "value": "30576074978046450", "gasUsed": "23878", "gasLimit": "566542", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d", "to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7", "internalTxType": "CALL", "value": "0", "gasUsed": "25116", "gasLimit": "540114", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d", "to": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4", "internalTxType": "CALL", "value": "0", "gasUsed": "81496", "gasLimit": "511279", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4", "to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7", "internalTxType": "STATICCALL", "value": "0", "gasUsed": "491", "gasLimit": "501085", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4", "to": "0x0E663593657B064e1baE76d28625Df5D0eBd4421", "internalTxType": "CALL", "value": "0", "gasUsed": "74900", "gasLimit": "497032", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421", "to": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "internalTxType": "CALL", "value": "0", "gasUsed": "32063", "gasLimit": "463431", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "to": "0x30DFE0469803BcE76F8F62aC24b18d33D3d6FfE6", "internalTxType": "DELEGATECALL", "value": "0", "gasUsed": "31363", "gasLimit": "455542", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421", "to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7", "internalTxType": "STATICCALL", "value": "0", "gasUsed": "2491", "gasLimit": "430998", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421", "to": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4", "internalTxType": "CALL", "value": "0", "gasUsed": "7591", "gasLimit": "427775", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0xbe882fb094143B59Dc5335D32cEcB711570EbDD4", "to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7", "internalTxType": "CALL", "value": "0", "gasUsed": "6016", "gasLimit": "419746", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x0E663593657B064e1baE76d28625Df5D0eBd4421", "to": "0xB31f66AA3C1e785363F0875A1B74E27b85FD66c7", "internalTxType": "STATICCALL", "value": "0", "gasUsed": "491", "gasLimit": "419670", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d", "to": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "internalTxType": "STATICCALL", "value": "0", "gasUsed": "3250", "gasLimit": "430493", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "to": "0x30DFE0469803BcE76F8F62aC24b18d33D3d6FfE6", "internalTxType": "DELEGATECALL", "value": "0", "gasUsed": "2553", "gasLimit": "423121", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0x1daC23e41Fc8ce857E86fD8C1AE5b6121C67D96d", "to": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "internalTxType": "STATICCALL", "value": "0", "gasUsed": "1250", "gasLimit": "426766", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" }, { "from": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "to": "0x30DFE0469803BcE76F8F62aC24b18d33D3d6FfE6", "internalTxType": "DELEGATECALL", "value": "0", "gasUsed": "553", "gasLimit": "419453", "transactionHash": "0xf6a791920652e87ccc91d2f1b20c1505a94452b88f359acdeb5a6fa8205638c4" } ], "blockTimestamp": 1713884373 } } } ``` # Rate Limits (/docs/api-reference/webhook-api/rate-limits) --- title: Rate Limits description: Rate Limits for the Webhooks API icon: Clock --- Rate limiting is managed through a weighted scoring system, known as Compute Units (CUs). Each API request consumes a specified number of CUs, determined by the complexity of the request. This system is designed to accommodate basic requests while efficiently handling more computationally intensive operations. ## Rate Limit Tiers The maximum CUs (rate-limiting score) for a user depends on their subscription level and is delineated in the following table: | Subscription Level | Per Minute Limit (CUs) | Per Day Limit (CUs) | | :----------------- | :--------------------- | :------------------ | | Unauthenticated | 6,000 | 1,200,000 | | Free | 8,000 | 2,000,000 | | Base | 10,000 | 3,750,000 | | Growth | 14,000 | 11,200,000 | | Pro | 20,000 | 25,000,000 | To update your subscription level use the [AvaCloud Portal](https://app.avacloud.io/) Note: Rate limits apply collectively across both Webhooks and Data APIs, with usage from each counting toward your total CU limit. ## Rate Limit Categories The CUs for each category are defined in the following table: | Weight | CU Value | | :----- | :------- | | Free | 1 | | Small | 10 | | Medium | 20 | | Large | 50 | | XL | 100 | | XXL | 200 | ## Rate Limits for Webhook Endpoints The CUs for each route are defined in the table below: | Endpoint | Method | Weight | CU Value | | :------------------------------------------ | :----- | :----- | :------- | | `/v1/webhooks` | POST | Medium | 20 | | `/v1/webhooks` | GET | Small | 10 | | `/v1/webhooks/{id}` | GET | Small | 10 | | `/v1/webhooks/{id}` | DELETE | Medium | 20 | | `/v1/webhooks/{id}` | PATCH | Medium | 20 | | `/v1/webhooks:generateOrRotateSharedSecret` | POST | Medium | 20 | | `/v1/webhooks:getSharedSecret` | GET | Small | 10 | | `/v1/webhooks/{id}/addresses` | PATCH | Medium | 20 | | `/v1/webhooks/{id}/addresses` | DELETE | Medium | 20 | | `/v1/webhooks/{id}/addresses` | GET | Medium | 20 | All rate limits, weights, and CU values are subject to change. # Retry mechanism (/docs/api-reference/webhook-api/retries) --- title: Retry mechanism description: Retry mechanism for the Webhook API icon: RotateCcw --- Our webhook system is designed to ensure you receive all your messages, even if temporary issues prevent immediate delivery. To achieve this, we’ve implemented a retry mechanism that resends messages if they don’t get through on the first attempt. Importantly, **retries are handled on a per-message basis**, meaning each webhook message follows its own independent retry schedule. This ensures that the failure of one message doesn’t affect the delivery attempts of others. This guide will walk you through how the retry mechanism works, the differences between free and paid tier users, and practical steps you can take to ensure your system handles webhooks effectively. ## How it works When we send a webhook message to your server, we expect a `200` status code within 10 seconds to confirm successful receipt. Your server should return this response immediately and process the message afterward. Processing the message before sending the response can lead to timeouts and trigger unnecessary retries. webhooks * **Attempt 1:** We send the message expecting a respose with `200` status code. If we do not receive a `200` status code within **10 seconds**, the attempt is considered failed. During this window, any non-`2xx` responses are ignored. * **Attempt 2:** Occurs **10 seconds** after the first attempt, with another 10-second timeout and the same rule for ignoring non-`2xx` responses. * **Retry Queue After Two Failed Attempts** If both initial attempts fail, the message enters a **retry queue** with progressively longer intervals between attempts. Each retry attempt still has a 10-second timeout, and non-`2xx` responses are ignored during this window. The retry schedule is as follows: | Attempt | Interval | | ------- | -------- | | 3 | 1 min | | 4 | 5 min | | 5 | 10 min | | 6 | 30 min | | 7 | 2 hours | | 8 | 6 hours | | 9 | 12 hours | | 10 | 24 hours | **Total Retry Duration:** Up to approximately 44.8 hours (2,688 minutes) if all retries are exhausted. **Interval Timing:** Each retry interval starts 10 seconds after the previous attempt is deemed failed. For example, if attempt 2 fails at t=20 seconds, attempt 3 will start at t=80 seconds (20s + 1 minute interval + 10s). Since retries are per message, multiple messages can be in different stages of their retry schedules simultaneously without interfering with each other. ## Differences Between Free and Paid Tier Users The behavior of the retry mechanism varies based on your subscription tier: **Free tier users** * **Initial attempts limit:** If six messages fail both the first and second attempts, your webhook will be automatically deactivated. * **Retry queue limit:** Only five messages can enter the retry queue over the lifetime of the subscription. If a sixth message requires retry queuing, or if any message fails all 10 retry attempts, the subscription will be deactivated. **Paid tier users** * For paid users, webhooks will be deactivated if a single message, retried at the 24-hour interval, fails to process successfully. ## What you can do **Ensure server availability:** * Keep your server running smoothly to receive webhook messages without interruption. * Implement logging for incoming webhook requests and your server's responses to help identify any issues quickly. **Design for idempotency** * Set up your webhook handler so it can safely process the same message multiple times without causing errors or unwanted effects. This way, if retries occur, they won't negatively impact your system. * The webhook retry mechanism is designed to maximize the reliability of message delivery while minimizing the impact of temporary issues. By understanding how retries work—especially the per-message nature of the system—and following best practices like ensuring server availability and designing for idempotency, you can ensure a seamless experience with webhooks. ## Key Takeaways * Each message has its own retry schedule, ensuring isolation and reliability. * Free tier users have limits on failed attempts and retry queue entries, while paid users do not. * Implement logging and idempotency to handle retries effectively and avoid disruptions. * By following this guide, you’ll be well-equipped to manage webhooks and ensure your system remains robust, even in the face of temporary challenges. # Webhook Signature (/docs/api-reference/webhook-api/webhooks-signature) --- title: Webhook Signature description: Webhook Signature for the Webhook API icon: Signature --- To make your webhooks extra secure, you can verify that they originated from our side by generating an HMAC SHA-256 hash code using your Authentication Token and request body. You can get the signing secret through the AvaCloud portal or Glacier API. ### Find your signing secret **Using the portal**\ Navigate to the webhook section and click on Generate Signing Secret. Create the secret and copy it to your code. **Using Data API**\ The following endpoint retrieves a shared secret: ```bash curl --location 'https://glacier-api.avax.network/v1/webhooks:getSharedSecret' \ --header 'x-glacier-api-key: ' \ ``` ### Validate the signature received Every outbound request will include an authentication signature in the header. This signature is generated by: 1. **Canonicalizing the JSON Payload**: This means arranging the JSON data in a standard format. 2. **Generating a Hash**: Using the HMAC SHA256 hash algorithm to create a hash of the canonicalized JSON payload. To verify that the signature is from us, follow these steps: 1. Generate the HMAC SHA256 hash of the received JSON payload. 2. Compare this generated hash with the signature in the request header. This process, known as verifying the digital signature, ensures the authenticity and integrity of the request. **Example Request Header** ``` Content-Type: application/json; x-signature: your-hashed-signature ``` ### Example Signature Validation Function This Node.js code sets up an HTTP server using the Express framework. It listens for POST requests sent to the `/callback` endpoint. Upon receiving a request, it validates the signature of the request against a predefined `signingSecret`. If the signature is valid, it logs match; otherwise, it logs no match. The server responds with a JSON object indicating that the request was received. ### Node (JavaScript) ```javascript const express = require('express'); const crypto = require('crypto'); const { canonicalize } = require('json-canonicalize'); const app = express(); app.use(express.json({limit: '50mb'})); const signingSecret = 'c13cc017c4ed63bcc842c8edfb49df37512280326a32826de3b885340b8a3d53'; function isValidSignature(signingSecret, signature, payload) { const canonicalizedPayload = canonicalize(payload); const hmac = crypto.createHmac('sha256', Buffer.from(signingSecret, 'hex')); const digest = hmac.update(canonicalizedPayload).digest('base64'); console.log("signature: ", signature); console.log("digest", digest); return signature === digest; } app.post('/callback', express.json({ type: 'application/json' }), (request, response) => { const { body, headers } = request; const signature = headers['x-signature']; // Handle the event switch (body.evenType) { case 'address\*activity': console.log("\*\** Address*activity \*\*\*"); console.log(body); if (isValidSignature(signingSecret, signature, body)) { console.log("match"); } else { console.log("no match"); } break; // ... handle other event types default: console.log(`Unhandled event type ${body}`); } // Return a response to acknowledge receipt of the event response.json({ received: true }); }); const PORT = 8000; app.listen(PORT, () => console.log(`Running on port ${PORT}`)); ``` ### Python (Flask) ```python from flask import Flask, request, jsonify import hmac import hashlib import base64 import json app = Flask(__name__) SIGNING_SECRET = 'c13cc017c4ed63bcc842c8edfb49df37512280326a32826de3b885340b8a3d53' def canonicalize(payload): """Function to canonicalize JSON payload""" # In Python, canonicalization can be achieved by using sort_keys=True in json.dumps return json.dumps(payload, separators=(',', ':'), sort_keys=True) def is_valid_signature(signing_secret, signature, payload): canonicalized_payload = canonicalize(payload) hmac_obj = hmac.new(bytes.fromhex(signing_secret), canonicalized_payload.encode('utf-8'), hashlib.sha256) digest = base64.b64encode(hmac_obj.digest()).decode('utf-8') print("signature:", signature) print("digest:", digest) return signature == digest @app.route('/callback', methods=['POST']) def callback_handler(): body = request.json signature = request.headers.get('x-signature') # Handle the event if body.get('eventType') == 'address_activity': print("*** Address_activity ***") print(body) if is_valid_signature(SIGNING_SECRET, signature, body): print("match") else: print("no match") else: print(f"Unhandled event type {body}") # Return a response to acknowledge receipt of the event return jsonify({"received": True}) if __name__ == '__main__': PORT = 8000 print(f"Running on port {PORT}") app.run(port=PORT) ``` ### Go (net/http) ```go package main import ( "crypto/hmac" "crypto/sha256" "encoding/base64" "encoding/hex" "encoding/json" "fmt" "net/http" "sort" "strings" ) const signingSecret = "c13cc017c4ed63bcc842c8edfb49df37512280326a32826de3b885340b8a3d53" // Canonicalize function sorts the JSON keys and produces a canonicalized string func Canonicalize(payload map[string]interface{}) (string, error) { var sb strings.Builder var keys []string for k := range payload { keys = append(keys, k) } sort.Strings(keys) sb.WriteString("{") for i, k := range keys { v, err := json.Marshal(payload[k]) if err != nil { return "", err } sb.WriteString(fmt.Sprintf("\"%s\":%s", k, v)) if i < len(keys)-1 { sb.WriteString(",") } } sb.WriteString("}") return sb.String(), nil } func isValidSignature(signingSecret, signature string, payload map[string]interface{}) bool { canonicalizedPayload, err := Canonicalize(payload) if err != nil { fmt.Println("Error canonicalizing payload:", err) return false } key, err := hex.DecodeString(signingSecret) if err != nil { fmt.Println("Error decoding signing secret:", err) return false } h := hmac.New(sha256.New, key) h.Write([]byte(canonicalizedPayload)) digest := h.Sum(nil) encodedDigest := base64.StdEncoding.EncodeToString(digest) fmt.Println("signature:", signature) fmt.Println("digest:", encodedDigest) return signature == encodedDigest } func callbackHandler(w http.ResponseWriter, r *http.Request) { var body map[string]interface{} err := json.NewDecoder(r.Body).Decode(&body) if err != nil { fmt.Println("Error decoding body:", err) http.Error(w, "Invalid request body", http.StatusBadRequest) return } signature := r.Header.Get("x-signature") eventType, ok := body["eventType"].(string) if !ok { fmt.Println("Error parsing eventType") http.Error(w, "Invalid event type", http.StatusBadRequest) return } switch eventType { case "address_activity": fmt.Println("*** Address_activity ***") fmt.Println(body) if isValidSignature(signingSecret, signature, body) { fmt.Println("match") } else { fmt.Println("no match") } default: fmt.Printf("Unhandled event type %s\n", eventType) } w.Header().Set("Content-Type", "application/json") json.NewEncoder(w).Encode(map[string]bool{"received": true}) } func main() { http.HandleFunc("/callback", callbackHandler) fmt.Println("Running on port 8000") http.ListenAndServe(":8000", nil) } ``` ### Rust (actix-web) ```rust use actix_web::{web, App, HttpServer, HttpResponse, Responder, post}; use serde::Deserialize; use hmac::{Hmac, Mac}; use sha2::Sha256; use base64::encode; use std::collections::BTreeMap; type HmacSha256 = Hmac; const SIGNING_SECRET: &str = "c13cc017c4ed63bcc842c8edfb49df37512280326a32826de3b885340b8a3d53"; #[derive(Deserialize)] struct EventPayload { eventType: String, // Add other fields as necessary } // Canonicalize the JSON payload by sorting keys fn canonicalize(payload: &BTreeMap) -> String { serde_json::to_string(payload).unwrap() } fn is_valid_signature(signing_secret: &str, signature: &str, payload: &BTreeMap) -> bool { let canonicalized_payload = canonicalize(payload); let mut mac = HmacSha256::new_from_slice(signing_secret.as_bytes()) .expect("HMAC can take key of any size"); mac.update(canonicalized_payload.as_bytes()); let result = mac.finalize(); let digest = encode(result.into_bytes()); println!("signature: {}", signature); println!("digest: {}", digest); digest == signature } #[post("/callback")] async fn callback(body: web::Json>, req: web::HttpRequest) -> impl Responder { let signature = req.headers().get("x-signature").unwrap().to_str().unwrap(); if let Some(event_type) = body.get("eventType").and_then(|v| v.as_str()) { match event_type { "address_activity" => { println!("*** Address_activity ***"); println!("{:?}", body); if is_valid_signature(SIGNING_SECRET, signature, &body) { println!("match"); } else { println!("no match"); } } _ => { println!("Unhandled event type: {}", event_type); } } } else { println!("Error parsing eventType"); return HttpResponse::BadRequest().finish(); } HttpResponse::Ok().json(serde_json::json!({ "received": true })) } #[actix_web::main] async fn main() -> std::io::Result<()> { HttpServer::new(|| { App::new() .service(callback) }) .bind("0.0.0.0:8000")? .run() .await } ``` ### TypeScript (ChainKit SDK) ```typescript import { isValidSignature } from '@avalanche-sdk/chainkit/utils'; import express from 'express'; const app = express(); app.use(express.json()); const signingSecret = 'your-signing-secret'; // Replace with your signing secret app.post('/webhook', (req, res) => { const signature = req.headers['x-signature']; const payload = req.body; if (isValidSignature(signingSecret, signature, payload)) { console.log('Valid signature'); // Process the request } else { console.log('Invalid signature'); } res.json({ received: true }); }); app.listen(8000, () => console.log('Server running on port 8000')); ``` # WebSockets vs Webhooks (/docs/api-reference/webhook-api/wss-vs-webhooks) --- title: WebSockets vs Webhooks description: WebSockets vs Webhooks for the Webhook API icon: GitCompare --- Reacting to real-time events from Avalanche smart contracts allows for immediate responses and automation, improving user experience and streamlining application functionality. It ensures that applications stay synchronized with the blockchain state. There are two primary methods for receiving these on-chain events: * **WebSockets**, using libraries like Ethers.js or Viem * **Webhooks**, which send structured event data directly to your app via HTTP POST. Both approaches enable real-time interactions, but they differ drastically in their reliability, ease of implementation, and long-term maintainability. In this post, we break down why Webhooks are the better, more resilient choice for most Avalanche developers. ## Architecture Overview The diagram below compares the two models side-by-side: wss_vs_webhooks **WebSockets** * The app connects to the Avalanche RPC API over WSS to receive raw log data. * It must decode logs, manage connection state, and store data locally. * On disconnection, it must re-sync via an external Data API or using standard `eth_*` RPC calls (e.g., `eth_getLogs`, `eth_getBlockByNumber`). Important: WSS is a transport protocol—not real-time by itself. Real-time capabilities come from the availability of `eth_subscribe`, which requires node support. **Webhooks** * The app exposes a simple HTTP endpoint. * Decoded event data is pushed directly via POST, including token metadata. * Built-in retries ensure reliable delivery, even during downtime. Important: Webhooks have a 48-hour retry window. If your app is down for longer, you still need a re-sync strategy using `eth_*` calls to recover older missed events. *** ## Using WebSockets: Real-time but high maintenance WebSockets allow you to subscribe to events using methods like eth\_subscribe. These subscriptions notify your app in real-time whenever new logs, blocks, or pending transactions meet your criteria. ```javascript import { createPublicClient, webSocket, formatUnits } from 'viem'; import { avalancheFuji } from 'viem/chains'; import { usdcAbi } from './usdc-abi.mjs'; // Ensure this includes the Transfer event // Your wallet address (case-insensitive comparison) const MY_WALLET = '0x8ae323046633A07FB162043f28Cea39FFc23B50A'.toLowerCase(); //Chrome async function monitorTransfers() { try { // USDC.e contract address on Avalanche Fuji const usdcAddress = '0x5425890298aed601595a70AB815c96711a31Bc65'; // Set up the WebSocket client for Avalanche Fuji const client = createPublicClient({ chain: avalancheFuji, transport: webSocket('wss://api.avax-test.network/ext/bc/C/ws'), }); // Watch for Transfer events on the USDC contract client.watchContractEvent({ address: usdcAddress, abi: usdcAbi, eventName: 'Transfer', onLogs: (logs) => { logs.forEach((log) => { const { from, to, value } = log.args; const fromLower = from.toLowerCase(); // Filter for transactions where 'from' matches your wallet if (fromLower === MY_WALLET) { console.log('*******'); console.log('Transfer from my wallet:'); console.log(`From: ${from}`); console.log(`To: ${to}`); console.log(`Value: ${formatUnits(value, 6)} USDC`); // USDC has 6 decimals console.log(`Transaction Hash: ${log.transactionHash}`); } }); }, onError: (error) => { console.error('Event watching error:', error.message); }, }); console.log('Monitoring USDC Transfer events on Fuji...'); } catch (error) { console.error('Error setting up transfer monitoring:', error.message); } } // Start monitoring monitorTransfers(); ``` The downside? If your connection drops, you lose everything in between. You’ll need to: * Set up a database to track the latest processed block and log index. * Correctly handling dropped connections and reconnection by hand can be challenging to get right. * Use `eth_getLogs` to re-fetch missed logs. * Decode and process raw logs yourself to rebuild app state. This requires extra infrastructure, custom recovery logic, and significant maintenance overhead. *** ## Webhooks: Resilient and developer-friendly Webhooks eliminate the complexity of managing live connections. Instead, you register an HTTP endpoint to receive blockchain event payloads when they occur. Webhook payload example: ```json { "eventType": "address_activity", "event": { "transaction": { "txHash": "0x1d8f...", "from": "0x3D3B...", "to": "0x9702...", "erc20Transfers": [ { "valueWithDecimals": "110.56", "erc20Token": { "symbol": "USDt", "decimals": 6 } } ] } } } ``` You get everything you need: * Decoded event data * Token metadata (name, symbol, decimals) * Full transaction context * No extra calls. No parsing. No manual re-sync logic. *** ## Key Advantages of Webhooks * **Reliable delivery with zero effort:** Built-in retries ensure no missed events during downtime * **Instant enrichment:** Payloads contain decoded logs, token metadata, and transaction context * **No extra infrastructure:** No WebSocket connections, no DB, no external APIs * **Faster development:** Go from idea to production with fewer moving parts * **Lower operational cost:** Less compute, fewer network calls, smaller surface area to manage If we compare using a table: | Feature | WebSockets (Ethers.js/Viem) | Webhooks | | | | :----------------------------- | :------------------------------------------------- | :--------------------------------------------------- | - | - | | **Interruption Handling** | Manual; Requires complex custom logic | Automatic; Built-in queues & retries | | | | **Data Recovery** | Requires DB + External API for re-sync | Handled by provider; No re-sync logic needed | | | | **Dev Complexity** | High; Error-prone custom resilience code | Low; Focus on processing incoming POST data | | | | **Infrastructure** | WSS connection + DB + Potential Data API cost | Application API endpoint | | | | **Data Integrity** | Risk of gaps if recovery logic fails | High; Ensures eventual delivery | | | | **Payload** | Often raw; Requires extra calls for context | Typically enriched and ready-to-use | | | | **Multiple addresses** | Manual filtering or separate listeners per address | Supports direct configuration for multiple addresses | | | | **Listen to wallet addresses** | Requires manual block/transaction filtering | Can monitor wallet addresses and smart contracts | | | ## Summary * WebSockets offer real-time access to Avalanche data, but come with complexity: raw logs, reconnect logic, re-sync handling, and decoding responsibilities. * Webhooks flip the model: the data comes to you, pre-processed and reliable. You focus on your product logic instead of infrastructure. * If you want to ship faster, operate more reliably, and reduce overhead, Webhooks are the better path forward for Avalanche event monitoring. # Deploy a Smart Contract (/docs/avalanche-l1s/add-utility/deploy-smart-contract) --- title: Deploy a Smart Contract description: Deploy a smart contract on your Avalanche L1. --- This tutorial assumes that: - [an Avalanche L1 and EVM blockchain](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet) has been created - Your Node is currently validating your target Avalanche L1 - Your wallet has a balance of the Avalanche L1 Native Token(Specified under _alloc_ in your [Genesis File](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#genesis)). Step 1: Setting up Core[​](#step-1-setting-up-core "Direct link to heading") ---------------------------------------------------------------------------- ### **EVM Avalanche L1 Settings**: [(EVM Core Tutorial)](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet#connect-with-core)[​](#evm-avalanche-l1-settings-evm-core-tutorial "Direct link to heading") - **`Network Name`**: Custom Subnet-EVM - **`New RPC URL`**: http://NodeIPAddress:9650/ext/bc/BlockchainID/rpc (Note: the port number should match your local setting which can be different from 9650.) - **`ChainID`**: Subnet-EVM ChainID - **`Symbol`**: Subnet-EVM Token Symbol - **`Explorer`**: N/A You should see a balance of your Avalanche L1's Native Token in Core. ![balance](/images/smart-contract1.png) Step 2: Connect Core and Deploy a Smart Contract[​](#step-2-connect-core-and-deploy-a-smart-contract "Direct link to heading") ------------------------------------------------------------------------------------------------------------------------------ ### Using Remix[​](#using-remix "Direct link to heading") Open [Remix](https://remix.ethereum.org/) -> Select Solidity. ![remix Avalanche L1 evm sc home](/images/smart-contract2.png) Create the smart contracts that we want to compile and deploy using Remix file explorer ### Using GitHub[​](#using-github "Direct link to heading") In Remix Home _Click_ the GitHub button. ![remix Avalanche L1 evm sc load panel](/images/smart-contract3.png) Paste the [link to the Smart Contract](https://github.com/ava-labs/avalanche-smart-contract-quickstart/blob/main/contracts/NFT.sol) into the popup and _Click_ import. ![remix Avalanche L1 evm sc import](/images/smart-contract4.png) For this example, we will deploy an ERC721 contract from the [Avalanche Smart Contract Quickstart Repository](https://github.com/ava-labs/avalanche-smart-contract-quickstart). ![remix Avalanche L1 evm sc file explorer](/images/smart-contract5.png) Navigate to Deploy Tab -> Open the "ENVIRONMENT" drop-down and select Injected Web3 (make sure Core is loaded). ![remix Avalanche L1 evm sc web3](/images/smart-contract6.png) Once we injected the web3-> Go back to the compiler, and compile the selected contract -> Navigate to Deploy Tab. ![remix Avalanche L1 evm sc compile](/images/smart-contract7.png) Now, the smart contract is compiled, Core is injected, and we are ready to deploy our ERC721. Click "Deploy." ![remix Avalanche L1 evm sc deploy](/images/smart-contract8.png) Confirm the transaction on the Core pop up. ![balance](/images/smart-contract9.png) Our contract is successfully deployed! ![remix Avalanche L1 evm sc deployed](/images/smart-contract10.png) Now, we can expand it by selecting it from the "Deployed Contracts" tab and test it out. ![remix Avalanche L1 evm sc end](/images/smart-contract11.png) The contract ABI and Bytecode are available on the compiler tab. ![remix Avalanche L1 evm sc ABI](/images/smart-contract12.png) If you had any difficulties following this tutorial or simply want to discuss Avalanche with us, you can join our community at [Discord](https://chat.avalabs.org/)! You can use Subnet-EVM just like you use C-Chain and EVM tools. Only differences are `chainID` and RPC URL. For example you can deploy your contracts with [Hardhat](https://hardhat.org/getting-started) by changing `url` and `chainId` in the `hardhat.config.ts`. # Add a Testnet Faucet (/docs/avalanche-l1s/add-utility/testnet-faucet) --- title: Add a Testnet Faucet description: This guide will help you add a testnet faucet to your Avalanche L1. --- There are thousands of networks and chains in the blockchain space, each with its capabilities and use-cases. Each network requires native coins to do any transaction on them, which can have a monetary value as well. These coins can be collected through centralized exchanges, token sales, etc in exchange for some monetary assets like USD. But we cannot risk our funds on the network or on any applications hosted on that network, without testing them first. So, these networks often have test networks or testnets, where the native coins do not have any monetary value, and thus can be obtained freely through faucets. These testnets are often the testbeds for any new native feature of the network itself, or any dapp or [Avalanche L1](/docs/avalanche-l1s) that is going live on the main network (Mainnet). For example, [Fuji](/docs/primary-network) network is the Testnet for Avalanche's Mainnet. Besides Fuji Testnet, the [Avalanche Faucet](https://core.app/tools/testnet-faucet/?avalanche-l1=c&token=c) can be used to get free test tokens on testnet Avalanche L1s like: - [WAGMI Testnet](https://core.app/tools/testnet-faucet/?avalanche-l1=wagmi) - [DeFI Kingdoms Testnet](https://core.app/tools/testnet-faucet/?avalanche-l1=dfk) - [Beam Testnet](https://core.app/tools/testnet-faucet/?avalanche-l1=beam&token=beam) and many more. You can use this [repository](https://github.com/ava-labs/avalanche-faucet) to deploy your faucet or just make a PR with the [configurations](https://github.com/ava-labs/avalanche-faucet/blob/main/config.json) of the Avalanche L1. This faucet comes with many features like multiple chain support, custom rate-limiting per Avalanche L1, CAPTCHA verification, and concurrent transaction handling. Summary[​](#summary "Direct link to heading") --------------------------------------------- A [Faucet](https://core.app/tools/testnet-faucet/) powered by Avalanche for Fuji Network and other Avalanche L1s. You can - - Request test coins for the supported Avalanche L1s - Integrate your EVM Avalanche L1 with the faucet by making a PR with the [chain configurations](https://github.com/ava-labs/avalanche-faucet/blob/main/config.json) - Fork the [repository](https://github.com/ava-labs/avalanche-faucet) to deploy your faucet for any EVM chain Adding a New Avalanche L1[​](#adding-a-new-avalanche-l1 "Direct link to heading") --------------------------------------------------------------------- You can also integrate a new Avalanche L1 on the live [faucet](https://core.app/tools/testnet-faucet/) with just a few lines of configuration parameters. All you have to do is make a PR on the [Avalanche Faucet](https://github.com/ava-labs/avalanche-faucet) git repository with the Avalanche L1's information. The following parameters are required. ```json { "ID": string, "NAME": string, "TOKEN": string, "RPC": string, "CHAINID": number, "EXPLORER": string, "IMAGE": string, "MAX_PRIORITY_FEE": string, "MAX_FEE": string, "DRIP_AMOUNT": number, "RATELIMIT": { "MAX_LIMIT": number, "WINDOW_SIZE": number } } ``` - `ID` - Each Avalanche L1 chain should have a unique and relatable ID. - `NAME` - Name of the Avalanche L1 chain that will appear on the site. - `RPC` - A valid RPC URL for accessing the chain. - `CHAINID` - ChainID of the chain - `EXPLORER` - Base URL of standard explorer's site. - `IMAGE` - URL of the icon of the chain that will be shown in the dropdown. - `MAX_PRIORITY_FEE` - Maximum tip per faucet drop in **wei** or **10\-18** unit (for EIP1559 supported chains) - `MAX_FEE` - Maximum fee that can be paid for a faucet drop in **wei** or **10\-18** unit - `DRIP_AMOUNT` - Amount of coins to send per request in **gwei** or **10\-9** unit - `RECALIBRATE` _(optional)_ - Number of seconds after which the nonce and balance will recalibrate - `RATELIMIT` - Number of times (MAX\_LIMIT) to allow per user within the WINDOW\_SIZE (in minutes) Add the configuration in the array of `evmchains` inside the [config.json](https://github.com/ava-labs/avalanche-faucet/blob/main/config.json) file and make a PR. Building and Deploying a Faucet[​](#building-and-deploying-a-faucet "Direct link to heading") --------------------------------------------------------------------------------------------- You can also deploy and build your faucet by using the [Avalanche Faucet](https://github.com/ava-labs/avalanche-faucet) repository. ### Requirements[​](#requirements "Direct link to heading") - [Node](https://nodejs.org/en) >= 17.0 and [npm](https://www.npmjs.com/) >= 8.0 - [Google's reCAPTCHA](https://www.google.com/recaptcha/intro/v3.html) v3 keys - [Docker](https://www.docker.com/get-started/) ### Installation[​](#installation "Direct link to heading") Clone this repository at your preferred location. ```bash git clone https://github.com/ava-labs/avalanche-faucet ``` The repository cloning method used is HTTPS, but SSH can be used too: `git clone git@github.com:ava-labs/avalanche-faucet.git` You can find more about SSH and how to use it [here](https://docs.github.com/en/authentication/connecting-to-github-with-ssh/about-ssh). ### Client-Side Configurations[​](#client-side-configurations "Direct link to heading") We need to configure our application with the server API endpoints and CAPTCHA site keys. All the client-side configurations are there in the `client/src/config.json` file. Since there are no secrets on the client-side, we do not need any environment variables. Update the config files according to your need. ```json { "banner": "/banner.png", "apiBaseEndpointProduction": "/api/", "apiBaseEndpointDevelopment": "http://localhost:8000/api/", "apiTimeout": 10000, "CAPTCHA": { "siteKey": "6LcNScYfAAAAAJH8fauA-okTZrmAxYqfF9gOmujf", "action": "faucetdrip" } } ``` Put the Google's reCAPTCHA site-key without which the faucet client can't send the necessary CAPTCHA response to the server. This key is not a secret and could be public. In the above file, there are 2 base endpoints for the faucet server `apiBaseEndpointProduction` and `apiBaseEndpointDevelopment`. In production mode, the client-side will be served as static content over the server's endpoint, and hence we do not have to provide the server's IP address or domain. The URL path should be valid, where the server's APIs are hosted. If the endpoints for API have a leading `/v1/api` and the server is running on localhost at port 3000, then you should use `http://localhost:3000/v1/api` or `/v1/api/` depending on whether it is production or development. ### Server-Side Configurations[​](#server-side-configurations "Direct link to heading") On the server-side, we need to configure 2 files - `.env` for secret keys and `config.json` for chain and API rate limiting configurations. #### Setup Environment Variables[​](#setup-environment-variables "Direct link to heading") Setup the environment variable with your private key and reCAPTCHA secret. Make a `.env` file in your preferred location with the following credentials, as this file will not be committed to the repository. The faucet server can handle multiple EVM chains, and therefore requires private keys for addresses with funds on each of the chains. If you have funds on the same address on every chain, then you can specify them with the single variable`PK`. But if you have funds on different addresses on different chains, then you can provide each of the private keys against the ID of the chain, as shown below. ```bash C="C chain private key" WAGMI="Wagmi chain private key" PK="Sender Private Key with Funds in it" CAPTCHA_SECRET="Google reCAPTCHA Secret" ``` `PK` will act as a fallback private key, in case, the key for any chain is not provided. #### Setup EVM Chain Configurations[​](#setup-evm-chain-configurations "Direct link to heading") You can create a faucet server for any EVM chain by making changes in the `config.json` file. Add your chain configuration as shown below in the `evmchains` object. Configuration for Fuji's C-Chain and WAGMI chain is shown below for example. ```json "evmchains": [ { "ID": "C", "NAME": "Fuji (C-Chain)", "TOKEN": "AVAX", "RPC": "https://api.avax-test.network/ext/C/rpc", "CHAINID": 43113, "EXPLORER": "https://testnet.snowtrace.io", "IMAGE": "/avaxred.png", "MAX_PRIORITY_FEE": "2000000000", "MAX_FEE": "100000000000", "DRIP_AMOUNT": 2000000000, "RECALIBRATE": 30, "RATELIMIT": { "MAX_LIMIT": 1, "WINDOW_SIZE": 1440 } }, { "ID": "WAGMI", "NAME": "WAGMI Testnet", "TOKEN": "WGM", "RPC": "https://subnets.avax.network/wagmi/wagmi-chain-testnet/rpc", "CHAINID": 11111, "EXPLORER": "https://subnets.avax.network/wagmi/wagmi-chain-testnet/explorer", "IMAGE": "/wagmi.png", "MAX_PRIORITY_FEE": "2000000000", "MAX_FEE": "100000000000", "DRIP_AMOUNT": 2000000000, "RATELIMIT": { "MAX_LIMIT": 1, "WINDOW_SIZE": 1440 } } ] ``` In the above configuration drip amount is in `nAVAX` or `gwei`, whereas fees are in `wei`. For example, with the above configurations, the faucet will send `1 AVAX` with maximum fees per gas being `100 nAVAX` and priority fee as `2 nAVAX`. The rate limiter for C-Chain will only accept 1 request in 60 minutes for a particular API and 2 requests in 60 minutes for the WAGMI chain. Though it will skip any failed requests so that users can request tokens again, even if there is some internal error in the application. On the other hand, the global rate limiter will allow 15 requests per minute on every API. This time failed requests will also get counted so that no one can abuse the APIs. ### API Endpoints[​](#api-endpoints "Direct link to heading") This server will expose the following APIs #### Health API[​](#health-api "Direct link to heading") The `/health` API will always return a response with a `200` status code. This endpoint can be used to know the health of the server. ```bash curl http://localhost:8000/health ``` Response #### Get Faucet Address[​](#get-faucet-address "Direct link to heading") This API will be used for fetching the faucet address. ```bash curl http://localhost:8000/api/faucetAddress?chain=C ``` It will give the following response: ```bash 0x3EA53fA26b41885cB9149B62f0b7c0BAf76C78D4 ``` #### Get Faucet Balance[​](#get-faucet-balance "Direct link to heading") This API will be used for fetching the faucet address. ```bash curl http://localhost:8000/api/getBalance?chain=C ``` #### Send Token[​](#send-token "Direct link to heading") This API endpoint will handle token requests from users. It will return the transaction hash as a receipt of the faucet drip. ```bash curl -d '{ "address": "0x3EA53fA26b41885cB9149B62f0b7c0BAf76C78D4" "chain": "C" }' -H 'Content-Type: application/json' http://localhost:8000/api/sendToken ``` Send token API requires a CAPTCHA response token that is generated using the CAPTCHA site key on the client-side. Since we can't generate and pass this token while making a curl request, we have to disable the CAPTCHA verification for testing purposes. You can find the steps to disable it in the next sections. The response is shown below ```json { "message": "Transaction successful on Avalanche C Chain!", "txHash": "0x3d1f1c3facf59c5cd7d6937b3b727d047a1e664f52834daf20b0555e89fc8317" } ``` ### Rate Limiters[​](#rate-limiters-important "Direct link to heading") The rate limiters are applied on the global (all endpoints) as well as on the `/api/sendToken` API. These can be configured from the `config.json` file. Rate limiting parameters for chains are passed in the chain configuration as shown above. ```json "GLOBAL_RL": { "ID": "GLOBAL", "RATELIMIT": { "REVERSE_PROXIES": 4, "MAX_LIMIT": 40, "WINDOW_SIZE": 1, "PATH": "/", "SKIP_FAILED_REQUESTS": false } } ``` There could be multiple proxies between the server and the client. The server will see the IP address of the adjacent proxy connected with the server, and this may not be the client's actual IP. The IPs of all the proxies that the request has hopped through are stuffed inside the header **x-forwarded-for** array. But the proxies in between can easily manipulate these headers to bypass rate limiters. So, we cannot trust all the proxies and hence all the IPs inside the header. The proxies that are set up by the owner of the server (reverse-proxies) are the trusted proxies on which we can rely and know that they have stuffed the actual IP of the callers in between. Any proxy that is not set up by the server, should be considered an untrusted proxy. So, we can jump to the IP address added by the last proxy that we trust. The number of jumps that we want can be configured in the `config.json` file inside the `GLOBAL_RL` object. ![faucet 5](/images/faucet1.png) #### Clients Behind Same Proxy[​](#clients-behind-same-proxy "Direct link to heading") Consider the below diagram. The server is set up with 2 reverse proxies. If the client is behind proxies, then we cannot get the client's actual IP, and instead will consider the proxy's IP as the client's IP. And if some other client is behind the same proxy, then those clients will be considered as a single entity and might get rate-limited faster. ![faucet 6](/images/faucet2.png) Therefore it is advised to the users, to avoid using any proxy for accessing applications that have critical rate limits, like this faucet. #### Wrong Number of Reverse Proxies[​](#wrong-number-of-reverse-proxies "Direct link to heading") So, if you want to deploy this faucet, and have some reverse proxies in between, then you should configure this inside the `GLOBAL_RL` key of the `config.json` file. If this is not configured properly, then the users might get rate-limited very frequently, since the server-side proxy's IP addresses are being viewed as the client's IP. You can verify this in the code [here](https://github.com/ava-labs/avalanche-faucet/blob/23eb300635b64130bc9ce10d9e894f0a0b3d81ea/middlewares/rateLimiter.ts#L25). ```json "GLOBAL_RL": { "ID": "GLOBAL", "RATELIMIT": { "REVERSE_PROXIES": 4, ... } } ``` ![faucet 7](/images/faucet3.png) It is also quite common to have Cloudflare as the last reverse proxy or the exposed server. Cloudflare provides a header **cf-connecting-ip** which is the IP of the client that requested the faucet and hence Cloudflare. We are using this as default. ### CAPTCHA Verification[​](#captcha-verification "Direct link to heading") CAPTCHA is required to prove the user is a human and not a bot. For this purpose, we will use [Google's reCAPTCHA](https://www.google.com/recaptcha/intro/v3.html). The server-side will require `CAPTCHA_SECRET` that should not be exposed. You can set the threshold score to pass the CAPTCHA test by the users [here](https://github.com/ava-labs/avalanche-faucet/blob/23eb300635b64130bc9ce10d9e894f0a0b3d81ea/middlewares/verifyCaptcha.ts#L20). You can disable these CAPTCHA verifications and rate limiters for testing the purpose, by tweaking in the `server.ts` file. ### Disabling Rate Limiters[​](#disabling-rate-limiters "Direct link to heading") Comment or remove these two lines from the `server.ts` file ```ts title="server.ts" new RateLimiter(app, [GLOBAL_RL]); new RateLimiter(app, evmchains); ``` ### Disabling CAPTCHA Verification[​](#disabling-captcha-verification "Direct link to heading") Remove the `captcha.middleware` from `sendToken` API. ### Starting the Faucet[​](#starting-the-faucet "Direct link to heading") Follow the below commands to start your local faucet. #### Installing Dependencies[​](#installing-dependencies "Direct link to heading") This will concurrently install dependencies for both client and server. If ports have a default configuration, then the client will start at port 3000 and the server will start at port 8000 while in development mode. #### Starting in Development Mode[​](#starting-in-development-mode "Direct link to heading") This will concurrently start the server and client in development mode. #### Building for Production[​](#building-for-production "Direct link to heading") The following command will build server and client at `build/` and `build/client` directories. #### Starting in Production Mode[​](#starting-in-production-mode "Direct link to heading") This command should only be run after successfully building the client and server-side code. ### Setting up with Docker[​](#setting-up-with-docker "Direct link to heading") Follow the steps to run this application in a Docker container. #### Build Docker Image[​](#build-docker-image "Direct link to heading") Docker images can be served as the built versions of our application, that can be used to deploy on Docker container. ```bash docker build . -t faucet-image ``` #### Starting Application inside Docker Container[​](#starting-application-inside-docker-container "Direct link to heading") Now we can create any number of containers using the above `faucet` image. We also have to supply the `.env` file or the environment variables with the secret keys to create the container. Once the container is created, these variables and configurations will be persisted and can be easily started or stopped with a single command. ```bash docker run -p 3000:8000 --name faucet-container --env-file ../.env faucet-image ``` The server will run on port 8000, and our Docker will also expose this port for the outer world to interact. We have exposed this port in the `Dockerfile`. But we cannot directly interact with the container port, so we had to bind this container port to our host port. For the host port, we have chosen 3000. This flag `-p 3000:8000` achieves the same. This will start our faucet application in a Docker container at port 3000 (port 8000 on the container). You can interact with the application by visiting \[http://localhost:3000\] in your browser. #### Stopping the Container[​](#stopping-the-container "Direct link to heading") You can easily stop the container using the following command ```bash docker stop faucet-container ``` #### Restarting the Container[​](#restarting-the-container "Direct link to heading") To restart the container, use the following command ```bash docker start faucet-container ``` Using the Faucet[​](#using-the-faucet "Direct link to heading") --------------------------------------------------------------- Using the faucet is quite straightforward, but for the sake of completeness, let's go through the steps, to collect your first test coins. ### Visit Avalanche Faucet Site[​](#visit-avalanche-faucet-site "Direct link to heading") Go to [https://core.app/tools/testnet-faucet/](https://core.app/tools/testnet-faucet/). You will see various network parameters like network name, faucet balance, drop amount, drop limit, faucet address, etc. ![faucet 1](/images/faucet4.png) ### Select Network[​](#select-network "Direct link to heading") You can use the dropdown to select the network of your choice and get some free coins (each network may have a different drop amount). ![faucet 2](/images/faucet5.png) ### Put Address and Request Coins[​](#put-address-and-request-coins "Direct link to heading") If you already have an AVAX balance greater than zero on Mainnet, paste your C-Chain address there, and request test tokens. Otherwise, please request a faucet coupon on [Guild](https://guild.xyz/avalanche). Admins and mods on the official [Discord](https://discord.com/invite/RwXY7P6) can provide testnet AVAX if developers are unable to obtain it from the other two options. Within a second, you will get a **transaction hash** for the processed transaction. The hash would be a hyperlink to Avalanche L1's explorer. You can see the transaction status, by clicking on that hyperlink. ![faucet 3](/images/faucet6.png) ### More Interactions[​](#more-interactions "Direct link to heading") This is not just it. Using the buttons shown below, you can go to the Avalanche L1 explorer or add the Avalanche L1 to your browser wallet extensions like Core or MetaMask with a single click. ![faucet 4](/images/faucet7.png) ### Probable Errors and Troubleshooting[​](#probable-errors-and-troubleshooting "Direct link to heading") Errors are not expected, but if you are facing some of the errors shown, then you could try troubleshooting as shown below. If none of the troubleshooting works, reach us through [Discord](https://discord.com/channels/578992315641626624/). 1. **Too many requests. Please try again after X minutes**: This is a rate-limiting message. Every Avalanche L1 can set its drop limits. The above message suggests that you have reached your drop limit, that is the number of times you could request coins within the window of X minutes. You should try requesting after X minutes. If you are facing this problem, even when you are requesting for the first time in the window, you may be behind some proxy, Wi-Fi, or VPN service that is also being used by some other user. 2. **CAPTCHA verification failed! Try refreshing**: We are using v3 of [Google's reCAPTCHA](https://developers.google.com/recaptcha/docs/v3). This version uses scores between 0 and 1 to rate the interaction of humans with the site, with 0 being the most suspicious one. You do not have to solve any puzzle or mark the **I am not a Robot** checkbox. The score will be automatically calculated. We want our users to score at least 0.3 to use the faucet. This is configurable, and we will update the threshold after having broader data. But if you are facing this issue, then you can try refreshing your page, disabling ad-blockers, or switching off any VPN. You can follow this [guide](https://2captcha.com/blog/google-doesnt-accept-recaptcha-answers) to get rid of this issue. 3. **Internal RPC error! Please try after sometime**: This is an internal error in the Avalanche L1's node, on which we are making an RPC for sending transactions. A regular check will update the RPC's health status every 30 seconds (default) or whatever is set in the configuration. This may happen only in rare scenarios and you cannot do much about it, rather than waiting. 4. **Timeout of 10000ms exceeded**: There could be many reasons for this message. It could be an internal server error, or the request didn't receive by the server, slow internet, etc. You could try again after some time, and if the problem persists, then you should raise this issue on our [Discord](https://discord.com/channels/578992315641626624/) server. 5. **Couldn't see any transaction status on explorer**: The transaction hash that you get for each drop is pre-computed using the expected nonce, amount, and receiver's address. Though transactions on Avalanche are near-instant, the explorer may take time to index those transactions. You should wait for a few more seconds, before raising any issue or reaching out to us. # Background and Requirements (/docs/avalanche-l1s/custom-precompiles/background-requirements) --- title: Background and Requirements description: Learn about the background and requirements for customizing Ethereum Virtual Machine. --- This is a brief overview of what this tutorial will cover. - Write a Solidity interface - Generate the precompile template - Implement the precompile functions in Golang - Write and run tests Stateful precompiles are [alpha software](https://en.wikipedia.org/wiki/Software_release_life_cycle#Alpha). Build at your own risk. In this tutorial, we used a branch based on Subnet-EVM version `v0.5.2`. You can find the branch [here](https://github.com/ava-labs/subnet-evm/tree/helloworld-official-tutorial-v2). The code in this branch is the same as Subnet-EVM except for the `precompile/contracts/helloworld` directory. The directory contains the code for the `HelloWorld` precompile. We will be using this precompile as an example to learn how to write a stateful precompile. The code in this branch can become outdated. You should always use the latest version of Subnet-EVM when you develop your own precompile. ## Precompile-EVM Subnet-EVM precompiles can be registered from an external repo. This allows developer to build their precompiles without maintaining a fork of Subnet-EVM. The precompiles are then registered in the Subnet-EVM at build time. The difference between using Subnet-EVM and Precompile-EVM is that with Subnet-EVM you can change EVM internals to interact with your precompiles. Such as changing fee structure, adding new opcodes, changing how to build a block, etc. With Precompile-EVM you can only add new stateful precompiles that can interact with the StateDB. Precompiles built with Precompile-EVM are still very powerful because it can directly access to the state and modify it. There is a template repo for how to build a precompile with this way called [Precompile-EVM](https://github.com/ava-labs/precompile-evm). Both Subnet-EVM and Precompile-EVM share similar directory structures and common codes. You can reference the Precompile-EVM PR that adds Hello World precompile [here](https://github.com/ava-labs/precompile-evm/pull/12). ## Requirements This tutorial assumes familiarity with Golang and JavaScript. Additionally, users should be deeply familiar with the EVM in order to understand its invariants since adding a Stateful Precompile modifies the EVM itself. Here are some recommended resources to learn the ins and outs of the EVM: - [The Ethereum Virtual Machine](https://github.com/ethereumbook/ethereumbook/blob/develop/13evm.asciidoc) - [Precompiles in Solidity](https://medium.com/@rbkhmrcr/precompiles-solidity-e5d29bd428c4) - [Deconstructing a Smart Contract](https://blog.openzeppelin.com/deconstructing-a-solidity-contract-part-i-introduction-832efd2d7737/) - [Layout of State Variables in Storage](https://docs.soliditylang.org/en/v0.8.10/internals/layout_in_storage.html) - [Layout in Memory](https://docs.soliditylang.org/en/v0.8.10/internals/layout_in_memory.html) - [Layout of Call Data](https://docs.soliditylang.org/en/v0.8.10/internals/layout_in_calldata.html) - [Contract ABI Specification](https://docs.soliditylang.org/en/v0.8.10/abi-spec.html) - [Customizing the EVM with Stateful Precompiles](https://medium.com/avalancheavax/customizing-the-evm-with-stateful-precompiles-f44a34f39efd) Please install the following before getting started. First, install the latest version of Go. Follow the instructions [here](https://go.dev/doc/install). You can verify by running `go version`. Set the `$GOPATH` environment variable properly for Go to look for Go Workspaces. Please read [this](https://go.dev/doc/gopath_code) for details. You can verify by running `echo $GOPATH`. See [here](https://github.com/golang/go/wiki/SettingGOPATH) for instructions on setting the GOPATH based on system configurations. As a few things will be installed into `$GOPATH/bin`, please make sure that `$GOPATH/bin` is in your `$PATH`, otherwise, you may get an error running the commands below. To do that, run the command: `export PATH=$PATH:$GOROOT/bin:$GOPATH/bin` Download the following prerequisites into your `$GOPATH`: - Git Clone the repository (Subnet-EVM or Precompile-EVM) - Git Clone [AvalancheGo](https://github.com/ava-labs/avalanchego) repository - Install [Avalanche Network Runner](/docs/tooling/avalanche-cli) - Install [solc](https://github.com/ethereum/solc-js#usage-on-the-command-line) - Install [Node.js and NPM](https://nodejs.org/en/download) For easy copy paste, use the below commands: ```bash cd $GOPATH mkdir -p src/github.com/ava-labs cd src/github.com/ava-labs ``` Clone the repository: ```bash git clone git@github.com:ava-labs/subnet-evm.git ``` Then run the following commands: ```bash git clone git@github.com:ava-labs/avalanchego.git curl -sSfL https://raw.githubusercontent.com/ava-labs/avalanche-network-runner/main/scripts/install.sh | sh -s npm install -g solc ``` ```bash git clone git@github.com:ava-labs/precompile-evm.git ``` Alternatively you can use it as a template repo from github. Then run the following commands: ```bash git clone git@github.com:ava-labs/avalanchego.git curl -sSfL https://raw.githubusercontent.com/ava-labs/avalanche-network-runner/main/scripts/install.sh | sh -s npm install -g solc ``` ## Complete Code You can inspect example pull request for the complete code. [Subnet-EVM Hello World Pull Request](https://github.com/ava-labs/subnet-evm/pull/565/) [Precompile-EVM Hello World Pull Request](https://github.com/ava-labs/precompile-evm/pull/12/) For a full-fledged example, you can also check out the [Reward Manager Precompile](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/rewardmanager/). # Generating Your Precompile (/docs/avalanche-l1s/custom-precompiles/create-precompile) --- title: Generating Your Precompile description: In this section, we will go over the process for automatically generating the template code which you can configure accordingly for your stateful precompile. --- First, we must create the Solidity interface that we want our precompile to implement. This will be the HelloWorld Interface. It will have two simple functions, `sayHello()`, `setGreeting()` and an event `GreetingChanged`. These two functions will demonstrate the getting and setting respectively of a value stored in the precompile's state space. The `sayHello()` function is a `view` function, meaning it does not modify the state of the precompile and returns a string result. The `setGreeting()` function is a state changer function, meaning it modifies the state of the precompile. The `HelloWorld` interface inherits `IAllowList` interface to use the allow list functionality. For this tutorial, we will be working in a new branch in Subnet-EVM/Precompile-EVM repo. ```bash cd $GOPATH/src/github.com/ava-labs/subnet-evm ``` We will start off in this directory `./contracts/`: ```bash cd contracts/ ``` Create a new file called `IHelloWorld.sol` and copy and paste the below code: ```solidity title="contracts/IHelloWorld.sol" // (c) 2022-2023, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. // SPDX-License-Identifier: MIT pragma solidity >=0.8.0; import "./IAllowList.sol"; interface IHelloWorld is IAllowList { event GreetingChanged( address indexed sender, string oldGreeting, string newGreeting ); // sayHello returns the stored greeting string function sayHello() external view returns (string calldata result); // setGreeting stores the greeting string function setGreeting(string calldata response) external; } ``` Now we have an interface that our precompile can implement! Let's create an [ABI](https://docs.soliditylang.org/en/v0.8.13/abi-spec.html#contract-abi-specification) of our Solidity interface. In the same directory, let's run: ```bash solc --abi ./contracts/interfaces/IHelloWorld.sol -o ./abis ``` This generates the ABI code under `./abis/contracts_interfaces_IHelloWorld_sol_IHelloWorld.abi`. ``` [ { "anonymous": false, "inputs": [ { "indexed": true, "internalType": "address", "name": "sender", "type": "address" }, { "indexed": false, "internalType": "string", "name": "oldGreeting", "type": "string" }, { "indexed": false, "internalType": "string", "name": "newGreeting", "type": "string" } ], "name": "GreetingChanged", "type": "event" }, { "anonymous": false, "inputs": [ { "indexed": true, "internalType": "uint256", "name": "role", "type": "uint256" }, { "indexed": true, "internalType": "address", "name": "account", "type": "address" }, { "indexed": true, "internalType": "address", "name": "sender", "type": "address" }, { "indexed": false, "internalType": "uint256", "name": "oldRole", "type": "uint256" } ], "name": "RoleSet", "type": "event" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "readAllowList", "outputs": [ { "internalType": "uint256", "name": "role", "type": "uint256" } ], "stateMutability": "view", "type": "function" }, { "inputs": [], "name": "sayHello", "outputs": [ { "internalType": "string", "name": "result", "type": "string" } ], "stateMutability": "view", "type": "function" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "setAdmin", "outputs": [], "stateMutability": "nonpayable", "type": "function" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "setEnabled", "outputs": [], "stateMutability": "nonpayable", "type": "function" }, { "inputs": [ { "internalType": "string", "name": "response", "type": "string" } ], "name": "setGreeting", "outputs": [], "stateMutability": "nonpayable", "type": "function" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "setManager", "outputs": [], "stateMutability": "nonpayable", "type": "function" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "setNone", "outputs": [], "stateMutability": "nonpayable", "type": "function" } ] ``` As you can see the ABI also contains the `IAllowList` interface functions. This is because the `IHelloWorld` interface inherits from the `IAllowList` interface. Note: The ABI must have named outputs in order to generate the precompile template. Now that we have an ABI for the precompile gen tool to interact with, we can run the following command to generate our HelloWorld precompile files! Let's go back to the root of the repository and run the PrecompileGen script helper: ```bash cd .. ``` Both of these Subnet-EVM and Precompile-EVM have the same `generate_precompile.sh` script. The one in Precompile-EVM installs the script from Subnet-EVM and runs it. ```bash ./scripts/generate_precompile.sh --help # output Using branch: precompile-tutorial NAME: precompilegen - subnet-evm precompile generator tool USAGE: main [global options] command [command options] [arguments...] VERSION: 1.10.26-stable COMMANDS: help, h Shows a list of commands or help for one command GLOBAL OPTIONS: --abi value Path to the contract ABI json to generate, - for STDIN --out value Output folder for the generated precompile files, - for STDOUT (default = ./precompile/contracts/{pkg}). Test files won't be generated if STDOUT is used --pkg value Go package name to generate the precompile into (default = {type}) --type value Struct name for the precompile (default = {abi file name}) MISC --help, -h (default: false) show help --version, -v (default: false) print the version COPYRIGHT: Copyright 2013-2022 The go-ethereum Authors ``` Now let's generate the precompile template files! ```bash cd $GOPATH/src/github.com/ava-labs/precompile-evm ``` We will start off in this directory `./contracts/`: ```bash cd contracts/ ``` For Precompile-EVM interfaces and other contracts in Subnet-EVM can be accessible through `@avalabs/subnet-evm-contracts` package. This is already added to the `package.json` file. You can install it by running `npm install`. In order to import `IAllowList` interface, you can use the following import statement: ```solidity import "@avalabs/subnet-evm-contracts/contracts/interfaces/IAllowList.sol"; ``` The full file looks like this: ```solidity // SPDX-License-Identifier: MIT pragma solidity >=0.8.0; import "@avalabs/subnet-evm-contracts/contracts/interfaces/IAllowList.sol"; interface IHelloWorld is IAllowList { event GreetingChanged( address indexed sender, string oldGreeting, string newGreeting ); // sayHello returns the stored greeting string function sayHello() external view returns (string calldata result); // setGreeting stores the greeting string function setGreeting(string calldata response) external; } ``` Now we have an interface that our precompile can implement! Let's create an ABI of our Solidity interface. In Precompile-EVM we import contracts from `@avalabs/subnet-evm-contracts` package. In order to generate the ABI in Precompile-EVM we need to include the `node_modules` folder to find imported contracts with following flags: - `--abi`: ABI specification of the contracts. - `--base-path path`: Use the given path as the root of the source tree instead of the root of the filesystem. - `--include-path path`: Make an additional source directory available to the default import callback. Use this option if you want to import contracts whose location is not fixed in relation to your main source tree; for example third-party libraries installed using a package manager. Can be used multiple times. Can only be used if base path has a non-empty value. - `--output-dir path`: If given, creates one file per output component and contract/file at the specified directory. - `--overwrite`: Overwrite existing files (used together with` --output-dir`). ```bash solc --abi ./contracts/interfaces/IHelloWorld.sol -o ./abis --base-path . --include-path ./node_modules ``` This generates the ABI code under `./abis/contracts_interfaces_IHelloWorld_sol_IHelloWorld.abi`. ``` [ { "anonymous": false, "inputs": [ { "indexed": true, "internalType": "address", "name": "sender", "type": "address" }, { "indexed": false, "internalType": "string", "name": "oldGreeting", "type": "string" }, { "indexed": false, "internalType": "string", "name": "newGreeting", "type": "string" } ], "name": "GreetingChanged", "type": "event" }, { "anonymous": false, "inputs": [ { "indexed": true, "internalType": "uint256", "name": "role", "type": "uint256" }, { "indexed": true, "internalType": "address", "name": "account", "type": "address" }, { "indexed": true, "internalType": "address", "name": "sender", "type": "address" }, { "indexed": false, "internalType": "uint256", "name": "oldRole", "type": "uint256" } ], "name": "RoleSet", "type": "event" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "readAllowList", "outputs": [ { "internalType": "uint256", "name": "role", "type": "uint256" } ], "stateMutability": "view", "type": "function" }, { "inputs": [], "name": "sayHello", "outputs": [ { "internalType": "string", "name": "result", "type": "string" } ], "stateMutability": "view", "type": "function" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "setAdmin", "outputs": [], "stateMutability": "nonpayable", "type": "function" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "setEnabled", "outputs": [], "stateMutability": "nonpayable", "type": "function" }, { "inputs": [ { "internalType": "string", "name": "response", "type": "string" } ], "name": "setGreeting", "outputs": [], "stateMutability": "nonpayable", "type": "function" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "setManager", "outputs": [], "stateMutability": "nonpayable", "type": "function" }, { "inputs": [ { "internalType": "address", "name": "addr", "type": "address" } ], "name": "setNone", "outputs": [], "stateMutability": "nonpayable", "type": "function" } ] ``` As you can see the ABI also contains the `IAllowList` interface functions. This is because the `IHelloWorld` interface inherits from the `IAllowList` interface. Note: The ABI must have named outputs in order to generate the precompile template. Now that we have an ABI for the precompile gen tool to interact with, we can run the following command to generate our HelloWorld precompile files! Let's go back to the root of the repository and run the PrecompileGen script helper: ```bash cd .. ``` Both of these Subnet-EVM and Precompile-EVM have the same generate_precompile.sh script. The one in Precompile-EVM installs the script from Subnet-EVM and runs it. ```bash ./scripts/generate_precompile.sh --help # output Using branch: precompile-tutorial NAME: precompilegen - subnet-evm precompile generator tool USAGE: main [global options] command [command options] [arguments...] VERSION: 1.10.26-stable COMMANDS: help, h Shows a list of commands or help for one command GLOBAL OPTIONS: --abi value Path to the contract ABI json to generate, - for STDIN --out value Output folder for the generated precompile files, - for STDOUT (default = ./precompile/contracts/{pkg}). Test files won't be generated if STDOUT is used --pkg value Go package name to generate the precompile into (default = {type}) --type value Struct name for the precompile (default = {abi file name}) MISC --help, -h (default: false) show help --version, -v (default: false) print the version COPYRIGHT: Copyright 2013-2022 The go-ethereum Authors ``` Now let's generate the precompile template files! In Subnet-EVM precompile implementations reside under the `./precompile/contracts` directory. Let's generate our precompile template in the `./precompile/contracts/helloworld` directory, where `helloworld` is the name of the Go package we want to generate the precompile into. ```bash ./scripts/generate_precompile.sh --abi ./contracts/abis/contracts_interfaces_IHelloWorld_sol_IHelloWorld.abi --type HelloWorld --pkg helloworld ``` This generates a precompile template files `contract.go`, `contract.abi`, `config.go`, `module.go`, `event.go` and `README.md` files. `README.md` explains general guidelines for precompile development. You should carefully read this file before modifying the precompile template. ``` There are some must-be-done changes waiting in the generated file. Each area requiring you to add your code is marked with CUSTOM CODE to make them easy to find and modify. Additionally there are other files you need to edit to activate your precompile. These areas are highlighted with comments "ADD YOUR PRECOMPILE HERE". For testing take a look at other precompile tests in contract_test.go and config_test.go in other precompile folders. General guidelines for precompile development: 1- Set a suitable config key in generated module.go. E.g: "yourPrecompileConfig" 2- Read the comment and set a suitable contract address in generated module.go. E.g: ContractAddress = common.HexToAddress("ASUITABLEHEXADDRESS") 3- It is recommended to only modify code in the highlighted areas marked with "CUSTOM CODE STARTS HERE". Typically, custom codes are required in only those areas. Modifying code outside of these areas should be done with caution and with a deep understanding of how these changes may impact the EVM. 4- If you have any event defined in your precompile, review the generated event.go file and set your event gas costs. You should also emit your event in your function in the contract.go file. 5- Set gas costs in generated contract.go 6- Force import your precompile package in precompile/registry/registry.go 7- Add your config unit tests under generated package config_test.go 8- Add your contract unit tests under generated package contract_test.go 9- Additionally you can add a full-fledged VM test for your precompile under plugin/vm/vm_test.go. See existing precompile tests for examples. 10- Add your solidity interface and test contract to contracts/contracts 11- Write solidity contract tests for your precompile in contracts/contracts/test 12- Write TypeScript DS-Test counterparts for your solidity tests in contracts/test 13- Create your genesis with your precompile enabled in tests/precompile/genesis/ 14- Create e2e test for your solidity test in tests/precompile/solidity/suites.go 15- Run your e2e precompile Solidity tests with './scripts/run_ginkgo.sh` ``` Let's follow these steps and create our HelloWorld precompile. For Precompile-EVM we don't need to put files under a deep directory structure. We can just generate the precompile template under its own directory via `--out ./helloworld` flag. ```bash ./scripts/generate_precompile.sh --abi ./contracts/abis/contracts_interfaces_IHelloWorld_sol_IHelloWorld.abi --type HelloWorld --pkg helloworld --out ./helloworld ``` This generates a precompile template files `contract.go`, `contract.abi`, `config.go`, `module.go`, `event.go` and `README.md` files. `README.md` explains general guidelines for precompile development. You should carefully read this file before modifying the precompile template. ``` There are some must-be-done changes waiting in the generated file. Each area requiring you to add your code is marked with CUSTOM CODE to make them easy to find and modify. Additionally there are other files you need to edit to activate your precompile. These areas are highlighted with comments "ADD YOUR PRECOMPILE HERE". For testing take a look at other precompile tests in contract_test.go and config_test.go in other precompile folders. General guidelines for precompile development: 1- Set a suitable config key in generated module.go. E.g: "yourPrecompileConfig" 2- Read the comment and set a suitable contract address in generated module.go. E.g: ContractAddress = common.HexToAddress("ASUITABLEHEXADDRESS") 3- It is recommended to only modify code in the highlighted areas marked with "CUSTOM CODE STARTS HERE". Typically, custom codes are required in only those areas. Modifying code outside of these areas should be done with caution and with a deep understanding of how these changes may impact the EVM. 4- If you have any event defined in your precompile, review the generated event.go file and set your event gas costs. You should also emit your event in your function in the contract.go file. 5- Set gas costs in generated contract.go 6- Force import your precompile package in precompile/registry/registry.go 7- Add your config unit tests under generated package config_test.go 8- Add your contract unit tests under generated package contract_test.go 9- Additionally you can add a full-fledged VM test for your precompile under plugin/vm/vm_test.go. See existing precompile tests for examples. 10- Add your solidity interface and test contract to contracts/contracts 11- Write solidity contract tests for your precompile in contracts/contracts/test 12- Write TypeScript DS-Test counterparts for your solidity tests in contracts/test 13- Create your genesis with your precompile enabled in tests/precompile/genesis/ 14- Create e2e test for your solidity test in tests/precompile/solidity/suites.go 15- Run your e2e precompile Solidity tests with './scripts/run_ginkgo.sh` ``` Let's follow these steps and create our HelloWorld precompile! # Defining Your Precompile (/docs/avalanche-l1s/custom-precompiles/defining-precompile) --- title: Defining Your Precompile description: Now that we have autogenerated the template code required for our precompile, let's actually write the logic for the precompile itself. --- ## Setting Config Key Let's jump to `helloworld/module.go` file first. This file contains the module definition for our precompile. You can see the `ConfigKey` is set to some default value of `helloWorldConfig`. This key should be unique to the precompile. This config key determines which JSON key to use when reading the precompile's config from the JSON upgrade/genesis file. In this case, the config key is `helloWorldConfig` and the JSON config should look like this: ```json { "helloWorldConfig": { "blockTimestamp": 0 ... } } ``` ## Setting Contract Address In the `helloworld/module.go` you can see the `ContractAddress` is set to some default value. This should be changed to a suitable address for your precompile. The address should be unique to the precompile. There is a registry of precompile addresses under [`precompile/registry/registry.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/registry/registry.go). A list of addresses is specified in the comments under this file. Modify the default value to be the next user available stateful precompile address. For forks of Subnet-EVM or Precompile-EVM, users should start at `0x0300000000000000000000000000000000000000` to ensure that their own modifications do not conflict with stateful precompiles that may be added to Subnet-EVM in the future. You should pick an address that is not already taken. ```go title="helloworld/module.go" // This list is kept just for reference. The actual addresses defined in respective packages of precompiles. // Note: it is important that none of these addresses conflict with each other or any other precompiles // in core/vm/contracts.go. // The first stateful precompiles were added in coreth to support nativeAssetCall and nativeAssetBalance. New stateful precompiles // originating in coreth will continue at this prefix, so we reserve this range in subnet-evm so that they can be migrated into // subnet-evm without issue. // These start at the address: 0x0100000000000000000000000000000000000000 and will increment by 1. // Optional precompiles implemented in subnet-evm start at 0x0200000000000000000000000000000000000000 and will increment by 1 // from here to reduce the risk of conflicts. // For forks of subnet-evm, users should start at 0x0300000000000000000000000000000000000000 to ensure // that their own modifications do not conflict with stateful precompiles that may be added to subnet-evm // in the future. // ContractDeployerAllowListAddress = common.HexToAddress("0x0200000000000000000000000000000000000000") // ContractNativeMinterAddress = common.HexToAddress("0x0200000000000000000000000000000000000001") // TxAllowListAddress = common.HexToAddress("0x0200000000000000000000000000000000000002") // FeeManagerAddress = common.HexToAddress("0x0200000000000000000000000000000000000003") // RewardManagerAddress = common.HexToAddress("0x0200000000000000000000000000000000000004") // HelloWorldAddress = common.HexToAddress("0x0300000000000000000000000000000000000000") // ADD YOUR PRECOMPILE HERE // {YourPrecompile}Address = common.HexToAddress("0x03000000000000000000000000000000000000??") ``` Don't forget to update the actual variable `ContractAddress` in `module.go` to the address you chose. It should look like this: ```go title="helloworld/module.go" // ContractAddress is the defined address of the precompile contract. // This should be unique across all precompile contracts. // See params/precompile_modules.go for registered precompile contracts and more information. var ContractAddress = common.HexToAddress("0x0300000000000000000000000000000000000000") ``` Now when Subnet-EVM sees the `helloworld.ContractAddress` as input when executing [`CALL`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/evm.go#L251), [`CALLCODE`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/evm.go#L341), [`DELEGATECALL`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/evm.go#L392), [`STATICCALL`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/evm.go#L435), it can run the precompile if the precompile is enabled. ## Adding Custom Code Search (`CTRL F`) throughout the file with `CUSTOM CODE STARTS HERE` to find the areas in the precompile package that you need to modify. You should start with the reference imports code block. ### Module File The module file contains fundamental information about the precompile. This includes the key for the precompile, the address of the precompile, and a configurator. This file is located at [`./precompile/helloworld/module.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/module.go) for Subnet-EVM and [./helloworld/module.go](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/module.go) for Precompile-EVM. This file defines the module for the precompile. The module is used to register the precompile to the precompile registry. The precompile registry is used to read configs and enable the precompile. Registration is done in the `init()` function of the module file. `MakeConfig()` is used to create a new instance for the precompile config. This will be used in custom Unmarshal/Marshal logic. You don't need to override these functions. #### Configure() Module file contains a `configurator` which implements the `contract.Configurator` interface. This interface includes a `Configure()` function used to configure the precompile and set the initial state of the precompile. This function is called when the precompile is enabled. This is typically used to read from a given config in upgrade/genesis JSON and sets the initial state of the precompile accordingly. This function also calls `AllowListConfig.Configure()` to invoke AllowList configuration as the last step. You should keep it as it is if you want to use AllowList. You can modify this function for your custom logic. You can circle back to this function later after you have finalized the implementation of the precompile config. ### Config File The config file contains the config for the precompile. This file is located at [`./precompile/helloworld/config.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/config.go) for Subnet-EVM and [./helloworld/config.go](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/config.go) for Precompile-EVM. This file contains the `Config` struct, which implements `precompileconfig.Config` interface. It has some embedded structs like `precompileconfig.Upgrade`. `Upgrade` is used to enable upgrades for the precompile. It contains the `BlockTimestamp` and `Disable` to enable/disable upgrades. `BlockTimestamp` is the timestamp of the block when the upgrade will be activated. `Disable` is used to disable the upgrade. If you use `AllowList` for the precompile, there is also `allowlist.AllowListConfig` embedded in the `Config` struct. `AllowListConfig` is used to specify initial roles for specified addresses. If you have any custom fields in your precompile config, you can add them here. These custom fields will be read from upgrade/genesis JSON and set in the precompile config. ```go title="precompile/helloworld/config.go" // Config implements the precompileconfig.Config interface and // adds specific configuration for HelloWorld. type Config struct { allowlist.AllowListConfig precompileconfig.Upgrade } ``` #### Verify() `Verify()` is called on startup and an error is treated as fatal. Generated code contains a call to `AllowListConfig.Verify()` to verify the `AllowListConfig`. You can leave that as is and start adding your own custom verify code after that. We can leave this function as is right now because there is no invalid custom configuration for the `Config`. ```go title="precompile/helloworld/config.go" // Verify tries to verify Config and returns an error accordingly. func (c *Config) Verify() error { // Verify AllowList first if err := c.AllowListConfig.Verify(); err != nil { return err } // CUSTOM CODE STARTS HERE // Add your own custom verify code for Config here // and return an error accordingly return nil } ``` #### Equal() Next, we see is `Equal()`. This function determines if two precompile configs are equal. This is used to determine if the precompile needs to be upgraded. There is some default code that is generated for checking `Upgrade` and `AllowListConfig` equality. ```go title="precompile/helloworld/config.go" // Equal returns true if [s] is a [*Config] and it has been configured identical to [c]. func (c *Config) Equal(s precompileconfig.Config) bool { // typecast before comparison other, ok := (s).(*Config) if !ok { return false } // CUSTOM CODE STARTS HERE // modify this boolean accordingly with your custom Config, to check if [other] and the current [c] are equal // if Config contains only Upgrade and AllowListConfig you can skip modifying it. equals := c.Upgrade.Equal(&other.Upgrade) && c.AllowListConfig.Equal(&other.AllowListConfig) return equals } ``` We can leave this function as is since we check `Upgrade` and `AllowListConfig` for equality which are the only fields that `Config` struct has. ### Modify Configure() We can now circle back to `Configure()` in `module.go` as we finished implementing `Config` struct. This function configures the `state` with the initial configuration at`blockTimestamp` when the precompile is enabled. In the HelloWorld example, we want to set up a default key-value mapping in the state where the key is `storageKey` and the value is `Hello World!`. The `StateDB` allows us to store a key-value mapping of 32-byte hashes. The below code snippet can be copied and pasted to overwrite the default `Configure()` code. ```go title="precompile/helloworld/module.go" const defaultGreeting = "Hello World!" // Configure configures [state] with the given [cfg] precompileconfig. // This function is called by the EVM once per precompile contract activation. // You can use this function to set up your precompile contract's initial state, // by using the [cfg] config and [state] stateDB. func (*configurator) Configure(chainConfig contract.ChainConfig, cfg precompileconfig.Config, state contract.StateDB, _ contract.BlockContext) error { config, ok := cfg.(*Config) if !ok { return fmt.Errorf("incorrect config %T: %v", config, config) } // CUSTOM CODE STARTS HERE // This will be called in the first block where HelloWorld stateful precompile is enabled. // 1) If BlockTimestamp is nil, this will not be called // 2) If BlockTimestamp is 0, this will be called while setting up the genesis block // 3) If BlockTimestamp is 1000, this will be called while processing the first block // whose timestamp is >= 1000 // // Set the initial value under [common.BytesToHash([]byte("storageKey")] to "Hello World!" StoreGreeting(state, defaultGreeting) // AllowList is activated for this precompile. Configuring allowlist addresses here. return config.AllowListConfig.Configure(state, ContractAddress) } ``` ### Event File The event file contains the events that the precompile can emit. This file is located at [`./precompile/helloworld/event.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/event.go) for Subnet-EVM and [./helloworld/event.go](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/event.go) for Precompile-EVM. The file begins with a comment about events and how they can be emitted: ```go title="precompile/helloworld/event.go" /* NOTE: Events can only be emitted in state-changing functions. So you cannot use events in read-only (view) functions. Events are generally emitted at the end of a state-changing function with AddLog method of the StateDB. The AddLog method takes 4 arguments: 1. Address of the contract that emitted the event. 2. Topic hashes of the event. 3. Encoded non-indexed data of the event. 4. Block number at which the event was emitted. The first argument is the address of the contract that emitted the event. Topics can be at most 4 elements, the first topic is the hash of the event signature and the rest are the indexed event arguments. There can be at most 3 indexed arguments. Topics cannot be fully unpacked into their original values since they're 32-bytes hashes. The non-indexed arguments are encoded using the ABI encoding scheme. The non-indexed arguments can be unpacked into their original values. Before packing the event, you need to calculate the gas cost of the event. The gas cost of an event is the base gas cost + the gas cost of the topics + the gas cost of the non-indexed data. See Get{EvetName}EventGasCost functions for more details. You can use the following code to emit an event in your state-changing precompile functions (generated packer might be different):*/ topics, data, err := PackMyEvent( topic1, topic2, data1, data2, ) if err != nil { return nil, remainingGas, err } accessibleState.GetStateDB().AddLog(&types.Log{ Address: ContractAddress, Topics: topics, Data: data, BlockNumber: accessibleState.GetBlockContext().Number().Uint64(), }) ``` ```go title="precompile/helloworld/event.go" /* NOTE: Events can only be emitted in state-changing functions. So you cannot use events in read-only (view) functions. Events are generally emitted at the end of a state-changing function with AddLog method of the StateDB. The AddLog method takes 4 arguments: 1. Address of the contract that emitted the event. 2. Topic hashes of the event. 3. Encoded non-indexed data of the event. 4. Block number at which the event was emitted. The first argument is the address of the contract that emitted the event. Topics can be at most 4 elements, the first topic is the hash of the event signature and the rest are the indexed event arguments. There can be at most 3 indexed arguments. Topics cannot be fully unpacked into their original values since they're 32-bytes hashes. The non-indexed arguments are encoded using the ABI encoding scheme. The non-indexed arguments can be unpacked into their original values. Before packing the event, you need to calculate the gas cost of the event. The gas cost of an event is the base gas cost + the gas cost of the topics + the gas cost of the non-indexed data. See Get{EvetName}EventGasCost functions for more details. You can use the following code to emit an event in your state-changing precompile functions (generated packer might be different):*/ topics, data, err := PackMyEvent( topic1, topic2, data1, data2, ) if err != nil { return nil, remainingGas, err } accessibleState.GetStateDB().AddLog( ContractAddress, topics, data, accessibleState.GetBlockContext().Number().Uint64(), ) ``` In this file you should set your event's gas cost and implement the `Get{EventName}EventGasCost` function. This function should take the data you want to emit and calculate the gas cost. In this example we defined our event as follow, and plan to emit it in the `setGreeting` function: ```go event GreetingChanged(address indexed sender, string oldGreeting, string newGreeting); ``` We used arbitrary strings as non-indexed event data, remind that each emitted event is stored on chain, thus charging right amount is critical. We calculated gas cost according to the length of the string to make sure we're charging right amount of gas. If you're sure that you're dealing with a fixed length data, you can use a fixed gas cost for your event. We will show how events can be emitted under the Contract File section. ### Contract File The contract file contains the functions of the precompile contract that will be called by the EVM. The file is located at [`./precompile/helloworld/contract.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/contract.go) for Subnet-EVM and [./helloworld/contract.go](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/contract.go) for Precompile-EVM. Since we use `IAllowList` interface there will be auto-generated code for `AllowList` functions like below: ```go title="precompile/helloworld/contract.go" // GetHelloWorldAllowListStatus returns the role of [address] for the HelloWorld list. func GetHelloWorldAllowListStatus(stateDB contract.StateDB, address common.Address) allowlist.Role { return allowlist.GetAllowListStatus(stateDB, ContractAddress, address) } // SetHelloWorldAllowListStatus sets the permissions of [address] to [role] for the // HelloWorld list. Assumes [role] has already been verified as valid. // This stores the [role] in the contract storage with address [ContractAddress] // and [address] hash. It means that any reusage of the [address] key for different value // conflicts with the same slot [role] is stored. // Precompile implementations must use a different key than [address] for their storage. func SetHelloWorldAllowListStatus(stateDB contract.StateDB, address common.Address, role allowlist.Role) { allowlist.SetAllowListRole(stateDB, ContractAddress, address, role) } ``` These will be helpful to use AllowList precompile helper in our functions. #### Packers and Unpackers There are also auto-generated Packers and Unpackers for the ABI. These will be used in `sayHello` and `setGreeting` functions to comfort the ABI. These functions are auto-generated and will be used in necessary places accordingly. You don't need to worry about how to deal with them, but it's good to know what they are. Note: There were few changes to precompile packers with Durango. In this example we assumed that the HelloWorld precompile contract has been deployed before Durango. We need to activate this condition only after Durango. If this is a new precompile and never deployed before Durango, you can activate it immediately by removing the if condition. Each input to a precompile contract function has it's own `Unpacker` function as follows (if deployed before Durango): ```go title="precompile/helloworld/contract.go" // UnpackSetGreetingInput attempts to unpack [input] into the string type argument // assumes that [input] does not include selector (omits first 4 func signature bytes) // if [useStrictMode] is true, it will return an error if the length of [input] is not [common.HashLength] func UnpackSetGreetingInput(input []byte, useStrictMode bool) (string, error) { // Initially we had this check to ensure that the input was the correct length. // However solidity does not always pack the input to the correct length, and allows // for extra padding bytes to be added to the end of the input. Therefore, we have removed // this check with the Durango. We still need to keep this check for backwards compatibility. if useStrictMode && len(input) > common.HashLength { return "", ErrInputExceedsLimit } res, err := HelloWorldABI.UnpackInput("setGreeting", input, useStrictMode) if err != nil { return "", err } unpacked := *abi.ConvertType(res[0], new(string)).(*string) return unpacked, nil } ``` If this is a new precompile that will be deployed after Durango, you can skip strict mode handling and use false: ```go title="precompile/helloworld/contract.go" func UnpackSetGreetingInput(input []byte) (string, error) { res, err := HelloWorldABI.UnpackInput("setGreeting", input, false) if err != nil { return "", err } unpacked := *abi.ConvertType(res[0], new(string)).(*string) return unpacked, nil } ``` The ABI is a binary format and the input to the precompile contract function is a byte array. The `Unpacker` function converts this input to a more easy-to-use format so that we can use it in our function. Similarly, there is a `Packer` function for each output of a precompile contract function as follows: ```go title="precompile/helloworld/contract.go" // PackSayHelloOutput attempts to pack given result of type string // to conform the ABI outputs. func PackSayHelloOutput(result string) ([]byte, error) { return HelloWorldABI.PackOutput("sayHello", result) } ``` This function converts the output of the function to a byte array that conforms to the ABI and can be returned to the EVM as a result. #### Modify sayHello() The next place to modify is in our `sayHello()` function. In a previous step, we created the `IHelloWorld.sol` interface with two functions `sayHello()` and `setGreeting()`. We finally get to implement them here. If any contract calls these functions from the interface, the below function gets executed. This function is a simple getter function. In `Configure()` we set up a mapping with the key as `storageKey` and the value as `Hello World!`. In this function, we will be returning whatever value is at `storageKey`. The below code snippet can be copied and pasted to overwrite the default `setGreeting` code. First, we add a helper function to get the greeting value from the stateDB, this will be helpful when we test our contract. We will use the `storageKeyHash` to store the value in the Contract's reserved storage in the stateDB. ```go title="precompile/helloworld/contract.go" var ( // storageKeyHash is the hash of the storage key "storageKey" in the contract storage. // This is used to store the value of the greeting in the contract storage. // It is important to use a unique key here to avoid conflicts with other storage keys // like addresses, AllowList, etc. storageKeyHash = common.BytesToHash([]byte("storageKey")) ) // GetGreeting returns the value of the storage key "storageKey" in the contract storage, // with leading zeroes trimmed. // This function is mostly used for tests. func GetGreeting(stateDB contract.StateDB) string { // Get the value set at recipient value := stateDB.GetState(ContractAddress, storageKeyHash) return string(common.TrimLeftZeroes(value.Bytes())) } ``` Now we can modify the `sayHello` function to return the stored value. ```go title="precompile/helloworld/contract.go" func sayHello(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, SayHelloGasCost); err != nil { return nil, 0, err } // CUSTOM CODE STARTS HERE // Get the current state currentState := accessibleState.GetStateDB() // Get the value set at recipient value := GetGreeting(currentState) packedOutput, err := PackSayHelloOutput(value) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` #### Modify setGreeting() `setGreeting()` function is a simple setter function. It takes in `input` and we will set that as the value in the state mapping with the key as `storageKey`. It also checks if the VM running the precompile is in read-only mode. If it is, it returns an error. At the end of a successful execution, it will emit `GreetingChanged` event. There is also a generated `AllowList` code in that function. This generated code checks if the caller address is eligible to perform this state-changing operation. If not, it returns an error. Let's add the helper function to set the greeting value in the stateDB, this will be helpful when we test our contract. ```go title="precompile/helloworld/contract.go" // StoreGreeting sets the value of the storage key "storageKey" in the contract storage. func StoreGreeting(stateDB contract.StateDB, input string) { inputPadded := common.LeftPadBytes([]byte(input), common.HashLength) inputHash := common.BytesToHash(inputPadded) stateDB.SetState(ContractAddress, storageKeyHash, inputHash) } ``` The below code snippet can be copied and pasted to overwrite the default `setGreeting()` code. ```go title="precompile/helloworld/contract.go" func setGreeting(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, SetGreetingGasCost); err != nil { return nil, 0, err } if readOnly { return nil, remainingGas, vmerrs.ErrWriteProtection } // do not use strict mode after Durango useStrictMode := !contract.IsDurangoActivated(accessibleState) // attempts to unpack [input] into the arguments to the SetGreetingInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackSetGreetingInput(input, useStrictMode) if err != nil { return nil, remainingGas, err } // Allow list is enabled and SetGreeting is a state-changer function. // This part of the code restricts the function to be called only by enabled/admin addresses in the allow list. // You can modify/delete this code if you don't want this function to be restricted by the allow list. stateDB := accessibleState.GetStateDB() // Verify that the caller is in the allow list and therefore has the right to call this function. callerStatus := allowlist.GetAllowListStatus(stateDB, ContractAddress, caller) if !callerStatus.IsEnabled() { return nil, remainingGas, fmt.Errorf("%w: %s", ErrCannotSetGreeting, caller) } // allow list code ends here. // CUSTOM CODE STARTS HERE // With Durango, you can emit an event in your state-changing precompile functions. // Note: If you have been using the precompile before Durango, you should activate it only after Durango. // Activating this code before Durango will result in a consensus failure. // If this is a new precompile and never deployed before Durango, you can activate it immediately by removing // the if condition. // We will first read the old greeting. So we should charge the gas for reading the storage. if remainingGas, err = contract.DeductGas(remainingGas, contract.ReadGasCostPerSlot); err != nil { return nil, 0, err } oldGreeting := GetGreeting(stateDB) eventData := GreetingChangedEventData{ OldGreeting: oldGreeting, NewGreeting: inputStruct, } topics, data, err := PackGreetingChangedEvent(caller, eventData) if err != nil { return nil, remainingGas, err } // Charge the gas for emitting the event. eventGasCost := GetGreetingChangedEventGasCost(eventData) if remainingGas, err = contract.DeductGas(remainingGas, eventGasCost); err != nil { return nil, 0, err } // Emit the event stateDB.AddLog(&types.Log{ Address: ContractAddress, Topics: topics, Data: data, BlockNumber: accessibleState.GetBlockContext().Number().Uint64(), }) // setGreeting is the execution function // "SetGreeting(name string)" and sets the storageKey // in the string returned by hello world StoreGreeting(stateDB, inputStruct) // This function does not return an output, leave this one as is packedOutput := []byte{} // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` ```go title="precompile/helloworld/contract.go" func setGreeting(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, SetGreetingGasCost); err != nil { return nil, 0, err } if readOnly { return nil, remainingGas, vmerrs.ErrWriteProtection } // do not use strict mode after Durango useStrictMode := !contract.IsDurangoActivated(accessibleState) // attempts to unpack [input] into the arguments to the SetGreetingInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackSetGreetingInput(input, useStrictMode) if err != nil { return nil, remainingGas, err } // Allow list is enabled and SetGreeting is a state-changer function. // This part of the code restricts the function to be called only by enabled/admin addresses in the allow list. // You can modify/delete this code if you don't want this function to be restricted by the allow list. stateDB := accessibleState.GetStateDB() // Verify that the caller is in the allow list and therefore has the right to call this function. callerStatus := allowlist.GetAllowListStatus(stateDB, ContractAddress, caller) if !callerStatus.IsEnabled() { return nil, remainingGas, fmt.Errorf("%w: %s", ErrCannotSetGreeting, caller) } // allow list code ends here. // CUSTOM CODE STARTS HERE // With Durango, you can emit an event in your state-changing precompile functions. // Note: If you have been using the precompile before Durango, you should activate it only after Durango. // Activating this code before Durango will result in a consensus failure. // If this is a new precompile and never deployed before Durango, you can activate it immediately by removing // the if condition. // We will first read the old greeting. So we should charge the gas for reading the storage. if remainingGas, err = contract.DeductGas(remainingGas, contract.ReadGasCostPerSlot); err != nil { return nil, 0, err } oldGreeting := GetGreeting(stateDB) eventData := GreetingChangedEventData{ OldGreeting: oldGreeting, NewGreeting: inputStruct, } topics, data, err := PackGreetingChangedEvent(caller, eventData) if err != nil { return nil, remainingGas, err } // Charge the gas for emitting the event. eventGasCost := GetGreetingChangedEventGasCost(eventData) if remainingGas, err = contract.DeductGas(remainingGas, eventGasCost); err != nil { return nil, 0, err } // Emit the event stateDB.AddLog(&types.Log{ Address: ContractAddress, Topics: topics, Data: data, BlockNumber: accessibleState.GetBlockContext().Number().Uint64(), }) // setGreeting is the execution function // "SetGreeting(name string)" and sets the storageKey // in the string returned by hello world StoreGreeting(stateDB, inputStruct) // This function does not return an output, leave this one as is packedOutput := []byte{} // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` Precompile events introduced with Durango. In this example we assumed that the `HelloWorld` precompile contract has been deployed before Durango. If this is a new precompile and it will be deployed after Durango, you can activate it immediately by removing the Durango if condition (`contract.IsDurangoActivated(accessibleState)`). ### Setting Gas Costs Setting gas costs for functions is very important and should be done carefully. If the gas costs are set too low, then functions can be abused and can cause DoS attacks. If the gas costs are set too high, then the contract will be too expensive to run. Subnet-EVM has some predefined gas costs for write and read operations in [`precompile/contract/utils.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contract/utils.go#L19-L20). In order to provide a baseline for gas costs, we have set the following gas costs. ```go title="precompile/contract/utils.go" // Gas costs for stateful precompiles const ( WriteGasCostPerSlot = 20_000 ReadGasCostPerSlot = 5_000 ) ``` - `WriteGasCostPerSlot` is the cost of one write such as modifying a state storage slot. - `ReadGasCostPerSlot` is the cost of reading a state storage slot. This should be in your gas cost estimations based on how many times the precompile function does a read or a write. For example, if the precompile modifies the state slot of its precompile address twice then the gas cost for that function would be `40_000`. However, if the precompile does additional operations and requires more computational power, then you should increase the gas costs accordingly. On top of these gas costs, we also have to account for the gas costs of AllowList gas costs. These are the gas costs of reading and writing permissions for addresses in AllowList. These are defined under Subnet-EVM's [`precompile/allowlist/allowlist.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/allowlist/allowlist.go#L28-L29). By default, these are added to the default gas costs of the state-change functions (SetGreeting) of the precompile. Meaning that these functions will cost an additional `ReadAllowListGasCost` in order to read permissions from the storage. If you don't plan to read permissions from the storage then you can omit these. Now going back to our `/helloworld/contract.go`, we can modify our precompile function gas costs. Please search (`CTRL F`) `SET A GAS COST HERE` to locate the default gas cost code. ```go title="helloworld/contract.go" SayHelloGasCost uint64 = 0 // SET A GAS COST HERE SetGreetingGasCost uint64 = 0 + allowlist.ReadAllowListGasCost // SET A GAS COST HERE ``` We get and set our greeting with `sayHello()` and `setGreeting()` in one slot respectively so we can define the gas costs as follows. We also read permissions from the AllowList in `setGreeting()` so we keep `allowlist.ReadAllowListGasCost`. ```go title="helloworld/contract.go" SayHelloGasCost uint64 = contract.ReadGasCostPerSlot SetGreetingGasCost uint64 = contract.WriteGasCostPerSlot + allowlist.ReadAllowListGasCost ``` ## Registering Your Precompile We should register our precompile package to the Subnet-EVM to be discovered by other packages. Our `Module` file contains an `init()` function that registers our precompile. `init()` is called when the package is imported. We should register our precompile in a common package so that it can be imported by other packages. For Subnet-EVM we have a precompile registry under [`/precompile/registry/registry.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/registry/registry.go). This registry force-imports precompiles from other packages, for example: ```go title="precompile/registry/registry.go" // Force imports of each precompile to ensure each precompile's init function runs and registers itself // with the registry. import ( _ "github.com/ava-labs/subnet-evm/precompile/contracts/deployerallowlist" _ "github.com/ava-labs/subnet-evm/precompile/contracts/nativeminter" _ "github.com/ava-labs/subnet-evm/precompile/contracts/txallowlist" _ "github.com/ava-labs/subnet-evm/precompile/contracts/feemanager" _ "github.com/ava-labs/subnet-evm/precompile/contracts/rewardmanager" _ "github.com/ava-labs/subnet-evm/precompile/contracts/helloworld" // ADD YOUR PRECOMPILE HERE // _ "github.com/ava-labs/subnet-evm/precompile/contracts/yourprecompile" ) ``` The registry itself also force-imported by the [\`/plugin/evm/vm.go](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/plugin/evm/vm.go#L50). This ensures that the registry is imported and the precompiles are registered. For Precompile-EVM there is a `plugin/main.go` file in Precompile-EVM that orchestrates this precompile registration. ```go title="plugin/main.go" // (c) 2019-2023, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. package main import ( "fmt" "github.com/ava-labs/avalanchego/version" "github.com/ava-labs/subnet-evm/plugin/evm" "github.com/ava-labs/subnet-evm/plugin/runner" // Each precompile generated by the precompilegen tool has a self-registering init function // that registers the precompile with the subnet-evm. Importing the precompile package here // will cause the precompile to be registered with the subnet-evm. _ "github.com/ava-labs/precompile-evm/helloworld" // ADD YOUR PRECOMPILE HERE //_ "github.com/ava-labs/precompile-evm/{yourprecompilepkg}" ) ``` # Writing Test Cases (/docs/avalanche-l1s/custom-precompiles/defining-test-cases) --- title: Writing Test Cases description: In this section, we will go over the different ways we can write test cases for our stateful precompile. --- ## Adding Config Tests Precompile generation tool generates skeletons for unit tests as well. Generated config tests will be under [`./precompile/contracts/helloworld/config_test.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/config_test.go) for Subnet-EVM and [`./helloworld/config_test.go`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/config_test.go) for Precompile-EVM. There are mainly two functions we need to test: `Verify` and `Equal`. `Verify` checks if the precompile is configured correctly. `Equal` checks if the precompile is equal to another precompile. Generated `Verify` tests contain a valid case. You can add more invalid cases depending on your implementation. `Equal` tests generate some invalid cases to test different timestamps, types, and AllowList cases. You can check each `config_test.go` files for other precompiles under the Subnet-EVM's [`./precompile/contracts`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/) directory for more examples. ## Adding Contract Tests The tool also generates contract tests to make sure our precompile is working correctly. Generated tests include cases to test allow list capabilities, gas costs, and calling functions in read-only mode. You can check other `contract_test.go` files in the `/precompile/contracts`. Hello World contract tests will be under [`./precompile/contracts/helloworld/contract_test.go`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contracts/helloworld/contract_test.go) for Subnet-EVM and [`./helloworld/contract_test.go`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/helloworld/contract_test.go) for Precompile-EVM. We will also add more test to cover functionalities of `sayHello()` and `setGreeting()`. Contract tests are defined in a standard structure that each test can customize to their needs. The test structure is as follows: ```go // PrecompileTest is a test case for a precompile type PrecompileTest struct { // Caller is the address of the precompile caller Caller common.Address // Input the raw input bytes to the precompile Input []byte // InputFn is a function that returns the raw input bytes to the precompile // If specified, Input will be ignored. InputFn func(t *testing.T) []byte // SuppliedGas is the amount of gas supplied to the precompile SuppliedGas uint64 // ReadOnly is whether the precompile should be called in read only // mode. If true, the precompile should not modify the state. ReadOnly bool // Config is the config to use for the precompile // It should be the same precompile config that is used in the // precompile's configurator. // If nil, Configure will not be called. Config precompileconfig.Config // BeforeHook is called before the precompile is called. BeforeHook func(t *testing.T, state contract.StateDB) // AfterHook is called after the precompile is called. AfterHook func(t *testing.T, state contract.StateDB) // ExpectedRes is the expected raw byte result returned by the precompile ExpectedRes []byte // ExpectedErr is the expected error returned by the precompile ExpectedErr string // BlockNumber is the block number to use for the precompile's block context BlockNumber int64 } ``` Each test can populate the fields of the `PrecompileTest` struct to customize the test. This test uses an AllowList helper function `allowlist.RunPrecompileWithAllowListTests(t, Module, state.NewTestStateDB, tests)` which can run all specified tests plus AllowList test suites. If you don't plan to use AllowList, you can directly run them as follows: ```go for name, test := range tests { t.Run(name, func(t *testing.T) { test.Run(t, module, newStateDB(t)) }) } ``` ## Adding VM Tests (Optional) This is only applicable for direct Subnet-EVM forks as test files are not directly exported in Golang. If you use Precompile-EVM you can skip this step. VM tests are tests that run the precompile by calling it through the Subnet-EVM. These are the most comprehensive tests that we can run. If your precompile modifies how the Subnet-EVM works, for example changing blockchain rules, you should add a VM test. For example, you can take a look at the `TestRewardManagerPrecompileSetRewardAddress` function in [here](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/plugin/evm/vm_test.go#L2772). For this Hello World example, we don't modify any Subnet-EVM rules, so we don't need to add any VM tests. ## Adding Solidity Test Contracts Let's add our test contract to `./contracts/contracts`. This smart contract lets us interact with our precompile! We cast the `HelloWorld` precompile address to the `IHelloWorld` interface. In doing so, `helloWorld` is now a contract of type `IHelloWorld` and when we call any functions on that contract, we will be redirected to the HelloWorld precompile address. The below code snippet can be copied and pasted into a new file called `ExampleHelloWorld.sol`: ```go //SPDX-License-Identifier: MIT pragma solidity ^0.8.0; import "./IHelloWorld.sol"; // ExampleHelloWorld shows how the HelloWorld precompile can be used in a smart contract. contract ExampleHelloWorld { address constant HELLO_WORLD_ADDRESS = 0x0300000000000000000000000000000000000000; IHelloWorld helloWorld = IHelloWorld(HELLO_WORLD_ADDRESS); function sayHello() public view returns (string memory) { return helloWorld.sayHello(); } function setGreeting(string calldata greeting) public { helloWorld.setGreeting(greeting); } } ``` Hello World Precompile is a different contract than ExampleHelloWorld and has a different address. Since the precompile uses AllowList for a permissioned access, any call to the precompile including from ExampleHelloWorld will be denied unless the caller is added to the AllowList. Please note that this contract is simply a wrapper and is calling the precompile functions. The reason why we add another example smart contract is to have a simpler stateless tests. For the test contract we write our test in `./contracts/test/ExampleHelloWorldTest.sol`. ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.0; import "../ExampleHelloWorld.sol"; import "../interfaces/IHelloWorld.sol"; import "./AllowListTest.sol"; contract ExampleHelloWorldTest is AllowListTest { IHelloWorld helloWorld = IHelloWorld(HELLO_WORLD_ADDRESS); function step_getDefaultHelloWorld() public { ExampleHelloWorld example = new ExampleHelloWorld(); address exampleAddress = address(example); assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None); assertEq(example.sayHello(), "Hello World!"); } function step_doesNotSetGreetingBeforeEnabled() public { ExampleHelloWorld example = new ExampleHelloWorld(); address exampleAddress = address(example); assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None); try example.setGreeting("testing") { assertTrue(false, "setGreeting should fail"); } catch {} } function step_setAndGetGreeting() public { ExampleHelloWorld example = new ExampleHelloWorld(); address exampleAddress = address(example); assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None); helloWorld.setEnabled(exampleAddress); assertRole( helloWorld.readAllowList(exampleAddress), AllowList.Role.Enabled ); string memory greeting = "testgreeting"; example.setGreeting(greeting); assertEq(example.sayHello(), greeting); } } ``` For Precompile-EVM, you should import AllowListTest with `@avalabs/subnet-evm-contracts` NPM package: ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.0; import "../ExampleHelloWorld.sol"; import "../interfaces/IHelloWorld.sol"; import "@avalabs/subnet-evm-contracts/contracts/test/AllowListTest.sol"; contract ExampleHelloWorldTest is AllowListTest { IHelloWorld helloWorld = IHelloWorld(HELLO_WORLD_ADDRESS); function step_getDefaultHelloWorld() public { ExampleHelloWorld example = new ExampleHelloWorld(); address exampleAddress = address(example); assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None); assertEq(example.sayHello(), "Hello World!"); } function step_doesNotSetGreetingBeforeEnabled() public { ExampleHelloWorld example = new ExampleHelloWorld(); address exampleAddress = address(example); assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None); try example.setGreeting("testing") { assertTrue(false, "setGreeting should fail"); } catch {} } function step_setAndGetGreeting() public { ExampleHelloWorld example = new ExampleHelloWorld(); address exampleAddress = address(example); assertRole(helloWorld.readAllowList(exampleAddress), AllowList.Role.None); helloWorld.setEnabled(exampleAddress); assertRole( helloWorld.readAllowList(exampleAddress), AllowList.Role.Enabled ); string memory greeting = "testgreeting"; example.setGreeting(greeting); assertEq(example.sayHello(), greeting); } } ``` ## Adding DS-Test Case We can now trigger this test contract via `hardhat` tests. The test script uses Subnet-EVM's `test` framework test in `./contracts/test`. You can find more information about the test framework [here](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/contracts/test/utils.ts). We also can test the events emitted by the precompile. The test script looks like this: The test script looks like this: ```go // (c) 2019-2022, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. import { expect } from "chai"; import { SignerWithAddress } from "@nomiclabs/hardhat-ethers/signers"; import { Contract } from "ethers"; import { ethers } from "hardhat"; import { test } from "./utils"; // make sure this is always an admin for hello world precompile const ADMIN_ADDRESS = "0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"; const HELLO_WORLD_ADDRESS = "0x0300000000000000000000000000000000000000"; describe("ExampleHelloWorldTest", function () { this.timeout("30s"); beforeEach("Setup DS-Test contract", async function () { const signer = await ethers.getSigner(ADMIN_ADDRESS); const helloWorldPromise = ethers.getContractAt( "IHelloWorld", HELLO_WORLD_ADDRESS, signer ); return ethers .getContractFactory("ExampleHelloWorldTest", { signer }) .then((factory) => factory.deploy()) .then((contract) => { this.testContract = contract; return contract.deployed().then(() => contract); }) .then(() => Promise.all([helloWorldPromise])) .then(([helloWorld]) => helloWorld.setAdmin(this.testContract.address)) .then((tx) => tx.wait()); }); test("should gets default hello world", ["step_getDefaultHelloWorld"]); test( "should not set greeting before enabled", "step_doesNotSetGreetingBeforeEnabled" ); test( "should set and get greeting with enabled account", "step_setAndGetGreeting" ); }); describe("IHelloWorld events", function () { let owner: SignerWithAddress; let contract: Contract; let defaultGreeting = "Hello, World!"; before(async function () { owner = await ethers.getSigner(ADMIN_ADDRESS); contract = await ethers.getContractAt( "IHelloWorld", HELLO_WORLD_ADDRESS, owner ); // reset greeting let tx = await contract.setGreeting(defaultGreeting); await tx.wait(); }); it("should emit GreetingChanged event", async function () { let newGreeting = "helloprecompile"; await expect(contract.setGreeting(newGreeting)) .to.emit(contract, "GreetingChanged") .withArgs( owner.address, // old greeting defaultGreeting, // new greeting newGreeting ); }); }); ``` The test script looks like this: ```go // (c) 2019-2022, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. import { expect } from "chai"; import { SignerWithAddress } from "@nomiclabs/hardhat-ethers/signers"; import { Contract } from "ethers"; import { ethers } from "hardhat"; import { test } from "@avalabs/subnet-evm-contracts"; // make sure this is always an admin for hello world precompile const ADMIN_ADDRESS = "0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"; const HELLO_WORLD_ADDRESS = "0x0300000000000000000000000000000000000000"; describe("ExampleHelloWorldTest", function () { this.timeout("30s"); beforeEach("Setup DS-Test contract", async function () { const signer = await ethers.getSigner(ADMIN_ADDRESS); const helloWorldPromise = ethers.getContractAt( "IHelloWorld", HELLO_WORLD_ADDRESS, signer ); return ethers .getContractFactory("ExampleHelloWorldTest", { signer }) .then((factory) => factory.deploy()) .then((contract) => { this.testContract = contract; return contract.deployed().then(() => contract); }) .then(() => Promise.all([helloWorldPromise])) .then(([helloWorld]) => helloWorld.setAdmin(this.testContract.address)) .then((tx) => tx.wait()); }); test("should gets default hello world", ["step_getDefaultHelloWorld"]); test( "should not set greeting before enabled", "step_doesNotSetGreetingBeforeEnabled" ); test( "should set and get greeting with enabled account", "step_setAndGetGreeting" ); }); describe("IHelloWorld events", function () { let owner: SignerWithAddress; let contract: Contract; let defaultGreeting = "Hello, World!"; before(async function () { owner = await ethers.getSigner(ADMIN_ADDRESS); contract = await ethers.getContractAt( "IHelloWorld", HELLO_WORLD_ADDRESS, owner ); // reset greeting let tx = await contract.setGreeting(defaultGreeting); await tx.wait(); }); it("should emit GreetingChanged event", async function () { let newGreeting = "helloprecompile"; await expect(contract.setGreeting(newGreeting)) .to.emit(contract, "GreetingChanged") .withArgs( owner.address, // old greeting defaultGreeting, // new greeting newGreeting ); }); }); ``` # Executing Test Cases (/docs/avalanche-l1s/custom-precompiles/executing-test-cases) --- title: Executing Test Cases description: In this section, we will go over how to be able to execute the test cases you wrote in the last section. --- ## Adding the Test Genesis File To run our e2e contract tests, we will need to create an Avalanche L1 that has the `Hello World` precompile activated, so we will copy and paste the below genesis file into: `/tests/precompile/genesis/hello_world.json`. Note: it's important that this has the same name as the HardHat test file we created previously. ```json { "config": { "chainId": 99999, "homesteadBlock": 0, "eip150Block": 0, "eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0", "eip155Block": 0, "eip158Block": 0, "byzantiumBlock": 0, "constantinopleBlock": 0, "petersburgBlock": 0, "istanbulBlock": 0, "muirGlacierBlock": 0, "feeConfig": { "gasLimit": 20000000, "minBaseFee": 1000000000, "targetGas": 100000000, "baseFeeChangeDenominator": 48, "minBlockGasCost": 0, "maxBlockGasCost": 10000000, "targetBlockRate": 2, "blockGasCostStep": 500000 }, "helloWorldConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } }, "alloc": { "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { "balance": "0x52B7D2DCC80CD2E4000000" }, "0x0Fa8EA536Be85F32724D57A37758761B86416123": { "balance": "0x52B7D2DCC80CD2E4000000" } }, "nonce": "0x0", "timestamp": "0x66321C34", "extraData": "0x00", "gasLimit": "0x1312D00", "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000" } ``` Adding this to our genesis enables our HelloWorld precompile at the genesis block (0th block), with `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` as the admin address. ```json { "helloWorldConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } ``` ## Declaring the HardHat E2E Test Now that we have declared the HardHat test and corresponding `genesis.json` file. The last step to running the e2e test is to declare the new test in `/tests/precompile/solidity/suites.go`. At the bottom of the file you will see the following code commented out: ```go title="suites.go" // ADD YOUR PRECOMPILE HERE /* ginkgo.It("your precompile", ginkgo.Label("Precompile"), ginkgo.Label("YourPrecompile"), func() { ctx, cancel := context.WithTimeout(context.Background(), time.Minute) defer cancel() // Specify the name shared by the genesis file in ./tests/precompile/genesis/{your_precompile}.json // and the test file in ./contracts/tests/{your_precompile}.ts blockchainID := subnetsSuite.GetBlockchainID("{your_precompile}") runDefaultHardhatTests(ctx, blockchainID, "{your_precompile}") */ ``` `runDefaultHardhatTests` will run the default Hardhat test command and use the default genesis path. If you want to use a different test command and genesis path than the defaults, you can use the `utils.CreateSubnet` and `utils.RunTestCMD`. See how they were used with default params [here](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/tests/utils/subnet.go#L113) You should copy and paste the ginkgo `It` node and update from `{your_precompile}` to `hello_world`. The string passed in to `utils.RunDefaultHardhatTests(ctx, "your_precompile")` will be used to find both the HardHat test file to execute and the genesis file, which is why you need to use the same name for both. After modifying the `It` node, it should look like the following (you can copy and paste this directly if you prefer): ```go ginkgo.It("hello world", ginkgo.Label("Precompile"), ginkgo.Label("HelloWorld"), func() { ctx, cancel := context.WithTimeout(context.Background(), time.Minute) defer cancel() blockchainID := subnetsSuite.GetBlockchainID("hello_world") runDefaultHardhatTests(ctx, blockchainID, "hello_world") }) ``` Now that we've set up the new ginkgo test, we can run the ginkgo test that we want by using the `GINKGO_LABEL_FILTER`. This environment variable is passed as a flag to Ginkgo in `./scripts/run_ginkgo.sh` and restricts what tests will run to only the tests with a matching label. ## Running E2E Tests Before we start testing, we will need to build the AvalancheGo binary and the custom Subnet-EVM binary. Precompile-EVM bundles Subnet-EVM and runs it under the hood in the [`plugins/main.go`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/plugin/main.go#L24). Meaning that Precompile-EVM binary works the same way as Subnet-EVM binary. Precompile-EVM repo has also same scripts and the build process as Subnet-EVM. Following steps also apply to Precompile-EVM. You should have cloned [AvalancheGo](https://github.com/ava-labs/avalanchego) within your `$GOPATH` in the [Background and Requirements](/docs/avalanche-l1s/custom-precompiles/background-requirements) section, so you can build AvalancheGo with the following command: ```bash cd $GOPATH/src/github.com/ava-labs/avalanchego ./scripts/build.sh ``` Once you've built AvalancheGo, you can confirm that it was successful by printing the version: ```bash ./build/avalanchego --version ``` This should print something like the following (if you are running AvalancheGo v1.9.7): ```bash avalanchego/1.11.0 [database=v1.4.5, rpcchainvm=33, commit=c60f7d2dd10c87f57382885b59d6fb2c763eded7, go=1.21.7] ``` This path will be used later as the environment variable `AVALANCHEGO_EXEC_PATH` in the network runner. Please note that the RPCChainVM version of AvalancheGo and Subnet-EVM must match. Once we've built AvalancheGo, we can navigate back to the repo and build the binary: ```bash cd $GOPATH/src/github.com/ava-labs/subnet-evm ./scripts/build.sh ``` This will build the Subnet-EVM binary and place it in AvalancheGo's `build/plugins` directory by default at the file path: `$GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy` To confirm that the Subnet-EVM binary is compatible with AvalancheGo, you can run the same version command and confirm the RPCChainVM version matches: ```bash $GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy --version ``` This should give similar output: ```bash Subnet-EVM/v0.6.1 [AvalancheGo=v1.11.1, rpcchainvm=33] ``` ```bash cd $GOPATH/src/github.com/ava-labs/precompile-evm ./scripts/build.sh ``` This will build the Precompile-EVM binary and place it in AvalancheGo's `build/plugins` directory by default at the file path: `$GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy` To confirm that the Precompile-EVM binary is compatible with AvalancheGo, you can run the same version command and confirm the RPCChainVM version matches: ```bash $GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy --version ``` This should give similar output: ```bash Precompile-EVM/v0.2.0 Subnet-EVM/v0.6.1 [AvalancheGo=v1.11.1, rpcchainvm=33] ``` If the RPCChainVM Protocol version printed out does not match the one used in AvalancheGo then Subnet-EVM will not be able to talk to AvalancheGo and the blockchain will not start. You can find the compatibility table for AvalancheGo and Subnet-EVM [here](https://github.com/ava-labs/subnet-evm#avalanchego-compatibility). The `build/plugins` directory will later be used as the `AVALANCHEGO_PLUGIN_PATH`. ### Running Ginkgo Tests To run ONLY the HelloWorld precompile test, run the command: ```bash cd $GOPATH/src/github.com/ava-labs/subnet-evm ``` ```bash cd $GOPATH/src/github.com/ava-labs/precompile-evm ``` use `GINKGO_LABEL_FILTER` env var to filter the test: ```bash GINKGO_LABEL_FILTER=HelloWorld ./scripts/run_ginkgo.sh ``` You will first see the node starting up in the `BeforeSuite` section of the precompile test: ```bash GINKGO_LABEL_FILTER=HelloWorld ./scripts/run_ginkgo.sh # output Using branch: hello-world-tutorial-walkthrough building precompile.test # github.com/ava-labs/subnet-evm/tests/precompile.test ld: warning: could not create compact unwind for _blst_sha256_block_data_order: does not use RBP or RSP based frame Compiled precompile.test # github.com/ava-labs/subnet-evm/tests/load.test ld: warning: could not create compact unwind for _blst_sha256_block_data_order: does not use RBP or RSP based frame Compiled load.test Running Suite: subnet-evm precompile ginkgo test suite - /Users/avalabs/go/src/github.com/ava-labs/subnet-evm =================================================================================================================== Random Seed: 1674833631 Will run 1 of 7 specs ------------------------------ [BeforeSuite] /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/precompile_test.go:31 > Enter [BeforeSuite] TOP-LEVEL - /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/precompile_test.go:31 @ 01/27/23 10:33:51.001 INFO [01-27|10:33:51.002] Starting AvalancheGo node wd=/Users/avalabs/go/src/github.com/ava-labs/subnet-evm INFO [01-27|10:33:51.002] Executing cmd="./scripts/run.sh " [streaming output] Using branch: hello-world-tutorial-walkthrough ... [BeforeSuite] PASSED [15.002 seconds] ``` After the `BeforeSuite` completes successfully, it will skip all but the `HelloWorld` labeled precompile test: ```bash S [SKIPPED] [Precompiles] /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:26 contract native minter [Precompile, ContractNativeMinter] /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:29 ------------------------------ S [SKIPPED] [Precompiles] /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:26 tx allow list [Precompile, TxAllowList] /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:36 ------------------------------ ... Combined output: Compiling 2 files with 0.8.0 Compilation finished successfully ExampleHelloWorldTest ✓ should gets default hello world (4057ms) ✓ should not set greeting before enabled (4067ms) ✓ should set and get greeting with enabled account (4074ms) 3 passing (33s) < Exit [It] hello world - /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/precompile/solidity/suites.go:64 @ 01/27/23 10:34:17.484 (11.48s) • [11.480 seconds] ------------------------------ ``` Finally, you will see the load test being skipped as well: ```bash Running Suite: subnet-evm small load simulator test suite - /Users/avalabs/go/src/github.com/ava-labs/subnet-evm ====================================================================================================================== Random Seed: 1674833658 Will run 0 of 1 specs S [SKIPPED] [Load Simulator] /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/load/load_test.go:49 basic subnet load test [load] /Users/avalabs/go/src/github.com/ava-labs/subnet-evm/tests/load/load_test.go:50 ------------------------------ Ran 0 of 1 Specs in 0.000 seconds SUCCESS! -- 0 Passed | 0 Failed | 0 Pending | 1 Skipped PASS ``` Looks like the tests are passing! If your tests failed, please retrace your steps. Most likely the error is that the precompile was not enabled and some code is missing. Try running `npm install` in the contracts directory to ensure that hardhat and other packages are installed. You may also use the [official tutorial implementation](https://github.com/ava-labs/subnet-evm/tree/helloworld-official-tutorial-v2) to double-check your work as well. # Custom Precompiles (/docs/avalanche-l1s/custom-precompiles) --- title: Custom Precompiles description: In this tutorial, we are going to walk through how we can generate a stateful precompile from scratch. Before we start, let's brush up on what a precompile is, what a stateful precompile is, and why this is extremely useful. --- ## Background ### Precompiled Contracts Ethereum uses precompiles to efficiently implement cryptographic primitives within the EVM instead of re-implementing the same primitives in Solidity. The following precompiles are currently included: ecrecover, sha256, blake2f, ripemd-160, Bn256Add, Bn256Mul, Bn256Pairing, the identity function, and modular exponentiation. We can see these [precompile](https://github.com/ethereum/go-ethereum/blob/v1.11.1/core/vm/contracts.go#L82) mappings from address to function here in the Ethereum VM: ```go // PrecompiledContractsBerlin contains the default set of pre-compiled Ethereum // contracts used in the Berlin release. var PrecompiledContractsBerlin = map[common.Address]PrecompiledContract{ common.BytesToAddress([]byte{1}): &ecrecover{}, common.BytesToAddress([]byte{2}): &sha256hash{}, common.BytesToAddress([]byte{3}): &ripemd160hash{}, common.BytesToAddress([]byte{4}): &dataCopy{}, common.BytesToAddress([]byte{5}): &bigModExp{eip2565: true}, common.BytesToAddress([]byte{6}): &bn256AddIstanbul{}, common.BytesToAddress([]byte{7}): &bn256ScalarMulIstanbul{}, common.BytesToAddress([]byte{8}): &bn256PairingIstanbul{}, common.BytesToAddress([]byte{9}): &blake2F{}, } ``` These precompile addresses start from `0x0000000000000000000000000000000000000001` and increment by 1. A [precompile](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/contracts.go#L54-L57) follows this interface: ```go // PrecompiledContract is the basic interface for native Go contracts. The implementation // requires a deterministic gas count based on the input size of the Run method of the // contract. type PrecompiledContract interface { RequiredGas(input []byte) uint64 // RequiredPrice calculates the contract gas use Run(input []byte) ([]byte, error) // Run runs the precompiled contract } ``` Here is an example of the [sha256 precompile](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/core/vm/contracts.go#L237-L250) function. ```go type sha256hash struct{} // RequiredGas returns the gas required to execute the pre-compiled contract. // // This method does not require any overflow checking as the input size gas costs // required for anything significant is so high it's impossible to pay for. func (c *sha256hash) RequiredGas(input []byte) uint64 { return uint64(len(input)+31)/32*params.Sha256PerWordGas + params.Sha256BaseGas } func (c *sha256hash) Run(input []byte) ([]byte, error) { h := sha256.Sum256(input) return h[:], nil } ``` The CALL opcode (CALL, STATICCALL, DELEGATECALL, and CALLCODE) allows us to invoke this precompile. The function signature of CALL in the EVM is as follows: ```go Call( caller ContractRef, addr common.Address, input []byte, gas uint64, value *big.Int, )(ret []byte, leftOverGas uint64, err error) ``` Precompiles are a shortcut to execute a function implemented by the EVM itself, rather than an actual contract. A precompile is associated with a fixed address defined in the EVM. There is no byte code associated with that address. When a precompile is called, the EVM checks if the input address is a precompile address, and if so it executes the precompile. Otherwise, it loads the smart contract at the input address and runs it on the EVM interpreter with the specified input data. ### Stateful Precompiled Contracts A stateful precompile builds on a precompile in that it adds state access. Stateful precompiles are not available in the default EVM, and are specific to Avalanche EVMs such as [Coreth](https://github.com/ava-labs/coreth) and [Subnet-EVM](https://github.com/ava-labs/subnet-evm). A stateful precompile follows this [interface](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/precompile/contract/interfaces.go#L17-L20): ```go // StatefulPrecompiledContract is the interface for executing a precompiled contract type StatefulPrecompiledContract interface { // Run executes the precompiled contract. Run(accessibleState PrecompileAccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) } ``` A stateful precompile injects state access through the `PrecompileAccessibleState` interface to provide access to the EVM state including the ability to modify balances and read/write storage. This way we can provide even more customization of the EVM through Stateful Precompiles than we can with the original precompile interface! ### AllowList The AllowList enables a precompile to enforce permissions on addresses. The AllowList is not a contract itself, but a helper structure to provide a control mechanism for wrapping contracts. It provides an `AllowListConfig` to the precompile so that it can take an initial configuration from genesis/upgrade. It also provides functions to set/read the permissions. In this tutorial, we used `IAllowList` interface to provide permission control to the `HelloWorld` precompile. `IAllowList` is defined in Subnet-EVM under [`./contracts/contracts/interfaces/IAllowList.sol`](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/contracts/contracts/interfaces/IAllowList.sol). The interface is as follows: ```go //SPDX-License-Identifier: MIT pragma solidity ^0.8.0; interface IAllowList { event RoleSet( uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole ); // Set [addr] to have the admin role over the precompile contract. function setAdmin(address addr) external; // Set [addr] to be enabled on the precompile contract. function setEnabled(address addr) external; // Set [addr] to have the manager role over the precompile contract. function setManager(address addr) external; // Set [addr] to have no role for the precompile contract. function setNone(address addr) external; // Read the status of [addr]. function readAllowList(address addr) external view returns (uint256 role); } ``` You can find more information about the AllowList interface [here](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#allowlist-interface). # Deploying Your Precompile (/docs/avalanche-l1s/custom-precompiles/precompile-deployment) --- title: Deploying Your Precompile description: Now that we have defined our precompile, let's deploy it to a local network. --- We made it! Everything works in our Ginkgo tests, and now we want to spin up a local network with the Hello World precompile activated. Start the server in a terminal in a new tab using avalanche-network-runner. Please check out [this link](/docs/tooling/avalanche-cli) for more information on Avalanche Network Runner, how to download it, and how to use it. The server will be in "listening" mode waiting for API calls. We will start the server from the Subnet-EVM directory so that we can use a relative file path to the genesis JSON file: ```bash cd $GOPATH/src/github.com/ava-labs/subnet-evm ``` ```bash cd $GOPATH/src/github.com/ava-labs/precompile-evm ``` Then run ANR: ```bash avalanche-network-runner server \ --log-level debug \ --port=":8080" \ --grpc-gateway-port=":8081" ``` Since we already compiled AvalancheGo and Subnet-EVM/Precompile-EVM in a previous step, we should have the AvalancheGo and Subnet-EVM binaries ready to go. We can now set the following paths. `AVALANCHEGO_EXEC_PATH` points to the latest AvalancheGo binary we have just built. `AVALANCHEGO_PLUGIN_PATH` points to the plugins path which should have the Subnet-EVM binary we have just built: ```bash export AVALANCHEGO_EXEC_PATH="${GOPATH}/src/github.com/ava-labs/avalanchego/build/avalanchego" export AVALANCHEGO_PLUGIN_PATH="${HOME}/.avalanchego/plugins" ``` The following command will "issue requests" to the server we just spun up. We can use avalanche-network-runner to spin up some nodes that run the latest version of Subnet-EVM: ```bash avalanche-network-runner control start \ --log-level debug \ --endpoint="0.0.0.0:8080" \ --number-of-nodes=5 \ --avalanchego-path ${AVALANCHEGO_EXEC_PATH} \ --plugin-dir ${AVALANCHEGO_PLUGIN_PATH} \ --blockchain-specs '[{"vm_name": "subnetevm", "genesis": "./tests/precompile/genesis/hello_world.json"}]' ``` We can look at the server terminal tab and see it booting up the local network. If the network startup is successful then you should see something like this: ```bash [blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9650/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU" [blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9652/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU" [blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9654/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU" [blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9656/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU" [blockchain RPC for "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy"] "http://127.0.0.1:9658/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU" ``` This shows the extension to the API server on AvalancheGo that's specific to the Subnet-EVM Blockchain instance. To interact with it, you will want to append the `/rpc` extension, which will supply the standard Ethereum API calls. For example, you can use the RPC URL: `http://127.0.0.1:9650/ext/bc/2jDWMrF9yKK8gZfJaaaSfACKeMasiNgHmuZip5mWxUfhKaYoEU/rpc` ## Maintenance You should always keep your fork up to date with the latest changes in the official Subnet-EVM repo. If you have forked the Subnet-EVM repo, there could be conflicts and you may need to manually resolve them. If you used Precompile-EVM, you can update your repo by bumping Subnet-EVM versions in [`go.mod`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/go.mod#L7) and [`version.sh`](https://github.com/ava-labs/precompile-evm/blob/hello-world-example/scripts/versions.sh#L4) ## Conclusion We have now created a stateful precompile from scratch with the precompile generation tool. We hope you had fun and learned a little more about the Subnet-EVM. Now that you have created a simple stateful precompile, we urge you to create one of your own. If you have an idea for a stateful precompile that may be useful to the community, feel free to create a fork of [Subnet-EVM](https://github.com/ava-labs/subnet-evm) and create a pull request. # cli info (/docs/avalanche-l1s/deploy-a-avalanche-l1/cli_structure) --- title: cli info description: cli flags and stuff --- ## avalanche blockchain The blockchain command suite provides a collection of tools for developing and deploying Blockchains. To get started, use the blockchain create command wizard to walk through the configuration of your very first Blockchain. Then, go ahead and deploy it with the blockchain deploy command. You can use the rest of the commands to manage your Blockchain configurations and live deployments. **Usage:** ```bash avalanche blockchain [subcommand] [flags] ``` **Subcommands:** - [`addValidator`](#avalanche-blockchain-addvalidator): The blockchain addValidator command adds a node as a validator to an L1 of the user provided deployed network. If the network is proof of authority, the owner of the validator manager contract must sign the transaction. If the network is proof of stake, the node must stake the L1's staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain. This command currently only works on Blockchains deployed to either the Fuji Testnet or Mainnet. - [`changeOwner`](#avalanche-blockchain-changeowner): The blockchain changeOwner changes the owner of the subnet of the deployed Blockchain. - [`changeWeight`](#avalanche-blockchain-changeweight): The blockchain changeWeight command changes the weight of a Subnet Validator. The Subnet has to be a Proof of Authority Subnet-Only Validator Subnet. - [`configure`](#avalanche-blockchain-configure): AvalancheGo nodes support several different configuration files. Subnets have their own Subnet config which applies to all chains/VMs in the Subnet. Each chain within the Subnet can have its own chain config. A chain can also have special requirements for the AvalancheGo node configuration itself. This command allows you to set all those files. - [`create`](#avalanche-blockchain-create): The blockchain create command builds a new genesis file to configure your Blockchain. By default, the command runs an interactive wizard. It walks you through all the steps you need to create your first Blockchain. The tool supports deploying Subnet-EVM, and custom VMs. You can create a custom, user-generated genesis with a custom VM by providing the path to your genesis and VM binaries with the --genesis and --vm flags. By default, running the command with a blockchainName that already exists causes the command to fail. If you'd like to overwrite an existing configuration, pass the -f flag. - [`delete`](#avalanche-blockchain-delete): The blockchain delete command deletes an existing blockchain configuration. - [`deploy`](#avalanche-blockchain-deploy): The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet. At the end of the call, the command prints the RPC URL you can use to interact with the Subnet. Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call avalanche network clean to reset all deployed chain state. Subsequent local deploys redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks, so you can take your locally tested Subnet and deploy it on Fuji or Mainnet. - [`describe`](#avalanche-blockchain-describe): The blockchain describe command prints the details of a Blockchain configuration to the console. By default, the command prints a summary of the configuration. By providing the --genesis flag, the command instead prints out the raw genesis file. - [`export`](#avalanche-blockchain-export): The blockchain export command write the details of an existing Blockchain deploy to a file. The command prompts for an output path. You can also provide one with the --output flag. - [`import`](#avalanche-blockchain-import): Import blockchain configurations into avalanche-cli. This command suite supports importing from a file created on another computer, or importing from blockchains running public networks (e.g. created manually or with the deprecated subnet-cli) - [`join`](#avalanche-blockchain-join): The subnet join command configures your validator node to begin validating a new Blockchain. To complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can generate or update your node's config file automatically. Alternatively, the command can print the necessary instructions to update your node manually. To complete the validation process, the Subnet's admins must add the NodeID of your validator to the Subnet's allow list by calling addValidator with your NodeID. After you update your validator's config, you need to restart your validator manually. If you provide the --avalanchego-config flag, this command attempts to edit the config file at that path. This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet. - [`list`](#avalanche-blockchain-list): The blockchain list command prints the names of all created Blockchain configurations. Without any flags, it prints some general, static information about the Blockchain. With the --deployed flag, the command shows additional information including the VMID, BlockchainID and SubnetID. - [`publish`](#avalanche-blockchain-publish): The blockchain publish command publishes the Blockchain's VM to a repository. - [`removeValidator`](#avalanche-blockchain-removevalidator): The blockchain removeValidator command stops a whitelisted, subnet network validator from validating your deployed Blockchain. To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass these prompts by providing the values with flags. - [`stats`](#avalanche-blockchain-stats): The blockchain stats command prints validator statistics for the given Blockchain. - [`upgrade`](#avalanche-blockchain-upgrade): The blockchain upgrade command suite provides a collection of tools for updating your developmental and deployed Blockchains. - [`validators`](#avalanche-blockchain-validators): The blockchain validators command lists the validators of a blockchain's subnet and provides several statistics about them. - [`vmid`](#avalanche-blockchain-vmid): The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain. **Flags:** ```bash -h, --help help for blockchain --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### addValidator The blockchain addValidator command adds a node as a validator to an L1 of the user provided deployed network. If the network is proof of authority, the owner of the validator manager contract must sign the transaction. If the network is proof of stake, the node must stake the L1's staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain. This command currently only works on Blockchains deployed to either the Fuji Testnet or Mainnet. **Usage:** ```bash avalanche blockchain addValidator [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Off") --balance uint set the AVAX balance of the validator that will be used for continuous fee on P-Chain --blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's registration (blockchain gas token) --blockchain-key string CLI stored key to use to pay fees for completing the validator's registration (blockchain gas token) --blockchain-private-key string private key to use to pay fees for completing the validator's registration (blockchain gas token) --bls-proof-of-possession string set the BLS proof of possession of the validator to add --bls-public-key string set the BLS public key of the validator to add --cluster string operate on the given cluster --create-local-validator create additional local validator and add it to existing running local node --default-duration (for Subnets, not L1s) set duration so as to validate until primary validator ends its period --default-start-time (for Subnets, not L1s) use default start time for subnet validator (5 minutes later for fuji & mainnet, 30 seconds later for devnet) --default-validator-params (for Subnets, not L1s) use default weight/start/duration params for subnet validator --delegation-fee uint16 (PoS only) delegation fee (in bips) (default 100) --devnet operate on a devnet network --disable-owner string P-Chain address that will able to disable the validator with a P-Chain transaction --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet only] -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for addValidator -k, --key string select the key to use [fuji/devnet only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-endpoint string gather node id/bls from publicly available avalanchego apis on the given endpoint --node-id string node-id of the validator to add --output-tx-path string (for Subnets, not L1s) file path of the add validator tx --partial-sync set primary network partial sync for new validators (default true) --remaining-balance-owner string P-Chain address that will receive any leftover AVAX from the validator when it is removed from Subnet --rpc string connect to validator manager at the given rpc endpoint --stake-amount uint (PoS only) amount of tokens to stake --staking-period duration how long this validator will be staking --start-time string (for Subnets, not L1s) UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format --subnet-auth-keys strings (for Subnets, not L1s) control keys that will be used to authenticate add validator tx -t, --testnet fuji operate on testnet (alias to fuji) --wait-for-tx-acceptance (for Subnets, not L1s) just issue the add validator tx, without waiting for its acceptance (default true) --weight uint set the staking weight of the validator to add (default 20) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### changeOwner The blockchain changeOwner changes the owner of the subnet of the deployed Blockchain. **Usage:** ```bash avalanche blockchain changeOwner [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --control-keys strings addresses that may make subnet changes --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet] -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for changeOwner -k, --key string select the key to use [fuji/devnet] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --output-tx-path string file path of the transfer subnet ownership tx -s, --same-control-key use the fee-paying key as control key --subnet-auth-keys strings control keys that will be used to authenticate transfer subnet ownership tx -t, --testnet fuji operate on testnet (alias to fuji) --threshold uint32 required number of control key signatures to make subnet changes --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### changeWeight The blockchain changeWeight command changes the weight of a Subnet Validator. The Subnet has to be a Proof of Authority Subnet-Only Validator Subnet. **Usage:** ```bash avalanche blockchain changeWeight [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet only] -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for changeWeight -k, --key string select the key to use [fuji/devnet only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-id string node-id of the validator -t, --testnet fuji operate on testnet (alias to fuji) --weight uint set the new staking weight of the validator (default 20) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### configure AvalancheGo nodes support several different configuration files. Subnets have their own Subnet config which applies to all chains/VMs in the Subnet. Each chain within the Subnet can have its own chain config. A chain can also have special requirements for the AvalancheGo node configuration itself. This command allows you to set all those files. **Usage:** ```bash avalanche blockchain configure [subcommand] [flags] ``` **Flags:** ```bash --chain-config string path to the chain configuration -h, --help help for configure --node-config string path to avalanchego node configuration --per-node-chain-config string path to per node chain configuration for local network --subnet-config string path to the subnet configuration --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### create The blockchain create command builds a new genesis file to configure your Blockchain. By default, the command runs an interactive wizard. It walks you through all the steps you need to create your first Blockchain. The tool supports deploying Subnet-EVM, and custom VMs. You can create a custom, user-generated genesis with a custom VM by providing the path to your genesis and VM binaries with the --genesis and --vm flags. By default, running the command with a blockchainName that already exists causes the command to fail. If you'd like to overwrite an existing configuration, pass the -f flag. **Usage:** ```bash avalanche blockchain create [subcommand] [flags] ``` **Flags:** ```bash --custom use a custom VM template --custom-vm-branch string custom vm branch or commit --custom-vm-build-script string custom vm build-script --custom-vm-path string file path of custom vm to use --custom-vm-repo-url string custom vm repository url --debug enable blockchain debugging (default true) --evm use the Subnet-EVM as the base template --evm-chain-id uint chain ID to use with Subnet-EVM --evm-defaults deprecation notice: use '--production-defaults' --evm-token string token symbol to use with Subnet-EVM --external-gas-token use a gas token from another blockchain -f, --force overwrite the existing configuration if one exists --from-github-repo generate custom VM binary from github repository --genesis string file path of genesis to use -h, --help help for create --icm interoperate with other blockchains using ICM --icm-registry-at-genesis setup ICM registry smart contract on genesis [experimental] --latest use latest Subnet-EVM released version, takes precedence over --vm-version --pre-release use latest Subnet-EVM pre-released version, takes precedence over --vm-version --production-defaults use default production settings for your blockchain --proof-of-authority use proof of authority(PoA) for validator management --proof-of-stake use proof of stake(PoS) for validator management --proxy-contract-owner string EVM address that controls ProxyAdmin for TransparentProxy of ValidatorManager contract --reward-basis-points uint (PoS only) reward basis points for PoS Reward Calculator (default 100) --sovereign set to false if creating non-sovereign blockchain (default true) --teleporter interoperate with other blockchains using ICM --test-defaults use default test settings for your blockchain --validator-manager-owner string EVM address that controls Validator Manager Owner --vm string file path of custom vm to use. alias to custom-vm-path --vm-version string version of Subnet-EVM template to use --warp generate a vm with warp support (needed for ICM) (default true) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### delete The blockchain delete command deletes an existing blockchain configuration. **Usage:** ```bash avalanche blockchain delete [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for delete --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet. At the end of the call, the command prints the RPC URL you can use to interact with the Subnet. Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call avalanche network clean to reset all deployed chain state. Subsequent local deploys redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks, so you can take your locally tested Subnet and deploy it on Fuji or Mainnet. **Usage:** ```bash avalanche blockchain deploy [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Off") --avalanchego-path string use this avalanchego binary path --avalanchego-version string use this version of avalanchego (ex: v1.17.12) (default "latest-prerelease") --balance float set the AVAX balance of each bootstrap validator that will be used for continuous fee on P-Chain (default 0.1) --blockchain-genesis-key use genesis allocated key to fund validator manager initialization --blockchain-key string CLI stored key to use to fund validator manager initialization --blockchain-private-key string private key to use to fund validator manager initialization --bootstrap-endpoints strings take validator node info from the given endpoints --bootstrap-filepath string JSON file path that provides details about bootstrap validators, leave Node-ID and BLS values empty if using --generate-node-id=true --cchain-funding-key string key to be used to fund relayer account on cchain --cchain-icm-key string key to be used to pay for ICM deploys on C-Chain --change-owner-address string address that will receive change if node is no longer L1 validator --cluster string operate on the given cluster --control-keys strings addresses that may make subnet changes --convert-only avoid node track, restart and poa manager setup --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet deploy only] -f, --fuji testnet operate on fuji (alias to testnet --generate-node-id whether to create new node id for bootstrap validators (Node-ID and BLS values in bootstrap JSON file will be overridden if --bootstrap-filepath flag is used) -h, --help help for deploy --icm-key string key to be used to pay for ICM deploys (default "cli-teleporter-deployer") --icm-version string ICM version to deploy (default "latest") -k, --key string select the key to use [fuji/devnet deploy only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --mainnet-chain-id uint32 use different ChainID for mainnet deployment --noicm skip automatic ICM deploy --num-bootstrap-validators int (only if --generate-node-id is true) number of bootstrap validators to set up in sovereign L1 validator) --num-local-nodes int number of nodes to be created on local machine --num-nodes uint32 number of nodes to be created on local network deploy (default 2) --output-tx-path string file path of the blockchain creation tx --partial-sync set primary network partial sync for new validators (default true) --pos-maximum-stake-amount uint maximum stake amount (default 1000) --pos-maximum-stake-multiplier uint8 maximum stake multiplier (default 1) --pos-minimum-delegation-fee uint16 minimum delegation fee (default 1) --pos-minimum-stake-amount uint minimum stake amount (default 1) --pos-minimum-stake-duration uint minimum stake duration (default 100) --pos-weight-to-value-factor uint weight to value factor (default 1) --relay-cchain relay C-Chain as source and destination (default true) --relayer-allow-private-ips allow relayer to connec to private ips (default true) --relayer-amount float automatically fund relayer fee payments with the given amount --relayer-key string key to be used by default both for rewards and to pay fees --relayer-log-level string log level to be used for relayer logs (default "info") --relayer-path string relayer binary to use --relayer-version string relayer version to deploy (default "latest-prerelease") -s, --same-control-key use the fee-paying key as control key --skip-icm-deploy skip automatic ICM deploy --skip-local-teleporter skip automatic ICM deploy on local networks [to be deprecated] --skip-relayer skip relayer deploy --skip-teleporter-deploy skip automatic ICM deploy --subnet-auth-keys strings control keys that will be used to authenticate chain creation -u, --subnet-id string do not create a subnet, deploy the blockchain into the given subnet id --subnet-only only create a subnet --teleporter-messenger-contract-address-path string path to an ICM Messenger contract address file --teleporter-messenger-deployer-address-path string path to an ICM Messenger deployer address file --teleporter-messenger-deployer-tx-path string path to an ICM Messenger deployer tx file --teleporter-registry-bytecode-path string path to an ICM Registry bytecode file --teleporter-version string ICM version to deploy (default "latest") -t, --testnet fuji operate on testnet (alias to fuji) --threshold uint32 required number of control key signatures to make subnet changes --use-local-machine use local machine as a blockchain validator --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### describe The blockchain describe command prints the details of a Blockchain configuration to the console. By default, the command prints a summary of the configuration. By providing the --genesis flag, the command instead prints out the raw genesis file. **Usage:** ```bash avalanche blockchain describe [subcommand] [flags] ``` **Flags:** ```bash -g, --genesis Print the genesis to the console directly instead of the summary -h, --help help for describe --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### export The blockchain export command write the details of an existing Blockchain deploy to a file. The command prompts for an output path. You can also provide one with the --output flag. **Usage:** ```bash avalanche blockchain export [subcommand] [flags] ``` **Flags:** ```bash --custom-vm-branch string custom vm branch --custom-vm-build-script string custom vm build-script --custom-vm-repo-url string custom vm repository url -h, --help help for export -o, --output string write the export data to the provided file path --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### import Import blockchain configurations into avalanche-cli. This command suite supports importing from a file created on another computer, or importing from blockchains running public networks (e.g. created manually or with the deprecated subnet-cli) **Usage:** ```bash avalanche blockchain import [subcommand] [flags] ``` **Subcommands:** - [`file`](#avalanche-blockchain-import-file): The blockchain import command will import a blockchain configuration from a file or a git repository. To import from a file, you can optionally provide the path as a command-line argument. Alternatively, running the command without any arguments triggers an interactive wizard. To import from a repository, go through the wizard. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. - [`public`](#avalanche-blockchain-import-public): The blockchain import public command imports a Blockchain configuration from a running network. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. **Flags:** ```bash -h, --help help for import --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### import file The blockchain import command will import a blockchain configuration from a file or a git repository. To import from a file, you can optionally provide the path as a command-line argument. Alternatively, running the command without any arguments triggers an interactive wizard. To import from a repository, go through the wizard. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. **Usage:** ```bash avalanche blockchain import file [subcommand] [flags] ``` **Flags:** ```bash --branch string the repo branch to use if downloading a new repo -f, --force overwrite the existing configuration if one exists -h, --help help for file --repo string the repo to import (ex: ava-labs/avalanche-plugins-core) or url to download the repo from --subnet string the subnet configuration to import from the provided repo --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### import public The blockchain import public command imports a Blockchain configuration from a running network. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. **Usage:** ```bash avalanche blockchain import public [subcommand] [flags] ``` **Flags:** ```bash --blockchain-id string the blockchain ID --cluster string operate on the given cluster --custom use a custom VM template --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --evm import a subnet-evm --force overwrite the existing configuration if one exists -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for public -l, --local operate on a local network -m, --mainnet operate on mainnet --node-url string [optional] URL of an already running subnet validator -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### join The subnet join command configures your validator node to begin validating a new Blockchain. To complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can generate or update your node's config file automatically. Alternatively, the command can print the necessary instructions to update your node manually. To complete the validation process, the Subnet's admins must add the NodeID of your validator to the Subnet's allow list by calling addValidator with your NodeID. After you update your validator's config, you need to restart your validator manually. If you provide the --avalanchego-config flag, this command attempts to edit the config file at that path. This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet. **Usage:** ```bash avalanche blockchain join [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-config string file path of the avalanchego config file --cluster string operate on the given cluster --data-dir string path of avalanchego's data dir directory --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force-write if true, skip to prompt to overwrite the config file -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for join -k, --key string select the key to use [fuji only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-id string set the NodeID of the validator to check --plugin-dir string file path of avalanchego's plugin directory --print if true, print the manual config without prompting --stake-amount uint amount of tokens to stake on validator --staking-period duration how long validator validates for after start time --start-time string start time that validator starts validating -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### list The blockchain list command prints the names of all created Blockchain configurations. Without any flags, it prints some general, static information about the Blockchain. With the --deployed flag, the command shows additional information including the VMID, BlockchainID and SubnetID. **Usage:** ```bash avalanche blockchain list [subcommand] [flags] ``` **Flags:** ```bash --deployed show additional deploy information -h, --help help for list --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### publish The blockchain publish command publishes the Blockchain's VM to a repository. **Usage:** ```bash avalanche blockchain publish [subcommand] [flags] ``` **Flags:** ```bash --alias string We publish to a remote repo, but identify the repo locally under a user-provided alias (e.g. myrepo). --force If true, ignores if the subnet has been published in the past, and attempts a forced publish. -h, --help help for publish --no-repo-path string Do not let the tool manage file publishing, but have it only generate the files and put them in the location given by this flag. --repo-url string The URL of the repo where we are publishing --subnet-file-path string Path to the Subnet description file. If not given, a prompting sequence will be initiated. --vm-file-path string Path to the VM description file. If not given, a prompting sequence will be initiated. --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### removeValidator The blockchain removeValidator command stops a whitelisted, subnet network validator from validating your deployed Blockchain. To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass these prompts by providing the values with flags. **Usage:** ```bash avalanche blockchain removeValidator [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Off") --blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's removal (blockchain gas token) --blockchain-key string CLI stored key to use to pay fees for completing the validator's removal (blockchain gas token) --blockchain-private-key string private key to use to pay fees for completing the validator's removal (blockchain gas token) --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force force validator removal even if it's not getting rewarded -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for removeValidator -k, --key string select the key to use [fuji deploy only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-endpoint string remove validator that responds to the given endpoint --node-id string node-id of the validator --output-tx-path string (for non-SOV blockchain only) file path of the removeValidator tx --rpc string connect to validator manager at the given rpc endpoint --subnet-auth-keys strings (for non-SOV blockchain only) control keys that will be used to authenticate the removeValidator tx -t, --testnet fuji operate on testnet (alias to fuji) --uptime uint validator's uptime in seconds. If not provided, it will be automatically calculated --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### stats The blockchain stats command prints validator statistics for the given Blockchain. **Usage:** ```bash avalanche blockchain stats [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for stats -l, --local operate on a local network -m, --mainnet operate on mainnet -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### upgrade The blockchain upgrade command suite provides a collection of tools for updating your developmental and deployed Blockchains. **Usage:** ```bash avalanche blockchain upgrade [subcommand] [flags] ``` **Subcommands:** - [`apply`](#avalanche-blockchain-upgrade-apply): Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade. For public networks (Fuji Testnet or Mainnet), to complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can manipulate your node's configuration automatically. Alternatively, the command can print the necessary instructions to upgrade your node manually. After you update your validator's configuration, you need to restart your validator manually. If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path. Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation. - [`export`](#avalanche-blockchain-upgrade-export): Export the upgrade bytes file to a location of choice on disk - [`generate`](#avalanche-blockchain-upgrade-generate): The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It guides the user through the process using an interactive wizard. - [`import`](#avalanche-blockchain-upgrade-import): Import the upgrade bytes file into the local environment - [`print`](#avalanche-blockchain-upgrade-print): Print the upgrade.json file content - [`vm`](#avalanche-blockchain-upgrade-vm): The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet. The command walks the user through an interactive wizard. The user can skip the wizard by providing command line flags. **Flags:** ```bash -h, --help help for upgrade --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade apply Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade. For public networks (Fuji Testnet or Mainnet), to complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can manipulate your node's configuration automatically. Alternatively, the command can print the necessary instructions to upgrade your node manually. After you update your validator's configuration, you need to restart your validator manually. If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path. Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation. **Usage:** ```bash avalanche blockchain upgrade apply [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-chain-config-dir string avalanchego's chain config file directory (default "/Users/owen.wahlgren/.avalanchego/chains") --config create upgrade config for future subnet deployments (same as generate) --force If true, don't prompt for confirmation of timestamps in the past --fuji fuji apply upgrade existing fuji deployment (alias for `testnet`) -h, --help help for apply --local local apply upgrade existing local deployment --mainnet mainnet apply upgrade existing mainnet deployment --print if true, print the manual config without prompting (for public networks only) --testnet testnet apply upgrade existing testnet deployment (alias for `fuji`) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade export Export the upgrade bytes file to a location of choice on disk **Usage:** ```bash avalanche blockchain upgrade export [subcommand] [flags] ``` **Flags:** ```bash --force If true, overwrite a possibly existing file without prompting -h, --help help for export --upgrade-filepath string Export upgrade bytes file to location of choice on disk --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade generate The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It guides the user through the process using an interactive wizard. **Usage:** ```bash avalanche blockchain upgrade generate [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for generate --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade import Import the upgrade bytes file into the local environment **Usage:** ```bash avalanche blockchain upgrade import [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for import --upgrade-filepath string Import upgrade bytes file into local environment --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade print Print the upgrade.json file content **Usage:** ```bash avalanche blockchain upgrade print [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for print --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade vm The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet. The command walks the user through an interactive wizard. The user can skip the wizard by providing command line flags. **Usage:** ```bash avalanche blockchain upgrade vm [subcommand] [flags] ``` **Flags:** ```bash --binary string Upgrade to custom binary --config upgrade config for future subnet deployments --fuji fuji upgrade existing fuji deployment (alias for `testnet`) -h, --help help for vm --latest upgrade to latest version --local local upgrade existing local deployment --mainnet mainnet upgrade existing mainnet deployment --plugin-dir string plugin directory to automatically upgrade VM --print print instructions for upgrading --testnet testnet upgrade existing testnet deployment (alias for `fuji`) --version string Upgrade to custom version --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### validators The blockchain validators command lists the validators of a blockchain's subnet and provides several statistics about them. **Usage:** ```bash avalanche blockchain validators [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for validators -l, --local operate on a local network -m, --mainnet operate on mainnet -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### vmid The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain. **Usage:** ```bash avalanche blockchain vmid [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for vmid --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche config Customize configuration for Avalanche-CLI **Usage:** ```bash avalanche config [subcommand] [flags] ``` **Subcommands:** - [`authorize-cloud-access`](#avalanche-config-authorize-cloud-access): set preferences to authorize access to cloud resources - [`metrics`](#avalanche-config-metrics): set user metrics collection preferences - [`migrate`](#avalanche-config-migrate): migrate command migrates old ~/.avalanche-cli.json and ~/.avalanche-cli/config to /.avalanche-cli/config.json.. - [`snapshotsAutoSave`](#avalanche-config-snapshotsautosave): set user preference between auto saving local network snapshots or not - [`update`](#avalanche-config-update): set user preference between update check or not **Flags:** ```bash -h, --help help for config --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### authorize-cloud-access set preferences to authorize access to cloud resources **Usage:** ```bash avalanche config authorize-cloud-access [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for authorize-cloud-access --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### metrics set user metrics collection preferences **Usage:** ```bash avalanche config metrics [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for metrics --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### migrate migrate command migrates old ~/.avalanche-cli.json and ~/.avalanche-cli/config to /.avalanche-cli/config.json.. **Usage:** ```bash avalanche config migrate [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for migrate --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### snapshotsAutoSave set user preference between auto saving local network snapshots or not **Usage:** ```bash avalanche config snapshotsAutoSave [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for snapshotsAutoSave --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### update set user preference between update check or not **Usage:** ```bash avalanche config update [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for update --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche contract The contract command suite provides a collection of tools for deploying and interacting with smart contracts. **Usage:** ```bash avalanche contract [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-contract-deploy): The contract command suite provides a collection of tools for deploying smart contracts. - [`initValidatorManager`](#avalanche-contract-initvalidatormanager): Initializes Proof of Authority(PoA) or Proof of Stake(PoS)Validator Manager contract on a Blockchain and sets up initial validator set on the Blockchain. For more info on Validator Manager, please head to https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager **Flags:** ```bash -h, --help help for contract --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy The contract command suite provides a collection of tools for deploying smart contracts. **Usage:** ```bash avalanche contract deploy [subcommand] [flags] ``` **Subcommands:** - [`erc20`](#avalanche-contract-deploy-erc20): Deploy an ERC20 token into a given Network and Blockchain **Flags:** ```bash -h, --help help for deploy --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### deploy erc20 Deploy an ERC20 token into a given Network and Blockchain **Usage:** ```bash avalanche contract deploy erc20 [subcommand] [flags] ``` **Flags:** ```bash --blockchain string deploy the ERC20 contract into the given CLI blockchain --blockchain-id string deploy the ERC20 contract into the given blockchain ID/Alias --c-chain deploy the ERC20 contract into C-Chain --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --funded string set the funded address --genesis-key use genesis allocated key as contract deployer -h, --help help for erc20 --key string CLI stored key to use as contract deployer -l, --local operate on a local network --private-key string private key to use as contract deployer --rpc string deploy the contract into the given rpc endpoint --supply uint set the token supply --symbol string set the token symbol -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### initValidatorManager Initializes Proof of Authority(PoA) or Proof of Stake(PoS)Validator Manager contract on a Blockchain and sets up initial validator set on the Blockchain. For more info on Validator Manager, please head to https://github.com/ava-labs/icm-contracts/tree/main/contracts/validator-manager **Usage:** ```bash avalanche contract initValidatorManager [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Off") --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key as contract deployer -h, --help help for initValidatorManager --key string CLI stored key to use as contract deployer -l, --local operate on a local network -m, --mainnet operate on mainnet --pos-maximum-stake-amount uint (PoS only) maximum stake amount (default 1000) --pos-maximum-stake-multiplier uint8 (PoS only )maximum stake multiplier (default 1) --pos-minimum-delegation-fee uint16 (PoS only) minimum delegation fee (default 1) --pos-minimum-stake-amount uint (PoS only) minimum stake amount (default 1) --pos-minimum-stake-duration uint (PoS only) minimum stake duration (default 100) --pos-reward-calculator-address string (PoS only) initialize the ValidatorManager with reward calculator address --pos-weight-to-value-factor uint (PoS only) weight to value factor (default 1) --private-key string private key to use as contract deployer --rpc string deploy the contract into the given rpc endpoint -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche help Help provides help for any command in the application. Simply type avalanche help [path to command] for full details. **Usage:** ```bash avalanche help [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for help --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche icm The messenger command suite provides a collection of tools for interacting with ICM messenger contracts. **Usage:** ```bash avalanche icm [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-icm-deploy): Deploys ICM Messenger and Registry into a given L1. - [`sendMsg`](#avalanche-icm-sendmsg): Sends and wait reception for a ICM msg between two subnets. **Flags:** ```bash -h, --help help for icm --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy Deploys ICM Messenger and Registry into a given L1. **Usage:** ```bash avalanche icm deploy [subcommand] [flags] ``` **Flags:** ```bash --blockchain string deploy ICM into the given CLI blockchain --blockchain-id string deploy ICM into the given blockchain ID/Alias --c-chain deploy ICM into C-Chain --cchain-key string key to be used to pay fees to deploy ICM to C-Chain --cluster string operate on the given cluster --deploy-messenger deploy ICM Messenger (default true) --deploy-registry deploy ICM Registry (default true) --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force-registry-deploy deploy ICM Registry even if Messenger has already been deployed -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key to fund ICM deploy -h, --help help for deploy --include-cchain deploy ICM also to C-Chain --key string CLI stored key to use to fund ICM deploy -l, --local operate on a local network --messenger-contract-address-path string path to a messenger contract address file --messenger-deployer-address-path string path to a messenger deployer address file --messenger-deployer-tx-path string path to a messenger deployer tx file --private-key string private key to use to fund ICM deploy --registry-bytecode-path string path to a registry bytecode file --rpc-url string use the given RPC URL to connect to the subnet -t, --testnet fuji operate on testnet (alias to fuji) --version string version to deploy (default "latest") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### sendMsg Sends and wait reception for a ICM msg between two subnets. **Usage:** ```bash avalanche icm sendMsg [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --dest-rpc string use the given destination blockchain rpc endpoint --destination-address string deliver the message to the given contract destination address --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key as message originator and to pay source blockchain fees -h, --help help for sendMsg --hex-encoded given message is hex encoded --key string CLI stored key to use as message originator and to pay source blockchain fees -l, --local operate on a local network --private-key string private key to use as message originator and to pay source blockchain fees --source-rpc string use the given source blockchain rpc endpoint -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche ictt The ictt command suite provides tools to deploy and manage Interchain Token Transferrers. **Usage:** ```bash avalanche ictt [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-ictt-deploy): Deploys a Token Transferrer into a given Network and Subnets **Flags:** ```bash -h, --help help for ictt --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy Deploys a Token Transferrer into a given Network and Subnets **Usage:** ```bash avalanche ictt deploy [subcommand] [flags] ``` **Flags:** ```bash --c-chain-home set the Transferrer's Home Chain into C-Chain --c-chain-remote set the Transferrer's Remote Chain into C-Chain --cluster string operate on the given cluster --deploy-erc20-home string deploy a Transferrer Home for the given Chain's ERC20 Token --deploy-native-home deploy a Transferrer Home for the Chain's Native Token --deploy-native-remote deploy a Transferrer Remote for the Chain's Native Token --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for deploy --home-blockchain string set the Transferrer's Home Chain into the given CLI blockchain --home-genesis-key use genesis allocated key to deploy Transferrer Home --home-key string CLI stored key to use to deploy Transferrer Home --home-private-key string private key to use to deploy Transferrer Home --home-rpc string use the given RPC URL to connect to the home blockchain -l, --local operate on a local network --remote-blockchain string set the Transferrer's Remote Chain into the given CLI blockchain --remote-genesis-key use genesis allocated key to deploy Transferrer Remote --remote-key string CLI stored key to use to deploy Transferrer Remote --remote-private-key string private key to use to deploy Transferrer Remote --remote-rpc string use the given RPC URL to connect to the remote blockchain --remote-token-decimals uint8 use the given number of token decimals for the Transferrer Remote [defaults to token home's decimals (18 for a new wrapped native home token)] --remove-minter-admin remove the native minter precompile admin found on remote blockchain genesis -t, --testnet fuji operate on testnet (alias to fuji) --use-home string use the given Transferrer's Home Address --version string tag/branch/commit of Avalanche Interchain Token Transfer (ICTT) to be used (defaults to main branch) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche interchain The interchain command suite provides a collection of tools to set and manage interoperability between blockchains. **Usage:** ```bash avalanche interchain [subcommand] [flags] ``` **Subcommands:** - [`messenger`](#avalanche-interchain-messenger): The messenger command suite provides a collection of tools for interacting with ICM messenger contracts. - [`relayer`](#avalanche-interchain-relayer): The relayer command suite provides a collection of tools for deploying and configuring an ICM relayers. - [`tokenTransferrer`](#avalanche-interchain-tokentransferrer): The tokenTransfer command suite provides tools to deploy and manage Token Transferrers. **Flags:** ```bash -h, --help help for interchain --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### messenger The messenger command suite provides a collection of tools for interacting with ICM messenger contracts. **Usage:** ```bash avalanche interchain messenger [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-interchain-messenger-deploy): Deploys ICM Messenger and Registry into a given L1. - [`sendMsg`](#avalanche-interchain-messenger-sendmsg): Sends and wait reception for a ICM msg between two subnets. **Flags:** ```bash -h, --help help for messenger --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### messenger deploy Deploys ICM Messenger and Registry into a given L1. **Usage:** ```bash avalanche interchain messenger deploy [subcommand] [flags] ``` **Flags:** ```bash --blockchain string deploy ICM into the given CLI blockchain --blockchain-id string deploy ICM into the given blockchain ID/Alias --c-chain deploy ICM into C-Chain --cchain-key string key to be used to pay fees to deploy ICM to C-Chain --cluster string operate on the given cluster --deploy-messenger deploy ICM Messenger (default true) --deploy-registry deploy ICM Registry (default true) --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force-registry-deploy deploy ICM Registry even if Messenger has already been deployed -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key to fund ICM deploy -h, --help help for deploy --include-cchain deploy ICM also to C-Chain --key string CLI stored key to use to fund ICM deploy -l, --local operate on a local network --messenger-contract-address-path string path to a messenger contract address file --messenger-deployer-address-path string path to a messenger deployer address file --messenger-deployer-tx-path string path to a messenger deployer tx file --private-key string private key to use to fund ICM deploy --registry-bytecode-path string path to a registry bytecode file --rpc-url string use the given RPC URL to connect to the subnet -t, --testnet fuji operate on testnet (alias to fuji) --version string version to deploy (default "latest") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### messenger sendMsg Sends and wait reception for a ICM msg between two subnets. **Usage:** ```bash avalanche interchain messenger sendMsg [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --dest-rpc string use the given destination blockchain rpc endpoint --destination-address string deliver the message to the given contract destination address --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key as message originator and to pay source blockchain fees -h, --help help for sendMsg --hex-encoded given message is hex encoded --key string CLI stored key to use as message originator and to pay source blockchain fees -l, --local operate on a local network --private-key string private key to use as message originator and to pay source blockchain fees --source-rpc string use the given source blockchain rpc endpoint -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### relayer The relayer command suite provides a collection of tools for deploying and configuring an ICM relayers. **Usage:** ```bash avalanche interchain relayer [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-interchain-relayer-deploy): Deploys an ICM Relayer for the given Network. - [`logs`](#avalanche-interchain-relayer-logs): Shows pretty formatted AWM relayer logs - [`start`](#avalanche-interchain-relayer-start): Starts AWM relayer on the specified network (Currently only for local network). - [`stop`](#avalanche-interchain-relayer-stop): Stops AWM relayer on the specified network (Currently only for local network, cluster). **Flags:** ```bash -h, --help help for relayer --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### relayer deploy Deploys an ICM Relayer for the given Network. **Usage:** ```bash avalanche interchain relayer deploy [subcommand] [flags] ``` **Flags:** ```bash --allow-private-ips allow relayer to connec to private ips (default true) --amount float automatically fund l1s fee payments with the given amount --bin-path string use the given relayer binary --blockchain-funding-key string key to be used to fund relayer account on all l1s --blockchains strings blockchains to relay as source and destination --cchain relay C-Chain as source and destination --cchain-amount float automatically fund cchain fee payments with the given amount --cchain-funding-key string key to be used to fund relayer account on cchain --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for deploy --key string key to be used by default both for rewards and to pay fees -l, --local operate on a local network --log-level string log level to use for relayer logs -t, --testnet fuji operate on testnet (alias to fuji) --version string version to deploy (default "latest-prerelease") --config string config file (default is $HOME/.avalanche-cli/config.json) --skip-update-check skip check for new versions ``` #### relayer logs Shows pretty formatted AWM relayer logs **Usage:** ```bash avalanche interchain relayer logs [subcommand] [flags] ``` **Flags:** ```bash --endpoint string use the given endpoint for network operations --first uint output first N log lines -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for logs --last uint output last N log lines -l, --local operate on a local network --raw raw logs output -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### relayer start Starts AWM relayer on the specified network (Currently only for local network). **Usage:** ```bash avalanche interchain relayer start [subcommand] [flags] ``` **Flags:** ```bash --bin-path string use the given relayer binary --cluster string operate on the given cluster --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for start -l, --local operate on a local network -t, --testnet fuji operate on testnet (alias to fuji) --version string version to use (default "latest-prerelease") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### relayer stop Stops AWM relayer on the specified network (Currently only for local network, cluster). **Usage:** ```bash avalanche interchain relayer stop [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for stop -l, --local operate on a local network -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### tokenTransferrer The tokenTransfer command suite provides tools to deploy and manage Token Transferrers. **Usage:** ```bash avalanche interchain tokenTransferrer [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-interchain-tokentransferrer-deploy): Deploys a Token Transferrer into a given Network and Subnets **Flags:** ```bash -h, --help help for tokenTransferrer --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### tokenTransferrer deploy Deploys a Token Transferrer into a given Network and Subnets **Usage:** ```bash avalanche interchain tokenTransferrer deploy [subcommand] [flags] ``` **Flags:** ```bash --c-chain-home set the Transferrer's Home Chain into C-Chain --c-chain-remote set the Transferrer's Remote Chain into C-Chain --cluster string operate on the given cluster --deploy-erc20-home string deploy a Transferrer Home for the given Chain's ERC20 Token --deploy-native-home deploy a Transferrer Home for the Chain's Native Token --deploy-native-remote deploy a Transferrer Remote for the Chain's Native Token --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for deploy --home-blockchain string set the Transferrer's Home Chain into the given CLI blockchain --home-genesis-key use genesis allocated key to deploy Transferrer Home --home-key string CLI stored key to use to deploy Transferrer Home --home-private-key string private key to use to deploy Transferrer Home --home-rpc string use the given RPC URL to connect to the home blockchain -l, --local operate on a local network --remote-blockchain string set the Transferrer's Remote Chain into the given CLI blockchain --remote-genesis-key use genesis allocated key to deploy Transferrer Remote --remote-key string CLI stored key to use to deploy Transferrer Remote --remote-private-key string private key to use to deploy Transferrer Remote --remote-rpc string use the given RPC URL to connect to the remote blockchain --remote-token-decimals uint8 use the given number of token decimals for the Transferrer Remote [defaults to token home's decimals (18 for a new wrapped native home token)] --remove-minter-admin remove the native minter precompile admin found on remote blockchain genesis -t, --testnet fuji operate on testnet (alias to fuji) --use-home string use the given Transferrer's Home Address --version string tag/branch/commit of Avalanche Interchain Token Transfer (ICTT) to be used (defaults to main branch) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche key The key command suite provides a collection of tools for creating and managing signing keys. You can use these keys to deploy Subnets to the Fuji Testnet, but these keys are NOT suitable to use in production environments. DO NOT use these keys on Mainnet. To get started, use the key create command. **Usage:** ```bash avalanche key [subcommand] [flags] ``` **Subcommands:** - [`create`](#avalanche-key-create): The key create command generates a new private key to use for creating and controlling test Subnets. Keys generated by this command are NOT cryptographically secure enough to use in production environments. DO NOT use these keys on Mainnet. The command works by generating a secp256 key and storing it with the provided keyName. You can use this key in other commands by providing this keyName. If you'd like to import an existing key instead of generating one from scratch, provide the --file flag. - [`delete`](#avalanche-key-delete): The key delete command deletes an existing signing key. To delete a key, provide the keyName. The command prompts for confirmation before deleting the key. To skip the confirmation, provide the --force flag. - [`export`](#avalanche-key-export): The key export command exports a created signing key. You can use an exported key in other applications or import it into another instance of Avalanche-CLI. By default, the tool writes the hex encoded key to stdout. If you provide the --output flag, the command writes the key to a file of your choosing. - [`list`](#avalanche-key-list): The key list command prints information for all stored signing keys or for the ledger addresses associated to certain indices. - [`transfer`](#avalanche-key-transfer): The key transfer command allows to transfer funds between stored keys or ledger addresses. **Flags:** ```bash -h, --help help for key --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### create The key create command generates a new private key to use for creating and controlling test Subnets. Keys generated by this command are NOT cryptographically secure enough to use in production environments. DO NOT use these keys on Mainnet. The command works by generating a secp256 key and storing it with the provided keyName. You can use this key in other commands by providing this keyName. If you'd like to import an existing key instead of generating one from scratch, provide the --file flag. **Usage:** ```bash avalanche key create [subcommand] [flags] ``` **Flags:** ```bash --file string import the key from an existing key file -f, --force overwrite an existing key with the same name -h, --help help for create --skip-balances do not query public network balances for an imported key --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### delete The key delete command deletes an existing signing key. To delete a key, provide the keyName. The command prompts for confirmation before deleting the key. To skip the confirmation, provide the --force flag. **Usage:** ```bash avalanche key delete [subcommand] [flags] ``` **Flags:** ```bash -f, --force delete the key without confirmation -h, --help help for delete --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### export The key export command exports a created signing key. You can use an exported key in other applications or import it into another instance of Avalanche-CLI. By default, the tool writes the hex encoded key to stdout. If you provide the --output flag, the command writes the key to a file of your choosing. **Usage:** ```bash avalanche key export [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for export -o, --output string write the key to the provided file path --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### list The key list command prints information for all stored signing keys or for the ledger addresses associated to certain indices. **Usage:** ```bash avalanche key list [subcommand] [flags] ``` **Flags:** ```bash -a, --all-networks list all network addresses --blockchains strings blockchains to show information about (p=p-chain, x=x-chain, c=c-chain, and blockchain names) (default p,x,c) -c, --cchain list C-Chain addresses (default true) --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for list --keys strings list addresses for the given keys -g, --ledger uints list ledger addresses for the given indices (default []) -l, --local operate on a local network -m, --mainnet operate on mainnet --pchain list P-Chain addresses (default true) --subnets strings subnets to show information about (p=p-chain, x=x-chain, c=c-chain, and subnet names) (default p,x,c) -t, --testnet fuji operate on testnet (alias to fuji) --tokens strings provide balance information for the given token contract addresses (Evm only) (default [Native]) --use-gwei use gwei for EVM balances -n, --use-nano-avax use nano Avax for balances --xchain list X-Chain addresses (default true) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### transfer The key transfer command allows to transfer funds between stored keys or ledger addresses. **Usage:** ```bash avalanche key transfer [subcommand] [flags] ``` **Flags:** ```bash -o, --amount float amount to send or receive (AVAX or TOKEN units) --c-chain-receiver receive at C-Chain --c-chain-sender send from C-Chain --cluster string operate on the given cluster -a, --destination-addr string destination address --destination-key string key associated to a destination address --destination-subnet string subnet where the funds will be sent (token transferrer experimental) --destination-transferrer-address string token transferrer address at the destination subnet (token transferrer experimental) --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for transfer -k, --key string key associated to the sender or receiver address -i, --ledger uint32 ledger index associated to the sender or receiver address (default 32768) -l, --local operate on a local network -m, --mainnet operate on mainnet --origin-subnet string subnet where the funds belong (token transferrer experimental) --origin-transferrer-address string token transferrer address at the origin subnet (token transferrer experimental) --p-chain-receiver receive at P-Chain --p-chain-sender send from P-Chain --receiver-blockchain string receive at the given CLI blockchain --receiver-blockchain-id string receive at the given blockchain ID/Alias --sender-blockchain string send from the given CLI blockchain --sender-blockchain-id string send from the given blockchain ID/Alias -t, --testnet fuji operate on testnet (alias to fuji) --x-chain-receiver receive at X-Chain --x-chain-sender send from X-Chain --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche network The network command suite provides a collection of tools for managing local Subnet deployments. When you deploy a Subnet locally, it runs on a local, multi-node Avalanche network. The subnet deploy command starts this network in the background. This command suite allows you to shutdown, restart, and clear that network. This network currently supports multiple, concurrently deployed Subnets. **Usage:** ```bash avalanche network [subcommand] [flags] ``` **Subcommands:** - [`clean`](#avalanche-network-clean): The network clean command shuts down your local, multi-node network. All deployed Subnets shutdown and delete their state. You can restart the network by deploying a new Subnet configuration. - [`start`](#avalanche-network-start): The network start command starts a local, multi-node Avalanche network on your machine. By default, the command loads the default snapshot. If you provide the --snapshot-name flag, the network loads that snapshot instead. The command fails if the local network is already running. - [`status`](#avalanche-network-status): The network status command prints whether or not a local Avalanche network is running and some basic stats about the network. - [`stop`](#avalanche-network-stop): The network stop command shuts down your local, multi-node network. All deployed Subnets shutdown gracefully and save their state. If you provide the --snapshot-name flag, the network saves its state under this named snapshot. You can reload this snapshot with network start --snapshot-name `snapshotName`. Otherwise, the network saves to the default snapshot, overwriting any existing state. You can reload the default snapshot with network start. **Flags:** ```bash -h, --help help for network --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### clean The network clean command shuts down your local, multi-node network. All deployed Subnets shutdown and delete their state. You can restart the network by deploying a new Subnet configuration. **Usage:** ```bash avalanche network clean [subcommand] [flags] ``` **Flags:** ```bash --hard Also clean downloaded avalanchego and plugin binaries -h, --help help for clean --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### start The network start command starts a local, multi-node Avalanche network on your machine. By default, the command loads the default snapshot. If you provide the --snapshot-name flag, the network loads that snapshot instead. The command fails if the local network is already running. **Usage:** ```bash avalanche network start [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-path string use this avalanchego binary path --avalanchego-version string use this version of avalanchego (ex: v1.17.12) (default "latest-prerelease") -h, --help help for start --num-nodes uint32 number of nodes to be created on local network (default 2) --relayer-path string use this relayer binary path --relayer-version string use this relayer version (default "latest-prerelease") --snapshot-name string name of snapshot to use to start the network from (default "default-1654102509") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### status The network status command prints whether or not a local Avalanche network is running and some basic stats about the network. **Usage:** ```bash avalanche network status [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for status --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### stop The network stop command shuts down your local, multi-node network. All deployed Subnets shutdown gracefully and save their state. If you provide the --snapshot-name flag, the network saves its state under this named snapshot. You can reload this snapshot with network start --snapshot-name `snapshotName`. Otherwise, the network saves to the default snapshot, overwriting any existing state. You can reload the default snapshot with network start. **Usage:** ```bash avalanche network stop [subcommand] [flags] ``` **Flags:** ```bash --dont-save do not save snapshot, just stop the network -h, --help help for stop --snapshot-name string name of snapshot to use to save network state into (default "default-1654102509") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche node The node command suite provides a collection of tools for creating and maintaining validators on Avalanche Network. To get started, use the node create command wizard to walk through the configuration to make your node a primary validator on Avalanche public network. You can use the rest of the commands to maintain your node and make your node a Subnet Validator. **Usage:** ```bash avalanche node [subcommand] [flags] ``` **Subcommands:** - [`addDashboard`](#avalanche-node-adddashboard): (ALPHA Warning) This command is currently in experimental mode. The node addDashboard command adds custom dashboard to the Grafana monitoring dashboard for the cluster. - [`create`](#avalanche-node-create): (ALPHA Warning) This command is currently in experimental mode. The node create command sets up a validator on a cloud server of your choice. The validator will be validating the Avalanche Primary Network and Subnet of your choice. By default, the command runs an interactive wizard. It walks you through all the steps you need to set up a validator. Once this command is completed, you will have to wait for the validator to finish bootstrapping on the primary network before running further commands on it, e.g. validating a Subnet. You can check the bootstrapping status by running avalanche node status The created node will be part of group of validators called `clusterName` and users can call node commands with `clusterName` so that the command will apply to all nodes in the cluster - [`destroy`](#avalanche-node-destroy): (ALPHA Warning) This command is currently in experimental mode. The node destroy command terminates all running nodes in cloud server and deletes all storage disks. If there is a static IP address attached, it will be released. - [`devnet`](#avalanche-node-devnet): (ALPHA Warning) This command is currently in experimental mode. The node devnet command suite provides a collection of commands related to devnets. You can check the updated status by calling avalanche node status `clusterName` - [`export`](#avalanche-node-export): (ALPHA Warning) This command is currently in experimental mode. The node export command exports cluster configuration and its nodes config to a text file. If no file is specified, the configuration is printed to the stdout. Use --include-secrets to include keys in the export. In this case please keep the file secure as it contains sensitive information. Exported cluster configuration without secrets can be imported by another user using node import command. - [`import`](#avalanche-node-import): (ALPHA Warning) This command is currently in experimental mode. The node import command imports cluster configuration and its nodes configuration from a text file created from the node export command. Prior to calling this command, call node whitelist command to have your SSH public key and IP whitelisted by the cluster owner. This will enable you to use avalanche-cli commands to manage the imported cluster. Please note, that this imported cluster will be considered as EXTERNAL by avalanche-cli, so some commands affecting cloud nodes like node create or node destroy will be not applicable to it. - [`list`](#avalanche-node-list): (ALPHA Warning) This command is currently in experimental mode. The node list command lists all clusters together with their nodes. - [`loadtest`](#avalanche-node-loadtest): (ALPHA Warning) This command is currently in experimental mode. The node loadtest command suite starts and stops a load test for an existing devnet cluster. - [`local`](#avalanche-node-local): (ALPHA Warning) This command is currently in experimental mode. The node local command suite provides a collection of commands related to local nodes - [`refresh-ips`](#avalanche-node-refresh-ips): (ALPHA Warning) This command is currently in experimental mode. The node refresh-ips command obtains the current IP for all nodes with dynamic IPs in the cluster, and updates the local node information used by CLI commands. - [`resize`](#avalanche-node-resize): (ALPHA Warning) This command is currently in experimental mode. The node resize command can change the amount of CPU, memory and disk space available for the cluster nodes. - [`scp`](#avalanche-node-scp): (ALPHA Warning) This command is currently in experimental mode. The node scp command securely copies files to and from nodes. Remote source or destionation can be specified using the following format: [clusterName|nodeID|instanceID|IP]:/path/to/file. Regular expressions are supported for the source files like /tmp/*.txt. File transfer to the nodes are parallelized. IF source or destination is cluster, the other should be a local file path. If both destinations are remote, they must be nodes for the same cluster and not clusters themselves. For example: $ avalanche node scp [cluster1|node1]:/tmp/file.txt /tmp/file.txt $ avalanche node scp /tmp/file.txt [cluster1|NodeID-XXXX]:/tmp/file.txt $ avalanche node scp node1:/tmp/file.txt NodeID-XXXX:/tmp/file.txt - [`ssh`](#avalanche-node-ssh): (ALPHA Warning) This command is currently in experimental mode. The node ssh command execute a given command [cmd] using ssh on all nodes in the cluster if ClusterName is given. If no command is given, just prints the ssh command to be used to connect to each node in the cluster. For provided NodeID or InstanceID or IP, the command [cmd] will be executed on that node. If no [cmd] is provided for the node, it will open ssh shell there. - [`status`](#avalanche-node-status): (ALPHA Warning) This command is currently in experimental mode. The node status command gets the bootstrap status of all nodes in a cluster with the Primary Network. If no cluster is given, defaults to node list behaviour. To get the bootstrap status of a node with a Blockchain, use --blockchain flag - [`sync`](#avalanche-node-sync): (ALPHA Warning) This command is currently in experimental mode. The node sync command enables all nodes in a cluster to be bootstrapped to a Blockchain. You can check the blockchain bootstrap status by calling avalanche node status `clusterName` --blockchain `blockchainName` - [`update`](#avalanche-node-update): (ALPHA Warning) This command is currently in experimental mode. The node update command suite provides a collection of commands for nodes to update their avalanchego or VM config. You can check the status after update by calling avalanche node status - [`upgrade`](#avalanche-node-upgrade): (ALPHA Warning) This command is currently in experimental mode. The node update command suite provides a collection of commands for nodes to update their avalanchego or VM version. You can check the status after upgrade by calling avalanche node status - [`validate`](#avalanche-node-validate): (ALPHA Warning) This command is currently in experimental mode. The node validate command suite provides a collection of commands for nodes to join the Primary Network and Subnets as validators. If any of the commands is run before the nodes are bootstrapped on the Primary Network, the command will fail. You can check the bootstrap status by calling avalanche node status `clusterName` - [`whitelist`](#avalanche-node-whitelist): (ALPHA Warning) The whitelist command suite provides a collection of tools for granting access to the cluster. Command adds IP if --ip params provided to cloud security access rules allowing it to access all nodes in the cluster via ssh or http. It also command adds SSH public key to all nodes in the cluster if --ssh params is there. If no params provided it detects current user IP automaticaly and whitelists it **Flags:** ```bash -h, --help help for node --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### addDashboard (ALPHA Warning) This command is currently in experimental mode. The node addDashboard command adds custom dashboard to the Grafana monitoring dashboard for the cluster. **Usage:** ```bash avalanche node addDashboard [subcommand] [flags] ``` **Flags:** ```bash --add-grafana-dashboard string path to additional grafana dashboard json file -h, --help help for addDashboard --subnet string subnet that the dasbhoard is intended for (if any) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### create (ALPHA Warning) This command is currently in experimental mode. The node create command sets up a validator on a cloud server of your choice. The validator will be validating the Avalanche Primary Network and Subnet of your choice. By default, the command runs an interactive wizard. It walks you through all the steps you need to set up a validator. Once this command is completed, you will have to wait for the validator to finish bootstrapping on the primary network before running further commands on it, e.g. validating a Subnet. You can check the bootstrapping status by running avalanche node status The created node will be part of group of validators called `clusterName` and users can call node commands with `clusterName` so that the command will apply to all nodes in the cluster **Usage:** ```bash avalanche node create [subcommand] [flags] ``` **Flags:** ```bash --add-grafana-dashboard string path to additional grafana dashboard json file --alternative-key-pair-name string key pair name to use if default one generates conflicts --authorize-access authorize CLI to create cloud resources --auto-replace-keypair automatically replaces key pair to access node if previous key pair is not found --avalanchego-version-from-subnet string install latest avalanchego version, that is compatible with the given subnet, on node/s --aws create node/s in AWS cloud --aws-profile string aws profile to use (default "default") --aws-volume-iops int AWS iops (for gp3, io1, and io2 volume types only) (default 3000) --aws-volume-size int AWS volume size in GB (default 1000) --aws-volume-throughput int AWS throughput in MiB/s (for gp3 volume type only) (default 125) --aws-volume-type string AWS volume type (default "gp3") --bootstrap-ids stringArray nodeIDs of bootstrap nodes --bootstrap-ips stringArray IP:port pairs of bootstrap nodes --cluster string operate on the given cluster --custom-avalanchego-version string install given avalanchego version on node/s --devnet operate on a devnet network --enable-monitoring set up Prometheus monitoring for created nodes. This option creates a separate monitoring cloud instance and incures additional cost --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --gcp create node/s in GCP cloud --gcp-credentials string use given GCP credentials --gcp-project string use given GCP project --genesis string path to genesis file --grafana-pkg string use grafana pkg instead of apt repo(by default), for example https://dl.grafana.com/oss/release/grafana_10.4.1_amd64.deb -h, --help help for create --latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s --latest-avalanchego-version install latest avalanchego release version on node/s -m, --mainnet operate on mainnet --node-type string cloud instance type. Use 'default' to use recommended default instance type --num-apis ints number of API nodes(nodes without stake) to create in the new Devnet --num-validators ints number of nodes to create per region(s). Use comma to separate multiple numbers for each region in the same order as --region flag --partial-sync primary network partial sync (default true) --public-http-port allow public access to avalanchego HTTP port --region strings create node(s) in given region(s). Use comma to separate multiple regions --ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used -t, --testnet fuji operate on testnet (alias to fuji) --upgrade string path to upgrade file --use-ssh-agent use ssh agent(ex: Yubikey) for ssh auth --use-static-ip attach static Public IP on cloud servers (default true) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### destroy (ALPHA Warning) This command is currently in experimental mode. The node destroy command terminates all running nodes in cloud server and deletes all storage disks. If there is a static IP address attached, it will be released. **Usage:** ```bash avalanche node destroy [subcommand] [flags] ``` **Flags:** ```bash --all destroy all existing clusters created by Avalanche CLI --authorize-access authorize CLI to release cloud resources -y, --authorize-all authorize all CLI requests --authorize-remove authorize CLI to remove all local files related to cloud nodes --aws-profile string aws profile to use (default "default") -h, --help help for destroy --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### devnet (ALPHA Warning) This command is currently in experimental mode. The node devnet command suite provides a collection of commands related to devnets. You can check the updated status by calling avalanche node status `clusterName` **Usage:** ```bash avalanche node devnet [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-node-devnet-deploy): (ALPHA Warning) This command is currently in experimental mode. The node devnet deploy command deploys a subnet into a devnet cluster, creating subnet and blockchain txs for it. It saves the deploy info both locally and remotely. - [`wiz`](#avalanche-node-devnet-wiz): (ALPHA Warning) This command is currently in experimental mode. The node wiz command creates a devnet and deploys, sync and validate a subnet into it. It creates the subnet if so needed. **Flags:** ```bash -h, --help help for devnet --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### devnet deploy (ALPHA Warning) This command is currently in experimental mode. The node devnet deploy command deploys a subnet into a devnet cluster, creating subnet and blockchain txs for it. It saves the deploy info both locally and remotely. **Usage:** ```bash avalanche node devnet deploy [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for deploy --no-checks do not check for healthy status or rpc compatibility of nodes against subnet --subnet-aliases strings additional subnet aliases to be used for RPC calls in addition to subnet blockchain name --subnet-only only create a subnet --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### devnet wiz (ALPHA Warning) This command is currently in experimental mode. The node wiz command creates a devnet and deploys, sync and validate a subnet into it. It creates the subnet if so needed. **Usage:** ```bash avalanche node devnet wiz [subcommand] [flags] ``` **Flags:** ```bash --add-grafana-dashboard string path to additional grafana dashboard json file --alternative-key-pair-name string key pair name to use if default one generates conflicts --authorize-access authorize CLI to create cloud resources --auto-replace-keypair automatically replaces key pair to access node if previous key pair is not found --aws create node/s in AWS cloud --aws-profile string aws profile to use (default "default") --aws-volume-iops int AWS iops (for gp3, io1, and io2 volume types only) (default 3000) --aws-volume-size int AWS volume size in GB (default 1000) --aws-volume-throughput int AWS throughput in MiB/s (for gp3 volume type only) (default 125) --aws-volume-type string AWS volume type (default "gp3") --chain-config string path to the chain configuration for subnet --custom-avalanchego-version string install given avalanchego version on node/s --custom-subnet use a custom VM as the subnet virtual machine --custom-vm-branch string custom vm branch or commit --custom-vm-build-script string custom vm build-script --custom-vm-repo-url string custom vm repository url --default-validator-params use default weight/start/duration params for subnet validator --deploy-icm-messenger deploy Interchain Messenger (default true) --deploy-icm-registry deploy Interchain Registry (default true) --deploy-teleporter-messenger deploy Interchain Messenger (default true) --deploy-teleporter-registry deploy Interchain Registry (default true) --enable-monitoring set up Prometheus monitoring for created nodes. Please note that this option creates a separate monitoring instance and incures additional cost --evm-chain-id uint chain ID to use with Subnet-EVM --evm-defaults use default production settings with Subnet-EVM --evm-production-defaults use default production settings for your blockchain --evm-subnet use Subnet-EVM as the subnet virtual machine --evm-test-defaults use default test settings for your blockchain --evm-token string token name to use with Subnet-EVM --evm-version string version of Subnet-EVM to use --force-subnet-create overwrite the existing subnet configuration if one exists --gcp create node/s in GCP cloud --gcp-credentials string use given GCP credentials --gcp-project string use given GCP project --grafana-pkg string use grafana pkg instead of apt repo(by default), for example https://dl.grafana.com/oss/release/grafana_10.4.1_amd64.deb -h, --help help for wiz --icm generate an icm-ready vm --icm-messenger-contract-address-path string path to an icm messenger contract address file --icm-messenger-deployer-address-path string path to an icm messenger deployer address file --icm-messenger-deployer-tx-path string path to an icm messenger deployer tx file --icm-registry-bytecode-path string path to an icm registry bytecode file --icm-version string icm version to deploy (default "latest") --latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s --latest-avalanchego-version install latest avalanchego release version on node/s --latest-evm-version use latest Subnet-EVM released version --latest-pre-released-evm-version use latest Subnet-EVM pre-released version --node-config string path to avalanchego node configuration for subnet --node-type string cloud instance type. Use 'default' to use recommended default instance type --num-apis ints number of API nodes(nodes without stake) to create in the new Devnet --num-validators ints number of nodes to create per region(s). Use comma to separate multiple numbers for each region in the same order as --region flag --public-http-port allow public access to avalanchego HTTP port --region strings create node/s in given region(s). Use comma to separate multiple regions --relayer run AWM relayer when deploying the vm --ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used. --subnet-aliases strings additional subnet aliases to be used for RPC calls in addition to subnet blockchain name --subnet-config string path to the subnet configuration for subnet --subnet-genesis string file path of the subnet genesis --teleporter generate an icm-ready vm --teleporter-messenger-contract-address-path string path to an icm messenger contract address file --teleporter-messenger-deployer-address-path string path to an icm messenger deployer address file --teleporter-messenger-deployer-tx-path string path to an icm messenger deployer tx file --teleporter-registry-bytecode-path string path to an icm registry bytecode file --teleporter-version string icm version to deploy (default "latest") --use-ssh-agent use ssh agent for ssh --use-static-ip attach static Public IP on cloud servers (default true) --validators strings deploy subnet into given comma separated list of validators. defaults to all cluster nodes --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### export (ALPHA Warning) This command is currently in experimental mode. The node export command exports cluster configuration and its nodes config to a text file. If no file is specified, the configuration is printed to the stdout. Use --include-secrets to include keys in the export. In this case please keep the file secure as it contains sensitive information. Exported cluster configuration without secrets can be imported by another user using node import command. **Usage:** ```bash avalanche node export [subcommand] [flags] ``` **Flags:** ```bash --file string specify the file to export the cluster configuration to --force overwrite the file if it exists -h, --help help for export --include-secrets include keys in the export --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### import (ALPHA Warning) This command is currently in experimental mode. The node import command imports cluster configuration and its nodes configuration from a text file created from the node export command. Prior to calling this command, call node whitelist command to have your SSH public key and IP whitelisted by the cluster owner. This will enable you to use avalanche-cli commands to manage the imported cluster. Please note, that this imported cluster will be considered as EXTERNAL by avalanche-cli, so some commands affecting cloud nodes like node create or node destroy will be not applicable to it. **Usage:** ```bash avalanche node import [subcommand] [flags] ``` **Flags:** ```bash --file string specify the file to export the cluster configuration to -h, --help help for import --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### list (ALPHA Warning) This command is currently in experimental mode. The node list command lists all clusters together with their nodes. **Usage:** ```bash avalanche node list [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for list --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### loadtest (ALPHA Warning) This command is currently in experimental mode. The node loadtest command suite starts and stops a load test for an existing devnet cluster. **Usage:** ```bash avalanche node loadtest [subcommand] [flags] ``` **Subcommands:** - [`start`](#avalanche-node-loadtest-start): (ALPHA Warning) This command is currently in experimental mode. The node loadtest command starts load testing for an existing devnet cluster. If the cluster does not have an existing load test host, the command creates a separate cloud server and builds the load test binary based on the provided load test Git Repo URL and load test binary build command. The command will then run the load test binary based on the provided load test run command. - [`stop`](#avalanche-node-loadtest-stop): (ALPHA Warning) This command is currently in experimental mode. The node loadtest stop command stops load testing for an existing devnet cluster and terminates the separate cloud server created to host the load test. **Flags:** ```bash -h, --help help for loadtest --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### loadtest start (ALPHA Warning) This command is currently in experimental mode. The node loadtest command starts load testing for an existing devnet cluster. If the cluster does not have an existing load test host, the command creates a separate cloud server and builds the load test binary based on the provided load test Git Repo URL and load test binary build command. The command will then run the load test binary based on the provided load test run command. **Usage:** ```bash avalanche node loadtest start [subcommand] [flags] ``` **Flags:** ```bash --authorize-access authorize CLI to create cloud resources --aws create loadtest node in AWS cloud --aws-profile string aws profile to use (default "default") --gcp create loadtest in GCP cloud -h, --help help for start --load-test-branch string load test branch or commit --load-test-build-cmd string command to build load test binary --load-test-cmd string command to run load test --load-test-repo string load test repo url to use --node-type string cloud instance type for loadtest script --region string create load test node in a given region --ssh-agent-identity string use given ssh identity(only for ssh agent). If not set, default will be used --use-ssh-agent use ssh agent(ex: Yubikey) for ssh auth --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### loadtest stop (ALPHA Warning) This command is currently in experimental mode. The node loadtest stop command stops load testing for an existing devnet cluster and terminates the separate cloud server created to host the load test. **Usage:** ```bash avalanche node loadtest stop [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for stop --load-test strings stop specified load test node(s). Use comma to separate multiple load test instance names --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### local (ALPHA Warning) This command is currently in experimental mode. The node local command suite provides a collection of commands related to local nodes **Usage:** ```bash avalanche node local [subcommand] [flags] ``` **Subcommands:** - [`destroy`](#avalanche-node-local-destroy): Cleanup local node. - [`start`](#avalanche-node-local-start): (ALPHA Warning) This command is currently in experimental mode. The node local start command sets up a validator on a local server. The validator will be validating the Avalanche Primary Network and Subnet of your choice. By default, the command runs an interactive wizard. It walks you through all the steps you need to set up a validator. Once this command is completed, you will have to wait for the validator to finish bootstrapping on the primary network before running further commands on it, e.g. validating a Subnet. You can check the bootstrapping status by running avalanche node status local - [`status`](#avalanche-node-local-status): Get status of local node. - [`stop`](#avalanche-node-local-stop): Stop local node. - [`track`](#avalanche-node-local-track): (ALPHA Warning) make the local node at the cluster to track given blockchain **Flags:** ```bash -h, --help help for local --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local destroy Cleanup local node. **Usage:** ```bash avalanche node local destroy [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for destroy --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local start (ALPHA Warning) This command is currently in experimental mode. The node local start command sets up a validator on a local server. The validator will be validating the Avalanche Primary Network and Subnet of your choice. By default, the command runs an interactive wizard. It walks you through all the steps you need to set up a validator. Once this command is completed, you will have to wait for the validator to finish bootstrapping on the primary network before running further commands on it, e.g. validating a Subnet. You can check the bootstrapping status by running avalanche node status local **Usage:** ```bash avalanche node local start [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-path string use this avalanchego binary path --bootstrap-id stringArray nodeIDs of bootstrap nodes --bootstrap-ip stringArray IP:port pairs of bootstrap nodes --cluster string operate on the given cluster --custom-avalanchego-version string install given avalanchego version on node/s --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --genesis string path to genesis file -h, --help help for start --latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s (default true) --latest-avalanchego-version install latest avalanchego release version on node/s -l, --local operate on a local network -m, --mainnet operate on mainnet --node-config string path to common avalanchego config settings for all nodes --num-nodes uint32 number of nodes to start (default 1) --partial-sync primary network partial sync (default true) --staking-cert-key-path string path to provided staking cert key for node --staking-signer-key-path string path to provided staking signer key for node --staking-tls-key-path string path to provided staking tls key for node -t, --testnet fuji operate on testnet (alias to fuji) --upgrade string path to upgrade file --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local status Get status of local node. **Usage:** ```bash avalanche node local status [subcommand] [flags] ``` **Flags:** ```bash --blockchain string specify the blockchain the node is syncing with -h, --help help for status --subnet string specify the blockchain the node is syncing with --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local stop Stop local node. **Usage:** ```bash avalanche node local stop [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for stop --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### local track (ALPHA Warning) make the local node at the cluster to track given blockchain **Usage:** ```bash avalanche node local track [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-path string use this avalanchego binary path --custom-avalanchego-version string install given avalanchego version on node/s -h, --help help for track --latest-avalanchego-pre-release-version install latest avalanchego pre-release version on node/s (default true) --latest-avalanchego-version install latest avalanchego release version on node/s --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### refresh-ips (ALPHA Warning) This command is currently in experimental mode. The node refresh-ips command obtains the current IP for all nodes with dynamic IPs in the cluster, and updates the local node information used by CLI commands. **Usage:** ```bash avalanche node refresh-ips [subcommand] [flags] ``` **Flags:** ```bash --aws-profile string aws profile to use (default "default") -h, --help help for refresh-ips --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### resize (ALPHA Warning) This command is currently in experimental mode. The node resize command can change the amount of CPU, memory and disk space available for the cluster nodes. **Usage:** ```bash avalanche node resize [subcommand] [flags] ``` **Flags:** ```bash --aws-profile string aws profile to use (default "default") --disk-size string Disk size to resize in Gb (e.g. 1000Gb) -h, --help help for resize --node-type string Node type to resize (e.g. t3.2xlarge) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### scp (ALPHA Warning) This command is currently in experimental mode. The node scp command securely copies files to and from nodes. Remote source or destionation can be specified using the following format: [clusterName|nodeID|instanceID|IP]:/path/to/file. Regular expressions are supported for the source files like /tmp/*.txt. File transfer to the nodes are parallelized. IF source or destination is cluster, the other should be a local file path. If both destinations are remote, they must be nodes for the same cluster and not clusters themselves. For example: $ avalanche node scp [cluster1|node1]:/tmp/file.txt /tmp/file.txt $ avalanche node scp /tmp/file.txt [cluster1|NodeID-XXXX]:/tmp/file.txt $ avalanche node scp node1:/tmp/file.txt NodeID-XXXX:/tmp/file.txt **Usage:** ```bash avalanche node scp [subcommand] [flags] ``` **Flags:** ```bash --compress use compression for ssh -h, --help help for scp --recursive copy directories recursively --with-loadtest include loadtest node for scp cluster operations --with-monitor include monitoring node for scp cluster operations --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### ssh (ALPHA Warning) This command is currently in experimental mode. The node ssh command execute a given command [cmd] using ssh on all nodes in the cluster if ClusterName is given. If no command is given, just prints the ssh command to be used to connect to each node in the cluster. For provided NodeID or InstanceID or IP, the command [cmd] will be executed on that node. If no [cmd] is provided for the node, it will open ssh shell there. **Usage:** ```bash avalanche node ssh [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for ssh --parallel run ssh command on all nodes in parallel --with-loadtest include loadtest node for ssh cluster operations --with-monitor include monitoring node for ssh cluster operations --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### status (ALPHA Warning) This command is currently in experimental mode. The node status command gets the bootstrap status of all nodes in a cluster with the Primary Network. If no cluster is given, defaults to node list behaviour. To get the bootstrap status of a node with a Blockchain, use --blockchain flag **Usage:** ```bash avalanche node status [subcommand] [flags] ``` **Flags:** ```bash --blockchain string specify the blockchain the node is syncing with -h, --help help for status --subnet string specify the blockchain the node is syncing with --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### sync (ALPHA Warning) This command is currently in experimental mode. The node sync command enables all nodes in a cluster to be bootstrapped to a Blockchain. You can check the blockchain bootstrap status by calling avalanche node status `clusterName` --blockchain `blockchainName` **Usage:** ```bash avalanche node sync [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for sync --no-checks do not check for bootstrapped/healthy status or rpc compatibility of nodes against subnet --subnet-aliases strings subnet alias to be used for RPC calls. defaults to subnet blockchain ID --validators strings sync subnet into given comma separated list of validators. defaults to all cluster nodes --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### update (ALPHA Warning) This command is currently in experimental mode. The node update command suite provides a collection of commands for nodes to update their avalanchego or VM config. You can check the status after update by calling avalanche node status **Usage:** ```bash avalanche node update [subcommand] [flags] ``` **Subcommands:** - [`subnet`](#avalanche-node-update-subnet): (ALPHA Warning) This command is currently in experimental mode. The node update subnet command updates all nodes in a cluster with latest Subnet configuration and VM for custom VM. You can check the updated subnet bootstrap status by calling avalanche node status `clusterName` --subnet `subnetName` **Flags:** ```bash -h, --help help for update --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### update subnet (ALPHA Warning) This command is currently in experimental mode. The node update subnet command updates all nodes in a cluster with latest Subnet configuration and VM for custom VM. You can check the updated subnet bootstrap status by calling avalanche node status `clusterName` --subnet `subnetName` **Usage:** ```bash avalanche node update subnet [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for subnet --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### upgrade (ALPHA Warning) This command is currently in experimental mode. The node update command suite provides a collection of commands for nodes to update their avalanchego or VM version. You can check the status after upgrade by calling avalanche node status **Usage:** ```bash avalanche node upgrade [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for upgrade --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### validate (ALPHA Warning) This command is currently in experimental mode. The node validate command suite provides a collection of commands for nodes to join the Primary Network and Subnets as validators. If any of the commands is run before the nodes are bootstrapped on the Primary Network, the command will fail. You can check the bootstrap status by calling avalanche node status `clusterName` **Usage:** ```bash avalanche node validate [subcommand] [flags] ``` **Subcommands:** - [`primary`](#avalanche-node-validate-primary): (ALPHA Warning) This command is currently in experimental mode. The node validate primary command enables all nodes in a cluster to be validators of Primary Network. - [`subnet`](#avalanche-node-validate-subnet): (ALPHA Warning) This command is currently in experimental mode. The node validate subnet command enables all nodes in a cluster to be validators of a Subnet. If the command is run before the nodes are Primary Network validators, the command will first make the nodes Primary Network validators before making them Subnet validators. If The command is run before the nodes are bootstrapped on the Primary Network, the command will fail. You can check the bootstrap status by calling avalanche node status `clusterName` If The command is run before the nodes are synced to the subnet, the command will fail. You can check the subnet sync status by calling avalanche node status `clusterName` --subnet `subnetName` **Flags:** ```bash -h, --help help for validate --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### validate primary (ALPHA Warning) This command is currently in experimental mode. The node validate primary command enables all nodes in a cluster to be validators of Primary Network. **Usage:** ```bash avalanche node validate primary [subcommand] [flags] ``` **Flags:** ```bash -e, --ewoq use ewoq key [fuji/devnet only] -h, --help help for primary -k, --key string select the key to use [fuji only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses --stake-amount uint how many AVAX to stake in the validator --staking-period duration how long validator validates for after start time --start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### validate subnet (ALPHA Warning) This command is currently in experimental mode. The node validate subnet command enables all nodes in a cluster to be validators of a Subnet. If the command is run before the nodes are Primary Network validators, the command will first make the nodes Primary Network validators before making them Subnet validators. If The command is run before the nodes are bootstrapped on the Primary Network, the command will fail. You can check the bootstrap status by calling avalanche node status `clusterName` If The command is run before the nodes are synced to the subnet, the command will fail. You can check the subnet sync status by calling avalanche node status `clusterName` --subnet `subnetName` **Usage:** ```bash avalanche node validate subnet [subcommand] [flags] ``` **Flags:** ```bash --default-validator-params use default weight/start/duration params for subnet validator -e, --ewoq use ewoq key [fuji/devnet only] -h, --help help for subnet -k, --key string select the key to use [fuji/devnet only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses --no-checks do not check for bootstrapped status or healthy status --no-validation-checks do not check if subnet is already synced or validated (default true) --stake-amount uint how many AVAX to stake in the validator --staking-period duration how long validator validates for after start time --start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format --validators strings validate subnet for the given comma separated list of validators. defaults to all cluster nodes --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### whitelist (ALPHA Warning) The whitelist command suite provides a collection of tools for granting access to the cluster. Command adds IP if --ip params provided to cloud security access rules allowing it to access all nodes in the cluster via ssh or http. It also command adds SSH public key to all nodes in the cluster if --ssh params is there. If no params provided it detects current user IP automaticaly and whitelists it **Usage:** ```bash avalanche node whitelist [subcommand] [flags] ``` **Flags:** ```bash -y, --current-ip whitelist current host ip -h, --help help for whitelist --ip string ip address to whitelist --ssh string ssh public key to whitelist --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche primary The primary command suite provides a collection of tools for interacting with the Primary Network **Usage:** ```bash avalanche primary [subcommand] [flags] ``` **Subcommands:** - [`addValidator`](#avalanche-primary-addvalidator): The primary addValidator command adds a node as a validator in the Primary Network - [`describe`](#avalanche-primary-describe): The subnet describe command prints details of the primary network configuration to the console. **Flags:** ```bash -h, --help help for primary --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### addValidator The primary addValidator command adds a node as a validator in the Primary Network **Usage:** ```bash avalanche primary addValidator [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --delegation-fee uint32 set the delegation fee (20 000 is equivalent to 2%) --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for addValidator -k, --key string select the key to use [fuji only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses -m, --mainnet operate on mainnet --nodeID string set the NodeID of the validator to add --proof-of-possession string set the BLS proof of possession of the validator to add --public-key string set the BLS public key of the validator to add --staking-period duration how long this validator will be staking --start-time string UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format -t, --testnet fuji operate on testnet (alias to fuji) --weight uint set the staking weight of the validator to add --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### describe The subnet describe command prints details of the primary network configuration to the console. **Usage:** ```bash avalanche primary describe [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster -h, --help help for describe -l, --local operate on a local network --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche subnet The subnet command suite provides a collection of tools for developing and deploying Blockchains. To get started, use the subnet create command wizard to walk through the configuration of your very first Blockchain. Then, go ahead and deploy it with the subnet deploy command. You can use the rest of the commands to manage your Blockchain configurations and live deployments. Deprecation notice: use 'avalanche blockchain' **Usage:** ```bash avalanche subnet [subcommand] [flags] ``` **Subcommands:** - [`addValidator`](#avalanche-subnet-addvalidator): The blockchain addValidator command adds a node as a validator to an L1 of the user provided deployed network. If the network is proof of authority, the owner of the validator manager contract must sign the transaction. If the network is proof of stake, the node must stake the L1's staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain. This command currently only works on Blockchains deployed to either the Fuji Testnet or Mainnet. - [`changeOwner`](#avalanche-subnet-changeowner): The blockchain changeOwner changes the owner of the subnet of the deployed Blockchain. - [`changeWeight`](#avalanche-subnet-changeweight): The blockchain changeWeight command changes the weight of a Subnet Validator. The Subnet has to be a Proof of Authority Subnet-Only Validator Subnet. - [`configure`](#avalanche-subnet-configure): AvalancheGo nodes support several different configuration files. Subnets have their own Subnet config which applies to all chains/VMs in the Subnet. Each chain within the Subnet can have its own chain config. A chain can also have special requirements for the AvalancheGo node configuration itself. This command allows you to set all those files. - [`create`](#avalanche-subnet-create): The blockchain create command builds a new genesis file to configure your Blockchain. By default, the command runs an interactive wizard. It walks you through all the steps you need to create your first Blockchain. The tool supports deploying Subnet-EVM, and custom VMs. You can create a custom, user-generated genesis with a custom VM by providing the path to your genesis and VM binaries with the --genesis and --vm flags. By default, running the command with a blockchainName that already exists causes the command to fail. If you'd like to overwrite an existing configuration, pass the -f flag. - [`delete`](#avalanche-subnet-delete): The blockchain delete command deletes an existing blockchain configuration. - [`deploy`](#avalanche-subnet-deploy): The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet. At the end of the call, the command prints the RPC URL you can use to interact with the Subnet. Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call avalanche network clean to reset all deployed chain state. Subsequent local deploys redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks, so you can take your locally tested Subnet and deploy it on Fuji or Mainnet. - [`describe`](#avalanche-subnet-describe): The blockchain describe command prints the details of a Blockchain configuration to the console. By default, the command prints a summary of the configuration. By providing the --genesis flag, the command instead prints out the raw genesis file. - [`export`](#avalanche-subnet-export): The blockchain export command write the details of an existing Blockchain deploy to a file. The command prompts for an output path. You can also provide one with the --output flag. - [`import`](#avalanche-subnet-import): Import blockchain configurations into avalanche-cli. This command suite supports importing from a file created on another computer, or importing from blockchains running public networks (e.g. created manually or with the deprecated subnet-cli) - [`join`](#avalanche-subnet-join): The subnet join command configures your validator node to begin validating a new Blockchain. To complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can generate or update your node's config file automatically. Alternatively, the command can print the necessary instructions to update your node manually. To complete the validation process, the Subnet's admins must add the NodeID of your validator to the Subnet's allow list by calling addValidator with your NodeID. After you update your validator's config, you need to restart your validator manually. If you provide the --avalanchego-config flag, this command attempts to edit the config file at that path. This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet. - [`list`](#avalanche-subnet-list): The blockchain list command prints the names of all created Blockchain configurations. Without any flags, it prints some general, static information about the Blockchain. With the --deployed flag, the command shows additional information including the VMID, BlockchainID and SubnetID. - [`publish`](#avalanche-subnet-publish): The blockchain publish command publishes the Blockchain's VM to a repository. - [`removeValidator`](#avalanche-subnet-removevalidator): The blockchain removeValidator command stops a whitelisted, subnet network validator from validating your deployed Blockchain. To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass these prompts by providing the values with flags. - [`stats`](#avalanche-subnet-stats): The blockchain stats command prints validator statistics for the given Blockchain. - [`upgrade`](#avalanche-subnet-upgrade): The blockchain upgrade command suite provides a collection of tools for updating your developmental and deployed Blockchains. - [`validators`](#avalanche-subnet-validators): The blockchain validators command lists the validators of a blockchain's subnet and provides several statistics about them. - [`vmid`](#avalanche-subnet-vmid): The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain. **Flags:** ```bash -h, --help help for subnet --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### addValidator The blockchain addValidator command adds a node as a validator to an L1 of the user provided deployed network. If the network is proof of authority, the owner of the validator manager contract must sign the transaction. If the network is proof of stake, the node must stake the L1's staking token. Both processes will issue a RegisterL1ValidatorTx on the P-Chain. This command currently only works on Blockchains deployed to either the Fuji Testnet or Mainnet. **Usage:** ```bash avalanche subnet addValidator [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Off") --balance uint set the AVAX balance of the validator that will be used for continuous fee on P-Chain --blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's registration (blockchain gas token) --blockchain-key string CLI stored key to use to pay fees for completing the validator's registration (blockchain gas token) --blockchain-private-key string private key to use to pay fees for completing the validator's registration (blockchain gas token) --bls-proof-of-possession string set the BLS proof of possession of the validator to add --bls-public-key string set the BLS public key of the validator to add --cluster string operate on the given cluster --create-local-validator create additional local validator and add it to existing running local node --default-duration (for Subnets, not L1s) set duration so as to validate until primary validator ends its period --default-start-time (for Subnets, not L1s) use default start time for subnet validator (5 minutes later for fuji & mainnet, 30 seconds later for devnet) --default-validator-params (for Subnets, not L1s) use default weight/start/duration params for subnet validator --delegation-fee uint16 (PoS only) delegation fee (in bips) (default 100) --devnet operate on a devnet network --disable-owner string P-Chain address that will able to disable the validator with a P-Chain transaction --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet only] -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for addValidator -k, --key string select the key to use [fuji/devnet only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-endpoint string gather node id/bls from publicly available avalanchego apis on the given endpoint --node-id string node-id of the validator to add --output-tx-path string (for Subnets, not L1s) file path of the add validator tx --partial-sync set primary network partial sync for new validators (default true) --remaining-balance-owner string P-Chain address that will receive any leftover AVAX from the validator when it is removed from Subnet --rpc string connect to validator manager at the given rpc endpoint --stake-amount uint (PoS only) amount of tokens to stake --staking-period duration how long this validator will be staking --start-time string (for Subnets, not L1s) UTC start time when this validator starts validating, in 'YYYY-MM-DD HH:MM:SS' format --subnet-auth-keys strings (for Subnets, not L1s) control keys that will be used to authenticate add validator tx -t, --testnet fuji operate on testnet (alias to fuji) --wait-for-tx-acceptance (for Subnets, not L1s) just issue the add validator tx, without waiting for its acceptance (default true) --weight uint set the staking weight of the validator to add (default 20) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### changeOwner The blockchain changeOwner changes the owner of the subnet of the deployed Blockchain. **Usage:** ```bash avalanche subnet changeOwner [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --control-keys strings addresses that may make subnet changes --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet] -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for changeOwner -k, --key string select the key to use [fuji/devnet] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --output-tx-path string file path of the transfer subnet ownership tx -s, --same-control-key use the fee-paying key as control key --subnet-auth-keys strings control keys that will be used to authenticate transfer subnet ownership tx -t, --testnet fuji operate on testnet (alias to fuji) --threshold uint32 required number of control key signatures to make subnet changes --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### changeWeight The blockchain changeWeight command changes the weight of a Subnet Validator. The Subnet has to be a Proof of Authority Subnet-Only Validator Subnet. **Usage:** ```bash avalanche subnet changeWeight [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet only] -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for changeWeight -k, --key string select the key to use [fuji/devnet only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-id string node-id of the validator -t, --testnet fuji operate on testnet (alias to fuji) --weight uint set the new staking weight of the validator (default 20) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### configure AvalancheGo nodes support several different configuration files. Subnets have their own Subnet config which applies to all chains/VMs in the Subnet. Each chain within the Subnet can have its own chain config. A chain can also have special requirements for the AvalancheGo node configuration itself. This command allows you to set all those files. **Usage:** ```bash avalanche subnet configure [subcommand] [flags] ``` **Flags:** ```bash --chain-config string path to the chain configuration -h, --help help for configure --node-config string path to avalanchego node configuration --per-node-chain-config string path to per node chain configuration for local network --subnet-config string path to the subnet configuration --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### create The blockchain create command builds a new genesis file to configure your Blockchain. By default, the command runs an interactive wizard. It walks you through all the steps you need to create your first Blockchain. The tool supports deploying Subnet-EVM, and custom VMs. You can create a custom, user-generated genesis with a custom VM by providing the path to your genesis and VM binaries with the --genesis and --vm flags. By default, running the command with a blockchainName that already exists causes the command to fail. If you'd like to overwrite an existing configuration, pass the -f flag. **Usage:** ```bash avalanche subnet create [subcommand] [flags] ``` **Flags:** ```bash --custom use a custom VM template --custom-vm-branch string custom vm branch or commit --custom-vm-build-script string custom vm build-script --custom-vm-path string file path of custom vm to use --custom-vm-repo-url string custom vm repository url --debug enable blockchain debugging (default true) --evm use the Subnet-EVM as the base template --evm-chain-id uint chain ID to use with Subnet-EVM --evm-defaults deprecation notice: use '--production-defaults' --evm-token string token symbol to use with Subnet-EVM --external-gas-token use a gas token from another blockchain -f, --force overwrite the existing configuration if one exists --from-github-repo generate custom VM binary from github repository --genesis string file path of genesis to use -h, --help help for create --icm interoperate with other blockchains using ICM --icm-registry-at-genesis setup ICM registry smart contract on genesis [experimental] --latest use latest Subnet-EVM released version, takes precedence over --vm-version --pre-release use latest Subnet-EVM pre-released version, takes precedence over --vm-version --production-defaults use default production settings for your blockchain --proof-of-authority use proof of authority(PoA) for validator management --proof-of-stake use proof of stake(PoS) for validator management --proxy-contract-owner string EVM address that controls ProxyAdmin for TransparentProxy of ValidatorManager contract --reward-basis-points uint (PoS only) reward basis points for PoS Reward Calculator (default 100) --sovereign set to false if creating non-sovereign blockchain (default true) --teleporter interoperate with other blockchains using ICM --test-defaults use default test settings for your blockchain --validator-manager-owner string EVM address that controls Validator Manager Owner --vm string file path of custom vm to use. alias to custom-vm-path --vm-version string version of Subnet-EVM template to use --warp generate a vm with warp support (needed for ICM) (default true) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### delete The blockchain delete command deletes an existing blockchain configuration. **Usage:** ```bash avalanche subnet delete [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for delete --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy The blockchain deploy command deploys your Blockchain configuration locally, to Fuji Testnet, or to Mainnet. At the end of the call, the command prints the RPC URL you can use to interact with the Subnet. Avalanche-CLI only supports deploying an individual Blockchain once per network. Subsequent attempts to deploy the same Blockchain to the same network (local, Fuji, Mainnet) aren't allowed. If you'd like to redeploy a Blockchain locally for testing, you must first call avalanche network clean to reset all deployed chain state. Subsequent local deploys redeploy the chain with fresh state. You can deploy the same Blockchain to multiple networks, so you can take your locally tested Subnet and deploy it on Fuji or Mainnet. **Usage:** ```bash avalanche subnet deploy [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Off") --avalanchego-path string use this avalanchego binary path --avalanchego-version string use this version of avalanchego (ex: v1.17.12) (default "latest-prerelease") --balance float set the AVAX balance of each bootstrap validator that will be used for continuous fee on P-Chain (default 0.1) --blockchain-genesis-key use genesis allocated key to fund validator manager initialization --blockchain-key string CLI stored key to use to fund validator manager initialization --blockchain-private-key string private key to use to fund validator manager initialization --bootstrap-endpoints strings take validator node info from the given endpoints --bootstrap-filepath string JSON file path that provides details about bootstrap validators, leave Node-ID and BLS values empty if using --generate-node-id=true --cchain-funding-key string key to be used to fund relayer account on cchain --cchain-icm-key string key to be used to pay for ICM deploys on C-Chain --change-owner-address string address that will receive change if node is no longer L1 validator --cluster string operate on the given cluster --control-keys strings addresses that may make subnet changes --convert-only avoid node track, restart and poa manager setup --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -e, --ewoq use ewoq key [fuji/devnet deploy only] -f, --fuji testnet operate on fuji (alias to testnet --generate-node-id whether to create new node id for bootstrap validators (Node-ID and BLS values in bootstrap JSON file will be overridden if --bootstrap-filepath flag is used) -h, --help help for deploy --icm-key string key to be used to pay for ICM deploys (default "cli-teleporter-deployer") --icm-version string ICM version to deploy (default "latest") -k, --key string select the key to use [fuji/devnet deploy only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji/devnet) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --mainnet-chain-id uint32 use different ChainID for mainnet deployment --noicm skip automatic ICM deploy --num-bootstrap-validators int (only if --generate-node-id is true) number of bootstrap validators to set up in sovereign L1 validator) --num-local-nodes int number of nodes to be created on local machine --num-nodes uint32 number of nodes to be created on local network deploy (default 2) --output-tx-path string file path of the blockchain creation tx --partial-sync set primary network partial sync for new validators (default true) --pos-maximum-stake-amount uint maximum stake amount (default 1000) --pos-maximum-stake-multiplier uint8 maximum stake multiplier (default 1) --pos-minimum-delegation-fee uint16 minimum delegation fee (default 1) --pos-minimum-stake-amount uint minimum stake amount (default 1) --pos-minimum-stake-duration uint minimum stake duration (default 100) --pos-weight-to-value-factor uint weight to value factor (default 1) --relay-cchain relay C-Chain as source and destination (default true) --relayer-allow-private-ips allow relayer to connec to private ips (default true) --relayer-amount float automatically fund relayer fee payments with the given amount --relayer-key string key to be used by default both for rewards and to pay fees --relayer-log-level string log level to be used for relayer logs (default "info") --relayer-path string relayer binary to use --relayer-version string relayer version to deploy (default "latest-prerelease") -s, --same-control-key use the fee-paying key as control key --skip-icm-deploy skip automatic ICM deploy --skip-local-teleporter skip automatic ICM deploy on local networks [to be deprecated] --skip-relayer skip relayer deploy --skip-teleporter-deploy skip automatic ICM deploy --subnet-auth-keys strings control keys that will be used to authenticate chain creation -u, --subnet-id string do not create a subnet, deploy the blockchain into the given subnet id --subnet-only only create a subnet --teleporter-messenger-contract-address-path string path to an ICM Messenger contract address file --teleporter-messenger-deployer-address-path string path to an ICM Messenger deployer address file --teleporter-messenger-deployer-tx-path string path to an ICM Messenger deployer tx file --teleporter-registry-bytecode-path string path to an ICM Registry bytecode file --teleporter-version string ICM version to deploy (default "latest") -t, --testnet fuji operate on testnet (alias to fuji) --threshold uint32 required number of control key signatures to make subnet changes --use-local-machine use local machine as a blockchain validator --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### describe The blockchain describe command prints the details of a Blockchain configuration to the console. By default, the command prints a summary of the configuration. By providing the --genesis flag, the command instead prints out the raw genesis file. **Usage:** ```bash avalanche subnet describe [subcommand] [flags] ``` **Flags:** ```bash -g, --genesis Print the genesis to the console directly instead of the summary -h, --help help for describe --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### export The blockchain export command write the details of an existing Blockchain deploy to a file. The command prompts for an output path. You can also provide one with the --output flag. **Usage:** ```bash avalanche subnet export [subcommand] [flags] ``` **Flags:** ```bash --custom-vm-branch string custom vm branch --custom-vm-build-script string custom vm build-script --custom-vm-repo-url string custom vm repository url -h, --help help for export -o, --output string write the export data to the provided file path --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### import Import blockchain configurations into avalanche-cli. This command suite supports importing from a file created on another computer, or importing from blockchains running public networks (e.g. created manually or with the deprecated subnet-cli) **Usage:** ```bash avalanche subnet import [subcommand] [flags] ``` **Subcommands:** - [`file`](#avalanche-subnet-import-file): The blockchain import command will import a blockchain configuration from a file or a git repository. To import from a file, you can optionally provide the path as a command-line argument. Alternatively, running the command without any arguments triggers an interactive wizard. To import from a repository, go through the wizard. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. - [`public`](#avalanche-subnet-import-public): The blockchain import public command imports a Blockchain configuration from a running network. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. **Flags:** ```bash -h, --help help for import --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### import file The blockchain import command will import a blockchain configuration from a file or a git repository. To import from a file, you can optionally provide the path as a command-line argument. Alternatively, running the command without any arguments triggers an interactive wizard. To import from a repository, go through the wizard. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. **Usage:** ```bash avalanche subnet import file [subcommand] [flags] ``` **Flags:** ```bash --branch string the repo branch to use if downloading a new repo -f, --force overwrite the existing configuration if one exists -h, --help help for file --repo string the repo to import (ex: ava-labs/avalanche-plugins-core) or url to download the repo from --subnet string the subnet configuration to import from the provided repo --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### import public The blockchain import public command imports a Blockchain configuration from a running network. By default, an imported Blockchain doesn't overwrite an existing Blockchain with the same name. To allow overwrites, provide the --force flag. **Usage:** ```bash avalanche subnet import public [subcommand] [flags] ``` **Flags:** ```bash --blockchain-id string the blockchain ID --cluster string operate on the given cluster --custom use a custom VM template --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --evm import a subnet-evm --force overwrite the existing configuration if one exists -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for public -l, --local operate on a local network -m, --mainnet operate on mainnet --node-url string [optional] URL of an already running subnet validator -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### join The subnet join command configures your validator node to begin validating a new Blockchain. To complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can generate or update your node's config file automatically. Alternatively, the command can print the necessary instructions to update your node manually. To complete the validation process, the Subnet's admins must add the NodeID of your validator to the Subnet's allow list by calling addValidator with your NodeID. After you update your validator's config, you need to restart your validator manually. If you provide the --avalanchego-config flag, this command attempts to edit the config file at that path. This command currently only supports Blockchains deployed on the Fuji Testnet and Mainnet. **Usage:** ```bash avalanche subnet join [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-config string file path of the avalanchego config file --cluster string operate on the given cluster --data-dir string path of avalanchego's data dir directory --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force-write if true, skip to prompt to overwrite the config file -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for join -k, --key string select the key to use [fuji only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-id string set the NodeID of the validator to check --plugin-dir string file path of avalanchego's plugin directory --print if true, print the manual config without prompting --stake-amount uint amount of tokens to stake on validator --staking-period duration how long validator validates for after start time --start-time string start time that validator starts validating -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### list The blockchain list command prints the names of all created Blockchain configurations. Without any flags, it prints some general, static information about the Blockchain. With the --deployed flag, the command shows additional information including the VMID, BlockchainID and SubnetID. **Usage:** ```bash avalanche subnet list [subcommand] [flags] ``` **Flags:** ```bash --deployed show additional deploy information -h, --help help for list --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### publish The blockchain publish command publishes the Blockchain's VM to a repository. **Usage:** ```bash avalanche subnet publish [subcommand] [flags] ``` **Flags:** ```bash --alias string We publish to a remote repo, but identify the repo locally under a user-provided alias (e.g. myrepo). --force If true, ignores if the subnet has been published in the past, and attempts a forced publish. -h, --help help for publish --no-repo-path string Do not let the tool manage file publishing, but have it only generate the files and put them in the location given by this flag. --repo-url string The URL of the repo where we are publishing --subnet-file-path string Path to the Subnet description file. If not given, a prompting sequence will be initiated. --vm-file-path string Path to the VM description file. If not given, a prompting sequence will be initiated. --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### removeValidator The blockchain removeValidator command stops a whitelisted, subnet network validator from validating your deployed Blockchain. To remove the validator from the Subnet's allow list, provide the validator's unique NodeID. You can bypass these prompts by providing the values with flags. **Usage:** ```bash avalanche subnet removeValidator [subcommand] [flags] ``` **Flags:** ```bash --aggregator-allow-private-peers allow the signature aggregator to connect to peers with private IP (default true) --aggregator-extra-endpoints strings endpoints for extra nodes that are needed in signature aggregation --aggregator-log-level string log level to use with signature aggregator (default "Off") --blockchain-genesis-key use genesis allocated key to pay fees for completing the validator's removal (blockchain gas token) --blockchain-key string CLI stored key to use to pay fees for completing the validator's removal (blockchain gas token) --blockchain-private-key string private key to use to pay fees for completing the validator's removal (blockchain gas token) --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force force validator removal even if it's not getting rewarded -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for removeValidator -k, --key string select the key to use [fuji deploy only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses -l, --local operate on a local network -m, --mainnet operate on mainnet --node-endpoint string remove validator that responds to the given endpoint --node-id string node-id of the validator --output-tx-path string (for non-SOV blockchain only) file path of the removeValidator tx --rpc string connect to validator manager at the given rpc endpoint --subnet-auth-keys strings (for non-SOV blockchain only) control keys that will be used to authenticate the removeValidator tx -t, --testnet fuji operate on testnet (alias to fuji) --uptime uint validator's uptime in seconds. If not provided, it will be automatically calculated --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### stats The blockchain stats command prints validator statistics for the given Blockchain. **Usage:** ```bash avalanche subnet stats [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for stats -l, --local operate on a local network -m, --mainnet operate on mainnet -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### upgrade The blockchain upgrade command suite provides a collection of tools for updating your developmental and deployed Blockchains. **Usage:** ```bash avalanche subnet upgrade [subcommand] [flags] ``` **Subcommands:** - [`apply`](#avalanche-subnet-upgrade-apply): Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade. For public networks (Fuji Testnet or Mainnet), to complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can manipulate your node's configuration automatically. Alternatively, the command can print the necessary instructions to upgrade your node manually. After you update your validator's configuration, you need to restart your validator manually. If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path. Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation. - [`export`](#avalanche-subnet-upgrade-export): Export the upgrade bytes file to a location of choice on disk - [`generate`](#avalanche-subnet-upgrade-generate): The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It guides the user through the process using an interactive wizard. - [`import`](#avalanche-subnet-upgrade-import): Import the upgrade bytes file into the local environment - [`print`](#avalanche-subnet-upgrade-print): Print the upgrade.json file content - [`vm`](#avalanche-subnet-upgrade-vm): The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet. The command walks the user through an interactive wizard. The user can skip the wizard by providing command line flags. **Flags:** ```bash -h, --help help for upgrade --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade apply Apply generated upgrade bytes to running Blockchain nodes to trigger a network upgrade. For public networks (Fuji Testnet or Mainnet), to complete this process, you must have access to the machine running your validator. If the CLI is running on the same machine as your validator, it can manipulate your node's configuration automatically. Alternatively, the command can print the necessary instructions to upgrade your node manually. After you update your validator's configuration, you need to restart your validator manually. If you provide the --avalanchego-chain-config-dir flag, this command attempts to write the upgrade file at that path. Refer to https://docs.avax.network/nodes/maintain/chain-config-flags#subnet-chain-configs for related documentation. **Usage:** ```bash avalanche subnet upgrade apply [subcommand] [flags] ``` **Flags:** ```bash --avalanchego-chain-config-dir string avalanchego's chain config file directory (default "/Users/owen.wahlgren/.avalanchego/chains") --config create upgrade config for future subnet deployments (same as generate) --force If true, don't prompt for confirmation of timestamps in the past --fuji fuji apply upgrade existing fuji deployment (alias for `testnet`) -h, --help help for apply --local local apply upgrade existing local deployment --mainnet mainnet apply upgrade existing mainnet deployment --print if true, print the manual config without prompting (for public networks only) --testnet testnet apply upgrade existing testnet deployment (alias for `fuji`) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade export Export the upgrade bytes file to a location of choice on disk **Usage:** ```bash avalanche subnet upgrade export [subcommand] [flags] ``` **Flags:** ```bash --force If true, overwrite a possibly existing file without prompting -h, --help help for export --upgrade-filepath string Export upgrade bytes file to location of choice on disk --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade generate The blockchain upgrade generate command builds a new upgrade.json file to customize your Blockchain. It guides the user through the process using an interactive wizard. **Usage:** ```bash avalanche subnet upgrade generate [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for generate --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade import Import the upgrade bytes file into the local environment **Usage:** ```bash avalanche subnet upgrade import [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for import --upgrade-filepath string Import upgrade bytes file into local environment --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade print Print the upgrade.json file content **Usage:** ```bash avalanche subnet upgrade print [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for print --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` #### upgrade vm The blockchain upgrade vm command enables the user to upgrade their Blockchain's VM binary. The command can upgrade both local Blockchains and publicly deployed Blockchains on Fuji and Mainnet. The command walks the user through an interactive wizard. The user can skip the wizard by providing command line flags. **Usage:** ```bash avalanche subnet upgrade vm [subcommand] [flags] ``` **Flags:** ```bash --binary string Upgrade to custom binary --config upgrade config for future subnet deployments --fuji fuji upgrade existing fuji deployment (alias for `testnet`) -h, --help help for vm --latest upgrade to latest version --local local upgrade existing local deployment --mainnet mainnet upgrade existing mainnet deployment --plugin-dir string plugin directory to automatically upgrade VM --print print instructions for upgrading --testnet testnet upgrade existing testnet deployment (alias for `fuji`) --version string Upgrade to custom version --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### validators The blockchain validators command lists the validators of a blockchain's subnet and provides several statistics about them. **Usage:** ```bash avalanche subnet validators [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for validators -l, --local operate on a local network -m, --mainnet operate on mainnet -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### vmid The blockchain vmid command prints the virtual machine ID (VMID) for the given Blockchain. **Usage:** ```bash avalanche subnet vmid [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for vmid --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche teleporter The messenger command suite provides a collection of tools for interacting with ICM messenger contracts. **Usage:** ```bash avalanche teleporter [subcommand] [flags] ``` **Subcommands:** - [`deploy`](#avalanche-teleporter-deploy): Deploys ICM Messenger and Registry into a given L1. - [`sendMsg`](#avalanche-teleporter-sendmsg): Sends and wait reception for a ICM msg between two subnets. **Flags:** ```bash -h, --help help for teleporter --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### deploy Deploys ICM Messenger and Registry into a given L1. **Usage:** ```bash avalanche teleporter deploy [subcommand] [flags] ``` **Flags:** ```bash --blockchain string deploy ICM into the given CLI blockchain --blockchain-id string deploy ICM into the given blockchain ID/Alias --c-chain deploy ICM into C-Chain --cchain-key string key to be used to pay fees to deploy ICM to C-Chain --cluster string operate on the given cluster --deploy-messenger deploy ICM Messenger (default true) --deploy-registry deploy ICM Registry (default true) --devnet operate on a devnet network --endpoint string use the given endpoint for network operations --force-registry-deploy deploy ICM Registry even if Messenger has already been deployed -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key to fund ICM deploy -h, --help help for deploy --include-cchain deploy ICM also to C-Chain --key string CLI stored key to use to fund ICM deploy -l, --local operate on a local network --messenger-contract-address-path string path to a messenger contract address file --messenger-deployer-address-path string path to a messenger deployer address file --messenger-deployer-tx-path string path to a messenger deployer tx file --private-key string private key to use to fund ICM deploy --registry-bytecode-path string path to a registry bytecode file --rpc-url string use the given RPC URL to connect to the subnet -t, --testnet fuji operate on testnet (alias to fuji) --version string version to deploy (default "latest") --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### sendMsg Sends and wait reception for a ICM msg between two subnets. **Usage:** ```bash avalanche teleporter sendMsg [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --dest-rpc string use the given destination blockchain rpc endpoint --destination-address string deliver the message to the given contract destination address --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet --genesis-key use genesis allocated key as message originator and to pay source blockchain fees -h, --help help for sendMsg --hex-encoded given message is hex encoded --key string CLI stored key to use as message originator and to pay source blockchain fees -l, --local operate on a local network --private-key string private key to use as message originator and to pay source blockchain fees --source-rpc string use the given source blockchain rpc endpoint -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche transaction The transaction command suite provides all of the utilities required to sign multisig transactions. **Usage:** ```bash avalanche transaction [subcommand] [flags] ``` **Subcommands:** - [`commit`](#avalanche-transaction-commit): The transaction commit command commits a transaction by submitting it to the P-Chain. - [`sign`](#avalanche-transaction-sign): The transaction sign command signs a multisig transaction. **Flags:** ```bash -h, --help help for transaction --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### commit The transaction commit command commits a transaction by submitting it to the P-Chain. **Usage:** ```bash avalanche transaction commit [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for commit --input-tx-filepath string Path to the transaction signed by all signatories --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### sign The transaction sign command signs a multisig transaction. **Usage:** ```bash avalanche transaction sign [subcommand] [flags] ``` **Flags:** ```bash -h, --help help for sign --input-tx-filepath string Path to the transaction file for signing -k, --key string select the key to use [fuji only] -g, --ledger use ledger instead of key (always true on mainnet, defaults to false on fuji) --ledger-addrs strings use the given ledger addresses --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche update Check if an update is available, and prompt the user to install it **Usage:** ```bash avalanche update [subcommand] [flags] ``` **Flags:** ```bash -c, --confirm Assume yes for installation -h, --help help for update -v, --version version for update --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ## avalanche validator The validator command suite provides a collection of tools for managing validator balance on P-Chain. Validator's balance is used to pay for continuous fee to the P-Chain. When this Balance reaches 0, the validator will be considered inactive and will no longer participate in validating the L1 **Usage:** ```bash avalanche validator [subcommand] [flags] ``` **Subcommands:** - [`getBalance`](#avalanche-validator-getbalance): This command gets the remaining validator P-Chain balance that is available to pay P-Chain continuous fee - [`increaseBalance`](#avalanche-validator-increasebalance): This command increases the validator P-Chain balance - [`list`](#avalanche-validator-list): This command gets a list of the validators of the L1 **Flags:** ```bash -h, --help help for validator --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### getBalance This command gets the remaining validator P-Chain balance that is available to pay P-Chain continuous fee **Usage:** ```bash avalanche validator getBalance [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for getBalance --l1 string name of L1 -l, --local operate on a local network -m, --mainnet operate on mainnet --node-id string node ID of the validator -t, --testnet fuji operate on testnet (alias to fuji) --validation-id string validation ID of the validator --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### increaseBalance This command increases the validator P-Chain balance **Usage:** ```bash avalanche validator increaseBalance [subcommand] [flags] ``` **Flags:** ```bash --balance float amount of AVAX to increase validator's balance by --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for increaseBalance -k, --key string select the key to use [fuji/devnet deploy only] --l1 string name of L1 (to increase balance of bootstrap validators only) -l, --local operate on a local network -m, --mainnet operate on mainnet --node-id string node ID of the validator -t, --testnet fuji operate on testnet (alias to fuji) --validation-id string validationIDStr of the validator --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` ### list This command gets a list of the validators of the L1 **Usage:** ```bash avalanche validator list [subcommand] [flags] ``` **Flags:** ```bash --cluster string operate on the given cluster --devnet operate on a devnet network --endpoint string use the given endpoint for network operations -f, --fuji testnet operate on fuji (alias to testnet -h, --help help for list -l, --local operate on a local network -m, --mainnet operate on mainnet -t, --testnet fuji operate on testnet (alias to fuji) --config string config file (default is $HOME/.avalanche-cli/config.json) --log-level string log level for the application (default "ERROR") --skip-update-check skip check for new versions ``` # Data API vs RPC (/docs/api-reference/data-api/data-vs-rpc) --- title: Data API vs RPC description: Comparison of the Data API and RPC methods icon: Server --- In the rapidly evolving world of Web3 development, efficiently retrieving token balances for a user's address is a fundamental requirement. Whether you're building DeFi platforms, wallets, analytics tools, or exchanges, displaying accurate token balances is crucial for user engagement and trust. A typical use case involves showing a user's token portfolio in a wallet application, in this case, we have sAvax and USDC. title Developers generally have two options to fetch this data: 1. **Using RPC methods to index blockchain data on their own** 2. **Leveraging an indexer provider like the Data API** While both methods aim to achieve the same goal, the Data API offers a more efficient, scalable, and developer-friendly solution. This article delves into why using the Data API is better than relying on traditional RPC (Remote Procedure Call) methods. ### What Are RPC methods and their challenges? Remote Procedure Call (RPC) methods allow developers to interact directly with blockchain nodes. One of their key advantages is that they are standardized and universally understood by blockchain developers across different platforms. With RPC, you can perform tasks such as querying data, submitting transactions, and interacting with smart contracts. These methods are typically low-level and synchronous, meaning they require a deep understanding of the blockchain’s architecture and specific command structures. You can refer to the [official documentation](https://ethereum.org/en/developers/docs/apis/json-rpc/) to gain a more comprehensive understanding of the JSON-RPC API. Here’s an example using the `eth_getBalance` method to retrieve the native balance of a wallet: ```bash curl --location 'https://api.avax.network/ext/bc/C/rpc' \ --header 'Content-Type: application/json' \ --data '{"method":"eth_getBalance","params":["0x8ae323046633A07FB162043f28Cea39FFc23B50A", "latest"],"id":1,"jsonrpc":"2.0"}' ``` This call returns the following response: ```json { "jsonrpc": "2.0", "id": 1, "result": "0x284476254bc5d594" } ``` The balance in this wallet is 2.9016 AVAX. However, despite the wallet holding multiple tokens such as USDC, the `eth_getBalance` method only returns the AVAX amount and it does so in Wei and in hexadecimal format. This is not particularly human-readable, adding to the challenge for developers who need to manually convert the balance to a more understandable format. #### No direct RPC methods to retrieve token balances Despite their utility, RPC methods come with significant limitations when it comes to retrieving detailed token and transaction data. Currently, RPC methods do not provide direct solutions for the following: * **Listing all tokens held by a wallet**: There is no RPC method that provides a complete list of ERC-20 tokens owned by a wallet. * **Retrieving all transactions for a wallet**: : There is no direct method for fetching all transactions associated with a wallet. * **Getting ERC-20/721/1155 token balances**: The `eth_getBalance` method only returns the balance of the wallet’s native token (such as AVAX on Avalanche) and cannot be used to retrieve ERC-20/721/1155 token balances. To achieve these tasks using RPC methods alone, you would need to: * **Query every block for transaction logs**: Scan the entire blockchain, which is resource-intensive and impractical. * **Parse transaction logs**: Identify and extract ERC-20 token transfer events from each transaction. * **Aggregate data**: Collect and process this data to compute balances and transaction histories. #### Manual blockchain indexing is difficult and costly Using RPC methods to fetch token balances involves an arduous process: 1. You must connect to a node and subscribe to new block events. 2. For each block, parse every transaction to identify ERC-20 token transfers involving the user's address. 3. Extract contract addresses and other relevant data from the parsed transactions. 4. Compute balances by processing transfer events. 5. Store the processed data in a database for quick retrieval and aggregation. #### Why this is difficult: * **Resource-Intensive**: Requires significant computational power and storage to process and store blockchain data. * **Time-consuming**: Processing millions of blocks and transactions can take an enormous amount of time. * **Complexity**: Handling edge cases like contract upgrades, proxy contracts, and non-standard implementations adds layers of complexity. * **Maintenance**: Keeping the indexed data up-to-date necessitates continuous synchronization with new blocks being added to the blockchain. * **High Costs**: Associated with servers, databases, and network bandwidth. ### The Data API Advantage The Data API provides a streamlined, efficient, and scalable solution for fetching token balances. Here's why it's the best choice: With a single API call, you can retrieve all ERC-20 token balances for a user's address: ```javascript avalancheSDK.data.evm.balances.listErc20Balances({ address: "0xYourAddress", }); ``` Sample Response: ```json { "erc20TokenBalances": [ { "ercType": "ERC-20", "chainId": "43114", "address": "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", "name": "USD Coin", "symbol": "USDC", "decimals": 6, "price": { "value": 1.0, "currencyCode": "usd" }, "balance": "15000000", "balanceValue": { "currencyCode": "usd", "value": 9.6 }, "logoUri": "https://images.ctfassets.net/gcj8jwzm6086/e50058c1-2296-4e7e-91ea-83eb03db95ee/8db2a492ce64564c96de87c05a3756fd/43114-0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E.png" } // Additional tokens... ] } ``` As you can see with a single call the API returns an array of token balances for all the wallet tokens, including: * **Token metadata**: Contract address, name, symbol, decimals. * **Balance information**: Token balance in both hexadecimal and decimal formats, Also retrieves balances of native assets like ETH or AVAX. * **Price data**: Current value in USD or other supported currencies, saving you the effort of integrating another API. * **Visual assets**: Token logo URI for better user interface integration. If you’re building a wallet, DeFi app, or any application that requires displaying balances, transaction history, or smart contract interactions, relying solely on RPC methods can be challenging. Just as there’s no direct RPC method to retrieve token balances, there’s also no simple way to fetch all transactions associated with a wallet, especially for ERC-20, ERC-721, or ERC-1155 token transfers. However, by using the Data API, you can retrieve all token transfers for a given wallet **with a single API call**, making the process much more efficient. This approach simplifies tracking and displaying wallet activity without the need to manually scan the entire blockchain. Below are two examples that demonstrate the power of the Data API: in the first, it returns all ERC transfers, including ERC-20, ERC-721, and ERC-1155 tokens, and in the second, it shows all internal transactions, such as when one contract interacts with another. [Lists ERC transfers](/data-api/evm-transactions/list-erc-transfers) for an ERC-20, ERC-721, or ERC-1155 contract address. ```javascript theme={null} import { Avalanche } from "@avalanche-sdk/chainkit"; const avalancheSDK = new Avalanche({ apiKey: "", chainId: "43114", network: "mainnet", }); async function run() { const result = await avalancheSDK.data.evm.transactions.listTransfers({ startBlock: 6479329, endBlock: 6479330, pageSize: 10, address: "0x71C7656EC7ab88b098defB751B7401B5f6d8976F", }); for await (const page of result) { // Handle the page console.log(page); } } run(); ``` Example response ```json theme={null} { "nextPageToken": "", "transfers": [ { "blockNumber": "339", "blockTimestamp": 1648672486, "blockHash": "0x17533aeb5193378b9ff441d61728e7a2ebaf10f61fd5310759451627dfca2e7c", "txHash": "0x3e9303f81be00b4af28515dab7b914bf3dbff209ea10e7071fa24d4af0a112d4", "from": { "name": "Wrapped AVAX", "symbol": "WAVAX", "decimals": 18, "logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg", "address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F" }, "to": { "name": "Wrapped AVAX", "symbol": "WAVAX", "decimals": 18, "logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg", "address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F" }, "logIndex": 123, "value": "10000000000000000000", "erc20Token": { "address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F", "name": "Wrapped AVAX", "symbol": "WAVAX", "decimals": 18, "logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg", "ercType": "ERC-20", "price": { "currencyCode": "usd", "value": "42.42" } } } ] } ``` [Returns a list of internal transactions](/data-api/evm-transactions/list-internal-transactions) for an address and chain. Filterable by block range. ```javascript theme={null} import { Avalanche } from "@avalanche-sdk/chainkit"; const avalancheSDK = new Avalanche({ apiKey: "", chainId: "43114", network: "mainnet", }); async function run() { const result = await avalancheSDK.data.evm.transactions.listInternalTransactions({ startBlock: 6479329, endBlock: 6479330, pageSize: 10, address: "0x71C7656EC7ab88b098defB751B7401B5f6d8976F", }); for await (const page of result) { // Handle the page console.log(page); } } run(); ``` Example response ```json theme={null} { "nextPageToken": "", "transactions": [ { "blockNumber": "339", "blockTimestamp": 1648672486, "blockHash": "0x17533aeb5193378b9ff441d61728e7a2ebaf10f61fd5310759451627dfca2e7c", "txHash": "0x3e9303f81be00b4af28515dab7b914bf3dbff209ea10e7071fa24d4af0a112d4", "from": { "name": "Wrapped AVAX", "symbol": "WAVAX", "decimals": 18, "logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg", "address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F" }, "to": { "name": "Wrapped AVAX", "symbol": "WAVAX", "decimals": 18, "logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg", "address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F" }, "internalTxType": "UNKNOWN", "value": "10000000000000000000", "isReverted": true, "gasUsed": "", "gasLimit": "" } ] } ``` ### Conclusion Using the Data API over traditional RPC methods for fetching token balances offers significant advantages: * **Efficiency**: Retrieve all necessary information in a single API call. * **Simplicity**: Eliminates complex data processing and reduces development time. * **Scalability**: Handles large volumes of data efficiently, suitable for real-time applications. * **Comprehensive Data**: Provides enriched information, including token prices and logos. * **Reliability**: Ensures data accuracy and consistency without the need for extensive error handling. For developers building Web3 applications, leveraging the Data API is the smarter choice. It not only simplifies your codebase but also enhances the user experience by providing accurate and timely data. If you’re building cutting-edge Web3 applications, this API is the key to improving your workflow and performance. Whether you’re developing DeFi solutions, wallets, or analytics platforms, take your project to the next level. [Start today with the Data API](/data-api/getting-started) and experience the difference! # Getting Started (/docs/api-reference/data-api/getting-started) --- title: Getting Started description: Getting Started with the Data API icon: Book --- To begin, create your free account by visiting [Builder Hub Console](https://build.avax.network/login?callbackUrl=%2Fconsole%2Futilities%2Fdata-api-keys). Once the account is created: 1. Navigating to [**Data API Keys**](https://build.avax.network/console/utilities/data-api-keys) 2. Click on **Create API Key** 3. Set an alias and click on **create** 4. Copy the the value Always keep your API keys in a secure environment. Never expose them in public repositories, such as GitHub, or share them with unauthorized individuals. Compromised API keys can lead to unauthorized access and potential misuse of your account. With your API Key you can start making queries, for example to get the latest block on the C-chain(43114): ```bash theme={null} curl --location 'https://data-api.avax.network/v1/chains/43114/blocks' \ --header 'accept: application/json' \ --header 'x-glacier-api-key: ' \ ``` And you should see something like this: ```json theme={null} { "blocks": [ { "blockNumber": "49889407", "blockTimestamp": 1724990250, "blockHash": "0xd34becc82943e3e49048cdd3f75b80a87e44eb3aed6b87cc06867a7c3b9ee213", "txCount": 1, "baseFee": "25000000000", "gasUsed": "53608", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0xf4917efb4628a1d8f4d101b3d15bce9826e62ef2c93c3e16ee898d27cf02f3d4", "feesSpent": "1435117553916960", "cumulativeTransactions": "500325352" }, { "blockNumber": "49889406", "blockTimestamp": 1724990248, "blockHash": "0xf4917efb4628a1d8f4d101b3d15bce9826e62ef2c93c3e16ee898d27cf02f3d4", "txCount": 2, "baseFee": "25000000000", "gasUsed": "169050", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0x2a54f142fa3acee92a839b071bb6c7cca7abc2a797cf4aac68b07f79406ac0cb", "feesSpent": "4226250000000000", "cumulativeTransactions": "500325351" }, { "blockNumber": "49889405", "blockTimestamp": 1724990246, "blockHash": "0x2a54f142fa3acee92a839b071bb6c7cca7abc2a797cf4aac68b07f79406ac0cb", "txCount": 4, "baseFee": "25000000000", "gasUsed": "618638", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0x0cda1bb5c86e790976c9330c9fc26e241a705afbad11a4caa44df1c81058451d", "feesSpent": "16763932426044724", "cumulativeTransactions": "500325349" }, { "blockNumber": "49889404", "blockTimestamp": 1724990244, "blockHash": "0x0cda1bb5c86e790976c9330c9fc26e241a705afbad11a4caa44df1c81058451d", "txCount": 3, "baseFee": "25000000000", "gasUsed": "254544", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0x60e55dd9eacc095c07f50a73e02d81341c406584f7abbf5d10d938776a4c893c", "feesSpent": "6984642298020000", "cumulativeTransactions": "500325345" }, { "blockNumber": "49889403", "blockTimestamp": 1724990242, "blockHash": "0x60e55dd9eacc095c07f50a73e02d81341c406584f7abbf5d10d938776a4c893c", "txCount": 2, "baseFee": "25000000000", "gasUsed": "65050", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0xa3e9f91f45a85ed00b8ebe8e5e976ed1a1f52612143eddd3de9d2588d05398b8", "feesSpent": "1846500000000000", "cumulativeTransactions": "500325342" }, { "blockNumber": "49889402", "blockTimestamp": 1724990240, "blockHash": "0xa3e9f91f45a85ed00b8ebe8e5e976ed1a1f52612143eddd3de9d2588d05398b8", "txCount": 2, "baseFee": "25000000000", "gasUsed": "74608", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0x670db772edfc2fdae322d55473ba0670690aed6358a067a718492c819d63356a", "feesSpent": "1997299851936960", "cumulativeTransactions": "500325340" }, { "blockNumber": "49889401", "blockTimestamp": 1724990238, "blockHash": "0x670db772edfc2fdae322d55473ba0670690aed6358a067a718492c819d63356a", "txCount": 1, "baseFee": "25000000000", "gasUsed": "273992", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0x75742cf45383ce54823690b9dd2e85a743be819281468163d276f145d077902a", "feesSpent": "7334926295195040", "cumulativeTransactions": "500325338" }, { "blockNumber": "49889400", "blockTimestamp": 1724990236, "blockHash": "0x75742cf45383ce54823690b9dd2e85a743be819281468163d276f145d077902a", "txCount": 1, "baseFee": "25000000000", "gasUsed": "291509", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0xe5055eae3e1fd2df24b61e9c691f756c97e5619cfc66b69cbcb6025117d1bde7", "feesSpent": "7724988500000000", "cumulativeTransactions": "500325337" }, { "blockNumber": "49889399", "blockTimestamp": 1724990234, "blockHash": "0xe5055eae3e1fd2df24b61e9c691f756c97e5619cfc66b69cbcb6025117d1bde7", "txCount": 8, "baseFee": "25000000000", "gasUsed": "824335", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0xbcacff928f7dd20cc1522155e7c9b9716997914b53ab94034b813c3f207174ef", "feesSpent": "21983004380692400", "cumulativeTransactions": "500325336" }, { "blockNumber": "49889398", "blockTimestamp": 1724990229, "blockHash": "0xbcacff928f7dd20cc1522155e7c9b9716997914b53ab94034b813c3f207174ef", "txCount": 1, "baseFee": "25000000000", "gasUsed": "21000", "gasLimit": "15000000", "gasCost": "0", "parentHash": "0x0b686812078429d33e4224d2b48bd26b920db8dbb464e7f135d980759ca7e947", "feesSpent": "562182298020000", "cumulativeTransactions": "500325328" } ], "nextPageToken": "9f9e1d25-14a9-49f4-8742-fd4bf12f7cd8" } ``` Congratulations! You’ve successfully set up your account and made your first query to the Data API 🚀🚀🚀 # Data API (/docs/api-reference/data-api) --- title: Data API description: Access comprehensive blockchain data for Avalanche networks icon: Database --- ### What is the Data API? The Data API provides web3 application developers with multi-chain data related to Avalanche's primary network, Avalanche L1s, and Ethereum. With the Data API, you can easily build products that leverage real-time and historical transaction and transfer history, native and token balances, and various types of token metadata. Data API The [Data API](/docs/api-reference/data-api), along with the [Metrics API](/docs/api-reference/metrics-api), are the engines behind the [Avalanche Explorer](https://subnets.avax.network/stats/) and the [Core wallet](https://core.app/en/). They are used to display transactions, logs, balances, NFTs, and more. The data and visualizations presented are all powered by these APIs, offering real-time and historical insights that are essential for building sophisticated, data-driven blockchain products. ### Features * **Extensive L1 Support**: Gain access to data from over 100+ L1s across both mainnet and testnet. If an L1 is listed on the [Avalanche Explorer](https://subnets.avax.network/), you can query its data using the Data API. * **Transactions and UTXOs**: easily retrieve details related to transactions, UTXOs, and token transfers from Avalanche EVMs, Ethereum, and Avalanche's Primary Network - the P-Chain, X-Chain and C-Chain. * **Blocks**: retrieve latest blocks and block details * **Balances**: fetch balances of native, ERC-20, ERC-721, and ERC-1155 tokens along with relevant metadata. * **Tokens**: augment your user experience with asset details. * **Staking**: get staking related data for active and historical validations. ### Supported Chains Avalanche’s architecture supports a diverse ecosystem of interconnected L1 blockchains, each operating independently while retaining the ability to seamlessly communicate with other L1s within the network. Central to this architecture is the Primary Network—Avalanche’s foundational network layer, which all validators are required to validate prior to [ACP-77](/docs/acps/77-reinventing-subnets). The Primary Network runs three essential blockchains: * The Contract Chain (C-Chain) * The Platform Chain (P-Chain) * The Exchange Chain (X-Chain) However, with the implementation of [ACP-77](/docs/acps/77-reinventing-subnets), this requirement will change. Subnet Validators will be able to operate independently of the Primary Network, allowing for more flexible and affordable Subnet creation and management. The **Data API** supports a wide range of L1 blockchains (**over 100**) across both **mainnet** and **testnet**, including popular ones like Beam, DFK, Lamina1, Dexalot, Shrapnel, and Pulsar. In fact, every L1 you see on the [Avalanche Explorer](https://explorer.avax.network/) can be queried through the Data API. This list is continually expanding as we keep adding more L1s. For a full list of supported chains, visit [List chains](/docs/api-reference/data-api/evm-chains/supportedChains). #### The Contract Chain (C-Chain) The C-Chain is an implementation of the Ethereum Virtual Machine (EVM). The primary network endpoints only provide information related to C-Chain atomic memory balances and import/export transactions. For additional data, please reference the [EVM APIs](/docs/rpcs/c-chain/rpc). #### The Platform Chain (P-Chain) The P-Chain is responsible for all validator and L1-level operations. The P-Chain supports the creation of new blockchains and L1s, the addition of validators to L1s, staking operations, and other platform-level operations. #### The Exchange Chain (X-Chain) The X-Chain is responsible for operations on digital smart assets known as Avalanche Native Tokens. A smart asset is a representation of a real-world resource (for example, equity, or a bond) with sets of rules that govern its behavior, like "can’t be traded until tomorrow." The X-Chain supports the creation and trade of Avalanche Native Tokens. | Feature | Description | | :--------------- | :--------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------- | | **Chains** | Utilize this endpoint to retrieve the Primary Network chains that an address has transaction history associated with. | | **Blocks** | Blocks are the container for transactions executed on the Primary Network. Retrieve the latest blocks, a specific block by height or hash, or a list of blocks proposed by a specified NodeID on Primary Network chains. | | **Vertices** | Prior to Avalanche Cortina (v1.10.0), the X-Chain functioned as a DAG with vertices rather than blocks. These endpoints allow developers to retrieve historical data related to that period of chain history. Retrieve the latest vertices, a specific vertex, or a list of vertices at a specific height from the X-Chain. | | **Transactions** | Transactions are a user's primary form of interaction with a chain and provide details around their on-chain activity, including staking-related behavior. Retrieve a list of the latest transactions, a specific transaction, a list of active staking transactions for a specified address, or a list of transactions associated with a provided asset id from Primary Network chains. | | **UTXOs** | UTXOs are fundamental elements that denote the funds a user has available. Get a list of UTXOs for provided addresses from the Primary Network chains. | | **Balances** | User balances are an essential function of the blockchain. Retrieve balances related to the X and P-Chains, as well as atomic memory balances for the C-Chain. | | **Rewards** | Staking is the process where users lock up their tokens to support a blockchain network and, in return, receive rewards. It is an essential part of proof-of-stake (PoS) consensus mechanisms used by many blockchain networks, including Avalanche. Using the Data API, you can easily access pending and historical rewards associated with a set of addresses. | | **Assets** | Get asset details corresponding to the given asset id on the X-Chain. | #### EVM The C-Chain is an instance of the Coreth Virtual Machine, and many Avalanche L1s are instances of the *Subnet-EVM*, which is a Virtual Machine (VM) that defines the L1 Contract Chains. *Subnet-EVM* is a simplified version of *Coreth VM* (C-Chain). | Feature | Description | | :--------------- | :------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------ | | **Chains** | There are a number of chains supported by the Data API. These endpoints can be used to understand which chains are included/indexed as part of the API and retrieve information related to a specific chain. | | **Blocks** | Blocks are the container for transactions executed within the EVM. Retrieve the latest blocks or a specific block by height or hash. | | **Transactions** | Transactions are a user's primary form of interaction with a chain and provide details around their on-chain activity. These endpoints can be used to retrieve information related to specific transaction details, internal transactions, contract deployments, specific token standard transfers, and more! | | **Balances** | User balances are an essential function of the blockchain. Easily retrieve native token, collectible, and fungible token balances related to an EVM chain with these endpoints. | #### Operations The Operations API allows users to easily access their on-chain history by creating transaction exports returned in a CSV format. This API supports EVMs as well as non-EVM Primary Network chains. # Rate Limits (/docs/api-reference/data-api/rate-limits) --- title: Rate Limits description: Rate Limits for the Data API icon: Clock --- Rate limiting is managed through a weighted scoring system, known as Compute Units (CUs). Each API request consumes a specified number of CUs, determined by the complexity of the request. This system is designed to accommodate basic requests while efficiently handling more computationally intensive operations. ## Rate Limit Tiers The maximum CUs (rate-limiting score) for a user depends on their subscription level and is delineated in the following table: | Subscription Level | Per Minute Limit (CUs) | Per Day Limit (CUs) | | :----------------- | :--------------------- | :------------------ | | Unauthenticated | 6,000 | 1,200,000 | | Free | 8,000 | 2,000,000 | | Base | 10,000 | 3,750,000 | | Growth | 14,000 | 11,200,000 | | Pro | 20,000 | 25,000,000 | To update your subscription level use the [AvaCloud Portal](https://app.avacloud.io/) Note: Rate limits apply collectively across both Webhooks and Data APIs, with usage from each counting toward your total CU limit. ## Rate Limit Categories The CUs for each category are defined in the following table: | Weight | CU Value | | :----- | :------- | | Free | 1 | | Small | 10 | | Medium | 20 | | Large | 50 | | XL | 100 | | XXL | 200 | ## Rate Limits for Data API Endpoints The CUs for each route are defined in the table below: | Endpoint | Method | Weight | CU Value | | :-------------------------------------------------------------------------------- | :----- | :----- | :------- | | `/v1/health-check` | GET | Medium | 20 | | `/v1/address/{address}/chains` | GET | Medium | 20 | | `/v1/transactions` | GET | Medium | 20 | | `/v1/blocks` | GET | Medium | 20 | | `/v1/chains/{chainId}/nfts/collections/{address}/tokens/{tokenId}:reindex` | POST | Small | 10 | | `/v1/chains/{chainId}/nfts/collections/{address}/tokens` | GET | Medium | 20 | | `/v1/chains/{chainId}/nfts/collections/{address}/tokens/{tokenId}` | GET | Medium | 20 | | `/v1/operations/{operationId}` | GET | Small | 10 | | `/v1/operations/transactions:export` | POST | Medium | 20 | | `/v1/networks/{network}/blockchains/{blockchainId}/transactions/{txHash}` | GET | Medium | 20 | | `/v1/networks/{network}/blockchains/{blockchainId}/transactions` | GET | XL | 100 | | `/v1/networks/{network}/blockchains/{blockchainId}/transactions:listStaking` | GET | XL | 100 | | `/v1/networks/{network}/rewards:listPending` | GET | XL | 100 | | `/v1/networks/{network}/rewards` | GET | XL | 100 | | `/v1/networks/{network}/blockchains/{blockchainId}/utxos` | GET | XL | 100 | | `/v1/networks/{network}/blockchains/{blockchainId}/balances` | GET | XL | 100 | | `/v1/networks/{network}/blockchains/{blockchainId}/blocks/{blockId}` | GET | XL | 100 | | `/v1/networks/{network}/blockchains/{blockchainId}/nodes/{nodeId}/blocks` | GET | Medium | 20 | | `/v1/networks/{network}/blockchains/{blockchainId}/blocks` | GET | Medium | 20 | | `/v1/networks/{network}/blockchains/{blockchainId}/vertices` | GET | Medium | 20 | | `/v1/networks/{network}/blockchains/{blockchainId}/vertices/{vertexHash}` | GET | Medium | 20 | | `/v1/networks/{network}/blockchains/{blockchainId}/vertices:listByHeight` | GET | Medium | 20 | | `/v1/networks/{network}/blockchains/{blockchainId}/assets/{assetId}` | GET | XL | 100 | | `/v1/networks/{network}/blockchains/{blockchainId}/assets/{assetId}/transactions` | GET | XL | 100 | | `/v1/networks/{network}/addresses:listChainIds` | GET | XL | 100 | | `/v1/networks/{network}` | GET | XL | 100 | | `/v1/networks/{network}/blockchains` | GET | Medium | 20 | | `/v1/networks/{network}/subnets` | GET | Medium | 20 | | `/v1/networks/{network}/subnets/{subnetId}` | GET | Medium | 20 | | `/v1/networks/{network}/validators` | GET | Medium | 20 | | `/v1/networks/{network}/validators/{nodeId}` | GET | Medium | 20 | | `/v1/networks/{network}/delegators` | GET | Medium | 20 | | `/v1/networks/{network}/l1Validators` | GET | Medium | 20 | | `/v1/teleporter/messages/{messageId}` | GET | Medium | 20 | | `/v1/teleporter/messages` | GET | Medium | 20 | | `/v1/teleporter/addresses/{address}/messages` | GET | Medium | 20 | | `/v1/icm/messages/{messageId}` | GET | Medium | 20 | | `/v1/icm/messages` | GET | Medium | 20 | | `/v1/icm/addresses/{address}/messages` | GET | Medium | 20 | | `/v1/apiUsageMetrics` | GET | XXL | 200 | | `/v1/apiLogs` | GET | XXL | 200 | | `/v1/subnetRpcUsageMetrics` | GET | XXL | 200 | | `/v1/rpcUsageMetrics` | GET | XXL | 200 | | `/v1/primaryNetworkRpcUsageMetrics` | GET | XXL | 200 | | `/v1/signatureAggregator/{network}/aggregateSignatures` | POST | Medium | 20 | | `/v1/signatureAggregator/{network}/aggregateSignatures/{txHash}` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/balances:getNative` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/balances:listErc20` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/balances:listErc721` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/balances:listErc1155` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/balances:listCollectibles` | GET | Medium | 20 | | `/v1/chains/{chainId}/blocks` | GET | Small | 10 | | `/v1/chains/{chainId}/blocks/{blockId}` | GET | Small | 10 | | `/v1/chains/{chainId}/contracts/{address}/transactions:getDeployment` | GET | Medium | 20 | | `/v1/chains/{chainId}/contracts/{address}/deployments` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}` | GET | Medium | 20 | | `/v1/chains` | GET | Free | 1 | | `/v1/chains/{chainId}` | GET | Free | 1 | | `/v1/chains/address/{address}` | GET | Free | 1 | | `/v1/chains/allTransactions` | GET | Free | 1 | | `/v1/chains/allBlocks` | GET | Free | 1 | | `/v1/chains/{chainId}/tokens/{address}/transfers` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/transactions` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/transactions:listNative` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/transactions:listErc20` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/transactions:listErc721` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/transactions:listErc1155` | GET | Medium | 20 | | `/v1/chains/{chainId}/addresses/{address}/transactions:listInternals` | GET | Medium | 20 | | `/v1/chains/{chainId}/transactions/{txHash}` | GET | Medium | 20 | | `/v1/chains/{chainId}/blocks/{blockId}/transactions` | GET | Medium | 20 | | `/v1/chains/{chainId}/transactions` | GET | Medium | 20 | ## Rate Limits for RPC endpoints The CUs for RPC calls are calculated based on the RPC method(s) within the request. The CUs assigned to each method are defined in the table below: | Method | Weight | CU Value | | :---------------------------------------- | :----- | :------- | | `eth_accounts` | Free | 1 | | `eth_blockNumber` | Small | 10 | | `eth_call` | Small | 10 | | `eth_coinbase` | Small | 10 | | `eth_chainId` | Free | 1 | | `eth_gasPrice` | Small | 10 | | `eth_getBalance` | Small | 10 | | `eth_getBlockByHash` | Small | 10 | | `eth_getBlockByNumber` | Small | 10 | | `eth_getBlockTransactionCountByNumber` | Medium | 20 | | `eth_getCode` | Medium | 20 | | `eth_getLogs` | XXL | 200 | | `eth_getStorageAt` | Medium | 20 | | `eth_getTransactionByBlockNumberAndIndex` | Medium | 20 | | `eth_getTransactionByHash` | Small | 10 | | `eth_getTransactionCount` | Small | 10 | | `eth_getTransactionReceipt` | Small | 10 | | `eth_signTransaction` | Medium | 20 | | `eth_sendTransaction` | Medium | 20 | | `eth_sign` | Medium | 20 | | `eth_sendRawTransaction` | Small | 10 | | `eth_syncing` | Free | 1 | | `net_listening` | Free | 1 | | `net_peerCount` | Medium | 20 | | `net_version` | Free | 1 | | `web3_clientVersion` | Small | 10 | | `web3_sha3` | Small | 10 | | `eth_newPendingTransactionFilter` | Medium | 20 | | `eth_maxPriorityFeePerGas` | Small | 10 | | `eth_baseFee` | Small | 10 | | `rpc_modules` | Free | 1 | | `eth_getChainConfig` | Small | 10 | | `eth_feeConfig` | Small | 10 | | `eth_getActivePrecompilesAt` | Small | 10 | All rate limits, weights, and CU values are subject to change. # Snowflake Datashare (/docs/api-reference/data-api/snowflake) --- title: Snowflake Datashare description: Snowflake Datashare for Avalanche blockchain data icon: Snowflake --- Avalanche Primary Network data (C-chain, P-chain, and X-chain blockchains) can be accessed in a sql-based table format via the [Snowflake Data Marketplace.](https://app.snowflake.com/marketplace) Explore the blockchain state since the Genesis Block. These tables provide insights on transaction gas fees, DeFi activity, the historical stake of validators on the primary network, AVAX emissions rewarded to past validators/delegators, and fees paid by Avalanche L1 Validators to the primary network. ## Available Blockchain Data #### Primary Network * **C-chain:** * Blocks * Transactions * Logs * Internal Transactions * Receipts * Messages * **P-chain:** * Blocks * Transactions * UTXOs * **X-chain:** * Blocks * Transactions * Vertices before the [X-chain Linearization](https://www.avax.network/blog/cortina-x-chain-linearization) in the Cortina Upgrade * **Dictionary:** A data dictionary is provided with the listing with column and table descriptions. Example columns include: * `c_blocks.blockchash` * `c_transactions.transactionfrom` * `c_logs.topichex_0` * `p_blocks.block_hash` * `p_blocks.block_index` * `p_blocks.type` * `p_transactions.timestamp` * `p_transactions.transaction_hash` * `utxos.utxo_id` * `utxos.address` * `vertices.vertex_hash` * `vertices.parent_hash` * `x_blocks.timestamp` * `x_blocks.proposer_id` * `x_transactions.transaction_hash` * `x_transactions.type` #### Available Avalanche L1s * **Gunzilla** * **Dexalot** * **DeFi Kingdoms (DFK)** * **Henesys (MapleStory Universe)** #### L1 Data * Blocks * Transactions * Logs * Internal Transactions (currently unavailable for DFK) * Receipts * Messages ## Access Search for "Ava Labs" on the [Snowflake Data Marketplace](https://app.snowflake.com/marketplace). # Usage Guide (/docs/api-reference/data-api/usage) --- title: Usage Guide description: Usage Guide for the Data API icon: Code --- ### Setup and Authentication In order to utilize your accounts rate limits, you will need to make API requests with an API key. You can generate API Keys from the AvaCloud portal. Once you've created and retrieved that, you will be able to make authenticated queries by passing in your API key in the `x-glacier-api-key` header of your HTTP request. An example curl request can be found below: ```bash curl -H "Content-Type: Application/json" -H "x-glacier-api-key: your_api_key" \ "https://glacier-api.avax.network/v1/chains" ``` ### Rate Limits The Data API has rate limits in place to maintain it's stability and protect from bursts of incoming traffic. The rate limits associated with various plans can be found within AvaCloud. When you hit your rate limit, the server will respond with a 429 http response code, and response headers to help you determine when you should start to make additional requests. The response headers follow the standards set in the RateLimit header fields for HTTP draft from the Internet Engineering Task Force. With every response with a valid api key, the server will include the following headers: * `ratelimit-policy` - The rate limit policy tied to your api key. * `ratelimit-limit` - The number of requests you can send according to your policy. * `ratelimit-remaining` - How many request remaining you can send in the period for your policy For any request after the rate limit has been reached, the server will also respond with these headers: * `ratelimit-reset` * `retry-after` Both of these headers are set to the number of seconds until your period is over and requests will start succeeding again. If you start receiving rate limit errors with the 429 response code, we recommend you discontinue sending requests to the server. You should wait to retry requests for the duration specified in the response headers. Alternatively, you can implement an exponential backoff algorithm to prevent continuous errors. Failure to discontinue requests may result in being temporarily blocked from accessing the API. Error Types The Data API generates standard error responses along with error codes based on provided requests and parameters. Typically, response codes within the `2XX` range signifies successful requests, while those within the `4XX` range points to errors originating from the client's side. Meanwhile, response codes within the `5XX` range indicates problems on the server's side. ### Error Types The Glacier API generates standard error responses along with error codes based on provided requests and parameters. Typically, response codes within the `2XX` range signifies successful requests, while those within the `4XX` range points to errors originating from the client's side. Meanwhile, response codes within the `5XX` range indicates problems on the server's side. The error response body is formatted like this: ```json { "message": ["Invalid address format"], // route specific error message "error": "Bad Request", // error type "statusCode": 400 // http response code } ``` Let's go through every error code that we can respond with: | Error Code | Error Type | Description | | :--------- | :-------------------- | :---------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------------- | | **400** | Bad Request | Bad requests generally mean the client has passed invalid or malformed parameters. Error messages in the response could help in evaluating the error. | | **401** | Unauthorized | When a client attempts to access resources that require authorization credentials but the client lacks proper authentication in the request, the server responds with 401. | | **403** | Forbidden | When a client attempts to access resources with valid credentials but doesn't have the privilege to perform that action, the server responds with 403. | | **404** | Not Found | The 404 error is mostly returned when the client requests with either mistyped URL, or the passed resource is moved or deleted, or the resource doesn't exist. | | **500** | Internal Server Error | The 500 error is a generic server-side error that is returned for any uncaught and unexpected issues on the server side. This should be very rare, and you may reach out to us if the problem persists for a longer duration. | | **502** | Bad Gateway | This is an internal error indicating invalid response received by the client-facing proxy or gateway from the upstream server. | | **503** | Service Unavailable | The 503 error is returned for certain routes on a particular Subnet. This indicates an internal problem with our Subnet node, and may not necessarily mean the Subnet is down or affected. | The above list is not exhaustive of all the errors that you'll receive, but is categorized on the basis of error codes. You may see route-specific errors along with detailed error messages for better evaluating the response. Reach out to our team when you see an error in the `5XX` range for a longer duration. These errors should be very rare, but we try to fix them as soon as possible once detected. ### Pagination When utilizing pagination for endpoints that return lists of data such as transactions, UTXOs, or blocks, our API uses a straightforward mechanism to manage the navigation through large datasets. We divide data into pages and each page is limited with a `pageSize` number of elements as passed in the request. Users can navigate to subsequent pages using the page token received in the `nextPageToken` field. This method ensures efficient retrieval. Routes with pagination have a following common response format: ```json { "blocks": [""], // This field name will vary by route "nextPageToken": "3d22deea-ea64-4d30-8a1e-c2a353b67e90" } ``` ### Page Token Structure * If there's more data in the dataset for the request, the API will include a UUID-based page token in the response. This token acts as a pointer to the next page of data. * The UUID page token is generated randomly and uniquely for each pagination scenario, enhancing security and minimizing predictability. * It's important to note that the page token is only returned when a next page is present. If there's no further data to retrieve, a page token will not be included in the response. * The generated page token has an expiration window of 24 hours. Beyond this timeframe, the token will no longer be valid for accessing subsequent pages. ### Integration and Usage: To make use of the pagination system, simply examine the API response. If a UUID page token is present, it indicates the availability of additional data on the next page. You can extract this token and include it in the subsequent request to access the subsequent page of results. Please note that you must ensure that the subsequent request is made within the 24-hour timeframe after the original token's generation. Beyond this duration, the token will expire, and you will need to initiate a fresh request from the initial page. By incorporating UUID page tokens, our API offers a secure, efficient, and user-friendly approach to navigating large datasets, streamlining your data retrieval proces ### Swagger API Reference You can explore the full API definitions and interact with the endpoints in the Swagger documentation at: [https://glacier-api.avax.network/api](https://glacier-api.avax.network/api) # Complex Golang VM (/docs/avalanche-l1s/golang-vms/complex-golang-vm) --- title: Complex Golang VM description: In this tutorial, we'll walk through how to build a virtual machine by referencing the BlobVM. --- The [BlobVM](https://github.com/ava-labs/blobvm) is a virtual machine that can be used to implement a decentralized key-value store. A blob (shorthand for "binary large object") is an arbitrary piece of data. BlobVM stores a key-value pair by breaking it apart into multiple chunks stored with their hashes as their keys in the blockchain. A root key-value pair has references to these chunks for lookups. By default, the maximum chunk size is set to 200 KiB. ## Components A VM defines how a blockchain should be built. A block is populated with a set of transactions which mutate the state of the blockchain when executed. When a block with a set of transactions is applied to a given state, a state transition occurs by executing all of the transactions in the block in-order and applying it to the previous block of the blockchain. By executing a series of blocks chronologically, anyone can verify and reconstruct the state of the blockchain at an arbitrary point in time. The BlobVM repository has a few components to handle the lifecycle of tasks from a transaction being issued to a block being accepted across the network: - **Transaction**: A state transition - **Mempool**: Stores pending transactions that haven't been finalized yet - **Network**: Propagates transactions from the mempool other nodes in the network - **Block**: Defines the block format, how to verify it, and how it should be accepted or rejected across the network - **Block Builder**: Builds blocks by including transactions from the mempool - **Virtual Machine**: Application-level logic. Implements the VM interface needed to interact with Avalanche consensus and defines the blueprint for the blockchain. - **Service**: Exposes APIs so users can interact with the VM - **Factory**: Used to initialize the VM ## Lifecycle of a Transaction A VM will often times expose a set of APIs so users can interact with the it. In the blockchain, blocks can contain a set of transactions which mutate the blockchain's state. Let's dive into the lifecycle of a transaction from its issuance to its finalization on the blockchain. - A user makes an API request to `service.IssueRawTx` to issue their transaction. This API will deserialize the user's transaction and forward it to the VM - The transaction is submitted to the VM which is then added to the VM's mempool - The VM asynchronously periodically gossips new transactions in its mempool to other nodes in the network so they can learn about them - The VM sends the Avalanche consensus engine a message to indicate that it has transactions in the mempool that are ready to be built into a block - The VM proposes the block with to consensus - Consensus verifies that the block is valid and well-formed - Consensus gets the network to vote on whether the block should be accepted or rejected. If a block is rejected, its transactions are reclaimed by the mempool so they can be included in a future block. If a block is accepted, it's finalized by writing it to the blockchain. ## Coding the Virtual Machine We'll dive into a few of the packages that are in the The BlobVM repository to learn more about how they work: 1. [`vm`](https://github.com/ava-labs/blobvm/tree/master/vm) - `block_builder.go` - `chain_vm.go` - `network.go` - `service.go` - `vm.go` 2. [`chain`](https://github.com/ava-labs/blobvm/tree/master/chain) - `unsigned_tx.go` - `base_tx.go` - `transfer_tx.go` - `set_tx.go` - `tx.go` - `block.go` - `mempool.go` - `storage.go` - `builder.go` 3. [`mempool`](https://github.com/ava-labs/blobvm/tree/master/mempool) - `mempool.go` ### Transactions The state the blockchain can only be mutated by getting the network to accept a signed transaction. A signed transaction contains the transaction to be executed alongside the signature of the issuer. The signature is required to cryptographically verify the sender's identity. A VM can define an arbitrary amount of unique transactions types to support different operations on the blockchain. The BlobVM implements two different transactions types: - [TransferTx](https://github.com/ava-labs/blobvm/blob/master/chain/transfer_tx.go) - Transfers coins between accounts. - [SetTx](https://github.com/ava-labs/blobvm/blob/master/chain/set_tx.go) - Stores a key-value pair on the blockchain. #### UnsignedTransaction All transactions in the BlobVM implement the common [`UnsignedTransaction`](https://github.com/ava-labs/blobvm/blob/master/chain/unsigned_tx.go) interface, which exposes shared functionality for all transaction types. ```go type UnsignedTransaction interface { Copy() UnsignedTransaction GetBlockID() ids.ID GetMagic() uint64 GetPrice() uint64 SetBlockID(ids.ID) SetMagic(uint64) SetPrice(uint64) FeeUnits(*Genesis) uint64 // number of units to mine tx LoadUnits(*Genesis) uint64 // units that should impact fee rate ExecuteBase(*Genesis) error Execute(*TransactionContext) error TypedData() *tdata.TypedData Activity() *Activity } ``` #### BaseTx Common functionality and metadata for transaction types are implemented by [`BaseTx`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go). - [`SetBlockID`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L26) sets the transaction's block ID. - [`GetBlockID`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L22) returns the transaction's block ID. - [`SetMagic`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L34) sets the magic number. The magic number is used to differentiate chains to prevent replay attacks - [`GetMagic`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L30) returns the magic number. Magic number is defined in genesis. - [`SetPrice`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L42) sets the price per fee unit for this transaction. - [`GetPrice`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L38) returns the price for this transaction. - [`FeeUnits`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L59) returns the fee units this transaction will consume. - [`LoadUnits`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L63) identical to `FeeUnits` - [`ExecuteBase`](https://github.com/ava-labs/blobvm/blob/master/chain/base_tx.go#L46) executes common validation checks across different transaction types. This validates the transaction contains a valid block ID, magic number, and gas price as defined by genesis. #### TransferTx [`TransferTx`](https://github.com/ava-labs/blobvm/blob/master/chain/transfer_tx.go#L16) supports the transfer of tokens from one account to another. ```go type TransferTx struct { *BaseTx `serialize:"true" json:"baseTx"` // To is the recipient of the [Units]. To common.Address `serialize:"true" json:"to"` // Units are transferred to [To]. Units uint64 `serialize:"true" json:"units"` } ``` `TransferTx` embeds `BaseTx` to avoid re-implementing common operations with other transactions, but implements its own [`Execute`](https://github.com/ava-labs/blobvm/blob/master/chain/transfer_tx.go#L26) to support token transfers. This performs a few checks to ensure that the transfer is valid before transferring the tokens between the two accounts. ```go func (t *TransferTx) Execute(c *TransactionContext) error { // Must transfer to someone if bytes.Equal(t.To[:], zeroAddress[:]) { return ErrNonActionable } // This prevents someone from transferring to themselves. if bytes.Equal(t.To[:], c.Sender[:]) { return ErrNonActionable } if t.Units == 0 { return ErrNonActionable } if _, err := ModifyBalance(c.Database, c.Sender, false, t.Units); err != nil { return err } if _, err := ModifyBalance(c.Database, t.To, true, t.Units); err != nil { return err } return nil } ``` #### SetTx `SetTx` is used to assign a value to a key. ```go type SetTx struct { *BaseTx `serialize:"true" json:"baseTx"` Value []byte `serialize:"true" json:"value"` } ``` `SetTx` implements its own [`FeeUnits`](https://github.com/ava-labs/blobvm/blob/master/chain/set_tx.go#L48) method to compensate the network according to the size of the blob being stored. ```go func (s *SetTx) FeeUnits(g *Genesis) uint64 { // We don't subtract by 1 here because we want to charge extra for any // value-based interaction (even if it is small or a delete). return s.BaseTx.FeeUnits(g) + valueUnits(g, uint64(len(s.Value))) } ``` `SetTx`'s [`Execute`](https://github.com/ava-labs/blobvm/blob/master/chain/set_tx.go#L21) method performs a few safety checks to validate that the blob meets the size constraints enforced by genesis and doesn't overwrite an existing key before writing it to the blockchain. ```go func (s *SetTx) Execute(t *TransactionContext) error { g := t.Genesis switch { case len(s.Value) == 0: return ErrValueEmpty case uint64(len(s.Value)) > g.MaxValueSize: return ErrValueTooBig } k := ValueHash(s.Value) // Do not allow duplicate value setting _, exists, err := GetValueMeta(t.Database, k) if err != nil { return err } if exists { return ErrKeyExists } return PutKey(t.Database, k, &ValueMeta{ Size: uint64(len(s.Value)), TxID: t.TxID, Created: t.BlockTime, }) } ``` #### Signed Transaction The unsigned transactions mentioned previously can't be issued to the network without first being signed. BlobVM implements signed transactions by embedding the unsigned transaction alongside its signature in [`Transaction`](https://github.com/ava-labs/blobvm/blob/master/chain/tx.go). In BlobVM, a signature is defined as the [ECDSA signature](https://en.wikipedia.org/wiki/Elliptic_Curve_Digital_Signature_Algorithm) of the issuer's private key of the [KECCAK256](https://keccak.team/keccak.html) hash of the unsigned transaction's data ([digest hash](https://eips.ethereum.org/EIPS/eip-712)). ```go type Transaction struct { UnsignedTransaction `serialize:"true" json:"unsignedTransaction"` Signature []byte `serialize:"true" json:"signature"` digestHash []byte bytes []byte id ids.ID size uint64 sender common.Address } ``` The `Transaction` type wraps any unsigned transaction. When a `Transaction` is executed, it calls the `Execute` method of the underlying embedded `UnsignedTx` and performs the following sanity checks: 1. The underlying `UnsignedTx` must meet the requirements set by genesis. This includes checks to make sure that the transaction contains the correct magic number and meets the minimum gas price as defined by genesis 2. The transaction's block ID must be a recently accepted block 3. The transaction must not be a recently issued transaction 4. The issuer of the transaction must have enough gas 5. The transaction's gas price must be meet the next expected block's minimum gas price 6. The transaction must execute without error If the transaction is successfully verified, it's submitted as a pending write to the blockchain. ```go func (t *Transaction) Execute(g *Genesis, db database.Database, blk *StatelessBlock, context *Context) error { if err := t.UnsignedTransaction.ExecuteBase(g); err != nil { return err } if !context.RecentBlockIDs.Contains(t.GetBlockID()) { // Hash must be recent to be any good // Should not happen because of mempool cleanup return ErrInvalidBlockID } if context.RecentTxIDs.Contains(t.ID()) { // Tx hash must not be recently executed (otherwise could be replayed) // // NOTE: We only need to keep cached tx hashes around as long as the // block hash referenced in the tx is valid return ErrDuplicateTx } // Ensure sender has balance if _, err := ModifyBalance(db, t.sender, false, t.FeeUnits(g)*t.GetPrice()); err != nil { return err } if t.GetPrice() < context.NextPrice { return ErrInsufficientPrice } if err := t.UnsignedTransaction.Execute(&TransactionContext{ Genesis: g, Database: db, BlockTime: uint64(blk.Tmstmp), TxID: t.id, Sender: t.sender, }); err != nil { return err } if err := SetTransaction(db, t); err != nil { return err } return nil } ``` ##### Example Let's walk through an example on how to issue a `SetTx` transaction to the BlobVM to write a key-value pair. 1. Create the unsigned transaction for `SetTx` ```go utx := &chain.SetTx{ BaseTx: &chain.BaseTx{}, Value: []byte("data"), } utx.SetBlockID(lastAcceptedID) utx.SetMagic(genesis.Magic) utx.SetPrice(price + blockCost/utx.FeeUnits(genesis)) ``` 2. Calculate the [digest hash](https://github.com/ava-labs/blobvm/blob/master/chain/tx.go#L41) for the transaction. ```go digest, err := chain.DigestHash(utx) ``` 3. [Sign](https://github.com/ava-labs/blobvm/blob/master/chain/crypto.go#L17) the digest hash with the issuer's private key. ```go signature, err := chain.Sign(digest, privateKey) ``` 4. Create and initialize the new signed transaction. ```go tx := chain.NewTx(utx, sig) if err := tx.Init(g); err != nil { return ids.Empty, 0, err } ``` 5. Issue the request with the client ``` txID, err = cli.IssueRawTx(ctx, tx.Bytes()) ``` ### Mempool #### Overview The [mempool](https://github.com/ava-labs/blobvm/blob/master/mempool/mempool.go) is a buffer of volatile memory that stores pending transactions. Transactions are stored in the mempool whenever a node learns about a new transaction either through gossip with other nodes or through an API call issued by a user. The mempool is implemented as a min-max [heap](https://en.wikipedia.org/wiki/Heap_data_structure) ordered by each transaction's gas price. The mempool is created during the [initialization](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L93) of VM. ```go vm.mempool = mempool.New(vm.genesis, vm.config.MempoolSize) ``` Whenever a transaction is submitted to VM, it first gets initialized, verified, and executed locally. If the transaction looks valid, then it's added to the [mempool](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L414). #### Add Method When a transaction is added to the mempool, [`Add`](https://github.com/ava-labs/blobvm/blob/master/mempool/mempool.go#L43) is called. This performs the following: - Checks if the transaction being added already exists in the mempool or not - The transaction is added to the min-max heap - If the mempool's heap size is larger than the maximum configured value, then the lowest paying transaction is evicted - The transaction is added to the list of transactions that are able to be gossiped to other peers - A notification is sent through the in the `mempool.Pending` channel to indicate that the consensus engine should build a new block ### Block Builder #### Overview The [`TimeBuilder`](https://github.com/ava-labs/blobvm/blob/master/vm/block_builder.go) implementation for `BlockBuilder` acts as an intermediary notification service between the mempool and the consensus engine. It serves the following functions: - Periodically gossips new transactions to other nodes in the network - Periodically notifies the consensus engine that new transactions from the mempool are ready to be built into blocks `TimeBuilder` and can exist in 3 states: - `dontBuild` - There are no transactions in the mempool that are ready to be included in a block - `building` - The consensus engine has been notified that it should build a block and there are currently transactions in the mempool that are eligible to be included into a block - `mayBuild` - There are transactions in the mempool that are eligible to be included into a block, but the consensus engine has not been notified yet #### Gossip Method The [`Gossip`](https://github.com/ava-labs/blobvm/blob/master/vm/block_builder.go#L183) method initiates the gossip of new transactions from the mempool at periodically as defined by `vm.config.GossipInterval`. #### Build Method The [`Build`](https://github.com/ava-labs/blobvm/blob/master/vm/block_builder.go#L166) method consumes transactions from the mempool and signals the consensus engine when it's ready to build a block. If the mempool signals the `TimeBuilder` that it has available transactions, `TimeBuilder` will signal consensus that the VM is ready to build a block by sending the consensus engine a `common.PendingTxs` message. When the consensus engine receives the `common.PendingTxs` message it calls the VM's `BuildBlock` method. The VM will then build a block from eligible transactions in the mempool. If there are still remaining transactions in the mempool after a block is built, then the `TimeBuilder` is put into the `mayBuild` state to indicate that there are still transactions that are eligible to be built into block, but the consensus engine isn't aware of it yet. ### Network [Network](https://github.com/ava-labs/blobvm/blob/master/vm/network.go) handles the workflow of gossiping transactions from a node's mempool to other nodes in the network. #### GossipNewTxs Method `GossipNewTxs` sends a list of transactions to other nodes in the network. `TimeBuilder` calls the network's `GossipNewTxs` function to gossip new transactions in the mempool. ```go func (n *PushNetwork) GossipNewTxs(newTxs []*chain.Transaction) error { txs := []*chain.Transaction{} // Gossip at most the target units of a block at once for _, tx := range newTxs { if _, exists := n.gossipedTxs.Get(tx.ID()); exists { log.Debug("already gossiped, skipping", "txId", tx.ID()) continue } n.gossipedTxs.Put(tx.ID(), nil) txs = append(txs, tx) } return n.sendTxs(txs) } ``` Recently gossiped transactions are maintained in a cache to avoid DDoSing a node from repeated gossip failures. Other nodes in the network will receive the gossiped transactions through their `AppGossip` handler. Once a gossip message is received, it's deserialized and the new transactions are submitted to the VM. ```go func (vm *VM) AppGossip(nodeID ids.NodeID, msg []byte) error { txs := make([]*chain.Transaction, 0) if _, err := chain.Unmarshal(msg, &txs); err != nil { return nil } // submit incoming gossip log.Debug("AppGossip transactions are being submitted", "txs", len(txs)) if errs := vm.Submit(txs...); len(errs) > 0 { for _, err := range errs { } } return nil } ``` ### Block Blocks go through a lifecycle of being proposed by a validator, verified, and decided by consensus. Upon acceptance, a block will be committed and will be finalized on the blockchain. BlobVM implements two types of blocks, `StatefulBlock` and `StatelessBlock`. #### StatefulBlock A [`StatefulBlock`](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L27) contains strictly the metadata about the block that needs to be written to the database. ```go type StatefulBlock struct { Prnt ids.ID `serialize:"true" json:"parent"` Tmstmp int64 `serialize:"true" json:"timestamp"` Hght uint64 `serialize:"true" json:"height"` Price uint64 `serialize:"true" json:"price"` Cost uint64 `serialize:"true" json:"cost"` AccessProof common.Hash `serialize:"true" json:"accessProof"` Txs []*Transaction `serialize:"true" json:"txs"` } ``` #### StatelessBlock [StatelessBlock](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L40) is a superset of `StatefulBlock` and additionally contains fields that are needed to support block-level operations like verification and acceptance throughout its lifecycle in the VM. ```go type StatelessBlock struct { *StatefulBlock `serialize:"true" json:"block"` id ids.ID st choices.Status t time.Time bytes []byte vm VM children []*StatelessBlock onAcceptDB *versiondb.Database } ``` Let's have a look at the fields of StatelessBlock: - `StatefulBlock`: The metadata about the block that will be written to the database upon acceptance - `bytes`: The serialized form of the `StatefulBlock`. - `id`: The Keccak256 hash of `bytes`. - `st`: The status of the block in consensus (i.e `Processing`, `Accepted`, or `Rejected`) - `children`: The children of this block - `onAcceptDB`: The database this block should be written to upon acceptance. When the consensus engine tries to build a block by calling the VM's `BuildBlock`, the VM calls the [`block.NewBlock`](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L53) function to get a new block that is a child of the currently preferred block. ```go func NewBlock(vm VM, parent snowman.Block, tmstp int64, context *Context) *StatelessBlock { return &StatelessBlock{ StatefulBlock: &StatefulBlock{ Tmstmp: tmstp, Prnt: parent.ID(), Hght: parent.Height() + 1, Price: context.NextPrice, Cost: context.NextCost, }, vm: vm, st: choices.Processing, } } ``` Some `StatelessBlock` fields like the block ID, byte representation, and timestamp aren't populated immediately. These are set during the `StatelessBlock`'s [`init`](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L113) method, which initializes these fields once the block has been populated with transactions. ```go func (b *StatelessBlock) init() error { bytes, err := Marshal(b.StatefulBlock) if err != nil { return err } b.bytes = bytes id, err := ids.ToID(crypto.Keccak256(b.bytes)) if err != nil { return err } b.id = id b.t = time.Unix(b.StatefulBlock.Tmstmp, 0) g := b.vm.Genesis() for _, tx := range b.StatefulBlock.Txs { if err := tx.Init(g); err != nil { return err } } return nil } ``` To build the block, the VM will try to remove as many of the highest-paying transactions from the mempool to include them in the new block until the maximum block fee set by genesis is reached. A block once built, can exist in two states: 1. Rejected: The block was not accepted by consensus. In this case, the mempool will reclaim the rejected block's transactions so they can be included in a future block. 2. Accepted: The block was accepted by consensus. In this case, we write the block to the blockchain by committing it to the database. When the consensus engine receives the built block, it calls the block's [`Verify`](https://github.com/ava-labs/blobvm/blob/master/chain/block.go#L228) method to validate that the block is well-formed. In BlobVM, the following constraints are placed on valid blocks: 1. A block must contain at least one transaction and the block's timestamp must be within 10s into the future. ```go if len(b.Txs) == 0 { return nil, nil, ErrNoTxs } if b.Timestamp().Unix() >= time.Now().Add(futureBound).Unix() { return nil, nil, ErrTimestampTooLate } ``` 2. The sum of the gas units consumed by the transactions in the block must not exceed the gas limit defined by genesis. ```go blockSize := uint64(0) for _, tx := range b.Txs { blockSize += tx.LoadUnits(g) if blockSize > g.MaxBlockSize { return nil, nil, ErrBlockTooBig } } ``` 3. The parent block of the proposed block must exist and have an earlier timestamp. ```go parent, err := b.vm.GetStatelessBlock(b.Prnt) if err != nil { log.Debug("could not get parent", "id", b.Prnt) return nil, nil, err } if b.Timestamp().Unix() < parent.Timestamp().Unix() { return nil, nil, ErrTimestampTooEarly } ``` 4. The target block price and minimum gas price must meet the minimum enforced by the VM. ```go context, err := b.vm.ExecutionContext(b.Tmstmp, parent) if err != nil { return nil, nil, err } if b.Cost != context.NextCost { return nil, nil, ErrInvalidCost } if b.Price != context.NextPrice { return nil, nil, ErrInvalidPrice } ``` After the results of consensus are complete, the block is either accepted by committing the block to the database or rejected by returning the block's transactions into the mempool. ```go // implements "snowman.Block.choices.Decidable" func (b *StatelessBlock) Accept() error { if err := b.onAcceptDB.Commit(); err != nil { return err } for _, child := range b.children { if err := child.onAcceptDB.SetDatabase(b.vm.State()); err != nil { return err } } b.st = choices.Accepted b.vm.Accepted(b) return nil } // implements "snowman.Block.choices.Decidable" func (b *StatelessBlock) Reject() error { b.st = choices.Rejected b.vm.Rejected(b) return nil } ``` ### API [Service](https://github.com/ava-labs/blobvm/blob/master/vm/public_service.go) implements an API server so users can interact with the VM. The VM implements the interface method [`CreateHandlers`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L267) that exposes the VM's RPC API. ```go func (vm *VM) CreateHandlers() (map[string]*common.HTTPHandler, error) { apis := map[string]*common.HTTPHandler{} public, err := newHandler(Name, &PublicService{vm: vm}) if err != nil { return nil, err } apis[PublicEndpoint] = public return apis, nil } ``` One API that's exposed is [`IssueRawTx`](https://github.com/ava-labs/blobvm/blob/master/vm/public_service.go#L63) to allow users to issue transactions to the BlobVM. It accepts an `IssueRawTxArgs` that contains the transaction the user wants to issue and forwards it to the VM. ```go func (svc *PublicService) IssueRawTx(_ *http.Request, args *IssueRawTxArgs, reply *IssueRawTxReply) error { tx := new(chain.Transaction) if _, err := chain.Unmarshal(args.Tx, tx); err != nil { return err } // otherwise, unexported tx.id field is empty if err := tx.Init(svc.vm.genesis); err != nil { return err } reply.TxID = tx.ID() errs := svc.vm.Submit(tx) if len(errs) == 0 { return nil } if len(errs) == 1 { return errs[0] } return fmt.Errorf("%v", errs) } ``` ### Virtual Machine We have learned about all the components used in the BlobVM. Most of these components are referenced in the `vm.go` file, which acts as the entry point for the consensus engine as well as users interacting with the blockchain. For example, the engine calls `vm.BuildBlock()`, that in turn calls `chain.BuildBlock()`. Another example is when a user issues a raw transaction through service APIs, the `vm.Submit()` method is called. Let's look at some of the important methods of `vm.go` that must be implemented: #### Initialize Method [Initialize](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L93) is invoked by `avalanchego` when creating the blockchain. `avalanchego` passes some parameters to the implementing VM. - `ctx` - Metadata about the VM's execution - `dbManager` - The database that the VM can write to - `genesisBytes` - The serialized representation of the genesis state of this VM - `upgradeBytes` - The serialized representation of network upgrades - `configBytes` - The serialized VM-specific [configuration](https://github.com/ava-labs/blobvm/blob/master/vm/config.go#L10) - `toEngine` - The channel used to send messages to the consensus engine - `fxs` - Feature extensions that attach to this VM - `appSender` - Used to send messages to other nodes in the network BlobVM upon initialization persists these fields in its own state to use them throughout the lifetime of its execution. ```go // implements "snowmanblock.ChainVM.common.VM" func (vm *VM) Initialize( ctx *snow.Context, dbManager manager.Manager, genesisBytes []byte, upgradeBytes []byte, configBytes []byte, toEngine chan<- common.Message, _ []*common.Fx, appSender common.AppSender, ) error { log.Info("initializing blobvm", "version", version.Version) // Load config vm.config.SetDefaults() if len(configBytes) > 0 { if err := ejson.Unmarshal(configBytes, &vm.config); err != nil { return fmt.Errorf("failed to unmarshal config %s: %w", string(configBytes), err) } } vm.ctx = ctx vm.db = dbManager.Current().Database vm.activityCache = make([]*chain.Activity, vm.config.ActivityCacheSize) // Init channels before initializing other structs vm.stop = make(chan struct{}) vm.builderStop = make(chan struct{}) vm.doneBuild = make(chan struct{}) vm.doneGossip = make(chan struct{}) vm.appSender = appSender vm.network = vm.NewPushNetwork() vm.blocks = &cache.LRU{Size: blocksLRUSize} vm.verifiedBlocks = make(map[ids.ID]*chain.StatelessBlock) vm.toEngine = toEngine vm.builder = vm.NewTimeBuilder() // Try to load last accepted has, err := chain.HasLastAccepted(vm.db) if err != nil { log.Error("could not determine if have last accepted") return err } // Parse genesis data vm.genesis = new(chain.Genesis) if err := ejson.Unmarshal(genesisBytes, vm.genesis); err != nil { log.Error("could not unmarshal genesis bytes") return err } if err := vm.genesis.Verify(); err != nil { log.Error("genesis is invalid") return err } targetUnitsPerSecond := vm.genesis.TargetBlockSize / uint64(vm.genesis.TargetBlockRate) vm.targetRangeUnits = targetUnitsPerSecond * uint64(vm.genesis.LookbackWindow) log.Debug("loaded genesis", "genesis", string(genesisBytes), "target range units", vm.targetRangeUnits) vm.mempool = mempool.New(vm.genesis, vm.config.MempoolSize) if has { //nolint:nestif blkID, err := chain.GetLastAccepted(vm.db) if err != nil { log.Error("could not get last accepted", "err", err) return err } blk, err := vm.GetStatelessBlock(blkID) if err != nil { log.Error("could not load last accepted", "err", err) return err } vm.preferred, vm.lastAccepted = blkID, blk log.Info("initialized blobvm from last accepted", "block", blkID) } else { genesisBlk, err := chain.ParseStatefulBlock( vm.genesis.StatefulBlock(), nil, choices.Accepted, vm, ) if err != nil { log.Error("unable to init genesis block", "err", err) return err } // Set Balances if err := vm.genesis.Load(vm.db, vm.AirdropData); err != nil { log.Error("could not set genesis allocation", "err", err) return err } if err := chain.SetLastAccepted(vm.db, genesisBlk); err != nil { log.Error("could not set genesis as last accepted", "err", err) return err } gBlkID := genesisBlk.ID() vm.preferred, vm.lastAccepted = gBlkID, genesisBlk log.Info("initialized blobvm from genesis", "block", gBlkID) } vm.AirdropData = nil } ``` After initializing its own state, BlobVM also starts asynchronous workers to build blocks and gossip transactions to the rest of the network. ``` { go vm.builder.Build() go vm.builder.Gossip() return nil } ``` #### GetBlock Method [`GetBlock`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L318) returns the block with the provided ID. GetBlock will attempt to fetch the given block from the database, and return an non-nil error if it wasn't able to get it. ```go func (vm *VM) GetBlock(id ids.ID) (snowman.Block, error) { b, err := vm.GetStatelessBlock(id) if err != nil { log.Warn("failed to get block", "err", err) } return b, err } ``` #### ParseBlock Method [`ParseBlock`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L373) deserializes a block. ```go func (vm *VM) ParseBlock(source []byte) (snowman.Block, error) { newBlk, err := chain.ParseBlock( source, choices.Processing, vm, ) if err != nil { log.Error("could not parse block", "err", err) return nil, err } log.Debug("parsed block", "id", newBlk.ID()) // If we have seen this block before, return it with the most // up-to-date info if oldBlk, err := vm.GetBlock(newBlk.ID()); err == nil { log.Debug("returning previously parsed block", "id", oldBlk.ID()) return oldBlk, nil } return newBlk, nil } ``` #### BuildBlock Method Avalanche consensus calls [`BuildBlock`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L397) when it receives a notification from the VM that it has pending transactions that are ready to be issued into a block. ```go func (vm *VM) BuildBlock() (snowman.Block, error) { log.Debug("BuildBlock triggered") blk, err := chain.BuildBlock(vm, vm.preferred) vm.builder.HandleGenerateBlock() if err != nil { log.Debug("BuildBlock failed", "error", err) return nil, err } sblk, ok := blk.(*chain.StatelessBlock) if !ok { return nil, fmt.Errorf("unexpected snowman.Block %T, expected *StatelessBlock", blk) } log.Debug("BuildBlock success", "blkID", blk.ID(), "txs", len(sblk.Txs)) return blk, nil } ``` #### SetPreference Method [`SetPreference`](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L457) sets the block ID preferred by this node. A node votes to accept or reject a block based on its current preference in consensus. ```go func (vm *VM) SetPreference(id ids.ID) error { log.Debug("set preference", "id", id) vm.preferred = id return nil } ``` #### LastAccepted Method [LastAccepted](https://github.com/ava-labs/blobvm/blob/master/vm/vm.go#L465) returns the block ID of the block that was most recently accepted by this node. ```go func (vm *VM) LastAccepted() (ids.ID, error) { return vm.lastAccepted.ID(), nil } ``` ### CLI BlobVM implements a generic key-value store, but support to read and write arbitrary files into the BlobVM blockchain is implemented in the `blob-cli` To write a file, BlobVM breaks apart an arbitrarily large file into many small chunks. Each chunk is submitted to the VM in a `SetTx`. A root key is generated which contains all of the hashes of the chunks. ```go func Upload( ctx context.Context, cli client.Client, priv *ecdsa.PrivateKey, f io.Reader, chunkSize int, ) (common.Hash, error) { hashes := []common.Hash{} chunk := make([]byte, chunkSize) shouldExit := false opts := []client.OpOption{client.WithPollTx()} totalCost := uint64(0) uploaded := map[common.Hash]struct{}{} for !shouldExit { read, err := f.Read(chunk) if errors.Is(err, io.EOF) || read == 0 { break } if err != nil { return common.Hash{}, fmt.Errorf("%w: read error", err) } if read < chunkSize { shouldExit = true chunk = chunk[:read] // Use small file optimization if len(hashes) == 0 { break } } k := chain.ValueHash(chunk) if _, ok := uploaded[k]; ok { color.Yellow("already uploaded k=%s, skipping", k) } else if exists, _, _, err := cli.Resolve(ctx, k); err == nil && exists { color.Yellow("already on-chain k=%s, skipping", k) uploaded[k] = struct{}{} } else { tx := &chain.SetTx{ BaseTx: &chain.BaseTx{}, Value: chunk, } txID, cost, err := client.SignIssueRawTx(ctx, cli, tx, priv, opts...) if err != nil { return common.Hash{}, err } totalCost += cost color.Yellow("uploaded k=%s txID=%s cost=%d totalCost=%d", k, txID, cost, totalCost) uploaded[k] = struct{}{} } hashes = append(hashes, k) } r := &Root{} if len(hashes) == 0 { if len(chunk) == 0 { return common.Hash{}, ErrEmpty } r.Contents = chunk } else { r.Children = hashes } rb, err := json.Marshal(r) if err != nil { return common.Hash{}, err } rk := chain.ValueHash(rb) tx := &chain.SetTx{ BaseTx: &chain.BaseTx{}, Value: rb, } txID, cost, err := client.SignIssueRawTx(ctx, cli, tx, priv, opts...) if err != nil { return common.Hash{}, err } totalCost += cost color.Yellow("uploaded root=%v txID=%s cost=%d totalCost=%d", rk, txID, cost, totalCost) return rk, nil } ``` #### Example 1 ```bash blob-cli set-file ~/Downloads/computer.gif -> 6fe5a52f52b34fb1e07ba90bad47811c645176d0d49ef0c7a7b4b22013f676c8 ``` Given the root hash, a file can be looked up by deserializing all of its children chunk values and reconstructing the original file. ```go // TODO: make multi-threaded func Download(ctx context.Context, cli client.Client, root common.Hash, f io.Writer) error { exists, rb, _, err := cli.Resolve(ctx, root) if err != nil { return err } if !exists { return fmt.Errorf("%w:%v", ErrMissing, root) } var r Root if err := json.Unmarshal(rb, &r); err != nil { return err } // Use small file optimization if contentLen := len(r.Contents); contentLen > 0 { if _, err := f.Write(r.Contents); err != nil { return err } color.Yellow("downloaded root=%v size=%fKB", root, float64(contentLen)/units.KiB) return nil } if len(r.Children) == 0 { return ErrEmpty } amountDownloaded := 0 for _, h := range r.Children { exists, b, _, err := cli.Resolve(ctx, h) if err != nil { return err } if !exists { return fmt.Errorf("%w:%s", ErrMissing, h) } if _, err := f.Write(b); err != nil { return err } size := len(b) color.Yellow("downloaded chunk=%v size=%fKB", h, float64(size)/units.KiB) amountDownloaded += size } color.Yellow("download complete root=%v size=%fMB", root, float64(amountDownloaded)/units.MiB) return nil } ``` #### Example 2 ```bash blob-cli resolve-file 6fe5a52f52b34fb1e07ba90bad47811c645176d0d49ef0c7a7b4b22013f676c8 computer_copy.gif ``` ## Conclusion This documentation covers concepts about Virtual Machine by walking through a VM that implements a decentralized key-value store. You can learn more about the BlobVM by referencing the [README](https://github.com/ava-labs/blobvm/blob/master/README.md) in the GitHub repository. # Simple Golang VM (/docs/avalanche-l1s/golang-vms/simple-golang-vm) --- title: Simple Golang VM description: In this tutorial, we will learn how to build a virtual machine by referencing the TimestampVM. --- In this tutorial, we'll create a very simple VM called the [TimestampVM](https://github.com/ava-labs/timestampvm/tree/v1.2.1). Each block in the TimestampVM's blockchain contains a strictly increasing timestamp when the block was created and a 32-byte payload of data. Such a server is useful because it can be used to prove a piece of data existed at the time the block was created. Suppose you have a book manuscript, and you want to be able to prove in the future that the manuscript exists today. You can add a block to the blockchain where the block's payload is a hash of your manuscript. In the future, you can prove that the manuscript existed today by showing that the block has the hash of your manuscript in its payload (this follows from the fact that finding the pre-image of a hash is impossible). ## TimestampVM Implementation Now we know the interface our VM must implement and the libraries we can use to build a VM. Let's write our VM, which implements `block.ChainVM` and whose blocks implement `snowman.Block`. You can also follow the code in the [TimestampVM repository](https://github.com/ava-labs/timestampvm/tree/main). ### Codec `Codec` is required to encode/decode the block into byte representation. TimestampVM uses the default codec and manager. ```go title="timestampvm/codec.go" const ( // CodecVersion is the current default codec version CodecVersion = 0 ) // Codecs do serialization and deserialization var ( Codec codec.Manager ) func init() { // Create default codec and manager c := linearcodec.NewDefault() Codec = codec.NewDefaultManager() // Register codec to manager with CodecVersion if err := Codec.RegisterCodec(CodecVersion, c); err != nil { panic(err) } } ``` ### State The `State` interface defines the database layer and connections. Each VM should define their own database methods. `State` embeds the `BlockState` which defines block-related state operations. ```go title="timestampvm/state.go" var ( // These are prefixes for db keys. // It's important to set different prefixes for each separate database objects. singletonStatePrefix = []byte("singleton") blockStatePrefix = []byte("block") _ State = &state{} ) // State is a wrapper around avax.SingleTonState and BlockState // State also exposes a few methods needed for managing database commits and close. type State interface { // SingletonState is defined in avalanchego, // it is used to understand if db is initialized already. avax.SingletonState BlockState Commit() error Close() error } type state struct { avax.SingletonState BlockState baseDB *versiondb.Database } func NewState(db database.Database, vm *VM) State { // create a new baseDB baseDB := versiondb.New(db) // create a prefixed "blockDB" from baseDB blockDB := prefixdb.New(blockStatePrefix, baseDB) // create a prefixed "singletonDB" from baseDB singletonDB := prefixdb.New(singletonStatePrefix, baseDB) // return state with created sub state components return &state{ BlockState: NewBlockState(blockDB, vm), SingletonState: avax.NewSingletonState(singletonDB), baseDB: baseDB, } } // Commit commits pending operations to baseDB func (s *state) Commit() error { return s.baseDB.Commit() } // Close closes the underlying base database func (s *state) Close() error { return s.baseDB.Close() } ``` #### Block State This interface and implementation provides storage functions to VM to store and retrieve blocks. ```go title="timestampvm/block_state.go" const ( lastAcceptedByte byte = iota ) const ( // maximum block capacity of the cache blockCacheSize = 8192 ) // persists lastAccepted block IDs with this key var lastAcceptedKey = []byte{lastAcceptedByte} var _ BlockState = &blockState{} // BlockState defines methods to manage state with Blocks and LastAcceptedIDs. type BlockState interface { GetBlock(blkID ids.ID) (*Block, error) PutBlock(blk *Block) error GetLastAccepted() (ids.ID, error) SetLastAccepted(ids.ID) error } // blockState implements BlocksState interface with database and cache. type blockState struct { // cache to store blocks blkCache cache.Cacher // block database blockDB database.Database lastAccepted ids.ID // vm reference vm *VM } // blkWrapper wraps the actual blk bytes and status to persist them together type blkWrapper struct { Blk []byte `serialize:"true"` Status choices.Status `serialize:"true"` } // NewBlockState returns BlockState with a new cache and given db func NewBlockState(db database.Database, vm *VM) BlockState { return &blockState{ blkCache: &cache.LRU{Size: blockCacheSize}, blockDB: db, vm: vm, } } // GetBlock gets Block from either cache or database func (s *blockState) GetBlock(blkID ids.ID) (*Block, error) { // Check if cache has this blkID if blkIntf, cached := s.blkCache.Get(blkID); cached { // there is a key but value is nil, so return an error if blkIntf == nil { return nil, database.ErrNotFound } // We found it return the block in cache return blkIntf.(*Block), nil } // get block bytes from db with the blkID key wrappedBytes, err := s.blockDB.Get(blkID[:]) if err != nil { // we could not find it in the db, let's cache this blkID with nil value // so next time we try to fetch the same key we can return error // without hitting the database if err == database.ErrNotFound { s.blkCache.Put(blkID, nil) } // could not find the block, return error return nil, err } // first decode/unmarshal the block wrapper so we can have status and block bytes blkw := blkWrapper{} if _, err := Codec.Unmarshal(wrappedBytes, &blkw); err != nil { return nil, err } // now decode/unmarshal the actual block bytes to block blk := &Block{} if _, err := Codec.Unmarshal(blkw.Blk, blk); err != nil { return nil, err } // initialize block with block bytes, status and vm blk.Initialize(blkw.Blk, blkw.Status, s.vm) // put block into cache s.blkCache.Put(blkID, blk) return blk, nil } // PutBlock puts block into both database and cache func (s *blockState) PutBlock(blk *Block) error { // create block wrapper with block bytes and status blkw := blkWrapper{ Blk: blk.Bytes(), Status: blk.Status(), } // encode block wrapper to its byte representation wrappedBytes, err := Codec.Marshal(CodecVersion, &blkw) if err != nil { return err } blkID := blk.ID() // put actual block to cache, so we can directly fetch it from cache s.blkCache.Put(blkID, blk) // put wrapped block bytes into database return s.blockDB.Put(blkID[:], wrappedBytes) } // DeleteBlock deletes block from both cache and database func (s *blockState) DeleteBlock(blkID ids.ID) error { s.blkCache.Put(blkID, nil) return s.blockDB.Delete(blkID[:]) } // GetLastAccepted returns last accepted block ID func (s *blockState) GetLastAccepted() (ids.ID, error) { // check if we already have lastAccepted ID in state memory if s.lastAccepted != ids.Empty { return s.lastAccepted, nil } // get lastAccepted bytes from database with the fixed lastAcceptedKey lastAcceptedBytes, err := s.blockDB.Get(lastAcceptedKey) if err != nil { return ids.ID{}, err } // parse bytes to ID lastAccepted, err := ids.ToID(lastAcceptedBytes) if err != nil { return ids.ID{}, err } // put lastAccepted ID into memory s.lastAccepted = lastAccepted return lastAccepted, nil } // SetLastAccepted persists lastAccepted ID into both cache and database func (s *blockState) SetLastAccepted(lastAccepted ids.ID) error { // if the ID in memory and the given memory are same don't do anything if s.lastAccepted == lastAccepted { return nil } // put lastAccepted ID to memory s.lastAccepted = lastAccepted // persist lastAccepted ID to database with fixed lastAcceptedKey return s.blockDB.Put(lastAcceptedKey, lastAccepted[:]) } ``` ### Block Let's look at our block implementation. The type declaration is: ```go title="timestampvm/block.go" // Block is a block on the chain. // Each block contains: // 1) ParentID // 2) Height // 3) Timestamp // 4) A piece of data (a string) type Block struct { PrntID ids.ID `serialize:"true" json:"parentID"` // parent's ID Hght uint64 `serialize:"true" json:"height"` // This block's height. The genesis block is at height 0. Tmstmp int64 `serialize:"true" json:"timestamp"` // Time this block was proposed at Dt [dataLen]byte `serialize:"true" json:"data"` // Arbitrary data id ids.ID // hold this block's ID bytes []byte // this block's encoded bytes status choices.Status // block's status vm *VM // the underlying VM reference, mostly used for state } ``` The `serialize:"true"` tag indicates that the field should be included in the byte representation of the block used when persisting the block or sending it to other nodes. #### Verify This method verifies that a block is valid and stores it in the memory. It is important to store the verified block in the memory and return them in the `vm.GetBlock` method. ```go title="timestampvm/block.go" // Verify returns nil iff this block is valid. // To be valid, it must be that: // b.parent.Timestamp < b.Timestamp <= [local time] + 1 hour func (b *Block) Verify() error { // Get [b]'s parent parentID := b.Parent() parent, err := b.vm.getBlock(parentID) if err != nil { return errDatabaseGet } // Ensure [b]'s height comes right after its parent's height if expectedHeight := parent.Height() + 1; expectedHeight != b.Hght { return fmt.Errorf( "expected block to have height %d, but found %d", expectedHeight, b.Hght, ) } // Ensure [b]'s timestamp is after its parent's timestamp. if b.Timestamp().Unix() < parent.Timestamp().Unix() { return errTimestampTooEarly } // Ensure [b]'s timestamp is not more than an hour // ahead of this node's time if b.Timestamp().Unix() >= time.Now().Add(time.Hour).Unix() { return errTimestampTooLate } // Put that block to verified blocks in memory b.vm.verifiedBlocks[b.ID()] = b return nil } ``` #### Accept `Accept` is called by the consensus to indicate this block is accepted. ```go title="timestampvm/block.go" // Accept sets this block's status to Accepted and sets lastAccepted to this // block's ID and saves this info to b.vm.DB func (b *Block) Accept() error { b.SetStatus(choices.Accepted) // Change state of this block blkID := b.ID() // Persist data if err := b.vm.state.PutBlock(b); err != nil { return err } // Set last accepted ID to this block ID if err := b.vm.state.SetLastAccepted(blkID); err != nil { return err } // Delete this block from verified blocks as it's accepted delete(b.vm.verifiedBlocks, b.ID()) // Commit changes to database return b.vm.state.Commit() } ``` #### Reject `Reject` is called by the consensus to indicate this block is rejected. ```go title="timestampvm/block.go" // Reject sets this block's status to Rejected and saves the status in state // Recall that b.vm.DB.Commit() must be called to persist to the DB func (b *Block) Reject() error { b.SetStatus(choices.Rejected) // Change state of this block if err := b.vm.state.PutBlock(b); err != nil { return err } // Delete this block from verified blocks as it's rejected delete(b.vm.verifiedBlocks, b.ID()) // Commit changes to database return b.vm.state.Commit() } ``` #### Block Field Methods These methods are required by the `snowman.Block` interface. ```go title="timestampvm/block.go" // ID returns the ID of this block func (b *Block) ID() ids.ID { return b.id } // ParentID returns [b]'s parent's ID func (b *Block) Parent() ids.ID { return b.PrntID } // Height returns this block's height. The genesis block has height 0. func (b *Block) Height() uint64 { return b.Hght } // Timestamp returns this block's time. The genesis block has time 0. func (b *Block) Timestamp() time.Time { return time.Unix(b.Tmstmp, 0) } // Status returns the status of this block func (b *Block) Status() choices.Status { return b.status } // Bytes returns the byte repr. of this block func (b *Block) Bytes() []byte { return b.bytes } ``` #### Helper Functions These methods are convenience methods for blocks, they're not a part of the block interface. ```go // Initialize sets [b.bytes] to [bytes], [b.id] to hash([b.bytes]), // [b.status] to [status] and [b.vm] to [vm] func (b *Block) Initialize(bytes []byte, status choices.Status, vm *VM) { b.bytes = bytes b.id = hashing.ComputeHash256Array(b.bytes) b.status = status b.vm = vm } // SetStatus sets the status of this block func (b *Block) SetStatus(status choices.Status) { b.status = status } ``` ### Virtual Machine Now, let's look at our timestamp VM implementation, which implements the `block.ChainVM` interface. The declaration is: ```go title="timestampvm/vm.go" // This Virtual Machine defines a blockchain that acts as a timestamp server // Each block contains data (a payload) and the timestamp when it was created const ( dataLen = 32 Name = "timestampvm" ) // VM implements the snowman.VM interface // Each block in this chain contains a Unix timestamp // and a piece of data (a string) type VM struct { // The context of this vm ctx *snow.Context dbManager manager.Manager // State of this VM state State // ID of the preferred block preferred ids.ID // channel to send messages to the consensus engine toEngine chan<- common.Message // Proposed pieces of data that haven't been put into a block and proposed yet mempool [][dataLen]byte // Block ID --> Block // Each element is a block that passed verification but // hasn't yet been accepted/rejected verifiedBlocks map[ids.ID]*Block } ``` #### Initialize This method is called when a new instance of VM is initialized. Genesis block is created under this method. ```go title="timestampvm/vm.go" // Initialize this vm // [ctx] is this vm's context // [dbManager] is the manager of this vm's database // [toEngine] is used to notify the consensus engine that new blocks are // ready to be added to consensus // The data in the genesis block is [genesisData] func (vm *VM) Initialize( ctx *snow.Context, dbManager manager.Manager, genesisData []byte, upgradeData []byte, configData []byte, toEngine chan<- common.Message, _ []*common.Fx, _ common.AppSender, ) error { version, err := vm.Version() if err != nil { log.Error("error initializing Timestamp VM: %v", err) return err } log.Info("Initializing Timestamp VM", "Version", version) vm.dbManager = dbManager vm.ctx = ctx vm.toEngine = toEngine vm.verifiedBlocks = make(map[ids.ID]*Block) // Create new state vm.state = NewState(vm.dbManager.Current().Database, vm) // Initialize genesis if err := vm.initGenesis(genesisData); err != nil { return err } // Get last accepted lastAccepted, err := vm.state.GetLastAccepted() if err != nil { return err } ctx.Log.Info("initializing last accepted block as %s", lastAccepted) // Build off the most recently accepted block return vm.SetPreference(lastAccepted) } ``` #### `initGenesis` `initGenesis` is a helper method which initializes the genesis block from given bytes and puts into the state. ```go title="timestampvm/vm.go" // Initializes Genesis if required func (vm *VM) initGenesis(genesisData []byte) error { stateInitialized, err := vm.state.IsInitialized() if err != nil { return err } // if state is already initialized, skip init genesis. if stateInitialized { return nil } if len(genesisData) > dataLen { return errBadGenesisBytes } // genesisData is a byte slice but each block contains an byte array // Take the first [dataLen] bytes from genesisData and put them in an array var genesisDataArr [dataLen]byte copy(genesisDataArr[:], genesisData) // Create the genesis block // Timestamp of genesis block is 0. It has no parent. genesisBlock, err := vm.NewBlock(ids.Empty, 0, genesisDataArr, time.Unix(0, 0)) if err != nil { log.Error("error while creating genesis block: %v", err) return err } // Put genesis block to state if err := vm.state.PutBlock(genesisBlock); err != nil { log.Error("error while saving genesis block: %v", err) return err } // Accept the genesis block // Sets [vm.lastAccepted] and [vm.preferred] if err := genesisBlock.Accept(); err != nil { return fmt.Errorf("error accepting genesis block: %w", err) } // Mark this vm's state as initialized, so we can skip initGenesis in further restarts if err := vm.state.SetInitialized(); err != nil { return fmt.Errorf("error while setting db to initialized: %w", err) } // Flush VM's database to underlying db return vm.state.Commit() } ``` #### CreateHandlers Registered handlers defined in `Service`. See [below](/docs/avalanche-l1s/golang-vms/simple-golang-vm#api) for more on APIs. ```go title="timestampvm/vm.go" // CreateHandlers returns a map where: // Keys: The path extension for this blockchain's API (empty in this case) // Values: The handler for the API // In this case, our blockchain has only one API, which we name timestamp, // and it has no path extension, so the API endpoint: // [Node IP]/ext/bc/[this blockchain's ID] // See API section in documentation for more information func (vm *VM) CreateHandlers() (map[string]*common.HTTPHandler, error) { server := rpc.NewServer() server.RegisterCodec(json.NewCodec(), "application/json") server.RegisterCodec(json.NewCodec(), "application/json;charset=UTF-8") // Name is "timestampvm" if err := server.RegisterService(&Service{vm: vm}, Name); err != nil { return nil, err } return map[string]*common.HTTPHandler{ "": { Handler: server, }, }, nil } ``` #### CreateStaticHandlers Registers static handlers defined in `StaticService`. See [below](/docs/avalanche-l1s/golang-vms/simple-golang-vm#static-api) for more on static APIs. ```go title="timestampvm/vm.go" // CreateStaticHandlers returns a map where: // Keys: The path extension for this VM's static API // Values: The handler for that static API func (vm *VM) CreateStaticHandlers() (map[string]*common.HTTPHandler, error) { server := rpc.NewServer() server.RegisterCodec(json.NewCodec(), "application/json") server.RegisterCodec(json.NewCodec(), "application/json;charset=UTF-8") if err := server.RegisterService(&StaticService{}, Name); err != nil { return nil, err } return map[string]*common.HTTPHandler{ "": { LockOptions: common.NoLock, Handler: server, }, }, nil } ``` #### BuildBock `BuildBlock` builds a new block and returns it. This is mainly requested by the consensus engine. ```go title="timestampvm/vm.go" // BuildBlock returns a block that this vm wants to add to consensus func (vm *VM) BuildBlock() (snowman.Block, error) { if len(vm.mempool) == 0 { // There is no block to be built return nil, errNoPendingBlocks } // Get the value to put in the new block value := vm.mempool[0] vm.mempool = vm.mempool[1:] // Notify consensus engine that there are more pending data for blocks // (if that is the case) when done building this block if len(vm.mempool) > 0 { defer vm.NotifyBlockReady() } // Gets Preferred Block preferredBlock, err := vm.getBlock(vm.preferred) if err != nil { return nil, fmt.Errorf("couldn't get preferred block: %w", err) } preferredHeight := preferredBlock.Height() // Build the block with preferred height newBlock, err := vm.NewBlock(vm.preferred, preferredHeight+1, value, time.Now()) if err != nil { return nil, fmt.Errorf("couldn't build block: %w", err) } // Verifies block if err := newBlock.Verify(); err != nil { return nil, err } return newBlock, nil } ``` #### NotifyBlockReady `NotifyBlockReady` is a helper method that can send messages to the consensus engine through `toEngine` channel. ```go title="timestampvm/vm.go" // NotifyBlockReady tells the consensus engine that a new block // is ready to be created func (vm *VM) NotifyBlockReady() { select { case vm.toEngine <- common.PendingTxs: default: vm.ctx.Log.Debug("dropping message to consensus engine") } } ``` #### GetBlock `GetBlock` returns the block with the given block ID. ```go title="timestampvm/vm.go" // GetBlock implements the snowman.ChainVM interface func (vm *VM) GetBlock(blkID ids.ID) (snowman.Block, error) { return vm.getBlock(blkID) } func (vm *VM) getBlock(blkID ids.ID) (*Block, error) { // If block is in memory, return it. if blk, exists := vm.verifiedBlocks[blkID]; exists { return blk, nil } return vm.state.GetBlock(blkID) } ``` #### `proposeBlock` This method adds a piece of data to the mempool and notifies the consensus layer of the blockchain that a new block is ready to be built and voted on. This is called by API method `ProposeBlock`, which we'll see later. ```go title="timestampvm/vm.go" // proposeBlock appends [data] to [p.mempool]. // Then it notifies the consensus engine // that a new block is ready to be added to consensus // (namely, a block with data [data]) func (vm *VM) proposeBlock(data [dataLen]byte) { vm.mempool = append(vm.mempool, data) vm.NotifyBlockReady() } ``` #### ParseBlock Parse a block from its byte representation. ```go title="timestampvm/vm.go" // ParseBlock parses [bytes] to a snowman.Block // This function is used by the vm's state to unmarshal blocks saved in state // and by the consensus layer when it receives the byte representation of a block // from another node func (vm *VM) ParseBlock(bytes []byte) (snowman.Block, error) { // A new empty block block := &Block{} // Unmarshal the byte repr. of the block into our empty block _, err := Codec.Unmarshal(bytes, block) if err != nil { return nil, err } // Initialize the block block.Initialize(bytes, choices.Processing, vm) if blk, err := vm.getBlock(block.ID()); err == nil { // If we have seen this block before, return it with the most up-to-date // info return blk, nil } // Return the block return block, nil } ``` #### NewBlock `NewBlock` creates a new block with given block parameters. ```go title="timestampvm/vm.go" // NewBlock returns a new Block where: // - the block's parent is [parentID] // - the block's data is [data] // - the block's timestamp is [timestamp] func (vm *VM) NewBlock(parentID ids.ID, height uint64, data [dataLen]byte, timestamp time.Time) (*Block, error) { block := &Block{ PrntID: parentID, Hght: height, Tmstmp: timestamp.Unix(), Dt: data, } // Get the byte representation of the block blockBytes, err := Codec.Marshal(CodecVersion, block) if err != nil { return nil, err } // Initialize the block by providing it with its byte representation // and a reference to this VM block.Initialize(blockBytes, choices.Processing, vm) return block, nil } ``` #### SetPreference `SetPreference` implements the `block.ChainVM`. It sets the preferred block ID. ```go title="timestampvm/vm.go" // SetPreference sets the block with ID [ID] as the preferred block func (vm *VM) SetPreference(id ids.ID) error { vm.preferred = id return nil } ``` #### Other Functions These functions needs to be implemented for `block.ChainVM`. Most of them are just blank functions returning `nil`. ```go title="timestampvm/vm.go" // Bootstrapped marks this VM as bootstrapped func (vm *VM) Bootstrapped() error { return nil } // Bootstrapping marks this VM as bootstrapping func (vm *VM) Bootstrapping() error { return nil } // Returns this VM's version func (vm *VM) Version() (string, error) { return Version.String(), nil } func (vm *VM) Connected(id ids.ShortID, nodeVersion version.Application) error { return nil // noop } func (vm *VM) Disconnected(id ids.ShortID) error { return nil // noop } // This VM doesn't (currently) have any app-specific messages func (vm *VM) AppGossip(nodeID ids.ShortID, msg []byte) error { return nil } // This VM doesn't (currently) have any app-specific messages func (vm *VM) AppRequest(nodeID ids.ShortID, requestID uint32, time time.Time, request []byte) error { return nil } // This VM doesn't (currently) have any app-specific messages func (vm *VM) AppResponse(nodeID ids.ShortID, requestID uint32, response []byte) error { return nil } // This VM doesn't (currently) have any app-specific messages func (vm *VM) AppRequestFailed(nodeID ids.ShortID, requestID uint32) error { return nil } // Health implements the common.VM interface func (vm *VM) HealthCheck() (interface{}, error) { return nil, nil } ``` ### Factory VMs should implement the `Factory` interface. `New` method in the interface returns a new VM instance. ```go title="timestampvm/factory.go" var _ vms.Factory = &Factory{} // Factory ... type Factory struct{} // New ... func (f *Factory) New(*snow.Context) (interface{}, error) { return &VM{}, nil } ``` ### Static API A VM may have a static API, which allows clients to call methods that do not query or update the state of a particular blockchain, but rather apply to the VM as a whole. This is analogous to static methods in computer programming. AvalancheGo uses [Gorilla's RPC library](https://www.gorillatoolkit.org/pkg/rpc) to implement HTTP APIs. `StaticService` implements the static API for our VM. ```go title="timestampvm/static_service.go" // StaticService defines the static API for the timestamp vm type StaticService struct{} ``` #### Encode For each API method, there is: - A struct that defines the method's arguments - A struct that defines the method's return values - A method that implements the API method, and is parameterized on the above 2 structs This API method encodes a string to its byte representation using a given encoding scheme. It can be used to encode data that is then put in a block and proposed as the next block for this chain. ```go title="timestampvm/static_service.go" // EncodeArgs are arguments for Encode type EncodeArgs struct { Data string `json:"data"` Encoding formatting.Encoding `json:"encoding"` Length int32 `json:"length"` } // EncodeReply is the reply from Encoder type EncodeReply struct { Bytes string `json:"bytes"` Encoding formatting.Encoding `json:"encoding"` } // Encoder returns the encoded data func (ss *StaticService) Encode(_ *http.Request, args *EncodeArgs, reply *EncodeReply) error { if len(args.Data) == 0 { return fmt.Errorf("argument Data cannot be empty") } var argBytes []byte if args.Length > 0 { argBytes = make([]byte, args.Length) copy(argBytes, args.Data) } else { argBytes = []byte(args.Data) } bytes, err := formatting.EncodeWithChecksum(args.Encoding, argBytes) if err != nil { return fmt.Errorf("couldn't encode data as string: %s", err) } reply.Bytes = bytes reply.Encoding = args.Encoding return nil } ``` #### Decode This API method is the inverse of `Encode`. ```go title="timestampvm/static_service.go" // DecoderArgs are arguments for Decode type DecoderArgs struct { Bytes string `json:"bytes"` Encoding formatting.Encoding `json:"encoding"` } // DecoderReply is the reply from Decoder type DecoderReply struct { Data string `json:"data"` Encoding formatting.Encoding `json:"encoding"` } // Decoder returns the Decoded data func (ss *StaticService) Decode(_ *http.Request, args *DecoderArgs, reply *DecoderReply) error { bytes, err := formatting.Decode(args.Encoding, args.Bytes) if err != nil { return fmt.Errorf("couldn't Decode data as string: %s", err) } reply.Data = string(bytes) reply.Encoding = args.Encoding return nil } ``` ### API A VM may also have a non-static HTTP API, which allows clients to query and update the blockchain's state. `Service`'s declaration is: ```go title="timestampvm/service.go" // Service is the API service for this VM type Service struct{ vm *VM } ``` Note that this struct has a reference to the VM, so it can query and update state. This VM's API has two methods. One allows a client to get a block by its ID. The other allows a client to propose the next block of this blockchain. The blockchain ID in the endpoint changes, since every blockchain has an unique ID. #### `timestampvm.getBlock` Get a block by its ID. If no ID is provided, get the latest block. ##### `getBlock` Signature ``` timestampvm.getBlock({id: string}) -> { id: string, data: string, timestamp: int, parentID: string } ``` - `id` is the ID of the block being retrieved. If omitted from arguments, gets the latest block - `data` is the base 58 (with checksum) representation of the block's 32 byte payload - `timestamp` is the Unix timestamp when this block was created - `parentID` is the block's parent ##### `getBlock` Example Call ```bash curl -X POST --data '{ "jsonrpc": "2.0", "method": "timestampvm.getBlock", "params":{ "id":"xqQV1jDnCXDxhfnNT7tDBcXeoH2jC3Hh7Pyv4GXE1z1hfup5K" }, "id": 1 }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/bc/sw813hGSWH8pdU9uzaYy9fCtYFfY7AjDd2c9rm64SbApnvjmk ``` ##### `getBlock` Example Response ```json { "jsonrpc": "2.0", "result": { "timestamp": "1581717416", "data": "11111111111111111111111111111111LpoYY", "id": "xqQV1jDnCXDxhfnNT7tDBcXeoH2jC3Hh7Pyv4GXE1z1hfup5K", "parentID": "22XLgiM5dfCwTY9iZnVk8ZPuPe3aSrdVr5Dfrbxd3ejpJd7oef" }, "id": 1 } ``` ##### `getBlock` Implementation ```go title="timestampvm/service.go" // GetBlockArgs are the arguments to GetBlock type GetBlockArgs struct { // ID of the block we're getting. // If left blank, gets the latest block ID *ids.ID `json:"id"` } // GetBlockReply is the reply from GetBlock type GetBlockReply struct { Timestamp json.Uint64 `json:"timestamp"` // Timestamp of most recent block Data string `json:"data"` // Data in the most recent block. Base 58 repr. of 5 bytes. ID ids.ID `json:"id"` // String repr. of ID of the most recent block ParentID ids.ID `json:"parentID"` // String repr. of ID of the most recent block's parent } // GetBlock gets the block whose ID is [args.ID] // If [args.ID] is empty, get the latest block func (s *Service) GetBlock(_ *http.Request, args *GetBlockArgs, reply *GetBlockReply) error { // If an ID is given, parse its string representation to an ids.ID // If no ID is given, ID becomes the ID of last accepted block var ( id ids.ID err error ) if args.ID == nil { id, err = s.vm.state.GetLastAccepted() if err != nil { return errCannotGetLastAccepted } } else { id = *args.ID } // Get the block from the database block, err := s.vm.getBlock(id) if err != nil { return errNoSuchBlock } // Fill out the response with the block's data reply.ID = block.ID() reply.Timestamp = json.Uint64(block.Timestamp().Unix()) reply.ParentID = block.Parent() data := block.Data() reply.Data, err = formatting.EncodeWithChecksum(formatting.CB58, data[:]) return err } ``` #### `timestampvm.proposeBlock` Propose the next block on this blockchain. ##### `proposeBlock` Signature ```go timestampvm.proposeBlock({data: string}) -> {success: bool} ``` - `data` is the base 58 (with checksum) representation of the proposed block's 32 byte payload. ##### `proposeBlock` Example Call ```bash curl -X POST --data '{ "jsonrpc": "2.0", "method": "timestampvm.proposeBlock", "params":{ "data":"SkB92YpWm4Q2iPnLGCuDPZPgUQMxajqQQuz91oi3xD984f8r" }, "id": 1 }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/bc/sw813hGSWH8pdU9uzaYy9fCtYFfY7AjDd2c9rm64SbApnvjmk ``` ###### `proposeBlock` Example Response ```json { "jsonrpc": "2.0", "result": { "Success": true }, "id": 1 } ``` ##### `proposeBlock` Implementation ```go title="timestampvm/service.go" // ProposeBlockArgs are the arguments to ProposeValue type ProposeBlockArgs struct { // Data for the new block. Must be base 58 encoding (with checksum) of 32 bytes. Data string } // ProposeBlockReply is the reply from function ProposeBlock type ProposeBlockReply struct{ // True if the operation was successful Success bool } // ProposeBlock is an API method to propose a new block whose data is [args].Data. // [args].Data must be a string repr. of a 32 byte array func (s *Service) ProposeBlock(_ *http.Request, args *ProposeBlockArgs, reply *ProposeBlockReply) error { bytes, err := formatting.Decode(formatting.CB58, args.Data) if err != nil || len(bytes) != dataLen { return errBadData } var data [dataLen]byte // The data as an array of bytes copy(data[:], bytes[:dataLen]) // Copy the bytes in dataSlice to data s.vm.proposeBlock(data) reply.Success = true return nil } ``` ### Plugin In order to make this VM compatible with `go-plugin`, we need to define a `main` package and method, which serves our VM over gRPC so that AvalancheGo can call its methods. `main.go`'s contents are: ```go title="main/main.go" func main() { log.Root().SetHandler(log.LvlFilterHandler(log.LvlDebug, log.StreamHandler(os.Stderr, log.TerminalFormat()))) plugin.Serve(&plugin.ServeConfig{ HandshakeConfig: rpcchainvm.Handshake, Plugins: map[string]plugin.Plugin{ "vm": rpcchainvm.New(×tampvm.VM{}), }, // A non-nil value here enables gRPC serving for this plugin... GRPCServer: plugin.DefaultGRPCServer, }) } ``` Now AvalancheGo's `rpcchainvm` can connect to this plugin and calls its methods. ### Executable Binary This VM has a [build script](https://github.com/ava-labs/timestampvm/blob/v1.2.1/scripts/build.sh) that builds an executable of this VM (when invoked, it runs the `main` method from above.) The path to the executable, as well as its name, can be provided to the build script via arguments. For example: ```bash ./scripts/build.sh ../avalanchego/build/plugins timestampvm ``` If no argument is given, the path defaults to a binary named with default VM ID: `$GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH` This name `tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH` is the CB58 encoded 32 byte identifier for the VM. For the timestampvm, this is the string "timestamp" zero-extended in a 32 byte array and encoded in CB58. ### VM Aliases Each VM has a predefined, static ID. For instance, the default ID of the TimestampVM is: `tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH`. It's possible to give an alias for these IDs. For example, we can alias `TimestampVM` by creating a JSON file at `~/.avalanchego/configs/vms/aliases.json` with: The name of the VM binary is also its static ID and should not be changed manually. Changing the name of the VM binary will result in AvalancheGo failing to start the VM. To reference a VM by another name, define a VM alias as described below. ```json { "tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH": [ "timestampvm", "timestamp" ] } ``` ### Installing a VM AvalancheGo searches for and registers plugins under the `plugins` [directory](/docs/nodes/configure/configs-flags#--plugin-dir-string). To install the virtual machine onto your node, you need to move the built virtual machine binary under this directory. Virtual machine executable names must be either a full virtual machine ID (encoded in CB58), or a VM alias. Copy the binary into the plugins directory. ```bash cp -n $GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/ ``` #### Node Is Not Running If your node isn't running yet, you can install all virtual machines under your `plugin` directory by starting the node. #### Node Is Already Running Load the binary with the `loadVMs` API. ```bash curl -sX POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"admin.loadVMs", "params" :{} }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/admin ``` Confirm the response of `loadVMs` contains the newly installed virtual machine `tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH`. You'll see this virtual machine as well as any others that weren't already installed previously in the response. ```json { "jsonrpc": "2.0", "result": { "newVMs": { "tGas3T58KzdjLHhBDMnH2TvrddhqTji5iZAMZ3RXs2NLpSnhH": [ "timestampvm", "timestamp" ], "spdxUxVJQbX85MGxMHbKw1sHxMnSqJ3QBzDyDYEP3h6TLuxqQ": [] } }, "id": 1 } ``` Now, this VM's static API can be accessed at endpoints `/ext/vm/timestampvm` and `/ext/vm/timestamp`. For more details about VM configs, see [here](/docs/nodes/configure/configs-flags#virtual-machine-vm-configs). In this tutorial, we used the VM's ID as the executable name to simplify the process. However, AvalancheGo would also accept `timestampvm` or `timestamp` since those are registered aliases in previous step. ## Wrapping Up That's it! That's the entire implementation of a VM which defines a blockchain-based timestamp server. In this tutorial, we learned: - The `block.ChainVM` interface, which all VMs that define a linear chain must implement - The `snowman.Block` interface, which all blocks that are part of a linear chain must implement - The `rpcchainvm` type, which allows blockchains to run in their own processes. - An actual implementation of `block.ChainVM` and `snowman.Block`. # Customize an Avalanche L1 (/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1) --- title: Customize an Avalanche L1 description: Learn how to customize your EVM-powered Avalanche L1. --- All Avalanche L1s can be customized by utilizing [`L1s Configs`](#avalanche-l1-configs). an Avalanche L1 can have one or more blockchains. For example, the Primary Network, which is an Avalanche L1, a special one nonetheless, has 3 blockchains. Each chain can be further customized using chain specific configuration file. See [here](/docs/nodes/configure/configs-flags) for detailed explanation. An Avalanche L1 created by or forked from [Subnet-EVM](https://github.com/ava-labs/subnet-evm) can be customized by utilizing one or more of the following methods: - [Genesis](#genesis) - [Precompile](#precompiles) - [Upgrade Configs](#network-upgrades-enabledisable-precompiles) - [Chain Configs](#avalanchego-chain-configs) Avalanche L1 Configs[​](#avalanche-l1-configs "Direct link to heading") ----------------------------------------------------------- an Avalanche L1 can customized by setting parameters for the following: - [Validator-only communication to create a private Avalanche L1](/docs/nodes/configure/avalanche-l1-configs#validatoronly-bool) - [Consensus](/docs/nodes/configure/avalanche-l1-configs#consensus-parameters) - [Gossip](/docs/nodes/configure/avalanche-l1-configs#gossip-configs) See [here](/docs/nodes/configure/avalanche-l1-configs) for more info. Genesis[​](#genesis "Direct link to heading") --------------------------------------------- Each blockchain has some genesis state when it's created. Each Virtual Machine defines the format and semantics of its genesis data. The default genesis Subnet-EVM provided below has some well defined parameters: ```json { "config": { "chainId": 43214, "homesteadBlock": 0, "eip150Block": 0, "eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0", "eip155Block": 0, "eip158Block": 0, "byzantiumBlock": 0, "constantinopleBlock": 0, "petersburgBlock": 0, "istanbulBlock": 0, "muirGlacierBlock": 0, "feeConfig": { "gasLimit": 15000000, "minBaseFee": 25000000000, "targetGas": 15000000, "baseFeeChangeDenominator": 36, "minBlockGasCost": 0, "maxBlockGasCost": 1000000, "targetBlockRate": 2, "blockGasCostStep": 200000 }, "allowFeeRecipients": false }, "alloc": { "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { "balance": "0x295BE96E64066972000000" } }, "nonce": "0x0", "timestamp": "0x0", "extraData": "0x00", "gasLimit": "0xe4e1c0", "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000" } ``` ### Chain Config[​](#chain-config "Direct link to heading") `chainID`: Denotes the ChainID of to be created chain. Must be picked carefully since a conflict with other chains can cause issues. One suggestion is to check with [chainlist.org](https://chainlist.org/) to avoid ID collision, reserve and publish your ChainID properly. You can use `eth_getChainConfig` RPC call to get the current chain config. See [here](/docs/rpcs/subnet-evm#eth_getchainconfig) for more info. #### Hard Forks[​](#hard-forks "Direct link to heading") `homesteadBlock`, `eip150Block`, `eip150Hash`, `eip155Block`, `byzantiumBlock`, `constantinopleBlock`, `petersburgBlock`, `istanbulBlock`, `muirGlacierBlock` are EVM hard fork activation times. Changing these may cause issues, so treat them carefully. #### Fee Config[​](#fee-config "Direct link to heading") `gasLimit`: Sets the max amount of gas consumed per block. This restriction puts a cap on the amount of computation that can be done in a single block, which in turn sets a limit on the maximum gas usage allowed for a single transaction. For reference, C-Chain value is set to `15,000,000`. `targetBlockRate`: Sets the target rate of block production in seconds. A target of 2 will target producing a block every 2 seconds. If the network starts producing blocks at a faster rate, it indicates that more blocks than anticipated are being issued to the network, resulting in an increase in base fees. For C-chain this value is set to `2`. `minBaseFee`: Sets a lower bound on the EIP-1559 base fee of a block. Since the block's base fee sets the minimum gas price for any transaction included in that block, this effectively sets a minimum gas price for any transaction. `targetGas`: Specifies the targeted amount of gas (including block gas cost) to consume within a rolling 10-seconds window. When the dynamic fee algorithm observes that network activity is above/below the `targetGas`, it increases/decreases the base fee proportionally to how far above/below the target actual network activity is. If the network starts producing blocks with gas cost higher than this, base fees are increased accordingly. `baseFeeChangeDenominator`: Divides the difference between actual and target utilization to determine how much to increase/decrease the base fee. A larger denominator indicates a slower changing, stickier base fee, while a lower denominator allows the base fee to adjust more quickly. For reference, the C-chain value is set to `36`. This value sets the base fee to increase or decrease by a factor of `1/36` of the parent block's base fee. `minBlockGasCost`: Sets the minimum amount of gas to charge for the production of a block. This value is set to `0` in C-Chain. `maxBlockGasCost`: Sets the maximum amount of gas to charge for the production of a block. `blockGasCostStep`: Determines how much to increase/decrease the block gas cost depending on the amount of time elapsed since the previous block. If the block is produced at the target rate, the block gas cost will stay the same as the block gas cost for the parent block. If it is produced faster/slower, the block gas cost will be increased/decreased by the step value for each second faster/slower than the target block rate accordingly. If the `blockGasCostStep` is set to a very large number, it effectively requires block production to go no faster than the `targetBlockRate`. For example, if a block is produced two seconds faster than the target block rate, the block gas cost will increase by `2 * blockGasCostStep`. #### Custom Fee Recipients[​](#custom-fee-recipients "Direct link to heading") See section [Setting a Custom Fee Recipient](#setting-a-custom-fee-recipient) ### Alloc[​](#alloc "Direct link to heading") The fields `nonce`, `timestamp`, `extraData`, `gasLimit`, `difficulty`, `mixHash`, `coinbase`, `number`, `gasUsed`, `parentHash` defines the genesis block header. The field `gasLimit` should be set to match the `gasLimit` set in the `feeConfig`. You do not need to change any of the other genesis header fields. `nonce`, `mixHash` and `difficulty` are remnant parameters from Proof of Work systems. For Avalanche, these don't play any relevant role, so you should just leave them as their default values: `nonce`: The result of the mining process iteration is this value. It can be any value in the genesis block. Default value is `0x0`. `mixHash`: The combination of `nonce` and `mixHash` allows to verify that the Block has really been cryptographically mined, thus, from this aspect, is valid. Default value is `0x0000000000000000000000000000000000000000000000000000000000000000`. `difficulty`: The difficulty level applied during the nonce discovering process of this block. Default value is `0x0`. `timestamp`: The timestamp of the creation of the genesis block. This is commonly set to `0x0`. `extraData`: Optional extra data that can be included in the genesis block. This is commonly set to `0x`. `gasLimit`: The total amount of gas that can be used in a single block. It should be set to the same value as in the [fee config](#fee-config). The value `e4e1c0` is hexadecimal and is equal to `15,000,000`. `coinbase`: Refers to the address of the block producers. This also means it represents the recipient of the block reward. It is usually set to `0x0000000000000000000000000000000000000000` for the genesis block. To allow fee recipients in Subnet-EVM, refer to [this section.](#setting-a-custom-fee-recipient) `parentHash`: This is the Keccak 256-bit hash of the entire parent block's header. It is usually set to `0x0000000000000000000000000000000000000000000000000000000000000000` for the genesis block. `gasUsed`: This is the amount of gas used by the genesis block. It is usually set to `0x0`. `number`: This is the number of the genesis block. This required to be `0x0` for the genesis. Otherwise it will error. ### Genesis Examples[​](#genesis-examples "Direct link to heading") Another example of a genesis file can be found in the [networks folder](https://github.com/ava-labs/public-chain-assets/blob/1951594346dcc91682bdd8929bcf8c1bf6a04c33/chains/11111/genesis.json). Please remove `airdropHash` and `airdropAmount` fields if you want to start with it. Here are a few examples on how a genesis file is used: [scripts/run.sh](https://github.com/ava-labs/subnet-evm/blob/master/scripts/run.sh#L99) ### Setting the Genesis Allocation[​](#setting-the-genesis-allocation "Direct link to heading") Alloc defines addresses and their initial balances. This should be changed accordingly for each chain. If you don't provide any genesis allocation, you won't be able to interact with your new chain (all transactions require a fee to be paid from the sender's balance). The `alloc` field expects key-value pairs. Keys of each entry must be a valid `address`. The `balance` field in the value can be either a `hexadecimal` or `number` to indicate initial balance of the address. The default value contains `8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` with `50000000000000000000000000` balance in it. Default: ```json "alloc": { "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { "balance": "0x295BE96E64066972000000" } } ``` To specify a different genesis allocation, populate the `alloc` field in the genesis JSON as follows: ```json "alloc": { "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { "balance": "0x52B7D2DCC80CD2E4000000" }, "Ab5801a7D398351b8bE11C439e05C5B3259aeC9B": { "balance": "0xa796504b1cb5a7c0000" } }, ``` The keys in the allocation are [hex](https://en.wikipedia.org/wiki/Hexadecimal) addresses **without the canonical `0x` prefix**. The balances are denominated in Wei ([10^18 Wei = 1 Whole Unit of Native Token](https://eth-converter.com/)) and expressed as hex strings **with the canonical `0x` prefix**. You can use [this converter](https://www.rapidtables.com/convert/number/hex-to-decimal.html) to translate between decimal and hex numbers. The above example yields the following genesis allocations (denominated in whole units of the native token, that is 1 AVAX/1 WAGMI): ```bash 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC: 100000000 (0x52B7D2DCC80CD2E4000000=100000000000000000000000000 Wei) 0xAb5801a7D398351b8bE11C439e05C5B3259aeC9B: 49463 (0xa796504b1cb5a7c0000=49463000000000000000000 Wei) ``` ### Setting a Custom Fee Recipient[​](#setting-a-custom-fee-recipient "Direct link to heading") By default, all fees are burned (sent to the black hole address with `"allowFeeRecipients": false`). However, it is possible to enable block producers to set a fee recipient (who will get compensated for blocks they produce). To enable this feature, you'll need to add the following to your genesis file (under the `"config"` key): ```json { "config": { "allowFeeRecipients": true } } ``` #### Fee Recipient Address[​](#fee-recipient-address "Direct link to heading") With `allowFeeRecipients` enabled, your validators can specify their addresses to collect fees. They need to update their EVM [chain config](#avalanchego-chain-configs) with the following to specify where the fee should be sent to. ```json { "feeRecipient": "" } ``` If `allowFeeRecipients` feature is enabled on the Avalanche L1, but a validator doesn't specify a "feeRecipient", the fees will be burned in blocks it produces. This mechanism can be also activated as a precompile. See [Changing Fee Reward Mechanisms](#changing-fee-reward-mechanisms) section for more details. Precompiles[​](#precompiles "Direct link to heading") ----------------------------------------------------- Subnet-EVM can provide custom functionalities with precompiled contracts. These precompiled contracts can be activated through `ChainConfig` (in genesis or as an upgrade). ### AllowList Interface[​](#allowlist-interface "Direct link to heading") The `AllowList` interface is used by precompiles to check if a given address is allowed to use a precompiled contract. `AllowList` consist of three roles, `Admin`, `Manager` and `Enabled`. `Admin` can add/remove other `Admin` and `Enabled` addresses. `Manager` is introduced with Durango upgrade and can add/remove `Enabled` addresses, without the ability to add/remove `Admin` or `Manager` addresses. `Enabled` addresses can use the precompiled contract, but cannot modify other roles. `AllowList` adds `adminAddresses`, `managerAddresses`, `enabledAddresses` fields to precompile contract configurations. For instance fee manager precompile contract configuration looks like this: ```json { "feeManagerConfig": { "blockTimestamp": 0, "adminAddresses": [], "managerAddresses": [], "enabledAddresses": [], } } ``` `AllowList` configuration affects only the related precompile. For instance, the admin address in `feeManagerConfig` does not affect admin addresses in other activated precompiles. The `AllowList` solidity interface is defined as follows, and can be found in [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/helloworld-official-tutorial-v2/contracts/contracts/interfaces/IAllowList.sol): ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.0; interface IAllowList { event RoleSet( uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole ); // Set [addr] to have the admin role over the precompile contract. function setAdmin(address addr) external; // Set [addr] to be enabled on the precompile contract. function setEnabled(address addr) external; // Set [addr] to have the manager role over the precompile contract. function setManager(address addr) external; // Set [addr] to have no role for the precompile contract. function setNone(address addr) external; // Read the status of [addr]. function readAllowList(address addr) external view returns (uint256 role); } ``` `readAllowList(addr)` will return a uint256 with a value of 0, 1, or 2, corresponding to the roles `None`, `Enabled`, and `Admin` respectively. `RoleSet` is an event that is emitted when a role is set for an address. It includes the role, the modified address, the sender as indexed parameters and the old role as non-indexed parameter. Events in precompiles are activated after Durango upgrade. Note: `AllowList` is not an actual contract but just an interface. It's not callable by itself. This is used by other precompiles. Check other precompile sections to see how this works. ### Restricting Smart Contract Deployers[​](#restricting-smart-contract-deployers "Direct link to heading") If you'd like to restrict who has the ability to deploy contracts on your Avalanche L1, you can provide an `AllowList` configuration in your genesis or upgrade file: ```json { "contractDeployerAllowListConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } ``` In this example, `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` is named as the `Admin` of the `ContractDeployerAllowList`. This enables it to add other `Admin` or to add `Enabled` addresses. Both `Admin` and `Enabled` can deploy contracts. To provide a great UX with factory contracts, the `tx.Origin` is checked for being a valid deployer instead of the caller of `CREATE`. This means that factory contracts will still be able to create new contracts as long as the sender of the original transaction is an allow listed deployer. The `Stateful Precompile` contract powering the `ContractDeployerAllowList` adheres to the [AllowList Solidity interface](#allowlist-interface) at `0x0200000000000000000000000000000000000000` (you can load this interface and interact directly in Remix): - If you attempt to add a `Enabled` and you are not an `Admin`, you will see something like: ![admin fail](/images/customize1.png) - If you attempt to deploy a contract but you are not an `Admin` not a `Enabled`, you will see something like: ![deploy fail](/images/customize2.png) - If you call `readAllowList(addr)` then you can read the current role of `addr`, which will return a uint256 with a value of 0, 1, or 2, corresponding to the roles `None`, `Enabled`, and `Admin` respectively. If you remove all of the admins from the allow list, it will no longer be possible to update the allow list without modifying the Subnet-EVM to schedule a network upgrade. #### Initial Contract Allow List Configuration[​](#initial-contract-allow-list-configuration "Direct link to heading") It's possible to enable this precompile with an initial configuration to activate its effect on activation timestamp. This provides a way to enable the precompile without an admin address to manage the deployer list. With this, you can define a list of addresses that are allowed to deploy contracts. Since there will be no admin address to manage the deployer list, it can only be modified through a network upgrade. To use initial configuration, you need to specify addresses in `enabledAddresses` field in your genesis or upgrade file: ```json { "contractDeployerAllowListConfig": { "blockTimestamp": 0, "enabledAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } ``` This will allow only `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` to deploy contracts. For further information about precompile initial configurations see [Initial Precompile Configurations](#initial-precompile-configurations). ### Restricting Who Can Submit Transactions[​](#restricting-who-can-submit-transactions "Direct link to heading") Similar to restricting contract deployers, this precompile restricts which addresses may submit transactions on chain. Like the previous section, you can activate the precompile by including an `AllowList` configuration in your genesis file: ```json { "config": { "txAllowListConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } } ``` In this example, `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` is named as the `Admin` of the `TransactionAllowList`. This enables them to add other `Admins` or to add `Allowed`. `Admins`, `Manager` and `Enabled` can submit transactions to the chain. The `Stateful Precompile` contract powering the `TxAllowList` adheres to the [AllowList Solidity interface](#allowlist-interface) at `0x0200000000000000000000000000000000000002` (you can load this interface and interact directly in Remix): - If you attempt to add an `Enabled` and you are not an `Admin`, you will see something like: ![admin fail](/images/customize3.png) - If you attempt to submit a transaction but you are not an `Admin`, `Manager` or not `Enabled`, you will see something like: `cannot issue transaction from non-allow listed address` - If you call `readAllowList(addr)` then you can read the current role of `addr`, which will return a `uint256` with a value of 0, 1, 2 or 3 corresponding to the roles `None`, `Allowed`, `Admin` and `Manager` respectively. If you remove all of the admins and managers from the allow list, it will no longer be possible to update the allow list without modifying the Subnet-EVM to schedule a network upgrade. #### Initial TX Allow List Configuration[​](#initial-tx-allow-list-configuration "Direct link to heading") It's possible to enable this precompile with an initial configuration to activate its effect on activation timestamp. This provides a way to enable the precompile without an admin address to manage the TX allow list. With this, you can define a list of addresses that are allowed to submit transactions. Since there will be no admin address to manage the TX list, it can only be modified through a network upgrade. To use initial configuration, you need to specify addresses in `enabledAddresses` field in your genesis or upgrade file: ```json { "txAllowListConfig": { "blockTimestamp": 0, "enabledAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } ``` This will allow only `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` to submit transactions. For further information about precompile initial configurations see [Initial Precompile Configurations](#initial-precompile-configurations). ### Minting Native Coins[​](#minting-native-coins "Direct link to heading") You can mint native(gas) coins with a precompiled contract. In order to activate this feature, you can provide `nativeMinterConfig` in genesis: ```json { "config": { "contractNativeMinterConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } } ``` `adminAddresses` denotes admin accounts who can add other `Admin`, `Manager` or `Enabled` accounts. `Admin`, `Manager` and `Enabled` are both eligible to mint native coins for other addresses. `ContractNativeMinter` uses same methods as in `ContractDeployerAllowList`. The `Stateful Precompile` contract powering the `ContractNativeMinter` adheres to the following Solidity interface at `0x0200000000000000000000000000000000000001` (you can load this interface and interact directly in Remix): ```solidity // (c) 2022-2023, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. pragma solidity ^0.8.0; import "./IAllowList.sol"; interface INativeMinter is IAllowList { event NativeCoinMinted( address indexed sender, address indexed recipient, uint256 amount ); // Mint [amount] number of native coins and send to [addr] function mintNativeCoin(address addr, uint256 amount) external; } ``` `mintNativeCoin` takes an address and amount of native coins to be minted. The amount denotes the amount in minimum denomination of native coins (10^18). For example, if you want to mint 1 native coin (in AVAX), you need to pass 1 \* 10^18 as the amount. A `NativeCoinMinted` event is emitted with the sender, recipient and amount when a native coin is minted. Note that this uses `IAllowList` interface directly, meaning that it uses the same `AllowList` interface functions like `readAllowList` and `setAdmin`, `setManager`, `setEnabled`, `setNone`. For more information see [AllowList Solidity interface](#allowlist-interface). EVM does not prevent overflows when storing the address balance. Overflows in balance opcodes are handled by setting the balance to maximum. However the same won't apply for API calls. If you try to mint more than the maximum balance, API calls will return the overflowed hex-balance. This can break external tooling. Make sure the total supply of native coins is always less than 2^256-1. #### Initial Native Minter Configuration[​](#initial-native-minter-configuration "Direct link to heading") It's possible to enable this precompile with an initial configuration to activate its effect on activation timestamp. This provides a way to enable the precompile without an admin address to mint native coins. With this, you can define a list of addresses that will receive an initial mint of the native coin when this precompile activates. This can be useful for networks that require a one-time mint without specifying any admin addresses. To use initial configuration, you need to specify a map of addresses with their corresponding mint amounts in `initialMint` field in your genesis or upgrade file: ```json { "contractNativeMinterConfig": { "blockTimestamp": 0, "initialMint": { "0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": "1000000000000000000", "0x10037Fb06Ec4aB8c870a92AE3f00cD58e5D484b3": "0xde0b6b3a7640000" } } } ``` In the amount field you can specify either decimal or hex string. This will mint 1000000000000000000 (equivalent of 1 Native Coin denominated as 10^18) to both addresses. Note that these are both in string format. "0xde0b6b3a7640000" hex is equivalent to 1000000000000000000. For further information about precompile initial configurations see [Initial Precompile Configurations](#initial-precompile-configurations). ### Configuring Dynamic Fees[​](#configuring-dynamic-fees "Direct link to heading") You can configure the parameters of the dynamic fee algorithm on chain using the `FeeConfigManager`. In order to activate this feature, you will need to provide the `FeeConfigManager` in the genesis: ```json { "config": { "feeManagerConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } } ``` The precompile implements the `FeeManager` interface which includes the same `AllowList` interface used by ContractNativeMinter, TxAllowList, etc. For an example of the `AllowList` interface, see the [TxAllowList](#allowlist-interface) above. The `Stateful Precompile` contract powering the `FeeConfigManager` adheres to the following Solidity interface at `0x0200000000000000000000000000000000000003` (you can load this interface and interact directly in Remix). It can be also found in [IFeeManager.sol](https://github.com/ava-labs/subnet-evm/blob/5faabfeaa021a64c2616380ed2d6ec0a96c8f96d/contract-examples/contracts/IFeeManager.sol): ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.0; import "./IAllowList.sol"; interface IFeeManager is IAllowList { struct FeeConfig { uint256 gasLimit; uint256 targetBlockRate; uint256 minBaseFee; uint256 targetGas; uint256 baseFeeChangeDenominator; uint256 minBlockGasCost; uint256 maxBlockGasCost; uint256 blockGasCostStep; } event FeeConfigChanged( address indexed sender, FeeConfig oldFeeConfig, FeeConfig newFeeConfig ); // Set fee config fields to contract storage function setFeeConfig( uint256 gasLimit, uint256 targetBlockRate, uint256 minBaseFee, uint256 targetGas, uint256 baseFeeChangeDenominator, uint256 minBlockGasCost, uint256 maxBlockGasCost, uint256 blockGasCostStep ) external; // Get fee config from the contract storage function getFeeConfig() external view returns ( uint256 gasLimit, uint256 targetBlockRate, uint256 minBaseFee, uint256 targetGas, uint256 baseFeeChangeDenominator, uint256 minBlockGasCost, uint256 maxBlockGasCost, uint256 blockGasCostStep ); // Get the last block number changed the fee config from the contract storage function getFeeConfigLastChangedAt() external view returns (uint256 blockNumber); } ``` FeeConfigManager precompile uses `IAllowList` interface directly, meaning that it uses the same `AllowList` interface functions like `readAllowList` and `setAdmin`, `setManager`, `setEnabled`, `setNone`. For more information see [AllowList Solidity interface](#allowlist-interface). In addition to the `AllowList` interface, the FeeConfigManager adds the following capabilities: - `getFeeConfig`: retrieves the current dynamic fee config - `getFeeConfigLastChangedAt`: retrieves the timestamp of the last block where the fee config was updated - `setFeeConfig`: sets the dynamic fee config on chain (see [here](#fee-config) for details on the fee config parameters). This function can only be called by an `Admin`, `Manager` or `Enabled` address. - `FeeConfigChanged`: an event that is emitted when the fee config is updated. Topics include the sender, the old fee config, and the new fee config. You can also get the fee configuration at a block with the `eth_feeConfig` RPC method. For more information see [here](/docs/rpcs/subnet-evm#eth_feeconfig). #### Initial Fee Config Configuration[​](#initial-fee-config-configuration "Direct link to heading") It's possible to enable this precompile with an initial configuration to activate its effect on activation timestamp. This provides a way to define your fee structure to take effect at the activation. To use the initial configuration, you need to specify the fee config in `initialFeeConfig` field in your genesis or upgrade file: ```json { "feeManagerConfig": { "blockTimestamp": 0, "initialFeeConfig": { "gasLimit": 20000000, "targetBlockRate": 2, "minBaseFee": 1000000000, "targetGas": 100000000, "baseFeeChangeDenominator": 48, "minBlockGasCost": 0, "maxBlockGasCost": 10000000, "blockGasCostStep": 500000 } } } ``` This will set the fee config to the values specified in the `initialFeeConfig` field. For further information about precompile initial configurations see [Initial Precompile Configurations](#initial-precompile-configurations). ### Avalanche Warp Messaging[​](#avalanche-warp-messaging "Direct link to heading") Currently Warp Precompile can only be activated in Mainnet after Durango occurs. Durango in Mainnet is set at 11 AM ET (4 PM UTC) on Wednesday, March 6th, 2024. If you plan to use Warp messaging in your own Subnet-EVM chain in Mainnet you should upgrade to AvalancheGo 1.11.11 or later and coordinate your precompile upgrade. Warp Config's "blockTimestamp" must be set after `1709740800`, Durango date (11 AM ET (4 PM UTC) on Wednesday, March 6th, 2024). Contract Examples[​](#contract-examples "Direct link to heading") ----------------------------------------------------------------- Subnet-EVM contains example contracts for precompiles under `/contracts`. It's a hardhat project with tests and tasks. For more information see [contract examples README](https://github.com/ava-labs/subnet-evm/tree/master/contracts#subnet-evm-contracts). Network Upgrades: Enable/Disable Precompiles[​](#network-upgrades-enabledisable-precompiles "Direct link to heading") --------------------------------------------------------------------------------------------------------------------- Performing a network upgrade requires coordinating the upgrade network-wide. A network upgrade changes the rule set used to process and verify blocks, such that any node that upgrades incorrectly or fails to upgrade by the time that upgrade goes into effect may become out of sync with the rest of the network. Any mistakes in configuring network upgrades or coordinating them on validators may cause the network to halt and recovering may be difficult. In addition to specifying the configuration for each of the above precompiles in the genesis chain config, they can be individually enabled or disabled at a given timestamp as a network upgrade. Disabling a precompile disables calling the precompile and destructs its storage so it can be enabled at a later timestamp with a new configuration if desired. These upgrades must be specified in a file named `upgrade.json` placed in the same directory where [`config.json`](#avalanchego-chain-configs) resides: `{chain-config-dir}/{blockchainID}/upgrade.json`. For example, `WAGMI Subnet` upgrade should be placed in `~/.avalanchego/configs/chains/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt/upgrade.json`. The content of the `upgrade.json` should be formatted according to the following: ```json { "precompileUpgrades": [ { "[PRECOMPILE_NAME]": { "blockTimestamp": "[ACTIVATION_TIMESTAMP]", // unix timestamp precompile should activate at "[PARAMETER]": "[VALUE]" // precompile specific configuration options, eg. "adminAddresses" } } ] } ``` An invalid `blockTimestamp` in an upgrade file results the update failing. The `blockTimestamp` value should be set to a valid Unix timestamp value which is in the _future_ relative to the _head of the chain_. If the node encounters a `blockTimestamp` which is in the past, it will fail on startup. To disable a precompile, the following format should be used: ```json { "precompileUpgrades": [ { "": { "blockTimestamp": "[DEACTIVATION_TIMESTAMP]", // unix timestamp the precompile should deactivate at "disable": true } } ] } ``` Each item in `precompileUpgrades` must specify exactly one precompile to enable or disable and the block timestamps must be in increasing order. Once an upgrade has been activated (a block after the specified timestamp has been accepted), it must always be present in `upgrade.json` exactly as it was configured at the time of activation (otherwise the node will refuse to start). Enabling and disabling a precompile is a network upgrade and should always be done with caution. For safety, you should always treat `precompileUpgrades` as append-only. As a last resort measure, it is possible to abort or reconfigure a precompile upgrade that has not been activated since the chain is still processing blocks using the prior rule set. If aborting an upgrade becomes necessary, you can remove the precompile upgrade from `upgrade.json` from the end of the list of upgrades. As long as the blockchain has not accepted a block with a timestamp past that upgrade's timestamp, it will abort the upgrade for that node. ### Example[​](#example "Direct link to heading") ```json { "precompileUpgrades": [ { "feeManagerConfig": { "blockTimestamp": 1668950000, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } }, { "txAllowListConfig": { "blockTimestamp": 1668960000, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } }, { "feeManagerConfig": { "blockTimestamp": 1668970000, "disable": true } } ] } ``` This example enables the `feeManagerConfig` at the first block with timestamp >= `1668950000`, enables `txAllowListConfig` at the first block with timestamp >= `1668960000`, and disables `feeManagerConfig` at the first block with timestamp >= `1668970000`. When a precompile disable takes effect (that is, after its `blockTimestamp` has passed), its storage will be wiped. If you want to reenable it, you will need to treat it as a new configuration. After you have created the `upgrade.json` and placed it in the chain config directory, you need to restart the node for the upgrade file to be loaded (again, make sure you don't restart all Avalanche L1 validators at once!). On node restart, it will print out the configuration of the chain, where you can double-check that the upgrade has loaded correctly. In our example: ```bash INFO [08-15|15:09:36.772] <2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt Chain> github.com/ava-labs/subnet-evm/eth/backend.go:155: Initialised chain configuration config=“{ChainID: 11111 Homestead: 0 EIP150: 0 EIP155: 0 EIP158: 0 Byzantium: 0 Constantinople: 0 Petersburg: 0 Istanbul: 0, Muir Glacier: 0, Subnet EVM: 0, FeeConfig: {\“gasLimit\“:20000000,\“targetBlockRate\“:2,\“minBaseFee\“:1000000000,\“targetGas\ “:100000000,\“baseFeeChangeDenominator\“:48,\“minBlockGasCost\“:0,\“maxBlockGasCost\ “:10000000,\“blockGasCostStep\“:500000}, AllowFeeRecipients: false, NetworkUpgrades: {\ “subnetEVMTimestamp\“:0}, PrecompileUpgrade: {}, UpgradeConfig: {\"precompileUpgrades\":[{\"feeManagerConfig\":{\"adminAddresses\":[\"0x8db97c7cece249c2b98bdc0226cc4c2a57bf52fc\"],\"enabledAddresses\":null,\"blockTimestamp\":1668950000}},{\"txAllowListConfig\":{\"adminAddresses\":[\"0x8db97c7cece249c2b98bdc0226cc4c2a57bf52fc\"],\"enabledAddresses\":null,\"blockTimestamp\":1668960000}},{\"feeManagerConfig\":{\"adminAddresses\":null,\"enabledAddresses\":null,\"blockTimestamp\":1668970000,\"disable\":true}}]}, Engine: Dummy Consensus Engine}" ``` Notice that `precompileUpgrades` entry correctly reflects the changes. You can also check the activated precompiles at a timestamp with the [`eth_getActivePrecompilesAt`](/docs/rpcs/subnet-evm#eth_getactiveprecompilesat) RPC method. The [`eth_getChainConfig`](/docs/rpcs/subnet-evm#eth_getchainconfig) RPC method will also return the configured upgrades in the response. That's it, your Avalanche L1 is all set and the desired upgrades will be activated at the indicated timestamp! ### Initial Precompile Configurations[​](#initial-precompile-configurations "Direct link to heading") Precompiles can be managed by some privileged addresses to change their configurations and activate their effects. For example, the `feeManagerConfig` precompile can have `adminAddresses` which can change the fee structure of the network. ```json { "precompileUpgrades": [ { "feeManagerConfig": { "blockTimestamp": 1668950000, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } ] } ``` In this example, only the address `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` is allowed to change the fee structure of the network. The admin address has to call the precompile in order to activate its effect; that is it needs to send a transaction with a new fee config to perform the update. This is a very powerful feature, but it also gives a large amount of power to the admin address. If the address `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` is compromised, the network is compromised. With the initial configurations, precompiles can immediately activate their effect on the activation timestamp. With this way admin addresses can be omitted from the precompile configuration. For example, the `feeManagerConfig` precompile can have `initialFeeConfig` to setup the fee configuration on the activation: ```json { "precompileUpgrades": [ { "feeManagerConfig": { "blockTimestamp": 1668950000, "initialFeeConfig": { "gasLimit": 20000000, "targetBlockRate": 2, "minBaseFee": 1000000000, "targetGas": 100000000, "baseFeeChangeDenominator": 48, "minBlockGasCost": 0, "maxBlockGasCost": 10000000, "blockGasCostStep": 500000 } } } ] } ``` Notice that there is no `adminAddresses` field in the configuration. This means that there will be no admin addresses to manage the fee structure with this precompile. The precompile will simply update the fee configuration to the specified fee config when it activates on the `blockTimestamp` `1668950000`. It's still possible to add `adminAddresses` or `enabledAddresses` along with these initial configurations. In this case, the precompile will be activated with the initial configuration, and admin/enabled addresses can access to the precompiled contract normally. If you want to change the precompile initial configuration, you will need to first disable it then activate the precompile again with the new configuration. See every precompile initial configuration in their relevant `Initial Configuration` sections under [Precompiles](#precompiles). AvalancheGo Chain Configs[​](#avalanchego-chain-configs "Direct link to heading") --------------------------------------------------------------------------------- As described in [this doc](/docs/nodes/configure/configs-flags#avalanche-l1-chain-configs), each blockchain of Avalanche L1s can have its own custom configuration. If an Avalanche L1's ChainID is `2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt`, the config file for this chain is located at `{chain-config-dir}/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt/config.json`. For blockchains created by or forked from Subnet-EVM, most [C-Chain configs](/docs/nodes/chain-configs/primary-network/c-chain) are applicable except [Avalanche Specific APIs](/docs/nodes/chain-configs/primary-network/c-chain#enabling-avalanche-specific-apis). ### Priority Regossip[​](#priority-regossip "Direct link to heading") A transaction is "regossiped" when the node does not find the transaction in a block after `priority-regossip-frequency` (defaults to `1m`). By default, up to 16 transactions (max 1 per address) are regossiped to validators per minute. Operators can use "priority regossip" to more aggressively "regossip" transactions for a set of important addresses (like bridge relayers). To do so, you'll need to update your [chain config](/docs/nodes/configure/configs-flags#avalanche-l1-chain-configs) with the following: ```json { "priority-regossip-addresses": [""] } ``` By default, up to 32 transactions from priority addresses (max 16 per address) are regossipped to validators per second. You can override these defaults with the following config: ```json { "priority-regossip-frequency": "1s", "priority-regossip-max-txs": 32, "priority-regossip-addresses": [""], "priority-regossip-txs-per-address": 16 } ``` ### Fee Recipient[​](#fee-recipient "Direct link to heading") This works together with [`allowFeeRecipients`](#setting-a-custom-fee-recipient) and [RewardManager precompile](/docs/avalanche-l1s/precompiles/reward-manager) to specify where the fees should be sent to. With `allowFeeRecipients` enabled, validators can specify their addresses to collect fees. ```json { "feeRecipient": "" } ``` If `allowFeeRecipients` or `RewardManager` precompile is enabled on the Avalanche L1, but a validator doesn't specify a "feeRecipient", the fees will be burned in blocks it produces. ### Archival Node Configuration[​](#archival-node-configuration "Direct link to heading") Running an archival node that retains all historical state data requires specific configuration settings. Incorrect configuration can lead to historical data being pruned despite attempts to run in archival mode. Here are the key settings to configure: #### Disabling Pruning To retain all historical state, you must disable pruning. For EVM chains (like C-Chain or Subnet-EVM chains), add the following to your chain's `config.json`: ```json { "pruning-enabled": false } ``` #### State Sync Considerations State sync allows nodes to quickly sync by downloading recent state without processing all historical blocks. This can lead to missing historical data. For archival nodes, either disable state sync or ensure you start from genesis: ```json { "state-sync-enabled": false } ``` #### Transaction History Settings To maintain access to all historical transactions, you might need to configure these additional settings: ```json { "transaction-history": 0 } ``` #### Database Considerations Important: An already synced database cannot be fully converted to an archival node retroactively. The cleanest and most reliable way to set up an archival node is to start from scratch with the proper configuration. When switching between database types (e.g., from LevelDB to PebbleDB), historical data does not carry over. If you need to change the database type for your archival node, you must start a fresh sync from genesis. For information about all available configuration options and directory structures, see the [AvalancheGo Config Flags documentation](https://build.avax.network/docs/nodes/configure/configs-flags). Network Upgrades: State Upgrades[​](#network-upgrades-state-upgrades "Direct link to heading") ---------------------------------------------------------------------------------------------- Subnet-EVM allows the network operators to specify a modification to state that will take place at the beginning of the first block with a timestamp greater than or equal to the one specified in the configuration. This provides a last resort path to updating non-upgradeable contracts via a network upgrade (for example, to fix issues when you are running your own blockchain). This should only be used as a last resort alternative to forking `subnet-evm` and specifying the network upgrade in code. Using a network upgrade to modify state is not part of normal operations of the EVM. You should ensure the modifications do not invalidate any of the assumptions of deployed contracts or cause incompatibilities with downstream infrastructure such as block explorers. The timestamps for upgrades in `stateUpgrades` must be in increasing order. `stateUpgrades` can be specified along with `precompileUpgrades` or by itself. The following three state modifications are supported: - `balanceChange`: adds a specified amount to the balance of a given account. This amount can be specified as hex or decimal and must be positive. - `storage`: modifies the specified storage slots to the specified values. Keys and values must be 32 bytes specified in hex, with a `0x` prefix. - `code`: modifies the code stored in the specified account. The code must _only_ be the runtime portion of a code. The code must start with a `0x` prefix. If modifying the code, _only_ the runtime portion of the bytecode should be provided in `upgrades.json`. Do not use the bytecode that would be used for deploying a new contract, as this includes the constructor code as well. Refer to your compiler's documentation for information on how to find the runtime portion of the contract you wish to modify. The `upgrades.json` file shown below describes a network upgrade that will make the following state modifications at the first block after (or at) `March 8, 2023 1:30:00 AM GMT`: - Sets the code for the account at `0x71562b71999873DB5b286dF957af199Ec94617F7`, - And adds `100` wei to the balance of the account at `0xb794f5ea0ba39494ce839613fffba74279579268`, - Sets the storage slot `0x1234` to the value `0x6666` for the account at `0xb794f5ea0ba39494ce839613fffba74279579268`. ```json { "stateUpgrades": [ { "blockTimestamp": 1678239000, "accounts": { "0x71562b71999873DB5b286dF957af199Ec94617F7": { "code": "0x6080604052348015600f57600080fd5b506004361060285760003560e01c80632e64cec114602d575b600080fd5b60336047565b604051603e91906067565b60405180910390f35b60008054905090565b6000819050919050565b6061816050565b82525050565b6000602082019050607a6000830184605a565b9291505056fea26469706673582212209421042a1fdabcfa2486fb80942da62c28e61fc8362a3f348c4a96a92bccc63c64736f6c63430008120033" }, "0xb794f5ea0ba39494ce839613fffba74279579268": { "balanceChange": "0x64", "storage": { "0x0000000000000000000000000000000000000000000000000000000000001234": "0x0000000000000000000000000000000000000000000000000000000000006666" } } } } ] } ``` Network Upgrades: Rescheduling Mandatory Network Upgrades[​](#network-upgrades-rescheduling-mandatory-network-upgrades "Direct link to heading") ------------------------------------------------------------------------------------------------------------------------------------------------ A typical case when a network misses any mandatory activation would result in a network that is not able to operate. This is because validators/nodes running the old version would process transactions differently than nodes running the new version and end up different state. This would result in a fork in the network and new nodes would not be able to sync with the network. Normally this puts the chain in a halt and requires a hard fork to fix the issue. Starting with Subnet-EVM v0.6.3, you can reschedule mandatory activations like Durango via upgrade configs (upgrade.json in chain directory). This is a very advanced operation and should be done only if your network cannot operate going forward. The reschedule operation should be coordinated with your entire network nodes. Network upgrade overrides can be defined in the `upgrade.json` as follows: ```json { "networkUpgradeOverrides": { "{networkUpgrade1}": timestamp1, "{networkUpgrade2}": timestamp2, } } ``` The `timestamp` should be a Unix timestamp in seconds. For instance, if you missed the Durango activation in Fuji (February 13th, 2024, 16:00 UTC) or Mainnet (March 6th, 2024, 16:00 UTC) and having issues in your network, you can reschedule the Durango activation via upgrades. In order to do this, you need to prepare a new upgrade.json including following: ```json { "networkUpgradeOverrides": { "durangoTimestamp": 1712419200 } } ``` This reschedules the Durango activation to 2024-11-06 16:00:00 UTC (one month later than the actual activation). After preparing the upgrade.json, you need to update the chain directory with the new upgrade.json and restart your nodes. You should see logs similar to the following: ```bash INFO [03-22|14:04:48.284] github.com/ava-labs/subnet-evm/plugin/evm/vm.go:367: Applying network upgrade overrides overrides="{\"durangoTimestamp\":1712419200}" ... INFO [03-22|14:04:48.288] github.com/ava-labs/subnet-evm/core/blockchain.go:335: Avalanche Upgrades (timestamp based): INFO [03-22|14:04:48.288] github.com/ava-labs/subnet-evm/core/blockchain.go:335: - SubnetEVM Timestamp: @0 (https://github.com/ava-labs/avalanchego/releases/tag/v1.10.0) INFO [03-22|14:04:48.288] github.com/ava-labs/subnet-evm/core/blockchain.go:335: - Durango Timestamp: @1712419200 (https://github.com/ava-labs/avalanchego/releases/tag/v1.11.0) ... ``` This means your node is lock and loaded for the new Durango activation. After the new timestamp is reached, your node will activate Durango and start processing transactions with the new Durango features. Nodes running non-compatible version (running pre-Durango version after Durango activation), should be updated to most recent version of Subnet-EVM (v0.6.3+) and must have the new upgrade.json to reschedule the Durango activation. Running a new version without the rescheduling upgrade.json might create a fork in the network. All of network nodes, even ones correctly upgraded to Durango and running the correct version since Durango activation, should be restarted with the new upgrade.json to reschedule the Durango activation. This is a network-wide operation and should be coordinated with all network nodes. # Introduction (/docs/avalanche-l1s/evm-configuration/evm-l1-customization) --- title: Introduction description: Learn how to customize the Ethereum Virtual Machine with EVM and Precompiles. root: true --- Welcome to the EVM configuration guide. This documentation explores how to extend and customize your Avalanche L1 using **EVM** and **precompiles**. Building upon the Validator Manager capabilities we discussed in the previous section, we'll now dive into other powerful customization features available in EVM. ## Overview of EVM EVM is Avalanche's customized version of the Ethereum Virtual Machine, tailored to run on Avalanche L1s. It allows developers to deploy Solidity smart contracts with enhanced capabilities, benefiting from Avalanche's high throughput and low latency. EVM enables more flexibility and performance optimizations compared to the standard EVM. Beyond the Validator Manager functionality we've covered, EVM provides additional configuration options through precompiles, allowing you to extend your L1's capabilities even further. ## Genesis Configuration Each blockchain has some genesis state when it's created. Each Virtual Machine defines the format and semantics of its genesis data. The genesis configuration is crucial for setting up your Avalanche L1's initial state and behavior. ### Chain Configuration The chain configuration section in your genesis file defines fundamental parameters of your blockchain: ```json { "config": { "chainId": 43214, "homesteadBlock": 0, "eip150Block": 0, "eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0", "eip155Block": 0, "eip158Block": 0, "byzantiumBlock": 0, "constantinopleBlock": 0, "petersburgBlock": 0, "istanbulBlock": 0, "muirGlacierBlock": 0 } } ``` #### Chain ID `chainID`: Denotes the ChainID of to be created chain. Must be picked carefully since a conflict with other chains can cause issues. One suggestion is to check with [chainlist.org](https://chainlist.org/) to avoid ID collision, reserve and publish your ChainID properly. You can use `eth_getChainConfig` RPC call to get the current chain config. See [here](/docs/rpcs/subnet-evm#eth_getchainconfig) for more info. #### Hard Forks The following parameters define EVM hard fork activation times. These should be handled with care as changes may cause compatibility issues: - `homesteadBlock` - `eip150Block` - `eip150Hash` - `eip155Block` - `byzantiumBlock` - `constantinopleBlock` - `petersburgBlock` - `istanbulBlock` - `muirGlacierBlock` ### Genesis Block Header The genesis block header is defined by several parameters that set the initial state of your blockchain: ```json { "nonce": "0x0", "timestamp": "0x0", "extraData": "0x00", "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000" } ``` These parameters have specific roles: - `nonce`, `mixHash`, `difficulty`: These are remnants from Proof of Work systems. For Avalanche, they don't play any relevant role and should be left as their default values. - `timestamp`: The creation timestamp of the genesis block (commonly set to `0x0`). - `extraData`: Optional extra data field (commonly set to `0x`). - `coinbase`: The address of block producers (usually set to zero address for genesis). - `parentHash`: The hash of the parent block (set to zero hash for genesis). - `gasUsed`: Amount of gas used by the genesis block (usually `0x0`). - `number`: The block number (must be `0x0` for genesis). ## Precompiles Precompiles are specialized smart contracts that execute native Go code within the EVM context. They act as a bridge between Solidity and lower-level functionalities, allowing for performance optimizations and access to features not available in Solidity alone. ### Default Precompiles in EVM EVM comes with a set of default precompiles that extend the EVM's functionality: - **[AllowList Interface](/docs/avalanche-l1s/precompiles/allowlist-interface)**: Interface that manages access control by allowing or restricting specific addresses, inherited by all precompiles. - **[Deployer AllowList](/docs/avalanche-l1s/precompiles/deployer-allowlist)**: Restricts which addresses can deploy smart contracts. - **[Transaction AllowList](/docs/avalanche-l1s/precompiles/transaction-allowlist)**: Controls which addresses can submit transactions. - **[Native Minter](/docs/avalanche-l1s/precompiles/native-minter)**: Manages the minting and burning of native tokens. - **[Fee Manager](/docs/avalanche-l1s/precompiles/fee-manager)**: Controls gas fee parameters and fee markets. - **[Reward Manager](/docs/avalanche-l1s/precompiles/reward-manager)**: Handles the distribution of staking rewards to validators. - **[Warp Messenger](/docs/avalanche-l1s/precompiles/warp-messenger)**: Enables cross-chain communication between Avalanche L1s. ### Precompile Addresses and Configuration If a precompile is enabled within the `genesis.json` using the respective `ConfigKey`, you can interact with the precompile using Foundry or other tools such as Remix. Below are the addresses and `ConfigKey` values of default precompiles available in EVM. The address and `ConfigKey` [are defined in the `module.go` of each precompile contract](https://github.com/ava-labs/subnet-evm/tree/master/precompile/contracts). | Precompile | ConfigKey | Address | | ---------------------- | --------------------------------- | -------------------------------------------- | | [Deployer AllowList](/docs/avalanche-l1s/precompiles/deployer-allowlist) | `contractDeployerAllowListConfig` | `0x0200000000000000000000000000000000000000` | | [Native Minter](/docs/avalanche-l1s/precompiles/native-minter) | `contractNativeMinterConfig` | `0x0200000000000000000000000000000000000001` | | [Transaction AllowList](/docs/avalanche-l1s/precompiles/transaction-allowlist) | `txAllowListConfig` | `0x0200000000000000000000000000000000000002` | | [Fee Manager](/docs/avalanche-l1s/precompiles/fee-manager) | `feeManagerConfig` | `0x0200000000000000000000000000000000000003` | | [Reward Manager](/docs/avalanche-l1s/precompiles/reward-manager) | `rewardManagerConfig` | `0x0200000000000000000000000000000000000004` | | [Warp Messenger](/docs/avalanche-l1s/precompiles/warp-messenger) | `warpConfig` | `0x0200000000000000000000000000000000000005` | #### Example Interaction For example, if `contractDeployerAllowListConfig` is enabled in the `genesis.json`: ```json title="genesis.json" "contractDeployerAllowListConfig": { "adminAddresses": [ // Addresses that can manage (add/remove) enabled addresses. They are also enabled themselves for contract deployment. "0x4f9e12d407b18ad1e96e4f139ef1c144f4058a4e", "0x4b9e5977a46307dd93674762f9ddbe94fb054def" ], "blockTimestamp": 0, "enabledAddresses": [ "0x09c6fa19dd5d41ec6d0f4ca6f923ec3d941cc569" // Addresses that can only deploy contracts ] }, ``` We can then add an `Enabled` address to the Deployer AllowList by interacting with the `IAllowList` interface at `0x0200000000000000000000000000000000000000`: ```bash cast send 0x0200000000000000000000000000000000000000 setEnabled(address addr) --rpc-url $MY_L1_RPC --private-key $ADMIN_PRIVATE_KEY ``` # WarpMessenger Precompile - Technical Details (/docs/avalanche-l1s/evm-configuration/warpmessenger) --- title: "WarpMessenger Precompile - Technical Details" description: "Technical documentation for the WarpMessenger precompile implementation in subnet-evm." edit_url: https://github.com/ava-labs/subnet-evm/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/precompile/contracts/warp/README.md --- # Integrating Avalanche Warp Messaging into the EVM Avalanche Warp Messaging offers a basic primitive to enable Cross-L1 communication on the Avalanche Network. It is intended to allow communication between arbitrary Custom Virtual Machines (including, but not limited to Subnet-EVM and Coreth). ## How does Avalanche Warp Messaging Work? Avalanche Warp Messaging uses BLS Multi-Signatures with Public-Key Aggregation where every Avalanche validator registers a public key alongside its NodeID on the Avalanche P-Chain. Every node tracking an Avalanche L1 has read access to the Avalanche P-Chain. This provides weighted sets of BLS Public Keys that correspond to the validator sets of each L1 on the Avalanche Network. Avalanche Warp Messaging provides a basic primitive for signing and verifying messages between L1s: the receiving network can verify whether an aggregation of signatures from a set of source L1 validators represents a threshold of stake large enough for the receiving network to process the message. For more details on Avalanche Warp Messaging, see the AvalancheGo [Warp README](https://docs.avax.network/build/cross-chain/awm/deep-dive). ### Flow of Sending / Receiving a Warp Message within the EVM The Avalanche Warp Precompile enables this flow to send a message from blockchain A to blockchain B: 1. Call the Warp Precompile `sendWarpMessage` function with the arguments for the `UnsignedMessage` 2. Warp Precompile emits an event / log containing the `UnsignedMessage` specified by the caller of `sendWarpMessage` 3. Network accepts the block containing the `UnsignedMessage` in the log, so that validators are willing to sign the message 4. An off-chain relayer queries the validators for their signatures of the message and aggregates the signatures to create a `SignedMessage` 5. The off-chain relayer encodes the `SignedMessage` as the [predicate](#predicate-encoding) in the AccessList of a transaction to deliver on blockchain B 6. The transaction is delivered on blockchain B, the signature is verified prior to executing the block, and the message is accessible via the Warp Precompile's `getVerifiedWarpMessage` during the execution of that transaction ### Warp Precompile The Warp Precompile is broken down into three functions defined in the Solidity interface file [here](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/contracts/contracts/interfaces/IWarpMessenger.sol). #### sendWarpMessage `sendWarpMessage` is used to send a verifiable message. Calling this function results in sending a message with the following contents: - `SourceChainID` - blockchainID of the sourceChain on the Avalanche P-Chain - `SourceAddress` - `msg.sender` encoded as a 32 byte value that calls `sendWarpMessage` - `Payload` - `payload` argument specified in the call to `sendWarpMessage` emitted as the unindexed data of the resulting log Calling this function will issue a `SendWarpMessage` event from the Warp Precompile. Since the EVM limits the number of topics to 4 including the EventID, this message includes only the topics that would be expected to help filter messages emitted from the Warp Precompile the most. Specifically, the `payload` is not emitted as a topic because each topic must be encoded as a hash. Therefore, we opt to take advantage of each possible topic to maximize the possible filtering for emitted Warp Messages. Additionally, the `SourceChainID` is excluded because anyone parsing the chain can be expected to already know the blockchainID. Therefore, the `SendWarpMessage` event includes the indexable attributes: - `sender` - The `messageID` of the unsigned message (sha256 of the unsigned message) The actual `message` is the entire [Avalanche Warp Unsigned Message](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/unsigned_message.go#L14) including an [AddressedCall](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm/warp/payload#readme). The unsigned message is emitted as the unindexed data in the log. #### getVerifiedMessage `getVerifiedMessage` is used to read the contents of the delivered Avalanche Warp Message into the expected format. It returns the message if present and a boolean indicating if a message is present. To use this function, the transaction must include the signed Avalanche Warp Message encoded in the [predicate](#predicate-encoding) of the transaction. Prior to executing a block, the VM iterates through transactions and pre-verifies all predicates. If a transaction's predicate is invalid, then it is considered invalid to include in the block and dropped. This leads to the following advantages: 1. The EVM execution does not need to verify the Warp Message at runtime (no signature verification or external calls to the P-Chain) 2. The EVM can deterministically re-execute and re-verify blocks assuming the predicate was verified by the network (e.g., in bootstrapping) This pre-verification is performed using the ProposerVM Block header during [block verification](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/plugin/evm/block.go#L220) and [block building](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/miner/worker.go#L200). #### getBlockchainID `getBlockchainID` returns the blockchainID of the blockchain that the VM is running on. This is different from the conventional Ethereum ChainID registered to [ChainList](https://chainlist.org/). The `blockchainID` in Avalanche refers to the txID that created the blockchain on the Avalanche P-Chain ([docs](https://docs.avax.network/specs/platform-transaction-serialization#unsigned-create-chain-tx)). ### Predicate Encoding Avalanche Warp Messages are encoded as a signed Avalanche [Warp Message](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/message.go) where the [UnsignedMessage](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/unsigned_message.go)'s payload includes an [AddressedPayload](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/payload/payload.go). Since the predicate is encoded into the [Transaction Access List](https://eips.ethereum.org/EIPS/eip-2930), it is packed into 32 byte hashes intended to declare storage slots that should be pre-warmed into the cache prior to transaction execution. Therefore, we use the [Predicate Utils](https://github.com/ava-labs/subnet-evm/blob/master/predicate/Predicate.md) package to encode the actual byte slice of size N into the access list. ### Performance Optimization: Primary Network to Avalanche L1 The Primary Network has a large validator set compared to most Subnets and L1s, which makes Warp signature collection and verification from the entire Primary Network validator set costly. All Subnets and L1s track at least one blockchain of the Primary Network, so we can instead optimize this by using the validator set of the receiving L1 instead of the Primary Network for certain Warp messages. #### Subnets Recall that Avalanche Subnet validators must also validate the Primary Network, so it tracks all of the blockchains in the Primary Network (X, C, and P-Chains). When an Avalanche Subnet receives a message from a blockchain on the Primary Network, we use the validator set of the receiving Subnet instead of the entire network when validating the message. Sending messages from the X, C, or P-Chain remains unchanged. However, when the Subnet receives the message, it changes the semantics to the following: 1. Read the `SourceChainID` of the signed message 2. Look up the `SubnetID` that validates `SourceChainID`. In this case it will be the Primary Network's `SubnetID` 3. Look up the validator set of the Subnet (instead of the Primary Network) and the registered BLS Public Keys of the Subnet validators at the P-Chain height specified by the ProposerVM header 4. Continue Warp Message verification using the validator set of the Subnet instead of the Primary Network This means that Primary Network to Subnet communication only requires a threshold of stake on the receiving Subnet to sign the message instead of a threshold of stake for the entire Primary Network. Since the security of the Subnet is provided by trust in its validator set, requiring a threshold of stake from the receiving Subnet's validator set instead of the whole Primary Network does not meaningfully change the security of the receiving L1. Note: this special case is ONLY applied during Warp Message verification. The message sent by the Primary Network will still contain the blockchainID of the Primary Network chain that sent the message as the sourceChainID and signatures will be served by querying the source chain directly. #### L1s Avalanche L1s are only required to sync the P-Chain, but are not required to validate the Primary Network. Therefore, **for L1s, this optimization only applies to Warp messages sent by the P-Chain.** The rest of the description of this optimization in the above section applies to L1s. Note that **in order to properly verify messages from the C-Chain and X-Chain, the Warp precompile must be configured with `requirePrimaryNetworkSigners` set to `true`**. Otherwise, we will attempt to verify the message signature against the receiving L1's validator set, which is not required to track the C-Chain or X-Chain, and therefore will not in general be able to produce a valid Warp message. ## Design Considerations ### Re-Processing Historical Blocks Avalanche Warp Messaging depends on the Avalanche P-Chain state at the P-Chain height specified by the ProposerVM block header. Verifying a message requires looking up the validator set of the source L1 on the P-Chain. To support this, Avalanche Warp Messaging uses the ProposerVM header, which includes the P-Chain height it was issued at as the canonical point to lookup the source L1's validator set. This means verifying the Warp Message and therefore the state transition on a block depends on state that is external to the blockchain itself: the P-Chain. The Avalanche P-Chain tracks only its current state and reverse diff layers (reversing the changes from past blocks) in order to re-calculate the validator set at a historical height. This means calculating a very old validator set that is used to verify a Warp Message in an old block may become prohibitively expensive. Therefore, we need a heuristic to ensure that the network can correctly re-process old blocks (note: re-processing old blocks is a requirement to perform bootstrapping and is used in some VMs to serve or verify historical data). As a result, we require that the block itself provides a deterministic hint which determines which Avalanche Warp Messages were considered valid/invalid during the block's execution. This ensures that we can always re-process blocks and use the hint to decide whether an Avalanche Warp Message should be treated as valid/invalid even after the P-Chain state that was used at the original execution time may no longer support fast lookups. To provide that hint, we've explored two designs: 1. Include a predicate in the transaction to ensure any referenced message is valid 2. Append the results of checking whether a Warp Message is valid/invalid to the block data itself The current implementation uses option (1). The original reason for this was that the notion of predicates for precompiles was designed with Shared Memory in mind. In the case of shared memory, there is no canonical "P-Chain height" in the block which determines whether or not Avalanche Warp Messages are valid. Instead, the VM interprets a shared memory import operation as valid as soon as the UTXO is available in shared memory. This means that if it were up to the block producer to staple the valid/invalid results of whether or not an attempted atomic operation should be treated as valid, a byzantine block producer could arbitrarily report that such atomic operations were invalid and cause a griefing attack to burn the gas of users that attempted to perform an import. Therefore, a transaction specified predicate is required to implement the shared memory precompile to prevent such a griefing attack. In contrast, Avalanche Warp Messages are validated within the context of an exact P-Chain height. Therefore, if a block producer attempted to lie about the validity of such a message, the network would interpret that block as invalid. ### Guarantees Offered by Warp Precompile vs. Built on Top #### Guarantees Offered by Warp Precompile The Warp Precompile was designed with the intention of minimizing the trusted computing base for the VM as much as possible. Therefore, it makes several tradeoffs which encourage users to use protocols built ON TOP of the Warp Precompile itself as opposed to directly using the Warp Precompile. The Warp Precompile itself provides ONLY the following ability: - Emit a verifiable message from (Address A, Blockchain A) to (Address B, Blockchain B) that can be verified by the destination chain #### Explicitly Not Provided / Built on Top The Warp Precompile itself does not provide any guarantees of: - Eventual message delivery (may require re-send on blockchain A and additional assumptions about off-chain relayers and chain progress) - Ordering of messages (requires ordering provided a layer above) - Replay protection (requires replay protection provided a layer above) # AllowList Interface (/docs/avalanche-l1s/precompiles/allowlist-interface) --- title: AllowList Interface description: The AllowList interface is used by many default precompiles to permission access to the features they provide. --- ## Overview The AllowList is a security feature used by precompiles to manage which addresses have permission to interact with certain contract functionalities. It provides a consistent role-based permission system inherited by all precompiles that use it. | Property | Value | |----------|-------| | **Address** | Inherited by each precompile | | **ConfigKey** | N/A (Interface only) | ## Role-Based Permissions The AllowList implements a consistent role-based permission system: | Role | Value | Description | Permissions | |------|-------|-------------|-------------| | Admin | 2 | Can manage all roles | Can add/remove any role (Admin, Manager, Enabled) | | Manager | 3 | Can manage enabled addresses | Can add/remove only Enabled addresses | | Enabled | 1 | Basic permissions | Can use the precompile's functionality | | None | 0 | No permissions | Cannot use the precompile or manage permissions | Each precompile that uses the AllowList interface follows this permission structure, though the specific actions allowed for "Enabled" addresses vary depending on the precompile's purpose. For example: - In the Contract Deployer AllowList, "Enabled" addresses can deploy contracts - In the Transaction AllowList, "Enabled" addresses can submit transactions - In the Native Minter, "Enabled" addresses can mint tokens ## Interface The AllowList interface is defined as follows: ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.24; interface IAllowList { event RoleSet(uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole); // Set [addr] to have the admin role over the precompile contract. function setAdmin(address addr) external; // Set [addr] to be enabled on the precompile contract. function setEnabled(address addr) external; // Set [addr] to have the manager role over the precompile contract. function setManager(address addr) external; // Set [addr] to have no role for the precompile contract. function setNone(address addr) external; // Read the status of [addr]. function readAllowList(address addr) external view returns (uint256 role); } ``` ## Implementation The AllowList interface is implemented by multiple precompiles in the Subnet-EVM. You can find the core implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/allowlist/allowlist.go). ## Precompiles Using AllowList Several precompiles in Subnet-EVM use the AllowList interface: - [Deployer AllowList](/docs/avalanche-l1s/precompiles/deployer-allowlist) - [Transaction AllowList](/docs/avalanche-l1s/precompiles/transaction-allowlist) - [Native Minter](/docs/avalanche-l1s/precompiles/native-minter) - [Fee Manager](/docs/avalanche-l1s/precompiles/fee-manager) - [Reward Manager](/docs/avalanche-l1s/precompiles/reward-manager) # Deployer AllowList (/docs/avalanche-l1s/precompiles/deployer-allowlist) --- title: Deployer AllowList description: Control which addresses can deploy smart contracts on your Avalanche L1 blockchain. --- ## Overview The Contract Deployer Allowlist allows you to maintain a controlled environment where only authorized addresses can deploy new smart contracts. This is particularly useful for: - Maintaining a curated ecosystem of verified contracts - Preventing malicious contract deployments - Implementing KYC/AML requirements for contract deployers | Property | Value | |----------|-------| | **Address** | `0x0200000000000000000000000000000000000000` | | **ConfigKey** | `contractDeployerAllowListConfig` | ## Configuration You can activate this precompile in your genesis file: ```json { "config": { "contractDeployerAllowListConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } } ``` By enabling this feature, you can define which addresses are allowed to deploy smart contracts and manage these permissions over time. ## Interface The Contract Deployer Allowlist implements the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface): ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.24; interface IAllowList { event RoleSet(uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole); // Set [addr] to have the admin role over the precompile contract. function setAdmin(address addr) external; // Set [addr] to be enabled on the precompile contract. function setEnabled(address addr) external; // Set [addr] to have the manager role over the precompile contract. function setManager(address addr) external; // Set [addr] to have no role for the precompile contract. function setNone(address addr) external; // Read the status of [addr]. function readAllowList(address addr) external view returns (uint256 role); } ``` ## Permissions Management The Deployer Allowlist uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to manage permissions. This provides a consistent way to: - Assign and revoke deployment permissions - Manage admin and manager roles - Control who can deploy contracts For detailed information about the role-based permission system and available functions, see the [AllowList interface documentation](/docs/avalanche-l1s/precompiles/allowlist-interface). ## Best Practices 1. **Initial Setup**: Always configure at least one admin address in the genesis file to ensure you can manage permissions after deployment. 2. **Role Management**: - Use Admin roles sparingly and secure their private keys - Assign Manager roles to trusted entities who need to manage user access - Regularly audit the list of enabled addresses 3. **Security Considerations**: - Keep private keys of admin addresses secure - Implement a multi-sig wallet as an admin for additional security - Maintain an off-chain record of role assignments 4. **Monitoring**: - Monitor the `RoleSet` events to track permission changes - Regularly audit the enabled addresses list - Keep documentation of why each address was granted permissions ## Implementation You can find the implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/deployerallowlist/contract.go). ## Interacting with the Precompile For information on how to interact with this precompile, see: - [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles) - [Deployer Allowlist Console](/console/l1-access-restrictions/deployer-allowlist) # Fee Manager (/docs/avalanche-l1s/precompiles/fee-manager) --- title: Fee Manager description: Configure dynamic fee parameters and gas costs for your Avalanche L1 blockchain. --- ## Overview The Fee Manager allows you to configure the parameters of the dynamic fee algorithm on-chain. This gives you control over: - Gas limits and target block rates - Base fee parameters - Block gas cost parameters | Property | Value | |----------|-------| | **Address** | `0x0200000000000000000000000000000000000003` | | **ConfigKey** | `feeManagerConfig` | ## Configuration You can activate this precompile in your genesis file: ```json { "config": { "feeManagerConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"], "initialFeeConfig": { "gasLimit": 20000000, "targetBlockRate": 2, "minBaseFee": 1000000000, "targetGas": 100000000, "baseFeeChangeDenominator": 48, "minBlockGasCost": 0, "maxBlockGasCost": 10000000, "blockGasCostStep": 500000 } } } } ``` The following parameters were deprecated by the Granite upgrade: - `targetBlockRate` - `minBlockGasCost` - `maxBlockGasCost` - `blockGasCostStep` ## Fee Parameters The Fee Manager allows configuration of the following parameters: | Parameter | Description | Recommended Range | |-----------|-------------|------------------| | gasLimit | Maximum gas allowed per block | 8M - 100M | | targetBlockRate | Target time between blocks (seconds) | 2 - 10 | | minBaseFee | Minimum base fee (in wei) | 25 - 500 gwei | | targetGas | Target gas spending over the last 10 seconds | 5M - 50M | | baseFeeChangeDenominator | Controls how quickly base fee changes | 8 - 1000 | | minBlockGasCost | Minimum gas cost for a block | 0 - 1B | | maxBlockGasCost | Maximum gas cost for a block | > minBlockGasCost | | blockGasCostStep | How quickly block gas cost changes | < 5M | ## Interface ```solidity interface IFeeManager { struct FeeConfig { uint256 gasLimit; uint256 targetBlockRate; uint256 minBaseFee; uint256 targetGas; uint256 baseFeeChangeDenominator; uint256 minBlockGasCost; uint256 maxBlockGasCost; uint256 blockGasCostStep; } event FeeConfigChanged(address indexed sender, FeeConfig oldFeeConfig, FeeConfig newFeeConfig); function setFeeConfig( uint256 gasLimit, uint256 targetBlockRate, uint256 minBaseFee, uint256 targetGas, uint256 baseFeeChangeDenominator, uint256 minBlockGasCost, uint256 maxBlockGasCost, uint256 blockGasCostStep ) external; function getFeeConfig() external view returns ( uint256 gasLimit, uint256 targetBlockRate, uint256 minBaseFee, uint256 targetGas, uint256 baseFeeChangeDenominator, uint256 minBlockGasCost, uint256 maxBlockGasCost, uint256 blockGasCostStep ); function getFeeConfigLastChangedAt() external view returns (uint256 blockNumber); } ``` ## Access Control and Additional Features The FeeManager precompile uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to restrict access to its functionality. In addition to the AllowList interface, the FeeManager adds the following capabilities: - `getFeeConfig`: retrieves the current dynamic fee config - `getFeeConfigLastChangedAt`: retrieves the timestamp of the last block where the fee config was updated - `setFeeConfig`: sets the dynamic fee config on chain. This function can only be called by an Admin, Manager or Enabled address. - `FeeConfigChanged`: an event that is emitted when the fee config is updated. Topics include the sender, the old fee config, and the new fee config. You can also get the fee configuration at a block with the `eth_feeConfig` RPC method. For more information see [here](/docs/rpcs/subnet-evm#eth_feeconfig). ## Best Practices 1. **Fee Configuration**: - Test fee changes on testnet first - Monitor network congestion and adjust accordingly - Document rationale for fee parameter changes - Announce changes to validators in advance 2. **Security Considerations**: - Use multi-sig for admin addresses - Monitor events for unauthorized changes - Have a plan for fee parameter adjustments - Keep backup of previous configurations ## Implementation You can find the Fee Manager implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/feemanager/contract.go). ## Interacting with the Precompile For information on how to interact with this precompile, see: - [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles) - [Fee Manager Console](/console/l1-tokenomics/fee-manager) # Interacting with Precompiles (/docs/avalanche-l1s/precompiles/interacting-with-precompiles) --- title: Interacting with Precompiles description: Learn how to interact with Avalanche L1 precompiles using the Builder Hub Developer Console or Remix IDE. --- This guide shows you how to interact with precompiled contracts on your Avalanche L1. For standard precompile implementations, we recommend using the **Builder Hub Developer Console** for the best experience. For custom implementations or advanced use cases, you can use **Remix IDE** with browser wallets. ## Recommended: Using Builder Hub Developer Console The Builder Hub provides dedicated tools for interacting with standard Avalanche L1 precompiles. These tools offer: - ✅ **User-friendly interface** - No need to manually enter contract addresses or ABIs - ✅ **Built-in validation** - Prevents common configuration mistakes - ✅ **Connected to your Builder account** - Track your L1s and configurations - ✅ **Visual feedback** - See changes reflected in real-time ### Available Console Tools | Precompile | Console Tool | |------------|--------------| | Fee Manager | [Fee Manager Console](/console/l1-tokenomics/fee-manager) | | Reward Manager | [Reward Manager Console](/console/l1-tokenomics/reward-manager) | | Native Minter | [Native Minter Console](/console/l1-tokenomics/native-minter) | | Contract Deployer Allowlist | [Deployer Allowlist Console](/console/l1-access-restrictions/deployer-allowlist) | | Transaction Allowlist | [Transactor Allowlist Console](/console/l1-access-restrictions/transactor-allowlist) | ### How to Use Console Tools 1. **Navigate** to the appropriate console tool from the table above 2. **Connect** your wallet (Core or MetaMask) 3. **Switch** to your L1 network in your wallet 4. The tool will automatically detect your permissions 5. **Configure** using the visual interface: - For Fee Manager: Adjust gas limits, base fees, and target rates - For Native Minter: Mint tokens to specific addresses - For Allowlists: Add or remove addresses with specific roles - For Reward Manager: Configure fee distribution settings 6. **Review** the transaction details 7. **Submit** and approve in your wallet **Why use the Developer Console?** Using the Builder Hub console tools allows us to: - Provide better support for your L1 - Track feature usage to improve the platform - Build your profile in our builders/developers database - Offer personalized recommendations and resources ### Example Workflows **Configuring Transaction Fees:** 1. Go to [Fee Manager Console](/console/l1-tokenomics/fee-manager) 2. Connect wallet and switch to your L1 3. Adjust fee parameters using sliders and inputs 4. See real-time preview of how changes affect gas costs 5. Submit transaction to update fees **Minting Native Tokens:** 1. Go to [Native Minter Console](/console/l1-tokenomics/native-minter) 2. Connect with an admin/manager address 3. Enter recipient address and amount 4. Review the minting transaction 5. Approve to mint tokens instantly **Managing Permissions:** 1. Go to [Deployer Allowlist](/console/l1-access-restrictions/deployer-allowlist) or [Transactor Allowlist](/console/l1-access-restrictions/transactor-allowlist) 2. Connect with an admin address 3. Add addresses with desired roles (Admin, Manager, Enabled) 4. Remove addresses by changing their role to "None" 5. View current allowlist status ## Alternative: Using Remix IDE For custom precompile implementations or if you prefer a code-based approach, you can use Remix IDE to interact with precompiles directly. ### When to Use Remix Use Remix when: - You have a **custom precompile** implementation (non-standard addresses or interfaces) - You need to interact with precompiles **programmatically** - You're **debugging** contract interactions - The Builder Console doesn't support your specific use case ### Prerequisites - Access to an Avalanche L1 where you have admin/manager rights for a precompile - [Core Browser Extension](https://core.app) or MetaMask - Private key for an admin/manager address on your L1 - Your L1's RPC URL and Chain ID ## Setup Your Wallet ### Using Core 1. Install the [Core Browser Extension](https://core.app) 2. Import or create the account with admin/manager privileges 3. Enable **Testnet Mode** (if using testnet): - Open Core extension - Click hamburger menu → **Advanced** - Toggle **Testnet Mode** on 4. Add your L1 network: - Click the networks dropdown - Select **Manage Networks** - Click **Add Network** and enter: - **Network Name**: Your L1 name - **RPC URL**: Your L1's RPC endpoint - **Chain ID**: Your L1's chain ID - **Symbol**: Your native token symbol - **Explorer**: (Optional) Your L1's explorer URL 5. Switch to your L1 network in the dropdown ### Using MetaMask 1. Install MetaMask browser extension 2. Import the account with admin/manager privileges 3. Add your L1 network: - Click the networks dropdown - Click **Add Network** → **Add a network manually** - Enter your L1's network details - Click **Save** ## Connect Remix to Your L1 1. Open [Remix IDE](https://remix.ethereum.org/) in your browser 2. In the left sidebar, click the **Deploy & run transactions** icon 3. In the **Environment** dropdown, select **Injected Provider - MetaMask** (or Core) 4. Approve the connection request in your wallet extension 5. Verify the connection shows your L1's network (e.g., "Custom (11111) network") ## Load Precompile Interfaces You need to load the Solidity interfaces for the precompiles you want to interact with. ### Available Precompile Interfaces From the Remix home screen, use **load from GitHub** to import: **Required for all precompiles:** - [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IAllowList.sol) **Specific precompile interfaces:** - [IFeeManager.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IFeeManager.sol) - For fee configuration - [INativeMinter.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/INativeMinter.sol) - For minting native tokens - [IAllowList.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IAllowList.sol) - For transaction/deployer allowlists - [IRewardManager.sol](https://github.com/ava-labs/subnet-evm/blob/master/contracts/contracts/interfaces/IRewardManager.sol) - For block rewards ### Compile the Interface 1. In Remix, click the **Solidity Compiler** icon in the left sidebar 2. Select the precompile interface file (e.g., `IFeeManager.sol`) 3. Click **Compile** ## Interact with Precompiles ### Connect to Deployed Precompile Each precompile is deployed at a fixed address on your L1: | Precompile | Address | |------------|---------| | NativeMinter | `0x0200000000000000000000000000000000000001` | | ContractDeployerAllowList | `0x0200000000000000000000000000000000000000` | | FeeManager | `0x0200000000000000000000000000000000000003` | | RewardManager | `0x0200000000000000000000000000000000000004` | | TransactionAllowList | `0x0200000000000000000000000000000000000002` | 1. In Remix, click **Deploy & run transactions** 2. In the **Contract** dropdown, select your compiled interface 3. Paste the precompile address in the **At Address** field 4. Click **At Address** The precompile contract will appear in the **Deployed Contracts** section. ## Example: Using Fee Manager ### Read Current Fee Configuration Anyone can read the current fee configuration (no special permissions required): 1. Expand the FeeManager contract in **Deployed Contracts** 2. Click **getFeeConfig** 3. View the current fee parameters: - `gasLimit`: Maximum gas per block - `targetBlockRate`: Target time between blocks (seconds) - `minBaseFee`: Minimum base fee (wei) - `targetGas`: Target gas per second - `baseFeeChangeDenominator`: Rate of base fee adjustment - `minBlockGasCost`: Minimum gas cost for a block - `maxBlockGasCost`: Maximum gas cost for a block - `blockGasCostStep`: Increment for block gas cost ### Update Fee Configuration Only admin addresses can update the fee configuration: 1. Ensure you're connected with the admin address in your wallet 2. Expand **setFeeConfig** in the FeeManager contract 3. Fill in the new fee parameters: ``` gasLimit: 8000000 targetBlockRate: 2 minBaseFee: 25000000000 targetGas: 15000000 baseFeeChangeDenominator: 36 minBlockGasCost: 0 maxBlockGasCost: 1000000 blockGasCostStep: 200000 ``` 4. Click **transact** 5. Approve the transaction in your wallet 6. Wait for transaction confirmation The new fee configuration takes effect immediately after the transaction is accepted. ## Example: Using Native Minter ### Mint Native Tokens Only admin, manager, or enabled addresses can mint native tokens: 1. Expand the NativeMinter contract in **Deployed Contracts** 2. Click on **mintNativeCoin** 3. Fill in the parameters: - `addr`: Recipient address (e.g., `0xB78cbAa319ffBD899951AA30D4320f5818938310`) - `amount`: Amount to mint in wei (e.g., `1000000000000000000` for 1 token) 4. Click **transact** 5. Approve the transaction in your wallet The minted tokens are added directly to the recipient's balance by the EVM (no sender transaction). ### Check Minting Permissions Anyone can check who has minting permissions: 1. Click **readAllowList** with an address parameter 2. Returns: - `0`: No permission - `1`: Enabled (can mint) - `2`: Manager (can mint and manage enabled addresses) - `3`: Admin (full control) ## Example: Managing Allow Lists ### Add Address to Allow List Admins can add addresses to transaction or deployer allow lists: 1. Expand the AllowList contract 2. Use **setAdmin**, **setManager**, or **setEnabled**: ``` addr: 0x1234...5678 ``` 3. Click **transact** 4. Approve in wallet ### Remove Address from Allow List 1. Use **setNone** with the address: ``` addr: 0x1234...5678 ``` 2. Click **transact** ### Check Address Status 1. Click **readAllowList**: ``` addr: 0x1234...5678 ``` 2. Returns permission level (0-3) ## Best Practices ### Security - **Never share private keys** for admin addresses - **Use hardware wallets** for admin accounts when possible - **Test on testnet first** before making changes on mainnet - **Use multi-sig contracts** for critical admin operations - **Document all changes** and announce them to validators ### Network Upgrades When enabling precompiles via network upgrades: 1. **Announce upgrades** well in advance on social media and Discord 2. **Coordinate with validators** to ensure they update their nodes 3. **Use upgrade.json** to schedule precompile activation (see [Precompile Upgrades](/docs/avalanche-l1s/upgrade/precompile-upgrades)) 4. **Test the upgrade** on a testnet first 5. **Monitor** the network after activation ### Troubleshooting **Connection Issues:** - Verify your wallet is connected to the correct network - Check that the RPC URL is accessible - Ensure you have native tokens for gas fees **Transaction Failures:** - Confirm you're using an admin/manager address - Check that the precompile is enabled on your L1 - Verify parameter formats (addresses must be checksummed) - Ensure sufficient gas limit **Precompile Not Found:** - Verify the precompile address is correct - Confirm the precompile is activated in your genesis or upgrade.json - Check that you're on the correct network ## Additional Resources ### Builder Hub Console Tools - [Fee Manager Console](/console/l1-tokenomics/fee-manager) - Configure transaction fees - [Reward Manager Console](/console/l1-tokenomics/reward-manager) - Manage fee distribution - [Native Minter Console](/console/l1-tokenomics/native-minter) - Mint native tokens - [Deployer Allowlist Console](/console/l1-access-restrictions/deployer-allowlist) - Control contract deployment - [Transactor Allowlist Console](/console/l1-access-restrictions/transactor-allowlist) - Control transaction submission ### Documentation - [Precompile Configuration](/docs/avalanche-l1s/evm-configuration/evm-l1-customization) - Overview of precompiles - [Fee Manager](/docs/avalanche-l1s/precompiles/fee-manager) - Fee Manager details - [Reward Manager](/docs/avalanche-l1s/precompiles/reward-manager) - Reward Manager details - [Native Minter](/docs/avalanche-l1s/precompiles/native-minter) - Native Minter details - [Deployer AllowList](/docs/avalanche-l1s/precompiles/deployer-allowlist) - Deployer Allowlist details - [Transaction AllowList](/docs/avalanche-l1s/precompiles/transaction-allowlist) - Transaction Allowlist details - [Warp Messenger](/docs/avalanche-l1s/precompiles/warp-messenger) - Warp Messenger details - [Precompile Upgrades](/docs/avalanche-l1s/upgrade/precompile-upgrades) - Network upgrade process - [AllowList Interface](/docs/avalanche-l1s/precompiles/allowlist-interface) - Role-based access control - [Subnet-EVM Contracts](https://github.com/ava-labs/subnet-evm/tree/master/contracts/contracts/interfaces) - Precompile interfaces ## Conclusion For standard Avalanche L1 precompiles, **we strongly recommend using the [Builder Hub Developer Console tools](/console)** for the best experience. These tools provide: - ✅ Guided workflows with validation - ✅ No need to manage contract addresses or ABIs manually - ✅ Integration with your Builder Hub account - ✅ Support from the Builder Hub team For custom implementations or advanced scenarios, the Remix IDE approach provides flexibility to interact with any contract at any address. This is useful for: - Custom precompile implementations - Testing and debugging - Programmatic interactions - Non-standard use cases Whichever method you choose, always test on testnet first and follow security best practices when managing admin keys. # Native Minter (/docs/avalanche-l1s/precompiles/native-minter) --- title: Native Minter description: Manage the minting and burning of native tokens on your Avalanche L1 blockchain. --- ## Overview The Native Minter precompile allows authorized addresses to mint additional tokens after network launch. This is useful for: - Implementing programmatic token emission schedules - Providing validator rewards - Supporting ecosystem growth initiatives - Implementing monetary policy | Property | Value | |----------|-------| | **Address** | `0x0200000000000000000000000000000000000001` | | **ConfigKey** | `contractNativeMinterConfig` | ## Configuration You can activate this precompile in your genesis file: ```json { "config": { "contractNativeMinterConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } } ``` ## Interface ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.24; interface INativeMinter { event NativeCoinMinted(address indexed sender, address indexed recipient, uint256 amount); // Mint [amount] number of native coins and send to [addr] function mintNativeCoin(address addr, uint256 amount) external; // IAllowList event RoleSet(uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole); // Set [addr] to have the admin role over the precompile contract. function setAdmin(address addr) external; // Set [addr] to be enabled on the precompile contract. function setEnabled(address addr) external; // Set [addr] to have the manager role over the precompile contract. function setManager(address addr) external; // Set [addr] to have no role for the precompile contract. function setNone(address addr) external; // Read the status of [addr]. function readAllowList(address addr) external view returns (uint256 role); } ``` The Native Minter precompile uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to restrict access to its functionality. ## Best Practices 1. **Minting Policy**: - Define clear minting guidelines - Use multi-sig for admin control - Implement transparent emission schedules - Monitor total supply changes 2. **Supply Management**: - Balance minting with burning mechanisms - Consider implementing supply caps - Monitor token velocity and distribution - Plan for long-term sustainability 3. **Security Considerations**: - Use multi-sig wallets for admin addresses - Implement time-locks for large mints - Regular audits of minting activity - Monitor for unusual minting patterns 4. **Validator Incentives**: - Design sustainable reward mechanisms - Balance inflation with network security - Consider validator stake requirements - Plan for long-term validator participation ## Example Implementations ### Programmatic Emission Schedule ```solidity contract EmissionSchedule { INativeMinter public constant NATIVE_MINTER = INativeMinter(0x0200000000000000000000000000000000000001); uint256 public constant EMISSION_RATE = 1000 * 1e18; // 1000 tokens per day uint256 public constant EMISSION_DURATION = 365 days; uint256 public immutable startTime; constructor() { startTime = block.timestamp; } function mintDailyEmission() external { require(block.timestamp < startTime + EMISSION_DURATION, "Emission ended"); NATIVE_MINTER.mintNativeCoin(address(this), EMISSION_RATE); // Distribution logic here } } ``` ### Validator Reward Contract ```solidity contract ValidatorRewards { INativeMinter public constant NATIVE_MINTER = INativeMinter(0x0200000000000000000000000000000000000001); uint256 public constant REWARD_RATE = 10 * 1e18; // 10 tokens per block function distributeRewards(address[] calldata validators) external { uint256 reward = REWARD_RATE / validators.length; for (uint i = 0; i < validators.length; i++) { NATIVE_MINTER.mintNativeCoin(validators[i], reward); } } } ``` ## Implementation You can find the Native Minter implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/nativeminter/contract.go). ## Interacting with the Precompile For information on how to interact with this precompile, see: - [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles) - [Native Minter Console](/console/l1-tokenomics/native-minter) # Reward Manager (/docs/avalanche-l1s/precompiles/reward-manager) --- title: Reward Manager description: Control how transaction fees are distributed or burned on your Avalanche L1 blockchain. --- ## Overview The Reward Manager allows you to control how transaction fees are handled in your network. You can: - Send fees to a specific address (e.g., treasury) - Allow validators to collect fees - Burn fees entirely | Property | Value | |----------|-------| | **Address** | `0x0200000000000000000000000000000000000004` | | **ConfigKey** | `rewardManagerConfig` | ## Configuration You can activate this precompile in your genesis file: ```json { "config": { "rewardManagerConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"], "initialRewardConfig": { // Choose one of: "allowFeeRecipients": true, // Allow validators to collect fees "rewardAddress": "0x...", // Send fees to specific address // Empty config = burn fees } } } } ``` ## Reward Mechanisms The Reward Manager supports three mutually exclusive mechanisms: 1. **Validator Fee Collection** (`allowFeeRecipients`) - Validators can specify their own fee recipient addresses - Fees go to the block producer's chosen address - Good for incentivizing network participation 2. **Fixed Reward Address** (`rewardAddress`) - All fees go to a single specified address - Can be a contract or EOA - Useful for treasury or DAO-controlled fee collection 3. **Fee Burning** (default) - All transaction fees are burned - Reduces total token supply over time - Similar to Ethereum's EIP-1559 ## Interface ```solidity interface IRewardManager { event RewardAddressChanged( address indexed sender, address indexed oldRewardAddress, address indexed newRewardAddress ); event FeeRecipientsAllowed(address indexed sender); event RewardsDisabled(address indexed sender); function setRewardAddress(address addr) external; function allowFeeRecipients() external; function disableRewards() external; function currentRewardAddress() external view returns (address rewardAddress); function areFeeRecipientsAllowed() external view returns (bool isAllowed); } ``` The Reward Manager precompile uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to restrict access to its functionality. ## Best Practices 1. **Reward Management**: - Choose reward mechanism based on network goals - Consider using a multi-sig or DAO as reward address - Monitor fee collection and distribution - Keep documentation of fee policy changes 2. **Security Considerations**: - Use multi-sig for admin addresses - Test reward changes on testnet first - Monitor events for unauthorized changes - Have a plan for reward parameter adjustments ## Implementation You can find the Reward Manager implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/rewardmanager/contract.go). ## Interacting with the Precompile For information on how to interact with this precompile, see: - [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles) - [Reward Manager Console](/console/l1-tokenomics/reward-manager) # Transaction AllowList (/docs/avalanche-l1s/precompiles/transaction-allowlist) --- title: Transaction AllowList description: Control which addresses can submit transactions on your Avalanche L1 blockchain. --- ## Overview The Transaction Allowlist enables you to control which addresses can submit transactions to your network. This is essential for: - Creating fully permissioned networks - Implementing KYC/AML requirements for users - Controlling network access during testing or initial deployment | Property | Value | |----------|-------| | **Address** | `0x0200000000000000000000000000000000000002` | | **ConfigKey** | `txAllowListConfig` | ## Configuration You can activate this precompile in your genesis file: ```json { "config": { "txAllowListConfig": { "blockTimestamp": 0, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } } ``` By enabling this feature, you can define which addresses are allowed to submit transactions and manage these permissions over time. ## Interface The Transaction Allowlist implements the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface): ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.24; interface IAllowList { event RoleSet(uint256 indexed role, address indexed account, address indexed sender, uint256 oldRole); // Set [addr] to have the admin role over the precompile contract. function setAdmin(address addr) external; // Set [addr] to be enabled on the precompile contract. function setEnabled(address addr) external; // Set [addr] to have the manager role over the precompile contract. function setManager(address addr) external; // Set [addr] to have no role for the precompile contract. function setNone(address addr) external; // Read the status of [addr]. function readAllowList(address addr) external view returns (uint256 role); } ``` ## Permissions Management The Transaction Allowlist uses the [AllowList interface](/docs/avalanche-l1s/precompiles/allowlist-interface) to manage permissions. This provides a consistent way to: - Assign and revoke transaction permissions - Manage admin and manager roles - Control who can submit transactions For detailed information about the role-based permission system and available functions, see the [AllowList interface documentation](/docs/avalanche-l1s/precompiles/allowlist-interface). ## Best Practices 1. **Initial Setup**: Always configure at least one admin address in the genesis file to ensure you can manage permissions after deployment. 2. **Role Management**: - Use Admin roles sparingly and secure their private keys - Assign Manager roles to trusted entities who need to manage user access - Regularly audit the list of enabled addresses 3. **Security Considerations**: - Keep private keys of admin addresses secure - Implement a multi-sig wallet as an admin for additional security - Maintain an off-chain record of role assignments 4. **Monitoring**: - Monitor the `RoleSet` events to track permission changes - Regularly audit the enabled addresses list - Keep documentation of why each address was granted permissions ## Implementation You can find the implementation in the [subnet-evm repository](https://github.com/ava-labs/subnet-evm/blob/master/precompile/contracts/txallowlist/contract.go). ## Interacting with the Precompile For information on how to interact with this precompile, see: - [Interacting with Precompiles](/docs/avalanche-l1s/precompiles/interacting-with-precompiles) - [Transactor Allowlist Console](/console/l1-access-restrictions/transactor-allowlist) # Warp Messenger (/docs/avalanche-l1s/precompiles/warp-messenger) --- title: Warp Messenger description: Enable cross-chain communication between Avalanche L1s using Avalanche Warp Messaging. edit_url: https://github.com/ava-labs/subnet-evm/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/precompile/contracts/warp/README.md --- ## Overview Avalanche Warp Messaging offers a basic primitive to enable Cross-L1 communication on the Avalanche Network. It is intended to allow communication between arbitrary Custom Virtual Machines (including, but not limited to Subnet-EVM and Coreth). | Property | Value | |----------|-------| | **Address** | `0x0200000000000000000000000000000000000005` | | **ConfigKey** | `warpConfig` | ## How does Avalanche Warp Messaging Work? Avalanche Warp Messaging uses BLS Multi-Signatures with Public-Key Aggregation where every Avalanche validator registers a public key alongside its NodeID on the Avalanche P-Chain. Every node tracking an Avalanche L1 has read access to the Avalanche P-Chain. This provides weighted sets of BLS Public Keys that correspond to the validator sets of each L1 on the Avalanche Network. Avalanche Warp Messaging provides a basic primitive for signing and verifying messages between L1s: the receiving network can verify whether an aggregation of signatures from a set of source L1 validators represents a threshold of stake large enough for the receiving network to process the message. For more details on Avalanche Warp Messaging, see the AvalancheGo [Warp README](https://docs.avax.network/build/cross-chain/awm/deep-dive). ## Configuration The Warp Messenger precompile is enabled by default on all Avalanche L1s and does not require explicit configuration in the genesis file. However, you can configure it if needed: ```json { "config": { "warpConfig": { "blockTimestamp": 0, "quorumNumerator": 67 } } } ``` ### Configuration Parameters - `blockTimestamp`: The timestamp when the precompile should be activated (0 for genesis) - `quorumNumerator`: The percentage of stake weight required to verify a message (default: 67, meaning 67%) Unlike other precompiles, Warp Messenger does not use the AllowList interface - it is available to all addresses by default. ## Interface The Warp Messenger precompile provides the following Solidity interface: ```solidity //SPDX-License-Identifier: MIT pragma solidity ^0.8.24; interface IWarpMessenger { event SendWarpMessage(address indexed sender, bytes32 indexed messageID, bytes message); // sendWarpMessage emits a request for the subnet to sign a Warp message with the provided payload // The message emitted in the log is the unsigned Warp message function sendWarpMessage(bytes calldata payload) external returns (bytes32 messageID); // getVerifiedWarpMessage returns the verified Warp message if it exists, otherwise returns (WarpMessage, false) function getVerifiedWarpMessage(uint32 index) external view returns (WarpMessage memory message, bool valid); // getBlockchainID returns the blockchainID of the current chain function getBlockchainID() external view returns (bytes32 blockchainID); } struct WarpMessage { bytes32 sourceChainID; address originSenderAddress; bytes payload; } ``` ## Flow of Sending / Receiving a Warp Message within the EVM The Avalanche Warp Precompile enables this flow to send a message from blockchain A to blockchain B: 1. Call the Warp Precompile `sendWarpMessage` function with the arguments for the `UnsignedMessage` 2. Warp Precompile emits an event / log containing the `UnsignedMessage` specified by the caller of `sendWarpMessage` 3. Network accepts the block containing the `UnsignedMessage` in the log, so that validators are willing to sign the message 4. An off-chain relayer queries the validators for their signatures of the message and aggregates the signatures to create a `SignedMessage` 5. The off-chain relayer encodes the `SignedMessage` as the [predicate](#predicate-encoding) in the AccessList of a transaction to deliver on blockchain B 6. The transaction is delivered on blockchain B, the signature is verified prior to executing the block, and the message is accessible via the Warp Precompile's `getVerifiedWarpMessage` during the execution of that transaction ## Warp Precompile Functions The Warp Precompile is broken down into three functions defined in the Solidity interface file [here](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/contracts/contracts/interfaces/IWarpMessenger.sol). ### sendWarpMessage `sendWarpMessage` is used to send a verifiable message. Calling this function results in sending a message with the following contents: - `SourceChainID` - blockchainID of the sourceChain on the Avalanche P-Chain - `SourceAddress` - `msg.sender` encoded as a 32 byte value that calls `sendWarpMessage` - `Payload` - `payload` argument specified in the call to `sendWarpMessage` emitted as the unindexed data of the resulting log Calling this function will issue a `SendWarpMessage` event from the Warp Precompile. Since the EVM limits the number of topics to 4 including the EventID, this message includes only the topics that would be expected to help filter messages emitted from the Warp Precompile the most. Specifically, the `payload` is not emitted as a topic because each topic must be encoded as a hash. Therefore, we opt to take advantage of each possible topic to maximize the possible filtering for emitted Warp Messages. Additionally, the `SourceChainID` is excluded because anyone parsing the chain can be expected to already know the blockchainID. Therefore, the `SendWarpMessage` event includes the indexable attributes: - `sender` - The `messageID` of the unsigned message (sha256 of the unsigned message) The actual `message` is the entire [Avalanche Warp Unsigned Message](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/unsigned_message.go#L14) including an [AddressedCall](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm/warp/payload#readme). The unsigned message is emitted as the unindexed data in the log. ### getVerifiedMessage `getVerifiedMessage` is used to read the contents of the delivered Avalanche Warp Message into the expected format. It returns the message if present and a boolean indicating if a message is present. To use this function, the transaction must include the signed Avalanche Warp Message encoded in the [predicate](#predicate-encoding) of the transaction. Prior to executing a block, the VM iterates through transactions and pre-verifies all predicates. If a transaction's predicate is invalid, then it is considered invalid to include in the block and dropped. This leads to the following advantages: 1. The EVM execution does not need to verify the Warp Message at runtime (no signature verification or external calls to the P-Chain) 2. The EVM can deterministically re-execute and re-verify blocks assuming the predicate was verified by the network (e.g., in bootstrapping) This pre-verification is performed using the ProposerVM Block header during [block verification](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/plugin/evm/block.go#L220) and [block building](https://github.com/ava-labs/subnet-evm/blob/1ab7114c339f866b65cc02dfd586b2ed9041dd0b/miner/worker.go#L200). ### getBlockchainID `getBlockchainID` returns the blockchainID of the blockchain that the VM is running on. This is different from the conventional Ethereum ChainID registered to [ChainList](https://chainlist.org/). The `blockchainID` in Avalanche refers to the txID that created the blockchain on the Avalanche P-Chain ([docs](https://docs.avax.network/specs/platform-transaction-serialization#unsigned-create-chain-tx)). ## Predicate Encoding Avalanche Warp Messages are encoded as a signed Avalanche [Warp Message](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/message.go) where the [UnsignedMessage](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/unsigned_message.go)'s payload includes an [AddressedPayload](https://github.com/ava-labs/avalanchego/blob/master/vms/platformvm/warp/payload/payload.go). Since the predicate is encoded into the [Transaction Access List](https://eips.ethereum.org/EIPS/eip-2930), it is packed into 32 byte hashes intended to declare storage slots that should be pre-warmed into the cache prior to transaction execution. Therefore, we use the [Predicate Utils](https://github.com/ava-labs/subnet-evm/blob/master/predicate/Predicate.md) package to encode the actual byte slice of size N into the access list. ## Performance Optimization: Primary Network to Avalanche L1 The Primary Network has a large validator set compared to most Subnets and L1s, which makes Warp signature collection and verification from the entire Primary Network validator set costly. All Subnets and L1s track at least one blockchain of the Primary Network, so we can instead optimize this by using the validator set of the receiving L1 instead of the Primary Network for certain Warp messages. ### Subnets Recall that Avalanche Subnet validators must also validate the Primary Network, so it tracks all of the blockchains in the Primary Network (X, C, and P-Chains). When an Avalanche Subnet receives a message from a blockchain on the Primary Network, we use the validator set of the receiving Subnet instead of the entire network when validating the message. Sending messages from the X, C, or P-Chain remains unchanged. However, when the Subnet receives the message, it changes the semantics to the following: 1. Read the `SourceChainID` of the signed message 2. Look up the `SubnetID` that validates `SourceChainID`. In this case it will be the Primary Network's `SubnetID` 3. Look up the validator set of the Subnet (instead of the Primary Network) and the registered BLS Public Keys of the Subnet validators at the P-Chain height specified by the ProposerVM header 4. Continue Warp Message verification using the validator set of the Subnet instead of the Primary Network This means that Primary Network to Subnet communication only requires a threshold of stake on the receiving Subnet to sign the message instead of a threshold of stake for the entire Primary Network. Since the security of the Subnet is provided by trust in its validator set, requiring a threshold of stake from the receiving Subnet's validator set instead of the whole Primary Network does not meaningfully change the security of the receiving L1. Note: this special case is ONLY applied during Warp Message verification. The message sent by the Primary Network will still contain the blockchainID of the Primary Network chain that sent the message as the sourceChainID and signatures will be served by querying the source chain directly. ### L1s Avalanche L1s are only required to sync the P-Chain, but are not required to validate the Primary Network. Therefore, **for L1s, this optimization only applies to Warp messages sent by the P-Chain.** The rest of the description of this optimization in the above section applies to L1s. Note that **in order to properly verify messages from the C-Chain and X-Chain, the Warp precompile must be configured with `requirePrimaryNetworkSigners` set to `true`**. Otherwise, we will attempt to verify the message signature against the receiving L1's validator set, which is not required to track the C-Chain or X-Chain, and therefore will not in general be able to produce a valid Warp message. ## Design Considerations ### Re-Processing Historical Blocks Avalanche Warp Messaging depends on the Avalanche P-Chain state at the P-Chain height specified by the ProposerVM block header. Verifying a message requires looking up the validator set of the source L1 on the P-Chain. To support this, Avalanche Warp Messaging uses the ProposerVM header, which includes the P-Chain height it was issued at as the canonical point to lookup the source L1's validator set. This means verifying the Warp Message and therefore the state transition on a block depends on state that is external to the blockchain itself: the P-Chain. The Avalanche P-Chain tracks only its current state and reverse diff layers (reversing the changes from past blocks) in order to re-calculate the validator set at a historical height. This means calculating a very old validator set that is used to verify a Warp Message in an old block may become prohibitively expensive. Therefore, we need a heuristic to ensure that the network can correctly re-process old blocks (note: re-processing old blocks is a requirement to perform bootstrapping and is used in some VMs to serve or verify historical data). As a result, we require that the block itself provides a deterministic hint which determines which Avalanche Warp Messages were considered valid/invalid during the block's execution. This ensures that we can always re-process blocks and use the hint to decide whether an Avalanche Warp Message should be treated as valid/invalid even after the P-Chain state that was used at the original execution time may no longer support fast lookups. To provide that hint, we've explored two designs: 1. Include a predicate in the transaction to ensure any referenced message is valid 2. Append the results of checking whether a Warp Message is valid/invalid to the block data itself The current implementation uses option (1). The original reason for this was that the notion of predicates for precompiles was designed with Shared Memory in mind. In the case of shared memory, there is no canonical "P-Chain height" in the block which determines whether or not Avalanche Warp Messages are valid. Instead, the VM interprets a shared memory import operation as valid as soon as the UTXO is available in shared memory. This means that if it were up to the block producer to staple the valid/invalid results of whether or not an attempted atomic operation should be treated as valid, a byzantine block producer could arbitrarily report that such atomic operations were invalid and cause a griefing attack to burn the gas of users that attempted to perform an import. Therefore, a transaction specified predicate is required to implement the shared memory precompile to prevent such a griefing attack. In contrast, Avalanche Warp Messages are validated within the context of an exact P-Chain height. Therefore, if a block producer attempted to lie about the validity of such a message, the network would interpret that block as invalid. ### Guarantees Offered by Warp Precompile vs. Built on Top #### Guarantees Offered by Warp Precompile The Warp Precompile was designed with the intention of minimizing the trusted computing base for the VM as much as possible. Therefore, it makes several tradeoffs which encourage users to use protocols built ON TOP of the Warp Precompile itself as opposed to directly using the Warp Precompile. The Warp Precompile itself provides ONLY the following ability: - Emit a verifiable message from (Address A, Blockchain A) to (Address B, Blockchain B) that can be verified by the destination chain #### Explicitly Not Provided / Built on Top The Warp Precompile itself does not provide any guarantees of: - Eventual message delivery (may require re-send on blockchain A and additional assumptions about off-chain relayers and chain progress) - Ordering of messages (requires ordering provided a layer above) - Replay protection (requires replay protection provided a layer above) # Installing Your VM (/docs/avalanche-l1s/rust-vms/installing-vm) --- title: Installing Your VM description: Learn how to install your VM on your node. --- AvalancheGo searches for and registers VM plugins under the `plugins` [directory](/docs/nodes/configure/configs-flags#--plugin-dir-string). To install the virtual machine onto your node, you need to move the built virtual machine binary under this directory. Virtual machine executable names must be either a full virtual machine ID (encoded in CB58), or a VM alias. Copy the binary into the plugins directory. ```bash cp -n $GOPATH/src/github.com/ava-labs/avalanchego/build/plugins/ ``` ## Node Is Not Running If your node isn't running yet, you can install all virtual machines under your `plugin` directory by starting the node. ## Node Is Already Running Load the binary with the `loadVMs` API. ```bash curl -sX POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"admin.loadVMs", "params" :{} }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/admin ``` Confirm the response of `loadVMs` contains the newly installed virtual machine `tGas3T58KzdjcJ32c6GpePhtqo9rrHJ1oR9wFBtCcMgaosthX`. You'll see this virtual machine as well as any others that weren't already installed previously in the response. ```json { "jsonrpc": "2.0", "result": { "newVMs": { "tGas3T58KzdjcJ32c6GpePhtqo9rrHJ1oR9wFBtCcMgaosthX": [ "timestampvm-rs", "timestamp-rs" ], "spdxUxVJQbX85MGxMHbKw1sHxMnSqJ3QBzDyDYEP3h6TLuxqQ": [] } }, "id": 1 } ``` Now, this VM's static API can be accessed at endpoints `/ext/vm/timestampvm-rs` and `/ext/vm/timestamp-rs`. For more details about VM configs, see [here](/docs/nodes/configure/configs-flags#virtual-machine-vm-configs). In this tutorial, we used the VM's ID as the executable name to simplify the process. However, AvalancheGo would also accept `timestampvm-rs` or `timestamp-rs` since those are registered aliases in previous step. # Introduction to Avalanche-RS (/docs/avalanche-l1s/rust-vms/intro-avalanche-rs) --- title: Introduction to Avalanche-RS description: Learn how to write a simple virtual machine in Rust using Avalanche-RS. --- Since Rust is a language which we can write and implement Proto interfaces, this implies that we can also use Rust to write VMs which can then be deployed on Avalanche. However, rather than build Rust-based from the ground-up, we can utilize Avalanche-RS, a developer toolkit comprised of powerful building blocks and primitive types which allow us to focus exclusively on the business logic of our VM rather than working on low-level logic. ## Structure of Avalanche-RS Although Avalanche-RS is currently primarily used to build Rust-based VMs, Avalanche-RS actually consists of three different frameworks; as per the [GitHub](https://github.com/ava-labs/avalanche-rs) description of the Avalanche-RS repository, the three frameworks are as follows: - Core: framework for core networking components for a P2P Avalanche node - Avalanche-Consensus: a Rust implementation of the novel Avalanche consensus protocol - Avalanche-Types: implements foundational types used in Avalanche and provides an SDK for building Rust-based VMs As the above might make it obvious, the Avalanche-Types crate is the main framework that one would use to build Rust-based VMs. ## Documentation For the most up-to-date information regarding the Avalache-Types library, please refer to the associated [crates.io](https://crates.io/crates/avalanche-types) page for the Avalanche-Types crate. # Setting Up Your Environment (/docs/avalanche-l1s/rust-vms/setting-up-environment) --- title: Setting Up Your Environment description: Learn how to set up your environment to build a Rust VM. --- In this section, we will focus on getting set up with the Rust environment necessary to build with the `avalanche-types` crates (recall that `avalanche-types` contains the SDK we want to use to build our Rust VM). ## Installing Rust First and foremost, we will need to have Rust installed locally. If you do not have Rust installed, you can install `rustup` (the tool that manages your Rust installation) [here](https://www.rust-lang.org/tools/install). ## Adding `avalanche-types` to Your Project Once you have Rust installed and are ready to build, you will want to add the Avalanche-Types crate to your project. Below is a baseline example of how you can do this: ```toml title="Cargo.toml" [dependencies] avalanche-types = "0.1.4" ``` However, if you want to use the [TimestampVM](https://github.com/ava-labs/timestampvm-rs) as a reference for your project, a more appropriate import would be the following: ```toml title="Cargo.toml" [dependencies] avalanche-types = { version = "0.1.4", features = ["subnet", "codec_base64"] } ``` # APIs (/docs/avalanche-l1s/timestamp-vm/apis) --- title: APIs description: Learn how to interact with TimestampVM. --- Throughout this case study, we have been focusing of the functionality of the TimestampVM. However, one thing we haven't discussed is how external users can interact with an instance of TimestampVM. Without a way for users to interact with TimestampVM, the blockchain itself will be stagnant. In this section, we will go over the two types of APIs used in TimestampVM: - Static APIs - Chain APIs ## Precursor: Static and Instance Methods When understanding the static and chain APIs used in TimestampVM, a good way to think about these APIs is to compare them to static and instance methods in object-oriented programming. That is, - **Static Methods**: functions which belong to the class itself, and not any instance of the class - **Instance Methods**: functions which belong to the instance of a class ## Static APIs We can think of the static APIs in TimestampVM as functions which call the VM and are not associated with any specific instance of the TimestampVM. Within TimestampVM, we have just one static API function - the ping function: ```rust title="timestampvm/src/api/static_handlers.rs" /// Defines static handler RPCs for this VM. #[rpc] pub trait Rpc { #[rpc(name = "ping", alias("timestampvm.ping"))] fn ping(&self) -> BoxFuture>; } ``` ## Chain APIs In contrast to the static API, the chain API of TimestampVM is much more rich in the sense that we have functions with read from and write to an instance of TimestampVM. In this case, we have four functions defined in the chain API: - `ping`: when called, this function pings an instance of TimestampVM - `propose_Block`: write function which passes a block to TimestampVM for consideration to be appended to the blockchain - `last_accepted`: read function which returns the last accepted block (that is, the block at the tip of the blockchain) - `get_block`: read function which fetches the requested block We can see the functions included in the chain API here: ```rust title="timestampvm/src/api/chain_handlers.rs" /// Defines RPCs specific to the chain. #[rpc] pub trait Rpc { /// Pings th e VM. #[rpc(name = "ping", alias("timestampvm.ping"))] fn ping(&self) -> BoxFuture>; /// Proposes th e arbitrary data. #[rpc(name = "proposeBlock", alias("timestampvm.proposeBlock"))] fn propose_block(&self,args:ProposeBlockArgs)->BoxFuture>; /// Fetches th e last accepted block. #[rpc(name="lastAccepted",alias("timestampvm.lastAccepted"))] fn last_accepted(&self)->BoxFuture>; /// Fetches th e block. #[rpc(name="getBlock",alias("timestampvm.getBlock"))] fn get_block(&self,args:GetBlockArgs)->BoxFutur e >; } ``` # Blocks (/docs/avalanche-l1s/timestamp-vm/blocks) --- title: Blocks descscription: Learn about the Block data structure in TimestampVM. --- In this section, we will examine the Block data structure. In contrast to the design choice of the TimestampVM state (which was mostly in control of the implementers), blocks in TimestampVM must adhere to the SnowmanVM Block Interface. ## SnowmanVM.Block Interface TimestampVM is designed to be used in tandem with the Snowman Consensus Engine. In particular, this relationship is defined by the usage of blocks - TimestampVM will produce blocks which the Snowman Consensus Engine will use and eventually mark as accepted or rejected. Therefore, the Snowman Consensus Engine requires for all blocks to have the following interface: ```go type Block interface { choices.Decidable // Parent returns the ID of this block's parent. Parent() ids.ID // Verify that the state transition this block would make if accepted is // valid. If the state transition is invalid, a non-nil error should be // returned. // // It is guaranteed that the Parent has been successfully verified. // // If nil is returned, it is guaranteed that either Accept or Reject will be // called on this block, unless the VM is shut down. Verify(context.Context) error // Bytes returns the binary representation of this block. // // This is used for sending blocks to peers. The bytes should be able to be // parsed into the same block on another node. Bytes() []byte // Height returns the height of this block in the chain. Height() uint64 // Time this block was proposed at. This value should be consistent across // all nodes. If this block hasn't been successfully verified, any value can // be returned. If this block is the last accepted block, the timestamp must // be returned correctly. Otherwise, accepted blocks can return any value. Timestamp() time.Time } ``` ## Implementing the Block Data Structure With the above in mind, we now examine the block data structure: ```rust /// Represents a block, specific to `Vm` (crate::vm::Vm). #[serde_as] #[derive(Serialize, Deserialize, Clone, Derivative, Default)] #[derivative(Debug, PartialEq, Eq)] pub struct Block { /// The block Id of the parent block. parent_id: ids::Id, /// This block's height. /// The height of the genesis block is 0. height: u64, /// Unix second when this block was proposed. timestamp: u64, /// Arbitrary data. #[serde_as(as = "Hex0xBytes")] data: Vec, /// Current block status. #[serde(skip)] status: choices::status::Status, /// This block's encoded bytes. #[serde(skip)] bytes: Vec, /// Generated block Id. #[serde(skip)] id: ids::Id, /// Reference to the Vm state manager for blocks. #[derivative(Debug = "ignore", PartialEq = "ignore")] #[serde(skip)] state: state::State, } ``` Notice above that many of the fields of the `Block` struct store the information required to implement the `Snowman.Block` interface we saw previously. Tying the concept of Blocks back to the VM State, notice the last field `state` within the `Block` struct. This is where the `Block` struct stores a copy of the `State` struct from the previous section (and since each field of the `State` struct is wrapped in an `Arc` pointer, this implies that `Block` is really just storing a reference to both the `db` and `verified_blocks` data structures). ## `Block` Functions In this section, we examine some of the functions associated with the `Block` struct: ### `verify` This function verifies that a block is valid and stores it in memory. Note that a verified block does not mean that it has been accepted - rather, a verified block is eligible to be accepted. ```rust /// Verifies [`Block`](Block) properties (e.g., heights), /// and once verified, records it to the `State` (crate::state::State). /// # Errors /// Can fail if the parent block can't be retrieved. pub async fn verify(&mut self) -> io::Result<()> { if self.height == 0 && self.parent_id == ids::Id::empty() { log::debug!( "block {} has an empty parent Id since it's a genesis block -- skipping verify", self.id ); self.state.add_verified(&self.clone()).await; return Ok(()); } // if already exists in database, it means it's already accepted // thus no need to verify once more if self.state.get_block(&self.id).await.is_ok() { log::debug!("block {} already verified", self.id); return Ok(()); } let prnt_blk = self.state.get_block(&self.parent_id).await?; // ensure the height of the block is immediately following its parent if prnt_blk.height != self.height - 1 { return Err(Error::new( ErrorKind::InvalidData, format!( "parent block height {} != current block height {} - 1", prnt_blk.height, self.height ), )); } // ensure block timestamp is after its parent if prnt_blk.timestamp > self.timestamp { return Err(Error::new( ErrorKind::InvalidData, format!( "parent block timestamp {} > current block timestamp {}", prnt_blk.timestamp, self.timestamp ), )); } let one_hour_from_now = Utc::now() + Duration::hours(1); let one_hour_from_now = one_hour_from_now .timestamp() .try_into() .expect("failed to convert timestamp from i64 to u64"); // ensure block timestamp is no more than an hour ahead of this nodes time if self.timestamp >= one_hour_from_now { return Err(Error::new( ErrorKind::InvalidData, format!( "block timestamp {} is more than 1 hour ahead of local time", self.timestamp ), )); } // add newly verified block to memory self.state.add_verified(&self.clone()).await; Ok(()) } ``` ### `reject` When called by the Snowman Consensus Engine, this tells the VM that the particular block has been rejected. ```rust /// Mark this [`Block`](Block) rejected and updates `State` (crate::state::State) accordingly. /// # Errors /// Returns an error if the state can't be updated. pub async fn reject(&mut self) -> io::Result<()> { self.set_status(choices::status::Status::Rejected); // only decided blocks are persistent -- no reorg self.state.write_block(&self.clone()).await?; self.state.remove_verified(&self.id()).await; Ok(()) } ``` ### `accept` When called by the Snowman Consensus Engine, this tells the VM that the particular block has been rejected. ```rust /// Mark this [`Block`](Block) accepted and updates `State` (crate::state::State) accordingly. /// # Errors /// Returns an error if the state can't be updated. pub async fn accept(&mut self) -> io::Result<()> { self.set_status(choices::status::Status::Accepted); // only decided blocks are persistent -- no reorg self.state.write_block(&self.clone()).await?; self.state.set_last_accepted_block(&self.id()).await?; self.state.remove_verified(&self.id()).await; Ok(()) } ``` # Architecture of TimestampVM (/docs/avalanche-l1s/timestamp-vm/defining-vm-itself) --- title: Architecture of TimestampVM description: After examining several of the data structures and functionalities that TimestampVM relies on, it is time that we examine the architecture of the TimestampVM itself. In addition, we will look at some data structures that TimestampVM utilizes. --- ## Aside: SnowmanVM In addition to blocks having to adhere to the `Snowman.Block` interface, VMs which interact with the Snowman Consensus Engine must also implement the `SnowmanVM` interface. In the context of a Rust-based VM, this means that we must satisfy the `ChainVM` trait in `avalanche-types`: ```rust title="avalanche-types/src/subnet/rpc/snowman/block.rs" /// ref. #[tonic::async_trait] pub trait ChainVm: CommonVm + BatchedChainVm + Getter + Parser { type Block: snowman::Block; /// Attempt to create a new block from ChainVm data /// Returns either a block or an error async fn build_block(&self) -> Result<::Block>; /// Issues a transaction to the chain async fn issue_tx(&self) -> Result<::Block>; /// Notify the Vm of the currently preferred block. async fn set_preference(&self, id: Id) -> Result<()>; /// Returns ID of last accepted block. async fn last_accepted(&self) -> Result; } ``` ## Defining TimestampVM Below is definition of VM struct which represents TimestampVM: ```rust title="timestampvm/src/vm/mod.rs" pub struct Vm { /// Maintains Vm-specific states. pub state: Arc>, pub app_sender: Option, /// A queue not yet proposed into a block. pub mempool: Arc>>>, } ``` We see following three fields: - `state`: represents state of VM. Note different than earlier seen State structure. - `app_sender`: channel for receiving and sending requests by our VM - `mempool`: where proposed blocks are kept before being processed. We now examine the `state` data structure mentioned earlier: ```rust title="timestampvm/src/vm/mod.rs" /// Represents VM-specific states. /// Defined separately for interior mutability in [`Vm`](vm). /// Protected with 'Arc' and 'RwLock'. pub struct State { pub ctx : Option>, pub version : Version, pub genesis : Genesis, // Persistent Vm state representation pub state : Option, // Preferred block Id pub preferred : ids::Id, // Channel for messages to snowman consensus engine pub bootstrapped : bool, } ``` Relationship between State and state - contains alongside other fields relevant to Snowman consensus algorithm. # Introduction (/docs/avalanche-l1s/timestamp-vm/introduction) --- title: Introduction description: Learn about the TimestampVM Virtual Machine. --- To really get an understanding of how one can use the `avalanche-types` library to build a Rust-based VM, we will look at [TimeStampVM](https://github.com/ava-labs/timestampvm-rs/tree/main), a basic VM which utilizes the `avalanche-types` library. ## Idea of TimestampVM In contrast to complex VMs like the EVM which provide a general-purpose computing environment, TimestampVM is _much, much_ simpler. In fact, we can describe the goal of TimestampVM in two bullet points: - To store the timestamp when each block was appended to the blockchain - To store arbitrary payloads of data (within each block) Even though the above seems quite simple, this still requires us to define and build out an architecture to support such functionalities. In this case study, we will look at the following pieces of the architecture that define TimestampVM: - State - Blocks - API - The VM itself # State (/docs/avalanche-l1s/timestamp-vm/state) --- title: State description: Learn about the state within the context of TimestampVM. --- Blockchains can be defined as follows: > A linked-list where each list element consists of a block Implementations of blockchains, while adhering to the functionality above from a white-box perspective, are defined much more like databases than regular linked lists themselves. In fact, this is what TimestampVM utilizes! By utilizing a general database, TimestampVM is able to store blocks (and thus, store its blockchain) while also being able to store additional data such as pending blocks. ## State Definition Below is the definition of the `State` struct which is used to maintain the state of the TimestampVM: ```rust /// Manages block and chain states for this Vm, both in-memory and persistent. #[derive(Clone)] pub struct State { pub db: Arc>>, /// Maps block Id to Block. /// Each element is verified but not yet accepted/rejected (e.g., preferred). pub verified_blocks: Arc>>, } ``` `State` in this context acts like the database of TimestampVM. Within `State`, we are managing two different data structures: - `db`: a byte-based mapping which maps bytes to bytes. This is where finalized (that is, accepted blocks are stored) - `verified_blocks`: a hashmap which maps block numbers to their respective blocks. This is where all verified, but pending blocks are stored While one could have guessed the functionalities of `db` and `verified_blocks` from their respective types `subnet::rpc::database::Database + Send + Sync` and `HashMap`, it is not immediately clear why we are wrapping these fields with Read/Write locks and Arc pointers. However, as we'll see soon when we examine the Block data structure, blocks need access to the VM state so they can add themselves to state. This is due to the `SetPrefernce` function of SnowmanVM interface, which states: > `Set Preference` > > The VM implements the function SetPreference(blkID ids.ID) to allow the consensus engine to notify the VM which block is currently preferred to be accepted. The VM should use this information to set the head of its blockchain. Most importantly, when the consensus engine calls BuildBlock, the VM should be sure to build on top of the block that is the most recently set preference. > > Note: SetPreference will always be called with a block that has no verified children. Therefore, when building a Rust-based VM (or a VM in any supported language), the VM itself is only responsible for tracking the ID of the most recent finalized block; blocks bear the responsibility of storing themselves in VM state. As a result, we will need to wrap the `db` and `verified_blocks` fields with the following: - An `Arc` pointer so that whenever we clone the `State` structure, the cloned versions of `db` and `verified_blocks` are still pointing to the same data structures in memory. This allows for multiple Blocks to share the same `db` and `verified_blocks` - A read/write lock (that is, `RwLock`) so that we safely utilize concurrency in our VM ## `State` Functions Below are the functions associated with the `State` struct: ```rust title="timestampvm/src/state/mod.rs" impl State { /// Persists the last accepted block Id to state. /// # Errors /// Fails if the db can't be updated pub async fn set_last_accepted_block(&self, blk_id: &ids::Id) -> io::Result<()> { let mut db = self.db.write().await; db.put(LAST_ACCEPTED_BLOCK_KEY, &blk_id.to_vec()) .await .map_err(|e| { Error::new( ErrorKind::Other, format!("failed to put last accepted block: {e:?}"), ) }) } /// Returns "true" if there's a last accepted block found. /// # Errors /// Fails if the db can't be read pub async fn has_last_accepted_block(&self) -> io::Result { let db = self.db.read().await; match db.has(LAST_ACCEPTED_BLOCK_KEY).await { Ok(found) => Ok(found), Err(e) => Err(Error::new( ErrorKind::Other, format!("failed to load last accepted block: {e}"), )), } } /// Returns the last accepted block Id from state. /// # Errors /// Can fail if the db can't be read pub async fn get_last_accepted_block_id(&self) -> io::Result { let db = self.db.read().await; match db.get(LAST_ACCEPTED_BLOCK_KEY).await { Ok(d) => Ok(ids::Id::from_slice(&d)), Err(e) => { if subnet::rpc::errors::is_not_found(&e) { return Ok(ids::Id::empty()); } Err(e) } } } /// Adds a block to "`verified_blocks`". pub async fn add_verified(&mut self, block: &Block) { let blk_id = block.id(); log::info!("verified added {blk_id}"); let mut verified_blocks = self.verified_blocks.write().await; verified_blocks.insert(blk_id, block.clone()); } /// Removes a block from "`verified_blocks`". pub async fn remove_verified(&mut self, blk_id: &ids::Id) { let mut verified_blocks = self.verified_blocks.write().await; verified_blocks.remove(blk_id); } /// Returns "true" if the block Id has been already verified. pub async fn has_verified(&self, blk_id: &ids::Id) -> bool { let verified_blocks = self.verified_blocks.read().await; verified_blocks.contains_key(blk_id) } /// Writes a block to the state storage. /// # Errors /// Can fail if the block fails to serialize or if the db can't be updated pub async fn write_block(&mut self, block: &Block) -> io::Result<()> { let blk_id = block.id(); let blk_bytes = block.to_vec()?; let mut db = self.db.write().await; let blk_status = BlockWithStatus { block_bytes: blk_bytes, status: block.status(), }; let blk_status_bytes = blk_status.encode()?; db.put(&block_with_status_key(&blk_id), &blk_status_bytes) .await .map_err(|e| Error::new(ErrorKind::Other, format!("failed to put block: {e:?}"))) } /// Reads a block from the state storage using the `block_with_status_key`. /// # Errors /// Can fail if the block is not found in the state storage, or if the block fails to deserialize pub async fn get_block(&self, blk_id: &ids::Id) -> io::Result { // check if the block exists in memory as previously verified. let verified_blocks = self.verified_blocks.read().await; if let Some(b) = verified_blocks.get(blk_id) { return Ok(b.clone()); } let db = self.db.read().await; let blk_status_bytes = db.get(&block_with_status_key(blk_id)).await?; let blk_status = BlockWithStatus::from_slice(blk_status_bytes)?; let mut blk = Block::from_slice(&blk_status.block_bytes)?; blk.set_status(blk_status.status); Ok(blk) } } ``` The functions above are called will be called by both blocks and the VM itself. # Considerations (/docs/avalanche-l1s/upgrade/considerations) --- title: Considerations description: Learn about some of the key considerations while upgrading your Avalanche L1. --- In the course of Avalanche L1 operation, you will inevitably need to upgrade or change some part of the software stack that is running your Avalanche L1. If nothing else, you will have to upgrade the AvalancheGo node client. Same goes for the VM plugin binary that is used to run the blockchain on your Avalanche L1, which is most likely the [Subnet-EVM](https://github.com/ava-labs/subnet-evm), the Avalanche L1 implementation of the Ethereum virtual machine. Node and VM upgrades usually don't change the way your Avalanche L1 functions, instead they keep your Avalanche L1 in sync with the rest of the network, bringing security, performance and feature upgrades. Most upgrades are optional, but all of them are recommended, and you should make optional upgrades part of your routine Avalanche L1 maintenance. Some upgrades will be mandatory, and those will be clearly communicated as such ahead of time, you need to pay special attention to those. Besides the upgrades due to new releases, you also may want to change the configuration of the VM, to alter the way Avalanche L1 runs, for various business or operational needs. These upgrades are solely the purview of your team, and you have complete control over the timing of their roll out. Any such change represents a **network upgrade** and needs to be carefully planned and executed. Network Upgrades Permanently Change the Rules of Your Avalanche L1. Procedural mistakes or a botched upgrade can halt your Avalanche L1 or lead to data loss! When performing an Avalanche L1 upgrade, every single validator on the Avalanche L1 will need to perform the identical upgrade. If you are coordinating a network upgrade, you must schedule advance notice to every Avalanche L1 validator so that they have time to perform the upgrade prior to activation. Make sure you have direct line of communication to all your validators! This tutorial will guide you through the process of doing various Avalanche L1 upgrades and changes. We will point out things to watch out for and precautions you need to be mindful about. General Upgrade Considerations[​](#general-upgrade-considerations "Direct link to heading") ------------------------------------------------------------------------------------------- When operating an Avalanche L1, you should always keep in mind that Proof of Stake networks like Avalanche can only make progress if sufficient amount of validating nodes are connected and processing transactions. Each validator on an Avalanche L1 is assigned a certain `weight`, which is a numerical value representing the significance of the node in consensus decisions. On the Primary Network, weight is equal to the amount of AVAX staked on the node. On Avalanche L1s, weight is currently assigned by the Avalanche L1 owners when they issue the transaction adding a validator to the Avalanche L1. Avalanche L1s can operate normally only if validators representing 80% or more of the cumulative validator weight is connected. If the amount of connected stake falls close to or below 80%, Avalanche L1 performance (time to finality) will suffer, and ultimately the Avalanche L1 will halt (stop processing transactions). You as an Avalanche L1 operator need to ensure that whatever you do, at least 80% of the validators' cumulative weight is connected and working at all times. It is mandatory that the cumulative weight of all validators in the Avalanche L1 must be at least the value of [`snow-sample-size`](/docs/nodes/configure/configs-flags#--snow-sample-size-int) (default 20). For example, if there is only one validator in the Avalanche L1, its weight must be at least `snow-sample-size` . Hence, when assigning weight to the nodes, always use values greater than 20. Recall that a validator's weight can't be changed while it is validating, so take care to use an appropriate value. Upgrading Avalanche L1 Validator Nodes[​](#upgrading-avalanche-l1-validator-nodes "Direct link to heading") ----------------------------------------------------------------------------------------------- AvalancheGo, the node client that is running the Avalanche validators is under constant and rapid development. New versions come out often (roughly every two weeks), bringing added capabilities, performance improvements or security fixes. Updates are usually optional, but from time to time (much less frequently than regular updates) there will be an update that includes a mandatory network upgrade. Those upgrades are **MANDATORY** for every node running the Avalanche L1. Any node that does not perform the update before the activation timestamp will immediately stop working when the upgrade activates. That's why having a node upgrade strategy is absolutely vital, and you should always update to the latest AvalancheGo client immediately when it is made available. For a general guide on upgrading AvalancheGo check out [this tutorial](/docs/nodes/maintain/upgrade). When upgrading Avalanche L1 nodes and keeping in mind the previous section, make sure to stagger node upgrades and start a new upgrade only once the previous node has successfully upgraded. Use the [Health API](/docs/rpcs/other/health-rpc#healthhealth) to check that `healthy` value in the response is `true` on the upgraded node, and on other Avalanche L1 validators check that [platform.getCurrentValidators()](/docs/rpcs/p-chain#platformgetcurrentvalidators) has `true` in `connected` attribute for the upgraded node's `nodeID`. Once those two conditions are satisfied, node is confirmed to be online and validating the Avalanche L1 and you can start upgrading another node. Continue the upgrade cycle until all the Avalanche L1 nodes are upgraded. Upgrading Avalanche L1 VM Plugin Binaries[​](#upgrading-avalanche-l1-vm-plugin-binaries "Direct link to heading") ----------------------------------------------------------------------------------------------------- Besides the AvalancheGo client itself, new versions get released for the VM binaries that run the blockchains on the Avalanche L1. On most Avalanche L1s, that is the [Subnet-EVM](https://github.com/ava-labs/subnet-evm), so this tutorial will go through the steps for updating the `subnet-evm` binary. The update process will be similar for updating any VM plugin binary. All the considerations for doing staggered node upgrades as discussed in previous section are valid for VM upgrades as well. In the future, VM upgrades will be handled by the [Avalanche-CLI tool](https://github.com/ava-labs/avalanche-cli), but for now we need to do it manually. Go to the [releases page](https://github.com/ava-labs/subnet-evm/releases) of the Subnet-EVM repository. Locate the latest version, and copy link that corresponds to the OS and architecture of the machine the node is running on (`darwin` = Mac, `amd64` = Intel/AMD processor, `arm64` = Arm processor). Log into the machine where the node is running and download the archive, using `wget` and the link to the archive, like this: ```bash wget https://github.com/ava-labs/subnet-evm/releases/download/v0.2.9/subnet-evm_0.2.9_linux_amd64.tar.gz ``` This will download the archive to the machine. Unpack it like this (use the correct filename, of course): ```bash tar xvf subnet-evm_0.2.9_linux_amd64.tar.gz ``` This will unpack and place the contents of the archive in the current directory, file `subnet-evm` is the plugin binary. You need to stop the node now (if the node is running as a service, use `sudo systemctl stop avalanchego` command). You need to place that file into the plugins directory where the AvalancheGo binary is located. If the node is installed using the install script, the path will be `~/avalanche-node/plugins` Instead of the `subnet-evm` filename, VM binary needs to be named as the VM ID of the chain on the Avalanche L1. For example, for the [WAGMI Avalanche L1](/docs/avalanche-l1s/wagmi-avalanche-l1) that VM ID is `srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy`. So, the command to copy the new plugin binary would look like: ```bash cp subnet-evm ~/avalanche-node/plugins/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy ``` Make sure you use the correct VM ID, otherwise, your VM will not get updated and your Avalanche L1 may halt. After you do that, you can start the node back up (if running as service do `sudo systemctl start avalanchego`). You can monitor the log output on the node to check that everything is OK, or you can use the [info.getNodeVersion()](/docs/rpcs/other/info-rpc#infogetnodeversion) API to check the versions. Example output would look like: ```json { "jsonrpc": "2.0", "result": { "version": "avalanche/1.7.18", "databaseVersion": "v1.4.5", "gitCommit": "b6d5827f1a87e26da649f932ad649a4ea0e429c4", "vmVersions": { "avm": "v1.7.18", "evm": "v0.8.15", "platform": "v1.7.18", "sqja3uK17MJxfC7AN8nGadBw9JK5BcrsNwNynsqP5Gih8M5Bm": "v0.0.7", "srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy": "v0.2.9" } }, "id": 1 } ``` Note that entry next to the VM ID we upgraded correctly says `v0.2.9`. You have successfully upgraded the VM! Refer to the previous section on how to make sure node is healthy and connected before moving on to upgrading the next Avalanche L1 validator. If you don't get the expected result, you can stop the `AvalancheGo`, examine and follow closely step-by-step of the above. You are free to remove files under `~/avalanche-node/plugins`, however, you should keep in mind that removing files is to remove an existing VM binary. You must put the correct VM plugin in place before you restart AvalancheGo. Network Upgrades[​](#network-upgrades "Direct link to heading") --------------------------------------------------------------- Sometimes you need to do a network upgrade to change the configured rules in the genesis under which the Chain operates. In regular EVM, network upgrades are a pretty involved process that includes deploying the new EVM binary, coordinating the timed upgrade and deploying changes to the nodes. But since [Subnet-EVM v0.2.8](https://github.com/ava-labs/subnet-evm/releases/tag/v0.2.8), we introduced the long awaited feature to perform network upgrades by just using a few lines of JSON. Upgrades can consist of enabling/disabling particular precompiles, or changing their parameters. Currently available precompiles allow you to: - Restrict Smart Contract Deployers - Restrict Who Can Submit Transactions - Mint Native Coins - Configure Dynamic Fees Please refer to [Customize an Avalanche L1](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#network-upgrades-enabledisable-precompiles) for a detailed discussion of possible precompile upgrade parameters. Summary[​](#summary "Direct link to heading") --------------------------------------------- Vital part of Avalanche L1 maintenance is performing timely upgrades at all levels of the software stack running your Avalanche L1. We hope this tutorial will give you enough information and context to allow you to do those upgrades with confidence and ease. If you have additional questions or any issues, please reach out to us on [Discord](https://chat.avalabs.org/). # Precompile Upgrades (/docs/avalanche-l1s/upgrade/precompile-upgrades) --- title: Precompile Upgrades description: Learn how to enable, disable, and configure precompiles in your Subnet-EVM. --- # Precompile Upgrades Performing a network upgrade requires coordinating the upgrade network-wide. A network upgrade changes the rule set used to process and verify blocks, such that any node that upgrades incorrectly or fails to upgrade by the time that upgrade goes into effect may become out of sync with the rest of the network. Any mistakes in configuring network upgrades or coordinating them on validators may cause the network to halt and recovering may be difficult. Subnet-EVM precompiles can be individually enabled or disabled at a given timestamp as a network upgrade. When disabling a precompile, it disables calling the precompile and destructs its storage, allowing it to be enabled later with a new configuration if desired. ## Configuration File These upgrades must be specified in a file named `upgrade.json` placed in the same directory where `config.json` resides: `{chain-config-dir}/{blockchainID}/upgrade.json`. For example, `WAGMI Subnet` upgrade should be placed in `~/.avalanchego/configs/chains/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt/upgrade.json`. The content of the `upgrade.json` should be formatted according to the following: ```json { "precompileUpgrades": [ { "[PRECOMPILE_NAME]": { "blockTimestamp": "[ACTIVATION_TIMESTAMP]", // unix timestamp precompile should activate at "[PARAMETER]": "[VALUE]" // precompile specific configuration options, eg. "adminAddresses" } } ] } ``` An invalid `blockTimestamp` in an upgrade file results the update failing. The `blockTimestamp` value should be set to a valid Unix timestamp value which is in the _future_ relative to the _head of the chain_. If the node encounters a `blockTimestamp` which is in the past, it will fail on startup. ## Disabling Precompiles To disable a precompile, use the following format: ```json { "precompileUpgrades": [ { "": { "blockTimestamp": "[DEACTIVATION_TIMESTAMP]", // unix timestamp the precompile should deactivate at "disable": true } } ] } ``` Each item in `precompileUpgrades` must specify exactly one precompile to enable or disable and the block timestamps must be in increasing order. Once an upgrade has been activated (a block after the specified timestamp has been accepted), it must always be present in `upgrade.json` exactly as it was configured at the time of activation (otherwise the node will refuse to start). For safety, you should always treat `precompileUpgrades` as append-only. As a last resort measure, it is possible to abort or reconfigure a precompile upgrade that has not been activated since the chain is still processing blocks using the prior rule set. If aborting an upgrade becomes necessary, you can remove the precompile upgrade from `upgrade.json` from the end of the list of upgrades. As long as the blockchain has not accepted a block with a timestamp past that upgrade's timestamp, it will abort the upgrade for that node. ## Example Configuration Here's a complete example that demonstrates enabling and disabling precompiles: ```json { "precompileUpgrades": [ { "feeManagerConfig": { "blockTimestamp": 1668950000, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } }, { "txAllowListConfig": { "blockTimestamp": 1668960000, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } }, { "feeManagerConfig": { "blockTimestamp": 1668970000, "disable": true } } ] } ``` This example: 1. Enables the `feeManagerConfig` at timestamp `1668950000` 2. Enables `txAllowListConfig` at timestamp `1668960000` 3. Disables `feeManagerConfig` at timestamp `1668970000` ## Initial Precompile Configurations Precompiles can be managed by privileged addresses to change their configurations and activate their effects. For example, the `feeManagerConfig` precompile can have `adminAddresses` which can change the fee structure of the network: ```json { "precompileUpgrades": [ { "feeManagerConfig": { "blockTimestamp": 1668950000, "adminAddresses": ["0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC"] } } ] } ``` In this example, only the specified address can change the network's fee structure. The admin must call the precompile to activate changes by sending a transaction with a new fee config. ### Initial Configurations Without Admin Precompiles can also activate their effect immediately at the activation timestamp without admin addresses. For example: ```json { "precompileUpgrades": [ { "feeManagerConfig": { "blockTimestamp": 1668950000, "initialFeeConfig": { "gasLimit": 20000000, "targetBlockRate": 2, "minBaseFee": 1000000000, "targetGas": 100000000, "baseFeeChangeDenominator": 48, "minBlockGasCost": 0, "maxBlockGasCost": 10000000, "blockGasCostStep": 500000 } } } ] } ``` It's still possible to add `adminAddresses` or `enabledAddresses` along with these initial configurations. In this case, the precompile will be activated with the initial configuration, and admin/enabled addresses can access to the precompiled contract normally. If you want to change the precompile initial configuration, you will need to first disable it then activate the precompile again with the new configuration. ## Verifying Upgrades After creating or modifying `upgrade.json`, restart your node to load the changes. The node will print the chain configuration on startup, allowing you to verify the upgrade configuration: ```bash INFO [08-15|15:09:36.772] <2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt Chain> github.com/ava-labs/subnet-evm/eth/backend.go:155: Initialised chain configuration config="{ChainID: 11111 Homestead: 0 EIP150: 0 EIP155: 0 EIP158: 0 Byzantium: 0 Constantinople: 0 Petersburg: 0 Istanbul: 0, Muir Glacier: 0, Subnet EVM: 0, FeeConfig: {\"gasLimit\":20000000,\"targetBlockRate\":2,\"minBaseFee\":1000000000,\"targetGas\ ":100000000,\"baseFeeChangeDenominator\":48,\"minBlockGasCost\":0,\"maxBlockGasCost\ ":10000000,\"blockGasCostStep\":500000}, AllowFeeRecipients: false, NetworkUpgrades: {\ "subnetEVMTimestamp\":0}, PrecompileUpgrade: {}, UpgradeConfig: {\"precompileUpgrades\":[{\"feeManagerConfig\":{\"adminAddresses\":[\"0x8db97c7cece249c2b98bdc0226cc4c2a57bf52fc\"],\"enabledAddresses\":null,\"blockTimestamp\":1668950000}},{\"txAllowListConfig\":{\"adminAddresses\":[\"0x8db97c7cece249c2b98bdc0226cc4c2a57bf52fc\"],\"enabledAddresses\":null,\"blockTimestamp\":1668960000}},{\"feeManagerConfig\":{\"adminAddresses\":null,\"enabledAddresses\":null,\"blockTimestamp\":1668970000,\"disable\":true}}]}, Engine: Dummy Consensus Engine}" ``` You can also verify precompile configurations using: - [`eth_getActiveRulesAt`](/docs/rpcs/subnet-evm#eth_getactiverulesat) RPC method to check activated precompiles at a timestamp - [`eth_getChainConfig`](/docs/rpcs/subnet-evm#eth_getchainconfig) RPC method to view the complete configuration including upgrades # Validator Manager Contracts (/docs/avalanche-l1s/validator-manager/contract) --- title: "Validator Manager Contracts" description: "This page lists all available contracts for the Validator Manager." edit_url: https://github.com/ava-labs/icm-contracts/edit/main/contracts/validator-manager/README.md --- # Validator Manager Contracts The contracts in this directory define the Validator Manager used to manage Avalanche L1 validators, as defined in [ACP-77](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets). They comply with [ACP-99](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/99-validatorsetmanager-contract), which specifies the standard minimal functionality that Validator Managers should implement. The contracts in this directory are are related as follows: > ACP99Manager class ValidatorManager { +initializeValidatorSet() +completeValidatorRegistration() onlyOwner +completeValidatorRemoval() onlyOwner +completeValidatorWeightUpdate() onlyOwner +initiateValidatorRegistration() onlyOwner +initiateValidatorRemoval() onlyOwner +initiateValidatorWeightUpdate() onlyOwner } class PoAManager { +completeValidatorRegistration() +completeValidatorRemoval() +completeValidatorWeightUpdate() +initiateValidatorRegistration() onlyOwner +initiateValidatorRemoval() onlyOwner +initiateValidatorWeightUpdate() onlyOwner +transferValidatorManagerOwnership() onlyOwner } class StakingManager { +completeValidatorRegistration() +initiateValidatorRemoval() +completeValidatorRemoval() +completeDelegatorRegistration() +initiateDelegatorRemoval() +completeDelegatorRemoval() -_initiateValidatorRegistration() -_initiateDelegatorRegistration() } <> StakingManager class ERC20TokenStakingManager { +initiateValidatorRegistration() +initiateDelegatorRegistration() } class NativeTokenStakingManager { +initiateValidatorRegistration() payable +initiateDelegatorRegistration() payable } ACP99Manager <|-- ValidatorManager ValidatorManager --o PoAManager : owner ValidatorManager --o StakingManager : owner StakingManager <|-- ERC20TokenStakingManager StakingManager <|-- NativeTokenStakingManager`} /> ## A Note on Nomenclature The contracts in this directory are only useful to L1s that have been converted from Subnets as described in ACP-77. As such, `l1`/`L1` is generally preferred over `subnet`/`Subnet` in the source code. The one major exception is that `subnetID` should be used to refer to both Subnets that have not been converted, and L1s that have. This is because an L1 must first be initialized as a Subnet by issuing a `CreateSubnetTx` on the P-Chain, the transaction hash of which becomes the `subnetID`. Rather than change the name and/or value of this identifier, it is simpler for both to remain static in perpetuity. ## Deploying The validator manager system consists of a `ValidatorManager`, and one of `NativeTokenStakingManager`, `ERC20TokenStakingManager`, or `PoAManager`. `ValidatorManager` is `Ownable`, and its owner should be set to the address of the other contract. All of these are implemented as [upgradeable](https://github.com/OpenZeppelin/openzeppelin-contracts-upgradeable/blob/3d6a15108b50491ec3c51c03b32802c33e092a0f/contracts/proxy/utils/Initializable.sol#L56) contracts. There are numerous [guides](https://blog.chain.link/upgradable-smart-contracts/) for deploying upgradeable smart contracts, but the general steps are as follows: 1. Deploy the implementation contract 2. Deploy the proxy contract 3. Call the implementation contract's `initialize` function - Each deployed contract requires different settings. For example, `ValidatorManagerSettings` specifies the churn parameters, while `StakingManagerSettings` specifies the staking and rewards parameters. 4. Initialize the validator set by calling `initializeValidatorSet` on `ValidatorManager` - When an L1 is first created on the P-Chain, it must be explicitly converted to an L1 via [`ConvertSubnetToL1Tx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#convertsubnettol1tx). The resulting `SubnetToL1ConversionMessage` ICM [message](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#subnettol1conversionmessage) is provided in the call to `initializeValidatorSet` to specify the starting validator set in the `ValidatorManager`. Regardless of the setup of the overall validator manager system, these initial validators are treated as PoA and are not eligible for staking rewards. ### Proof-of-Authority PoA validator management is provided by `PoAManager` by providing an `owner` in the call to `initialize`. Only the `owner` may initiate validator set changes, but anybody can complete the validator set change by providing the corresponding ICM message signed by the P-Chain. > [!NOTE] > PoA validator management can also be implemented by `ValidatorManager` on its own, by setting the `owner` to the desired admin address. Unlike `PoAManager`, only the admin is able to initiate or complete validator set changes. ### Proof-of-Stake PoS validator management is provided by the abstract contract `StakingManager`, which has two concrete implementations: `NativeTokenStakingManager` and `ERC20TokenStakingManager`. `StakingManager` supports uptime-based validation rewards, as well as delegation to a chosen validator. The `uptimeBlockchainID` used to initialize the `StakingManager` **must** be validated by the L1 validator set that the contract manages. **There is no way to verify this from within the contract, so take care when setting this value.** This [state transition diagram](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/StateTransition.md) illustrates the relationship between validators and delegators. After deploying `StakingManager` and a proxy, call the `initialize` function, which takes a `StakingManagerSettings` as well as any implementation-specific arguments. > [!NOTE] > The `weightToValueFactor` fields of `StakingManagerSettings` sets the factor used to convert between the weight that the validator is registered with on the P-Chain, and the value transferred to the contract as stake. This involves integer division, which may result in loss of precision. When selecting `weightToValueFactor`, it's important to make the following considerations: > > 1. If `weightToValueFactor` is near the denomination of the asset, then staking amounts on the order of 1 unit of the asset may cause the converted weight to round down to 0. This may impose a larger-than-expected minimum stake amount. > - Ex: If USDC (denomination of 6) is used as the staking token and `weightToValueFactor` is 1e9, then any amount less than 1,000 USDC will round down to 0 and therefore be invalid. > 2. Staked amounts up to `weightValueFactor - 1` may be lost in the contract as dust, as the validator's registered weight is used to calculate the original staked amount. > - Ex: `value=1001` and `weightToValueFactor=1e3`. The resulting weight will be `1`. Converting the weight back to a value results in `value=1000`. > 3. The validator's weight is represented on the P-Chain as a `uint64`. `StakingManager` restricts values such that the calculated weight does not exceed the maximum value for that type. ### Migrating from Proof-of-Authority to Proof-of-Stake See the [migration guide](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/PoAMigration.md) for details. #### NativeTokenStakingManager `NativeTokenStakingManager` allows permissionless addition and removal of validators that post the L1's native token as stake. Staking rewards are minted via the Native Minter Precompile, which is configured with a set of addresses with minting privileges. As such, the address that `NativeTokenStakingManager` is deployed to must be added as an admin to the precompile. This can be done by either calling the precompile's `setAdmin` method from an admin address, or setting the address in the Native Minter precompile settings in the chain's genesis (`config.contractNativeMinterConfig.adminAddresses`). There are a couple of methods to get this address: one is to calculate the resulting deployed address based on the deployer's address and account nonce: `keccak256(rlp.encode(address, nonce))`. The second method involves manually placing the `NativeTokenStakingManager` bytecode at a particular address in the genesis, then setting that address as an admin. ```json { "config" : { ... "contractNativeMinterConfig": { "blockTimestamp": 0, "adminAddresses": [ "0xffffffffffffffffffffffffffffffffffffffff" ] } }, "alloc": { "0xffffffffffffffffffffffffffffffffffffffff": { "balance": "0x0", "code": "", "nonce": 1 } } } ``` #### ERC20TokenStakingManager `ERC20TokenStakingManager` allows permissionless addition and removal of validators that post the an ERC20 token as stake. The ERC20 is specified in the call to `initialize`, and must implement [`IERC20Mintable`](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/interfaces/IERC20Mintable.sol). Care should be taken to enforce that only authorized users are able to `mint` the ERC20 staking token. ## Usage ### Register a Validator #### PoA Validator registration is initiated with a call to `PoAManager.initiateValidatorRegistration`. Churn limitations are checked - only a certain (configurable) percentage of the total weight is allowed to be added or removed in a (configurable) period of time. The `ValidatorManager` then constructs a [`RegisterL1ValidatorMessage`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#registerl1validatormessage) ICM message to be sent to the P-Chain. Each validator registration request includes all of the information needed to identify the validator and its stake weight, as well as an `expiry` timestamp before which the `RegisterL1ValidatorMessage` must be delivered to the P-Chain. If the validator is not registered on the P-Chain before the `expiry`, then the validator may be removed from the contract state by calling `completeValidatorRemoval`. The `RegisterL1ValidatorMessage` is delivered to the P-Chain as the ICM message payload of a `RegisterL1ValidatorTx`. Please see the transaction [specification](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#registerl1validatortx) for validity requirements. The P-Chain then signs a [`L1ValidatorRegistrationMessage`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#l1validatorregistrationmessage) ICM message indicating that the specified validator was successfully registered on the P-Chain. The `L1ValidatorRegistrationMessage` is delivered by calling `ValidatorManager.completeValidatorRegistration`. #### PoS When registering a PoS validator, the same steps as the PoA case apply, with the only difference being that `StakingManager.initiateValidatorRegistration` and `StakingManager.completeValidatorRegistration` must be called instead. The sender of the transaction that called `StakingManager.initiateValidatorRegistration` is registered as the validator owner. Only this owner can remove the validator. Staking rewards begin accruing once `StakingManager.completeValidatorRegistration` is called. ### Remove a Validator ### PoA Validator exit is initiated with a call to `PoAManager.initiateValidatorRemoval`. The `ValidatorManager` contructs an [`L1ValidatorWeightMessage`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#l1validatorweightmessage) ICM message with the weight set to `0`. This is delivered to the P-Chain as the payload of a [`SetL1ValidatorWeightTx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#setl1validatorweighttx). The P-Chain acknowledges the validator exit by signing an `L1ValidatorRegistrationMessage` with `valid=0`, which is delivered by calling `ValidatorManager.completeValidatorRemoval`. The validation is removed from the contract's state. ### PoS PoS validator removal follows the same flow as the PoA case, except that `StakingManager.initiateValidatorRemoval` and `StakingManager.completeValidatorRemoval` must be called instead. There are two additional considerations: - A [`ValidationUptimeMessage`](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/UptimeMessageSpec.md) ICM message may optionally be provided in the call to `StakingManager.initiateValidatorRemoval` in order to calculate the staking rewards; otherwise the latest received uptime will be used (see [(PoS only) Submit and Uptime Proof](#pos-only-submit-an-uptime-proof)). This proof may be requested directly from the L1 validators, which will provide it in a `ValidationUptimeMessage` ICM message. If the uptime is not sufficient to earn validation rewards, the call to `initiateValidatorRemoval` will fail. `forceInitiateValidatorRemoval` acts the same as `initiateValidatorRemoval`, but bypasses the uptime-based rewards check. Once `initiateValidatorRemoval` or `forceInitiateValidatorRemoval` is called, staking rewards cease accruing for `StakingManagers`. - Unlike with PoA, PoS validators are not able to decrease their weight. This can lead to a scenario in which a PoS validator manager with a high proportion of the L1's weight is not able to exit the validator set due to churn restrictions. Additional validators or delegators will need to first be registered to more evenly distribute weight across the L1's validator set. Once acknowledgement from the P-Chain has been received via a call to `StakingManager.completeValidatorRemoval`, staking rewards are disbursed and stake is returned. #### Disable a Validator Directly on the P-Chain ACP-77 also provides a method to disable a validator without interacting with the L1 directly. The P-Chain transaction [`DisableL1ValidatorTx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#disablel1validatortx) disables the validator on the P-Chain. The disabled validator's weight will still count towards the L1's total weight. Disabled L1 validators can re-activate at any time by increasing their balance with an `IncreaseBalanceTx`. Anyone can call `IncreaseBalanceTx` for any validator on the P-Chain. A disabled validator can only be completely and permanently removed from the validator set by a call to `initiateValidatorRemoval`. ### (PoS only) Register a Delegator `StakingManager` supports delegation to an actively staked validator as a way for users to earn staking rewards without having to validate the chain. Delegators pay a configurable percentage fee on any earned staking rewards to the host validator. A delegator may be registered by calling `initiateDelegatorRegistration` and providing an amount to stake. The delegator will be registered as long as churn restrictions are not violated. The delegator is reflected on the P-Chain by adjusting the validator's registered weight via a [`SetL1ValidatorWeightTx`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#setl1validatorweighttx). The weight change acknowledgement is delivered to the `StakingManager` via an [`L1ValidatorWeightMessage`](https://github.com/avalanche-foundation/ACPs/tree/main/ACPs/77-reinventing-subnets#l1validatorweightmessage), which is provided by calling `completeDelegatorRegistration`. > [!NOTE] > The P-Chain is only willing to sign an `L1ValidatorWeightMessage` for a validator in the L1's validator set. Once a validator exit has been initiated (via a call to `initiateValidatorRemoval`), the `StakingManager` must assume that the validator has been removed from the L1's validator set on the P-Chain, and therefore that the P-Chain will not sign any further weight updates. The contracts prohibit _initiating_ adding or removing a delegator in between calls to `initiateValidatorRemoval` and `completeValidatorRemoval`. However, if the `L1ValidatorWeightMessage` pertaining to an already initiated delegator action is constructed _before_ the validator is removed on the P-Chain, then the delegator action may be completed. Otherwise, `completeValidatorRemoval` must be called before completing the delegator action. ### (PoS only) Remove a Delegator Delegator removal may be initiated by calling `initiateDelegatorRemoval`, as long as churn restrictions are not violated. Similar to `initiateValidatorRemoval`, an uptime proof may be provided to be used to determine delegator rewards eligibility. If no proof is provided, the latest known uptime will be used (see [(PoS only) Submit and Uptime Proof](#pos-only-submit-an-uptime-proof)). The validator's weight is updated on the P-Chain by the same mechanism used to register a delegator. The `L1ValidatorWeightMessage` from the P-Chain is delivered to the `StakingManager` in the call to `completeDelegatorRemoval`. Either the delegator owner or the validator owner may initiate removing a delegator. This is to prevent the validator from being unable to remove itself due to churn limitations if it is has too high a proportion of the Subnet's total weight due to delegator additions. The validator owner may only remove Delegators after the minimum stake duration has elapsed. ### (PoS only) Submit an Uptime Proof The [rewards calculator](https://github.com/ava-labs/icm-contracts/blob/main/contracts/validator-manager/interfaces/IRewardCalculator.sol) is a function of uptime seconds since the validator's start time. In addition to doing so in the calls to `initiateValidatorRemoval` and `initiateDelegatorRemoval` as described above, uptime proofs may also be supplied by calling `submitUptimeProof`. Unlike `initiateValidatorRemoval` and `initiateDelegatorRemoval`, `submitUptimeProof` may be called by anyone, decreasing the likelihood of a validation or delegation not being able to claim rewards that it deserved based on its actual uptime. ### (PoS only) Collect Staking Rewards #### Validation Rewards Validation rewards are distributed in the call to `completeValidatorRemoval` on the `StakingManager`. #### Delegation Rewards Delegation rewards are distributed in the call to `completeDelegatorRemoval` on the `StakingManager`. #### Delegation Fees Delegation fees owed to validators are _not_ distributed when the validation ends as to bound the amount of gas consumed in the call to `completeValidatorRemoval`. Instead, `claimDelegationFees` on the `StakingManager` may be called after the validation is completed. # Chain Components (/docs/builderkit/components/chains) --- title: Chain Components description: "Components for displaying and selecting blockchain networks." --- # Chain Components Chain components help you manage network selection and display chain information. ## ChainIcon The ChainIcon component displays chain logos. ```tsx import { ChainIcon } from '@avalabs/builderkit'; // Basic usage ``` ### Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID to display | | `className` | `string` | - | Additional CSS classes | ## ChainDropdown The ChainDropdown component provides network selection functionality. ```tsx import { ChainDropdown } from '@avalabs/builderkit'; // Basic usage { console.log('Selected chain:', chainId); }} /> ``` ### Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `selected` | `number` | - | Currently selected chain ID | | `list` | `number[]` | - | List of available chain IDs | | `onSelectionChanged` | `(chain_id: number) => void` | - | Selection change callback | | `className` | `string` | - | Additional CSS classes | ## ChainRow The ChainRow component displays detailed chain information. ```tsx import { ChainRow } from '@avalabs/builderkit'; // Basic usage ``` ### Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID | | `name` | `string` | - | Chain name | | `className` | `string` | - | Additional CSS classes | # Control Components (/docs/builderkit/components/control) --- title: Control Components description: "Interactive control components like buttons and wallet connection interfaces." --- # Control Components Control components provide interactive elements for your Web3 application. ## Button The Button component is a versatile control that supports multiple states and actions. ```tsx import { Button } from '@avalabs/builderkit'; // Basic usage ``` Run the project using Nodejs. ```bash npm install express axios path body-parser dotenv node app.js ``` Open a Chrome tab and type `http://localhost:3000`, you should see something like this. Then click on Connect and accept receiving push notifications. If you are using MacOS, check in **System Settings** > **Notifications** that you have enabled notifications for the browser. If everything runs correctly your browser should be registered in OneSignal. To check go to **Audience** > **Subscriptions** and verify that your browser is registered. ### Step 3 - Backend Setup Now, let's configure the backend to manage webhook events and dispatch notifications based on the incoming data. Here's the step-by-step process: 1. **Transaction Initiation:** When someone starts a transaction with your wallet as the destination, the webhooks detect the transaction and generate an event. 2. **Event Triggering:** The backend receives the event triggered by the transaction, containing the destination address. 3. **ExternalID Retrieval:** Using the received address, the backend retrieves the corresponding `externalID` associated with that wallet. 4. **Notification Dispatch:** The final step involves sending a notification through OneSignal, utilizing the retrieved `externalID`. OneSignal Backend #### 3.1 - Use Ngrok to tunnel the traffic to localhost If we want to test the webhook in our computer and we are behind a proxy/NAT device or a firewall we need a tool like Ngrok. Glacier will trigger the webhook and make a POST to the Ngrok cloud, then the request is forwarded to your local Ngrok client who in turn forwards it to the Node.js app listening on port 3000. Go to [https://ngrok.com/](https://ngrok.com/) create a free account, download the binary, and connect to your account. Create a Node.js app with Express and paste the following code to receive the webhook: To start an HTTP tunnel forwarding to your local port 3000 with Ngrok, run this next: ```bash ./ngrok http 3000 ``` You should see something like this: ``` ngrok (Ctrl+C to quit) Take our ngrok in production survey! https://forms.gle/aXiBFWzEA36DudFn6 Session Status online Account javier.toledo@avalabs.org (Plan: Free) Version 3.8.0 Region United States (us) Latency 48ms Web Interface http://127.0.0.1:4040 Forwarding https://c902-2600-1700-5220-11a0-813c-d5ac-d72c-f7fd.ngrok-free.app -> http://localhost:3000 Connections ttl opn rt1 rt5 p50 p90 33 0 0.00 0.00 5.02 5.05 HTTP Requests ------------- ``` #### 3.2 - Create the webhook The webhook can be created using the [Avacloud Dashboard](https://app.avacloud.io/) or Glacier API. For convenience, we are going to use cURL. For that copy the forwarding URL generated by Ngrok and append the `/callbackpath` and our address. ```bash curl --location 'https://glacier-api-dev.avax.network/v1/webhooks' \ --header 'x-glacier-api-key: ' \ --header 'Content-Type: application/json' \ --data '{ "url": " https://c902-2600-1700-5220-11a0-813c-d5ac-d72c-f7fd.ngrok-free.app/callback", "chainId": "43113", "eventType": "address_activity", "includeInternalTxs": true, "includeLogs": true, "metadata": { "addresses": ["0x8ae323046633A07FB162043f28Cea39FFc23B50A"] }, "name": "My wallet", "description": "My wallet" }' ``` Don't forget to add your API Key. If you don't have one go to the [Avacloud Dashboard](https://app.avacloud.io/) and create a new one. #### 3.3 - The backend To run the backend we need to add the environment variables in the root of your project. For that create an `.env` file with the following values: ``` PORT=3000 ONESIGNAL_API_KEY= APP_ID= ``` To get the APP ID from OneSignal go to **Settings** > **Keys and IDs** Since we are simulating the connection to a database to retrieve the externalID, we need to add the wallet address and the OneSignal externalID to the myDB array. ```javascript //simulating a DB const myDB = [ { name: 'wallet1', address: '0x8ae323046633A07FB162043f28Cea39FFc23B50A', externalID: '9c96e91d40c7a44c763fb55960e12293afbcfaf6228860550b0c1cc09cd40ac3' }, { name: 'wallet2', address: '0x1f83eC80D755A87B31553f670070bFD897c40CE0', externalID: '0xd39d39c99305c6df2446d5cc3d584dc1eb041d95ac8fb35d4246f1d2176bf330' } ]; ``` The code handles a webhook event triggered when a wallet receives a transaction, performs a lookup in the simulated "database" using the receiving address to retrieve the corresponding OneSignal `externalID`, and then sends an instruction to OneSignal to dispatch a notification to the browser, with OneSignal ultimately delivering the web push notification to the browser. ```javascript require('dotenv').config(); const axios = require('axios'); const express = require('express'); const bodyParser = require('body-parser'); const path = require('path'); const app = express(); const port = process.env.PORT || 3000; // Serve static website app.use(bodyParser.json()); app.use(express.static(path.join(__dirname, './client'))); //simulating a DB const myDB = [ { name: 'wallet1', address: '0x8ae323046633A07FB162043f28Cea39FFc23B50A', externalID: '9c96e91d40c7a44c763fb55960e12293afbcfaf6228860550b0c1cc09cd40ac3' }, { name: 'wallet2', address: '0x1f83eC80D755A87B31553f670070bFD897c40CE0', externalID: '0xd39d39c99305c6df2446d5cc3d584dc1eb041d95ac8fb35d4246f1d2176bf330' } ]; app.post('/callback', async (req, res) => { const { body } = req; try { res.sendStatus(200); handleTransaction(body.event.transaction).catch(error => { console.error('Error processing transaction:', error); }); } catch (error) { console.error('Error processing transaction:', error); res.status(500).json({ error: 'Internal server error' }); } }); // Handle transaction async function handleTransaction(transaction) { console.log('*****Transaction:', transaction); const notifications = []; const erc20Transfers = transaction?.erc20Transfers || []; for (const transfer of erc20Transfers) { const externalID = await getExternalID(transfer.to); const { symbol, valueWithDecimals } = transfer.erc20Token; notifications.push({ type: transfer.type, sender: transfer.from, receiver: transfer.to, amount: valueWithDecimals, token: symbol, externalID }); } if (transaction?.networkToken) { const { tokenSymbol, valueWithDecimals } = transaction.networkToken; const externalID = await getExternalID(transaction.to); notifications.push({ sender: transaction.from, receiver: transaction.to, amount: valueWithDecimals, token: tokenSymbol, externalID }); } if (notifications.length > 0) { sendNotifications(notifications); } } //connect to DB and return externalID async function getExternalID(address) { const entry = myDB.find(entry => entry.address.toLowerCase() === address.toLowerCase()); return entry ? entry.externalID : null; } // Send notifications async function sendNotifications(notifications) { for (const notification of notifications) { try { const data = { include_aliases: { external_id: [notification.externalID.toLowerCase()] }, target_channel: 'push', isAnyWeb: true, contents: { en: `You've received ${notification.amount} ${notification.token}` }, headings: { en: 'Core wallet' }, name: 'Notification', app_id: process.env.APP_ID }; console.log('data:', data); const response = await axios.post('https://onesignal.com/api/v1/notifications', data, { headers: { Authorization: `Bearer ${process.env.ONESIGNAL_API_KEY}`, 'Content-Type': 'application/json' } }); console.log('Notification sent:', response.data); } catch (error) { console.error('Error sending notification:', error); // Optionally, implement retry logic here } } } // Start the server app.listen(port, () => { console.log(`App listening at http://localhost:${port}`); }); ``` You can now start your backend server by running: ```shell node app.js ``` Send AVAX from another wallet to the wallet being monitored by the webhook and you should receive a notification with the amount of Avax received. You can try it with any other ERC20 token as well. ### Conclusion In this tutorial, we've set up a frontend to connect to the Core wallet and enable push notifications using OneSignal. We've also implemented a backend to handle webhook events and send notifications based on the received data. By integrating the frontend with the backend, users can receive real-time notifications for blockchain events. # Add addresses to EVM activity webhook (/docs/api-reference/webhook-api/webhooks/addAddressesToWebhook) --- title: Add addresses to EVM activity webhook full: true _openapi: method: PATCH route: /v1/webhooks/{id}/addresses toc: [] structuredData: headings: [] contents: - content: Add addresses to webhook. Only valid for EVM activity webhooks. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Add addresses to webhook. Only valid for EVM activity webhooks. # Create a webhook (/docs/api-reference/webhook-api/webhooks/createWebhook) --- title: Create a webhook full: true _openapi: method: POST route: /v1/webhooks toc: [] structuredData: headings: [] contents: - content: Create a new webhook. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Create a new webhook. # Deactivate a webhook (/docs/api-reference/webhook-api/webhooks/deactivateWebhook) --- title: Deactivate a webhook full: true _openapi: method: DELETE route: /v1/webhooks/{id} toc: [] structuredData: headings: [] contents: - content: Deactivates a webhook by ID. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Deactivates a webhook by ID. # Generate or rotate a shared secret (/docs/api-reference/webhook-api/webhooks/generateOrRotateSharedSecret) --- title: Generate or rotate a shared secret full: true _openapi: method: POST route: /v1/webhooks:generateOrRotateSharedSecret toc: [] structuredData: headings: [] contents: - content: Generates a new shared secret or rotate an existing one. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Generates a new shared secret or rotate an existing one. # List adresses by EVM activity webhooks (/docs/api-reference/webhook-api/webhooks/getAddressesFromWebhook) --- title: List adresses by EVM activity webhooks full: true _openapi: method: GET route: /v1/webhooks/{id}/addresses toc: [] structuredData: headings: [] contents: - content: List adresses by webhook. Only valid for EVM activity webhooks. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} List adresses by webhook. Only valid for EVM activity webhooks. # Get a shared secret (/docs/api-reference/webhook-api/webhooks/getSharedSecret) --- title: Get a shared secret full: true _openapi: method: GET route: /v1/webhooks:getSharedSecret toc: [] structuredData: headings: [] contents: - content: Get a previously generated shared secret. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Get a previously generated shared secret. # Get a webhook by ID (/docs/api-reference/webhook-api/webhooks/getWebhook) --- title: Get a webhook by ID full: true _openapi: method: GET route: /v1/webhooks/{id} toc: [] structuredData: headings: [] contents: - content: Retrieves a webhook by ID. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Retrieves a webhook by ID. # List webhooks (/docs/api-reference/webhook-api/webhooks/listWebhooks) --- title: List webhooks full: true _openapi: method: GET route: /v1/webhooks toc: [] structuredData: headings: [] contents: - content: Lists webhooks for the user. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists webhooks for the user. # Remove addresses from EVM activity webhook (/docs/api-reference/webhook-api/webhooks/removeAddressesFromWebhook) --- title: Remove addresses from EVM activity webhook full: true _openapi: method: DELETE route: /v1/webhooks/{id}/addresses toc: [] structuredData: headings: [] contents: - content: Remove addresses from webhook. Only valid for EVM activity webhooks. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Remove addresses from webhook. Only valid for EVM activity webhooks. # Update a webhook (/docs/api-reference/webhook-api/webhooks/updateWebhook) --- title: Update a webhook full: true _openapi: method: PATCH route: /v1/webhooks/{id} toc: [] structuredData: headings: [] contents: - content: Updates an existing webhook. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Updates an existing webhook. # Get AVAX supply information (/docs/api-reference/data-api/avax-supply/getAvaxSupply) --- title: Get AVAX supply information full: true _openapi: method: GET route: /v1/avax/supply toc: [] structuredData: headings: [] contents: - content: >- Get AVAX supply information that includes total supply, circulating supply, total p burned, total c burned, total x burned, total staked, total locked, total rewards, and last updated. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Get AVAX supply information that includes total supply, circulating supply, total p burned, total c burned, total x burned, total staked, total locked, total rewards, and last updated. # Get logs for requests made by client (/docs/api-reference/data-api/data-api-usage-metrics/getApiLogs) --- title: Get logs for requests made by client full: true _openapi: method: GET route: /v1/apiLogs toc: [] structuredData: headings: [] contents: - content: >- Gets logs for requests made by client over a specified time interval for a specific organization. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets logs for requests made by client over a specified time interval for a specific organization. # Get usage metrics for the Data API (/docs/api-reference/data-api/data-api-usage-metrics/getApiUsageMetrics) --- title: Get usage metrics for the Data API full: true _openapi: method: GET route: /v1/apiUsageMetrics toc: [] structuredData: headings: [] contents: - content: >- Gets metrics for Data API usage over a specified time interval aggregated at the specified time-duration granularity. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets metrics for Data API usage over a specified time interval aggregated at the specified time-duration granularity. # Get usage metrics for the Primary Network RPC (/docs/api-reference/data-api/data-api-usage-metrics/getPrimaryNetworkRpcUsageMetrics) --- title: Get usage metrics for the Primary Network RPC full: true _openapi: method: GET route: /v1/primaryNetworkRpcUsageMetrics toc: [] structuredData: headings: [] contents: - content: >- Gets metrics for public Primary Network RPC usage over a specified time interval aggregated at the specified time-duration granularity. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets metrics for public Primary Network RPC usage over a specified time interval aggregated at the specified time-duration granularity. # Get usage metrics for the Subnet RPC (/docs/api-reference/data-api/data-api-usage-metrics/getSubnetRpcUsageMetrics) --- title: Get usage metrics for the Subnet RPC full: true _openapi: method: GET route: /v1/subnetRpcUsageMetrics toc: [] structuredData: headings: [] contents: - content: >- Gets metrics for public Subnet RPC usage over a specified time interval aggregated at the specified time-duration granularity. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets metrics for public Subnet RPC usage over a specified time interval aggregated at the specified time-duration granularity. # Get native token balance (/docs/api-reference/data-api/evm-balances/getNativeBalance) --- title: Get native token balance full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/balances:getNative toc: [] structuredData: headings: [] contents: - content: >- Gets native token balance of a wallet address. Balance at a given block can be retrieved with the `blockNumber` parameter. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets native token balance of a wallet address. Balance at a given block can be retrieved with the `blockNumber` parameter. # List collectible (ERC-721/ERC-1155) balances (/docs/api-reference/data-api/evm-balances/listCollectibleBalances) --- title: List collectible (ERC-721/ERC-1155) balances full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/balances:listCollectibles toc: [] structuredData: headings: [] contents: - content: >- Lists ERC-721 and ERC-1155 token balances of a wallet address. Balance for a specific contract can be retrieved with the `contractAddress` parameter. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ERC-721 and ERC-1155 token balances of a wallet address. Balance for a specific contract can be retrieved with the `contractAddress` parameter. # List ERC-1155 balances (/docs/api-reference/data-api/evm-balances/listErc1155Balances) --- title: List ERC-1155 balances full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/balances:listErc1155 toc: [] structuredData: headings: [] contents: - content: >- Lists ERC-1155 token balances of a wallet address. Balance at a given block can be retrieved with the `blockNumber` parameter. Balance for a specific contract can be retrieved with the `contractAddress` parameter. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ERC-1155 token balances of a wallet address. Balance at a given block can be retrieved with the `blockNumber` parameter. Balance for a specific contract can be retrieved with the `contractAddress` parameter. # List ERC-20 balances (/docs/api-reference/data-api/evm-balances/listErc20Balances) --- title: List ERC-20 balances full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/balances:listErc20 toc: [] structuredData: headings: [] contents: - content: >- Lists ERC-20 token balances of a wallet address. Balance at a given block can be retrieved with the `blockNumber` parameter. Balance for specific contracts can be retrieved with the `contractAddresses` parameter. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ERC-20 token balances of a wallet address. Balance at a given block can be retrieved with the `blockNumber` parameter. Balance for specific contracts can be retrieved with the `contractAddresses` parameter. # List ERC-721 balances (/docs/api-reference/data-api/evm-balances/listErc721Balances) --- title: List ERC-721 balances full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/balances:listErc721 toc: [] structuredData: headings: [] contents: - content: >- Lists ERC-721 token balances of a wallet address. Balance for a specific contract can be retrieved with the `contractAddress` parameter. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ERC-721 token balances of a wallet address. Balance for a specific contract can be retrieved with the `contractAddress` parameter. # Get block (/docs/api-reference/data-api/evm-blocks/getBlock) --- title: Get block full: true _openapi: method: GET route: /v1/chains/{chainId}/blocks/{blockId} toc: [] structuredData: headings: [] contents: - content: Gets the details of an individual block on the EVM-compatible chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets the details of an individual block on the EVM-compatible chain. # List latest blocks (/docs/api-reference/data-api/evm-blocks/getLatestBlocks) --- title: List latest blocks full: true _openapi: method: GET route: /v1/chains/{chainId}/blocks toc: [] structuredData: headings: [] contents: - content: >- Lists the latest indexed blocks on the EVM-compatible chain sorted in descending order by block timestamp. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists the latest indexed blocks on the EVM-compatible chain sorted in descending order by block timestamp. # List latest blocks across all supported EVM chains (/docs/api-reference/data-api/evm-blocks/listLatestBlocksAllChains) --- title: List latest blocks across all supported EVM chains full: true _openapi: method: GET route: /v1/blocks toc: [] structuredData: headings: [] contents: - content: >- Lists the most recent blocks from all supported EVM-compatible chains. The results can be filtered by network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists the most recent blocks from all supported EVM-compatible chains. The results can be filtered by network. # Get chain information (/docs/api-reference/data-api/evm-chains/getChainInfo) --- title: Get chain information full: true _openapi: method: GET route: /v1/chains/{chainId} toc: [] structuredData: headings: [] contents: - content: >- Gets chain information for the EVM-compatible chain if supported by AvaCloud. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets chain information for the EVM-compatible chain if supported by AvaCloud. # List all chains associated with a given address (/docs/api-reference/data-api/evm-chains/listAddressChains) --- title: List all chains associated with a given address full: true _openapi: method: GET route: /v1/address/{address}/chains toc: [] structuredData: headings: [] contents: - content: >- Lists the chains where the specified address has participated in transactions or ERC token transfers, either as a sender or receiver. The data is refreshed every 15 minutes. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists the chains where the specified address has participated in transactions or ERC token transfers, either as a sender or receiver. The data is refreshed every 15 minutes. # List chains (/docs/api-reference/data-api/evm-chains/supportedChains) --- title: List chains full: true _openapi: method: GET route: /v1/chains toc: [] structuredData: headings: [] contents: - content: >- Lists the AvaCloud supported EVM-compatible chains. Filterable by network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists the AvaCloud supported EVM-compatible chains. Filterable by network. # Get contract metadata (/docs/api-reference/data-api/evm-contracts/getContractMetadata) --- title: Get contract metadata full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address} toc: [] structuredData: headings: [] contents: - content: Gets metadata about the contract at the given address. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets metadata about the contract at the given address. # Get deployment transaction (/docs/api-reference/data-api/evm-transactions/getDeploymentTransaction) --- title: Get deployment transaction full: true _openapi: method: GET route: /v1/chains/{chainId}/contracts/{address}/transactions:getDeployment toc: [] structuredData: headings: [] contents: - content: >- If the address is a smart contract, returns the transaction in which it was deployed. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} If the address is a smart contract, returns the transaction in which it was deployed. # Get transaction (/docs/api-reference/data-api/evm-transactions/getTransaction) --- title: Get transaction full: true _openapi: method: GET route: /v1/chains/{chainId}/transactions/{txHash} toc: [] structuredData: headings: [] contents: - content: Gets the details of a single transaction. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets the details of a single transaction. # List transactions for a block (/docs/api-reference/data-api/evm-transactions/getTransactionsForBlock) --- title: List transactions for a block full: true _openapi: method: GET route: /v1/chains/{chainId}/blocks/{blockId}/transactions toc: [] structuredData: headings: [] contents: - content: Lists the transactions that occured in a given block. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists the transactions that occured in a given block. # List deployed contracts (/docs/api-reference/data-api/evm-transactions/listContractDeployments) --- title: List deployed contracts full: true _openapi: method: GET route: /v1/chains/{chainId}/contracts/{address}/deployments toc: [] structuredData: headings: [] contents: - content: Lists all contracts deployed by the given address. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists all contracts deployed by the given address. # List ERC-1155 transfers (/docs/api-reference/data-api/evm-transactions/listErc1155Transactions) --- title: List ERC-1155 transfers full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/transactions:listErc1155 toc: [] structuredData: headings: [] contents: - content: Lists ERC-1155 transfers for an address. Filterable by block range. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ERC-1155 transfers for an address. Filterable by block range. # List ERC-20 transfers (/docs/api-reference/data-api/evm-transactions/listErc20Transactions) --- title: List ERC-20 transfers full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/transactions:listErc20 toc: [] structuredData: headings: [] contents: - content: Lists ERC-20 transfers for an address. Filterable by block range. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ERC-20 transfers for an address. Filterable by block range. # List ERC-721 transfers (/docs/api-reference/data-api/evm-transactions/listErc721Transactions) --- title: List ERC-721 transfers full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/transactions:listErc721 toc: [] structuredData: headings: [] contents: - content: Lists ERC-721 transfers for an address. Filterable by block range. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ERC-721 transfers for an address. Filterable by block range. # List internal transactions (/docs/api-reference/data-api/evm-transactions/listInternalTransactions) --- title: List internal transactions full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/transactions:listInternals toc: [] structuredData: headings: [] contents: - content: >- Returns a list of internal transactions for an address and chain. Filterable by block range. Note that the internal transactions list only contains `CALL` or `CALLCODE` transactions with a non-zero value and `CREATE`/`CREATE2`/`CREATE3` transactions. To get a complete list of internal transactions use the `debug_` prefixed RPC methods on an archive node. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns a list of internal transactions for an address and chain. Filterable by block range. Note that the internal transactions list only contains `CALL` or `CALLCODE` transactions with a non-zero value and `CREATE`/`CREATE2`/`CREATE3` transactions. To get a complete list of internal transactions use the `debug_` prefixed RPC methods on an archive node. # List latest transactions (/docs/api-reference/data-api/evm-transactions/listLatestTransactions) --- title: List latest transactions full: true _openapi: method: GET route: /v1/chains/{chainId}/transactions toc: [] structuredData: headings: [] contents: - content: Lists the latest transactions. Filterable by status. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists the latest transactions. Filterable by status. # List the latest transactions across all supported EVM chains (/docs/api-reference/data-api/evm-transactions/listLatestTransactionsAllChains) --- title: List the latest transactions across all supported EVM chains full: true _openapi: method: GET route: /v1/transactions toc: [] structuredData: headings: [] contents: - content: >- Lists the most recent transactions from all supported EVM-compatible chains. The results can be filtered based on transaction status. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists the most recent transactions from all supported EVM-compatible chains. The results can be filtered based on transaction status. # List native transactions (/docs/api-reference/data-api/evm-transactions/listNativeTransactions) --- title: List native transactions full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/transactions:listNative toc: [] structuredData: headings: [] contents: - content: Lists native transactions for an address. Filterable by block range. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists native transactions for an address. Filterable by block range. # List transactions (/docs/api-reference/data-api/evm-transactions/listTransactions) --- title: List transactions full: true _openapi: method: GET route: /v1/chains/{chainId}/addresses/{address}/transactions toc: [] structuredData: headings: [] contents: - content: >- Returns a list of transactions where the given wallet address had an on-chain interaction for the given chain. The ERC-20 transfers, ERC-721 transfers, ERC-1155, and internal transactions returned are only those where the input address had an interaction. Specifically, those lists only inlcude entries where the input address was the sender (`from` field) or the receiver (`to` field) for the sub-transaction. Therefore the transactions returned from this list may not be complete representations of the on-chain data. For a complete view of a transaction use the `/chains/:chainId/transactions/:txHash` endpoint. Filterable by block ranges. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns a list of transactions where the given wallet address had an on-chain interaction for the given chain. The ERC-20 transfers, ERC-721 transfers, ERC-1155, and internal transactions returned are only those where the input address had an interaction. Specifically, those lists only inlcude entries where the input address was the sender (`from` field) or the receiver (`to` field) for the sub-transaction. Therefore the transactions returned from this list may not be complete representations of the on-chain data. For a complete view of a transaction use the `/chains/:chainId/transactions/:txHash` endpoint. Filterable by block ranges. # List ERC transfers (/docs/api-reference/data-api/evm-transactions/listTransfers) --- title: List ERC transfers full: true _openapi: method: GET route: /v1/chains/{chainId}/tokens/{address}/transfers toc: [] structuredData: headings: [] contents: - content: >- Lists ERC transfers for an ERC-20, ERC-721, or ERC-1155 contract address. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ERC transfers for an ERC-20, ERC-721, or ERC-1155 contract address. # Get the health of the service (/docs/api-reference/data-api/health-check/data-health-check) --- title: Get the health of the service full: true _openapi: method: GET route: /v1/health-check toc: [] structuredData: headings: [] contents: - content: >- Check the health of the service. This checks the read and write health of the database and cache. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Check the health of the service. This checks the read and write health of the database and cache. # Get the liveliness of the service (reads only) (/docs/api-reference/data-api/health-check/live-check) --- title: Get the liveliness of the service (reads only) full: true _openapi: method: GET route: /v1/live-check toc: [] structuredData: headings: [] contents: - content: Check the liveliness of the service (reads only). --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Check the liveliness of the service (reads only). # Get an ICM message (/docs/api-reference/data-api/interchain-messaging/getIcmMessage) --- title: Get an ICM message full: true _openapi: method: GET route: /v1/icm/messages/{messageId} toc: [] structuredData: headings: [] contents: - content: Gets an ICM message by teleporter message ID. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets an ICM message by teleporter message ID. # List ICM messages (/docs/api-reference/data-api/interchain-messaging/listIcmMessages) --- title: List ICM messages full: true _openapi: method: GET route: /v1/icm/messages toc: [] structuredData: headings: [] contents: - content: Lists ICM messages. Ordered by timestamp in descending order. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ICM messages. Ordered by timestamp in descending order. # List ICM messages by address (/docs/api-reference/data-api/interchain-messaging/listIcmMessagesByAddress) --- title: List ICM messages by address full: true _openapi: method: GET route: /v1/icm/addresses/{address}/messages toc: [] structuredData: headings: [] contents: - content: >- Lists ICM messages by address. Ordered by timestamp in descending order. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists ICM messages by address. Ordered by timestamp in descending order. # Get token details (/docs/api-reference/data-api/nfts/getTokenDetails) --- title: Get token details full: true _openapi: method: GET route: /v1/chains/{chainId}/nfts/collections/{address}/tokens/{tokenId} toc: [] structuredData: headings: [] contents: - content: Gets token details for a specific token of an NFT contract. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets token details for a specific token of an NFT contract. # List tokens (/docs/api-reference/data-api/nfts/listTokens) --- title: List tokens full: true _openapi: method: GET route: /v1/chains/{chainId}/nfts/collections/{address}/tokens toc: [] structuredData: headings: [] contents: - content: Lists tokens for an NFT contract. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists tokens for an NFT contract. # Reindex NFT metadata (/docs/api-reference/data-api/nfts/reindexNft) --- title: Reindex NFT metadata full: true _openapi: method: POST route: /v1/chains/{chainId}/nfts/collections/{address}/tokens/{tokenId}:reindex toc: [] structuredData: headings: [] contents: - content: >- Triggers reindexing of token metadata for an NFT token. Reindexing can only be called once per hour for each NFT token. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Triggers reindexing of token metadata for an NFT token. Reindexing can only be called once per hour for each NFT token. # Get operation (/docs/api-reference/data-api/operations/getOperationResult) --- title: Get operation full: true _openapi: method: GET route: /v1/operations/{operationId} toc: [] structuredData: headings: [] contents: - content: Gets operation details for the given operation id. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets operation details for the given operation id. # Create transaction export operation (/docs/api-reference/data-api/operations/postTransactionExportJob) --- title: Create transaction export operation full: true _openapi: method: POST route: /v1/operations/transactions:export toc: [] structuredData: headings: [] contents: - content: >- Trigger a transaction export operation with given parameters. The transaction export operation runs asynchronously in the background. The status of the job can be retrieved from the `/v1/operations/:operationId` endpoint using the `operationId` returned from this endpoint. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Trigger a transaction export operation with given parameters. The transaction export operation runs asynchronously in the background. The status of the job can be retrieved from the `/v1/operations/:operationId` endpoint using the `operationId` returned from this endpoint. # Get asset details (/docs/api-reference/data-api/primary-network/getAssetDetails) --- title: Get asset details full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/assets/{assetId} toc: [] structuredData: headings: [] contents: - content: Gets asset details corresponding to the given asset id on the X-Chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets asset details corresponding to the given asset id on the X-Chain. # Get blockchain details by ID (/docs/api-reference/data-api/primary-network/getBlockchainById) --- title: Get blockchain details by ID full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId} toc: [] structuredData: headings: [] contents: - content: Get details of the blockchain registered on the network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Get details of the blockchain registered on the network. # Get chain interactions for addresses (/docs/api-reference/data-api/primary-network/getChainIdsForAddresses) --- title: Get chain interactions for addresses full: true _openapi: method: GET route: /v1/networks/{network}/addresses:listChainIds toc: [] structuredData: headings: [] contents: - content: >- Returns Primary Network chains that each address has touched in the form of an address mapped array. If an address has had any on-chain interaction for a chain, that chain's chain id will be returned. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns Primary Network chains that each address has touched in the form of an address mapped array. If an address has had any on-chain interaction for a chain, that chain's chain id will be returned. # Get network details (/docs/api-reference/data-api/primary-network/getNetworkDetails) --- title: Get network details full: true _openapi: method: GET route: /v1/networks/{network} toc: [] structuredData: headings: [] contents: - content: Gets network details such as validator and delegator stats. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets network details such as validator and delegator stats. # Get single validator details (/docs/api-reference/data-api/primary-network/getSingleValidatorDetails) --- title: Get single validator details full: true _openapi: method: GET route: /v1/networks/{network}/validators/{nodeId} toc: [] structuredData: headings: [] contents: - content: >- List validator details for a single validator. Filterable by validation status. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} List validator details for a single validator. Filterable by validation status. # Get Subnet details by ID (/docs/api-reference/data-api/primary-network/getSubnetById) --- title: Get Subnet details by ID full: true _openapi: method: GET route: /v1/networks/{network}/subnets/{subnetId} toc: [] structuredData: headings: [] contents: - content: Get details of the Subnet registered on the network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Get details of the Subnet registered on the network. # List blockchains (/docs/api-reference/data-api/primary-network/listBlockchains) --- title: List blockchains full: true _openapi: method: GET route: /v1/networks/{network}/blockchains toc: [] structuredData: headings: [] contents: - content: Lists all blockchains registered on the network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists all blockchains registered on the network. # List delegators (/docs/api-reference/data-api/primary-network/listDelegators) --- title: List delegators full: true _openapi: method: GET route: /v1/networks/{network}/delegators toc: [] structuredData: headings: [] contents: - content: Lists details for delegators. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists details for delegators. # List L1 validators (/docs/api-reference/data-api/primary-network/listL1Validators) --- title: List L1 validators full: true _openapi: method: GET route: /v1/networks/{network}/l1Validators toc: [] structuredData: headings: [] contents: - content: >- Lists details for L1 validators. By default, returns details for all active L1 validators. Filterable by validator node ids, subnet id, and validation id. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists details for L1 validators. By default, returns details for all active L1 validators. Filterable by validator node ids, subnet id, and validation id. # List subnets (/docs/api-reference/data-api/primary-network/listSubnets) --- title: List subnets full: true _openapi: method: GET route: /v1/networks/{network}/subnets toc: [] structuredData: headings: [] contents: - content: Lists all subnets registered on the network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists all subnets registered on the network. # List validators (/docs/api-reference/data-api/primary-network/listValidators) --- title: List validators full: true _openapi: method: GET route: /v1/networks/{network}/validators toc: [] structuredData: headings: [] contents: - content: >- Lists details for validators. By default, returns details for all validators. The nodeIds parameter supports substring matching. Filterable by validation status, delegation capacity, time remaining, fee percentage, uptime performance, and subnet id. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists details for validators. By default, returns details for all validators. The nodeIds parameter supports substring matching. Filterable by validation status, delegation capacity, time remaining, fee percentage, uptime performance, and subnet id. # Get balances (/docs/api-reference/data-api/primary-network-balances/getBalancesByAddresses) --- title: Get balances full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/balances toc: [] structuredData: headings: [] contents: - content: >- Gets primary network balances for one of the Primary Network chains for the supplied addresses. C-Chain balances returned are only the shared atomic memory balance. For EVM balance, use the `/v1/chains/:chainId/addresses/:addressId/balances:getNative` endpoint. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets primary network balances for one of the Primary Network chains for the supplied addresses. C-Chain balances returned are only the shared atomic memory balance. For EVM balance, use the `/v1/chains/:chainId/addresses/:addressId/balances:getNative` endpoint. # Get block (/docs/api-reference/data-api/primary-network-blocks/getBlockById) --- title: Get block full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/blocks/{blockId} toc: [] structuredData: headings: [] contents: - content: >- Gets a block by block height or block hash on one of the Primary Network chains. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets a block by block height or block hash on one of the Primary Network chains. # List latest blocks (/docs/api-reference/data-api/primary-network-blocks/listLatestPrimaryNetworkBlocks) --- title: List latest blocks full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/blocks toc: [] structuredData: headings: [] contents: - content: Lists latest blocks on one of the Primary Network chains. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists latest blocks on one of the Primary Network chains. # List blocks proposed by node (/docs/api-reference/data-api/primary-network-blocks/listPrimaryNetworkBlocksByNodeId) --- title: List blocks proposed by node full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/nodes/{nodeId}/blocks toc: [] structuredData: headings: [] contents: - content: >- Lists the latest blocks proposed by a given NodeID on one of the Primary Network chains. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists the latest blocks proposed by a given NodeID on one of the Primary Network chains. # List historical rewards (/docs/api-reference/data-api/primary-network-rewards/listHistoricalPrimaryNetworkRewards) --- title: List historical rewards full: true _openapi: method: GET route: /v1/networks/{network}/rewards toc: [] structuredData: headings: [] contents: - content: >- Lists historical rewards on the Primary Network for the supplied addresses. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists historical rewards on the Primary Network for the supplied addresses. # List pending rewards (/docs/api-reference/data-api/primary-network-rewards/listPendingPrimaryNetworkRewards) --- title: List pending rewards full: true _openapi: method: GET route: /v1/networks/{network}/rewards:listPending toc: [] structuredData: headings: [] contents: - content: >- Lists pending rewards on the Primary Network for the supplied addresses. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists pending rewards on the Primary Network for the supplied addresses. # Get transaction (/docs/api-reference/data-api/primary-network-transactions/getTxByHash) --- title: Get transaction full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/transactions/{txHash} toc: [] structuredData: headings: [] contents: - content: >- Gets the details of a single transaction on one of the Primary Network chains. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets the details of a single transaction on one of the Primary Network chains. # List staking transactions (/docs/api-reference/data-api/primary-network-transactions/listActivePrimaryNetworkStakingTransactions) --- title: List staking transactions full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/transactions:listStaking toc: [] structuredData: headings: [] contents: - content: >- Lists active staking transactions on the P-Chain for the supplied addresses. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists active staking transactions on the P-Chain for the supplied addresses. # List asset transactions (/docs/api-reference/data-api/primary-network-transactions/listAssetTransactions) --- title: List asset transactions full: true _openapi: method: GET route: >- /v1/networks/{network}/blockchains/{blockchainId}/assets/{assetId}/transactions toc: [] structuredData: headings: [] contents: - content: >- Lists asset transactions corresponding to the given asset id on the X-Chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists asset transactions corresponding to the given asset id on the X-Chain. # List latest transactions (/docs/api-reference/data-api/primary-network-transactions/listLatestPrimaryNetworkTransactions) --- title: List latest transactions full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/transactions toc: [] structuredData: headings: [] contents: - content: >- Lists the latest transactions on one of the Primary Network chains. Transactions are filterable by addresses, txTypes, and timestamps. When querying for latest transactions without an address parameter, filtering by txTypes and timestamps is not supported. An address filter must be provided to utilize txTypes and timestamp filters. For P-Chain, you can fetch all L1 validators related transactions like ConvertSubnetToL1Tx, IncreaseL1ValidatorBalanceTx etc. using the unique L1 validation ID. These transactions are further filterable by txTypes and timestamps as well. Given that each transaction may return a large number of UTXO objects, bounded only by the maximum transaction size, the query may return less transactions than the provided page size. The result will contain less results than the page size if the number of utxos contained in the resulting transactions reach a performance threshold. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists the latest transactions on one of the Primary Network chains. Transactions are filterable by addresses, txTypes, and timestamps. When querying for latest transactions without an address parameter, filtering by txTypes and timestamps is not supported. An address filter must be provided to utilize txTypes and timestamp filters. For P-Chain, you can fetch all L1 validators related transactions like ConvertSubnetToL1Tx, IncreaseL1ValidatorBalanceTx etc. using the unique L1 validation ID. These transactions are further filterable by txTypes and timestamps as well. Given that each transaction may return a large number of UTXO objects, bounded only by the maximum transaction size, the query may return less transactions than the provided page size. The result will contain less results than the page size if the number of utxos contained in the resulting transactions reach a performance threshold. # List UTXOs (/docs/api-reference/data-api/primary-network-utxos/getUtxosByAddresses) --- title: List UTXOs full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/utxos toc: [] structuredData: headings: [] contents: - content: >- Lists UTXOs on one of the Primary Network chains for the supplied addresses. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists UTXOs on one of the Primary Network chains for the supplied addresses. # List UTXOs v2 - Supports querying for more addresses (/docs/api-reference/data-api/primary-network-utxos/getUtxosByAddressesV2) --- title: List UTXOs v2 - Supports querying for more addresses full: true _openapi: method: POST route: /v1/networks/{network}/blockchains/{blockchainId}/utxos toc: [] structuredData: headings: [] contents: - content: >- Lists UTXOs on one of the Primary Network chains for the supplied addresses. This v2 route supports increased page size and address limit. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists UTXOs on one of the Primary Network chains for the supplied addresses. This v2 route supports increased page size and address limit. # Get vertex (/docs/api-reference/data-api/primary-network-vertices/getVertexByHash) --- title: Get vertex full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/vertices/{vertexHash} toc: [] structuredData: headings: [] contents: - content: Gets a single vertex on the X-Chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets a single vertex on the X-Chain. # List vertices by height (/docs/api-reference/data-api/primary-network-vertices/getVertexByHeight) --- title: List vertices by height full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/vertices:listByHeight toc: [] structuredData: headings: [] contents: - content: Lists vertices at the given vertex height on the X-Chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists vertices at the given vertex height on the X-Chain. # List vertices (/docs/api-reference/data-api/primary-network-vertices/listLatestXChainVertices) --- title: List vertices full: true _openapi: method: GET route: /v1/networks/{network}/blockchains/{blockchainId}/vertices toc: [] structuredData: headings: [] contents: - content: Lists latest vertices on the X-Chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Lists latest vertices on the X-Chain. # Aggregate Signatures (/docs/api-reference/data-api/signature-aggregator/aggregateSignatures) --- title: Aggregate Signatures full: true _openapi: method: POST route: /v1/signatureAggregator/{network}/aggregateSignatures toc: [] structuredData: headings: [] contents: - content: Aggregates Signatures for a Warp message from Subnet validators. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Aggregates Signatures for a Warp message from Subnet validators. # Get Aggregated Signatures (/docs/api-reference/data-api/signature-aggregator/getAggregatedSignatures) --- title: Get Aggregated Signatures full: true _openapi: method: GET route: /v1/signatureAggregator/{network}/aggregateSignatures/{txHash} toc: [] structuredData: headings: [] contents: - content: Get Aggregated Signatures for a P-Chain L1 related Warp Message. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Get Aggregated Signatures for a P-Chain L1 related Warp Message. # ChainDropdown (/docs/builderkit/components/chains/chain-dropdown) --- title: ChainDropdown description: "A dropdown component for selecting Avalanche chains with visual chain information." --- # ChainDropdown The ChainDropdown component provides a styled dropdown menu for selecting between different Avalanche chains. ## Usage ```tsx import { ChainDropdown } from '@avalabs/builderkit'; // Basic usage console.log('Selected chain:', chainId)} /> // With custom styling ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `selected` | `number` | - | Currently selected chain ID | | `list` | `number[]` | - | Array of available chain IDs | | `onSelectionChanged` | `(chain_id: number) => void` | - | Callback when selection changes | | `className` | `string` | - | Additional CSS classes | ## Features - Displays chain information using ChainRow component - Maintains selected state internally - Styled dropdown with Tailwind CSS - Uses common Select components for consistent UI - Automatic chain information lookup ## Examples ### Basic Chain Selection ```tsx ``` ### With Network Switching ```tsx { try { await switchNetwork(chainId); } catch (error) { console.error('Failed to switch network:', error); } }} /> ``` ### Custom Styling ```tsx ``` ### With Chain Filtering ```tsx supportedChains.includes(id))} onSelectionChanged={handleChainChange} /> ``` ## Component Structure The dropdown consists of: 1. **Trigger**: Shows currently selected chain 2. **Content**: List of available chains 3. **Items**: Individual chain rows with icons and names ## Visual States 1. **Default**: Shows selected chain 2. **Open**: Displays list of available chains 3. **Hover**: Highlights chain under cursor 4. **Selected**: Indicates current selection ## Chain Information The component uses the `useChains` hook to fetch chain information, which includes: - Chain ID - Chain name - Chain icon (via ChainRow component) ## Styling Default styling includes: - Primary background color - Contrasting text color - Rounded corners - Proper padding and spacing - Hover and focus states # ChainIcon (/docs/builderkit/components/chains/chain-icon) --- title: ChainIcon description: "A component for displaying chain logos based on chain ID." --- # ChainIcon The ChainIcon component displays chain logos for Avalanche networks using a standardized path structure. ## Usage ```tsx import { ChainIcon } from '@avalabs/builderkit'; // Basic usage // With custom styling ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID to display logo for | | `className` | `string` | - | Additional CSS classes | ## Features - Displays chain logos from a standardized path structure - Uses common Icon component for consistent display - Supports custom styling through className - Simple and lightweight implementation ## Examples ### Basic Chain Icon ```tsx ``` ### Custom Size ```tsx ``` ### In a List ```tsx
``` ### With Border ```tsx ``` ## Asset Requirements The component expects chain logo images to be available at: ``` /chains/logo/{chain_id}.png ``` For example: ``` /chains/logo/43114.png // Avalanche C-Chain /chains/logo/43113.png // Fuji Testnet ``` # ChainRow (/docs/builderkit/components/chains/chain-row) --- title: ChainRow description: "A component for displaying chain information in a row layout with icon and name." --- # ChainRow The ChainRow component displays chain information in a horizontal layout, combining a chain icon with its name. ## Usage ```tsx import { ChainRow } from '@avalabs/builderkit'; // Basic usage // With custom styling ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID | | `name` | `string` | - | Chain name | | `className` | `string` | - | Additional CSS classes | ## Features - Combines ChainIcon with chain name - Horizontal layout with proper spacing - Flexible styling through className - Simple and lightweight implementation - Consistent alignment and spacing ## Examples ### Basic Chain Display ```tsx ``` ### In a List ```tsx
``` ### Interactive Row ```tsx ``` ### With Custom Styling ```tsx ``` ## Layout Structure The component uses a flex layout with: - ChainIcon on the left - Chain name on the right - Gap between icon and name - Center alignment of items # Collectible (/docs/builderkit/components/collectibles/collectible) --- title: Collectible description: "A component for displaying NFT collectibles with metadata and image support." --- # Collectible The Collectible component displays NFT collectibles with automatic metadata resolution and image display. ## Usage ```tsx import { Collectible } from '@avalabs/builderkit'; // Basic usage // With custom styling ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID where the NFT exists | | `address` | `string` | - | NFT contract address | | `token_id` | `number` | - | Token ID of the NFT | | `className` | `string` | - | Additional CSS classes | ## Features - Automatic metadata resolution from IPFS - Displays NFT image and name - Shows token ID - Supports ERC721 standard - Responsive layout with fixed dimensions - Loading state handling ## Examples ### Basic NFT Display ```tsx ``` ### In a Grid Layout ```tsx
{nfts.map(nft => ( ))}
``` ### With Custom Styling ```tsx ``` ## Component Structure 1. **Container** - Fixed width of 120px - Rounded corners - Border - Overflow hidden 2. **Image** - Fixed dimensions (120x120) - Maintains aspect ratio - Centered display 3. **Info Section** - White background - Token ID display - NFT name - Proper padding ## Metadata Resolution The component automatically: 1. Fetches token URI from the contract 2. Resolves IPFS metadata 3. Extracts image URL and name 4. Handles IPFS gateway resolution # Button (/docs/builderkit/components/control/button) --- title: Button description: "A versatile button component that supports multiple states and actions." --- # Button The Button component is a versatile control that supports multiple states and actions. ## Usage ```tsx import { Button } from '@avalabs/builderkit'; // Basic usage ``` ## Validation States 1. **Initial**: No validation indicator 2. **Valid**: No visual feedback (clean state) 3. **Invalid**: Red ring around input 4. **Disabled**: Grayed out appearance # AmountInput (/docs/builderkit/components/input/amount-input) --- title: AmountInput description: "A specialized input component for handling numeric amounts with proper formatting." --- # AmountInput The AmountInput component provides a specialized input field for handling numeric amounts with automatic formatting and validation. ## Usage ```tsx import { AmountInput } from '@avalabs/builderkit'; import { DollarSign } from 'lucide-react'; // Basic usage console.log('Amount:', value)} /> // With currency icon } onChange={handleAmountChange} /> ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `type` | `string` | - | Input type (usually "text") | | `placeholder` | `string` | - | Placeholder text | | `value` | `string` | `""` | Controlled input value | | `disabled` | `boolean` | `false` | Whether the input is disabled | | `icon` | `ReactNode` | - | Optional icon element | | `onChange` | `(value: string) => void` | - | Called with formatted amount | | `className` | `string` | - | Additional CSS classes | ## Features - Automatic number formatting - Prevents invalid number inputs - Handles decimal points appropriately - Optional icon support - Controlled value management - Background color inheritance ## Examples ### Basic Amount Input ```tsx ``` ### With Maximum Value ```tsx { if (parseFloat(value) <= maxAmount) { setAmount(value); } }} /> ``` ### With Currency Symbol ```tsx $} onChange={handleAmount} className="text-right" /> ``` ### In a Form ```tsx
``` ## Number Formatting The component uses `parseNumberInput` utility to: - Allow only numeric input - Handle decimal points - Remove leading zeros - Maintain proper number format # Input (/docs/builderkit/components/input/input) --- title: Input description: "A base input component with icon support and controlled value management." --- # Input The Input component provides a base text input with support for icons, controlled values, and custom styling. ## Usage ```tsx import { Input } from '@avalabs/builderkit'; import { Search } from 'lucide-react'; // Basic usage console.log('Input value:', value)} /> // With icon } onChange={handleSearch} /> // Disabled state ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `type` | `string` | - | Input type (e.g., 'text', 'number') | | `placeholder` | `string` | - | Placeholder text | | `value` | `any` | `""` | Controlled input value | | `disabled` | `boolean` | `false` | Whether the input is disabled | | `icon` | `ReactNode` | - | Optional icon element | | `onChange` | `(value: any) => void` | - | Value change callback | | `className` | `string` | - | Additional CSS classes | ## Features - Controlled input value management - Optional icon support - Disabled state handling - Flexible styling with Tailwind CSS - Consistent padding and spacing - Background inheritance for seamless integration ## Examples ### Text Input ```tsx ``` ### Search Input ```tsx } onChange={handleSearch} className="bg-gray-100" /> ``` ### Number Input ```tsx ``` ### With Validation ```tsx ``` ## Layout Structure The component uses a flex container with: - Optional icon on the left - Full-width input field - Consistent padding and gap - Background color inheritance # MultiChainTokenInput (/docs/builderkit/components/input/multi-chain-token-input) --- title: MultiChainTokenInput description: "A token selection component that supports tokens across multiple chains." --- # MultiChainTokenInput The MultiChainTokenInput component provides a token selection interface that allows users to select tokens from different chains. ## Usage ```tsx import { MultiChainTokenInput } from '@avalabs/builderkit'; // Basic usage console.log('Selected token:', token)} showBalances={true} /> ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `selected` | `{ address: string, chain_id: number } & Partial` | - | Currently selected token with chain | | `list` | `TokenItem[]` | - | Array of tokens across all chains | | `onSelectionChanged` | `(token: TokenItem) => void` | - | Called when token selection changes | | `showBalances` | `boolean` | - | Whether to show token balances | | `className` | `string` | - | Additional CSS classes | ## Features - Token selection across multiple chains - Chain selection interface - Displays token with chain icon - Shows token balances (optional) - Searchable token list per chain - Responsive dialog design ## Examples ### Basic Multi-Chain Selection ```tsx ``` ### With Balances ```tsx ``` ### In a Cross-Chain Form ```tsx
t.chain_id !== sourceToken.chain_id)} onSelectionChanged={setDestinationToken} showBalances={true} />
``` ### Custom Styling ```tsx ``` ## Component Structure 1. **Trigger** - TokenChip with chain icon - Chevron down indicator - Click to open dialog 2. **Dialog** - Header with back button - Chain selection row - Search input - Chain-specific token list - Token balances (if enabled) ## Chain Selection The component automatically extracts unique chain IDs from the token list and displays them as selectable options: ```tsx let chains = Array.from(new Set(list.map(t => t.chain_id))); ``` # TokenInput (/docs/builderkit/components/input/token-input) --- title: TokenInput description: "A token selection component with a searchable token list and balance display." --- # TokenInput The TokenInput component provides a token selection interface with a modal dialog containing a searchable list of tokens. ## Usage ```tsx import { TokenInput } from '@avalabs/builderkit'; // Basic usage console.log('Selected token:', token)} showBalances={true} /> ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `selected` | `{ address: string } & Partial` | - | Currently selected token | | `chain_id` | `number` | - | Chain ID for the token list | | `list` | `TokenItem[]` | - | Array of available tokens | | `onSelectionChanged` | `(token: TokenItem) => void` | - | Called when token selection changes | | `showBalances` | `boolean` | - | Whether to show token balances | | `className` | `string` | - | Additional CSS classes | ## Features - Token selection through modal dialog - Displays token icon and symbol - Shows token balances (optional) - Searchable token list - Uses TokenChip for selected token display - Responsive dialog design ## Examples ### Basic Token Selection ```tsx ``` ### With Balances ```tsx ``` ### In a Form ```tsx
t.address !== fromToken.address)} onSelectionChanged={setToToken} showBalances={true} />
``` ### Custom Styling ```tsx ``` ## Component Structure 1. **Trigger** - TokenChip showing selected token - Chevron down indicator - Click to open dialog 2. **Dialog** - Header with back button - Search input - Scrollable token list - Token balances (if enabled) ## Token Item Structure ```tsx type TokenItem = { chain_id: number; address: string; name: string; symbol: string; balance?: BigNumber; } ``` # TokenChip (/docs/builderkit/components/tokens/token-chip) --- title: TokenChip description: "A compact component for displaying token information with optional chain icon and copy functionality." --- # TokenChip The TokenChip component provides a compact way to display token information, including token icon, name, symbol, and optional chain information. ## Usage ```tsx import { TokenChip } from '@avalabs/builderkit'; // Basic usage // With chain icon and copy functionality ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID of the token | | `address` | `string` | - | Token contract address | | `symbol` | `string` | - | Token symbol | | `name` | `string` | - | Token name (optional) | | `showChainIcon` | `boolean` | `false` | Whether to show chain icon alongside token icon | | `showName` | `boolean` | `true` | Whether to show token name (if false, shows only symbol) | | `allowCopyToClipboard` | `boolean` | `false` | Enable copy address to clipboard functionality | | `className` | `string` | - | Additional CSS classes | ## Features - Displays token icon with optional chain icon - Shows token name and/or symbol - Copy to clipboard functionality with visual feedback - Flexible layout options - Tailwind CSS styling support ## Examples ### Basic Token Display ```tsx ``` ### With Chain Icon ```tsx ``` ### Symbol Only ```tsx ``` ### With Copy Functionality ```tsx ``` ### Custom Styling ```tsx ``` ## Visual States 1. **Default**: Shows token information with icon 2. **Copy Button**: Shows copy icon when `allowCopyToClipboard` is true 3. **Copy Confirmation**: Shows check icon briefly after copying 4. **Chain Display**: Shows chain icon when `showChainIcon` is true # TokenIconWithChain (/docs/builderkit/components/tokens/token-icon-with-chain) --- title: TokenIconWithChain description: "A component for displaying token logos with an overlaid chain icon." --- # TokenIconWithChain The TokenIconWithChain component displays a token logo with its corresponding chain icon overlaid in the bottom-right corner. ## Usage ```tsx import { TokenIconWithChain } from '@avalabs/builderkit'; // Basic usage // With custom styling ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID of the token | | `address` | `string` | - | Token contract address | | `className` | `string` | - | Additional CSS classes (applied to both icons) | ## Features - Combines TokenIcon with chain logo - Chain icon is automatically positioned and scaled - Supports custom styling through className - Uses consistent icon paths for both token and chain logos - Responsive layout with Tailwind CSS ## Examples ### Basic Usage ```tsx ``` ### Custom Size ```tsx ``` ### In a Token List ```tsx
``` ### With Custom Border ```tsx ``` ## Asset Requirements The component requires two image assets: 1. Token logo at: ``` /tokens/logo/{chain_id}/{address}.png ``` 2. Chain logo at: ``` /chains/logo/{chain_id}.png ``` For example: ``` /tokens/logo/43114/0x1234567890123456789012345678901234567890.png /chains/logo/43114.png ``` ## Layout Details The component uses the following layout structure: - Main token icon as the primary element - Chain icon positioned at bottom-right - Chain icon scaled to 50% of the token icon size - Chain icon has a white border for visual separation # TokenIcon (/docs/builderkit/components/tokens/token-icon) --- title: TokenIcon description: "A component for displaying token logos." --- # TokenIcon The TokenIcon component displays token logos based on the token's chain ID and contract address. ## Usage ```tsx import { TokenIcon } from '@avalabs/builderkit'; // Basic usage // With custom styling ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID of the token | | `address` | `string` | - | Token contract address | | `className` | `string` | - | Additional CSS classes | ## Features - Displays token logos from a standardized path structure - Supports custom styling through className - Uses common Icon component for consistent display - Follows `/tokens/logo/{chain_id}/{address}.png` path convention ## Examples ### Basic Token Icon ```tsx ``` ### Custom Size ```tsx ``` ### In a List ```tsx
``` ### With Border ```tsx ``` ## Asset Requirements The component expects token logo images to be available at: ``` /tokens/logo/{chain_id}/{address}.png ``` For example: ``` /tokens/logo/43114/0x1234567890123456789012345678901234567890.png ``` # TokenList (/docs/builderkit/components/tokens/token-list) --- title: TokenList description: "A searchable list component for displaying and selecting tokens with optional balance information." --- # TokenList The TokenList component provides a searchable list of tokens with support for balance display and token selection. ## Usage ```tsx import { TokenList } from '@avalabs/builderkit'; // Basic usage console.log('Selected token:', address)} /> // With balances and selected token ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID for the token list | | `list` | `TokenItem[]` | - | Array of tokens to display | | `onClick` | `(address: string) => void` | - | Callback when a token is selected | | `selected` | `{ address: string }` | - | Currently selected token (optional) | | `showBalances` | `boolean` | `false` | Whether to show token balances | | `className` | `string` | - | Additional CSS classes | ## Features - Search by token name, symbol, or contract address - Displays token balances (optional) - Highlights selected token - Supports token whitelisting - Responsive scrollable list - Search input with clear functionality ## Examples ### Basic Token List ```tsx ``` ### With Balances ```tsx ``` ### With Selected Token ```tsx ``` ## Token Item Structure Each token in the list should follow this structure: ```tsx type TokenItem = { chain_id: number; address: string; name: string; symbol: string; balance?: BigNumber; // Optional, used when showBalances is true whitelisted?: boolean; // Optional, for token verification } ``` ## States 1. **Loading**: Shows loading state when fetching balances 2. **Empty Search**: Displays all tokens in the list 3. **Search Results**: Shows filtered tokens based on search input 4. **Selected**: Highlights the currently selected token 5. **Non-whitelisted**: Shows warning for non-whitelisted tokens ## Search Functionality The component supports searching by: - Token name - Token symbol - Exact contract address When searching by contract address: - Must be a valid Ethereum address - Shows token details if found in the list - Can show import option for non-whitelisted tokens # TokenRow (/docs/builderkit/components/tokens/token-row) --- title: TokenRow description: "A component for displaying token information in a row layout with optional balance display." --- # TokenRow The TokenRow component displays token information in a row layout, combining a TokenChip with optional balance information. ## Usage ```tsx import { TokenRow } from '@avalabs/builderkit'; // Basic usage // With balance and click handler handleTokenSelect()} /> ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID of the token | | `address` | `string` | - | Token contract address | | `name` | `string` | - | Token name | | `symbol` | `string` | - | Token symbol | | `balance` | `BigNumber` | - | Token balance (optional) | | `onClick` | `() => void` | - | Click handler (optional) | | `className` | `string` | - | Additional CSS classes | ## Features - Displays token information using TokenChip - Shows token balance with 3 decimal places - Supports click interactions - Flexible styling with Tailwind CSS - Responsive layout with proper alignment ## Examples ### Basic Display ```tsx ``` ### With Balance ```tsx ``` ### Interactive Row ```tsx selectToken("AVAX")} className="hover:bg-gray-100 cursor-pointer" /> ``` ### In a List ```tsx
``` ## Layout Structure The component uses a flex layout with: - Left side: TokenChip (icon, name, and symbol) - Right side (if balance provided): - Token balance (3 decimal places) - USD value (currently hardcoded to $0) - Proper spacing and alignment - Optional hover and click interactions # TransactionButton (/docs/builderkit/components/transaction/transaction-button) --- title: TransactionButton description: "A button component that handles blockchain transaction submission with built-in status tracking and notifications." --- # TransactionButton The TransactionButton component handles individual transaction submission with built-in status tracking and notifications. ## Usage ```tsx import { TransactionButton } from '@avalabs/builderkit'; // Basic usage // With callbacks { console.log('Transaction sent at:', timestamp); }} onTransactionConfirmed={(receipt) => { console.log('Transaction confirmed:', receipt); }} /> ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID for the transaction | | `title` | `string` | - | Transaction title | | `description` | `string` | - | Transaction description | | `data` | `any` | - | Transaction data | | `onTransactionSent` | `(timestamp: number) => void` | - | Called when transaction is sent | | `onTransactionConfirmed` | `(receipt: any) => void` | - | Called when transaction is confirmed | | `className` | `string` | - | Additional CSS classes | ## Features - Automatic wallet connection handling - Network switching support - Transaction status tracking - Toast notifications with explorer links - Loading states and error handling ## Examples ### Basic Transaction ```tsx ``` ### With Custom Styling ```tsx ``` ## Component States 1. **Not Connected** - Shows "Connect Wallet" button - Handles wallet connection 2. **Wrong Network** - Shows "Wrong Network" button - Handles network switching 3. **Ready** - Shows transaction button - Enables transaction submission 4. **Processing** - Shows loading indicator - Tracks transaction status ## Notifications The component provides toast notifications for: - Transaction sent - Transaction confirmed - Transaction failed Each notification includes: - Timestamp - Transaction explorer link - Appropriate styling # TransactionManager (/docs/builderkit/components/transaction/transaction-manager) --- title: TransactionManager description: "A component that orchestrates multiple blockchain transactions in sequence." --- # TransactionManager The TransactionManager component orchestrates multiple blockchain transactions in sequence, handling the flow between steps and providing status tracking. ## Usage ```tsx import { TransactionManager } from '@avalabs/builderkit'; // Basic usage { console.log('Step completed at:', timestamp); }} onTransactionConfirmed={(receipt) => { console.log('All transactions completed:', receipt); }} /> ``` ## Props | Prop | Type | Default | Description | |------|------|---------|-------------| | `chain_id` | `number` | - | Chain ID for the transactions | | `transactions` | `TransactionProps[]` | - | Array of transactions to process | | `onTransactionSent` | `(timestamp: number) => void` | - | Called when a step completes | | `onTransactionConfirmed` | `(receipt: any) => void` | - | Called when all transactions complete | | `className` | `string` | - | Additional CSS classes | ## Features - Sequential transaction execution - Step-by-step progress tracking - Automatic state management - Transaction dependency handling - Consistent error handling - Status notifications for each step ## Examples ### Token Approval and Transfer ```tsx ``` ### Multi-step Protocol Interaction ```tsx ``` ## Transaction Flow 1. **Initialization** - Validates transaction array - Sets up initial state - Prepares first transaction 2. **Step Execution** - Processes current transaction - Waits for confirmation - Updates progress state 3. **Step Transition** - Validates completion - Moves to next transaction - Updates UI state 4. **Completion** - Confirms all steps finished - Triggers completion callback - Resets internal state # Avalanche L1 Configs (/docs/nodes/chain-configs/avalanche-l1s/avalanche-l1-configs) --- title: "Avalanche L1 Configs" description: "This page describes the configuration options available for Avalanche L1s." edit_url: https://github.com/ava-labs/avalanchego/edit/master/subnets/config.md --- # Subnet Configs It is possible to provide parameters for a Subnet. Parameters here apply to all chains in the specified Subnet. AvalancheGo looks for files specified with `{subnetID}.json` under `--subnet-config-dir` as documented [here](https://build.avax.network/docs/nodes/configure/configs-flags#subnet-configs). Here is an example of Subnet config file: ```json { "validatorOnly": false, "consensusParameters": { "k": 25, "alpha": 18 } } ``` ## Parameters ### Private Subnet #### `validatorOnly` (bool) If `true` this node does not expose Subnet blockchain contents to non-validators via P2P messages. Defaults to `false`. Avalanche Subnets are public by default. It means that every node can sync and listen ongoing transactions/blocks in Subnets, even they're not validating the listened Subnet. Subnet validators can choose not to publish contents of blockchains via this configuration. If a node sets `validatorOnly` to true, the node exchanges messages only with this Subnet's validators. Other peers will not be able to learn contents of this Subnet from this node. :::tip This is a node-specific configuration. Every validator of this Subnet has to use this configuration in order to create a full private Subnet. ::: #### `allowedNodes` (string list) If `validatorOnly=true` this allows explicitly specified NodeIDs to be allowed to sync the Subnet regardless of validator status. Defaults to be empty. :::tip This is a node-specific configuration. Every validator of this Subnet has to use this configuration in order to properly allow a node in the private Subnet. ::: ### Consensus Parameters Subnet configs supports loading new consensus parameters. JSON keys are different from their matching `CLI` keys. These parameters must be grouped under `consensusParameters` key. The consensus parameters of a Subnet default to the same values used for the Primary Network, which are given [CLI Snow Parameters](https://build.avax.network/docs/nodes/configure/configs-flags#snow-parameters). | CLI Key | JSON Key | | :------------------------------- | :-------------------- | | --snow-sample-size | k | | --snow-quorum-size | alpha | | --snow-commit-threshold | `beta` | | --snow-concurrent-repolls | concurrentRepolls | | --snow-optimal-processing | `optimalProcessing` | | --snow-max-processing | maxOutstandingItems | | --snow-max-time-processing | maxItemProcessingTime | | --snow-avalanche-batch-size | `batchSize` | | --snow-avalanche-num-parents | `parentSize` | #### `proposerMinBlockDelay` (duration) The minimum delay performed when building snowman++ blocks. Default is set to 1 second. As one of the ways to control network congestion, Snowman++ will only build a block `proposerMinBlockDelay` after the parent block's timestamp. Some high-performance custom VMs may find this too strict. This flag allows tuning the frequency at which blocks are built. ### Gossip Configs It's possible to define different Gossip configurations for each Subnet without changing values for Primary Network. JSON keys of these parameters are different from their matching `CLI` keys. These parameters default to the same values used for the Primary Network. For more information see [CLI Gossip Configs](https://build.avax.network/docs/nodes/configure/configs-flags#gossiping). | CLI Key | JSON Key | | :------------------------------------------------------ | :------------------------------------- | | --consensus-accepted-frontier-gossip-validator-size | gossipAcceptedFrontierValidatorSize | | --consensus-accepted-frontier-gossip-non-validator-size | gossipAcceptedFrontierNonValidatorSize | | --consensus-accepted-frontier-gossip-peer-size | gossipAcceptedFrontierPeerSize | | --consensus-on-accept-gossip-validator-size | gossipOnAcceptValidatorSize | | --consensus-on-accept-gossip-non-validator-size | gossipOnAcceptNonValidatorSize | | --consensus-on-accept-gossip-peer-size | gossipOnAcceptPeerSize | # Subnet-EVM Configs (/docs/nodes/chain-configs/avalanche-l1s/subnet-evm) --- title: "Subnet-EVM Configs" description: "This page describes the configuration options available for the Subnet-EVM." edit_url: https://github.com/ava-labs/subnet-evm/edit/master/plugin/evm/config/config.md --- # Subnet-EVM Configuration > **Note**: These are the configuration options available in the Subnet-EVM codebase. To set these values, you need to create a configuration file at `~/.avalanchego/configs/chains//config.json`. > > For the AvalancheGo node configuration options, see the AvalancheGo Configuration page. This document describes all configuration options available for Subnet-EVM. ## Example Configuration ```json { "eth-apis": ["eth", "eth-filter", "net", "web3"], "pruning-enabled": true, "commit-interval": 4096, "trie-clean-cache": 512, "trie-dirty-cache": 512, "snapshot-cache": 256, "rpc-gas-cap": 50000000, "log-level": "info", "metrics-expensive-enabled": true, "continuous-profiler-dir": "./profiles", "state-sync-enabled": false, "accepted-cache-size": 32 } ``` ## Configuration Format Configuration is provided as a JSON object. All fields are optional unless otherwise specified. ## API Configuration ### Ethereum APIs | Option | Type | Description | Default | |--------|------|-------------|---------| | `eth-apis` | array of strings | List of Ethereum services that should be enabled | `["eth", "eth-filter", "net", "web3", "internal-eth", "internal-blockchain", "internal-transaction"]` | ### Subnet-EVM Specific APIs | Option | Type | Description | Default | |--------|------|-------------|---------| | `validators-api-enabled` | bool | Enable the validators API | `true` | | `admin-api-enabled` | bool | Enable the admin API for administrative operations | `false` | | `admin-api-dir` | string | Directory for admin API operations | - | | `warp-api-enabled` | bool | Enable the Warp API for cross-chain messaging | `false` | ### API Limits and Security | Option | Type | Description | Default | |--------|------|-------------|---------| | `rpc-gas-cap` | uint64 | Maximum gas limit for RPC calls | `50,000,000` | | `rpc-tx-fee-cap` | float64 | Maximum transaction fee cap in AVAX | `100` | | `api-max-duration` | duration | Maximum duration for API calls (0 = no limit) | `0` | | `api-max-blocks-per-request` | int64 | Maximum number of blocks per getLogs request (0 = no limit) | `0` | | `http-body-limit` | uint64 | Maximum size of HTTP request bodies | - | | `batch-request-limit` | uint64 | Maximum number of requests that can be batched in an RPC call. For no limit, set either this or `batch-response-max-size` to 0 | `1000` | | `batch-response-max-size` | uint64 | Maximum size (in bytes) of response that can be returned from a batched RPC call. For no limit, set either this or `batch-request-limit` to 0. Defaults to `25 MB`| `1000` | ### WebSocket Settings | Option | Type | Description | Default | |--------|------|-------------|---------| | `ws-cpu-refill-rate` | duration | Rate at which WebSocket CPU usage quota is refilled (0 = no limit) | `0` | | `ws-cpu-max-stored` | duration | Maximum stored WebSocket CPU usage quota (0 = no limit) | `0` | ## Cache Configuration ### Trie Caches | Option | Type | Description | Default | |--------|------|-------------|---------| | `trie-clean-cache` | int | Size of the trie clean cache in MB | `512` | | `trie-dirty-cache` | int | Size of the trie dirty cache in MB | `512` | | `trie-dirty-commit-target` | int | Memory limit to target in the dirty cache before performing a commit in MB | `20` | | `trie-prefetcher-parallelism` | int | Maximum concurrent disk reads trie prefetcher should perform | `16` | ### Other Caches | Option | Type | Description | Default | |--------|------|-------------|---------| | `snapshot-cache` | int | Size of the snapshot disk layer clean cache in MB | `256` | | `accepted-cache-size` | int | Depth to keep in the accepted headers and logs cache (blocks) | `32` | | `state-sync-server-trie-cache` | int | Trie cache size for state sync server in MB | `64` | ## Ethereum Settings ### Transaction Processing | Option | Type | Description | Default | |--------|------|-------------|---------| | `preimages-enabled` | bool | Enable preimage recording | `false` | | `allow-unfinalized-queries` | bool | Allow queries for unfinalized blocks | `false` | | `allow-unprotected-txs` | bool | Allow unprotected transactions (without EIP-155) | `false` | | `allow-unprotected-tx-hashes` | array | List of specific transaction hashes allowed to be unprotected | EIP-1820 registry tx | | `local-txs-enabled` | bool | Enable treatment of transactions from local accounts as local | `false` | ### Snapshots | Option | Type | Description | Default | |--------|------|-------------|---------| | `snapshot-wait` | bool | Wait for snapshot generation on startup | `false` | | `snapshot-verification-enabled` | bool | Enable snapshot verification | `false` | ## Pruning and State Management ### Basic Pruning | Option | Type | Description | Default | |--------|------|-------------|---------| | `pruning-enabled` | bool | Enable state pruning to save disk space | `true` | | `commit-interval` | uint64 | Interval at which to persist EVM and atomic tries (blocks) | `4096` | | `accepted-queue-limit` | int | Maximum blocks to queue before blocking during acceptance | `64` | ### State Reconstruction | Option | Type | Description | Default | |--------|------|-------------|---------| | `allow-missing-tries` | bool | Suppress warnings about incomplete trie index | `false` | | `populate-missing-tries` | uint64 | Starting block for re-populating missing tries (null = disabled) | `null` | | `populate-missing-tries-parallelism` | int | Concurrent readers for re-populating missing tries | `1024` | ### Offline Pruning | Option | Type | Description | Default | |--------|------|-------------|---------| | `offline-pruning-enabled` | bool | Enable offline pruning | `false` | | `offline-pruning-bloom-filter-size` | uint64 | Bloom filter size for offline pruning in MB | `512` | | `offline-pruning-data-directory` | string | Directory for offline pruning data | - | ### Historical Data | Option | Type | Description | Default | |--------|------|-------------|---------| | `historical-proof-query-window` | uint64 | Number of blocks before last accepted for proof queries (archive mode only, ~24 hours) | `43200` | | `state-history` | uint64 | Number of most recent states that are accesible on disk (pruning mode only) | `32` | ## Transaction Pool Configuration | Option | Type | Description | Default | |--------|------|-------------|---------| | `tx-pool-price-limit` | uint64 | Minimum gas price for transaction acceptance | - | | `tx-pool-price-bump` | uint64 | Minimum price bump percentage for transaction replacement | - | | `tx-pool-account-slots` | uint64 | Maximum number of executable transaction slots per account | - | | `tx-pool-global-slots` | uint64 | Maximum number of executable transaction slots for all accounts | - | | `tx-pool-account-queue` | uint64 | Maximum number of non-executable transaction slots per account | - | | `tx-pool-global-queue` | uint64 | Maximum number of non-executable transaction slots for all accounts | - | | `tx-pool-lifetime` | duration | Maximum time transactions can stay in the pool | - | ## Gossip Configuration ### Push Gossip Settings | Option | Type | Description | Default | |--------|------|-------------|---------| | `push-gossip-percent-stake` | float64 | Percentage of total stake to push gossip to (range: [0, 1]) | `0.9` | | `push-gossip-num-validators` | int | Number of validators to push gossip to | `100` | | `push-gossip-num-peers` | int | Number of non-validator peers to push gossip to | `0` | ### Regossip Settings | Option | Type | Description | Default | |--------|------|-------------|---------| | `push-regossip-num-validators` | int | Number of validators to regossip to | `10` | | `push-regossip-num-peers` | int | Number of non-validator peers to regossip to | `0` | | `priority-regossip-addresses` | array | Addresses to prioritize for regossip | - | ### Timing Configuration | Option | Type | Description | Default | |--------|------|-------------|---------| | `push-gossip-frequency` | duration | Frequency of push gossip | `100ms` | | `pull-gossip-frequency` | duration | Frequency of pull gossip | `1s` | | `regossip-frequency` | duration | Frequency of regossip | `30s` | ## Logging and Monitoring ### Logging | Option | Type | Description | Default | |--------|------|-------------|---------| | `log-level` | string | Logging level (trace, debug, info, warn, error, crit) | `"info"` | | `log-json-format` | bool | Use JSON format for logs | `false` | ### Profiling | Option | Type | Description | Default | |--------|------|-------------|---------| | `continuous-profiler-dir` | string | Directory for continuous profiler output (empty = disabled) | - | | `continuous-profiler-frequency` | duration | Frequency to run continuous profiler | `15m` | | `continuous-profiler-max-files` | int | Maximum number of profiler files to maintain | `5` | ### Metrics | Option | Type | Description | Default | |--------|------|-------------|---------| | `metrics-expensive-enabled` | bool | Enable expensive debug-level metrics; this includes Firewood metrics | `true` | ## Security and Access ### Keystore | Option | Type | Description | Default | |--------|------|-------------|---------| | `keystore-directory` | string | Directory for keystore files (absolute or relative path) | - | | `keystore-external-signer` | string | External signer configuration | - | | `keystore-insecure-unlock-allowed` | bool | Allow insecure account unlocking | `false` | ### Fee Configuration | Option | Type | Description | Default | |--------|------|-------------|---------| | `feeRecipient` | string | Address to send transaction fees to (leave empty if not supported) | - | ## Network and Sync ### Network | Option | Type | Description | Default | |--------|------|-------------|---------| | `max-outbound-active-requests` | int64 | Maximum number of outbound active requests for VM2VM network | `16` | ### State Sync | Option | Type | Description | Default | |--------|------|-------------|---------| | `state-sync-enabled` | bool | Enable state sync | `false` | | `state-sync-skip-resume` | bool | Force state sync to use highest available summary block | `false` | | `state-sync-ids` | string | Comma-separated list of state sync IDs | - | | `state-sync-commit-interval` | uint64 | Commit interval for state sync (blocks) | `16384` | | `state-sync-min-blocks` | uint64 | Minimum blocks ahead required for state sync | `300000` | | `state-sync-request-size` | uint16 | Number of key/values to request per state sync request | `1024` | ## Database Configuration > **WARNING**: `firewood` and `path` schemes are untested in production. Using `path` is strongly discouraged. To use `firewood`, you must also set the following config options: > > - `pruning-enabled: true` (enabled by default) > - `state-sync-enabled: false` > - `snapshot-cache: 0` Failing to set these options will result in errors on VM initialization. Additionally, not all APIs are available - see these portions of the config documentation for more details. | Option | Type | Description | Default | |--------|------|-------------|---------| | `database-type` | string | Type of database to use | `"pebbledb"` | | `database-path` | string | Path to database directory | - | | `database-read-only` | bool | Open database in read-only mode | `false` | | `database-config` | string | Inline database configuration | - | | `database-config-file` | string | Path to database configuration file | - | | `use-standalone-database` | bool | Use standalone database instead of shared one | - | | `inspect-database` | bool | Inspect database on startup | `false` | | `state-scheme` | string | EXPERIMENTAL: specifies the database scheme to store state data; can be one of `hash` or `firewood` | `hash` | ## Transaction Indexing | Option | Type | Description | Default | |--------|------|-------------|---------| | `transaction-history` | uint64 | Maximum number of blocks from head whose transaction indices are reserved (0 = no limit) | - | | `tx-lookup-limit` | uint64 | **Deprecated** - use `transaction-history` instead | - | | `skip-tx-indexing` | bool | Skip indexing transactions entirely | `false` | ## Warp Configuration | Option | Type | Description | Default | |--------|------|-------------|---------| | `warp-off-chain-messages` | array | Off-chain messages the node should be willing to sign | - | | `prune-warp-db-enabled` | bool | Clear warp database on startup | `false` | ## Miscellaneous | Option | Type | Description | Default | |--------|------|-------------|---------| | `airdrop` | string | Path to airdrop file | - | | `skip-upgrade-check` | bool | Skip checking that upgrades occur before last accepted block ⚠️ **Warning**: Only use when you understand the implications | `false` | | `min-delay-target` | integer | The minimum delay between blocks (in milliseconds) that this node will attempt to use when creating blocks | Parent block's target | ## Gossip Constants The following constants are defined for transaction gossip behavior and cannot be configured without a custom build of Subnet-EVM: | Constant | Type | Description | Value | |----------|------|-------------|-------| | Bloom Filter Min Target Elements | int | Minimum target elements for bloom filter | `8,192` | | Bloom Filter Target False Positive Rate | float | Target false positive rate | `1%` | | Bloom Filter Reset False Positive Rate | float | Reset false positive rate | `5%` | | Bloom Filter Churn Multiplier | int | Churn multiplier | `3` | | Push Gossip Discarded Elements | int | Number of discarded elements | `16,384` | | Tx Gossip Target Message Size | size | Target message size for transaction gossip | `20 KiB` | | Tx Gossip Throttling Period | duration | Throttling period | `10s` | | Tx Gossip Throttling Limit | int | Throttling limit | `2` | | Tx Gossip Poll Size | int | Poll size | `1` | ## Validation Notes - Cannot enable `populate-missing-tries` while pruning or offline pruning is enabled - Cannot run offline pruning while pruning is disabled - Commit interval must be non-zero when pruning is enabled - `push-gossip-percent-stake` must be in range `[0, 1]` - Some settings may require node restart to take effect # C-Chain Configs (/docs/nodes/chain-configs/primary-network/c-chain) --- title: "C-Chain Configs" description: "This page describes the configuration options available for the C-Chain." edit_url: https://github.com/ava-labs/coreth/edit/master/plugin/evm/config/config.md --- {/* markdownlint-disable MD041 MD033 */} > **Note**: These are the configuration options available in the coreth codebase. To set these values, you need to create a configuration file at `{chain-config-dir}/C/config.json`. This file does not exist by default. > > For example if `chain-config-dir` has the default value which is `$HOME/.avalanchego/configs/chains`, then `config.json` should be placed at `$HOME/.avalanchego/configs/chains/C/config.json`. > > For the AvalancheGo node configuration options, see the AvalancheGo Configuration page. This document describes all configuration options available for coreth. The C-Chain config is printed out in the log when a node starts. Default values for each config flag are specified below. Default values are overridden only if specified in the given config file. It is recommended to only provide values which are different from the default, as that makes the config more resilient to future default changes. Otherwise, if defaults change, your node will remain with the old values, which might adversely affect your node operation. ## Example Configuration ```json { "eth-apis": ["eth", "eth-filter", "net", "web3"], "pruning-enabled": true, "commit-interval": 4096, "trie-clean-cache": 512, "trie-dirty-cache": 512, "snapshot-cache": 256, "rpc-gas-cap": 50000000, "log-level": "info", "metrics-expensive-enabled": true, "continuous-profiler-dir": "./profiles", "state-sync-enabled": false, "accepted-cache-size": 32 } ``` ## Configuration Format Configuration is provided as a JSON object. All fields are optional unless otherwise specified. ## API Configuration ### Ethereum APIs | Option | Type | Description | Default | |--------|------|-------------|---------| | `eth-apis` | array of strings | List of Ethereum services that should be enabled | `["eth", "eth-filter", "net", "web3", "internal-eth", "internal-blockchain", "internal-transaction"]` | | `eth` | bool | Adds the `eth_coinbase` and `eth_etherbase` RPC calls to the `eth_*` namespace. | `true` | | `eth-filter` | bool | Enables the public filter API for the `eth_*` namespace and adds the following RPC calls (see [Ethereum JSON-RPC API documentation](https://eth.wiki/json-rpc/API) for complete documentation):
- `eth_newPendingTransactionFilter`
- `eth_newPendingTransactions`
- `eth_newAcceptedTransactions`
- `eth_newBlockFilter`
- `eth_newHeads`
- `eth_logs`
- `eth_newFilter`
- `eth_getLogs`
- `eth_uninstallFilter`
- `eth_getFilterLogs`
- `eth_getFilterChanges`
| `true` | | `admin` | bool | Adds the `admin_importChain` and `admin_exportChain` RPC calls to the `admin_*` namespace | `false` | | `debug` | bool | Adds the following RPC calls to the `debug_*` namespace.
- `debug_dumpBlock`
- `debug_accountRange`
- `debug_preimage`
- `debug_getBadBlocks`
- `debug_storageRangeAt`
- `debug_getModifiedAccountsByNumber`
- `debug_getModifiedAccountsByHash`
- `debug_getAccessibleState`
The following RPC calls are disabled for any nodes with `state-scheme = firewood`:
- `debug_storageRangeAt`
- `debug_getModifiedAccountsByNumber`
- `debug_getModifiedAccountsByHash`
| `false` | | `net` | bool | Adds the following RPC calls to the `net_*` namespace.
- `net_listening`
- `net_peerCount`
- `net_version`
Note: Coreth is a virtual machine and does not have direct access to the networking layer, so `net_listening` always returns true and `net_peerCount` always returns 0. For accurate metrics on the network layer, users should use the AvalancheGo APIs. | `true` | | `debug-tracer` | bool | Adds the following RPC calls to the `debug_*` namespace.
- `debug_traceChain`
- `debug_traceBlockByNumber`
- `debug_traceBlockByHash`
- `debug_traceBlock`
- `debug_traceBadBlock`
- `debug_intermediateRoots`
- `debug_traceTransaction`
- `debug_traceCall` | `false` | | `web3` | bool | Adds the `web3_clientVersion` and `web3_sha3` RPC calls to the `web3_*` namespace | `true` | | `internal-eth` | bool | Adds the following RPC calls to the `eth_*` namespace.
- `eth_gasPrice`
- `eth_baseFee`
- `eth_maxPriorityFeePerGas`
- `eth_feeHistory` | `true` | | `internal-blockchain` | bool | Adds the following RPC calls to the `eth_*` namespace.
- `eth_chainId`
- `eth_blockNumber`
- `eth_getBalance`
- `eth_getProof`
- `eth_getHeaderByNumber`
- `eth_getHeaderByHash`
- `eth_getBlockByNumber`
- `eth_getBlockByHash`
- `eth_getUncleBlockByNumberAndIndex`
- `eth_getUncleBlockByBlockHashAndIndex`
- `eth_getUncleCountByBlockNumber`
- `eth_getUncleCountByBlockHash`
- `eth_getCode`
- `eth_getStorageAt`
- `eth_call`
- `eth_estimateGas`
- `eth_createAccessList`
`eth_getProof` is disabled for any node with `state-scheme = firewood` | `true` | | `internal-transaction` | bool | Adds the following RPC calls to the `eth_*` namespace.
- `eth_getBlockTransactionCountByNumber`
- `eth_getBlockTransactionCountByHash`
- `eth_getTransactionByBlockNumberAndIndex`
- `eth_getTransactionByBlockHashAndIndex`
- `eth_getRawTransactionByBlockNumberAndIndex`
- `eth_getRawTransactionByBlockHashAndIndex`
- `eth_getTransactionCount`
- `eth_getTransactionByHash`
- `eth_getRawTransactionByHash`
- `eth_getTransactionReceipt`
- `eth_sendTransaction`
- `eth_fillTransaction`
- `eth_sendRawTransaction`
- `eth_sign`
- `eth_signTransaction`
- `eth_pendingTransactions`
- `eth_resend` | `true` | | `internal-tx-pool` | bool | Adds the following RPC calls to the `txpool_*` namespace.
- `txpool_content`
- `txpool_contentFrom`
- `txpool_status`
- `txpool_inspect` | `false` | | `internal-debug` | bool | Adds the following RPC calls to the `debug_*` namespace.
- `debug_getHeaderRlp`
- `debug_getBlockRlp`
- `debug_printBlock`
- `debug_chaindbProperty`
- `debug_chaindbCompact` | `false` | | `debug-handler` | bool | Adds the following RPC calls to the `debug_*` namespace.
- `debug_verbosity`
- `debug_vmodule`
- `debug_backtraceAt`
- `debug_memStats`
- `debug_gcStats`
- `debug_blockProfile`
- `debug_setBlockProfileRate`
- `debug_writeBlockProfile`
- `debug_mutexProfile`
- `debug_setMutexProfileFraction`
- `debug_writeMutexProfile`
- `debug_writeMemProfile`
- `debug_stacks`
- `debug_freeOSMemory`
- `debug_setGCPercent` | `false` | | `internal-account` | bool | Adds the `eth_accounts` RPC call to the `eth_*` namespace | `true` | | `internal-personal` | bool | Adds the following RPC calls to the `personal_*` namespace.
- `personal_listAccounts`
- `personal_listWallets`
- `personal_openWallet`
- `personal_deriveAccount`
- `personal_newAccount`
- `personal_importRawKey`
- `personal_unlockAccount`
- `personal_lockAccount`
- `personal_sendTransaction`
- `personal_signTransaction`
- `personal_sign`
- `personal_ecRecover`
- `personal_signAndSendTransaction`
- `personal_initializeWallet`
- `personal_unpair` | `false` | ### Enabling Avalanche Specific APIs | Option | Type | Description | Default | |--------|------|-------------|---------| | `admin-api-enabled` | bool | Enables the Admin API | `false` | | `admin-api-dir` | string | Specifies the directory for the Admin API to use to store CPU/Mem/Lock Profiles | `""` | | `warp-api-enabled` | bool | Enable the Warp API for cross-chain messaging | `false` | ### API Limits and Security | Option | Type | Description | Default | |--------|------|-------------|---------| | `rpc-gas-cap` | uint64 | Maximum gas limit for RPC calls | `50,000,000` | | `rpc-tx-fee-cap` | float64 | Maximum transaction fee cap in AVAX | `100` | | `api-max-duration` | duration | Maximum duration for API calls (0 = no limit) | `0` | | `api-max-blocks-per-request` | int64 | Maximum number of blocks per getLogs request (0 = no limit) | `0` | | `http-body-limit` | uint64 | Maximum size of HTTP request bodies (0 = no limit) | `0` | | `batch-request-limit` | uint64 | Maximum number of requests that can be batched in an RPC call. For no limit, set either this or `batch-response-max-size` to 0 | `1000` | | `batch-response-max-size` | uint64 | Maximum size (in bytes) of response that can be returned from a batched RPC call. For no limit, set either this or `batch-request-limit` to 0. Defaults to `25 MB`| `1000` | ### WebSocket Settings | Option | Type | Description | Default | |--------|------|-------------|---------| | `ws-cpu-refill-rate` | duration | Rate at which WebSocket CPU usage quota is refilled (0 = no limit) | `0` | | `ws-cpu-max-stored` | duration | Maximum stored WebSocket CPU usage quota (0 = no limit) | `0` | ## Cache Configuration ### Trie Caches | Option | Type | Description | Default | |--------|------|-------------|---------| | `trie-clean-cache` | int | Size of the trie clean cache in MB | `512` | | `trie-dirty-cache` | int | Size of the trie dirty cache in MB | `512` | | `trie-dirty-commit-target` | int | Memory limit to target in the dirty cache before performing a commit in MB | `20` | | `trie-prefetcher-parallelism` | int | Maximum concurrent disk reads trie prefetcher should perform | `16` | ### Other Caches | Option | Type | Description | Default | |--------|------|-------------|---------| | `snapshot-cache` | int | Size of the snapshot disk layer clean cache in MB | `256` | | `accepted-cache-size` | int | Depth to keep in the accepted headers and logs cache (blocks) | `32` | | `state-sync-server-trie-cache` | int | Trie cache size for state sync server in MB | `64` | ## Ethereum Settings ### Transaction Processing > **⚠️ WARNING: `allow-unfinalized-queries` should likely be set to `false` in production.** Enabling this flag can result in a confusing/unreliable user experience. Enabling this flag should only be done when users are expected to have knowledge of how Snow* consensus finalizes blocks. > Unlike chains with reorgs and forks that require block confirmations, Avalanche **does not** increase the confidence that a block will be finalized based on the depth of the chain. Waiting for additional blocks **does not** confirm finalization. Enabling this flag removes the guarantee that the node only exposes finalized blocks; requiring users to guess if a block is finalized. | Option | Type | Description | Default | |--------|------|-------------|---------| | `preimages-enabled` | bool | Enable preimage recording | `false` | | `allow-unfinalized-queries` | bool | Allow queries for unfinalized blocks | `false` | | `allow-unprotected-txs` | bool | Allow unprotected transactions (without EIP-155) | `false` | | `allow-unprotected-tx-hashes` | \[\]TxHash | Specifies an array of transaction hashes that should be allowed to bypass replay protection. This flag is intended for node operators that want to explicitly allow specific transactions to be issued through their API. | an empty list | | `local-txs-enabled` | bool | Enable treatment of transactions from local accounts as local | `false` | ### Snapshots | Option | Type | Description | Default | |--------|------|-------------|---------| | `snapshot-wait` | bool | Wait for snapshot generation on startup | `false` | | `snapshot-verification-enabled` | bool | Enable snapshot verification | `false` | ## Pruning and State Management > **Note**: If a node is ever run with `pruning-enabled` as `false` (archival mode), setting `pruning-enabled` to `true` will result in a warning and the node will shut down. This is to protect against unintentional misconfigurations of an archival node. To override this and switch to pruning mode, in addition to `pruning-enabled: true`, `allow-missing-tries` should be set to `true` as well. ### Basic Pruning | Option | Type | Description | Default | |--------|------|-------------|---------| | `pruning-enabled` | bool | Enable state pruning to save disk space | `true` | | `commit-interval` | uint64 | Interval at which to persist EVM and atomic tries (blocks) | `4096` | | `accepted-queue-limit` | int | Maximum blocks to queue before blocking during acceptance | `64` | ### State Reconstruction | Option | Type | Description | Default | |--------|------|-------------|---------| | `allow-missing-tries` | bool | Suppress warnings about incomplete trie index | `false` | | `populate-missing-tries` | uint64 | Starting block for re-populating missing tries (null = disabled) | `null` | | `populate-missing-tries-parallelism` | int | Concurrent readers for re-populating missing tries | `1024` | ### Offline Pruning > **Note**: If offline pruning is enabled it will run on startup and block until it completes (approximately one hour on Mainnet). This will reduce the size of the database by deleting old trie nodes. **While performing offline pruning, your node will not be able to process blocks and will be considered offline.** While ongoing, the pruning process consumes a small amount of additional disk space (for deletion markers and the bloom filter). For more information see the [disk space considerations documentation](https://build.avax.network/docs/nodes/maintain/reduce-disk-usage#disk-space-considerations). Since offline pruning deletes old state data, this should not be run on nodes that need to support archival API requests. This is meant to be run manually, so after running with this flag once, it must be toggled back to false before running the node again. Therefore, you should run with this flag set to true and then set it to false on the subsequent run. | Option | Type | Description | Default | |--------|------|-------------|---------| | `offline-pruning-enabled` | bool | Enable offline pruning | `false` | | `offline-pruning-bloom-filter-size` | uint64 | Bloom filter size for offline pruning in MB | `512` | | `offline-pruning-data-directory` | string | Directory for offline pruning data | - | ### Historical Data | Option | Type | Description | Default | |--------|------|-------------|---------| | `historical-proof-query-window` | uint64 | Number of blocks before last accepted for proof queries (archive mode only, ~24 hours) | `43200` | | `state-history` | uint64 | Number of most recent states that are accesible on disk (pruning mode only) | `32` | ## Transaction Pool Configuration | Option | Type | Description | Default | |--------|------|-------------|---------| | `tx-pool-price-limit` | uint64 | Minimum gas price for transaction acceptance | `1` | | `tx-pool-price-bump` | uint64 | Minimum price bump percentage for transaction replacement | `10%` | | `tx-pool-account-slots` | uint64 | Maximum number of executable transaction slots per account | `16` | | `tx-pool-global-slots` | uint64 | Maximum number of executable transaction slots for all accounts | `5120` | | `tx-pool-account-queue` | uint64 | Maximum number of non-executable transaction slots per account | `64` | | `tx-pool-global-queue` | uint64 | Maximum number of non-executable transaction slots for all accounts | `1024` | | `tx-pool-lifetime` | duration | Maximum duration in nanoseconds a non-executable transaction will be allowed in the poll | `600000000000` (10 minutes) | | `price-options-slow-fee-percentage` | integer | Percentage to apply for slow fee estimation | `95` | | `price-options-fast-fee-percentage` | integer | Percentage to apply for fast fee estimation | `105` | | `price-options-max-tip` | integer | Maximum tip in wei for fee estimation | `20000000000` (20 Gwei) | ### Push Gossip Settings | Option | Type | Description | Default | |--------|------|-------------|---------| | `push-gossip-percent-stake` | float64 | Percentage of total stake to push gossip to (range: [0, 1]) | `0.9` | | `push-gossip-num-validators` | int | Number of validators to push gossip to | `100` | | `push-gossip-num-peers` | int | Number of non-validator peers to push gossip to | `0` | ### Regossip Settings | Option | Type | Description | Default | |--------|------|-------------|---------| | `push-regossip-num-validators` | int | Number of validators to regossip to | `10` | | `push-regossip-num-peers` | int | Number of non-validator peers to regossip to | `0` | ### Timing Configuration | Option | Type | Description | Default | |--------|------|-------------|---------| | `push-gossip-frequency` | duration | Frequency of push gossip | `100ms` | | `pull-gossip-frequency` | duration | Frequency of pull gossip | `1s` | | `regossip-frequency` | duration | Frequency of regossip | `30s` | ## Logging and Monitoring ### Logging | Option | Type | Description | Default | |--------|------|-------------|---------| | `log-level` | string | Logging level (trace, debug, info, warn, error, crit) | `"info"` | | `log-json-format` | bool | Use JSON format for logs | `false` | ### Profiling | Option | Type | Description | Default | |--------|------|-------------|---------| | `continuous-profiler-dir` | string | Directory for continuous profiler output (empty = disabled) | `""` | | `continuous-profiler-frequency` | duration | Frequency to run continuous profiler | `15m` | | `continuous-profiler-max-files` | int | Maximum number of profiler files to maintain | `5` | ### Metrics | Option | Type | Description | Default | |--------|------|-------------|---------| | `metrics-expensive-enabled` | bool | Enable expensive debug-level metrics; this includes Firewood metrics | `true` | ## Security and Access ### Keystore | Option | Type | Description | Default | |--------|------|-------------|---------| | `keystore-directory` | string | Directory for keystore files (absolute or relative path); if empty, uses a temporary directory at `coreth-keystore` | `""` | | `keystore-external-signer` | string | Specifies an external URI for a clef-type signer | `""` | | `keystore-insecure-unlock-allowed` | bool | Allow insecure account unlocking | `false` | ## Network and Sync ### Network | Option | Type | Description | Default | |--------|------|-------------|---------| | `max-outbound-active-requests` | int64 | Maximum number of outbound active requests for VM2VM network | `16` | ### State Sync > **Note:** If state-sync is enabled, the peer will download chain state from peers up to a recent block near tip, then proceed with normal bootstrapping. Please note that if you need historical data, state sync isn't the right option. However, it is sufficient if you are just running a validator. | Option | Type | Description | Default | |--------|------|-------------|---------| | `state-sync-enabled` | bool | Enable state sync | `false` | | `state-sync-skip-resume` | bool | Force state sync to use highest available summary block | `false` | | `state-sync-ids` | string | Comma-separated list of state sync IDs; If not specified (or empty), peers are selected at random.| `""`| | `state-sync-commit-interval` | uint64 | Commit interval for state sync (blocks) | `16384` | | `state-sync-min-blocks` | uint64 | Minimum blocks ahead required for state sync | `300000` | | `state-sync-request-size` | uint16 | Number of key/values to request per state sync request | `1024` | ## Database Configuration > **WARNING**: `firewood` and `path` schemes are untested in production. Using `path` is strongly discouraged. To use `firewood`, you must also set the following config options: > > - `populate-missing-tries: nil` > - `state-sync-enabled: false` > - `snapshot-cache: 0` Failing to set these options will result in errors on VM initialization. Additionally, not all APIs are available - see these portions of the config documentation for more details. | Option | Type | Description | Default | |--------|------|-------------|---------| | `inspect-database` | bool | Inspect database on startup | `false` | | `state-scheme` | string | EXPERIMENTAL: specifies the database scheme to store state data; can be one of `hash`, `firewood`, or `path` | `hash` | ## Transaction Indexing | Option | Type | Description | Default | |--------|------|-------------|---------| | `transaction-history` | uint64 | Maximum number of blocks from head whose transaction indices are reserved (0 = no limit) | `0` | | `skip-tx-indexing` | bool | Skip indexing transactions entirely | `false` | ## Warp Configuration | Option | Type | Description | Default | |--------|------|-------------|---------| | `warp-off-chain-messages` | array | Off-chain messages the node should be willing to sign | empty array | | `prune-warp-db-enabled` | bool | Clear warp database on startup | `false` | ## Miscellaneous > **Note:** If `skip-upgrade-check` is set to `true`, the chain will skip verifying that all expected network upgrades have taken place before the last accepted block on startup. This allows node operators to recover if their node has accepted blocks after a network upgrade with a version of the code prior to the upgrade. | Option | Type | Description | Default | |--------|------|-------------|---------| | `acceptor-queue-limit` | integer | Specifies the maximum number of blocks to queue during block acceptance before blocking on Accept. | `64` | | `gas-target` | integer | The target gas per second that this node will attempt to use when creating blocks | Parent block's target | | `min-delay-target` | integer | The minimum delay between blocks (in milliseconds) that this node will attempt to use when creating blocks | Parent block's target | | `skip-upgrade-check` | bool | Skip checking that upgrades occur before last accepted block ⚠️ **Warning**: Only use when you understand the implications | `false` | # P-Chain Configs (/docs/nodes/chain-configs/primary-network/p-chain) --- title: "P-Chain Configs" description: "This page describes the configuration options available for the P-Chain." edit_url: https://github.com/ava-labs/avalanchego/edit/master/vms/platformvm/config/config.md --- This document provides details about the configuration options available for the PlatformVM. ## Standard Configurations In order to specify a configuration for the PlatformVM, you need to define a `Config` struct and its parameters. The default values for these parameters are: | Option | Type | Default | | ------------------------------------ | --------------- | ------------------ | | `network` | `Network` | `DefaultNetwork` | | `block-cache-size` | `int` | `64 * units.MiB` | | `tx-cache-size` | `int` | `128 * units.MiB` | | `transformed-subnet-tx-cache-size` | `int` | `4 * units.MiB` | | `reward-utxos-cache-size` | `int` | `2048` | | `chain-cache-size` | `int` | `2048` | | `chain-db-cache-size` | `int` | `2048` | | `block-id-cache-size` | `int` | `8192` | | `fx-owner-cache-size` | `int` | `4 * units.MiB` | | `subnet-to-l1-conversion-cache-size` | `int` | `4 * units.MiB` | | `l1-weights-cache-size` | `int` | `16 * units.KiB` | | `l1-inactive-validators-cache-size` | `int` | `256 * units.KiB` | | `l1-subnet-id-node-id-cache-size` | `int` | `16 * units.KiB` | | `checksums-enabled` | `bool` | `false` | | `mempool-prune-frequency` | `time.Duration` | `30 * time.Minute` | | `mempool-gas-capacity` | `gas.Gas` | `1_000_000` | Default values are overridden only if explicitly specified in the config. ## Network Configuration The Network configuration defines parameters that control the network's gossip and validator behavior. ### Parameters | Field | Type | Default | Description | |-------|------|---------|-------------| | `max-validator-set-staleness` | `time.Duration` | `1 minute` | Maximum age of a validator set used for peer sampling and rate limiting | | `target-gossip-size` | `int` | `20 * units.KiB` | Target number of bytes to send when pushing transactions or responding to transaction pull requests | | `push-gossip-percent-stake` | `float64` | `0.9` | Percentage of total stake to target in the initial gossip round. Higher stake nodes are prioritized to minimize network messages | | `push-gossip-num-validators` | `int` | `100` | Number of validators to push transactions to in the initial gossip round | | `push-gossip-num-peers` | `int` | `0` | Number of peers to push transactions to in the initial gossip round | | `push-regossip-num-validators` | `int` | `10` | Number of validators for subsequent gossip rounds after the initial push | | `push-regossip-num-peers` | `int` | `0` | Number of peers for subsequent gossip rounds after the initial push | | `push-gossip-discarded-cache-size` | `int` | `16384` | Size of the cache storing recently dropped transaction IDs from mempool to avoid re-pushing | | `push-gossip-max-regossip-frequency` | `time.Duration` | `30 * time.Second` | Maximum frequency limit for re-gossiping a transaction | | `push-gossip-frequency` | `time.Duration` | `500 * time.Millisecond` | Frequency of push gossip rounds | | `pull-gossip-poll-size` | `int` | `1` | Number of validators to sample during pull gossip rounds | | `pull-gossip-frequency` | `time.Duration` | `1500 * time.Millisecond` | Frequency of pull gossip rounds | | `pull-gossip-throttling-period` | `time.Duration` | `10 * time.Second` | Time window for throttling pull requests | | `pull-gossip-throttling-limit` | `int` | `2` | Maximum number of pull queries allowed per validator within the throttling window | | `expected-bloom-filter-elements` | `int` | `8 * 1024` | Expected number of elements when creating a new bloom filter. Larger values increase filter size | | `expected-bloom-filter-false-positive-probability` | `float64` | `0.01` | Target probability of false positives after inserting the expected number of elements. Lower values increase filter size | | `max-bloom-filter-false-positive-probability` | `float64` | `0.05` | Threshold for bloom filter regeneration. Filter is refreshed when false positive probability exceeds this value | ### Details The configuration is divided into several key areas: - **Validator Set Management**: Controls how fresh the validator set must be for network operations. The staleness setting ensures the network operates with reasonably current validator information. - **Gossip Size Controls**: Manages the size of gossip messages to maintain efficient network usage while ensuring reliable transaction propagation. - **Push Gossip Configuration**: Defines how transactions are initially propagated through the network, with emphasis on reaching high-stake validators first to optimize network coverage. - **Pull Gossip Configuration**: Controls how nodes request transactions they may have missed, including throttling mechanisms to prevent network overload. - **Bloom Filter Settings**: Configures the trade-off between memory usage and false positive rates in transaction filtering, with automatic filter regeneration when accuracy degrades. # X-Chain Configs (/docs/nodes/chain-configs/primary-network/x-chain) --- title: "X-Chain Configs" description: "This page describes the configuration options available for the X-Chain." edit_url: https://github.com/ava-labs/avalanchego/edit/master/vms/avm/config.md --- In order to specify a config for the X-Chain, a JSON config file should be placed at `{chain-config-dir}/X/config.json`. For example if `chain-config-dir` has the default value which is `$HOME/.avalanchego/configs/chains`, then `config.json` can be placed at `$HOME/.avalanchego/configs/chains/X/config.json`. This allows you to specify a config to be passed into the X-Chain. The default values for this config are: ```json { "checksums-enabled": false } ``` Default values are overridden only if explicitly specified in the config. The parameters are as follows: ### `checksums-enabled` _Boolean_ Enables checksums if set to `true`. # Amazon Web Services (/docs/nodes/run-a-node/on-third-party-services/amazon-web-services) --- title: Amazon Web Services description: Learn how to run a node on Amazon Web Services. --- Introduction[​](#introduction "Direct link to heading") ------------------------------------------------------- This tutorial will guide you through setting up an Avalanche node on [Amazon Web Services (AWS)](https://aws.amazon.com/). Cloud services like AWS are a good way to ensure that your node is highly secure, available, and accessible. To get started, you'll need: - An AWS account - A terminal with which to SSH into your AWS machine - A place to securely store and back up files This tutorial assumes your local machine has a Unix style terminal. If you're on Windows, you'll have to adapt some of the commands used here. Log Into AWS[​](#log-into-aws "Direct link to heading") ------------------------------------------------------- Signing up for AWS is outside the scope of this article, but Amazon has instructions [here](https://aws.amazon.com/premiumsupport/knowledge-center/create-and-activate-aws-account). It is _highly_ recommended that you set up Multi-Factor Authentication on your AWS root user account to protect it. Amazon has documentation for this [here](https://docs.aws.amazon.com/IAM/latest/UserGuide/id_credentials_mfa_enable_virtual.html#enable-virt-mfa-for-root). Once your account is set up, you should create a new EC2 instance. An EC2 is a virtual machine instance in AWS's cloud. Go to the [AWS Management Console](https://console.aws.amazon.com/) and enter the EC2 dashboard. ![AWS Management Console.png](/images/amazon1.png) To log into the EC2 instance, you will need a key on your local machine that grants access to the instance. First, create that key so that it can be assigned to the EC2 instance later on. On the bar on the left side, under **Network & Security**, select **Key Pairs.** ![Select "Key Pairs" under the "Network & Security" drop-down.](/images/amazon2.png) Select **Create key pair** to launch the key pair creation wizard. ![Select "Create key pair."](/images/amazon3.png) Name your key `avalanche`. If your local machine has MacOS or Linux, select the `pem` file format. If it's Windows, use the `ppk` file format. Optionally, you can add tags for the key pair to assist with tracking. ![Create a key pair that will later be assigned to your EC2 instance.](/images/amazon4.png) Click `Create key pair`. You should see a success message, and the key file should be downloaded to your local machine. Without this file, you will not be able to access your EC2 instance. **Make a copy of this file and put it on a separate storage medium such as an external hard drive. Keep this file secret; do not share it with others.** ![Success message after creating a key pair.](/images/amazon5.png) Create a Security Group[​](#create-a-security-group "Direct link to heading") ----------------------------------------------------------------------------- An AWS Security Group defines what internet traffic can enter and leave your EC2 instance. Think of it like a firewall. Create a new Security Group by selecting **Security Groups** under the **Network & Security** drop-down. ![Select "Security Groups" underneath "Network & Security."](/images/amazon6.png) This opens the Security Groups panel. Click **Create security group** in the top right of the Security Groups panel. ![Select "Create security group."](/images/amazon7.png) You'll need to specify what inbound traffic is allowed. Allow SSH traffic from your IP address so that you can log into your EC2 instance (each time your ISP changes your IP address, you will need to modify this rule). Allow TCP traffic on port 9651 so your node can communicate with other nodes on the network. Allow TCP traffic on port 9650 from your IP so you can make API calls to your node. **It's important that you only allow traffic on the SSH and API port from your IP.** If you allow incoming traffic from anywhere, this could be used to brute force entry to your node (SSH port) or used as a denial of service attack vector (API port). Finally, allow all outbound traffic. ![Your inbound and outbound rules should look like this.](/images/amazon8.png) Add a tag to the new security group with key `Name` and value`Avalanche Security Group`. This will enable us to know what this security group is when we see it in the list of security groups. ![Tag the security group so you can identify it later.](/images/amazon9.png) Click `Create security group`. You should see the new security group in the list of security groups. Launch an EC2 Instance[​](#launch-an-ec2-instance "Direct link to heading") --------------------------------------------------------------------------- Now you're ready to launch an EC2 instance. Go to the EC2 Dashboard and select **Launch instance**. ![Select "Launch Instance."](/images/amazon10.png) Select **Ubuntu 20.04 LTS (HVM), SSD Volume Type** for the operating system. ![Select Ubuntu 20.04 LTS.](/images/amazon11.png) Next, choose your instance type. This defines the hardware specifications of the cloud instance. In this tutorial we set up a **c5.2xlarge**. This should be more than powerful enough since Avalanche is a lightweight consensus protocol. To create a c5.2xlarge instance, select the **Compute-optimized** option from the filter drop-down menu. ![Filter by compute optimized.](/images/amazon12.png) Select the checkbox next to the c5.2xlarge instance in the table. ![Select c5.2xlarge.](/images/amazon13.png) Click the **Next: Configure Instance Details** button in the bottom right-hand corner. ![Configure instance details](/images/amazon14.png) The instance details can stay as their defaults. When setting up a node as a validator, it is crucial to select the appropriate AWS instance type to ensure the node can efficiently process transactions and manage the network load. The recommended instance types are as follows: - For a minimal stake, start with a compute-optimized instance such as c6, c6i, c6a, c7 and similar. - Use a 2xlarge instance size for the minimal stake configuration. - As the staked amount increases, choose larger instance sizes to accommodate the additional workload. For every order of magnitude increase in stake, move up one instance size. For example, for a 20k AVAX stake, a 4xlarge instance is suitable. ### Optional: Using Reserved Instances[​](#optional-using-reserved-instances "Direct link to heading") By default, you will be charged hourly for running your EC2 instance. For a long term usage that is not optimal. You could save money by using a **Reserved Instance**. With a reserved instance, you pay upfront for an entire year of EC2 usage, and receive a lower per-hour rate in exchange for locking in. If you intend to run a node for a long time and don't want to risk service interruptions, this is a good option to save money. Again, do your own research before selecting this option. ### Add Storage, Tags, Security Group[​](#add-storage-tags-security-group "Direct link to heading") Click the **Next: Add Storage** button in the bottom right corner of the screen. You need to add space to your instance's disk. You should start with at least 700GB of disk space. Although upgrades to reduce disk usage are always in development, on average the database will continually grow, so you need to constantly monitor disk usage on the node and increase disk space if needed. Note that the image below shows 100GB as disk size, which was appropriate at the time the screenshot was taken. You should check the current [recommended disk space size](https://github.com/ava-labs/avalanchego#installation) before entering the actual value here. ![Select disk size.](/images/amazon15.png) Click **Next: Add Tags** in the bottom right corner of the screen to add tags to the instance. Tags enable us to associate metadata with our instance. Add a tag with key `Name` and value `My Avalanche Node`. This will make it clear what this instance is on your list of EC2 instances. ![Add a tag with key "Name" and value "My Avalanche Node."](/images/amazon16.png) Now assign the security group created earlier to the instance. Choose **Select an existing security group** and choose the security group created earlier. ![Choose the security group created earlier.](/images/amazon17.png) Finally, click **Review and Launch** in the bottom right. A review page will show the details of the instance you're about to launch. Review those, and if all looks good, click the blue **Launch** button in the bottom right corner of the screen. You'll be asked to select a key pair for this instance. Select **Choose an existing key pair** and then select the `avalanche` key pair you made earlier in the tutorial. Check the box acknowledging that you have access to the `.pem` or `.ppk` file created earlier (make sure you've backed it up!) and then click **Launch Instances**. ![Use the key pair created earlier.](/images/amazon18.png) You should see a new pop up that confirms the instance is launching! ![Your instance is launching!](/images/amazon19.png) ### Assign an Elastic IP[​](#assign-an-elastic-ip "Direct link to heading") By default, your instance will not have a fixed IP. Let's give it a fixed IP through AWS's Elastic IP service. Go back to the EC2 dashboard. Under **Network & Security,** select **Elastic IPs**. ![Select "Elastic IPs" under "Network & Security."](/images/amazon20.png) Select **Allocate Elastic IP address**. ![Select "Allocate Elastic IP address."](/images/amazon21.png) Select the region your instance is running in, and choose to use Amazon's pool of IPv4 addresses. Click **Allocate**. ![Settings for the Elastic IP.](/images/amazon22.png) Select the Elastic IP you just created from the Elastic IP manager. From the **Actions** drop-down, choose **Associate Elastic IP address**. ![Under "Actions" select "Associate Elastic IP address."](/images/amazon23.png) Select the instance you just created. This will associate the new Elastic IP with the instance and give it a public IP address that won't change. ![Assign the Elastic IP to your EC2 instance.](/images/amazon24.png) Set Up AvalancheGo[​](#set-up-avalanchego "Direct link to heading") ------------------------------------------------------------------- Go back to the EC2 Dashboard and select `Running Instances`. ![Go to your running instances.](/images/amazon25.png) Select the newly created EC2 instance. This opens a details panel with information about the instance. ![Details about your new instance.](/images/amazon26.png) Copy the `IPv4 Public IP` field to use later. From now on we call this value `PUBLICIP`. **Remember: the terminal commands below assume you're running Linux. Commands may differ for MacOS or other operating systems. When copy-pasting a command from a code block, copy and paste the entirety of the text in the block.** Log into the AWS instance from your local machine. Open a terminal (try shortcut `CTRL + ALT + T`) and navigate to the directory containing the `.pem` file you downloaded earlier. Move the `.pem` file to `$HOME/.ssh` (where `.pem` files generally live) with: Add it to the SSH agent so that we can use it to SSH into your EC2 instance, and mark it as read-only. ```bash ssh-add ~/.ssh/avalanche.pem; chmod 400 ~/.ssh/avalanche.pem ``` SSH into the instance. (Remember to replace `PUBLICIP` with the public IP field from earlier.) If the permissions are **not** set correctly, you will see the following error. ![Make sure you set the permissions correctly.](/images/amazon27.png) You are now logged into the EC2 instance. ![You're on the EC2 instance.](/images/amazon28.png) If you have not already done so, update the instance to make sure it has the latest operating system and security updates: ```bash sudo apt update; sudo apt upgrade -y; sudo reboot ``` This also reboots the instance. Wait 5 minutes, then log in again by running this command on your local machine: You're logged into the EC2 instance again. Now we'll need to set up our Avalanche node. To do this, follow the [Set Up Avalanche Node With Installer](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) tutorial which automates the installation process. You will need the `PUBLICIP` we set up earlier. Your AvalancheGo node should now be running and in the process of bootstrapping, which can take a few hours. To check if it's done, you can issue an API call using `curl`. If you're making the request from the EC2 instance, the request is: ```bash curl -X POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"info.isBootstrapped", "params": { "chain":"X" } }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` Once the node is finished bootstrapping, the response will be: ```json { "jsonrpc": "2.0", "result": { "isBootstrapped": true }, "id": 1 } ``` You can continue on, even if AvalancheGo isn't done bootstrapping. In order to make your node a validator, you'll need its node ID. To get it, run: ```bash curl -X POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"info.getNodeID" }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` The response contains the node ID. ```json {"jsonrpc":"2.0","result":{"nodeID":"NodeID-DznHmm3o7RkmpLkWMn9NqafH66mqunXbM"},"id":1} ``` In the above example the node ID is`NodeID-DznHmm3o7RkmpLkWMn9NqafH66mqunXbM`. Copy your node ID for later. Your node ID is not a secret, so you can just paste it into a text editor. AvalancheGo has other APIs, such as the [Health API](/docs/rpcs/other/health-rpc), that may be used to interact with the node. Some APIs are disabled by default. To enable such APIs, modify the ExecStart section of `/etc/systemd/system/avalanchego.service` (created during the installation process) to include flags that enable these endpoints. Don't manually enable any APIs unless you have a reason to. ![Some APIs are disabled by default.](/images/amazon29.png) Back up the node's staking key and certificate in case the EC2 instance is corrupted or otherwise unavailable. The node's ID is derived from its staking key and certificate. If you lose your staking key or certificate then your node will get a new node ID, which could cause you to become ineligible for a staking reward if your node is a validator. **It is very strongly advised that you copy your node's staking key and certificate**. The first time you run a node, it will generate a new staking key/certificate pair and store them in directory `/home/ubuntu/.avalanchego/staking`. Exit out of the SSH instance by running: Now you're no longer connected to the EC2 instance; you're back on your local machine. To copy the staking key and certificate to your machine, run the following command. As always, replace `PUBLICIP`. ```bash scp -r ubuntu@PUBLICIP:/home/ubuntu/.avalanchego/staking ~/aws_avalanche_backup ``` Now your staking key and certificate are in directory `~/aws_avalanche_backup` . **The contents of this directory are secret.** You should hold this directory on storage not connected to the internet (like an external hard drive.) ### Upgrading Your Node[​](#upgrading-your-node "Direct link to heading") AvalancheGo is an ongoing project and there are regular version upgrades. Most upgrades are recommended but not required. Advance notice will be given for upgrades that are not backwards compatible. To update your node to the latest version, SSH into your AWS instance as before and run the installer script again. ```bash ./avalanchego-installer.sh ``` Your machine is now running the newest AvalancheGo version. To see the status of the AvalancheGo service, run `sudo systemctl status avalanchego.` Increase Volume Size[​](#increase-volume-size "Direct link to heading") ----------------------------------------------------------------------- If you need to increase the volume size, follow these instructions from AWS: - [Request modifications to your EBS volumes](https://docs.aws.amazon.com/AWSEC2/latest/UserGuide/requesting-ebs-volume-modifications.html) - [Extend a Linux file system after resizing a volume](https://docs.aws.amazon.com/AWSEC2/latest/UserGuide/recognize-expanded-volume-linux.html) Wrap Up[​](#wrap-up "Direct link to heading") --------------------------------------------- That's it! You now have an AvalancheGo node running on an AWS EC2 instance. We recommend setting up [node monitoring](/docs/nodes/maintain/monitoring)for your AvalancheGo node. We also recommend setting up AWS billing alerts so you're not surprised when the bill arrives. If you have feedback on this tutorial, or anything else, send us a message on [Discord](https://chat.avalabs.org/). # AWS Marketplace (/docs/nodes/run-a-node/on-third-party-services/aws-marketplace) --- title: AWS Marketplace description: Learn how to run a node on AWS Marketplace. --- ## How to Launch an Avalanche Validator using AWS With the intention of enabling developers and entrepreneurs to on-ramp into the Avalanche ecosystem with as little friction as possible, Ava Labs recently launched an offering to deploy an Avalanche Validator node via the AWS Marketplace. This tutorial will show the main steps required to get this node running and validating on the Avalanche Fuji testnet. Product Overview[​](#product-overview "Direct link to heading") --------------------------------------------------------------- The Avalanche Validator node is available via [the AWS Marketplace](https://aws.amazon.com/marketplace/pp/prodview-nd6wgi2bhhslg). There you'll find a high level product overview. This includes a product description, pricing information, usage instructions, support information and customer reviews. After reviewing this information you want to click the "Continue to Subscribe" button. Subscribe to This Software[​](#subscribe-to-this-software "Direct link to heading") ----------------------------------------------------------------------------------- Once on the "Subscribe to this Software" page you will see a button which enables you to subscribe to this AWS Marketplace offering. In addition you'll see Terms of service including the seller's End User License Agreement and the [AWS Privacy Notice](https://aws.amazon.com/privacy/). After reviewing these you want to click on the "Continue to Configuration" button. Configure This Software[​](#configure-this-software "Direct link to heading") ----------------------------------------------------------------------------- This page lets you choose a fulfillment option and software version to launch this software. No changes are needed as the default settings are sufficient. Leave the `Fulfillment Option` as `64-bit (x86) Amazon Machine Image (AMI)`. The software version is the latest build of [the AvalancheGo full node](https://github.com/ava-labs/avalanchego/releases), `v1.9.5 (Dec 22, 2022)`, AKA `Banff.5`. This will always show the latest version. Also, the Region to deploy in can be left as `US East (N. Virginia)`. On the right you'll see the software and infrastructure pricing. Lastly, click the "Continue to Launch" button. Launch This Software[​](#launch-this-software "Direct link to heading") ----------------------------------------------------------------------- Here you can review the launch configuration details and follow the instructions to launch the Avalanche Validator Node. The changes are very minor. Leave the action as "Launch from Website." The EC2 Instance Type should remain `c5.2xlarge`. The primary change you'll need to make is to choose a keypair which will enable you to `ssh` into the newly created EC2 instance to run `curl` commands on the Validator node. You can search for existing Keypairs or you can create a new keypair and download it to your local machine. If you create a new keypair you'll need to move the keypair to the appropriate location, change the permissions and add it to the OpenSSH authentication agent. For example, on MacOS it would look similar to the following: ```bash # In this example we have a keypair called avalanche.pem which was downloaded from AWS to ~/Downloads/avalanche.pem # Confirm the file exists with the following command test -f ~/Downloads/avalanche.pem && echo "Avalanche.pem exists." # Running the above command will output the following: # Avalanche.pem exists. # Move the avalanche.pem keypair from the ~/Downloads directory to the hidden ~/.ssh directory mv ~/Downloads/avalanche.pem ~/.ssh # Next add the private key identity to the OpenSSH authentication agent ssh-add ~/.ssh/avalanche.pem; # Change file modes or Access Control Lists sudo chmod 600 ~/.ssh/avalanche.pem ``` Once these steps are complete you are ready to launch the Validator node on EC2. To make that happen click the "Launch" button ![launch successful](/images/aws1.png) You now have an Avalanche node deployed on an AWS EC2 instance! Copy the `AMI ID` and click on the `EC2 Console` link for the next step. EC2 Console[​](#ec2-console "Direct link to heading") ----------------------------------------------------- Now take the `AMI ID` from the previous step and input it into the search bar on the EC2 Console. This will bring you to the dashboard where you can find the EC2 instances public IP address. ![AMI instance](/images/aws2.png) Copy that public IP address and open a Terminal or command line prompt. Once you have the new Terminal open `ssh` into the EC2 instance with the following command. Node Configuration[​](#node-configuration "Direct link to heading") ------------------------------------------------------------------- ### Switch to Fuji Testnet[​](#switch-to-fuji-testnet "Direct link to heading") By default the Avalanche Node available through the AWS Marketplace syncs the Mainnet. If this is what you are looking for, you can skip this step. For this tutorial you want to sync and validate the Fuji Testnet. Now that you're `ssh`ed into the EC2 instance you can make the required changes to sync Fuji instead of Mainnet. First, confirm that the node is syncing the Mainnet by running the `info.getNetworkID` command. #### `info.getNetworkID` Request[​](#infogetnetworkid-request "Direct link to heading") ```bash curl -X POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"info.getNetworkID", "params": { } }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` #### `info.getNetworkID` Response[​](#infogetnetworkid-response "Direct link to heading") The returned `networkID` will be 1 which is the network ID for Mainnet. ```json { "jsonrpc": "2.0", "result": { "networkID": "1" }, "id": 1 } ``` Now you want to edit `/etc/avalanchego/conf.json` and change the `"network-id"` property from `"mainnet"` to `"fuji"`. To see the contents of `/etc/avalanchego/conf.json` you can `cat` the file. ```bash cat /etc/avalanchego/conf.json { "api-keystore-enabled": false, "http-host": "0.0.0.0", "log-dir": "/var/log/avalanchego", "db-dir": "/data/avalanchego", "api-admin-enabled": false, "public-ip-resolution-service": "opendns", "network-id": "mainnet" } ``` Edit that `/etc/avalanchego/conf.json` with your favorite text editor and change the value of the `"network-id"` property from `"mainnet"` to `"fuji"`. Once that's complete, save the file and restart the Avalanche node via `sudo systemctl restart avalanchego`. You can then call the `info.getNetworkID` endpoint to confirm the change was successful. #### `info.getNetworkID` Request[​](#infogetnetworkid-request-1 "Direct link to heading") ```bash curl -X POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"info.getNetworkID", "params": { } }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` #### `info.getNetworkID` Response[​](#infogetnetworkid-response-1 "Direct link to heading") The returned `networkID` will be 5 which is the network ID for Fuji. ```json { "jsonrpc": "2.0", "result": { "networkID": "5" }, "id": 1 } ``` Next you run the `info.isBoostrapped` command to confirm if the Avalanche Validator node has finished bootstrapping. ### `info.isBootstrapped` Request[​](#infoisbootstrapped-request "Direct link to heading") ```bash curl -X POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"info.isBootstrapped", "params": { "chain":"P" } }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` Once the node is finished bootstrapping, the response will be: ### `info.isBootstrapped` Response[​](#infoisbootstrapped-response "Direct link to heading") ```json { "jsonrpc": "2.0", "result": { "isBootstrapped": true }, "id": 1 } ``` **Note** that initially the response is `false` because the network is still syncing. When you're adding your node as a Validator on the Avalanche Mainnet you'll want to wait for this response to return `true` so that you don't suffer from any downtime while validating. For this tutorial you're not going to wait for it to finish syncing as it's not strictly necessary. ### `info.getNodeID` Request[​](#infogetnodeid-request "Direct link to heading") Next, you want to get the NodeID which will be used to add the node as a Validator. To get the node's ID you call the `info.getNodeID` jsonrpc endpoint. ```bash curl --location --request POST 'http://127.0.0.1:9650/ext/info' \ --header 'Content-Type: application/json' \ --data-raw '{ "jsonrpc":"2.0", "id" :1, "method" :"info.getNodeID", "params" :{ } }' ``` ### `info.getNodeID` Response[​](#infogetnodeid-response "Direct link to heading") Take a note of the `nodeID` value which is returned as you'll need to use it in the next step when adding a validator via the Avalanche Web Wallet. In this case the `nodeID` is `NodeID-Q8Gfaaio9FAqCmZVEXDq9bFvNPvDi7rt5` ```json { "jsonrpc": "2.0", "result": { "nodeID": "NodeID-Q8Gfaaio9FAqCmZVEXDq9bFvNPvDi7rt5", "nodePOP": { "publicKey": "0x85675db18b326a9585bfd43892b25b71bf01b18587dc5fac136dc5343a9e8892cd6c49b0615ce928d53ff5dc7fd8945d", "proofOfPossession": "0x98a56f092830161243c1f1a613ad68a7f1fb25d2462ecf85065f22eaebb4e93a60e9e29649a32252392365d8f628b2571174f520331ee0063a94473f8db6888fc3a722be330d5c51e67d0d1075549cb55376e1f21d1b48f859ef807b978f65d9" } }, "id": 1 } ``` Add Node as Validator on Fuji via Core web[​](#add-node-as-validator-on-fuji-via-core-web "Direct link to heading") ------------------------------------------------------------------------------------------------------------------- For adding the new node as a Validator on the Fuji testnet's Primary Network you can use the [Core web](https://core.app/) [connected](https://support.avax.network/en/articles/6639869-core-web-how-do-i-connect-to-core-web) to [Core extension](https://core.app). If you don't have a Core extension already, check out this [guide](https://support.avax.network/en/articles/6100129-core-extension-how-do-i-create-a-new-wallet). If you'd like to import an existing wallet to Core extension, follow [these steps](https://support.avax.network/en/articles/6078933-core-extension-how-do-i-access-my-existing-account). ![Core web](/images/aws3.png) Core web is a free, all-in-one command center that gives users a more intuitive and comprehensive way to view assets, and use dApps across the Avalanche network, its various Avalanche L1s, and Ethereum. Core web is optimized for use with the Core browser extension and Core mobile (available on both iOS & Android). Together, they are key components of the Core product suite that brings dApps, NFTs, Avalanche Bridge, Avalanche L1s, L2s, and more, directly to users. ### Switching to Testnet Mode[​](#switching-to-testnet-mode "Direct link to heading") By default, Core web and Core extension are connected to Mainnet. For the sake of this demo, you want to connect to the Fuji Testnet. #### On Core Extension[​](#on-core-extension "Direct link to heading") From the hamburger menu on the top-left corner, choose Advanced, and then toggle the Testnet Mode on. ![](/images/aws4.gif) You can follow the same steps for switching back to Mainnet. #### On Core web[​](#on-core-web "Direct link to heading") Click on the Settings button top-right corner of the page, then toggle Testnet Mode on. ![](/images/aws5.gif) You can follow the same steps for switching back to Mainnet. ### Adding the Validator[​](#adding-the-validator "Direct link to heading") - Node ID: A unique ID derived from each individual node's staker certificate. Use the `NodeID` which was returned in the `info.getNodeID` response. In this example it's `NodeID-Q8Gfaaio9FAqCmZVEXDq9bFvNPvDi7rt5` - Staking End Date: Your AVAX tokens will be locked until this date. - Stake Amount: The amount of AVAX to lock for staking. On Mainnet, the minimum required amount is 2,000 AVAX. On Testnet the minimum required amount is 1 AVAAX. - Delegation Fee: You will claim this % of the rewards from the delegators on your node. - Reward Address: A reward address is the destination address of the accumulated staking rewards. To add a node as a Validator, first select the Stake tab on Core web, in the left hand nav menu. Next click the Validate button, and select Get Started. ![](/images/aws6.gif) This page will open up. ![](/images/aws7.png) Choose the desired Staking Amount, then click Next. ![](/images/aws8.png) Enter you Node ID, then click Next. ![](/images/aws9.png) Here, you'll need to choose the staking duration. There are predefined values, like 1 day, 1 month and so on. You can also choose a custom period of time. For this example, 22 days were chosen. ![](/images/aws10.png) Choose the address that the network will send rewards to. Make sure it's the correct address because once the transaction is submitted this cannot be changed later or undone. You can choose the wallet's P-Chain address, or a custom P-Chain address. After entering the address, click Next. ![](/images/aws11.png) Other individuals can stake to your validator and receive rewards too, known as "delegating." You will claim this percent of the rewards from the delegators on your node. Click Next. ![](/images/aws12.png) After entering all these details, a summary of your validation will show up. If everything is correct, you can proceed and click on Submit Validation. A new page will open up, prompting you to accept the transaction. Here, please approve the transaction. ![](/images/aws13.png) After the transaction is approved, you will see a message saying that your validation transaction was submitted. ![](/images/aws14.png) If you click on View on explorer, a new browser tab will open with the details of the `AddValidatorTx`. It will show details such as the total value of AVAX transferred, any AVAX which were burned, the blockchainID, the blockID, the NodeID of the validator, and the total time which has elapsed from the entire Validation period. ![](/images/aws15.png) Confirm That the Node is a Pending Validator on Fuji[​](#confirm-that-the-node-is-a-pending-validator-on-fuji "Direct link to heading") --------------------------------------------------------------------------------------------------------------------------------------- As a last step you can call the `platform.getPendingvalidators` endpoint to confirm that the Avalanche node which was recently spun up on AWS is no in the pending validators queue where it will stay for 5 minutes. ### `platform.getPendingValidators` Request[​](#platformgetpendingvalidators-request "Direct link to heading") ```bash curl --location --request POST 'https://api.avax-test.network/ext/bc/P' \ --header 'Content-Type: application/json' \ --data-raw '{ "jsonrpc": "2.0", "method": "platform.getPendingValidators", "params": { "subnetID": "11111111111111111111111111111111LpoYY", "nodeIDs": [] }, "id": 1 }' ``` ### `platform.getPendingValidators` Response[​](#platformgetpendingvalidators-response "Direct link to heading") ```json { "jsonrpc": "2.0", "result": { "validators": [ { "txID": "4d7ZboCrND4FjnyNaF3qyosuGQsNeJ2R4KPJhHJ55VCU1Myjd", "startTime": "1673411918", "endTime": "1675313170", "stakeAmount": "1000000000", "nodeID": "NodeID-Q8Gfaaio9FAqCmZVEXDq9bFvNPvDi7rt5", "delegationFee": "2.0000", "connected": false, "delegators": null } ], "delegators": [] }, "id": 1 } ``` You can also pass in the `NodeID` as a string to the `nodeIDs` array in the request body. ```bash curl --location --request POST 'https://api.avax-test.network/ext/bc/P' \ --header 'Content-Type: application/json' \ --data-raw '{ "jsonrpc": "2.0", "method": "platform.getPendingValidators", "params": { "subnetID": "11111111111111111111111111111111LpoYY", "nodeIDs": ["NodeID-Q8Gfaaio9FAqCmZVEXDq9bFvNPvDi7rt5"] }, "id": 1 }' ``` This will filter the response by the `nodeIDs` array which will save you time by no longer requiring you to search through the entire response body for the NodeIDs. ```json { "jsonrpc": "2.0", "result": { "validators": [ { "txID": "4d7ZboCrND4FjnyNaF3qyosuGQsNeJ2R4KPJhHJ55VCU1Myjd", "startTime": "1673411918", "endTime": "1675313170", "stakeAmount": "1000000000", "nodeID": "NodeID-Q8Gfaaio9FAqCmZVEXDq9bFvNPvDi7rt5", "delegationFee": "2.0000", "connected": false, "delegators": null } ], "delegators": [] }, "id": 1 } ``` After 5 minutes the node will officially start validating the Avalanche Fuji testnet and you will no longer see it in the response body for the `platform.getPendingValidators` endpoint. Now you will access it via the `platform.getCurrentValidators` endpoint. ### `platform.getCurrentValidators` Request[​](#platformgetcurrentvalidators-request "Direct link to heading") ```bash curl --location --request POST 'https://api.avax-test.network/ext/bc/P' \ --header 'Content-Type: application/json' \ --data-raw '{ "jsonrpc": "2.0", "method": "platform.getCurrentValidators", "params": { "subnetID": "11111111111111111111111111111111LpoYY", "nodeIDs": ["NodeID-Q8Gfaaio9FAqCmZVEXDq9bFvNPvDi7rt5"] }, "id": 1 }' ``` ### `platform.getCurrentValidators` Response[​](#platformgetcurrentvalidators-response "Direct link to heading") ```json { "jsonrpc": "2.0", "result": { "validators": [ { "txID": "2hy57Z7KiZ8L3w2KonJJE1fs5j4JDzVHLjEALAHaXPr6VMeDhk", "startTime": "1673411918", "endTime": "1675313170", "stakeAmount": "1000000000", "nodeID": "NodeID-Q8Gfaaio9FAqCmZVEXDq9bFvNPvDi7rt5", "rewardOwner": { "locktime": "0", "threshold": "1", "addresses": [ "P-fuji1tgj2c3k56enytw5d78rt0tsq3lzg8wnftffwk7" ] }, "validationRewardOwner": { "locktime": "0", "threshold": "1", "addresses": [ "P-fuji1tgj2c3k56enytw5d78rt0tsq3lzg8wnftffwk7" ] }, "delegationRewardOwner": { "locktime": "0", "threshold": "1", "addresses": [ "P-fuji1tgj2c3k56enytw5d78rt0tsq3lzg8wnftffwk7" ] }, "potentialReward": "5400963", "delegationFee": "2.0000", "uptime": "0.0000", "connected": false, "delegators": null } ] }, "id": 1 } ``` Mainnet[​](#mainnet "Direct link to heading") --------------------------------------------- All of these steps can be applied to Mainnet. However, the minimum required Avax token amounts to become a validator is 2,000 on the Mainnet. For more information, please read [this doc](/docs/primary-network/validate/how-to-stake#validators). Maintenance[​](#maintenance "Direct link to heading") ----------------------------------------------------- AWS one click is meant to be used in automated environments, not as an end-user solution. You can still manage it manually, but it is not as easy as an Ubuntu instance or using the script: - AvalancheGo binary is at `/usr/local/bin/avalanchego` - Main node config is at `/etc/avalanchego/conf.json` - Working directory is at `/home/avalanche/.avalanchego/ (and belongs to avalanchego user)` - Database is at `/data/avalanchego` - Logs are at `/var/log/avalanchego` For a simple upgrade you would need to place the new binary at `/usr/local/bin/`. If you run an Avalanche L1, you would also need to place the VM binary into `/home/avalanche/.avalanchego/plugins`. You can also look at using [this guide](https://docs.aws.amazon.com/systems-manager/latest/userguide/automation-tutorial-update-ami.html), but that won't address updating the Avalanche L1, if you have one. Summary[​](#summary "Direct link to heading") --------------------------------------------- Avalanche is the first decentralized smart contracts platform built for the scale of global finance, with near-instant transaction finality. Now with an Avalanche Validator node available as a one-click install from the AWS Marketplace developers and entrepreneurs can on-ramp into the Avalanche ecosystem in a matter of minutes. If you have any questions or want to follow up in any way please join our Discord server at [https://discord.gg/avax](https://discord.gg/avax/). For more developer resources please check out our [Developer Documentation](/docs). # Google Cloud (/docs/nodes/run-a-node/on-third-party-services/google-cloud) --- title: Google Cloud description: Learn how to run an Avalanche node on Google Cloud. --- This document was written by a community member, some information may be outdated. Introduction[​](#introduction "Direct link to heading") ------------------------------------------------------- Google's Cloud Platform (GCP) is a scalable, trusted and reliable hosting platform. Google operates a significant amount of it's own global networking infrastructure. It's [fiber network](https://cloud.google.com/blog/products/networking/google-cloud-networking-in-depth-cloud-cdn) can provide highly stable and consistent global connectivity. In this article, we will leverage GCP to deploy a node on which Avalanche can installed via [terraform](https://www.terraform.io/). Leveraging `terraform` may seem like overkill, it should set you apart as an operator and administrator as it will enable you greater flexibility and provide the basis on which you can easily build further automation. Conventions[​](#conventions "Direct link to heading") ----------------------------------------------------- - `Items` highlighted in this manor are GCP parlance and can be searched for further reference in the Google documentation for their cloud products. Important Notes[​](#important-notes "Direct link to heading") ------------------------------------------------------------- - The machine type used in this documentation is for reference only and the actual sizing you use will depend entirely upon the amount that is staked and delegated to the node. Architectural Description[​](#architectural-description "Direct link to heading") --------------------------------------------------------------------------------- This section aims to describe the architecture of the system that the steps in the [Setup Instructions](#-setup-instructions) section deploy when enacted. This is done so that the executor can not only deploy the reference architecture, but also understand and potentially optimize it for their needs. ### Project[​](#project "Direct link to heading") We will create and utilize a single GCP `Project` for deployment of all resources. #### Service Enablement[​](#service-enablement "Direct link to heading") Within our GCP project we will need to enable the following Cloud Services: - `Compute Engine` - `IAP` ### Networking[​](#networking "Direct link to heading") #### Compute Network[​](#compute-network "Direct link to heading") We will deploy a single `Compute Network` object. This unit is where we will deploy all subsequent networking objects. It provides a logical boundary and securitization context should you wish to deploy other chain stacks or other infrastructure in GCP. #### Public IP[​](#public-ip "Direct link to heading") Avalanche requires that a validator communicate outbound on the same public IP address that it advertises for other peers to connect to it on. Within GCP this precludes the possibility of us using a Cloud NAT Router for the outbound communications and requires us to bind the public IP that we provision to the interface of the machine. We will provision a single `EXTERNAL` static IPv4 `Compute Address`. #### Avalanche L1s[​](#avalanche-l1s "Direct link to heading") For the purposes of this documentation we will deploy a single `Compute Subnetwork` in the US-EAST1 `Region` with a /24 address range giving us 254 IP addresses (not all usable but for the sake of generalized documentation). ### Compute[​](#compute "Direct link to heading") #### Disk[​](#disk "Direct link to heading") We will provision a single 400GB `PD-SSD` disk that will be attached to our VM. #### Instance[​](#instance "Direct link to heading") We will deploy a single `Compute Instance` of size `e2-standard-8`. Observations of operations using this machine specification suggest it is memory over provisioned and could be brought down to 16GB using custom machine specification; but please review and adjust as needed (the beauty of compute virtualization!!). #### Zone[​](#zone "Direct link to heading") We will deploy our instance into the `US-EAST1-B` `Zone` #### Firewall[​](#firewall "Direct link to heading") We will provision the following `Compute Firewall` rules: - IAP INGRESS for SSH (TCP 22) - this only allows GCP IAP sources inbound on SSH. - P2P INGRESS for AVAX Peers (TCP 9651) These are obviously just default ports and can be tailored to your needs as you desire. Setup Instructions[​](#-setup-instructions "Direct link to heading") -------------------------------------------------------------------- ### GCP Account[​](#gcp-account "Direct link to heading") 1. If you don't already have a GCP account go create one [here](https://console.cloud.google.com/freetrial) You will get some free bucks to run a trial, the trial is feature complete but your usage will start to deplete your free bucks so turn off anything you don't need and/or add a credit card to your account if you intend to run things long term to avoid service shutdowns. ### Project[​](#project-1 "Direct link to heading") Login to the GCP `Cloud Console` and create a new `Project` in your organization. Let's use the name `my-avax-nodes` for the sake of this setup. 1. ![Select Project Dropdown](/images/cloud1.png) 2. ![Click New Project Button](/images/cloud2.png) 3. ![Create New Project](/images/cloud3.png) ### Terraform State[​](#terraform-state "Direct link to heading") Terraform uses a state files to compose a differential between current infrastructure configuration and the proposed plan. You can store this state in a variety of different places, but using GCP storage is a reasonable approach given where we are deploying so we will stick with that. 1. ![Select Cloud Storage Browser](/images/cloud4.png) 2. ![Create New Bucket](/images/cloud5.png) Authentication to GCP from terraform has a few different options which are laid out [here](https://www.terraform.io/language/settings/backends/gcs). Please chose the option that aligns with your context and ensure those steps are completed before continuing. Depending upon how you intend to execute your terraform operations you may or may not need to enable public access to the bucket. Obviously, not exposing the bucket for `public` access (even if authenticated) is preferable. If you intend to simply run terraform commands from your local machine then you will need to open the access up. I recommend to employ a full CI/CD pipeline using GCP Cloud Build which if utilized will mean the bucket can be marked as `private`. A full walk through of Cloud Build setup in this context can be found [here](https://cloud.google.com/architecture/managing-infrastructure-as-code) ### Clone GitHub Repository[​](#clone-github-repository "Direct link to heading") I have provided a rudimentary terraform construct to provision a node on which to run Avalanche which can be found [here](https://github.com/meaghanfitzgerald/deprecated-avalanche-docs/tree/master/static/scripts). Documentation below assumes you are using this repository but if you have another terraform skeleton similar steps will apply. ### Terraform Configuration[​](#terraform-configuration "Direct link to heading") 1. If running terraform locally, please [install](https://learn.hashicorp.com/tutorials/terraform/install-cli) it. 2. In this repository, navigate to the `terraform` directory. 3. Under the `projects` directory, rename the `my-avax-project` directory to match your GCP project name that you created (not required, but nice to be consistent) 4. Under the folder you just renamed locate the `terraform.tfvars` file. 5. Edit this file and populate it with the values which make sense for your context and save it. 6. Locate the `backend.tf` file in the same directory. 7. Edit this file ensuring to replace the `bucket` property with the GCS bucket name that you created earlier. If you do not with to use cloud storage to persist terraform state then simply switch the `backend` to some other desirable provider. ### Terraform Execution[​](#terraform-execution "Direct link to heading") Terraform enables us to see what it would do if we were to run it without actually applying any changes... this is called a `plan` operation. This plan is then enacted (optionally) by an `apply`. #### Plan[​](#plan "Direct link to heading") 1. In a terminal which is able to execute the `tf` binary, `cd` to the ~`my-avax-project` directory that you renamed in step 3 of `Terraform Configuration`. 2. Execute the command `tf plan` 3. You should see a JSON output to the stdout of the terminal which lays out the operations that terraform will execute to apply the intended state. #### Apply[​](#apply "Direct link to heading") 1. In a terminal which is able to execute the `tf` binary, `cd` to the ~`my-avax-project` directory that you renamed in step 3 of `Terraform Configuration`. 2. Execute the command `tf apply` If you want to ensure that terraform does **exactly** what you saw in the `apply` output, you can optionally request for the `plan` output to be saved to a file to feed to `apply`. This is generally considered best practice in highly fluid environments where rapid change is occurring from multiple sources. Conclusion[​](#conclusion "Direct link to heading") --------------------------------------------------- Establishing CI/CD practices using tools such as GitHub and Terraform to manage your infrastructure assets is a great way to ensure base disaster recovery capabilities and to ensure you have a place to embed any ~tweaks you have to make operationally removing the potential to miss them when you have to scale from 1 node to 10. Having an automated pipeline also gives you a place to build a bigger house... what starts as your interest in building and managing a single AVAX node today can quickly change into you building an infrastructure operation for many different chains working with multiple different team members. I hope this may have inspired you to take a leap into automation in this context! # Latitude (/docs/nodes/run-a-node/on-third-party-services/latitude) --- title: Latitude description: Learn how to run an Avalanche node on Latitude.sh. --- Introduction[​](#introduction "Direct link to heading") ------------------------------------------------------- This tutorial will guide you through setting up an Avalanche node on [Latitude.sh](https://latitude.sh/). Latitude.sh provides high-performance lighting-fast bare metal servers to ensure that your node is highly secure, available, and accessible. To get started, you'll need: - A Latitude.sh account - A terminal with which to SSH into your Latitude.sh machine For the instructions on creating an account and server with Latitude.sh, please reference their [GitHub tutorial](https://github.com/NottherealIllest/Latitude.sh-post/blob/main/avalanhe/avax-copy.md) , or visit [this page](https://www.latitude.sh/dashboard/signup) to sign up and create your first project. This tutorial assumes your local machine has a Unix-style terminal. If you're on Windows, you'll have to adapt some of the commands used here. Configuring Your Server[​](#configuring-your-server "Direct link to heading") ----------------------------------------------------------------------------- ### Create a Latitude.sh Account[​](#create-a-latitudesh-account "Direct link to heading") At this point your account has been verified, and you have created a new project and deployed the server according to the instructions linked above. ### Access Your Server & Further Steps[​](#access-your-server--further-steps "Direct link to heading") All your Latitude.sh credentials are available by clicking the `server` under your project, and can be used to access your Latitude.sh machine from your local machine using a terminal. You will need to install the `avalanche node installer script` directly in the server's terminal. After gaining access, we'll need to set up our Avalanche node. To do this, follow the instructions here to install and run your node [Set Up Avalanche Node With Installer](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go). Your AvalancheGo node should now be running and in the process of bootstrapping, which can take a few hours. To check if it's done, you can issue an API call using `curl`. The request is: ```bash curl -X POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"info.isBootstrapped", "params": { "chain":"X" } }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` Once the node is finished bootstrapping, the response will be: ```json { "jsonrpc": "2.0", "result": { "isBootstrapped": true }, "id": 1 } ``` You can continue on, even if AvalancheGo isn't done bootstrapping. In order to make your node a validator, you'll need its node ID. To get it, run: ```bash curl -X POST --data '{ "jsonrpc": "2.0", "id": 1, "method": "info.getNodeID" }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` The response contains the node ID. ```json { "jsonrpc": "2.0", "result": { "nodeID": "KhDnAoZDW8iRJ3F26iQgK5xXVFMPcaYeu" }, "id": 1 } ``` In the above example the node ID is `NodeID-KhDnAoZDW8iRJ3F26iQgK5xXVFMPcaYeu`. AvalancheGo has other APIs, such as the [Health API](/docs/rpcs/other/health-rpc), that may be used to interact with the node. Some APIs are disabled by default. To enable such APIs, modify the ExecStart section of `/etc/systemd/system/avalanchego.service` (created during the installation process) to include flags that enable these endpoints. Don't manually enable any APIs unless you have a reason to. Exit out of the SSH server by running: ### Upgrading Your Node[​](#upgrading-your-node "Direct link to heading") AvalancheGo is an ongoing project and there are regular version upgrades. Most upgrades are recommended but not required. Advance notice will be given for upgrades that are not backwards compatible. To update your node to the latest version, SSH into your server using a terminal and run the installer script again. ```bash ./avalanchego-installer.sh ``` Your machine is now running the newest AvalancheGo version. To see the status of the AvalancheGo service, run `sudo systemctl status avalanchego.` Wrap Up[​](#wrap-up "Direct link to heading") --------------------------------------------- That's it! You now have an AvalancheGo node running on a Latitude.sh machine. We recommend setting up [node monitoring](/docs/nodes/maintain/monitoring) for your AvalancheGo node. # Microsoft Azure (/docs/nodes/run-a-node/on-third-party-services/microsoft-azure) --- title: Microsoft Azure description: How to run an Avalanche node on Microsoft Azure. --- This document was written by a community member, some information may be out of date. Running a validator and staking with Avalanche provides extremely competitive rewards of between 9.69% and 11.54% depending on the length you stake for. The maximum rate is earned by staking for a year, whilst the lowest rate for 14 days. There is also no slashing, so you don't need to worry about a hardware failure or bug in the client which causes you to lose part or all of your stake. Instead with Avalanche you only need to currently maintain at least 80% uptime to receive rewards. If you fail to meet this requirement you don't get slashed, but you don't receive the rewards. **You also do not need to put your private keys onto a node to begin validating on that node.** Even if someone breaks into your cloud environment and gains access to the node, the worst they can do is turn off the node. Not only does running a validator node enable you to receive rewards in AVAX, but later you will also be able to validate other Avalanche L1s in the ecosystem as well and receive rewards in the token native to their Avalanche L1s. Hardware requirements to run a validator are relatively modest: 8 CPU cores, 16 GB of RAM and 1 TB SSD. It also doesn't use enormous amounts of energy. Avalanche's [revolutionary consensus mechanism](/docs/primary-network/avalanche-consensus) is able to scale to millions of validators participating in consensus at once, offering unparalleled decentralisation. Currently the minimum amount required to stake to become a validator is 2,000 AVAX. Alternatively, validators can also charge a small fee to enable users to delegate their stake with them to help towards running costs. In this article we will step through the process of configuring a node on Microsoft Azure. This tutorial assumes no prior experience with Microsoft Azure and will go through each step with as few assumptions possible. At the time of this article, spot pricing for a virtual machine with 2 Cores and 8 GB memory costs as little as 0.01060perhourwhichworksoutatabout0.01060 per hour which works out at about 113.44 a year, **a saving of 83.76%! compared to normal pay as you go prices.** In comparison a virtual machine in AWS with 2 Cores and 4 GB Memory with spot pricing is around $462 a year. Initial Subscription Configuration[​](#initial-subscription-configuration "Direct link to heading") --------------------------------------------------------------------------------------------------- ### Set up 2 Factor[​](#set-up-2-factor "Direct link to heading") First you will need a Microsoft Account, if you don't have one already you will see an option to create one at the following link. If you already have one, make sure to set up 2 Factor authentication to secure your node by going to the following link and then selecting "Two-step verification" and following the steps provided. [https://account.microsoft.com/security](https://account.microsoft.com/security) ![Image for post](/images/azure1.png) Once two factor has been configured log into the Azure portal by going to [https://portal.azure.com](https://portal.azure.com/) and signing in with your Microsoft account. When you login you won't have a subscription, so we need to create one first. Select "Subscriptions" as highlighted below: ![Image for post](/images/azure2.png) Then select "+ Add" to add a new subscription ![Image for post](/images/azure3.png) If you want to use Spot Instance VM Pricing (which will be considerably cheaper) you can't use a Free Trial account (and you will receive an error upon validation), so **make sure to select Pay-As-You-Go.** ![Image for post](/images/azure4.png) Enter your billing details and confirm identity as part of the sign-up process, when you get to Add technical support select the without support option (unless you want to pay extra for support) and press Next. ![Image for post](/images/azure5.png) Create a Virtual Machine[​](#create-a-virtual-machine "Direct link to heading") ------------------------------------------------------------------------------- Now that we have a subscription, we can create the Ubuntu Virtual Machine for our Avalanche Node. Select the Icon in the top left for the Menu and choose "+ Create a resource" ![Image for post](/images/azure6.png) Select Ubuntu Server 18.04 LTS (this will normally be under the popular section or alternatively search for it in the marketplace) ![Image for post](/images/azure7.png) This will take you to the Create a virtual machine page as shown below: ![Image for post](/images/azure8.png) First, enter a virtual machine a name, this can be anything but in my example, I have called it Avalanche (This will also automatically change the resource group name to match) Then select a region from the drop-down list. Select one of the recommended ones in a region that you prefer as these tend to be the larger ones with most features enabled and cheaper prices. In this example I have selected North Europe. ![Image for post](/images/azure9.png) You have the option of using spot pricing to save significant amounts on running costs. Spot instances use a supply and demand market price structure. As demand for instances goes up, the price for the spot instance goes up. If there is insufficient capacity, then your VM will be turned off. The chances of this happening are incredibly low though, especially if you select the Capacity only option. Even in the unlikely event it does get turned off temporarily you only need to maintain at least 80% up time to receive the staking rewards and there is no slashing implemented in Avalanche. Select Yes for Azure Spot instance, select Eviction type to Capacity Only and **make sure to set the eviction policy to Stop / Deallocate. This is very important otherwise the VM will be deleted** ![Image for post](/images/azure10.png) Choose "Select size" to change the Virtual Machine size, and from the menu select D2s\_v4 under the D-Series v4 selection (This size has 2 Cores, 8 GB Memory and enables Premium SSDs). You can use F2s\_v2 instances instead, with are 2 Cores, 4 GB Memory and enables Premium SSDs) but the spot price actually works out cheaper for the larger VM currently with spot instance prices. You can use [this link](https://azure.microsoft.com/en-us/pricing/details/virtual-machines/linux/) to view the prices across the different regions. ![Image for post](/images/azure11.png) Once you have selected the size of the Virtual Machine, select "View pricing history and compare prices in nearby regions" to see how the spot price has changed over the last 3 months, and whether it's cheaper to use a nearby region which may have more spare capacity. ![Image for post](/images/azure12.png) At the time of this article, spot pricing for D2s\_v4 in North Europe costs 0.07975perhour,oraround0.07975 per hour, or around 698.61 a year. With spot pricing, the price falls to 0.01295perhour,whichworksoutatabout0.01295 per hour, which works out at about 113.44 a year, **a saving of 83.76%!** There are some regions which are even cheaper, East US for example is 0.01060perhouroraround0.01060 per hour or around 92.86 a year! ![Image for post](/images/azure13.png) Below you can see the price history of the VM over the last 3 months for North Europe and regions nearby. ![Image for post](/images/azure14.png) ### Cheaper Than Amazon AWS[​](#cheaper-than-amazon-aws "Direct link to heading") As a comparison a c5.large instance costs 0.085USDperhouronAWS.Thistotals 0.085 USD per hour on AWS. This totals ~745 USD per year. Spot instances can save 62%, bringing that total down to $462. The next step is to change the username for the VM, to align with other Avalanche tutorials change the username to Ubuntu. Otherwise you will need to change several commands later in this article and swap out Ubuntu with your new username. ![Image for post](/images/azure15.png) ### Disks[​](#disks "Direct link to heading") Select Next: Disks to then configure the disks for the instance. There are 2 choices for disks, either Premium SSD which offer greater performance with a 64 GB disk costs around 10amonth,orthereisthestandardSSDwhichofferslowerperformanceandisaround10 a month, or there is the standard SSD which offers lower performance and is around 5 a month. You also have to pay $0.002 per 10,000 transaction units (reads / writes and deletes) with the Standard SSD, whereas with Premium SSDs everything is included. Personally, I chose the Premium SSD for greater performance, but also because the disks are likely to be heavily used and so may even work out cheaper in the long run. Select Next: Networking to move onto the network configuration ![Image for post](/images/azure16.png) ### Network Config[​](#network-config "Direct link to heading") You want to use a Static IP so that the public IP assigned to the node doesn't change in the event it stops. Under Public IP select "Create new" ![Image for post](/images/azure17.png) Then select "Static" as the Assignment type ![Image for post](/images/azure19.png) Then we need to configure the network security group to control access inbound to the Avalanche node. Select "Advanced" as the NIC network security group type and select "Create new" ![Image for post](/images/azure20.png) For security purposes you want to restrict who is able to remotely connect to your node. To do this you will first want to find out what your existing public IP is. This can be done by going to google and searching for "what's my IP" ![Image for post](/images/azure21.png) It's likely that you have been assigned a dynamic public IP for your home, unless you have specifically requested it, and so your assigned public IP may change in the future. It's still recommended to restrict access to your current IP though, and then in the event your home IP changes and you are no longer able to remotely connect to the VM, you can just update the network security rules with your new public IP so you are able to connect again. NOTE: If you need to change the network security group rules after deployment if your home IP has changed, search for "avalanche-nsg" and you can modify the rule for SSH and Port 9650 with the new IP. **Port 9651 needs to remain open to everyone** though as that's how it communicates with other Avalanche nodes. ![Image for post](/images/azure22.png) Now that you have your public IP select the default allow ssh rule on the left under inbound rules to modify it. Change Source from "Any" to "IP Addresses" and then enter in your Public IP address that you found from google in the Source IP address field. Change the Priority towards the bottom to 100 and then press Save. ![Image for post](/images/azure23.png) Then select "+ Add an inbound rule" to add another rule for RPC access, this should also be restricted to only your IP. Change Source to "IP Addresses" and enter in your public IP returned from google into the Source IP field. This time change the "Destination port ranges" field to 9650 and select "TCP" as the protocol. Change the priority to 110 and give it a name of "Avalanche\_RPC" and press Add. ![Image for post](/images/azure24.png) Select "+ Add an inbound rule" to add a final rule for the Avalanche Protocol so that other nodes can communicate with your node. This rule needs to be open to everyone so keep "Source" set to "Any." Change the Destination port range to "9651" and change the protocol to "TCP." Enter a priority of 120 and a name of Avalanche\_Protocol and press Add. ![Image for post](/images/azure25.png) The network security group should look like the below (albeit your public IP address will be different) and press OK. ![Image for post](/images/azure26.png) Leave the other settings as default and then press "Review + create" to create the Virtual machine. ![Image for post](/images/azure27.png) First it will perform a validation test. If you receive an error here, make sure you selected Pay-As-You-Go subscription model and you are not using the Free Trial subscription as Spot instances are not available. Verify everything looks correct and press "Create" ![Image for post](/images/azure28.png) You should then receive a prompt asking you to generate a new key pair to connect your virtual machine. Select "Download private key and create resource" to download the private key to your PC. ![Image for post](/images/azure29.png) Once your deployment has finished, select "Go to resource" ![Image for post](/images/azure30.png) Change the Provisioned Disk Size[​](#change-the-provisioned-disk-size "Direct link to heading") ----------------------------------------------------------------------------------------------- By default, the Ubuntu VM will be provisioned with a 30 GB Premium SSD. You should increase this to 250 GB, to allow for database growth. ![Image for post](/images/azure31.png) To change the Disk size, the VM needs to be stopped and deallocated. Select "Stop" and wait for the status to show deallocated. Then select "Disks" on the left. ![Image for post](/images/azure32.png) Select the Disk name that's current provisioned to modify it ![Image for post](/images/azure33.png) Select "Size + performance" on the left under settings and change the size to 250 GB and press "Resize" ![Image for post](/images/azure34.png) Doing this now will also extend the partition automatically within Ubuntu. To go back to the virtual machine overview page, select Avalanche in the navigation setting. ![Image for post](/images/azure35.png) Then start the VM ![Image for post](/images/azure36.png) Connect to the Avalanche Node[​](#connect-to-the-avalanche-node "Direct link to heading") ----------------------------------------------------------------------------------------- The following instructions show how to connect to the Virtual Machine from a Windows 10 machine. For instructions on how to connect from a Ubuntu machine see the [AWS tutorial](/docs/nodes/run-a-node/on-third-party-services/amazon-web-services). On your local PC, create a folder on the root of the C: drive called Avalanche and then move the Avalanche\_key.pem file you downloaded before into the folder. Then right click the file and select Properties. Go to the security tab and select "Advanced" at the bottom ![Image for post](/images/azure37.png) Select "Disable inheritance" and then "Remove all inherited permissions from this object" to remove all existing permissions on that file. ![Image for post](/images/azure38.png) Then select "Add" to add a new permission and choose "Select a principal" at the top. From the pop-up box enter in your user account that you use to log into your machine. In this example I log on with a local user called Seq, you may have a Microsoft account that you use to log in, so use whatever account you login to your PC with and press "Check Names" and it should underline it to verify and press OK. ![Image for post](/images/azure39.png) Then from the permissions section make sure only "Read & Execute" and "Read" are selected and press OK. ![Image for post](/images/azure40.png) It should look something like the below, except with a different PC name / user account. This just means the key file can't be modified or accessed by any other accounts on this machine for security purposes so they can't access your Avalanche Node. ![Image for post](/images/azure41.png) ### Find your Avalanche Node Public IP[​](#find-your-avalanche-node-public-ip "Direct link to heading") From the Azure Portal make a note of your static public IP address that has been assigned to your node. ![Image for post](/images/azure42.png) To log onto the Avalanche node, open command prompt by searching for `cmd` and selecting "Command Prompt" on your Windows 10 machine. ![Image for post](/images/azure43.png) Then use the following command and replace the EnterYourAzureIPHere with the static IP address shown on the Azure portal. ssh -i C:\\Avalanche\\Avalanche\_key.pem ubuntu@EnterYourAzureIPHere for my example its: ssh -i C:\\Avalanche\\Avalanche\_key.pem The first time you connect you will receive a prompt asking to continue, enter yes. ![Image for post](/images/azure44.png) You should now be connected to your Node. ![Image for post](/images/azure45.png) The following section is taken from Colin's excellent tutorial for [configuring an Avalanche Node on Amazon's AWS](/docs/nodes/run-a-node/on-third-party-services/amazon-web-services). ### Update Linux with Security Patches[​](#update-linux-with-security-patches "Direct link to heading") Now that we are on our node, it's a good idea to update it to the latest packages. To do this, run the following commands, one-at-a-time, in order: ``` sudo apt update sudo apt upgrade -y sudo reboot ``` ![Image for post](/images/azure46.png) This will make our instance up to date with the latest security patches for our operating system. This will also reboot the node. We'll give the node a minute or two to boot back up, then log in again, same as before. ### Set up the Avalanche Node[​](#set-up-the-avalanche-node "Direct link to heading") Now we'll need to set up our Avalanche node. To do this, follow the [Set Up Avalanche Node With Installer](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) tutorial which automates the installation process. You will need the "IPv4 Public IP" copied from the Azure Portal we set up earlier. Once the installation is complete, our node should now be bootstrapping! We can run the following command to take a peek at the latest status of the AvalancheGo node: ``` sudo systemctl status avalanchego ``` To check the status of the bootstrap, we'll need to make a request to the local RPC using `curl`. This request is as follows: ``` curl -X POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"info.isBootstrapped", "params": { "chain":"X" } }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` The node can take some time (upward of an hour at this moment writing) to bootstrap. Bootstrapping means that the node downloads and verifies the history of the chains. Give this some time. Once the node is finished bootstrapping, the response will be: ``` { "jsonrpc": "2.0", "result": { "isBootstrapped": true }, "id": 1 } ``` We can always use `sudo systemctl status avalanchego` to peek at the latest status of our service as before, as well. ### Get Your NodeID[​](#get-your-nodeid "Direct link to heading") We absolutely must get our NodeID if we plan to do any validating on this node. This is retrieved from the RPC as well. We call the following curl command to get our NodeID. ``` curl -X POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"info.getNodeID" }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` If all is well, the response should look something like: ``` {"jsonrpc":"2.0","result":{"nodeID":"NodeID-Lve2PzuCvXZrqn8Stqwy9vWZux6VyGUCR"},"id":1} ``` That portion that says, "NodeID-Lve2PzuCvXZrqn8Stqwy9vWZux6VyGUCR" is our NodeID, the entire thing. Copy that and keep that in our notes. There's nothing confidential or secure about this value, but it's an absolute must for when we submit this node to be a validator. ### Backup Your Staking Keys[​](#backup-your-staking-keys "Direct link to heading") The last thing that should be done is backing up our staking keys in the untimely event that our instance is corrupted or terminated. It's just good practice for us to keep these keys. To back them up, we use the following command: ``` scp -i C:\Avalanche\avalanche_key.pem -r ubuntu@EnterYourAzureIPHere:/home/ubuntu/.avalanchego/staking C:\Avalanche ``` As before, we'll need to replace "EnterYourAzureIPHere" with the appropriate value that we retrieved. This backs up our staking key and staking certificate into the C:\\Avalanche folder we created before. ![Image for post](/images/azure47.png) # Installing AvalancheGo (/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) --- title: Installing AvalancheGo description: Learn how to install AvalancheGo on your system. --- ## Running the Script So, now that you prepared your system and have the info ready, let's get to it. To download and run the script, enter the following in the terminal: ```bash wget -nd -m https://raw.githubusercontent.com/ava-labs/avalanche-docs/master/scripts/avalanchego-installer.sh;\ chmod 755 avalanchego-installer.sh;\ ./avalanchego-installer.sh ``` And we're off! The output should look something like this: ```bash AvalancheGo installer --------------------- Preparing environment... Found arm64 architecture... Looking for the latest arm64 build... Will attempt to download: https://github.com/ava-labs/avalanchego/releases/download/v1.1.1/avalanchego-linux-arm64-v1.1.1.tar.gz avalanchego-linux-arm64-v1.1.1.tar.gz 100%[=========================================================================>] 29.83M 75.8MB/s in 0.4s 2020-12-28 14:57:47 URL:https://github-production-release-asset-2e65be.s3.amazonaws.com/246387644/f4d27b00-4161-11eb-8fb2-156a992fd2c8?X-Amz-Algorithm=AWS4-HMAC-SHA256&X-Amz-Credential=AKIAIWNJYAX4CSVEH53A%2F20201228%2Fus-east-1%2Fs3%2Faws4_request&X-Amz-Date=20201228T145747Z&X-Amz-Expires=300&X-Amz-Signature=ea838877f39ae940a37a076137c4c2689494c7e683cb95a5a4714c062e6ba018&X-Amz-SignedHeaders=host&actor_id=0&key_id=0&repo_id=246387644&response-content-disposition=attachment%3B%20filename%3Davalanchego-linux-arm64-v1.1.1.tar.gz&response-content-type=application%2Foctet-stream [31283052/31283052] -> "avalanchego-linux-arm64-v1.1.1.tar.gz" [1] Unpacking node files... avalanchego-v1.1.1/plugins/ avalanchego-v1.1.1/plugins/evm avalanchego-v1.1.1/avalanchego Node files unpacked into /home/ubuntu/avalanche-node ``` And then the script will prompt you for information about the network environment: ```bash To complete the setup some networking information is needed. Where is the node installed: 1) residential network (dynamic IP) 2) cloud provider (static IP) Enter your connection type [1,2]: ``` Enter `1` if you have dynamic IP, and `2` if you have a static IP. If you are on a static IP, it will try to auto-detect the IP and ask for confirmation. ```bash Detected '3.15.152.14' as your public IP. Is this correct? [y,n]: ``` Confirm with `y`, or `n` if the detected IP is wrong (or empty), and then enter the correct IP at the next prompt. Next, you have to set up RPC port access for your node. Those are used to query the node for its internal state, to send commands to the node, or to interact with the platform and its chains (sending transactions, for example). You will be prompted: ```bash RPC port should be public (this is a public API node) or private (this is a validator)? [public, private]: ``` - `private`: this setting only allows RPC requests from the node machine itself. - `public`: this setting exposes the RPC port to all network interfaces. As this is a sensitive setting you will be asked to confirm if choosing `public`. Please read the following note carefully: If you choose to allow RPC requests on any network interface you will need to set up a firewall to only let through RPC requests from known IP addresses, otherwise your node will be accessible to anyone and might be overwhelmed by RPC calls from malicious actors! If you do not plan to use your node to send RPC calls remotely, enter `private`. The script will then prompt you to choose whether to enable state sync setting or not: ```bash Do you want state sync bootstrapping to be turned on or off? [on, off]: ``` Turning state sync on will greatly increase the speed of bootstrapping, but will sync only the current network state. If you intend to use your node for accessing historical data (archival node) you should select `off`. Otherwise, select `on`. Validators can be bootstrapped with state sync turned on. The script will then continue with system service creation and finish with starting the service. ```bash Created symlink /etc/systemd/system/multi-user.target.wants/avalanchego.service → /etc/systemd/system/avalanchego.service. Done! Your node should now be bootstrapping. Node configuration file is /home/ubuntu/.avalanchego/configs/node.json C-Chain configuration file is /home/ubuntu/.avalanchego/configs/chains/C/config.json Plugin directory, for storing subnet VM binaries, is /home/ubuntu/.avalanchego/plugins To check that the service is running use the following command (q to exit): sudo systemctl status avalanchego To follow the log use (ctrl-c to stop): sudo journalctl -u avalanchego -f Reach us over on https://discord.gg/avax if you're having problems. ``` The script is finished, and you should see the system prompt again. ## Post Installation AvalancheGo should be running in the background as a service. You can check that it's running with: ```bash sudo systemctl status avalanchego ``` Below is an example of what the node's latest logs should look like: ```bash ● avalanchego.service - AvalancheGo systemd service Loaded: loaded (/etc/systemd/system/avalanchego.service; enabled; vendor preset: enabled) Active: active (running) since Tue 2021-01-05 10:38:21 UTC; 51s ago Main PID: 2142 (avalanchego) Tasks: 8 (limit: 4495) Memory: 223.0M CGroup: /system.slice/avalanchego.service └─2142 /home/ubuntu/avalanche-node/avalanchego --public-ip-resolution-service=opendns --http-host= Jan 05 10:38:45 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:38:45]

avalanchego/vms/platformvm/vm.go#322: initializing last accepted block as 2FUFPVPxbTpKNn39moGSzsmGroYES4NZRdw3mJgNvMkMiMHJ9e Jan 05 10:38:45 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:38:45]

avalanchego/snow/engine/snowman/transitive.go#58: initializing consensus engine Jan 05 10:38:45 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:38:45] avalanchego/api/server.go#143: adding route /ext/bc/11111111111111111111111111111111LpoYY Jan 05 10:38:45 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:38:45] avalanchego/api/server.go#88: HTTP API server listening on ":9650" Jan 05 10:38:58 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:38:58]

avalanchego/snow/engine/common/bootstrapper.go#185: Bootstrapping started syncing with 1 vertices in the accepted frontier Jan 05 10:39:02 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:39:02]

avalanchego/snow/engine/snowman/bootstrap/bootstrapper.go#210: fetched 2500 blocks Jan 05 10:39:04 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:39:04]

avalanchego/snow/engine/snowman/bootstrap/bootstrapper.go#210: fetched 5000 blocks Jan 05 10:39:06 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:39:06]

avalanchego/snow/engine/snowman/bootstrap/bootstrapper.go#210: fetched 7500 blocks Jan 05 10:39:09 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:39:09]

avalanchego/snow/engine/snowman/bootstrap/bootstrapper.go#210: fetched 10000 blocks Jan 05 10:39:11 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:39:11]

avalanchego/snow/engine/snowman/bootstrap/bootstrapper.go#210: fetched 12500 blocks ``` Note the `active (running)` which indicates the service is running OK. You may need to press `q` to return to the command prompt. To find out your NodeID, which is used to identify your node to the network, run the following command: ```bash sudo journalctl -u avalanchego | grep "NodeID" ``` It will produce output like: ```bash Jan 05 10:38:38 ip-172-31-30-64 avalanchego[2142]: INFO [01-05|10:38:38] avalanchego/node/node.go#428: Set node's ID to 6seStrauyCnVV7NEVwRbfaT9B6EnXEzfY ``` Prepend `NodeID-` to the value to get, for example, `NodeID-6seStrauyCnVV7NEVwRbfaT9B6EnXEzfY`. Store that; it will be needed for staking or looking up your node. Your node should be in the process of bootstrapping now. You can monitor the progress by issuing the following command: ```bash sudo journalctl -u avalanchego -f ``` Press `ctrl+C` when you wish to stop reading node output. # Managing AvalancheGo (/docs/nodes/run-a-node/using-install-script/managing-avalanche-go) --- title: Managing AvalancheGo description: Learn how to start, stop and upgrade your AvalancheGo node --- ## Stop Your Node To stop AvalancheGo, run: ```bash sudo systemctl stop avalanchego ``` ## Start Your Node To start your node again, run: ```bash sudo systemctl start avalanchego ``` ## Upgrade Your Node AvalancheGo is an ongoing project and there are regular version upgrades. Most upgrades are recommended but not required. Advance notice will be given for upgrades that are not backwards compatible. When a new version of the node is released, you will notice log lines like: ```bash Jan 08 10:26:45 ip-172-31-16-229 avalanchego[6335]: INFO [01-08|10:26:45] avalanchego/network/peer.go#526: beacon 9CkG9MBNavnw7EVSRsuFr7ws9gascDQy3 attempting to connect with newer version avalanche/1.1.1. You may want to update your client ``` It is recommended to always upgrade to the latest version, because new versions bring bug fixes, new features and upgrades. To upgrade your node, just run the installer script again: ```bash ./avalanchego-installer.sh ``` It will detect that you already have AvalancheGo installed: ```bash AvalancheGo installer --------------------- Preparing environment... Found 64bit Intel/AMD architecture... Found AvalancheGo systemd service already installed, switching to upgrade mode. Stopping service... ``` It will then upgrade your node to the latest version, and after it's done, start the node back up, and print out the information about the latest version: ```bash Node upgraded, starting service... New node version: avalanche/1.1.1 [network=mainnet, database=v1.0.0, commit=f76f1fd5f99736cf468413bbac158d6626f712d2] Done! ``` # Node Config and Maintenance (/docs/nodes/run-a-node/using-install-script/node-config-maintenance) --- title: Node Config and Maintenance description: Advanced options for configuring and maintaining your AvalancheGo node. --- ## Advanced Node Configuration Without any additional arguments, the script installs the node in a most common configuration. But the script also enables various advanced options to be configured, via the command line prompts. Following is a list of advanced options and their usage: - `admin` - [Admin API](/docs/rpcs/other/admin-rpc) will be enabled - `archival` - disables database pruning and preserves the complete transaction history - `state-sync` - if `on` state-sync for the C-Chain is used, if `off` it will use regular transaction replay to bootstrap; state-sync is much faster, but has no historical data - `db-dir` - use to provide the full path to the location where the database will be stored - `fuji` - node will connect to Fuji testnet instead of the Mainnet - `index` - [Index API](/docs/rpcs/other/index-rpc) will be enabled - `ip` - use `dynamic`, `static` arguments, of enter a desired IP directly to be used as the public IP node will advertise to the network - `rpc` - use `any` or `local` argument to select any or local network interface to be used to listen for RPC calls - `version` - install a specific node version, instead of the latest. See [here](#using-a-previous-version) for usage. Configuring the `index` and `archival` options on an existing node will require a fresh bootstrap to recreate the database. Complete script usage can be displayed by entering: ```bash ./avalanchego-installer.sh --help ``` ### Unattended Installation[​](#unattended-installation "Direct link to heading") If you want to use the script in an automated environment where you cannot enter the data at the prompts you must provide at least the `rpc` and `ip` options. For example: ```bash ./avalanchego-installer.sh --ip 1.2.3.4 --rpc local ``` ### Usage Examples[​](#usage-examples "Direct link to heading") - To run a Fuji node with indexing enabled and autodetected static IP: ```bash ./avalanchego-installer.sh --fuji --ip static --index ``` - To run an archival Mainnet node with dynamic IP and database located at `/home/node/db`: ```bash ./avalanchego-installer.sh --archival --ip dynamic --db-dir /home/node/db ``` - To use C-Chain state-sync to quickly bootstrap a Mainnet node, with dynamic IP and local RPC only: ```bash ./avalanchego-installer.sh --state-sync on --ip dynamic --rpc local ``` - To reinstall the node using node version 1.7.10 and use specific IP and local RPC only: ```bash ./avalanchego-installer.sh --reinstall --ip 1.2.3.4 --version v1.7.10 --rpc local ``` Node Configuration[​](#node-configuration "Direct link to heading") ------------------------------------------------------------------- The file that configures node operation is `~/.avalanchego/configs/node.json`. You can edit it to add or change configuration options. The documentation of configuration options can be found [here](/docs/nodes/configure/configs-flags). Configuration may look like this: ```json { "public-ip-resolution-service": "opendns", "http-host": "" } ``` Note that the configuration file needs to be a properly formatted `JSON` file, so switches should formatted differently than they would be for the command line. Therefore, don't enter options like `--public-ip-resolution-service=opendns` as shown in the example above. The script also creates an empty C-Chain config file, located at `~/.avalanchego/configs/chains/C/config.json`. By editing that file, you can configure the C-Chain, as described in detail [here](/docs/nodes/configure/configs-flags). Using a Previous Version[​](#using-a-previous-version "Direct link to heading") ------------------------------------------------------------------------------- The installer script can also be used to install a version of AvalancheGo other than the latest version. To see a list of available versions for installation, run: ```bash ./avalanchego-installer.sh --list ``` It will print out a list, something like: ```bash AvalancheGo installer --------------------- Available versions: v1.3.2 v1.3.1 v1.3.0 v1.2.4-arm-fix v1.2.4 v1.2.3-signed v1.2.3 v1.2.2 v1.2.1 v1.2.0 ``` To install a specific version, run the script with `--version` followed by the tag of the version. For example: ```bash ./avalanchego-installer.sh --version v1.3.1 ``` Note that not all AvalancheGo versions are compatible. You should generally run the latest version. Running a version other than latest may lead to your node not working properly and, for validators, not receiving a staking reward. Thanks to community member [Jean Zundel](https://github.com/jzu) for the inspiration and help implementing support for installing non-latest node versions. Reinstall and Script Update[​](#reinstall-and-script-update "Direct link to heading") ------------------------------------------------------------------------------------- The installer script gets updated from time to time, with new features and capabilities added. To take advantage of new features or to recover from modifications that made the node fail, you may want to reinstall the node. To do that, fetch the latest version of the script from the web with: ```bash wget -nd -m https://raw.githubusercontent.com/ava-labs/builders-hub/master/scripts/avalanchego-installer.sh ``` After the script has updated, run it again with the `--reinstall` config flag: ```bash ./avalanchego-installer.sh --reinstall ``` This will delete the existing service file, and run the installer from scratch, like it was started for the first time. Note that the database and NodeID will be left intact. Removing the Node Installation[​](#removing-the-node-installation "Direct link to heading") ------------------------------------------------------------------------------------------- If you want to remove the node installation from the machine, you can run the script with the `--remove` option, like this: ```bash ./avalanchego-installer.sh --remove ``` This will remove the service, service definition file and node binaries. It will not remove the working directory, node ID definition or the node database. To remove those as well, you can type: Please note that this is irreversible and the database and node ID will be deleted! What Next?[​](#what-next "Direct link to heading") -------------------------------------------------- That's it, you're running an AvalancheGo node! Congratulations! Let us know you did it on our [X](https://x.com/avax), [Telegram](https://t.me/avalancheavax) or [Reddit](https://www.reddit.com/r/Avax/)! If you're on a residential network (dynamic IP), don't forget to set up port forwarding. If you're on a cloud service provider, you're good to go. Now you can [interact with your node](/docs/rpcs/other/guides/issuing-api-calls), [stake your tokens](/docs/primary-network/validate/what-is-staking), or level up your installation by setting up [node monitoring](/docs/nodes/maintain/monitoring) to get a better insight into what your node is doing. Also, you might want to use our [Postman Collection](/docs/tooling/avalanche-postman) to more easily issue commands to your node. Finally, if you haven't already, it is a good idea to [back up](/docs/nodes/maintain/backup-restore) important files in case you ever need to restore your node to a different machine. If you have any questions, or need help, feel free to contact us on our [Discord](https://chat.avalabs.org/) server. # Preparing Your Environment (/docs/nodes/run-a-node/using-install-script/preparing-environment) --- title: Preparing Your Environment description: Learn how to prepare your environment before using install script. --- We have a shell (bash) script that installs AvalancheGo on your computer. This script sets up full, running node in a matter of minutes with minimal user input required. Script can also be used for unattended, automated installs. This install script assumes: - AvalancheGo is not running and not already installed as a service - User running the script has superuser privileges (can run `sudo`) Environment Considerations[​](#environment-considerations "Direct link to heading") ----------------------------------------------------------------------------------- If you run a different flavor of Linux, the script might not work as intended. It assumes `systemd` is used to run system services. Other Linux flavors might use something else, or might have files in different places than is assumed by the script. It will probably work on any distribution that uses `systemd` but it has been developed for and tested on Ubuntu. If you have a node already running on the computer, stop it before running the script. Script won't touch the node working directory so you won't need to bootstrap the node again. ### Node Running from Terminal[​](#node-running-from-terminal "Direct link to heading") If your node is running in a terminal stop it by pressing `ctrl+C`. ### Node Running as a Service[​](#node-running-as-a-service "Direct link to heading") If your node is already running as a service, then you probably don't need this script. You're good to go. ### Node Running in the Background[​](#node-running-in-the-background "Direct link to heading") If your node is running in the background (by running with `nohup`, for example) then find the process running the node by running `ps aux | grep avalanche`. This will produce output like: ```bash ubuntu 6834 0.0 0.0 2828 676 pts/1 S+ 19:54 0:00 grep avalanche ubuntu 2630 26.1 9.4 2459236 753316 ? Sl Dec02 1220:52 /home/ubuntu/build/avalanchego ``` Look for line that doesn't have `grep` on it. In this example, that is the second line. It shows information about your node. Note the process id, in this case, `2630`. Stop the node by running `kill -2 2630`. ### Node Working Files[​](#node-working-files "Direct link to heading") If you previously ran an AvalancheGo node on this computer, you will have local node files stored in `$HOME/.avalanchego` directory. Those files will not be disturbed, and node set up by the script will continue operation with the same identity and state it had before. That being said, for your node's security, back up `staker.crt` and `staker.key` files, found in `$HOME/.avalanchego/staking` and store them somewhere secure. You can use those files to recreate your node on a different computer if you ever need to. Check out this [tutorial](/docs/nodes/maintain/backup-restore) for backup and restore procedure. Networking Considerations[​](#networking-considerations "Direct link to heading") --------------------------------------------------------------------------------- To run successfully, AvalancheGo needs to accept connections from the Internet on the network port `9651`. Before you proceed with the installation, you need to determine the networking environment your node will run in. ### Running on a Cloud Provider[​](#running-on-a-cloud-provider "Direct link to heading") If your node is running on a cloud provider computer instance, it will have a static IP. Find out what that static IP is, or set it up if you didn't already. The script will try to find out the IP by itself, but that might not work in all environments, so you will need to check the IP or enter it yourself. ### Running on a Home Connection[​](#running-on-a-home-connection "Direct link to heading") If you're running a node on a computer that is on a residential internet connection, you have a dynamic IP; that is, your IP will change periodically. The install script will configure the node appropriately for that situation. But, for a home connection, you will need to set up inbound port forwarding of port `9651` from the internet to the computer the node is installed on. As there are too many models and router configurations, we cannot provide instructions on what exactly to do, but there are online guides to be found (like [this](https://www.noip.com/support/knowledgebase/general-port-forwarding-guide/), or [this](https://www.howtogeek.com/66214/how-to-forward-ports-on-your-router/) ), and your service provider support might help too. Please note that a fully connected Avalanche node maintains and communicates over a couple of thousand of live TCP connections. For some low-powered and older home routers that might be too much to handle. If that is the case you may experience lagging on other computers connected to the same router, node getting benched, failing to sync and similar issues. # avax.getAtomicTx (/docs/rpcs/c-chain/avalanche/avax_getAtomicTx) --- title: avax.getAtomicTx full: true _openapi: method: POST route: /ext/bc/C/avax#avax.getAtomicTx toc: [] structuredData: headings: [] contents: - content: Returns the specified atomic transaction. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the specified atomic transaction. # avax.getAtomicTxStatus (/docs/rpcs/c-chain/avalanche/avax_getAtomicTxStatus) --- title: avax.getAtomicTxStatus full: true _openapi: method: POST route: /ext/bc/C/avax#avax.getAtomicTxStatus toc: [] structuredData: headings: [] contents: - content: Returns the status of the specified atomic transaction. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the status of the specified atomic transaction. # avax.getUTXOs (/docs/rpcs/c-chain/avalanche/avax_getUTXOs) --- title: avax.getUTXOs full: true _openapi: method: POST route: /ext/bc/C/avax#avax.getUTXOs toc: [] structuredData: headings: [] contents: - content: Gets all UTXOs for the specified addresses. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets all UTXOs for the specified addresses. # avax.issueTx (/docs/rpcs/c-chain/avalanche/avax_issueTx) --- title: avax.issueTx full: true _openapi: method: POST route: /ext/bc/C/avax#avax.issueTx toc: [] structuredData: headings: [] contents: - content: Issues a transaction to the network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Issues a transaction to the network. # eth_suggestPriceOptions (/docs/rpcs/c-chain/avalanche/eth_suggestPriceOptions) --- title: eth_suggestPriceOptions full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_suggestPriceOptions toc: [] structuredData: headings: [] contents: - content: Returns suggested fee options (Coreth extension). --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns suggested fee options (Coreth extension). # debug_getRawBlock (/docs/rpcs/c-chain/debug/debug_getRawBlock) --- title: debug_getRawBlock full: true _openapi: method: POST route: /ext/bc/C/rpc#debug_getRawBlock toc: [] structuredData: headings: [] contents: - content: > Returns RLP-encoded bytes of a single block by number or hash. **⚠️ Note:** This method is NOT available on public RPC endpoints. You must run your own node or use a dedicated node service to access debug methods. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns RLP-encoded bytes of a single block by number or hash. **⚠️ Note:** This method is NOT available on public RPC endpoints. You must run your own node or use a dedicated node service to access debug methods. # debug_getRawTransaction (/docs/rpcs/c-chain/debug/debug_getRawTransaction) --- title: debug_getRawTransaction full: true _openapi: method: POST route: /ext/bc/C/rpc#debug_getRawTransaction toc: [] structuredData: headings: [] contents: - content: > Returns the bytes of the transaction for the given hash. **⚠️ Note:** This method is NOT available on public RPC endpoints. You must run your own node or use a dedicated node service to access debug methods. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the bytes of the transaction for the given hash. **⚠️ Note:** This method is NOT available on public RPC endpoints. You must run your own node or use a dedicated node service to access debug methods. # eth_accounts (/docs/rpcs/c-chain/eth/eth_accounts) --- title: eth_accounts full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_accounts toc: [] structuredData: headings: [] contents: - content: > Returns a list of addresses owned by the client. **Note:** Public RPC endpoints will return an empty array as they don't manage any accounts. This method only returns accounts when using a node you control with unlocked accounts. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns a list of addresses owned by the client. **Note:** Public RPC endpoints will return an empty array as they don't manage any accounts. This method only returns accounts when using a node you control with unlocked accounts. # eth_blockNumber (/docs/rpcs/c-chain/eth/eth_blockNumber) --- title: eth_blockNumber full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_blockNumber toc: [] structuredData: headings: [] contents: - content: Returns the block number of the chain head. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the block number of the chain head. # eth_call (/docs/rpcs/c-chain/eth/eth_call) --- title: eth_call full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_call toc: [] structuredData: headings: [] contents: - content: Executes a call without sending a transaction. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Executes a call without sending a transaction. # eth_chainId (/docs/rpcs/c-chain/eth/eth_chainId) --- title: eth_chainId full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_chainId toc: [] structuredData: headings: [] contents: - content: Returns the chain ID of the current network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the chain ID of the current network. # eth_coinbase (/docs/rpcs/c-chain/eth/eth_coinbase) --- title: eth_coinbase full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_coinbase toc: [] structuredData: headings: [] contents: - content: > Returns the client coinbase address. **Note:** On public RPC endpoints, this returns the node operator's coinbase address, not yours. This method is mainly useful when running your own node. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the client coinbase address. **Note:** On public RPC endpoints, this returns the node operator's coinbase address, not yours. This method is mainly useful when running your own node. # eth_estimateGas (/docs/rpcs/c-chain/eth/eth_estimateGas) --- title: eth_estimateGas full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_estimateGas toc: [] structuredData: headings: [] contents: - content: Returns the lowest gas limit for a transaction to succeed. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the lowest gas limit for a transaction to succeed. # eth_feeHistory (/docs/rpcs/c-chain/eth/eth_feeHistory) --- title: eth_feeHistory full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_feeHistory toc: [] structuredData: headings: [] contents: - content: Returns the fee market history. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the fee market history. # eth_gasPrice (/docs/rpcs/c-chain/eth/eth_gasPrice) --- title: eth_gasPrice full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_gasPrice toc: [] structuredData: headings: [] contents: - content: Returns a suggestion for a legacy gas price. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns a suggestion for a legacy gas price. # eth_getBalance (/docs/rpcs/c-chain/eth/eth_getBalance) --- title: eth_getBalance full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getBalance toc: [] structuredData: headings: [] contents: - content: Returns the balance of the account of given address. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the balance of the account of given address. # eth_getBlockByHash (/docs/rpcs/c-chain/eth/eth_getBlockByHash) --- title: eth_getBlockByHash full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getBlockByHash toc: [] structuredData: headings: [] contents: - content: >- Returns the block for a given hash. Second param selects full transactions. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the block for a given hash. Second param selects full transactions. # eth_getBlockByNumber (/docs/rpcs/c-chain/eth/eth_getBlockByNumber) --- title: eth_getBlockByNumber full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getBlockByNumber toc: [] structuredData: headings: [] contents: - content: >- Returns the block for a given number. Second param selects full transactions. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the block for a given number. Second param selects full transactions. # eth_getBlockTransactionCountByHash (/docs/rpcs/c-chain/eth/eth_getBlockTransactionCountByHash) --- title: eth_getBlockTransactionCountByHash full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getBlockTransactionCountByHash toc: [] structuredData: headings: [] contents: - content: >- Returns the number of transactions in a block from a block matching the given block hash. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the number of transactions in a block from a block matching the given block hash. # eth_getBlockTransactionCountByNumber (/docs/rpcs/c-chain/eth/eth_getBlockTransactionCountByNumber) --- title: eth_getBlockTransactionCountByNumber full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getBlockTransactionCountByNumber toc: [] structuredData: headings: [] contents: - content: >- Returns the number of transactions in a block matching the given block number. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the number of transactions in a block matching the given block number. # eth_getCode (/docs/rpcs/c-chain/eth/eth_getCode) --- title: eth_getCode full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getCode toc: [] structuredData: headings: [] contents: - content: Returns code at a given address. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns code at a given address. # eth_getFilterChanges (/docs/rpcs/c-chain/eth/eth_getFilterChanges) --- title: eth_getFilterChanges full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getFilterChanges toc: [] structuredData: headings: [] contents: - content: >- Polling method for a filter, which returns an array of logs which occurred since last poll. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Polling method for a filter, which returns an array of logs which occurred since last poll. # eth_getFilterLogs (/docs/rpcs/c-chain/eth/eth_getFilterLogs) --- title: eth_getFilterLogs full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getFilterLogs toc: [] structuredData: headings: [] contents: - content: Returns an array of all logs matching filter with given id. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns an array of all logs matching filter with given id. # eth_getLogs (/docs/rpcs/c-chain/eth/eth_getLogs) --- title: eth_getLogs full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getLogs toc: [] structuredData: headings: [] contents: - content: Returns logs matching the given filter object. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns logs matching the given filter object. # eth_getStorageAt (/docs/rpcs/c-chain/eth/eth_getStorageAt) --- title: eth_getStorageAt full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getStorageAt toc: [] structuredData: headings: [] contents: - content: Returns the value from a storage position at a given address. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the value from a storage position at a given address. # eth_getTransactionByBlockHashAndIndex (/docs/rpcs/c-chain/eth/eth_getTransactionByBlockHashAndIndex) --- title: eth_getTransactionByBlockHashAndIndex full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getTransactionByBlockHashAndIndex toc: [] structuredData: headings: [] contents: - content: >- Returns information about a transaction by block hash and transaction index position. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns information about a transaction by block hash and transaction index position. # eth_getTransactionByBlockNumberAndIndex (/docs/rpcs/c-chain/eth/eth_getTransactionByBlockNumberAndIndex) --- title: eth_getTransactionByBlockNumberAndIndex full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getTransactionByBlockNumberAndIndex toc: [] structuredData: headings: [] contents: - content: >- Returns information about a transaction by block number and transaction index position. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns information about a transaction by block number and transaction index position. # eth_getTransactionByHash (/docs/rpcs/c-chain/eth/eth_getTransactionByHash) --- title: eth_getTransactionByHash full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getTransactionByHash toc: [] structuredData: headings: [] contents: - content: >- Returns the information about a transaction requested by transaction hash. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the information about a transaction requested by transaction hash. # eth_getTransactionCount (/docs/rpcs/c-chain/eth/eth_getTransactionCount) --- title: eth_getTransactionCount full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getTransactionCount toc: [] structuredData: headings: [] contents: - content: Returns the number of transactions sent from an address. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the number of transactions sent from an address. # eth_getTransactionReceipt (/docs/rpcs/c-chain/eth/eth_getTransactionReceipt) --- title: eth_getTransactionReceipt full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_getTransactionReceipt toc: [] structuredData: headings: [] contents: - content: Returns the receipt of a transaction by transaction hash. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the receipt of a transaction by transaction hash. # eth_maxPriorityFeePerGas (/docs/rpcs/c-chain/eth/eth_maxPriorityFeePerGas) --- title: eth_maxPriorityFeePerGas full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_maxPriorityFeePerGas toc: [] structuredData: headings: [] contents: - content: Returns a suggestion for a tip cap for dynamic fee transactions. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns a suggestion for a tip cap for dynamic fee transactions. # eth_newBlockFilter (/docs/rpcs/c-chain/eth/eth_newBlockFilter) --- title: eth_newBlockFilter full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_newBlockFilter toc: [] structuredData: headings: [] contents: - content: > Creates a filter in the node, to notify when a new block arrives. **⚠️ Note:** Filter methods may not be available or may have limited functionality on public RPC endpoints as they require server-side state management. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Creates a filter in the node, to notify when a new block arrives. **⚠️ Note:** Filter methods may not be available or may have limited functionality on public RPC endpoints as they require server-side state management. # eth_newFilter (/docs/rpcs/c-chain/eth/eth_newFilter) --- title: eth_newFilter full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_newFilter toc: [] structuredData: headings: [] contents: - content: > Creates a filter object, based on filter options, to notify when the state changes (logs). **⚠️ Note:** Filter methods may not be available or may have limited functionality on public RPC endpoints as they require server-side state management. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Creates a filter object, based on filter options, to notify when the state changes (logs). **⚠️ Note:** Filter methods may not be available or may have limited functionality on public RPC endpoints as they require server-side state management. # eth_newPendingTransactionFilter (/docs/rpcs/c-chain/eth/eth_newPendingTransactionFilter) --- title: eth_newPendingTransactionFilter full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_newPendingTransactionFilter toc: [] structuredData: headings: [] contents: - content: > Creates a filter in the node, to notify when new pending transactions arrive. **⚠️ Note:** Filter methods may not be available or may have limited functionality on public RPC endpoints as they require server-side state management. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Creates a filter in the node, to notify when new pending transactions arrive. **⚠️ Note:** Filter methods may not be available or may have limited functionality on public RPC endpoints as they require server-side state management. # eth_protocolVersion (/docs/rpcs/c-chain/eth/eth_protocolVersion) --- title: eth_protocolVersion full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_protocolVersion toc: [] structuredData: headings: [] contents: - content: Returns the current ethereum protocol version. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the current ethereum protocol version. # eth_sendRawTransaction (/docs/rpcs/c-chain/eth/eth_sendRawTransaction) --- title: eth_sendRawTransaction full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_sendRawTransaction toc: [] structuredData: headings: [] contents: - content: Submits a signed raw transaction. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Submits a signed raw transaction. # eth_sign (/docs/rpcs/c-chain/eth/eth_sign) --- title: eth_sign full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_sign toc: [] structuredData: headings: [] contents: - content: > Signs data with a given address. **⚠️ Security Note:** This method is typically disabled on public RPC endpoints for security reasons. It requires access to private keys and should only be used on nodes you control. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Signs data with a given address. **⚠️ Security Note:** This method is typically disabled on public RPC endpoints for security reasons. It requires access to private keys and should only be used on nodes you control. # eth_uninstallFilter (/docs/rpcs/c-chain/eth/eth_uninstallFilter) --- title: eth_uninstallFilter full: true _openapi: method: POST route: /ext/bc/C/rpc#eth_uninstallFilter toc: [] structuredData: headings: [] contents: - content: Uninstalls a filter with given id. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Uninstalls a filter with given id. # net_version (/docs/rpcs/c-chain/net/net_version) --- title: net_version full: true _openapi: method: POST route: /ext/bc/C/rpc#net_version toc: [] structuredData: headings: [] contents: - content: Returns the current network ID as a string. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the current network ID as a string. # personal_newAccount (/docs/rpcs/c-chain/personal/personal_newAccount) --- title: personal_newAccount full: true _openapi: method: POST route: /ext/bc/C/rpc#personal_newAccount toc: [] structuredData: headings: [] contents: - content: > Creates a new account with the given password. **⚠️ Security Note:** This method is NOT available on public RPC endpoints for security reasons. Personal methods manage private keys and must only be used on nodes you control. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Creates a new account with the given password. **⚠️ Security Note:** This method is NOT available on public RPC endpoints for security reasons. Personal methods manage private keys and must only be used on nodes you control. # personal_unlockAccount (/docs/rpcs/c-chain/personal/personal_unlockAccount) --- title: personal_unlockAccount full: true _openapi: method: POST route: /ext/bc/C/rpc#personal_unlockAccount toc: [] structuredData: headings: [] contents: - content: > Unlocks an account with the given password and optional duration. **⚠️ Security Note:** This method is NOT available on public RPC endpoints for security reasons. Personal methods manage private keys and must only be used on nodes you control. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Unlocks an account with the given password and optional duration. **⚠️ Security Note:** This method is NOT available on public RPC endpoints for security reasons. Personal methods manage private keys and must only be used on nodes you control. # txpool_status (/docs/rpcs/c-chain/txpool/txpool_status) --- title: txpool_status full: true _openapi: method: POST route: /ext/bc/C/rpc#txpool_status toc: [] structuredData: headings: [] contents: - content: > Returns transaction pool status. **⚠️ Note:** This method may be restricted or rate-limited on public RPC endpoints. Consider running your own node for unrestricted access. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns transaction pool status. **⚠️ Note:** This method may be restricted or rate-limited on public RPC endpoints. Consider running your own node for unrestricted access. # web3_clientVersion (/docs/rpcs/c-chain/web3/web3_clientVersion) --- title: web3_clientVersion full: true _openapi: method: POST route: /ext/bc/C/rpc#web3_clientVersion toc: [] structuredData: headings: [] contents: - content: Returns the client version. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the client version. # Banff Changes (/docs/rpcs/other/guides/banff-changes) --- title: Banff Changes description: This document specifies the changes in Avalanche “Banff”, which was released in AvalancheGo v1.9.x. --- Block Changes[​](#block-changes "Direct link to heading") --------------------------------------------------------- ### Apricot[​](#apricot "Direct link to heading") Apricot allows the following block types with the following content: - _Standard Blocks_ may contain multiple transactions of the following types: - CreateChainTx - CreateSubnetTx - ImportTx - ExportTx - _Proposal Blocks_ may contain a single transaction of the following types: - AddValidatorTx - AddDelegatorTx - AddSubnetValidatorTx - RewardValidatorTx - AdvanceTimeTx - _Options Blocks_, that is _Commit Block_ and _Abort Block_ do not contain any transactions. Each block has a header containing: - ParentID - Height ### Banff[​](#banff "Direct link to heading") Banff allows the following block types with the following content: - _Standard Blocks_ may contain multiple transactions of the following types: - CreateChainTx - CreateSubnetTx - ImportTx - ExportTx - AddValidatorTx - AddDelegatorTx - AddSubnetValidatorTx - _RemoveSubnetValidatorTx_ - _TransformSubnetTx_ - _AddPermissionlessValidatorTx_ - _AddPermissionlessDelegatorTx_ - _Proposal Blocks_ may contain a single transaction of the following types: - RewardValidatorTx - _Options blocks_, that is _Commit Block_ and _Abort Block_ do not contain any transactions. Note that each block has an header containing: - ParentID - Height - _Time_ So the two main differences with respect to Apricot are: - _AddValidatorTx_, _AddDelegatorTx_, _AddSubnetValidatorTx_ are included into Standard Blocks rather than Proposal Blocks so that they don't need to be voted on (that is followed by a Commit/Abort Block). - New Transaction types: _RemoveSubnetValidatorTx_, _TransformSubnetTx_, _AddPermissionlessValidatorTx_, and _AddPermissionlessDelegatorTx_ have been added into Standard Blocks. - Block timestamp is explicitly serialized into block header, to allow chain time update. ### New Transactions[​](#new-transactions "Direct link to heading") #### RemoveSubnetValidatorTx[​](#removesubnetvalidatortx "Direct link to heading") ``` type RemoveSubnetValidatorTx struct { BaseTx `serialize:"true"` // The node to remove from the Avalanche L1. NodeID ids.NodeID `serialize:"true" json:"nodeID"` // The Avalanche L1 to remove the node from. Subnet ids.ID `serialize:"true" json:"subnet"` // Proves that the issuer has the right to remove the node from the Avalanche L1. SubnetAuth verify.Verifiable `serialize:"true" json:"subnetAuthorization"` } ``` #### TransformSubnetTx[​](#transformsubnettx "Direct link to heading") ``` type TransformSubnetTx struct { // Metadata, inputs and outputs BaseTx `serialize:"true"` // ID of the Subnet to transform // Restrictions: // - Must not be the Primary Network ID Subnet ids.ID `serialize:"true" json:"subnetID"` // Asset to use when staking on the Avalanche L1 // Restrictions: // - Must not be the Empty ID // - Must not be the AVAX ID AssetID ids.ID `serialize:"true" json:"assetID"` // Amount to initially specify as the current supply // Restrictions: // - Must be > 0 InitialSupply uint64 `serialize:"true" json:"initialSupply"` // Amount to specify as the maximum token supply // Restrictions: // - Must be >= [InitialSupply] MaximumSupply uint64 `serialize:"true" json:"maximumSupply"` // MinConsumptionRate is the rate to allocate funds if the validator's stake // duration is 0 MinConsumptionRate uint64 `serialize:"true" json:"minConsumptionRate"` // MaxConsumptionRate is the rate to allocate funds if the validator's stake // duration is equal to the minting period // Restrictions: // - Must be >= [MinConsumptionRate] // - Must be <= [reward.PercentDenominator] MaxConsumptionRate uint64 `serialize:"true" json:"maxConsumptionRate"` // MinValidatorStake is the minimum amount of funds required to become a // validator. // Restrictions: // - Must be > 0 // - Must be <= [InitialSupply] MinValidatorStake uint64 `serialize:"true" json:"minValidatorStake"` // MaxValidatorStake is the maximum amount of funds a single validator can // be allocated, including delegated funds. // Restrictions: // - Must be >= [MinValidatorStake] // - Must be <= [MaximumSupply] MaxValidatorStake uint64 `serialize:"true" json:"maxValidatorStake"` // MinStakeDuration is the minimum number of seconds a staker can stake for. // Restrictions: // - Must be > 0 MinStakeDuration uint32 `serialize:"true" json:"minStakeDuration"` // MaxStakeDuration is the maximum number of seconds a staker can stake for. // Restrictions: // - Must be >= [MinStakeDuration] // - Must be <= [GlobalMaxStakeDuration] MaxStakeDuration uint32 `serialize:"true" json:"maxStakeDuration"` // MinDelegationFee is the minimum percentage a validator must charge a // delegator for delegating. // Restrictions: // - Must be <= [reward.PercentDenominator] MinDelegationFee uint32 `serialize:"true" json:"minDelegationFee"` // MinDelegatorStake is the minimum amount of funds required to become a // delegator. // Restrictions: // - Must be > 0 MinDelegatorStake uint64 `serialize:"true" json:"minDelegatorStake"` // MaxValidatorWeightFactor is the factor which calculates the maximum // amount of delegation a validator can receive. // Note: a value of 1 effectively disables delegation. // Restrictions: // - Must be > 0 MaxValidatorWeightFactor byte `serialize:"true" json:"maxValidatorWeightFactor"` // UptimeRequirement is the minimum percentage a validator must be online // and responsive to receive a reward. // Restrictions: // - Must be <= [reward.PercentDenominator] UptimeRequirement uint32 `serialize:"true" json:"uptimeRequirement"` // Authorizes this transformation SubnetAuth verify.Verifiable `serialize:"true" json:"subnetAuthorization"` } ``` #### AddPermissionlessValidatorTx[​](#addpermissionlessvalidatortx "Direct link to heading") ``` type AddPermissionlessValidatorTx struct { // Metadata, inputs and outputs BaseTx `serialize:"true"` // Describes the validator Validator validator.Validator `serialize:"true" json:"validator"` // ID of the Avalanche L1 this validator is validating Subnet ids.ID `serialize:"true" json:"subnet"` // Where to send staked tokens when done validating StakeOuts []*avax.TransferableOutput `serialize:"true" json:"stake"` // Where to send validation rewards when done validating ValidatorRewardsOwner fx.Owner `serialize:"true" json:"validationRewardsOwner"` // Where to send delegation rewards when done validating DelegatorRewardsOwner fx.Owner `serialize:"true" json:"delegationRewardsOwner"` // Fee this validator charges delegators as a percentage, times 10,000 // For example, if this validator has DelegationShares=300,000 then they // take 30% of rewards from delegators DelegationShares uint32 `serialize:"true" json:"shares"` } ``` #### AddPermissionlessDelegatorTx[​](#addpermissionlessdelegatortx "Direct link to heading") ``` type AddPermissionlessDelegatorTx struct { // Metadata, inputs and outputs BaseTx `serialize:"true"` // Describes the validator Validator validator.Validator `serialize:"true" json:"validator"` // ID of the Avalanche L1 this validator is validating Subnet ids.ID `serialize:"true" json:"subnet"` // Where to send staked tokens when done validating Stake []*avax.TransferableOutput `serialize:"true" json:"stake"` // Where to send staking rewards when done validating RewardsOwner fx.Owner `serialize:"true" json:"rewardsOwner"` } ``` #### New TypeIDs[​](#new-typeids "Direct link to heading") ``` ApricotProposalBlock = 0 ApricotAbortBlock = 1 ApricotCommitBlock = 2 ApricotStandardBlock = 3 ApricotAtomicBlock = 4 secp256k1fx.TransferInput = 5 secp256k1fx.MintOutput = 6 secp256k1fx.TransferOutput = 7 secp256k1fx.MintOperation = 8 secp256k1fx.Credential = 9 secp256k1fx.Input = 10 secp256k1fx.OutputOwners = 11 AddValidatorTx = 12 AddSubnetValidatorTx = 13 AddDelegatorTx = 14 CreateChainTx = 15 CreateSubnetTx = 16 ImportTx = 17 ExportTx = 18 AdvanceTimeTx = 19 RewardValidatorTx = 20 stakeable.LockIn = 21 stakeable.LockOut = 22 RemoveSubnetValidatorTx = 23 TransformSubnetTx = 24 AddPermissionlessValidatorTx = 25 AddPermissionlessDelegatorTx = 26 EmptyProofOfPossession = 27 BLSProofOfPossession = 28 BanffProposalBlock = 29 BanffAbortBlock = 30 BanffCommitBlock = 31 BanffStandardBlock = 32 ``` # Flow of a Single Blockchain (/docs/rpcs/other/guides/blockchain-flow) --- title: Flow of a Single Blockchain --- ![](/images/flow1.png) Intro[​](#intro "Direct link to heading") ----------------------------------------- The Avalanche network consists of 3 built-in blockchains: X-Chain, C-Chain, and P-Chain. The X-Chain is used to manage assets and uses the Avalanche consensus protocol. The C-Chain is used to create and interact with smart contracts and uses the Snowman consensus protocol. The P-Chain is used to coordinate validators and stake and also uses the Snowman consensus protocol. At the time of writing, the Avalanche network has ~1200 validators. A set of validators makes up an Avalanche L1. Avalanche L1s can validate 1 or more chains. It is a common misconception that 1 Avalanche L1 = 1 chain and this is shown by the primary Avalanche L1 of Avalanche which is made up of the X-Chain, C-Chain, and P-Chain. A node in the Avalanche network can either be a validator or a non-validator. A validator stakes AVAX tokens and participates in consensus to earn rewards. A non-validator does not participate in consensus or have any AVAX staked but can be used as an API server. Both validators and non-validators need to have their own copy of the chain and need to know the current state of the network. At the time of writing, there are ~1200 validators and ~1800 non-validators. Each blockchain on Avalanche has several components: the virtual machine, database, consensus engine, sender, and handler. These components help the chain run smoothly. Blockchains also interact with the P2P layer and the chain router to send and receive messages. Peer-to-Peer (P2P)[​](#peer-to-peer-p2p "Direct link to heading") ----------------------------------------------------------------- ### Outbound Messages[​](#outbound-messages "Direct link to heading") [The `OutboundMsgBuilder` interface](https://github.com/ava-labs/avalanchego/blob/master/message/outbound_msg_builder.go) specifies methods that build messages of type `OutboundMessage`. Nodes communicate to other nodes by sending `OutboundMessage` messages. All messaging functions in `OutboundMsgBuilder` can be categorized as follows: - **Handshake** - Nodes need to be on a certain version before they can be accepted into the network. - **State Sync** - A new node can ask other nodes for the current state of the network. It only syncs the required state for a specific block. - **Bootstrapping** - Nodes can ask other nodes for blocks to build their own copy of the chain. A node can fetch all blocks from the locally last accepted block to the current last accepted block in the network. - **Consensus** - Once a node is up to tip they can participate in consensus! During consensus, a node conducts a poll to several different small random samples of the validator set. They can communicate decisions on whether or not they have accepted/rejected a block. - **App** - VMs communicate application-specific messages to other nodes through app messages. A common example is mempool gossiping. Currently, AvalancheGo implements its own message serialization to communicate. In the future, AvalancheGo will use protocol buffers to communicate. ### Network[​](#network "Direct link to heading") [The networking interface](https://github.com/ava-labs/avalanchego/blob/master/network/network.go) is shared across all chains. It implements functions from the `ExternalSender` interface. The two functions it implements are `Send` and `Gossip`. `Send` sends a message of type `OutboundMessage` to a specific set of nodes (specified by an array of `NodeIDs`). `Gossip` sends a message of type `OutboundMessage` to a random group of nodes in an Avalanche L1 (can be a validator or a non-validator). Gossiping is used to push transactions across the network. The networking protocol uses TLS to pass messages between peers. Along with sending and gossiping, the networking library is also responsible for making connections and maintaining connections. Any node, either a validator or non-validator, will attempt to connect to the primary network. Router[​](#router "Direct link to heading") ------------------------------------------- [The `ChainRouter`](https://github.com/ava-labs/avalanchego/blob/master/snow/networking/router/chain_router.go) routes all incoming messages to its respective blockchain using `ChainID`. It does this by pushing all the messages onto the respective Chain handler's queue. The `ChainRouter` references all existing chains on the network such as the X-chain, C-chain, P-chain and possibly any other chain. The `ChainRouter` handles timeouts as well. When sending messages on the P2P layer, timeouts are registered on the sender and cleared on the `ChainRouter` side when a response is received. If no response is received, then it triggers a timeout. Because timeouts are handled on the `ChainRouter` side, the handler is reliable. Timeouts are triggered when peers do not respond and the `ChainRouter` will still notify the handler of failure cases. The timeout manager within `ChainRouter` is also adaptive. If the network is experiencing long latencies, timeouts will then be adjusted as well. Handler[​](#handler "Direct link to heading") --------------------------------------------- The main function of [the `Handler`](https://github.com/ava-labs/avalanchego/blob/master/snow/networking/handler/handler.go) is to pass messages from the network to the consensus engine. It receives these messages from the `ChainRouter`. It passes messages by pushing them onto a sync or Async queue (depends on message type). Messages are then popped from the queue, parsed, and routed to the correct function in consensus engine. This can be one of the following. - **State sync message (sync queue)** - **Bootstrapping message (sync queue)** - **Consensus message (sync queue)** - **App message (Async queue)** Sender[​](#sender "Direct link to heading") ------------------------------------------- The main role of [the `sender`](https://github.com/ava-labs/avalanchego/blob/master/snow/networking/sender/sender.go) is to build and send outbound messages. It is actually a very thin wrapper around the normal networking code. The main difference here is that sender registers timeouts and tells the router to expect a response message. The timer starts on the sender side. If there is no response, sender will send a failed response to the router. If a node is repeatedly unresponsive, that node will get benched and the sender will immediately start marking those messages as failed. If a sufficient amount of network deems the node benched, it might not get rewards (as a validator). Consensus Engine[​](#consensus-engine "Direct link to heading") --------------------------------------------------------------- Consensus is defined as getting a group of distributed systems to agree on an outcome. In the case of the Avalanche network, consensus is achieved when validators are in agreement with the state of the blockchain. The novel consensus algorithm is documented in the [white paper](https://assets.website-files.com/5d80307810123f5ffbb34d6e/6009805681b416f34dcae012_Avalanche%20Consensus%20Whitepaper.pdf). There are two main consensus algorithms: Avalanche and [Snowman](https://github.com/ava-labs/avalanchego/blob/master/snow/consensus/snowman/consensus.go). The engine is responsible for adding proposing a new block to consensus, repeatedly polling the network for decisions (accept/reject), and communicating that decision to the `Sender`. Blockchain Creation[​](#blockchain-creation "Direct link to heading") --------------------------------------------------------------------- [The `Manager`](https://github.com/ava-labs/avalanchego/blob/master/chains/manager.go) is what kick-starts everything in regards to blockchain creation, starting with the P-Chain. Once the P-Chain finishes bootstrapping, it will kickstart C-Chain and X-Chain and any other chains. The `Manager`'s job is not done yet, if a create-chain transaction is seen by a validator, a whole new process to create a chain will be started by the `Manager`. This can happen dynamically, long after the 3 chains in the Primary Network have been created and bootstrapped. # Issuing API Calls (/docs/rpcs/other/guides/issuing-api-calls) --- title: Issuing API Calls description: This guide explains how to make calls to APIs exposed by Avalanche nodes. --- Endpoints[​](#endpoints "Direct link to heading") ------------------------------------------------- An API call is made to an endpoint, which is a URL, made up of the base URI which is the address and the port of the node, and the path the particular endpoint the API call is on. ### Base URL[​](#base-url "Direct link to heading") The base of the URL is always: `[node-ip]:[http-port]` where - `node-ip` is the IP address of the node the call is to. - `http-port` is the port the node listens on for HTTP calls. This is specified by [command-line argument](/docs/nodes/configure/configs-flags#http-server) `http-port` (default value `9650`). For example, if you're making RPC calls on the local node, the base URL might look like this: `127.0.0.1:9650`. If you're making RPC calls to remote nodes, then the instead of `127.0.0.1` you should use the public IP of the server where the node is. Note that by default the node will only accept API calls on the local interface, so you will need to set up the [`http-host`](/docs/nodes/configure/configs-flags#--http-host-string) config flag on the node. Also, you will need to make sure the firewall and/or security policy allows access to the `http-port` from the internet. When setting up RPC access to a node, make sure you don't leave the `http-port` accessible to everyone! There are malicious actors that scan for nodes that have unrestricted access to their RPC port and then use those nodes for spamming them with resource-intensive queries which can knock the node offline. Only allow access to your node's RPC port from known IP addresses! ### Endpoint Path[​](#endpoint-path "Direct link to heading") Each API's documentation specifies what endpoint path a user should make calls to in order to access the API's methods. In general, they are formatted like: So for the Admin API, the endpoint path is `/ext/admin`, for the Info API it is `/ext/info` and so on. Note that some APIs have additional path components, most notably the chain RPC endpoints which includes the Avalanche L1 chain RPCs. We'll go over those in detail in the next section. So, in combining the base URL and the endpoint path we get the complete URL for making RPC calls. For example, to make a local RPC call on the Info API, the full URL would be: ``` http://127.0.0.1:9650/ext/info ``` Primary Network and Avalanche L1 RPC calls[​](#primary-network-and-avalanche-l1-rpc-calls "Direct link to heading") ------------------------------------------------------------------------------------------------------- Besides the APIs that are local to the node, like Admin or Metrics APIs, nodes also expose endpoints for talking to particular chains that are either part of the Primary Network (the X, P and C chains), or part of any Avalanche L1s the node might be syncing or validating. In general, chain endpoints are formatted as: ### Primary Network Endpoints[​](#primary-network-endpoints "Direct link to heading") The Primary Network consists of three chains: X, P and C chain. As those chains are present on every node, there are also convenient aliases defined that can be used instead of the full blockchainIDs. So, the endpoints look like: ### C-Chain and Subnet-EVM Endpoints[​](#c-chain-and-subnet-evm-endpoints "Direct link to heading") C-Chain and many Avalanche L1s run a version of the EthereumVM (EVM). EVM exposes its own endpoints, which are also accessible on the node: JSON-RPC, and Websocket. #### JSON-RPC EVM Endpoints[​](#json-rpc-evm-endpoints "Direct link to heading") To interact with C-Chain EVM via the JSON-RPC use the endpoint: To interact with Avalanche L1 instances of the EVM via the JSON-RPC endpoint: ``` /ext/bc/[blockchainID]/rpc ``` where `blockchainID` is the ID of the blockchain running the EVM. So for example, the RPC URL for the DFK Network (an Avalanche L1 that runs the DeFi Kingdoms:Crystalvale game) running on a local node would be: ``` http://127.0.0.1/ext/bc/q2aTwKuyzgs8pynF7UXBZCU7DejbZbZ6EUyHr3JQzYgwNPUPi/rpc ``` Or for the WAGMI Avalanche L1 on the Fuji testnet: ``` http://127.0.0.1/ext/bc/2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt/rpc ``` #### Websocket EVM Endpoints[​](#websocket-evm-endpoints "Direct link to heading") To interact with C-Chain via the websocket endpoint, use: To interact with other instances of the EVM via the websocket endpoint: where `blockchainID` is the ID of the blockchain running the EVM. For example, to interact with the C-Chain's Ethereum APIs via websocket on localhost you can use: ``` ws://127.0.0.1:9650/ext/bc/C/ws ``` When using the [Public API](/docs/rpcs) or another host that supports HTTPS, use `https://` or `wss://` instead of `http://` or `ws://`. Also, note that the [public API](/docs/rpcs#using-the-public-api-nodes) only supports C-Chain websocket API calls for API methods that don't exist on the C-Chain's HTTP API. Making a JSON RPC Request[​](#making-a-json-rpc-request "Direct link to heading") --------------------------------------------------------------------------------- Most of the built-in APIs use the [JSON RPC 2.0](https://www.jsonrpc.org/specification) format to describe their requests and responses. Such APIs include the Platform API and the X-Chain API. Suppose we want to call the `getTxStatus` method of the [X-Chain API](/docs/rpcs/x-chain). The X-Chain API documentation tells us that the endpoint for this API is `/ext/bc/X`. That means that the endpoint we send our API call to is: `[node-ip]:[http-port]/ext/bc/X` The X-Chain API documentation tells us that the signature of `getTxStatus` is: [`avm.getTxStatus`](/docs/rpcs/x-chain#avmgettxstatus)`(txID:bytes) -> (status:string)` where: - Argument `txID` is the ID of the transaction we're getting the status of. - Returned value `status` is the status of the transaction in question. To call this method, then: ``` curl -X POST --data '{ "jsonrpc":"2.0", "id" :4, "method" :"avm.getTxStatus", "params" :{ "txID":"2QouvFWUbjuySRxeX5xMbNCuAaKWfbk5FeEa2JmoF85RKLk2dD" } }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/bc/X ``` - `jsonrpc` specifies the version of the JSON RPC protocol. (In practice is always 2.0) - `method` specifies the service (`avm`) and method (`getTxStatus`) that we want to invoke. - `params` specifies the arguments to the method. - `id` is the ID of this request. Request IDs should be unique. That's it! ### JSON RPC Success Response[​](#json-rpc-success-response "Direct link to heading") If the call is successful, the response will look like this: ``` { "jsonrpc": "2.0", "result": { "Status": "Accepted" }, "id": 1 } ``` - `id` is the ID of the request that this response corresponds to. - `result` is the returned values of `getTxStatus`. ### JSON RPC Error Response[​](#json-rpc-error-response "Direct link to heading") If the API method invoked returns an error then the response will have a field `error` in place of `result`. Additionally, there is an extra field, `data`, which holds additional information about the error that occurred. Such a response would look like: ``` { "jsonrpc": "2.0", "error": { "code": -32600, "message": "[Some error message here]", "data": [Object with additional information about the error] }, "id": 1 } ``` Other API Formats[​](#other-api-formats "Direct link to heading") ----------------------------------------------------------------- Some APIs may use a standard other than JSON RPC 2.0 to format their requests and responses. Such extension should specify how to make calls and parse responses to them in their documentation. Sending and Receiving Bytes[​](#sending-and-receiving-bytes "Direct link to heading") ------------------------------------------------------------------------------------- Unless otherwise noted, when bytes are sent in an API call/response, they are in hex representation. However, Transaction IDs (TXIDs), ChainIDs, and subnetIDs are in [CB58](https://support.avalabs.org/en/articles/4587395-what-is-cb58) representation, a base-58 encoding with a checksum. # Transaction Fees (/docs/rpcs/other/guides/txn-fees) --- title: Transaction Fees --- In order to prevent spam, transactions on Avalanche require the payment of a transaction fee. The fee is paid in AVAX. **The transaction fee is burned (destroyed forever).** When you issue a transaction through Avalanche's API, the transaction fee is automatically deducted from one of the addresses you control. The [avalanchego wallet](https://github.com/ava-labs/avalanchego/blob/master/wallet/chain) contains example code written in golang for building and signing transactions on all three mainnet chains. X-Chain Fees[​](#fee-schedule) ------------------------------------------------------- The X-Chain currently operates under a fixed fee mechanism. This table shows the X-Chain transaction fee schedule: ``` +----------+---------------------------+--------------------------------+ | Chain | Transaction Type | Mainnet Transaction Fee (AVAX) | +----------+---------------------------+--------------------------------+ | X | Send | 0.001 | +----------+---------------------------+--------------------------------+ | X | Create Asset | 0.01 | +----------+---------------------------+--------------------------------+ | X | Mint Asset | 0.001 | +----------+---------------------------+--------------------------------+ | X | Import AVAX | 0.001 | +----------+---------------------------+--------------------------------+ | X | Export AVAX | 0.001 | +----------+---------------------------+--------------------------------+ ``` C-Chain Fees[​](#c-chain-fees) ------------------------------------------------------- The Avalanche C-Chain uses an algorithm to determine the "base fee" for a transaction. The base fee increases when network utilization is above the target utilization and decreases when network utilization is below the target. ### Dynamic Fee Transactions[​](#dynamic-fee-transactions ) Transaction fees for non-atomic transactions are based on Ethereum's EIP-1559 style Dynamic Fee Transactions, which consists of a gas fee cap and a gas tip cap. The fee cap specifies the maximum price the transaction is willing to pay per unit of gas. The tip cap (also called the priority fee) specifies the maximum amount above the base fee that the transaction is willing to pay per unit of gas. Therefore, the effective gas price paid by a transaction will be `min(gasFeeCap, baseFee + gasTipCap)`. Unlike in Ethereum, where the priority fee is paid to the miner that produces the block, in Avalanche both the base fee and the priority fee are burned. For legacy transactions, which only specify a single gas price, the gas price serves as both the gas fee cap and the gas tip cap. Use the [`eth_baseFee`](/docs/rpcs/c-chain#eth_basefee) API method to estimate the base fee for the next block. If more blocks are produced in between the time that you construct your transaction and it is included in a block, the base fee could be different from the base fee estimated by the API call, so it is important to treat this value as an estimate. Next, use [eth\_maxPriorityFeePerGas](/docs/rpcs/c-chain#eth_maxpriorityfeepergas) API call to estimate the priority fee needed to be included in a block. This API call will look at the most recent blocks and see what tips have been paid by recent transactions in order to be included in the block. Transactions are ordered by the priority fee, then the timestamp (oldest first). Based off of this information, you can specify the `gasFeeCap` and `gasTipCap` to your liking based on how you prioritize getting your transaction included as quickly as possible vs. minimizing the price paid per unit of gas. #### Base Fee[​](#base-fee) The base fee can go as low as 1 nAVAX (Gwei) and has no upper bound. You can use the [`eth_baseFee`](/docs/rpcs/c-chain#eth_basefee) and [eth\_maxPriorityFeePerGas](/docs/rpcs/c-chain#eth_maxpriorityfeepergas) API methods, or [Snowtrace's C-Chain Gas Tracker](https://snowtrace.io/gastracker), to estimate the gas price to use in your transactions. ### Atomic Transaction Fees[​](#atomic-transaction-fees) C-Chain atomic transactions (that is imports and exports from/to other chains) charge dynamic fees based on the amount of gas used by the transaction and the base fee of the block that includes the atomic transaction. Gas Used: ``` +---------------------+-------+ | Item : Gas | +---------------------+-------+ | Unsigned Tx Byte : 1 | +---------------------+-------+ | Signature : 1000 | +---------------------+-------+ | Per Atomic Tx : 10000 | +---------------------+-------+ ``` Therefore, the gas used by an atomic transaction is `1 * len(unsignedTxBytes) + 1,000 * numSignatures + 10,000` The TX fee additionally takes the base fee into account. Due to the fact that atomic transactions use units denominated in 9 decimal places, the base fee must be converted to 9 decimal places before calculating the actual fee paid by the transaction. Therefore, the actual fee is: `gasUsed * baseFee (converted to 9 decimals)`. P-Chain Fees[​](#p-chain-fees) ------------------------------------------------------- The Avalanche P-Chain utilizes a dynamic fee mechanism to optimize transaction costs and network utilization. This system adapts fees based on gas consumption to maintain a target utilization rate. ### Dimensions of Gas Consumption Gas consumption is measured across four dimensions: 1. **Bandwidth** The transaction size in bytes. 2. **Reads** The number of state/database reads. 3. **Writes** The number of state/database writes. 4. **Compute** The compute time in microseconds. The total gas consumed ($G$) by a transaction is: ```math G = B + 1000R + 1000W + 4C ``` The current fee dimension weight configurations as well as the parameter configurations of the P-Chain can be read at any time with the [`platform.getFeeConfig`](/docs/rpcs/p-chain#platformgetfeeconfig) API endpoint. ### Fee Adjustment Mechanism Fees adjust dynamically based on excess gas consumption, the difference between current gas usage and the target gas rate. The exponential adjustment ensures consistent reactivity regardless of the current gas price. Fee changes scale proportionally with excess gas consumption, maintaining fairness and network stability. The technical specification of this mechanism is documented in [ACP-103](https://github.com/avalanche-foundation/ACPs/blob/main/ACPs/103-dynamic-fees/README.md#mechanism). # X-Chain Migration (/docs/rpcs/other/guides/x-chain-migration) --- title: X-Chain Migration --- Overview[​](#overview "Direct link to heading") ----------------------------------------------- This document summarizes all of the changes made to the X-Chain API to support Avalanche Cortina (v1.10.0), which migrates the X-Chain to run Snowman++. In summary, the core transaction submission and confirmation flow is unchanged, however, there are new APIs that must be called to index all transactions. Transaction Broadcast and Confirmation[​](#transaction-broadcast-and-confirmation "Direct link to heading") ----------------------------------------------------------------------------------------------------------- The transaction format on the X-Chain does not change in Cortina. This means that wallets that have already integrated with the X-Chain don't need to change how they sign transactions. Additionally, there is no change to the format of the [avm.issueTx](/docs/rpcs/x-chain#avmissuetx) or the [avm.getTx](/docs/rpcs/x-chain#avmgettx) API. However, the [avm.getTxStatus](/docs/rpcs/x-chain#avmgettxstatus) endpoint is now deprecated and its usage should be replaced with [avm.getTx](/docs/rpcs/x-chain#avmgettx) (which only returns accepted transactions for AvalancheGo >= v1.9.12). [avm.getTxStatus](/docs/rpcs/x-chain#avmgettxstatus) will still work up to and after the Cortina activation if you wish to migrate after the network upgrade has occurred. Vertex -> Block Indexing[​](#vertex---block-indexing "Direct link to heading") ------------------------------------------------------------------------------ Before Cortina, indexing the X-Chain required polling the `/ext/index/X/vtx` endpoint to fetch new vertices. During the Cortina activation, a “stop vertex” will be produced using a [new codec version](https://github.com/ava-labs/avalanchego/blob/c27721a8da1397b218ce9e9ec69839b8a30f9860/snow/engine/avalanche/vertex/codec.go#L17-L18) that will contain no transactions. This new vertex type will be the [same format](https://github.com/ava-labs/avalanchego/blob/c27721a8da1397b218ce9e9ec69839b8a30f9860/snow/engine/avalanche/vertex/stateless_vertex.go#L95-L102) as previous vertices. To ensure historical data can still be accessed in Cortina, the `/ext/index/X/vtx` will remain accessible even though it will no longer be populated with chain data. The index for the X-chain tx and vtx endpoints will never increase again. The index for the X-chain blocks will increase as new blocks are added. After Cortina activation, you will need to migrate to using the new _ext/index/X/block_ endpoint (shares the same semantics as [/ext/index/P/block](/docs/rpcs/other/index-rpc#p-chain-blocks)) to continue indexing X-Chain activity. Because X-Chain ordering is deterministic in Cortina, this means that X-Chain blocks across all heights will be consistent across all nodes and will include a timestamp. Here is an example of iterating over these blocks in Golang: ``` package main import ( "context" "fmt" "log" "time" "github.com/ava-labs/avalanchego/indexer" "github.com/ava-labs/avalanchego/vms/proposervm/block" "github.com/ava-labs/avalanchego/wallet/chain/x" "github.com/ava-labs/avalanchego/wallet/subnet/primary" ) func main() { var ( uri = fmt.Sprintf("%s/ext/index/X/block", primary.LocalAPIURI) client = indexer.NewClient(uri) ctx = context.Background() nextIndex uint64 ) for { log.Printf("polling for next accepted block") container, err := client.GetContainerByIndex(ctx, nextIndex) if err != nil { time.Sleep(time.Second) continue } proposerVMBlock, err := block.Parse(container.Bytes) if err != nil { log.Fatalf("failed to parse proposervm block: %s\n", err) } avmBlockBytes := proposerVMBlock.Block() avmBlock, err := x.Parser.ParseBlock(avmBlockBytes) if err != nil { log.Fatalf("failed to parse avm block: %s\n", err) } acceptedTxs := avmBlock.Txs() log.Printf("accepted block %s with %d transactions", avmBlock.ID(), len(acceptedTxs)) for _, tx := range acceptedTxs { log.Printf("accepted transaction %s", tx.ID()) } nextIndex++ } } ``` After Cortina activation, it will also be possible to fetch X-Chain blocks directly without enabling the Index API. You can use the [avm.getBlock](/docs/rpcs/x-chain#avmgetblock), [avm.getBlockByHeight](/docs/rpcs/x-chain#avmgetblockbyheight), and [avm.getHeight](/docs/rpcs/x-chain#avmgetheight) endpoints to do so. This, again, will be similar to the [P-Chain semantics](/docs/rpcs/p-chain#platformgetblock). Deprecated API Calls[​](#deprecated-api-calls "Direct link to heading") ----------------------------------------------------------------------- This long-term deprecation effort will better align usage of AvalancheGo with its purpose, to be a minimal and efficient runtime that supports only what is required to validate the Primary Network and Avalanche L1s. Integrators should make plans to migrate to tools and services that are better optimized for serving queries over Avalanche Network state and avoid keeping any keys on the node itself. This deprecation ONLY applies to APIs that AvalancheGo exposes over the HTTP port. Transaction types with similar names to these APIs are NOT being deprecated. - ipcs - ipcs.publishBlockchain - ipcs.unpublishBlockchain - ipcs.getPublishedBlockchains - keystore - keystore.createUser - keystore.deleteUser - keystore.listUsers - keystore.importUser - keystore.exportUser - avm/pubsub - avm - avm.getAddressTxs - avm.getBalance - avm.getAllBalances - avm.createAsset - avm.createFixedCapAsset - avm.createVariableCapAsset - avm.createNFTAsset - avm.createAddress - avm.listAddresses - avm.exportKey - avm.importKey - avm.mint - avm.sendNFT - avm.mintNFT - avm.import - avm.export - avm.send - avm.sendMultiple - avm/wallet - wallet.issueTx - wallet.send - wallet.sendMultiple - platform - platform.exportKey - platform.importKey - platform.getBalance - platform.createAddress - platform.listAddresses - platform.getSubnets - platform.addValidator - platform.addDelegator - platform.addSubnetValidator - platform.createSubnet - platform.exportAVAX - platform.importAVAX - platform.createBlockchain - platform.getBlockchains - platform.getStake - platform.getMaxStakeAmount - platform.getRewardUTXOs Cortina FAQ[​](#cortina-faq "Direct link to heading") ----------------------------------------------------- ### Do I Have to Upgrade my Node?[​](#do-i-have-to-upgrade-my-node "Direct link to heading") If you don't upgrade your validator to `v1.10.0` before the Avalanche Mainnet activation date, your node will be marked as offline and other nodes will report your node as having lower uptime, which may jeopardize your staking rewards. ### Is There any Change in Hardware Requirements?[​](#is-there-any-change-in-hardware-requirements "Direct link to heading") No. ### Will Updating Decrease my Validator's Uptime?[​](#will-updating-decrease-my-validators-uptime "Direct link to heading") No. As a reminder, you can check your validator's estimated uptime using the [`info.uptime` API call](/docs/rpcs/other/info-rpc#infouptime). ### I Think Something Is Wrong. What Should I Do?[​](#i-think-something-is-wrong-what-should-i-do "Direct link to heading") First, make sure that you've read the documentation thoroughly and checked the [FAQs](https://support.avax.network/en/). If you don't see an answer to your question, go to our [Discord](https://discord.com/invite/RwXY7P6) server and search for your question. If it has not already been asked, please post it in the appropriate channel. # Avalanche Network Protocol (/docs/rpcs/other/standards/avalanche-network-protocol) --- title: Avalanche Network Protocol --- Overview[​](#overview "Direct link to heading") ----------------------------------------------- Avalanche network defines the core communication format between Avalanche nodes. It uses the [primitive serialization](/docs/rpcs/other/standards/serialization-primitives) format for payload packing. `"Containers"` are mentioned extensively in the description. A Container is simply a generic term for blocks. This document describes the protocol for peer-to-peer communication using Protocol Buffers (proto3). The protocol defines a set of messages exchanged between peers in a peer-to-peer network. Each message is represented by the `Message` proto message, which can encapsulate various types of messages, including network messages, state-sync messages, bootstrapping messages, consensus messages, and application messages. Message[​](#message "Direct link to heading") --------------------------------------------- The `Message` proto message is the main container for all peer-to-peer communication. It uses the `oneof` construct to represent different message types. The supported compression algorithms include Gzip and Zstd. ``` message Message { oneof message { bytes compressed_gzip = 1; bytes compressed_zstd = 2; // ... (other compression algorithms can be added) Ping ping = 11; Pong pong = 12; Version version = 13; PeerList peer_list = 14; // ... (other message types) } } ``` ### Compression[​](#compression "Direct link to heading") The `compressed_gzip` and `compressed_zstd` fields are used for Gzip and Zstd compression, respectively, of the encapsulated message. These fields are set only if the message type supports compression. Network Messages[​](#network-messages "Direct link to heading") --------------------------------------------------------------- ### Ping[​](#ping "Direct link to heading") The `Ping` message reports a peer's perceived uptime percentage. ``` message Ping { uint32 uptime = 1; repeated SubnetUptime subnet_uptimes = 2; } ``` - `uptime`: Uptime percentage on the primary network \[0, 100\]. - `subnet_uptimes`: Uptime percentages on Avalanche L1s. ### Pong[​](#pong "Direct link to heading") The `Pong` message is sent in response to a `Ping` with the perceived uptime of the peer. ``` message Pong { uint32 uptime = 1; // Deprecated: uptime is now sent in Ping repeated SubnetUptime subnet_uptimes = 2; // Deprecated: uptime is now sent in Ping } ``` ### Version[​](#version "Direct link to heading") The `Version` message is the first outbound message sent to a peer during the p2p handshake. ``` message Version { uint32 network_id = 1; uint64 my_time = 2; bytes ip_addr = 3; uint32 ip_port = 4; string my_version = 5; uint64 my_version_time = 6; bytes sig = 7; repeated bytes tracked_subnets = 8; } ``` - `network_id`: Network identifier (e.g., local, testnet, Mainnet). - `my_time`: Unix timestamp when the `Version` message was created. - `ip_addr`: IP address of the peer. - `ip_port`: IP port of the peer. - `my_version`: Avalanche client version. - `my_version_time`: Timestamp of the IP. - `sig`: Signature of the peer IP port pair at a provided timestamp. - `tracked_subnets`: Avalanche L1s the peer is tracking. ### PeerList[​](#peerlist "Direct link to heading") The `PeerList` message contains network-level metadata for a set of validators. ``` message PeerList { repeated ClaimedIpPort claimed_ip_ports = 1; } ``` - `claimed_ip_ports`: List of claimed IP and port pairs. ### PeerListAck[​](#peerlistack "Direct link to heading") The `PeerListAck` message is sent in response to `PeerList` to acknowledge the subset of peers that the peer will attempt to connect to. ``` message PeerListAck { reserved 1; // deprecated; used to be tx_ids repeated PeerAck peer_acks = 2; } ``` - `peer_acks`: List of acknowledged peers. State-Sync Messages[​](#state-sync-messages "Direct link to heading") --------------------------------------------------------------------- ### GetStateSummaryFrontier[​](#getstatesummaryfrontier "Direct link to heading") The `GetStateSummaryFrontier` message requests a peer's most recently accepted state summary. ``` message GetStateSummaryFrontier { bytes chain_id = 1; uint32 request_id = 2; uint64 deadline = 3; } ``` - `chain_id`: Chain being requested from. - `request_id`: Unique identifier for this request. - `deadline`: Timeout (ns) for this request. ### StateSummaryFrontier[​](#statesummaryfrontier "Direct link to heading") The `StateSummaryFrontier` message is sent in response to a `GetStateSummaryFrontier` request. ``` message StateSummaryFrontier { bytes chain_id = 1; uint32 request_id = 2; bytes summary = 3; } ``` - `chain_id`: Chain being responded from. - `request_id`: Request ID of the original `GetStateSummaryFrontier` request. - `summary`: The requested state summary. ### GetAcceptedStateSummary[​](#getacceptedstatesummary "Direct link to heading") The `GetAcceptedStateSummary` message requests a set of state summaries at specified block heights. ``` message GetAcceptedStateSummary { bytes chain_id = 1; uint32 request_id = 2; uint64 deadline = 3; repeated uint64 heights = 4; } ``` - `chain_id`: Chain being requested from. - `request_id`: Unique identifier for this request. - `deadline`: Timeout (ns) for this request. - `heights`: Heights being requested. ### AcceptedStateSummary[​](#acceptedstatesummary "Direct link to heading") The `AcceptedStateSummary` message is sent in response to `GetAcceptedStateSummary`. ``` message AcceptedStateSummary { bytes chain_id = 1; uint32 request_id = 2; repeated bytes summary_ids = 3; } ``` - `chain_id`: Chain being responded from. - `request_id`: Request ID of the original `GetAcceptedStateSummary` request. - `summary_ids`: State summary IDs. Bootstrapping Messages[​](#bootstrapping-messages "Direct link to heading") --------------------------------------------------------------------------- ### GetAcceptedFrontier[​](#getacceptedfrontier "Direct link to heading") The `GetAcceptedFrontier` message requests the accepted frontier from a peer. ``` message GetAcceptedFrontier { bytes chain_id = 1; uint32 request_id = 2; uint64 deadline = 3; EngineType engine_type = 4; } ``` - `chain_id`: Chain being requested from. - `request_id`: Unique identifier for this request. - `deadline`: Timeout (ns) for this request. - `engine_type`: Consensus type the remote peer should use to handle this message. ### AcceptedFrontier[​](#acceptedfrontier "Direct link to heading") The `AcceptedFrontier` message contains the remote peer's last accepted frontier. ``` message AcceptedFrontier { reserved 4; // Until Cortina upgrade is activated bytes chain_id = 1; uint32 request_id = 2; bytes container_id = 3; } ``` - `chain_id`: Chain being responded from. - `request_id`: Request ID of the original `GetAcceptedFrontier` request. - `container_id`: The ID of the last accepted frontier. ### GetAccepted[​](#getaccepted "Direct link to heading") The `GetAccepted` message sends a request with the sender's accepted frontier to a remote peer. ``` message GetAccepted { bytes chain_id = 1; uint32 request_id = 2; uint64 deadline = 3; repeated bytes container_ids = 4; EngineType engine_type = 5; } ``` - `chain_id`: Chain being requested from. - `request_id`: Unique identifier for this message. - `deadline`: Timeout (ns) for this request. - `container_ids`: The sender's accepted frontier. - `engine_type`: Consensus type to handle this message. ### Accepted[​](#accepted "Direct link to heading") The `Accepted` message is sent in response to `GetAccepted`. ``` message Accepted { reserved 4; // Until Cortina upgrade is activated bytes chain_id = 1; uint32 request_id = 2; repeated bytes container_ids = 3; } ``` - `chain_id`: Chain being responded from. - `request_id`: Request ID of the original `GetAccepted` request. - `container_ids`: Subset of container IDs from the `GetAccepted` request that the sender has accepted. ### GetAncestors[​](#getancestors "Direct link to heading") The `GetAncestors` message requests the ancestors for a given container. ``` message GetAncestors { bytes chain_id = 1; uint32 request_id = 2; uint64 deadline = 3; bytes container_id = 4; EngineType engine_type = 5; } ``` - `chain_id`: Chain being requested from. - `request_id`: Unique identifier for this request. - `deadline`: Timeout (ns) for this request. - `container_id`: Container for which ancestors are being requested. - `engine_type`: Consensus type to handle this message. ### Ancestors[​](#ancestors "Direct link to heading") The `Ancestors` message is sent in response to `GetAncestors`. ``` message Ancestors { reserved 4; // Until Cortina upgrade is activated bytes chain_id = 1; uint32 request_id = 2; repeated bytes containers = 3; } ``` - `chain_id`: Chain being responded from. - `request_id`: Request ID of the original `GetAncestors` request. - `containers`: Ancestry for the requested container. Consensus Messages[​](#consensus-messages "Direct link to heading") ------------------------------------------------------------------- ### Get[​](#get "Direct link to heading") The `Get` message requests a container from a remote peer. ``` message Get { bytes chain_id = 1; uint32 request_id = 2; uint64 deadline = 3; bytes container_id = 4; EngineType engine_type = 5; } ``` - `chain_id`: Chain being requested from. - `request_id`: Unique identifier for this request. - `deadline`: Timeout (ns) for this request. - `container_id`: Container being requested. - `engine_type`: Consensus type to handle this message. ### Put[​](#put "Direct link to heading") The `Put` message is sent in response to `Get` with the requested block. ``` message Put { bytes chain_id = 1; uint32 request_id = 2; bytes container = 3; EngineType engine_type = 4; } ``` - `chain_id`: Chain being responded from. - `request_id`: Request ID of the original `Get` request. - `container`: Requested container. - `engine_type`: Consensus type to handle this message. ### PushQuery[​](#pushquery "Direct link to heading") The `PushQuery` message requests the preferences of a remote peer given a container. ``` message PushQuery { bytes chain_id = 1; uint32 request_id = 2; uint64 deadline = 3; bytes container = 4; EngineType engine_type = 5; uint64 requested_height = 6; } ``` - `chain_id`: Chain being requested from. - `request_id`: Unique identifier for this request. - `deadline`: Timeout (ns) for this request. - `container`: Container being gossiped. - `engine_type`: Consensus type to handle this message. - `requested_height`: Requesting peer's last accepted height. ### PullQuery[​](#pullquery "Direct link to heading") The `PullQuery` message requests the preferences of a remote peer given a container id. ``` message PullQuery { bytes chain_id = 1; uint32 request_id = 2; uint64 deadline = 3; bytes container_id = 4; EngineType engine_type = 5; uint64 requested_height = 6; } ``` - `chain_id`: Chain being requested from. - `request_id`: Unique identifier for this request. - `deadline`: Timeout (ns) for this request. - `container_id`: Container id being gossiped. - `engine_type`: Consensus type to handle this message. - `requested_height`: Requesting peer's last accepted height. ### Chits[​](#chits "Direct link to heading") The `Chits` message contains the preferences of a peer in response to a `PushQuery` or `PullQuery` message. ``` message Chits { bytes chain_id = 1; uint32 request_id = 2; bytes preferred_id = 3; bytes accepted_id = 4; bytes preferred_id_at_height = 5; } ``` - `chain_id`: Chain being responded from. - `request_id`: Request ID of the original `PushQuery`/`PullQuery` request. - `preferred_id`: Currently preferred block. - `accepted_id`: Last accepted block. - `preferred_id_at_height`: Currently preferred block at the requested height. Application Messages[​](#application-messages "Direct link to heading") ----------------------------------------------------------------------- ### AppRequest[​](#apprequest "Direct link to heading") The `AppRequest` message is a VM-defined request. ``` message AppRequest { bytes chain_id = 1; uint32 request_id = 2; uint64 deadline = 3; bytes app_bytes = 4; } ``` - `chain_id`: Chain being requested from. - `request_id`: Unique identifier for this request. - `deadline`: Timeout (ns) for this request. - `app_bytes`: Request body. ### AppResponse[​](#appresponse "Direct link to heading") The `AppResponse` message is a VM-defined response sent in response to `AppRequest`. ``` message AppResponse { bytes chain_id = 1; uint32 request_id = 2; bytes app_bytes = 3; } ``` - `chain_id`: Chain being responded from. - `request_id`: Request ID of the original `AppRequest`. - `app_bytes`: Response body. ### AppGossip[​](#appgossip "Direct link to heading") The `AppGossip` message is a VM-defined message. ``` message AppGossip { bytes chain_id = 1; bytes app_bytes = 2; } ``` - `chain_id`: Chain the message is for. - `app_bytes`: Message body. # Cryptographic Primitives (/docs/rpcs/other/standards/cryptographic-primitives) --- title: Cryptographic Primitives --- Avalanche uses a variety of cryptographic primitives for its different functions. This file summarizes the type and kind of cryptography used at the network and blockchain layers. ## Cryptography in the Network Layer Avalanche uses Transport Layer Security, TLS, to protect node-to-node communications from eavesdroppers. TLS combines the practicality of public-key cryptography with the efficiency of symmetric-key cryptography. This has resulted in TLS becoming the standard for internet communication. Whereas most classical consensus protocols employ public-key cryptography to prove receipt of messages to third parties, the novel Snow\* consensus family does not require such proofs. This enables Avalanche to employ TLS in authenticating stakers and eliminates the need for costly public-key cryptography for signing network messages. ### TLS Certificates Avalanche does not rely on any centralized third-parties, and in particular, it does not use certificates issued by third-party authenticators. All certificates used within the network layer to identify endpoints are self-signed, thus creating a self-sovereign identity layer. No third parties are ever involved. ### TLS Addresses To avoid posting the full TLS certificate to the P-Chain, the certificate is first hashed. For consistency, Avalanche employs the same hashing mechanism for the TLS certificates as is used in Bitcoin. Namely, the DER representation of the certificate is hashed with sha256, and the result is then hashed with ripemd160 to yield a 20-byte identifier for stakers. This 20-byte identifier is represented by "NodeID-" followed by the data's [CB58](https://support.avalabs.org/en/articles/4587395-what-is-cb58) encoded string. ## Cryptography in the Avalanche Virtual Machine The Avalanche virtual machine uses elliptic curve cryptography, specifically `secp256k1`, for its signatures on the blockchain. This 32-byte identifier is represented by "PrivateKey-" followed by the data's [CB58](https://support.avalabs.org/en/articles/4587395-what-is-cb58) encoded string. ### Secp256k1 Addresses Avalanche is not prescriptive about addressing schemes, choosing to instead leave addressing up to each blockchain. The addressing scheme of the X-Chain and the P-Chain relies on secp256k1. Avalanche follows a similar approach as Bitcoin and hashes the ECDSA public key. The 33-byte compressed representation of the public key is hashed with sha256 **once**. The result is then hashed with ripemd160 to yield a 20-byte address. Avalanche uses the convention `chainID-address` to specify which chain an address exists on. `chainID` may be replaced with an alias of the chain. When transmitting information through external applications, the CB58 convention is required. ### Bech32 Addresses on the X-Chain and P-Chain use the [Bech32](http://support.avalabs.org/en/articles/4587392-what-is-bech32) standard outlined in [BIP 0173](https://en.bitcoin.it/wiki/BIP_0173). There are four parts to a Bech32 address scheme. In order of appearance: - A human-readable part (HRP). On Mainnet this is `avax`. - The number `1`, which separates the HRP from the address and error correction code. - A base-32 encoded string representing the 20 byte address. - A 6-character base-32 encoded error correction code. Additionally, an Avalanche address is prefixed with the alias of the chain it exists on, followed by a dash. For example, X-Chain addresses are prefixed with `X-`. The following regular expression matches addresses on the X-Chain, P-Chain and C-Chain for Mainnet, Fuji and localhost. Note that all valid Avalanche addresses will match this regular expression, but some strings that are not valid Avalanche addresses may match this regular expression. ``` ^([XPC]|[a-km-zA-HJ-NP-Z1-9]{36,72})-[a-zA-Z]{1,83}1[qpzry9x8gf2tvdw0s3jn54khce6mua7l]{38}$ ``` Read more about Avalanche's [addressing scheme](https://support.avalabs.org/en/articles/4596397-what-is-an-address). For example the following Bech32 address, `X-avax19rknw8l0grnfunjrzwxlxync6zrlu33y2jxhrg`, is composed like so: 1. HRP: `avax` 2. Separator: `1` 3. Address: `9rknw8l0grnfunjrzwxlxync6zrlu33y` 4. Checksum: `2jxhrg` Depending on the `networkID`, the encoded addresses will have a distinctive HRP per each network. - 0 - X-`custom`19rknw8l0grnfunjrzwxlxync6zrlu33yeg5dya - 1 - X-`avax`19rknw8l0grnfunjrzwxlxync6zrlu33y2jxhrg - 2 - X-`cascade`19rknw8l0grnfunjrzwxlxync6zrlu33ypmtvnh - 3 - X-`denali`19rknw8l0grnfunjrzwxlxync6zrlu33yhc357h - 4 - X-`everest`19rknw8l0grnfunjrzwxlxync6zrlu33yn44wty - 5 - X-`fuji`19rknw8l0grnfunjrzwxlxync6zrlu33yxqzg0h - 1337 - X-`custom`19rknw8l0grnfunjrzwxlxync6zrlu33yeg5dya - 12345 - X-`local`19rknw8l0grnfunjrzwxlxync6zrlu33ynpm3qq Here's the mapping of `networkID` to bech32 HRP. ``` 0: "custom", 1: "avax", 2: "cascade", 3: "denali", 4: "everest", 5: "fuji", 1337: "custom", 12345: "local" ``` ### Secp256k1 Recoverable Signatures Recoverable signatures are stored as the 65-byte **`[R || S || V]`** where **`V`** is 0 or 1 to allow quick public key recoverability. **`S`** must be in the lower half of the possible range to prevent signature malleability. Before signing a message, the message is hashed using sha256. ### Secp256k1 Example Suppose Rick and Morty are setting up a secure communication channel. Morty creates a new public-private key pair. Private Key: `0x98cb077f972feb0481f1d894f272c6a1e3c15e272a1658ff716444f465200070` Public Key (33-byte compressed): `0x02b33c917f2f6103448d7feb42614037d05928433cb25e78f01a825aa829bb3c27` Because of Rick's infinite wisdom, he doesn't trust himself with carrying around Morty's public key, so he only asks for Morty's address. Morty follows the instructions, SHA256's his public key, and then ripemd160's that result to produce an address. SHA256(Public Key): `0x28d7670d71667e93ff586f664937f52828e6290068fa2a37782045bffa7b0d2f` Address: `0xe8777f38c88ca153a6fdc25942176d2bf5491b89` Morty is quite confused because a public key should be safe to be public knowledge. Rick belches and explains that hashing the public key protects the private key owner from potential future security flaws in elliptic curve cryptography. In the event cryptography is broken and a private key can be derived from a public key, users can transfer their funds to an address that has never signed a transaction before, preventing their funds from being compromised by an attacker. This enables coin owners to be protected while the cryptography is upgraded across the clients. Later, once Morty has learned more about Rick's backstory, Morty attempts to send Rick a message. Morty knows that Rick will only read the message if he can verify it was from him, so he signs the message with his private key. Message: `0x68656c702049276d207472617070656420696e206120636f6d7075746572` Message Hash: `0x912800c29d554fb9cdce579c0abba991165bbbc8bfec9622481d01e0b3e4b7da` Message Signature: `0xb52aa0535c5c48268d843bd65395623d2462016325a86f09420c81f142578e121d11bd368b88ca6de4179a007e6abe0e8d0be1a6a4485def8f9e02957d3d72da01` Morty was never seen again. ### Signed Messages A standard for interoperable generic signed messages based on the Bitcoin Script format and Ethereum format. ``` sign(sha256(length(prefix) + prefix + length(message) + message)) ``` The prefix is simply the string `\x1AAvalanche Signed Message:\n`, where `0x1A` is the length of the prefix text and `length(message)` is an [integer](/docs/rpcs/other/standards/serialization-primitives#integer) of the message size. ### Gantt Pre-Image Specification ``` +---------------+-----------+------------------------------+ | prefix : [26]byte | 26 bytes | +---------------+-----------+------------------------------+ | messageLength : int | 4 bytes | +---------------+-----------+------------------------------+ | message : []byte | size(message) bytes | +---------------+-----------+------------------------------+ | 26 + 4 + size(message) | +------------------------------+ ``` ### Example As an example we will sign the message "Through consensus to the stars" ``` // prefix size: 26 bytes 0x1a // prefix: Avalanche Signed Message:\n 0x41 0x76 0x61 0x6c 0x61 0x6e 0x63 0x68 0x65 0x20 0x53 0x69 0x67 0x6e 0x65 0x64 0x20 0x4d 0x65 0x73 0x73 0x61 0x67 0x65 0x3a 0x0a // msg size: 30 bytes 0x00 0x00 0x00 0x1e // msg: Through consensus to the stars 54 68 72 6f 75 67 68 20 63 6f 6e 73 65 6e 73 75 73 20 74 6f 20 74 68 65 20 73 74 61 72 73 ``` After hashing with `sha256` and signing the pre-image we return the value [cb58](https://support.avalabs.org/en/articles/4587395-what-is-cb58) encoded: `4Eb2zAHF4JjZFJmp4usSokTGqq9mEGwVMY2WZzzCmu657SNFZhndsiS8TvL32n3bexd8emUwiXs8XqKjhqzvoRFvghnvSN`. Here's an example using [Core web](https://core.app/tools/signing-tools/sign/). A full guide on how to sign messages with Core web can be found [here](https://support.avax.network/en/articles/7206948-core-web-how-do-i-use-the-signing-tools). ![Sign message](/images/cryptography1.png) ## Cryptography in Ethereum Virtual Machine Avalanche nodes support the full Ethereum Virtual Machine (EVM) and precisely duplicate all of the cryptographic constructs used in Ethereum. This includes the Keccak hash function and the other mechanisms used for cryptographic security in the EVM. ## Cryptography in Other Virtual Machines Since Avalanche is an extensible platform, we expect that people will add additional cryptographic primitives to the system over time. # Serialization Primitives (/docs/rpcs/other/standards/serialization-primitives) --- title: Serialization Primitives --- Avalanche uses a simple, uniform, and elegant representation for all internal data. This document describes how primitive types are encoded on the Avalanche platform. Transactions are encoded in terms of these basic primitive types. Byte[​](#byte "Direct link to heading") --------------------------------------- Bytes are packed as-is into the message payload. Example: ``` Packing: 0x01 Results in: [0x01] ``` Short[​](#short "Direct link to heading") ----------------------------------------- Shorts are packed in BigEndian format into the message payload. Example: ``` Packing: 0x0102 Results in: [0x01, 0x02] ``` Integer[​](#integer "Direct link to heading") --------------------------------------------- Integers are 32-bit values packed in BigEndian format into the message payload. Example: ``` Packing: 0x01020304 Results in: [0x01, 0x02, 0x03, 0x04] ``` Long Integers[​](#long-integers "Direct link to heading") --------------------------------------------------------- Long integers are 64-bit values packed in BigEndian format into the message payload. Example: ``` Packing: 0x0102030405060708 Results in: [0x01, 0x02, 0x03, 0x04, 0x05, 0x06, 0x07, 0x08] ``` IP Addresses[​](#ip-addresses "Direct link to heading") ------------------------------------------------------- IP addresses are represented as 16-byte IPv6 format, with the port appended into the message payload as a Short. IPv4 addresses are padded with 12 bytes of leading 0x00s. IPv4 example: ``` Packing: "127.0.0.1:9650" Results in: [ 0x00, 0x00, 0x00, 0x00, 0x00, 0x00, 0x00, 0x00, 0x00, 0x00, 0xff, 0xff, 0x7f, 0x00, 0x00, 0x01, 0x25, 0xb2, ] ``` IPv6 example: ``` Packing: "[2001:0db8:ac10:fe01::]:12345" Results in: [ 0x20, 0x01, 0x0d, 0xb8, 0xac, 0x10, 0xfe, 0x01, 0x00, 0x00, 0x00, 0x00, 0x00, 0x00, 0x00, 0x00, 0x30, 0x39, ] ``` Fixed-Length Array[​](#fixed-length-array "Direct link to heading") ------------------------------------------------------------------- Fixed-length arrays, whose length is known ahead of time and by context, are packed in order. Byte array example: ``` Packing: [0x01, 0x02] Results in: [0x01, 0x02] ``` Integer array example: ``` Packing: [0x03040506] Results in: [0x03, 0x04, 0x05, 0x06] ``` Variable Length Array[​](#variable-length-array "Direct link to heading") ------------------------------------------------------------------------- The length of the array is prefixed in Integer format, followed by the packing of the array contents in Fixed Length Array format. Byte array example: ``` Packing: [0x01, 0x02] Results in: [0x00, 0x00, 0x00, 0x02, 0x01, 0x02] ``` Int array example: ``` Packing: [0x03040506] Results in: [0x00, 0x00, 0x00, 0x01, 0x03, 0x04, 0x05, 0x06] ``` String[​](#string "Direct link to heading") ------------------------------------------- A String is packed similarly to a variable-length byte array. However, the length prefix is a short rather than an int. Strings are encoded in UTF-8 format. Example: ``` Packing: "Avax" Results in: [0x00, 0x04, 0x41, 0x76, 0x61, 0x78] ``` # platform.getBalance (/docs/rpcs/p-chain/balances-&-utxos/platform_getBalance) --- title: platform.getBalance full: true _openapi: method: POST route: /ext/bc/P#platform.getBalance toc: [] structuredData: headings: [] contents: - content: GetBalance gets the balance of an address --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetBalance gets the balance of an address # platform.getUTXOs (/docs/rpcs/p-chain/balances-&-utxos/platform_getUTXOs) --- title: platform.getUTXOs full: true _openapi: method: POST route: /ext/bc/P#platform.getUTXOs toc: [] structuredData: headings: [] contents: - content: GetUTXOs returns the UTXOs controlled by the given addresses --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetUTXOs returns the UTXOs controlled by the given addresses # platform.getBlock (/docs/rpcs/p-chain/blocks/platform_getBlock) --- title: platform.getBlock full: true _openapi: method: POST route: /ext/bc/P#platform.getBlock toc: [] structuredData: headings: [] contents: - content: Calls the platform.getBlock method --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Calls the platform.getBlock method # platform.getBlockByHeight (/docs/rpcs/p-chain/blocks/platform_getBlockByHeight) --- title: platform.getBlockByHeight full: true _openapi: method: POST route: /ext/bc/P#platform.getBlockByHeight toc: [] structuredData: headings: [] contents: - content: GetBlockByHeight returns the block at the given height. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetBlockByHeight returns the block at the given height. # platform.getBlockchainStatus (/docs/rpcs/p-chain/blockchains/platform_getBlockchainStatus) --- title: platform.getBlockchainStatus full: true _openapi: method: POST route: /ext/bc/P#platform.getBlockchainStatus toc: [] structuredData: headings: [] contents: - content: >- GetBlockchainStatus gets the status of a blockchain with the ID [args.BlockchainID]. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetBlockchainStatus gets the status of a blockchain with the ID [args.BlockchainID]. # platform.getBlockchains (/docs/rpcs/p-chain/blockchains/platform_getBlockchains) --- title: platform.getBlockchains full: true _openapi: method: POST route: /ext/bc/P#platform.getBlockchains toc: [] structuredData: headings: [] contents: - content: GetBlockchains returns all of the blockchains that exist --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetBlockchains returns all of the blockchains that exist # platform.validatedBy (/docs/rpcs/p-chain/blockchains/platform_validatedBy) --- title: platform.validatedBy full: true _openapi: method: POST route: /ext/bc/P#platform.validatedBy toc: [] structuredData: headings: [] contents: - content: >- ValidatedBy returns the ID of the Subnet that validates [args.BlockchainID] --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} ValidatedBy returns the ID of the Subnet that validates [args.BlockchainID] # platform.validates (/docs/rpcs/p-chain/blockchains/platform_validates) --- title: platform.validates full: true _openapi: method: POST route: /ext/bc/P#platform.validates toc: [] structuredData: headings: [] contents: - content: >- Validates returns the IDs of the blockchains validated by [args.SubnetID] --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Validates returns the IDs of the blockchains validated by [args.SubnetID] # platform.getCurrentSupply (/docs/rpcs/p-chain/chain-info/platform_getCurrentSupply) --- title: platform.getCurrentSupply full: true _openapi: method: POST route: /ext/bc/P#platform.getCurrentSupply toc: [] structuredData: headings: [] contents: - content: >- GetCurrentSupply returns an upper bound on the supply of AVAX in the system --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetCurrentSupply returns an upper bound on the supply of AVAX in the system # platform.getHeight (/docs/rpcs/p-chain/chain-info/platform_getHeight) --- title: platform.getHeight full: true _openapi: method: POST route: /ext/bc/P#platform.getHeight toc: [] structuredData: headings: [] contents: - content: GetHeight returns the height of the last accepted block --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetHeight returns the height of the last accepted block # platform.getProposedHeight (/docs/rpcs/p-chain/chain-info/platform_getProposedHeight) --- title: platform.getProposedHeight full: true _openapi: method: POST route: /ext/bc/P#platform.getProposedHeight toc: [] structuredData: headings: [] contents: - content: GetProposedHeight returns the current ProposerVM height --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetProposedHeight returns the current ProposerVM height # platform.getTimestamp (/docs/rpcs/p-chain/chain-info/platform_getTimestamp) --- title: platform.getTimestamp full: true _openapi: method: POST route: /ext/bc/P#platform.getTimestamp toc: [] structuredData: headings: [] contents: - content: GetTimestamp returns the current timestamp on chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetTimestamp returns the current timestamp on chain. # platform.getFeeConfig (/docs/rpcs/p-chain/fees/platform_getFeeConfig) --- title: platform.getFeeConfig full: true _openapi: method: POST route: /ext/bc/P#platform.getFeeConfig toc: [] structuredData: headings: [] contents: - content: GetFeeConfig returns the dynamic fee config of the chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetFeeConfig returns the dynamic fee config of the chain. # platform.getFeeState (/docs/rpcs/p-chain/fees/platform_getFeeState) --- title: platform.getFeeState full: true _openapi: method: POST route: /ext/bc/P#platform.getFeeState toc: [] structuredData: headings: [] contents: - content: GetFeeState returns the current fee state of the chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetFeeState returns the current fee state of the chain. # platform.getValidatorFeeConfig (/docs/rpcs/p-chain/fees/platform_getValidatorFeeConfig) --- title: platform.getValidatorFeeConfig full: true _openapi: method: POST route: /ext/bc/P#platform.getValidatorFeeConfig toc: [] structuredData: headings: [] contents: - content: GetValidatorFeeConfig returns the validator fee config of the chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetValidatorFeeConfig returns the validator fee config of the chain. # platform.getValidatorFeeState (/docs/rpcs/p-chain/fees/platform_getValidatorFeeState) --- title: platform.getValidatorFeeState full: true _openapi: method: POST route: /ext/bc/P#platform.getValidatorFeeState toc: [] structuredData: headings: [] contents: - content: >- GetValidatorFeeState returns the current validator fee state of the chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetValidatorFeeState returns the current validator fee state of the chain. # platform.getRewardUTXOs (/docs/rpcs/p-chain/rewards/platform_getRewardUTXOs) --- title: platform.getRewardUTXOs full: true _openapi: method: POST route: /ext/bc/P#platform.getRewardUTXOs toc: [] structuredData: headings: [] contents: - content: >- GetRewardUTXOs returns the UTXOs that were rewarded after the provided transaction's staking period ended. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetRewardUTXOs returns the UTXOs that were rewarded after the provided transaction's staking period ended. # platform.getMinStake (/docs/rpcs/p-chain/staking/platform_getMinStake) --- title: platform.getMinStake full: true _openapi: method: POST route: /ext/bc/P#platform.getMinStake toc: [] structuredData: headings: [] contents: - content: GetMinStake returns the minimum staking amount in nAVAX. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetMinStake returns the minimum staking amount in nAVAX. # platform.getStake (/docs/rpcs/p-chain/staking/platform_getStake) --- title: platform.getStake full: true _openapi: method: POST route: /ext/bc/P#platform.getStake toc: [] structuredData: headings: [] contents: - content: >- GetStake returns the amount of nAVAX that [args.Addresses] have cumulatively staked on the Primary Network. This method assumes that each stake output has only owner This method assumes only AVAX can be staked This method only concerns itself with the Primary Network, not subnets TODO: Improve the performance of this method by maintaining this data in a data structure rather than re-calculating it by iterating over stakers --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetStake returns the amount of nAVAX that [args.Addresses] have cumulatively staked on the Primary Network. This method assumes that each stake output has only owner This method assumes only AVAX can be staked This method only concerns itself with the Primary Network, not subnets TODO: Improve the performance of this method by maintaining this data in a data structure rather than re-calculating it by iterating over stakers # platform.getTotalStake (/docs/rpcs/p-chain/staking/platform_getTotalStake) --- title: platform.getTotalStake full: true _openapi: method: POST route: /ext/bc/P#platform.getTotalStake toc: [] structuredData: headings: [] contents: - content: GetTotalStake returns the total amount staked on the Primary Network --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetTotalStake returns the total amount staked on the Primary Network # platform.getStakingAssetID (/docs/rpcs/p-chain/subnets/platform_getStakingAssetID) --- title: platform.getStakingAssetID full: true _openapi: method: POST route: /ext/bc/P#platform.getStakingAssetID toc: [] structuredData: headings: [] contents: - content: >- GetStakingAssetID returns the assetID of the token used to stake on the provided subnet --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetStakingAssetID returns the assetID of the token used to stake on the provided subnet # platform.getSubnet (/docs/rpcs/p-chain/subnets/platform_getSubnet) --- title: platform.getSubnet full: true _openapi: method: POST route: /ext/bc/P#platform.getSubnet toc: [] structuredData: headings: [] contents: - content: Calls the platform.getSubnet method --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Calls the platform.getSubnet method # platform.getSubnets (/docs/rpcs/p-chain/subnets/platform_getSubnets) --- title: platform.getSubnets full: true _openapi: method: POST route: /ext/bc/P#platform.getSubnets toc: [] structuredData: headings: [] contents: - content: >- GetSubnets returns the subnets whose ID are in [args.IDs] The response will include the primary network --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetSubnets returns the subnets whose ID are in [args.IDs] The response will include the primary network # platform.getTx (/docs/rpcs/p-chain/transactions/platform_getTx) --- title: platform.getTx full: true _openapi: method: POST route: /ext/bc/P#platform.getTx toc: [] structuredData: headings: [] contents: - content: Calls the platform.getTx method --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Calls the platform.getTx method # platform.getTxStatus (/docs/rpcs/p-chain/transactions/platform_getTxStatus) --- title: platform.getTxStatus full: true _openapi: method: POST route: /ext/bc/P#platform.getTxStatus toc: [] structuredData: headings: [] contents: - content: GetTxStatus gets a tx's status --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetTxStatus gets a tx's status # platform.issueTx (/docs/rpcs/p-chain/transactions/platform_issueTx) --- title: platform.issueTx full: true _openapi: method: POST route: /ext/bc/P#platform.issueTx toc: [] structuredData: headings: [] contents: - content: Calls the platform.issueTx method --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Calls the platform.issueTx method # platform.getCurrentValidators (/docs/rpcs/p-chain/validators/platform_getCurrentValidators) --- title: platform.getCurrentValidators full: true _openapi: method: POST route: /ext/bc/P#platform.getCurrentValidators toc: [] structuredData: headings: [] contents: - content: >- GetCurrentValidators returns the current validators. If a single nodeID is provided, full delegators information is also returned. Otherwise only delegators' number and total weight is returned. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetCurrentValidators returns the current validators. If a single nodeID is provided, full delegators information is also returned. Otherwise only delegators' number and total weight is returned. # platform.getL1Validator (/docs/rpcs/p-chain/validators/platform_getL1Validator) --- title: platform.getL1Validator full: true _openapi: method: POST route: /ext/bc/P#platform.getL1Validator toc: [] structuredData: headings: [] contents: - content: GetL1Validator returns the L1 validator if it exists --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetL1Validator returns the L1 validator if it exists # platform.getValidatorsAt (/docs/rpcs/p-chain/validators/platform_getValidatorsAt) --- title: platform.getValidatorsAt full: true _openapi: method: POST route: /ext/bc/P#platform.getValidatorsAt toc: [] structuredData: headings: [] contents: - content: >- GetValidatorsAt returns the weights of the validator set of a provided subnet at the specified height. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} GetValidatorsAt returns the weights of the validator set of a provided subnet at the specified height. # platform.sampleValidators (/docs/rpcs/p-chain/validators/platform_sampleValidators) --- title: platform.sampleValidators full: true _openapi: method: POST route: /ext/bc/P#platform.sampleValidators toc: [] structuredData: headings: [] contents: - content: SampleValidators returns a sampling of the list of current validators --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} SampleValidators returns a sampling of the list of current validators # Deploy Custom VM (/docs/tooling/avalanche-cli/create-avalanche-nodes/deploy-custom-vm) --- title: Deploy Custom VM description: This page demonstrates how to deploy a custom VM into cloud-based validators using Avalanche-CLI. --- Currently, only Fuji network and Devnets are supported. ALPHA WARNING: This command is currently in experimental mode. Proceed at your own risk. ## Prerequisites Before we begin, you will need to have: - Created a cloud server node as described [here](/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-aws) - Created a Custom VM, as described [here](/docs/primary-network/virtual-machines). - (Ignore for Devnet) Set up a key to be able to pay for transaction Fees, as described [here](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet). Currently, only AWS & GCP cloud services are supported. Deploying the VM[​](#deploying-the-vm "Direct link to heading") --------------------------------------------------------------- We will be deploying the [MorpheusVM](https://github.com/ava-labs/hypersdk/tree/main/examples/morpheusvm) example built with the HyperSDK. The following settings will be used: - Repo url: `https://github.com/ava-labs/hypersdk/` - Branch Name: `vryx-poc` - Build Script: `examples/morpheusvm/scripts/build.sh` The CLI needs a public repo url in order to be able to download and install the custom VM on cloud. ### Genesis File[​](#genesis-file "Direct link to heading") The following contents will serve as the chain genesis. They were generated using `morpheus-cli` as shown [here](https://github.com/ava-labs/hypersdk/blob/main/examples/morpheusvm/scripts/run.sh). Save it into a file with path `` (for example `~/morpheusvm_genesis.json`): ```bash { "stateBranchFactor":16, "minBlockGap":1000, "minUnitPrice":[1,1,1,1,1], "maxChunkUnits":[1800000,18446744073709551615,18446744073709551615,18446744073709551615,18446744073709551615], "epochDuration":60000, "validityWindow":59000, "partitions":8, "baseUnits":1, "baseWarpUnits":1024, "warpUnitsPerSigner":128, "outgoingWarpComputeUnits":1024, "storageKeyReadUnits":5, "storageValueReadUnits":2, "storageKeyAllocateUnits":20, "storageValueAllocateUnits":5, "storageKeyWriteUnits":10, "storageValueWriteUnits":3, "customAllocation": [ { "address":"morpheus1qrzvk4zlwj9zsacqgtufx7zvapd3quufqpxk5rsdd4633m4wz2fdjk97rwu", "balance":3000000000000000000 }, {"address":"morpheus1qryyvfut6td0l2vwn8jwae0pmmev7eqxs2vw0fxpd2c4lr37jj7wvrj4vc3", "balance":3000000000000000000 }, {"address":"morpheus1qp52zjc3ul85309xn9stldfpwkseuth5ytdluyl7c5mvsv7a4fc76g6c4w4", "balance":3000000000000000000 }, {"address":"morpheus1qzqjp943t0tudpw06jnvakdc0y8w790tzk7suc92aehjw0epvj93s0uzasn", "balance":3000000000000000000 }, {"address":"morpheus1qz97wx3vl3upjuquvkulp56nk20l3jumm3y4yva7v6nlz5rf8ukty8fh27r", "balance":3000000000000000000 } ] } ``` Create the Avalanche L1[​](#create-the-avalanche-l1 "Direct link to heading") ----------------------------------------------------------------- Let's create an Avalanche L1 called ``, with custom VM binary and genesis. ```bash avalanche blockchain create ``` Choose custom ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose your VM: Subnet-EVM ▸ Custom ``` Provide path to genesis: ```bash ✗ Enter path to custom genesis: ``` Provide the source code repo url: ```bash ✗ Source code repository URL: https://github.com/ava-labs/hypersdk/ ``` Set the branch and finally set the build script: ```bash ✗ Build script: examples/morpheusvm/scripts/build.sh ``` CLI will generate a locally compiled binary, and then create the Avalanche L1. ```bash Cloning into ... Successfully created subnet configuration ``` ## Deploy Avalanche L1 For this example, we will deploy the Avalanche L1 and blockchain on Fuji. Run: ```bash avalanche blockchain deploy ``` Choose Fuji: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose a network to deploy on: Local Network ▸ Fuji Mainnet ``` Use the stored key: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Which key source should be used to pay transaction fees?: ▸ Use stored key Use ledger ``` Choose `` as the key to use to pay the fees: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Which stored key should be used to pay transaction fees?: ▸ ``` Use the same key as the control key for the Avalanche L1: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? How would you like to set your control keys?: ▸ Use fee-paying key Use all stored keys Custom list ``` The successfully creation of our Avalanche L1 and blockchain is confirmed by the following output: ```bash Your Subnet's control keys: [P-fuji1dlwux652lkflgz79g3nsphjzvl6t35xhmunfk1] Your subnet auth keys for chain creation: [P-fuji1dlwux652lkflgz79g3nsphjzvl6t35xhmunfk1] Subnet has been created with ID: RU72cWmBmcXber6ZBPT7R5scFFuVSoFRudcS3vayf3L535ZE3 Now creating blockchain... +--------------------+----------------------------------------------------+ | DEPLOYMENT RESULTS | | +--------------------+----------------------------------------------------+ | Chain Name | blockchainName | +--------------------+----------------------------------------------------+ | Subnet ID | RU72cWmBmcXber6ZBPT7R5scFFuVSoFRudcS3vayf3L535ZE3 | +--------------------+----------------------------------------------------+ | VM ID | srEXiWaHq58RK6uZMmUNaMF2FzG7vPzREsiXsptAHk9gsZNvN | +--------------------+----------------------------------------------------+ | Blockchain ID | 2aDgZRYcSBsNoLCsC8qQH6iw3kUSF5DbRHM4sGEqVKwMSfBDRf | +--------------------+ + | P-Chain TXID | | +--------------------+----------------------------------------------------+ ``` Set the Config Files[​](#set-the-config-files "Direct link to heading") ----------------------------------------------------------------------- Avalanche-CLI supports uploading the full set of configuration files for a blockchain: - Genesis File - Blockchain Config - Avalanche L1 Config - Network Upgrades - AvalancheGo Config The following example uses all of them, but the user can decide to provide a subset of those. ### AvalancheGo Flags[​](#avalanchego-flags "Direct link to heading") Save the following content (as defined [here](https://github.com/ava-labs/hypersdk/blob/vryx-poc/examples/morpheusvm/tests/e2e/e2e_test.go)) into a file with path `` (for example `~/morpheusvm_avago.json`): ```json { "log-level":"INFO", "log-display-level":"INFO", "proposervm-use-current-height":true, "throttler-inbound-validator-alloc-size":"10737418240", "throttler-inbound-at-large-alloc-size":"10737418240", "throttler-inbound-node-max-processing-msgs":"1000000", "throttler-inbound-node-max-at-large-bytes":"10737418240", "throttler-inbound-bandwidth-refill-rate":"1073741824", "throttler-inbound-bandwidth-max-burst-size":"1073741824", "throttler-inbound-cpu-validator-alloc":"100000", "throttler-inbound-cpu-max-non-validator-usage":"100000", "throttler-inbound-cpu-max-non-validator-node-usage":"100000", "throttler-inbound-disk-validator-alloc":"10737418240000", "throttler-outbound-validator-alloc-size":"10737418240", "throttler-outbound-at-large-alloc-size":"10737418240", "throttler-outbound-node-max-at-large-bytes":"10737418240", "consensus-on-accept-gossip-validator-size":"10", "consensus-on-accept-gossip-peer-size":"10", "network-compression-type":"zstd", "consensus-app-concurrency":"128", "profile-continuous-enabled":true, "profile-continuous-freq":"1m", "http-host":"", "http-allowed-origins": "*", "http-allowed-hosts": "*" } ``` Then set the Avalanche L1 to use it by executing: ```bash avalanche blockchain configure blockchainName ``` Select node-config.json: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Which configuration file would you like to provide?: ▸ node-config.json chain.json subnet.json per-node-chain.json ``` Provide the path to the AvalancheGo config file: ```bash ✗ Enter the path to your configuration file: ``` Finally, choose no: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Would you like to provide the chain.json file as well?: ▸ No Yes File ~/.avalanche-cli/subnets/blockchainName/node-config.json successfully written ``` ### Blockchain Config[​](#blockchain-config "Direct link to heading") `morpheus-cli` as shown [here](https://github.com/ava-labs/hypersdk/blob/vryx-poc/examples/morpheusvm/scripts/run.sh). Save the following content (generated by this [script](https://github.com/ava-labs/hypersdk/blob/vryx-poc/examples/morpheusvm/scripts/run.sh)) in a known file path (for example `~/morpheusvm_chain.json`): ```json { "chunkBuildFrequency": 250, "targetChunkBuildDuration": 250, "blockBuildFrequency": 100, "mempoolSize": 2147483648, "mempoolSponsorSize": 10000000, "authExecutionCores": 16, "precheckCores": 16, "actionExecutionCores": 8, "missingChunkFetchers": 48, "verifyAuth": true, "authRPCCores": 48, "authRPCBacklog": 10000000, "authGossipCores": 16, "authGossipBacklog": 10000000, "chunkStorageCores": 16, "chunkStorageBacklog": 10000000, "streamingBacklogSize": 10000000, "continuousProfilerDir":"/home/ubuntu/morpheusvm-profiles", "logLevel": "INFO" } ``` Then set the Avalanche L1 to use it by executing: ```bash avalanche blockchain configure blockchainName ``` Select chain.json: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Which configuration file would you like to provide?: node-config.json ▸ chain.json subnet.json per-node-chain.json ``` Provide the path to the blockchain config file: ```bash ✗ Enter the path to your configuration file: ~/morpheusvm_chain.json ``` Finally choose no: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Would you like to provide the subnet.json file as well?: ▸ No Yes File ~/.avalanche-cli/subnets/blockchainName/chain.json successfully written ``` ### Avalanche L1 Config[​](#avalanche-l1-config "Direct link to heading") Save the following content (generated by this [script](https://github.com/ava-labs/hypersdk/blob/vryx-poc/examples/morpheusvm/scripts/run.sh)) in a known path (for example `~/morpheusvm_subnet.json`): ```json { "proposerMinBlockDelay": 0, "proposerNumHistoricalBlocks": 512 } ``` Then set the Avalanche L1 to use it by executing: ```bash avalanche blockchain configure blockchainName ``` Select `subnet.json`: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Which configuration file would you like to provide?: node-config.json chain.json ▸ subnet.json per-node-chain.json ``` Provide the path to the Avalanche L1 config file: ```bash ✗ Enter the path to your configuration file: ~/morpheusvm_subnet.json ``` Choose no: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Would you like to provide the chain.json file as well?: ▸ No Yes File ~/.avalanche-cli/subnets/blockchainName/subnet.json successfully written ``` ### Network Upgrades[​](#network-upgrades "Direct link to heading") Save the following content (currently with no network upgrades) in a known path (for example `~/morpheusvm_upgrades.json`): Then set the Avalanche L1 to use it by executing: ```bash avalanche blockchain upgrade import blockchainName ``` Provide the path to the network upgrades file: ```bash ✗ Provide the path to the upgrade file to import: ~/morpheusvm_upgrades.json ``` Deploy Our Custom VM[​](#deploy-our-custom-vm "Direct link to heading") ----------------------------------------------------------------------- To deploy our Custom VM, run: ```bash avalanche node sync ``` ```bash Node(s) successfully started syncing with Subnet! ``` Your custom VM is successfully deployed! You can also use `avalanche node update blockchain ` to reinstall the binary when the branch is updated, or update the config files. # Execute SSH Command (/docs/tooling/avalanche-cli/create-avalanche-nodes/execute-ssh-commands) --- title: Execute SSH Command description: This page demonstrates how to execute a SSH command on a Cluster or Node managed by Avalanche-CLI --- ALPHA WARNING: This command is currently in experimental mode. Proceed at your own risk. ## Prerequisites Before we begin, you will need to have a cluster managed by CLI, either a [Fuji Cluster using AWS](/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-aws), a [Fuji Cluster using GCP](/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-gcp), or a [Devnet](/docs/tooling/avalanche-cli/create-avalanche-nodes/setup-devnet), SSH Warning[​](#ssh-warning "Direct link to heading") ----------------------------------------------------- Note: An expected warning may be seen when executing the command on a given cluster for the first time: ```bash Warning: Permanently added 'IP' (ED25519) to the list of known hosts. ``` Get SSH Connection Instructions for All Clusters[​](#get-ssh-connection-instructions-for-all-clusters "Direct link to heading") ------------------------------------------------------------------------------------------------------------------------------- Just execute `node ssh`: ```bash avalanche node ssh Cluster "" (Devnet) [i-0cf58a280bf3ef9a1] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem [i-0e2abd71a586e56b4] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem [i-027417a4f2ca0a478] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem [i-0360a867aa295d8a4] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem [i-0759b102acfd5b585] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem ``` Get the AvalancheGo PID for All Nodes in ``[​](#get-the-avalanchego-pid-for-all-nodes-in-clustername "Direct link to heading") ------------------------------------------------------------------------------------------------------------------------------------------- ```bash avalanche node ssh pgrep avalanchego [i-0cf58a280bf3ef9a1] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem pgrep avalanchego 14508 [i-0e2abd71a586e56b4] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem pgrep avalanchego 14555 [i-027417a4f2ca0a478] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem pgrep avalanchego 14545 [i-0360a867aa295d8a4] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem pgrep avalanchego 14531 [i-0759b102acfd5b585] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem pgrep avalanchego 14555 ``` Please note that commands via `ssh` on cluster are executed sequentially by default. It's possible to run command on all nodes at the same time by using `--parallel=true` flag Get the AvalancheGo Configuration for All Nodes in ``[​](#get-the-avalanchego-configuration-for-all-nodes-in-clustername "Direct link to heading") --------------------------------------------------------------------------------------------------------------------------------------------------------------- ```bash avalanche node ssh cat /home/ubuntu/.avalanchego/configs/node.json [i-0cf58a280bf3ef9a1] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem cat /home/ubuntu/.avalanchego/configs/node.json { "bootstrap-ids": "", "bootstrap-ips": "", "genesis-file": "/home/ubuntu/.avalanchego/configs/genesis.json", "http-allowed-hosts": "*", "http-allowed-origins": "*", "http-host": "", "log-display-level": "info", "log-level": "info", "network-id": "network-1338", "public-ip": "44.219.113.190", "track-subnets": "giY8tswWgZmcAWzPkoNrmjjrykited7GJ9799SsFzTiq5a1ML" } [i-0e2abd71a586e56b4] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem cat /home/ubuntu/.avalanchego/configs/node.json { "bootstrap-ids": "NodeID-EzxsrhoumLsQSWxsohfMFrM1rJcaiaBK8", "bootstrap-ips": "44.219.113.190:9651", "genesis-file": "/home/ubuntu/.avalanchego/configs/genesis.json", "http-allowed-hosts": "*", "http-allowed-origins": "*", "http-host": "", "log-display-level": "info", "log-level": "info", "network-id": "network-1338", "public-ip": "3.212.206.161", "track-subnets": "giY8tswWgZmcAWzPkoNrmjjrykited7GJ9799SsFzTiq5a1ML" } [i-027417a4f2ca0a478] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem cat /home/ubuntu/.avalanchego/configs/node.json { "bootstrap-ids": "NodeID-EzxsrhoumLsQSWxsohfMFrM1rJcaiaBK8,NodeID-6veKG5dAz1uJvKc7qm7v6wAPDod8hctb9", "bootstrap-ips": "44.219.113.190:9651,3.212.206.161:9651", "genesis-file": "/home/ubuntu/.avalanchego/configs/genesis.json", "http-allowed-hosts": "*", "http-allowed-origins": "*", "http-host": "", "log-display-level": "info", "log-level": "info", "network-id": "network-1338", "public-ip": "54.87.168.26", "track-subnets": "giY8tswWgZmcAWzPkoNrmjjrykited7GJ9799SsFzTiq5a1ML" } [i-0360a867aa295d8a4] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem cat /home/ubuntu/.avalanchego/configs/node.json { "bootstrap-ids": "NodeID-EzxsrhoumLsQSWxsohfMFrM1rJcaiaBK8,NodeID-6veKG5dAz1uJvKc7qm7v6wAPDod8hctb9,NodeID-ASseyUweBT82XquiGpmUFjd9QfkUjxiAY", "bootstrap-ips": "44.219.113.190:9651,3.212.206.161:9651,54.87.168.26:9651", "genesis-file": "/home/ubuntu/.avalanchego/configs/genesis.json", "http-allowed-hosts": "*", "http-allowed-origins": "*", "http-host": "", "log-display-level": "info", "log-level": "info", "network-id": "network-1338", "public-ip": "3.225.42.57", "track-subnets": "giY8tswWgZmcAWzPkoNrmjjrykited7GJ9799SsFzTiq5a1ML" } [i-0759b102acfd5b585] ssh -o IdentitiesOnly=yes -o StrictHostKeyChecking=no [email protected] -i /home/fm/.ssh/fm-us-east-1-avalanche-cli-us-east-1-kp.pem cat /home/ubuntu/.avalanchego/configs/node.json { "bootstrap-ids": "NodeID-EzxsrhoumLsQSWxsohfMFrM1rJcaiaBK8,NodeID-6veKG5dAz1uJvKc7qm7v6wAPDod8hctb9,NodeID-ASseyUweBT82XquiGpmUFjd9QfkUjxiAY,NodeID-LfwbUp9dkhmWTSGffer9kNWNzqUQc2TEJ", "bootstrap-ips": "44.219.113.190:9651,3.212.206.161:9651,54.87.168.26:9651,3.225.42.57:9651", "genesis-file": "/home/ubuntu/.avalanchego/configs/genesis.json", "http-allowed-hosts": "*", "http-allowed-origins": "*", "http-host": "", "log-display-level": "info", "log-level": "info", "network-id": "network-1338", "public-ip": "107.21.158.224", "track-subnets": "giY8tswWgZmcAWzPkoNrmjjrykited7GJ9799SsFzTiq5a1ML" } ``` Executing Command on a Single Node[​](#executing-command-on-a-single-node "Direct link to heading") --------------------------------------------------------------------------------------------------- As we all know command can be executed on single node similar to the examples above To execute ssh command on a single node, use ``, `` or `` instead of `` as an argument. For example: ```bash avalanche node ssh i-0225fc39626b1edd3 [or] avalanche node ssh NodeID-9wdKQ3KJU3GqvgFTc4CUYvmefEFe8t6ka [or] avalanche node ssh 54.159.59.123 ``` In this case `--parallel=true` flag will be ignored Opening SSH Shell for ``[​](#opening-ssh-shell-for-nodeid "Direct link to heading") ------------------------------------------------------------------------------------------- If no command is provided, Avalanche-CLI will open an interactive session for the specified node. For example: ```bash avalanche node ssh i-0225fc39626b1edd3 [or] avalanche node ssh NodeID-9wdKQ3KJU3GqvgFTc4CUYvmefEFe8t6ka [or] avalanche node ssh 54.159.59.123 ``` Please use `exit` shell command or Ctrl+D to end this session. # Run Load Test (/docs/tooling/avalanche-cli/create-avalanche-nodes/run-loadtest) --- title: Run Load Test description: This page demonstrates how to run load test on an Avalanche L1 deployed on a cluster of cloud-based validators using Avalanche-CLI. --- ## Prerequisites Before we begin, you will need to have: - Created an AWS account and have an updated AWS `credentials` file in home directory with [default] profile or set up your GCP account according to [here](/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-gcp) - Created a cluster of cloud servers with monitoring enabled - Deployed an Avalanche L1 into the cluster - Added the cloud servers as validator nodes in the Avalanche L1 ## Run Load Test When the load test command is run, a new cloud server will be created to run the load test. The created cloud server is referred by the name `` and you can use any name of your choice. To start load test, run: ```bash avalanche node loadtest start ``` Next, you will need to provide the load test Git repository URL, load test Git Branch, the command to build the load test binary and the command to run the load test binary. We will use an example of running load test on an Avalanche L1 running custom VM MorpheusVM built with [HyperSDK](https://github.com/ava-labs/hypersdk/tree/main/examples/morpheusvm). The following settings will be used: - Load Test Repo URL: `https://github.com/ava-labs/hypersdk/` - Load Test Branch: `vryx-poc` - Load Test Build Script: `cd /home/ubuntu/hypersdk/examples/morpheusvm; CGO_CFLAGS=\"-O -D__BLST_PORTABLE__\" go build -o ~/simulator ./cmd/morpheus-cli` - Load Test Run Script: `/home/ubuntu/simulator spam run ed25519 --accounts=10000000 --txs-per-second=100000 --min-capacity=15000 --step-size=1000 --s-zipf=1.0001 --v-zipf=2.7 --conns-per-host=10 --cluster-info=/home/ubuntu/clusterInfo.yaml --private-key=323b1d8f4eed5f0da9da93071b034f2dce9d2d22692c172f3cb252a64ddfafd01b057de320297c29ad0c1f589ea216869cf1938d88c9fbd70d6748323dbf2fa7` Once the command is run, you will be able to see the logs from the load test in the cluster's Grafana URL like the example below: ![Centralized Logs](/images/centralized-logs.png) ## Stop Load Test To stop the load test process on the load test instance `` and terminate the load test instance, run: ```bash avalanche node loadtest stop ``` # Run Validator on AWS (/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-aws) --- title: Run Validator on AWS description: This page demonstrates how to deploy Avalanche validators on AWS using just one Avalanche-CLI command. --- This page demonstrates how to deploy Avalanche validators on AWS using just one Avalanche-CLI command. Currently, only Fuji network and Devnets are supported. ALPHA WARNING: This command is currently in experimental mode. Proceed at your own risk. ## Prerequisites Before we begin, you will need to create an AWS account and have an AWS `credentials` file in home directory with \[default\] profile set. More info can be found [here](https://docs.aws.amazon.com/sdkref/latest/guide/file-format.html#file-format-creds) ## Create Validators To create Avalanche validators, run: ```bash avalanche node create ``` The created nodes will be part of cluster `clusterName` and all avalanche node commands applied to cluster `clusterName` will apply to all nodes in the cluster. Please note that running a validator on AWS will incur costs. Ava Labs is not responsible for the cost incurred from running an Avalanche validator on cloud services via Avalanche-CLI. Currently, we have set the following specs of the AWS cloud server to a fixed value, but we plan to enable customization in the near future: - OS Image: `Ubuntu 20.04 LTS (HVM), SSD Volume Type` - Storage: `1 TB` Instance type can be specified via `--node-type` parameter or via interactive menu. `c5.2xlarge` is the default(recommended) instance size. The command will ask which region you want to set up your cloud server in: ```bash Which AWS region do you want to set up your node in?: ▸ us-east-1 us-east-2 us-west-1 us-west-2 Choose custom region (list of regions available at https://docs.aws.amazon.com/AWSEC2/latest/UserGuide/using-regions-availability-zones.html) ``` The command will next ask whether you want to set up monitoring for your nodes. ```bash Do you want to set up a separate instance to host monitoring? (This enables you to monitor all your set up instances in one dashboard): ▸ Yes No ``` Setting up monitoring on a separate AWS instance enables you to have a centralized Grafana logs and dashboard for all nodes in a cluster, as seen below: ![Centralized Logs](/images/centralized-logs.png) ![Main Dashboard](/images/run-validators1.png) The separate monitoring AWS instance will have similar specs to the default AWS cloud server, except for its storage, which will be set to 50 GB. Please note that setting up monitoring on a separate AWS instance will incur additional cost of setting up an additional AWS cloud server. The command will then ask which Avalanche Go version you would like to install in the cloud server. You can choose `default` (which will install the latest version) or you can enter the name of an Avalanche L1 created with CLI that you plan to be validated by this node (we will get the latest version that is compatible with the deployed Avalanche L1's RPC version). Once the command has successfully completed, Avalanche-CLI outputs all the created cloud server node IDs as well as the public IP that each node can be reached at. Avalanche-CLI also outputs the command that you can use to ssh into each cloud server node. Finally, if monitoring is set up, Avalanche-CLI will also output the Grafana link where the centralized dashboards and logs can be accessed. By the end of successful run of `create` command, Avalanche-CLI would have: - Installed Avalanche Go in cloud server - Installed Avalanche CLI in cloud server - Downloaded the `.pem` private key file to access the cloud server into your local `.ssh` directory. Back up this private key file as you will not be able to ssh into the cloud server node without it (unless `ssh-agent` is used). - Downloaded `staker.crt` and `staker.key` files to your local `.avalanche-cli` directory so that you can back up your node. More info about node backup can be found [here](/docs/nodes/maintain/backup-restore) - Started the process of bootstrapping your new Avalanche node to the Primary Network (for non-Devnet only). Please note that Avalance CLI can be configured to use `ssh-agent` for ssh communication. In this case public key will be read from there and cloud server will be accessible using it. Yubikey hardware can be also used to store private ssh key. Please use official Yubikey documentation, for example \[[https://developers.yubico.com/PGP/SSH\_authentication/](https://developers.yubico.com/PGP/SSH_authentication/)\] for more details. Check Bootstrap Status[​](#check-bootstrap-status "Direct link to heading") --------------------------------------------------------------------------- Ignore for Devnet Please note that you will have to wait until the nodes have finished bootstrapping before the nodes can be Primary Network or Avalanche L1 Validators. To check whether all the nodes in a cluster have finished bootstrapping, run `avalanche node status `. # Run Validator on GCP (/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-gcp) --- title: Run Validator on GCP description: This page demonstrates how to deploy Avalanche validators on GCP using just one Avalanche-CLI command. --- This page demonstrates how to deploy Avalanche validators on GCP using just one Avalanche-CLI command. Currently, only Fuji network and Devnets are supported. ALPHA WARNING: This command is currently in experimental mode. Proceed at your own risk. ## Prerequisites Before we begin, you will need to: - Create a GCP account [here](https://console.cloud.google.com/freetrial) and create a new project - Enable Compute Engine API [here](https://console.cloud.google.com/apis/api/compute.googleapis.com) - Download the key json for the automatically created service account as shown [here](https://cloud.google.com/iam/docs/keys-create-delete#creating) ## Create Validator To create Avalanche validators, run: ```bash avalanche node create ``` The created nodes will be part of cluster `clusterName` and all avalanche node commands applied to cluster `clusterName` will apply to all nodes in the cluster. Please note that running a validator on GCP will incur costs. Ava Labs is not responsible for the cost incurred from running an Avalanche validator on cloud services via Avalanche-CLI. Currently, we have set the following specs of the GCP cloud server to a fixed value, but we plan to enable customization in the near future: - OS Image: `Ubuntu 20.04 LTS` - Storage: `1 TB` Instance type can be specified via `--node-type` parameter or via interactive menu. `e2-standard-8` is default(recommended) instance size. The command will ask which region you want to set up your cloud server in: ```bash Which Google Region do you want to set up your node(s) in?: ▸ us-east1 us-central1 us-west1 Choose custom Google Region (list of Google Regions available at https://cloud.google.com/compute/docs/regions-zones/) ``` The command will next ask whether you want to set up monitoring for your nodes. ```bash Do you want to set up a separate instance to host monitoring? (This enables you to monitor all your set up instances in one dashboard): ▸ Yes No ``` Setting up monitoring on a separate GCP instance enables you to have a unified Grafana dashboard for all nodes in a cluster, as seen below: ![Centralized Logs](/images/centralized-logs.png) ![Main Dashboard](/images/gcp1.png) The separate monitoring GCP instance will have similar specs to the default GCP cloud server, except for its storage, which will be set to 50 GB. Please note that setting up monitoring on a separate GCP instance will incur additional cost of setting up an additional GCP cloud server. The command will then ask which Avalanche Go version you would like to install in the cloud server. You can choose `default` (which will install the latest version) or you can enter the name of an Avalanche L1 created with CLI that you plan to be validated by this node (we will get the latest version that is compatible with the deployed Avalanche L1's RPC version). Once the command has successfully completed, Avalanche-CLI outputs all the created cloud server node IDs as well as the public IP that each node can be reached at. Avalanche-CLI also outputs the command that you can use to ssh into each cloud server node. Finally, if monitoring is set up, Avalanche-CLI will also output the Grafana link where the centralized dashboards and logs can be accessed. By the end of successful run of `create` command, Avalanche-CLI would have: - Installed Avalanche Go in cloud server - Installed Avalanche CLI in cloud server - Downloaded the `.pem` private key file to access the cloud server into your local `.ssh` directory. Back up this private key file as you will not be able to ssh into the cloud server node without it (unless `ssh-agent` is used). - Downloaded `staker.crt` and `staker.key` files to your local `.avalanche-cli` directory so that you can back up your node. More info about node backup can be found [here](/docs/nodes/maintain/backup-restore) - Started the process of bootstrapping your new Avalanche node to the Primary Network Please note that Avalanche CLI can be configured to use `ssh-agent` for ssh access to cloud server. Yubikey hardware can be also used to store private ssh key. Please use official Yubikey documentation, for example \[[https://developers.yubico.com/PGP/SSH\_authentication/](https://developers.yubico.com/PGP/SSH_authentication/)\] for more details. Check Bootstrap Status[​](#check-bootstrap-status "Direct link to heading") --------------------------------------------------------------------------- Ignore for Devnet Please note that you will have to wait until the nodes have finished bootstrapping before the nodes can be Primary Network or Avalanche L1 Validators. To check whether all the nodes in a cluster have finished bootstrapping, run `avalanche node status `. # Setup a Devnet (/docs/tooling/avalanche-cli/create-avalanche-nodes/setup-devnet) --- title: Setup a Devnet description: This page demonstrates how to setup a Devnet of cloud-based validators using Avalanche-CLI, and deploy a VM into it. --- Devnets (Developer Networks) are isolated Avalanche networks deployed on the cloud. Similar to local networks in terms of configuration and usage but installed on remote nodes. Think of DevNets as being an intermediate step in the developer testing process after local network and before Fuji network. ALPHA WARNING: This command is currently in experimental mode. Proceed at your own risk. ## Prerequisites Before we begin, you will need to create an AWS account and have an updated AWS `credentials` file in home directory with [default] profile or set up your GCP account according to [here](/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-gcp). Note: the tutorial uses AWS hosts, but Devnets can also be created and operated in other supported cloud providers, such as GCP. ## Setting up a Devnet Setting up a Devnet consists of: - Creating a cluster of cloud servers - Deploying an Avalanche L1 into the cluster - Adding the cloud servers as validator nodes in the Avalanche L1 To execute all steps above in one command, run: ```bash avalanche node devnet wiz ``` Command line flags can be used instead of interacting with the prompts. The complete command line flags for `devnet wiz` command can be found [here](/docs/tooling/cli-commands#node-devnet-wiz). Let's go through several examples with the full command (with flags) provided. ### Create a Devnet and Deploy Subnet-EVM Based Avalanche L1 into the Devnet For example, to spin up a Devnet with 5 validator nodes and 1 API node in 5 regions each (us-west-2,us-east-1,ap-south-1,ap-northeast-1,eu-west-1) in AWS with each node having spec of c7g.8xlarge AWS EC2 instance type and io2 volume type, with Avalanche L1 `` deployed into the Devnet, we will run : ```bash avalanche node devnet wiz --authorize-access --aws --num-apis 1,1,1,1,1 --num-validators 5,5,5,5,5 --region us-west-2,us-east-1,ap-south-1,ap-northeast-1,eu-west-1 --default-validator-params --node-type c7g.8xlarge --aws-volume-type=io2 Creating the devnet ... Waiting for node(s) in cluster to be healthy... ... Nodes healthy after 33 seconds Deploying the subnet ... Setting the nodes as subnet trackers ... Waiting for node(s) in cluster to be healthy... Nodes healthy after 33 seconds ... Waiting for node(s) in cluster to be syncing subnet ... Nodes Syncing after 5 seconds Adding nodes as subnet validators ... Waiting for node(s) in cluster to be validating subnet ... Nodes Validating after 23 seconds Devnet has been created and is validating subnet ! ``` ### Create a Devnet and Deploy a Custom VM based Avalanche L1 into the Devnet For this example, we will be using the custom VM [MorpheusVM](https://github.com/ava-labs/hypersdk/tree/main/examples/morpheusvm) built with [HyperSDK](https://github.com/ava-labs/hypersdk). The following settings will be used: - `` `https://github.com/ava-labs/hypersdk/` - `` `vryx-poc` - `` `examples/morpheusvm/scripts/build.sh` - `` [Genesis File](/docs/tooling/avalanche-cli/create-avalanche-nodes/deploy-custom-vm#genesis-file) - `` [Blockchain Config](/docs/tooling/avalanche-cli/create-avalanche-nodes/deploy-custom-vm#blockchain-config) - `` [Avalanche L1 Config](/docs/tooling/avalanche-cli/create-avalanche-nodes/deploy-custom-vm#avalanche-l1-config) - `` [AvalancheGo Config](/docs/tooling/avalanche-cli/create-avalanche-nodes/deploy-custom-vm#avalanchego-flags) To spin up a Devnet with 5 validator nodes and 1 API node in 5 regions each (us-west-2,us-east-1,ap-south-1,ap-northeast-1,eu-west-1) in AWS with each node having spec of c7g.8xlarge AWS EC2 instance type and io2 volume type, with the Custom VM based Avalanche L1 `` deployed into the Devnet, we will run : ```bash avalanche node devnet wiz --custom-subnet \ --subnet-genesis --custom-vm-repo-url \ --custom-vm-branch --custom-vm-build-script \ --chain-config --subnet-config \ --node-config --authorize-access --aws --num-apis 1,1,1,1,1 \ --num-validators 5,5,5,5,5 --region us-west-2,us-east-1,ap-south-1,ap-northeast-1,eu-west-1 \ --default-validator-params --node-type default Creating the subnet ... Creating the devnet ... Waiting for node(s) in cluster to be healthy... ... Nodes healthy after 33 seconds Deploying the subnet ... Setting the nodes as subnet trackers ... Waiting for node(s) in cluster to be healthy... Nodes healthy after 33 seconds ... Waiting for node(s) in cluster to be syncing subnet ... Nodes Syncing after 5 seconds Adding nodes as subnet validators ... Waiting for node(s) in cluster to be validating subnet ... Nodes Validating after 23 seconds Devnet has been created and is validating subnet ! ``` # Terminate All Nodes (/docs/tooling/avalanche-cli/create-avalanche-nodes/stop-node) --- title: Terminate All Nodes description: This page provides instructions for terminating cloud server nodes created by Avalanche-CLI. --- ALPHA WARNING: This command is currently in experimental mode. Proceed at your own risk. Terminating All Nodes[​](#terminating-all-nodes "Direct link to heading") ------------------------------------------------------------------------- To terminate all nodes in a cluster, run: ```bash avalanche node destroy ``` ALPHA WARNING: This command will delete all files associated with the cloud servers in the cluster. This includes the downloaded `staker.crt` and `staker.key` files in your local `.avalanche-cli` directory (which are used to back up your node). More info about node backup can be found [here](/docs/nodes/maintain/backup-restore). Once completed, the instance set up on AWS / GCP would have been terminated and the Static Public IP associated with it would have been released. # Validate the Primary Network (/docs/tooling/avalanche-cli/create-avalanche-nodes/validate-primary-network) --- title: Validate the Primary Network description: This page demonstrates how to configure nodes to validate the Primary Network. Validation via Avalanche-CLI is currently only supported on Fuji. --- ALPHA WARNING: This command is currently in experimental mode. Proceed at your own risk. ## Prerequisites Before we begin, you will need to have: - Created a Cloud Server node as described for [AWS](/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-aws) or [GCP](/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-gcp) - A node bootstrapped to the Primary Network (run `avalanche node status `to check bootstrap status as described [here](/docs/tooling/avalanche-cli/create-avalanche-nodes/run-validators-aws#check-bootstrap-status) - Stored key / Ledger with AVAX to pay for gas fess associated with adding node as Primary Network. Instructions on how to fund stored key on Fuji can be found [here](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet#funding-the-key). Be a Primary Network Validator[​](#be-a-primary-network-validator "Direct link to heading") ------------------------------------------------------------------------------------------- Once all nodes in a cluster are bootstrapped to Primary Network, we can now have the nodes be Primary Network Validators. To have all nodes in cluster `clusterName` be Primary Network Validators, run: ```bash avalanche node validate primary ``` The nodes will start validating the Primary Network 20 seconds after the command is run. The wizard will ask us how we want to pay for the transaction fee. Choose `Use stored key` for Fuji: ```bash Which key source should be used to pay transaction fees?: ▸ Use stored key Use ledger ``` Once you have selected the key to pay with, choose how many AVAX you would like to stake in the validator. Default is the minimum amount of AVAX that can be staked in a Fuji Network Validator. More info regarding minimum staking amount in different networks can be found [here](/docs/primary-network/validate/how-to-stake#fuji-testnet). ```bash What stake weight would you like to assign to the validator?: ▸ Default (1.00 AVAX) Custom ``` Next, choose how long the node will be validating for: ```bash How long should your validator validate for?: ▸ Minimum staking duration on primary network Custom ``` Once all the inputs are completed you will see transaction IDs indicating that all the nodes in the cluster will be Primary Network Validators once the start time has elapsed. # On Local Network (/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-locally) --- title: On Local Network description: This guide shows you how to deploy an Avalanche L1 to a local Avalanche network. --- This how-to guide focuses on taking an already created Avalanche L1 configuration and deploying it to a local Avalanche network. ## Prerequisites - [Avalanche-CLI installed](/docs/tooling/avalanche-cli) - You have [created an Avalanche L1 configuration](/docs/tooling/avalanche-cli#create-your-avalanche-l1-configuration) Deploying Avalanche L1s Locally[​](#deploying-avalanche-l1s-locally "Direct link to heading") --------------------------------------------------------------------------------- In the following commands, make sure to substitute the name of your Avalanche L1 configuration for ``. To deploy your Avalanche L1, run: ```bash avalanche blockchain deploy ``` and select `Local Network` to deploy on. Alternatively, you can bypass this prompt by providing the `--local` flag. For example: ```bash avalanche blockchain deploy --local ``` The command may take a couple minutes to run. Note: If you run `bash` on your shell and are running Avalanche-CLI on ARM64 on Mac, you will require Rosetta 2 to be able to deploy Avalanche L1s locally. You can download Rosetta 2 using `softwareupdate --install-rosetta` . ### Results[​](#results "Direct link to heading") If all works as expected, the command output should look something like this: ```bash > avalanche blockchain deploy myblockchain ✔ Local Network Deploying [myblockchain] to Local Network AvalancheGo path: /Users/felipe.madero/.avalanche-cli/bin/avalanchego/avalanchego-v1.13.0/avalanchego Booting Network. Wait until healthy... Node logs directory: /Users/felipe.madero/.avalanche-cli/runs/network_20250410_104205//logs Network ready to use. Using [P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p] to be set as a change owner for leftover AVAX AvalancheGo path: /Users/felipe.madero/.avalanche-cli/bin/avalanchego/avalanchego-v1.13.0/avalanchego ✓ Local cluster myblockchain-local-node-local-network not found. Creating... Starting local avalanchego node using root: /Users/felipe.madero/.avalanche-cli/local/myblockchain-local-node-local-network ... ✓ Booting Network. Wait until healthy... ✓ Avalanchego started and ready to use from /Users/felipe.madero/.avalanche-cli/local/myblockchain-local-node-local-network Node logs directory: /Users/felipe.madero/.avalanche-cli/local/myblockchain-local-node-local-network//logs Network ready to use. URI: http://127.0.0.1:60172 NodeID: NodeID-NuQc8BQ8mV9TVksgMtpyc57VnWzU2J6aN Your blockchain control keys: [P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p] Your blockchain auth keys for chain creation: [P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p] CreateSubnetTx fee: 0.000010278 AVAX Blockchain has been created with ID: 2W9boARgCWL25z6pMFNtkCfNA5v28VGg9PmBgUJfuKndEdhrvw Now creating blockchain... CreateChainTx fee: 0.000129564 AVAX +--------------------------------------------------------------------+ | DEPLOYMENT RESULTS | +---------------+----------------------------------------------------+ | Chain Name | myblockchain | +---------------+----------------------------------------------------+ | Subnet ID | 2W9boARgCWL25z6pMFNtkCfNA5v28VGg9PmBgUJfuKndEdhrvw | +---------------+----------------------------------------------------+ | VM ID | qDNV9vtxZYYNqm7TN1mYBuaaknLdefDbFK8bFmMLTJQJKaWjV | +---------------+----------------------------------------------------+ | Blockchain ID | Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y | +---------------+ | | P-Chain TXID | | +---------------+----------------------------------------------------+ Now calling ConvertSubnetToL1Tx... ConvertSubnetToL1Tx fee: 0.000036992 AVAX ConvertSubnetToL1Tx ID: 2d2EE7AorEhfKLBtnDGnAtcDYMGfPbWnHYDpNDm3SopYg6VtpV Waiting for the Subnet to be converted into a sovereign L1 ... 100% [===============] Validator Manager Protocol: ACP99 Restarting node NodeID-NuQc8BQ8mV9TVksgMtpyc57VnWzU2J6aN to track newly deployed subnet/s Waiting for blockchain Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y to be bootstrapped ✓ Local Network successfully tracking myblockchain ✓ Checking if node is healthy... ✓ Node is healthy after 0 seconds Initializing Proof of Authority Validator Manager contract on blockchain myblockchain ... ✓ Proof of Authority Validator Manager contract successfully initialized on blockchain myblockchain Your L1 is ready for on-chain interactions. RPC Endpoint: http://127.0.0.1:60172/ext/bc/Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y/rpc ICM Messenger successfully deployed to myblockchain (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) ICM Registry successfully deployed to myblockchain (0xEc7018552DC7E197Af85f157515f5976b1A15B12) ICM Messenger successfully deployed to c-chain (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) ICM Registry successfully deployed to c-chain (0x17aB05351fC94a1a67Bf3f56DdbB941aE6c63E25) ✓ ICM is successfully deployed Generating relayer config file at /Users/felipe.madero/.avalanche-cli/runs/network_20250410_104205/icm-relayer-config.json Relayer version icm-relayer-v1.6.2 Executing Relayer ✓ Relayer is successfully deployed +--------------------------------------------------------------------------------------------------------------------------------+ | MYBLOCKCHAIN | +---------------+----------------------------------------------------------------------------------------------------------------+ | Name | myblockchain | +---------------+----------------------------------------------------------------------------------------------------------------+ | VM ID | qDNV9vtxZYYNqm7TN1mYBuaaknLdefDbFK8bFmMLTJQJKaWjV | +---------------+----------------------------------------------------------------------------------------------------------------+ | VM Version | v0.7.3 | +---------------+----------------------------------------------------------------------------------------------------------------+ | Validation | Proof Of Authority | +---------------+--------------------------+-------------------------------------------------------------------------------------+ | Local Network | ChainID | 888 | | +--------------------------+-------------------------------------------------------------------------------------+ | | SubnetID | 2W9boARgCWL25z6pMFNtkCfNA5v28VGg9PmBgUJfuKndEdhrvw | | +--------------------------+-------------------------------------------------------------------------------------+ | | Owners (Threhold=1) | P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p | | +--------------------------+-------------------------------------------------------------------------------------+ | | BlockchainID (CB58) | Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y | | +--------------------------+-------------------------------------------------------------------------------------+ | | BlockchainID (HEX) | 0x48644613a5ef255fa171bf4773df668b57ea0ea9593df8927a6d9f32376a9c6f | | +--------------------------+-------------------------------------------------------------------------------------+ | | RPC Endpoint | http://127.0.0.1:60172/ext/bc/Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y/rpc | +---------------+--------------------------+-------------------------------------------------------------------------------------+ +------------------------------------------------------------------------------------+ | ICM | +---------------+-----------------------+--------------------------------------------+ | Local Network | ICM Messenger Address | 0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf | | +-----------------------+--------------------------------------------+ | | ICM Registry Address | 0xEc7018552DC7E197Af85f157515f5976b1A15B12 | +---------------+-----------------------+--------------------------------------------+ +--------------------------+ | TOKEN | +--------------+-----------+ | Token Name | TST Token | +--------------+-----------+ | Token Symbol | TST | +--------------+-----------+ +---------------------------------------------------------------------------------------------------------------------------------------+ | INITIAL TOKEN ALLOCATION | +-------------------------+------------------------------------------------------------------+--------------+---------------------------+ | DESCRIPTION | ADDRESS AND PRIVATE KEY | AMOUNT (TST) | AMOUNT (WEI) | +-------------------------+------------------------------------------------------------------+--------------+---------------------------+ | Main funded account | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | 1000000 | 1000000000000000000000000 | | ewoq | 56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027 | | | +-------------------------+------------------------------------------------------------------+--------------+---------------------------+ | Used by ICM | 0xf34408C05e3B339B1c89d15163d4B9D96845597A | 600 | 600000000000000000000 | | cli-teleporter-deployer | 30d57c7b6e7e393e2e4ce8166768b497cc37930361a15b1c647d6e665d88afff | | | +-------------------------+------------------------------------------------------------------+--------------+---------------------------+ +----------------------------------------------------------------------------------------------------------------------------------+ | SMART CONTRACTS | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | DESCRIPTION | ADDRESS | DEPLOYER | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | Validator Messages Lib | 0x9C00629cE712B0255b17A4a657171Acd15720B8C | | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | Proxy Admin | 0xC0fFEE1234567890aBCdeF1234567890abcDef34 | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | ACP99 Compatible PoA Validator Manager | 0x0C0DEbA5E0000000000000000000000000000000 | | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | Transparent Proxy | 0x0Feedc0de0000000000000000000000000000000 | | +----------------------------------------+--------------------------------------------+--------------------------------------------+ +----------------------------------------------------------------------+ | INITIAL PRECOMPILE CONFIGS | +------------+-----------------+-------------------+-------------------+ | PRECOMPILE | ADMIN ADDRESSES | MANAGER ADDRESSES | ENABLED ADDRESSES | +------------+-----------------+-------------------+-------------------+ | Warp | n/a | n/a | n/a | +------------+-----------------+-------------------+-------------------+ +-------------------------------------------------------------------------------------------------+ | MYBLOCKCHAIN RPC URLS | +-----------+-------------------------------------------------------------------------------------+ | Localhost | http://127.0.0.1:60172/ext/bc/Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y/rpc | +-----------+-------------------------------------------------------------------------------------+ +------------------------------------------------------------------+ | PRIMARY NODES | +------------------------------------------+-----------------------+ | NODE ID | LOCALHOST ENDPOINT | +------------------------------------------+-----------------------+ | NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg | http://127.0.0.1:9650 | +------------------------------------------+-----------------------+ | NodeID-MFrZFVCXPv5iCn6M9K6XduxGTYp891xXZ | http://127.0.0.1:9652 | +------------------------------------------+-----------------------+ +----------------------------------------------------------------------------------+ | L1 NODES | +------------------------------------------+------------------------+--------------+ | NODE ID | LOCALHOST ENDPOINT | L1 | +------------------------------------------+------------------------+--------------+ | NodeID-NuQc8BQ8mV9TVksgMtpyc57VnWzU2J6aN | http://127.0.0.1:60172 | myblockchain | +------------------------------------------+------------------------+--------------+ +-------------------------------------------------------------------------------------------------------+ | WALLET CONNECTION | +-----------------+-------------------------------------------------------------------------------------+ | Network RPC URL | http://127.0.0.1:60172/ext/bc/Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y/rpc | +-----------------+-------------------------------------------------------------------------------------+ | Network Name | myblockchain | +-----------------+-------------------------------------------------------------------------------------+ | Chain ID | 888 | +-----------------+-------------------------------------------------------------------------------------+ | Token Symbol | TST | +-----------------+-------------------------------------------------------------------------------------+ | Token Name | TST Token | +-----------------+-------------------------------------------------------------------------------------+ ✓ L1 is successfully deployed on Local Network ``` You can use the deployment details to connect to and interact with your Avalanche L1. Deploying Avalanche L1s Locally[​](#deploying-avalanche-l1s-locally) --------------------------------------------------------------------------------- To deploy your Avalanche L1, run: ```bash avalanche blockchain deploy myblockchain ``` Make sure to substitute the name of your Avalanche L1 if you used a different one than `myblockchain`. ```bash ? Choose a network for the operation: ▸ Local Network Devnet Etna Devnet Fuji Testnet Mainnet ``` Next, select `Local Network`. This command boots a three node Avalanche network on your machine: - Two nodes to act as primary validators for the local network, that will validate the local P and C chains (unrelated to testnet/mainnet).. - One node to act as sovereign validator for the new L1 that is deployed into the local network. The command needs to download the latest versions of AvalancheGo and Subnet-EVM. It may take a couple minutes to run. Note: If you run `bash` on your shell and are running Avalanche-CLI on ARM64 on Mac, you will require Rosetta 2 to be able to deploy Avalanche L1s locally. You can download Rosetta 2 using `softwareupdate --install-rosetta` . If all works as expected, the command output should look something like this: ```bash avalanche blockchain deploy myblockchain # output ✔ Local Network Deploying [myblockchain] to Local Network AvalancheGo path: /Users/felipe.madero/.avalanche-cli/bin/avalanchego/avalanchego-v1.13.0/avalanchego Booting Network. Wait until healthy... Node logs directory: /Users/felipe.madero/.avalanche-cli/runs/network_20250410_104205//logs Network ready to use. Using [P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p] to be set as a change owner for leftover AVAX AvalancheGo path: /Users/felipe.madero/.avalanche-cli/bin/avalanchego/avalanchego-v1.13.0/avalanchego ✓ Local cluster myblockchain-local-node-local-network not found. Creating... Starting local avalanchego node using root: /Users/felipe.madero/.avalanche-cli/local/myblockchain-local-node-local-network ... ✓ Booting Network. Wait until healthy... ✓ Avalanchego started and ready to use from /Users/felipe.madero/.avalanche-cli/local/myblockchain-local-node-local-network Node logs directory: /Users/felipe.madero/.avalanche-cli/local/myblockchain-local-node-local-network//logs Network ready to use. URI: http://127.0.0.1:60172 NodeID: NodeID-NuQc8BQ8mV9TVksgMtpyc57VnWzU2J6aN Your blockchain control keys: [P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p] Your blockchain auth keys for chain creation: [P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p] CreateSubnetTx fee: 0.000010278 AVAX Blockchain has been created with ID: 2W9boARgCWL25z6pMFNtkCfNA5v28VGg9PmBgUJfuKndEdhrvw Now creating blockchain... CreateChainTx fee: 0.000129564 AVAX +--------------------------------------------------------------------+ | DEPLOYMENT RESULTS | +---------------+----------------------------------------------------+ | Chain Name | myblockchain | +---------------+----------------------------------------------------+ | Subnet ID | 2W9boARgCWL25z6pMFNtkCfNA5v28VGg9PmBgUJfuKndEdhrvw | +---------------+----------------------------------------------------+ | VM ID | qDNV9vtxZYYNqm7TN1mYBuaaknLdefDbFK8bFmMLTJQJKaWjV | +---------------+----------------------------------------------------+ | Blockchain ID | Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y | +---------------+ | | P-Chain TXID | | +---------------+----------------------------------------------------+ Now calling ConvertSubnetToL1Tx... ConvertSubnetToL1Tx fee: 0.000036992 AVAX ConvertSubnetToL1Tx ID: 2d2EE7AorEhfKLBtnDGnAtcDYMGfPbWnHYDpNDm3SopYg6VtpV Waiting for the Subnet to be converted into a sovereign L1 ... 100% [===============] Validator Manager Protocol: ACP99 Restarting node NodeID-NuQc8BQ8mV9TVksgMtpyc57VnWzU2J6aN to track newly deployed subnet/s Waiting for blockchain Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y to be bootstrapped ✓ Local Network successfully tracking myblockchain ✓ Checking if node is healthy... ✓ Node is healthy after 0 seconds Initializing Proof of Authority Validator Manager contract on blockchain myblockchain ... ✓ Proof of Authority Validator Manager contract successfully initialized on blockchain myblockchain Your L1 is ready for on-chain interactions. RPC Endpoint: http://127.0.0.1:60172/ext/bc/Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y/rpc ICM Messenger successfully deployed to myblockchain (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) ICM Registry successfully deployed to myblockchain (0xEc7018552DC7E197Af85f157515f5976b1A15B12) ICM Messenger successfully deployed to c-chain (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) ICM Registry successfully deployed to c-chain (0x17aB05351fC94a1a67Bf3f56DdbB941aE6c63E25) ✓ ICM is successfully deployed Generating relayer config file at /Users/felipe.madero/.avalanche-cli/runs/network_20250410_104205/icm-relayer-config.json Relayer version icm-relayer-v1.6.2 Executing Relayer ✓ Relayer is successfully deployed +--------------------------------------------------------------------------------------------------------------------------------+ | MYBLOCKCHAIN | +---------------+----------------------------------------------------------------------------------------------------------------+ | Name | myblockchain | +---------------+----------------------------------------------------------------------------------------------------------------+ | VM ID | qDNV9vtxZYYNqm7TN1mYBuaaknLdefDbFK8bFmMLTJQJKaWjV | +---------------+----------------------------------------------------------------------------------------------------------------+ | VM Version | v0.7.3 | +---------------+----------------------------------------------------------------------------------------------------------------+ | Validation | Proof Of Authority | +---------------+--------------------------+-------------------------------------------------------------------------------------+ | Local Network | ChainID | 888 | | +--------------------------+-------------------------------------------------------------------------------------+ | | SubnetID | 2W9boARgCWL25z6pMFNtkCfNA5v28VGg9PmBgUJfuKndEdhrvw | | +--------------------------+-------------------------------------------------------------------------------------+ | | Owners (Threhold=1) | P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p | | +--------------------------+-------------------------------------------------------------------------------------+ | | BlockchainID (CB58) | Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y | | +--------------------------+-------------------------------------------------------------------------------------+ | | BlockchainID (HEX) | 0x48644613a5ef255fa171bf4773df668b57ea0ea9593df8927a6d9f32376a9c6f | | +--------------------------+-------------------------------------------------------------------------------------+ | | RPC Endpoint | http://127.0.0.1:60172/ext/bc/Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y/rpc | +---------------+--------------------------+-------------------------------------------------------------------------------------+ +------------------------------------------------------------------------------------+ | ICM | +---------------+-----------------------+--------------------------------------------+ | Local Network | ICM Messenger Address | 0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf | | +-----------------------+--------------------------------------------+ | | ICM Registry Address | 0xEc7018552DC7E197Af85f157515f5976b1A15B12 | +---------------+-----------------------+--------------------------------------------+ +--------------------------+ | TOKEN | +--------------+-----------+ | Token Name | TST Token | +--------------+-----------+ | Token Symbol | TST | +--------------+-----------+ +---------------------------------------------------------------------------------------------------------------------------------------+ | INITIAL TOKEN ALLOCATION | +-------------------------+------------------------------------------------------------------+--------------+---------------------------+ | DESCRIPTION | ADDRESS AND PRIVATE KEY | AMOUNT (TST) | AMOUNT (WEI) | +-------------------------+------------------------------------------------------------------+--------------+---------------------------+ | Main funded account | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | 1000000 | 1000000000000000000000000 | | ewoq | 56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027 | | | +-------------------------+------------------------------------------------------------------+--------------+---------------------------+ | Used by ICM | 0xf34408C05e3B339B1c89d15163d4B9D96845597A | 600 | 600000000000000000000 | | cli-teleporter-deployer | 30d57c7b6e7e393e2e4ce8166768b497cc37930361a15b1c647d6e665d88afff | | | +-------------------------+------------------------------------------------------------------+--------------+---------------------------+ +----------------------------------------------------------------------------------------------------------------------------------+ | SMART CONTRACTS | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | DESCRIPTION | ADDRESS | DEPLOYER | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | Validator Messages Lib | 0x9C00629cE712B0255b17A4a657171Acd15720B8C | | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | Proxy Admin | 0xC0fFEE1234567890aBCdeF1234567890abcDef34 | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | ACP99 Compatible PoA Validator Manager | 0x0C0DEbA5E0000000000000000000000000000000 | | +----------------------------------------+--------------------------------------------+--------------------------------------------+ | Transparent Proxy | 0x0Feedc0de0000000000000000000000000000000 | | +----------------------------------------+--------------------------------------------+--------------------------------------------+ +----------------------------------------------------------------------+ | INITIAL PRECOMPILE CONFIGS | +------------+-----------------+-------------------+-------------------+ | PRECOMPILE | ADMIN ADDRESSES | MANAGER ADDRESSES | ENABLED ADDRESSES | +------------+-----------------+-------------------+-------------------+ | Warp | n/a | n/a | n/a | +------------+-----------------+-------------------+-------------------+ +-------------------------------------------------------------------------------------------------+ | MYBLOCKCHAIN RPC URLS | +-----------+-------------------------------------------------------------------------------------+ | Localhost | http://127.0.0.1:60172/ext/bc/Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y/rpc | +-----------+-------------------------------------------------------------------------------------+ +------------------------------------------------------------------+ | PRIMARY NODES | +------------------------------------------+-----------------------+ | NODE ID | LOCALHOST ENDPOINT | +------------------------------------------+-----------------------+ | NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg | http://127.0.0.1:9650 | +------------------------------------------+-----------------------+ | NodeID-MFrZFVCXPv5iCn6M9K6XduxGTYp891xXZ | http://127.0.0.1:9652 | +------------------------------------------+-----------------------+ +----------------------------------------------------------------------------------+ | L1 NODES | +------------------------------------------+------------------------+--------------+ | NODE ID | LOCALHOST ENDPOINT | L1 | +------------------------------------------+------------------------+--------------+ | NodeID-NuQc8BQ8mV9TVksgMtpyc57VnWzU2J6aN | http://127.0.0.1:60172 | myblockchain | +------------------------------------------+------------------------+--------------+ +-------------------------------------------------------------------------------------------------------+ | WALLET CONNECTION | +-----------------+-------------------------------------------------------------------------------------+ | Network RPC URL | http://127.0.0.1:60172/ext/bc/Yt9d8RRW9JcoqfvyefqJJMX14HawtBc28J9CQspQKPkdonp1y/rpc | +-----------------+-------------------------------------------------------------------------------------+ | Network Name | myblockchain | +-----------------+-------------------------------------------------------------------------------------+ | Chain ID | 888 | +-----------------+-------------------------------------------------------------------------------------+ | Token Symbol | TST | +-----------------+-------------------------------------------------------------------------------------+ | Token Name | TST Token | +-----------------+-------------------------------------------------------------------------------------+ ✓ L1 is successfully deployed on Local Network ``` To manage the newly deployed local Avalanche network, see [the `avalanche network` command tree](/docs/tooling/cli-commands#avalanche-network). You can use the deployment details to connect to and interact with your Avalanche L1. Now it's time to interact with it. ## Interacting with Your Avalanche L1 You can use the value provided by `Browser Extension connection details` to connect to your Avalanche L1 with Core, MetaMask, or any other wallet. To allow API calls from other machines, use `--http-host=0.0.0.0` in the config. ```bash Browser Extension connection details (any node URL from above works): RPC URL: http://127.0.0.1:9650/ext/bc/2BK8CKA4Vfvi69TBTc5GW94JQ9nPiL8xPpPNeeckb9UFSPYedD/rpc Funded address: 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC with 1000000 (10^18) - private key: 56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027 Network name: myblockchain Chain ID: 888 Currency Symbol: TST ``` This tutorial uses Core. ### Importing the Test Private Key[​](#importing-the-test-private-key) This address derives from a well-known private key. Anyone can steal funds sent to this address. Only use it on development networks that only you have access to. If you send production funds to this address, attackers may steal them instantly. First, you need to import your airdrop private key into Core. In the Accounts screen, select the `Imported` tab. Click on `Import private key`. ![](/images/deploy-subnet1.png) Here, enter the private key. Import the well-known private key `0x56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027`. ![](/images/deploy-subnet2.png) Next, rename the Core account to prevent confusion. On the `Imported` tab, click on the pen icon next to your account. Rename the account `DO NOT USE -- Public test key` to prevent confusion with any personal wallets. ![Rename Account](/images/deploy-subnet3.png) ![Rename Account](/images/deploy-subnet4.png) ### Connect to the Avalanche L1[​](#connect-to-the-avalanche-l1) Next, you need to add your Avalanche L1 to Core's networks. In the Core Extension click, `See All Networks` and then select the `+` icon in the top right. ![Add network](/images/deploy-subnet5.png) Enter your Avalanche L1's details, found in the output of your `avalanche blockchain deploy` [command](#deploying-avalanche-l1s-locally), into the form and click `Save`. ![Add network 2](/images/deploy-subnet6.png) If all worked as expected, your balance should read 1 million tokens. Your Avalanche L1 is ready for action. You might want to try to [Deploy a Smart Contract on Your Subnet-EVM Using Remix and Core](/docs/avalanche-l1s/add-utility/deploy-smart-contract). ![Avalanche L1 in Core](/images/deploy-subnet7.png) ## Deploying Multiple Avalanche L1s[​](#deploying-multiple-avalanche-l1s "Direct link to heading") You may deploy multiple Avalanche L1s concurrently, but you can't deploy the same Avalanche L1 multiple times without resetting all deployed Avalanche L1 state. ## Redeploying the Avalanche L1 To redeploy the Avalanche L1, you first need to wipe the Avalanche L1 state. This permanently deletes all data from all locally deployed Avalanche L1s. To do so, run ```bash avalanche network clean ``` You are now free to redeploy your Avalanche L1 with ```bash avalanche blockchain deploy --local ``` ## Stopping the Local Network To gracefully stop a running local network while preserving state, run: ```bash avalanche network stop # output Network stopped successfully. ``` When restarted, all of your deployed Avalanche L1s resume where they left off. ### Resuming the Local Network To resume a stopped network, run: ```bash avalanche network start # output Starting previously deployed and stopped snapshot Booting Network. Wait until healthy... ............... Network ready to use. Local network node endpoints: +-------+----------+------------------------------------------------------------------------------------+ | NODE | VM | URL | +-------+----------+------------------------------------------------------------------------------------+ | node5 | myblockchain | http://127.0.0.1:9658/ext/bc/SPqou41AALqxDquEycNYuTJmRvZYbfoV9DYApDJVXKXuwVFPz/rpc | +-------+----------+------------------------------------------------------------------------------------+ | node1 | myblockchain | http://127.0.0.1:9650/ext/bc/SPqou41AALqxDquEycNYuTJmRvZYbfoV9DYApDJVXKXuwVFPz/rpc | +-------+----------+------------------------------------------------------------------------------------+ | node2 | myblockchain | http://127.0.0.1:9652/ext/bc/SPqou41AALqxDquEycNYuTJmRvZYbfoV9DYApDJVXKXuwVFPz/rpc | +-------+----------+------------------------------------------------------------------------------------+ | node3 | myblockchain | http://127.0.0.1:9654/ext/bc/SPqou41AALqxDquEycNYuTJmRvZYbfoV9DYApDJVXKXuwVFPz/rpc | +-------+----------+------------------------------------------------------------------------------------+ | node4 | myblockchain | http://127.0.0.1:9656/ext/bc/SPqou41AALqxDquEycNYuTJmRvZYbfoV9DYApDJVXKXuwVFPz/rpc | +-------+----------+------------------------------------------------------------------------------------+ ``` The network resumes with the same state it paused with. ## Next Steps After you feel comfortable with this deployment flow, try deploying smart contracts on your chain with [Remix](https://remix.ethereum.org/), [Hardhat](https://hardhat.org/), or [Foundry](https://github.com/foundry-rs/foundry). You can also experiment with customizing your Avalanche L1 by addingprecompiles or adjusting the airdrop. Once you've developed a stable Avalanche L1 you like, see [Create an EVM Avalanche L1 on Fuji Testnet](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1) to take your Avalanche L1 one step closer to production. ## FAQ **How is the Avalanche L1 ID (SubnetID) determined upon creation?** The Avalanche L1 ID (SubnetID) is the hash of the transaction that created the Avalanche L1. # On Fuji Testnet (/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet) --- title: On Fuji Testnet description: This tutorial shows how to deploy an Avalanche L1 on Fuji Testnet. --- This document describes how to use the new Avalanche-CLI to deploy an Avalanche L1 on `Fuji`. After trying out an Avalanche L1 on a local box by following [this tutorial](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-locally), next step is to try it out on `Fuji` Testnet. In this article, it's shown how to do the following on `Fuji` Testnet. - Create an Avalanche L1. - Deploy a virtual machine based on Subnet-EVM. - Join a node to the newly created Avalanche L1. - Add a node as a validator to the Avalanche L1. All IDs in this article are for illustration purposes. They can be different in your own run-through of this tutorial. ## Prerequisites - [`Avalanche-CLI`](https://github.com/ava-labs/avalanche-cli) installed Virtual Machine[​](#virtual-machine "Direct link to heading") ------------------------------------------------------------- Avalanche can run multiple blockchains. Each blockchain is an instance of a [Virtual Machine](/docs/primary-network/virtual-machines), much like an object in an object-oriented language is an instance of a class. That's, the VM defines the behavior of the blockchain. [Subnet-EVM](https://github.com/ava-labs/subnet-evm) is the VM that defines the Avalanche L1 Contract Chains. Subnet-EVM is a simplified version of [Avalanche C-Chain](https://github.com/ava-labs/coreth). This chain implements the Ethereum Virtual Machine and supports Solidity smart contracts as well as most other Ethereum client features. Avalanche-CLI[​](#avalanche-cli "Direct link to heading") --------------------------------------------------------- If not yet installed, install `Avalanche-CLI` following the tutorial at [Avalanche-CLI installation](/docs/tooling/avalanche-cli) ### Private Key[​](#private-key "Direct link to heading") All commands which issue a transaction require either a private key loaded into the tool, or a connected ledger device. This tutorial focuses on stored key usage and leave ledger operation details for the `Mainnet` deploy one, as `Mainnet` operations requires ledger usage, while for `Fuji` it's optional. `Avalanche-CLI` supports the following key operations: - create - delete - export - list You should only use the private key created for this tutorial for testing operations on `Fuji` or other testnets. Don't use this key on `Mainnet`. CLI is going to store the key on your file system. Whoever gets access to that key is going to have access to all funds secured by that private key. Run `create` if you don't have any private key available yet. You can create multiple named keys. Each command requiring a key is going to therefore require the appropriate key name you want to use. ```bash avalanche key create mytestkey ``` This is going to generate a new key named `mytestkey`. The command is going to then also print addresses associated with the key: ```bash Generating new key... Key created +-----------+-------------------------------+-------------------------------------------------+---------------+ | KEY NAME | CHAIN | ADDRESS | NETWORK | +-----------+-------------------------------+-------------------------------------------------+---------------+ | mytestkey | C-Chain (Ethereum hex format) | 0x86BB07a534ADF43786ECA5Dd34A97e3F96927e4F | All | + +-------------------------------+-------------------------------------------------+---------------+ | | P-Chain (Bech32 format) | P-custom1a3azftqvygc4tlqsdvd82wks2u7nx85rg7v8ta | Local Network | + + +-------------------------------------------------+---------------+ | | | P-fuji1a3azftqvygc4tlqsdvd82wks2u7nx85rhk6zqh | Fuji | +-----------+-------------------------------+-------------------------------------------------+---------------+ ``` You may use the C-Chain address (`0x86BB07a534ADF43786ECA5Dd34A97e3F96927e4F`) to fund your key: - **Recommended:** Create a [Builder Hub account](https://build.avax.network/login) and connect your wallet to receive testnet tokens automatically - **Alternative:** Use the [external faucet](https://core.app/tools/testnet-faucet/) The command also prints P-Chain addresses for both the default local network and `Fuji`. The latter (`P-fuji1a3azftqvygc4tlqsdvd82wks2u7nx85rhk6zqh`) is the one needed for this tutorial. The `delete` command of course deletes a private key: ```bash avalanche key delete mytestkey ``` Be careful though to always have a key available for commands involving transactions. The `export` command is going to **print your private key** in hex format to stdout. ```bash avalanche key export mytestkey 21940fbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbbb5f0b ``` This key is intentionally modified. You can also **import** a key by using the `--file` flag with a path argument and also providing a name to it: ```bash avalanche key create othertest --file /tmp/test.pk Loading user key... Key loaded ``` Finally, the `list` command is going to list all your keys in your system and their associated addresses (CLI stores the keys in a special directory on your file system, tampering with the directory is going to result in malfunction of the tool). ```bash avalanche key list +-----------+-------------------------------+-------------------------------------------------+---------------+ | KEY NAME | CHAIN | ADDRESS | NETWORK | +-----------+-------------------------------+-------------------------------------------------+---------------+ | othertest | C-Chain (Ethereum hex format) | 0x36c83263e33f9e87BB98D3fEb54a01E35a3Fa735 | All | + +-------------------------------+-------------------------------------------------+---------------+ | | P-Chain (Bech32 format) | P-custom1n5n4h99j3nx8hdrv50v8ll7aldm383nap6rh42 | Local Network | + + +-------------------------------------------------+---------------+ | | | P-fuji1n5n4h99j3nx8hdrv50v8ll7aldm383na7j4j7q | Fuji | +-----------+-------------------------------+-------------------------------------------------+---------------+ | mytestkey | C-Chain (Ethereum hex format) | 0x86BB07a534ADF43786ECA5Dd34A97e3F96927e4F | All | + +-------------------------------+-------------------------------------------------+---------------+ | | P-Chain (Bech32 format) | P-custom1a3azftqvygc4tlqsdvd82wks2u7nx85rg7v8ta | Local Network | + + +-------------------------------------------------+---------------+ | | | P-fuji1a3azftqvygc4tlqsdvd82wks2u7nx85rhk6zqh | Fuji | +-----------+-------------------------------+-------------------------------------------------+---------------+ ``` #### Funding the Key[​](#funding-the-key "Direct link to heading") Do these steps only to follow this tutorial for `Fuji` addresses. To access the wallet for `Mainnet`, the use of a ledger device is strongly recommended. 1. A newly created key has no funds on it. You have several options to fund it: - **Recommended:** Create a [Builder Hub account](https://build.avax.network/login) and connect your wallet to receive testnet tokens automatically on C-Chain and P-Chain - **Alternative:** Use the [external faucet](https://core.app/tools/testnet-faucet/) with your C-Chain address. If you have an AVAX balance on Mainnet, you can request tokens directly. Otherwise, request a faucet coupon on [Guild](https://guild.xyz/avalanche) or contact admins/mods on [Discord](https://discord.com/invite/RwXY7P6) 2. Export your key via the `avalanche key export` command. The output is your private key, which will help you [import](https://support.avax.network/en/articles/6821877-core-extension-how-can-i-import-an-account) your account into the Core extension. 3. Connect Core extension to [Core web](https://core.app/), and move the test funds from C-Chain to the P-Chain by clicking Stake, then Cross-Chain Transfer (find more details on [this tutorial](https://support.avax.network/en/articles/8133713-core-web-how-do-i-make-cross-chain-transfers-in-core-stake)). After following these 3 steps, your test key should now have a balance on the P-Chain on `Fuji` Testnet. Create an EVM Avalanche L1[​](#create-an-evm-avalanche-l1 "Direct link to heading") ----------------------------------------------------------------------- Creating an Avalanche L1 with `Avalanche-CLI` for `Fuji` works the same way as with a local network. In fact, the `create` commands only creates a specification of your Avalanche L1 on the local file system. Afterwards the Avalanche L1 needs to be _deployed_. This allows to reuse configs, by creating the config with the `create` command, then first deploying to a local network and successively to `Fuji` - and eventually to `Mainnet`. To create an EVM Avalanche L1, run the `blockchain create` command with a name of your choice: ```bash avalanche blockchain create testblockchain ``` This is going to start a series of prompts to customize your EVM Avalanche L1 to your needs. Most prompts have some validation to reduce issues due to invalid input. The first prompt asks for the type of the virtual machine (see [Virtual Machine](#virtual-machine)). ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose your VM: ▸ SubnetEVM Custom ``` As you want to create an EVM Avalanche L1, just accept the default `Subnet-EVM`. Choose either Proof of Authority (PoA) or Proof of Stake (PoS) as your consensus mechanism. ```bash ? Which validator management type would you like to use in your blockchain?: ▸ Proof Of Authority Proof Of Stake Explain the difference ``` For this tutorial, select `Proof of Authority (PoA)`. For more info, reference the [Validator Management Contracts](/docs/avalanche-l1s/validator-manager/contract). ```bash Which address do you want to enable as controller of ValidatorManager contract?: ▸ Get address from an existing stored key (created from avalanche key create or avalanche key import) Custom ``` This address will be able to add and remove validators from your Avalanche L1. You can either use an existing key or create a new one. In addition to being the PoA owner, this address will also be the owner of the `ProxyAdmin` contract of the Validator Manager's `TransparentUpgradeableProxy`. This address will be able to upgrade (PoA -> PoS) the Validator Manager implementation through updating the proxy. Next, CLI will ask for blockchain configuration values. Since we are deploying to Fuji, select `I want to use defaults for a production environment`. ```bash ? Do you want to use default values for the Blockchain configuration?: ▸ I want to use defaults for a test environment I want to use defaults for a production environment I don't want to use default values Explain the difference ``` The default values for production environment: - Use latest Subnet-EVM release - Allocate 1 million tokens to: 1. **a newly created key (production)**: name of this key will be in the format of `subnet_blockchainName_airdrop` 2. **ewoq address (test)**: 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC - Supply of the native token will be hard-capped - Set gas fee config as low throughput (12 million gas per block) - Use constant gas prices - Disable further adjustments in transaction fee configuration - Transaction fees are burned - Enable interoperability with other blockchains - Allow any user to deploy smart contracts, send transactions, and interact with your blockchain. Next, CLI asks for the ChainID. You should provide your own ID. Check [chainlist.org](https://chainlist.org/) to see if the value you'd like is already in use. ```bash ✔ Subnet-EVM creating Avalanche L1 test blockchain Enter your Avalanche L1's ChainId. It can be any positive integer. ChainId: 3333 ``` Now, provide a symbol of your choice for the token of this EVM: ```bash Select a symbol for your Avalanche L1's native token Token symbol: TST ``` It's possible to end the process with Ctrl-C at any time. At this point, CLI creates the specification of the new Avalanche L1 on disk, but isn't deployed yet. Print the specification to disk by running the `describe` command: ```bash avalanche blockchain describe testblockchain ``` ```bash +------------------------------------------------------------------+ | TESTBLOCKCHAIN | +------------+-----------------------------------------------------+ | Name | testblockchain | +------------+-----------------------------------------------------+ | VM ID | tGBrM94jbkesczgqsL1UaxjrdxRQQobs3MZTNQ4GrfhzvpiE8 | +------------+-----------------------------------------------------+ | VM Version | v0.6.12 | +------------+-----------------------------------------------------+ | Validation | Proof Of Authority | +------------+-----------------------------------------------------+ +--------------------------+ | TOKEN | +--------------+-----------+ | Token Name | TST Token | +--------------+-----------+ | Token Symbol | TST | +--------------+-----------+ +-----------------------------------------------------------------------------------------------------------------------------------+ | INITIAL TOKEN ALLOCATION | +---------------------+------------------------------------------------------------------+--------------+---------------------------+ | DESCRIPTION | ADDRESS AND PRIVATE KEY | AMOUNT (TST) | AMOUNT (WEI) | +---------------------+------------------------------------------------------------------+--------------+---------------------------+ | Main funded account | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | 1000000 | 1000000000000000000000000 | | ewoq | 56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027 | | | +---------------------+------------------------------------------------------------------+--------------+---------------------------+ +-----------------------------------------------------------------------------------------------------------------+ | SMART CONTRACTS | +-----------------------+--------------------------------------------+--------------------------------------------+ | DESCRIPTION | ADDRESS | DEPLOYER | +-----------------------+--------------------------------------------+--------------------------------------------+ | Proxy Admin | 0xC0fFEE1234567890aBCdeF1234567890abcDef34 | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | +-----------------------+--------------------------------------------+--------------------------------------------+ | PoA Validator Manager | 0x0C0DEbA5E0000000000000000000000000000000 | | +-----------------------+--------------------------------------------+--------------------------------------------+ | Transparent Proxy | 0x0Feedc0de0000000000000000000000000000000 | | +-----------------------+--------------------------------------------+--------------------------------------------+ +----------------------------------------------------------------------+ | INITIAL PRECOMPILE CONFIGS | +------------+-----------------+-------------------+-------------------+ | PRECOMPILE | ADMIN ADDRESSES | MANAGER ADDRESSES | ENABLED ADDRESSES | +------------+-----------------+-------------------+-------------------+ | Warp | n/a | n/a | n/a | +------------+-----------------+-------------------+-------------------+ ``` Deploy the Avalanche L1[​](#deploy-the-avalanche-l1 "Direct link to heading") ----------------------------------------------------------------- To deploy the Avalanche L1, you will need some testnet AVAX on the P-chain. To deploy the new Avalanche L1, run: ```bash avalanche blockchain deploy testblockchain ``` This is going to start a new prompt series. ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose a network to deploy on: ▸ Local Network Fuji Mainnet ``` This tutorial is about deploying to `Fuji`, so navigate with the arrow keys to `Fuji` and hit enter. The user is then asked to provide which private key to use for the deployment. Select a key to has P-Chain AVAX to pay for transaction fees. Also, this tutorial assumes that a node is up running, fully bootstrapped on `Fuji`, and runs from the **same** box. ```bash ✔ Fuji Deploying [testblockchain] to Fuji Use the arrow keys to navigate: ↓ ↑ → ← ? Which private key should be used to issue the transaction?: test ▸ mytestkey ``` Avalanche L1s require bootstrap validators during creation process. Avalanche CLI has enabled using local machine as a bootstrap validator on the blockchain. This means that you don't have to to set up a remote server on a cloud service (e.g. AWS / GCP) to be a validator on the blockchain. We will select `Yes` on using our local machine as a bootstrap validator. Note that since we need to sync our node with Fuji, this process will take around 3 minutes. ```bash You can use your local machine as a bootstrap validator on the blockchain This means that you don't have to to set up a remote server on a cloud service (e.g. AWS / GCP) to be a validator on the blockchain. Use the arrow keys to navigate: ↓ ↑ → ← ? Do you want to use your local machine as a bootstrap validator?: ▸ Yes No ``` Well done. You have just created your own Avalanche L1 on `Fuji`. You will be able to see information on the deployed L1 at the end of `avalanche blockchain deploy` command: ```bash +--------------------+----------------------------------------------------+ | DEPLOYMENT RESULTS | | +--------------------+----------------------------------------------------+ | Chain Name | testblockchain | +--------------------+----------------------------------------------------+ | Subnet ID | 2cNuyBhvAd4jH5bFSGndezhB66Z4UHYAsLCMGoCpvhXVhrZfgd | +--------------------+----------------------------------------------------+ | VM ID | qcvkEX1zWSz7PtGd7CKvPRBqLVTzA7qyMPvkh5NMDWkuhrcCu | +--------------------+----------------------------------------------------+ | Blockchain ID | 2U7vNdB78xTiN6QtZ9aetfKoGtQhfeEPQG6QZC8bpq8QMf4cDx | +--------------------+ + | P-Chain TXID | | +--------------------+----------------------------------------------------+ ``` To get your new Avalanche L1 information, visit the [Avalanche L1 Explorer](https://subnets-test.avax.network/). The search best works by blockchain ID, so in this example, enter `2U7vNdB78xTiN6QtZ9aetfKoGtQhfeEPQG6QZC8bpq8QMf4cDx` into the search box and you should see your shiny new blockchain information. Add a Validator[​](#add-a-validator "Direct link to heading") ------------------------------------------------------------- Before proceeding to add a validator to our Avalanche L1, we will need to have the validator's NodeID, BLS public key and proof of possession. These can be obtained by ssh into the node itself and run the `getNodeID` API specified [here](/docs/rpcs/other/info-rpc#infogetnodeid). To add a validator to an Avalanche L1, the owner of the key that acts as the controller of `ValidatorManager` contract specified in `avalanche blockchain create` command above run: ```bash avalanche blockchain addValidator testblockchain ``` Choose `Fuji`: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose a network to deploy on: ▸ Fuji ``` You will need to specify which private key to use to pay for the transaction fees: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Which key should be used to pay for transaction fees on P-Chain?: test ▸ mytestkey ``` Now enter the **NodeID** of the new validator to be added. ```bash What is the NodeID of the validator you'd like to whitelist?: NodeID-BFa1paAAAAAAAAAAAAAAAAAAAAQGjPhUy ``` Next, enter the node's BLS public key and proof of possession. Now, enter the amount of AVAX that you would like to allocate to the new validator. The validator's balance is used to pay for continuous fee to the P-Chain. When this Balance reaches 0, the validator will be considered inactive and will no longer participate in validating the L1. 1 AVAX should last the validator about a month. ```bash What balance would you like to assign to the validator (in AVAX)?: 1 ``` Next, select a key that will receive the leftover AVAX if the validator is removed from the L1: ```bash Which stored key should be used be set as a change owner for leftover AVAX?: test ▸ mytestkey ``` Next, select a key that can remove the validator: ```bash ? Which stored key should be used be able to disable the validator using P-Chain transactions?: test ▸ mytestkey ``` By the end of the command, you would have successfully added a new validator to the Avalanche L1 on Fuji Testnet! Appendix[​](#appendix "Direct link to heading") ----------------------------------------------- ### Connect with Core[​](#connect-with-core "Direct link to heading") To connect Core (or MetaMask) with your blockchain on the new Avalanche L1 running on your local computer, you can add a new network on your Core wallet with the following values: ```bash - Network Name: testblockchain - RPC URL: [http://127.0.0.1:9650/ext/bc/2U7vNdB78xTiN6QtZ9aetfKoGtQhfeEPQG6QZC8bpq8QMf4cDx/rpc] - Chain ID: 3333 - Symbol: TST ``` # On Avalanche Mainnet (/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-mainnet) --- title: On Avalanche Mainnet description: Deploy an Avalanche L1 to Avalanche Mainnet --- Deploying an Avalanche L1 to Mainnet has many risks. Doing so safely requires a laser focus on security. This tutorial does its best to point out common pitfalls, but there may be other risks not discussed here. This tutorial is an educational resource and provides no guarantees that following it results in a secure deployment. Additionally, this tutorial takes some shortcuts that aid the understanding of the deployment process at the expense of security. The text highlights these shortcuts and they shouldn't be used for a production deployment. After managing a successful Avalanche L1 deployment on the `Fuji Testnet`, you're ready to deploy your Avalanche L1 on Mainnet. If you haven't done so, first [Deploy an Avalanche L1 on Testnet](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet). This tutorial shows how to do the following on `Mainnet`. - Deploy an Avalanche L1. - Add a node as a validator to the Avalanche L1. All IDs in this article are for illustration purposes only. They are guaranteed to be different in your own run-through of this tutorial. ## Prerequisites - An Avalanche node running and [fully bootstrapped](/docs/nodes) on `Mainnet` - [Avalanche-CLI is installed](/docs/tooling/avalanche-cli) on each validator node's box - A [Ledger](https://www.ledger.com/) device - You've [created an Avalanche L1 configuration](/docs/tooling/avalanche-cli#create-your-avalanche-l1-configuration) and fully tested a [Fuji Testnet Avalanche L1 deployment](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet) ### Setting up Your Ledger[​](#setting-up-your-ledger "Direct link to heading") In the interest of security, all Avalanche-CLI `Mainnet` operations require the use of a connected Ledger device. You must unlock your Ledger and run the Avalanche App. See [How to Use Ledger](https://support.avax.network/en/articles/6150237-how-to-use-a-ledger-nano-s-or-nano-x-with-avalanche) for help getting set up. Ledger devices support TX signing for any address inside a sequence automatically generated by the device. By default, Avalanche-CLI uses the first address of the derivation, and that address needs funds to issue the TXs to create the Avalanche L1 and add validators. To get the first `Mainnet` address of your Ledger device, first make sure it is connected, unblocked, and running the Avalanche app. Then execute the `key list` command: ```bash avalanche key list --ledger 0 --mainnet ``` ```bash +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | KIND | NAME | CHAIN | ADDRESS | BALANCE | NETWORK | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | ledger | index 0 | P-Chain (Bech32 format) | P-avax1ucykh6ls8thqpuwhg3vp8vvu6spg5e8tp8a25j | 11 | Mainnet | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ ``` The command prints the P-Chain address for `Mainnet`, `P-avax1ucykh6ls8thqpuwhg3vp8vvu6spg5e8tp8a25j`, and its balance. You can use the `key list` command to get any Ledger address in the derivation sequence by changing the index parameter from `0` to the one desired, or to a list of them (for example: `2`, or `0,4,7`). Also, you can ask for addresses on `Mainnet` with the `--mainnet` parameter, and local networks with the `--local` parameter. #### Funding the Ledger[​](#funding-the-ledger "Direct link to heading") A new Ledger device has no funds on the addresses it controls. You'll need to send funds to it by exporting them from C-Chain to the P-Chain using [Core web](https://core.app/) connected to [Core extension](https://core.app/). You can load the Ledger's C-Chain address in Core extension, or load in a different private key to [Core extension](https://core.app/), and then connect to Core web . You can move test funds from the C-Chain to the P-Chain by clicking Stake on Core web , then Cross-Chain Transfer (find more details on [this tutorial](https://support.avax.network/en/articles/8133713-core-web-how-do-i-make-cross-chain-transfers-in-core-stake)). Deploy the Avalanche L1[​](#deploy-the-avalanche-l1 "Direct link to heading") ----------------------------------------------------------------- To deploy the Avalanche L1, you will need some AVAX on the P-Chain. For our Fuji example, we used our local machine as a bootstrap validator. However, since bootstrapping a node to Mainnet will take several hours, we will use an Avalanche node set up on an AWS server that is already bootstrapped to Mainnet for this example. To check if the Avalanche node is done bootstrapping, ssh into the node and call [`info.isBootstrapped`](/docs/rpcs/other/info-rpc#infoisbootstrapped) by copying and pasting the following command: ```bash curl -X POST --data '{ "jsonrpc":"2.0", "id" :1, "method" :"info.isBootstrapped", "params": { "chain":"P" } }' -H 'content-type:application/json;' 127.0.0.1:9650/ext/info ``` If this returns `true`, it means that the chain is bootstrapped and we will proceed to deploying our L1. We will need to have the Avalanche node's NodeID, BLS public key and proof of possession. These can be obtained by ssh into the node itself and run the `getNodeID` API specified [here](/docs/rpcs/other/info-rpc#infogetnodeid) To deploy the new Avalanche L1, with your Ledger unlocked and running the Avalanche app, run: ```bash avalanche blockchain deploy testblockchain ``` This is going to start a new prompt series. ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose a network to deploy on: Local Network Fuji ▸ Mainnet ``` This tutorial is about deploying to `Mainnet`, so navigate with the arrow keys to `Mainnet` and hit enter. The user is then asked to provide which private key to use for the deployment. Select a key to has P-Chain AVAX to pay for transaction fees. ```bash ✔ Mainnet Deploying [testblockchain] to Mainnet ``` After that, CLI shows the `Mainnet` Ledger address used to fund the deployment: ```bash Ledger address: P-avax1ucykh6ls8thqpuwhg3vp8vvu6spg5e8tp8a25j ``` Select `No` to using local machine as a bootstrap validator on the blockchain. ```bash You can use your local machine as a bootstrap validator on the blockchain This means that you don't have to to set up a remote server on a cloud service (e.g. AWS / GCP) to be a validator on the blockchain. Use the arrow keys to navigate: ↓ ↑ → ← ? Do you want to use your local machine as a bootstrap validator?: Yes ▸ No ``` Enter 1 as the number of bootstrap validators we will be setting up. ```bash ✔ No ✗ How many bootstrap validators do you want to set up?: 1 ``` Select `Yes` since we have already set up our Avalanche Node on AWS. ```bash If you have set up your own Avalanche Nodes, you can provide the Node ID and BLS Key from those nodes in the next step. Otherwise, we will generate new Node IDs and BLS Key for you. Use the arrow keys to navigate: ↓ ↑ → ← ? Have you set up your own Avalanche Nodes?: ▸ Yes No ``` Next, we will enter the node's Node-ID: ```bash Getting info for bootstrap validator 1 ✗ What is the NodeID of the node you want to add as bootstrap validator?: █ ``` And BLS public key and proof of possession: ```bash Next, we need the public key and proof of possession of the node's BLS Check https://build.avax.network/docs/rpcs/other/info-rpc#infogetnodeid for instructions on calling info.getNodeID API ✗ What is the node's BLS public key?: █ ``` Next, the CLI generates a CreateSubnet TX to create the Subnet and asks the user to sign it by using the Ledger. ```bash *** Please sign Avalanche L1 creation hash on the ledger device *** ``` This activates a `Please review` window on the Ledger. Navigate to the Ledger's `APPROVE` window by using the Ledger's right button, and then authorize the request by pressing both left and right buttons. If the Ledger doesn't have enough funds, the user may see an error message: ```bash *** Please sign Avalanche L1 creation hash on the ledger device *** Error: insufficient funds: provided UTXOs need 1000000000 more units of asset "U8iRqJoiJm8xZHAacmvYyZVwqQx6uDNtQeP3CQ6fcgQk3JqnK" ``` If successful, the CLI next asks you to sign a CreateChain Tx. Once CreateChain Tx is signed, it will then ask you to sign ConvertSubnetToL1 Tx. Well done. You have just created your own Avalanche L1 on `Mainnet`. You will be able to see information on the deployed L1 at the end of `avalanche blockchain deploy` command: ```bash +--------------------+----------------------------------------------------+ | DEPLOYMENT RESULTS | | +--------------------+----------------------------------------------------+ | Chain Name | testblockchain | +--------------------+----------------------------------------------------+ | Subnet ID | 2cNuyBhvAd4jH5bFSGndezhB66Z4UHYAsLCMGoCpvhXVhrZfgd | +--------------------+----------------------------------------------------+ | VM ID | qcvkEX1zWSz7PtGd7CKvPRBqLVTzA7qyMPvkh5NMDWkuhrcCu | +--------------------+----------------------------------------------------+ | Blockchain ID | 2U7vNdB78xTiN6QtZ9aetfKoGtQhfeEPQG6QZC8bpq8QMf4cDx | +--------------------+ + | P-Chain TXID | | +--------------------+----------------------------------------------------+ ``` To get your new Avalanche L1 information, there are two options: - Call `avalanche blockchain describe` command or - Visit the [Avalanche L1 Explorer](https://subnets-test.avax.network/). The search best works by blockchain ID, so in this example, enter `2U7vNdB78xTiN6QtZ9aetfKoGtQhfeEPQG6QZC8bpq8QMf4cDx` into the search box and you should see your shiny new blockchain information. Add a Validator[​](#add-a-validator "Direct link to heading") ------------------------------------------------------------- Before proceeding to add a validator to our Avalanche L1, we will need to have the validator's NodeID, BLS public key and proof of possession. These can be obtained by ssh into the node itself and run the `getNodeID` API specified [here](/docs/rpcs/other/info-rpc#infogetnodeid) To add a validator to an Avalanche L1, the owner of the key that acts as the controller of ValidatorManager contract specified in `avalanche blockchain create` command above run: ```bash avalanche blockchain addValidator testblockchain ``` Choose `Mainnet`: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose a network to deploy on: ▸ Mainnet ``` The CLI will show the Ledger address that will be used to pay for add validator tx: ```bash Ledger address: P-avax1ucykh6ls8thqpuwhg3vp8vvu6spg5e8tp8a25j ``` Now enter the **NodeID** of the new validator to be added. ```bash What is the NodeID of the validator you'd like to whitelist?: NodeID-BFa1paAAAAAAAAAAAAAAAAAAAAQGjPhUy ``` Next, enter the node's BLS public key and proof of possession. Now, enter the amount of AVAX that you would like to allocate to the new validator. The validator's balance is used to pay for continuous fee to the P-Chain. When this Balance reaches 0, the validator will be considered inactive and will no longer participate in validating the L1. 1 AVAX should last the validator about a month. ```bash What balance would you like to assign to the validator (in AVAX)?: 1 ``` Sign the addValidatorTx with your Ledger: ```bash *** Please sign add validator hash on the ledger device *** ``` This activates a `Please review` window on the Ledger. Navigate to the Ledger's `APPROVE` window by using the Ledger's right button, and then authorize the request by pressing both left and right buttons. This might take a couple of seconds. After, it prints: ```bash Transaction successful, transaction ID: r3tJ4Wr2CWA8AaticmFrKdKgAs5AhW2wwWTaQHRBZKwJhsXzb ``` This means the node is now a validator on the given Avalanche L1 on `Mainnet`! Going Live[​](#going-live "Direct link to heading") --------------------------------------------------- For the safety of your validators, you should setup dedicated API nodes to process transactions, but for test purposes, you can issue transactions directly to one of your validator's RPC interface. # On Production Infra (/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-production-infra) --- title: On Production Infra description: Learn how to deploy an Avalanche L1 on production infrastructure. --- After architecting your Avalanche L1 environment on the [local machine](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-locally), proving the design and testing it out on [the Fuji Testnet](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet), eventually you will need to deploy your Avalanche L1 to production environment. Running an Avalanche L1 in production is much more involved than local and Testnet deploys, as your Avalanche L1 will have to take care of real world usage, maintaining uptime, upgrades and all of that in a potentially adversarial environment. The purpose of this document is to point out a set of general considerations and propose potential solutions to them. The architecture of the environment your particular Avalanche L1 will use will be greatly influenced by the type of load and activity your Avalanche L1 is designed to support so your solution will most likely differ from what we propose here. Still, it might be useful to follow along, to build up the intuition for the type of questions you will need to consider. Node Setup[​](#node-setup "Direct link to heading") --------------------------------------------------- Avalanche nodes are essential elements for running your Avalanche L1 in production. At a minimum, your Avalanche L1 will need validator nodes, potentially also nodes that act as RPC servers, indexers or explorers. Running a node is basically running an instance of [AvalancheGo](/docs/nodes) on a server. ### Server OS[​](#server-os "Direct link to heading") Although AvalancheGo can run on a MacOS or a Windows computer, we strongly recommend running nodes on computers running Linux as they are designed specifically for server loads and all the tools and utilities needed for administering a server are native to Linux. ### Hardware Specification[​](#hardware-specification "Direct link to heading") For running AvalancheGo as a validator on the Primary Network the recommended configuration is as follows: - CPU: Equivalent of 8 AWS vCPU - RAM: 16 GiB - Storage: 1 TiB with at least 3000 IOPS - OS: Ubuntu 20.04 - Network: Reliable IPv4 or IPv6 network connection, with an open public port That is the configuration sufficient for running a Primary Network node. Any resource requirements for your Avalanche L1 come on top of this, so you should not go below this configuration, but may need to step up the specification if you expect your Avalanche L1 to handle a significant amount of transactions. Be sure to set up monitoring of resource consumption for your nodes because resource exhaustion may cause your node to slow down or even halt, which may severely impact your Avalanche L1 negatively. ### Server Location[​](#server-location "Direct link to heading") You can run a node on a physical computer that you own and run, or on a cloud instance. Although running on your own HW may seem like a good idea, unless you have a sizeable DevOps 24/7 staff we recommend using cloud service providers as they generally provide reliable computing resources that you can count on to be properly maintained and monitored. #### Local Servers[​](#local-servers "Direct link to heading") If you plan on running nodes on your own hardware, make sure they satisfy the minimum HW specification as outlined earlier. Pay close attention to proper networking setup, making sure the p2p port (9651) is accessible and public IP properly configured on the node. Make sure the node is connected to the network physically (not over Wi-Fi), and that the router is powerful enough to handle a couple of thousands of persistent TCP connections and that network bandwidth can accommodate at least 5Mbps of steady upstream and downstream network traffic. When installing the AvalancheGo node on the machines, unless you have a dedicated DevOps staff that will take care of node setup and configuration, we recommend using the [installer script](/docs/nodes/run-a-node/using-install-script/installing-avalanche-go) to set up the nodes. It will abstract most of the setup process for you, set up the node as a system service and will enable easy node upgrades. #### Cloud Providers[​](#cloud-providers "Direct link to heading") There are a number of different cloud providers. We have documents that show how to set up a node on the most popular ones: - [Amazon Web Services](/docs/nodes/run-a-node/on-third-party-services/amazon-web-services) - [Azure](/docs/nodes/run-a-node/on-third-party-services/microsoft-azure) - [Google Cloud Platform](/docs/nodes/run-a-node/on-third-party-services/google-cloud) There is a whole range of other cloud providers that may offer lower prices or better deals for your particular needs, so it makes sense to shop around. Once you decide on a provider (or providers), if they offer instances in multiple data centers, it makes sense to spread the nodes geographically since that provides a better resilience and stability against outages. ### Number of Validators[​](#number-of-validators "Direct link to heading") Number of validators on an Avalanche L1 is a crucial decision you need to make. For stability and decentralization, you should strive to have as many validators as possible. For stability reasons our recommendation is to have **at least** 5 full validators on your Avalanche L1. If you have less than 5 validators your Avalanche L1 liveness will be at risk whenever a single validator goes offline, and if you have less than 4 even one offline node will halt your Avalanche L1. You should be aware that 5 is the minimum we recommend. But, from a decentralization standpoint having more validators is always better as it increases the stability of your Avalanche L1 and makes it more resilient to both technical failures and adversarial action. In a nutshell: run as many Avalanche L1 validators as you can. Considering that at times you will have to take nodes offline, for routine maintenance (at least for node upgrades which happen with some regularity) or unscheduled outages and failures you need to be able to routinely handle at least one node being offline without your Avalanche L1 performance degrading. ### Node Bootstrap[​](#node-bootstrap "Direct link to heading") Once you set up the server and install AvalancheGo on them, nodes will need to bootstrap (sync with the network). This is a lengthy process, as the nodes need to catch up and replay all the network activity since the genesis up to the present moment. Full bootstrap on a node can take more than a week, but there are ways to shorten that process, depending on your circumstances. #### State Sync[​](#state-sync "Direct link to heading") If the nodes you will be running as validators don't need to have the full transaction history, then you can use [state sync](/docs/nodes/chain-configs/primary-network/c-chain#state-sync-enabled). With this flag enabled, instead of replaying the whole history to get to the current state, nodes simply download only the current state from other network peers, shortening the bootstrap process from multiple days to a couple of hours. If the nodes will be used for Avalanche L1 validation exclusively, you can use the state sync without any issues. Currently, state sync is only available for the C-Chain, but since the bulk of the transactions on the platform happen there it still has a significant impact on the speed of bootstrapping. #### Database Copy[​](#database-copy "Direct link to heading") Good way to cut down on bootstrap times on multiple nodes is database copy. Database is identical across nodes, and as such can safely be copied from one node to another. Just make sure to that the node is not running during the copy process, as that can result in a corrupted database. Database copy procedure is explained in detail [here](/docs/nodes/maintain/backup-restore#database). Please make sure you don't reuse any node's NodeID by accident, especially don't restore another node's ID, see [here](/docs/nodes/maintain/backup-restore#nodeid) for details. Each node must has its own unique NodeID, otherwise, the nodes sharing the same ID will not behave correctly, which will impact your validator's uptime, thus staking rewards, and the stability of your Avalanche L1. Avalanche L1 Deploy[​](#avalanche-l1-deploy "Direct link to heading") --------------------------------------------------------- Once you have the nodes set up you are ready to deploy the actual Avalanche L1. Right now, the recommended tool to do that is [Avalanche-CLI](https://github.com/ava-labs/avalanche-cli). Instructions for deployment by Avalanche-CLI can be found [here](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-mainnet). ### Ledger Hardware Wallet[​](#ledger-hw-wallet "Direct link to heading") When creating the Avalanche L1, you will be required to have a private key that will control the administrative functions of the Avalanche L1 (adding validators, managing the configuration). Needless to say, whoever has this private key has complete control over the Avalanche L1 and the way it runs. Therefore, protecting that key is of the utmost operational importance. Which is why we strongly recommend using a hardware wallet such as a [Ledger HW Wallet](https://www.ledger.com/) to store and access that private key. General instruction on how to use a Ledger device with Avalanche can be found [here](https://support.avax.network/en/articles/6150237-how-to-use-a-ledger-nano-s-or-nano-x-with-avalanche). ### Genesis File[​](#genesis-file "Direct link to heading") The structure that defines the most important parameters in an Avalanche L1 is found in the genesis file, which is a `json` formatted, human-readable file. Describing the contents and the options available in the genesis file is beyond the scope of this document, and if you're ready to deploy your Avalanche L1 to production you probably have it mapped out already. If you want to review, we have a description of the genesis file in our document on [customizing EVM Avalanche L1s](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1). Validator Configuration[​](#validator-configuration "Direct link to heading") ----------------------------------------------------------------------------- Running nodes as Avalanche L1 validators warrants some additional considerations, above those when running a regular node or a Primary Network-only validator. ### Joining an Avalanche L1[​](#joining-a-avalanche-l1 "Direct link to heading") For a node to join an Avalanche L1, there are two prerequisites: - Primary Network validation - Avalanche L1 tracking Primary Network validation means that a node cannot join an Avalanche L1 as a validator before becoming a validator on the Primary Network itself. So, after you add the node to the validator set on the Primary Network, node can join an Avalanche L1. Of course, this is valid only for Avalanche L1 validators, if you need a non-validating Avalanche L1 node, then the node doesn't need to be a validator at all. To have a node start syncing the Avalanche L1, you need to add the `--track-subnets` command line option, or `track-subnets` key to the node config file (found at `.avalanchego/configs/node.json` for installer-script created nodes). A single node can sync multiple Layer 1s, so you can add them as a comma-separated list of Avalanche L1 IDs (SubnetID). An example of a node config syncing two Avalanche L1s: ```json { "public-ip-resolution-service": "opendns", "http-host": "", "track-subnets": "28nrH5T2BMvNrWecFcV3mfccjs6axM1TVyqe79MCv2Mhs8kxiY,Ai42MkKqk8yjXFCpoHXw7rdTWSHiKEMqh5h8gbxwjgkCUfkrk" } ``` But that is not all. Besides tracking the SubnetID, the node also needs to have the plugin that contains the VM instance the blockchain in the Avalanche L1 will run. You should have already been through that on Testnet and Fuji, but for a refresher, you can refer to [this tutorial](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet). So, name the VM plugin binary as the `VMID` of the Avalanche L1 chain and place it in the `plugins` directory where the node binary is (for installer-script created nodes that would be `~/avalanche-node/plugins/`). ### Avalanche L1 Bootstrapping[​](#avalanche-l1-bootstrapping "Direct link to heading") After you have tracked the Avalanche L1 and placed the VM binary in the correct directory, your node is ready to start syncing with the Avalanche L1. Restart the node and monitor the log output. You should notice something similar to: ```bash Jul 30 18:26:31 node-fuji avalanchego[1728308]: [07-30|18:26:31.422] INFO chains/manager.go:262 creating chain: Jul 30 18:26:31 node-fuji avalanchego[1728308]: ID: 2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt Jul 30 18:26:31 node-fuji avalanchego[1728308]: VMID:srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy ``` That means the node has detected the Avalanche L1, and is attempting to initialize it and start bootstrapping the Avalanche L1. It might take some time (if there are already transactions on the Avalanche L1), and eventually it will finish the bootstrap with a message like: ```bash Jul 30 18:27:21 node-fuji avalanchego[1728308]: [07-30|18:27:21.055] INFO <2ebCneCbwthjQ1rYT41nhd7M76Hc6YmosMAQrTFhBq8qeqh6tt Chain> snowman/transitive.go:333 consensus starting with J5wjmotMCrM2DKxeBTBPfwgCPpvsjtuqWNozLog2TomTjSuGK as the last accepted block ``` That means the node has successfully bootstrapped the Avalanche L1 and is now in sync. If the node is one of the validators, it will start validating any transactions that get posted to the Avalanche L1. ### Monitoring[​](#monitoring "Direct link to heading") If you want to inspect the process of Avalanche L1 syncing, you can use the RPC call to check for the [blockchain status](/docs/rpcs/p-chain#platformgetblockchainstatus). For a more in-depth look into Avalanche L1 operation, check out the blockchain log. By default, the log can be found in `~/.avalanchego/logs/ChainID.log` where you replace the `ChainID` with the actual ID of the blockchain in your Avalanche L1. For an even more thorough (and pretty!) insight into how the node and the Avalanche L1 is behaving, you can install the Prometheus+Grafana monitoring system with the custom dashboards for the regular node operation, as well as a dedicated dashboard for Avalanche L1 data. Check out the [tutorial](/docs/nodes/maintain/monitoring) for information on how to set it up. ### Managing Validation[​](#managing-validation "Direct link to heading") On Avalanche all validations are limited in time and can range from two weeks up to one year. Furthermore, Avalanche L1 validations are always a subset of the Primary Network validation period (must be shorter or the same). That means that periodically your validators will expire and you will need to submit a new validation transaction for both the Primary Network and your Avalanche L1. Unless managed properly and in a timely manner, that can be disruptive for your Avalanche L1 (if all validators expire at the same time your Avalanche L1 will halt). To avoid that, keep notes on when a particular validation is set to expire and be ready to renew it as soon as possible. Also, when initially setting up the nodes, make sure to stagger the validator expiry so they don't all expire on the same date. Setting end dates at least a day apart is a good practice, as well as setting reminders for each expiry. Conclusion[​](#conclusion "Direct link to heading") --------------------------------------------------- Hopefully, by reading this document you have a better picture of the requirements and considerations you need to make when deploying your Avalanche L1 to production and you are now better prepared to launch your Avalanche L1 successfully. Keep in mind, running an Avalanche L1 in production is not a one-and-done kind of situation, it is in fact running a fleet of servers 24/7. And as with any real time service, you should have a robust logging, monitoring and alerting systems to constantly check the nodes and Avalanche L1 health and alert you if anything out of the ordinary happens. If you have any questions, doubts or would like to chat, please check out our [Discord server](https://discord.gg/avax/), where we host a dedicated `#subnet-chat` channel dedicated to talking about all things Avalanche L1. # With Custom VM (/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-with-custom-vm) --- title: With Custom VM description: Learn how to create an Avalanche L1 with a custom virtual machine and deploy it locally. --- This tutorial walks through the process of creating an Avalanche L1 with a custom virtual machine and deploying it locally. Although the tutorial uses a fork of Subnet-EVM as an example, you can extend its lessons to support any custom VM binary. Fork Subnet-EVM[​](#fork-subnet-evm "Direct link to heading") ------------------------------------------------------------- Instead of building a custom VM from scratch, this tutorial starts with forking Subnet-EVM. ### Clone Subnet-EVM[​](#clone-subnet-evm "Direct link to heading") First off, clone the Subnet-EVM repository into a directory of your choosing. ```bash git clone https://github.com/ava-labs/subnet-evm.git ``` The repository cloning method used is HTTPS, but SSH can be used too: `git clone git@github.com:ava-labs/subnet-evm.git` You can find more about SSH and how to use it [here](https://docs.github.com/en/authentication/connecting-to-github-with-ssh/about-ssh). ### Modify and Build Subnet-EVM[​](#modify-and-build-subnet-evm "Direct link to heading") To prove you're running your custom binary and not the stock Subnet-EVM included with Avalanche-CLI, you need to modify the Subnet-EVM binary by making a minor change. Navigate to the directory you cloned Subnet-EVM into and generate a new commit: ```bash git commit -a --allow-empty -m "custom vm commit" ``` Take note of the new commit hash: ```bash git rev-parse HEAD c0fe6506a40da466285f37dd0d3c044f494cce32 ``` In this case, `c0fe6506a40da466285f37dd0d3c044f494cce32`. Now build your custom binary by running: ```bash ./scripts/build.sh custom_vm.bin ``` This command builds the binary and saves it at `./custom_vm.bin`. ### Create a Custom Genesis[​](#create-a-custom-genesis "Direct link to heading") To start a VM, you need to provide a genesis file. Here is a basic Subnet-EVM genesis that's compatible with your custom VM. This genesis includes the PoA Validator Manager, a Transparent Proxy and Proxy Admin as predeployed contracts. `0c0deba5e0000000000000000000000000000000` is the ValidatorManager address. `0feedc0de0000000000000000000000000000000` is the Transparent Proxy address. `c0ffee1234567890abcdef1234567890abcdef34` is the Proxy Admin contract. These proxy contracts are from [OpenZeppelin v4.9](https://github.com/OpenZeppelin/openzeppelin-contracts/tree/release-v4.9/contracts/proxy/transparent) You can add your own predeployed contracts by running `forge build` and collecting the `deployedBytecode` output from `out/MyContract.sol` ```json { "config": { "berlinBlock": 0, "byzantiumBlock": 0, "chainId": 1, "constantinopleBlock": 0, "eip150Block": 0, "eip155Block": 0, "eip158Block": 0, "feeConfig": { "gasLimit": 12000000, "targetBlockRate": 2, "minBaseFee": 25000000000, "targetGas": 60000000, "baseFeeChangeDenominator": 36, "minBlockGasCost": 0, "maxBlockGasCost": 1000000, "blockGasCostStep": 200000 }, "homesteadBlock": 0, "istanbulBlock": 0, "londonBlock": 0, "muirGlacierBlock": 0, "petersburgBlock": 0, "warpConfig": { "blockTimestamp": 1736356569, "quorumNumerator": 67, "requirePrimaryNetworkSigners": true } }, "nonce": "0x0", "timestamp": "0x677eb2d9", "extraData": "0x", "gasLimit": "0xb71b00", "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "alloc": { "0c0deba5e0000000000000000000000000000000": { "code": "0x608060405234801561000f575f80fd5b5060043610610132575f3560e01c80639ba96b86116100b4578063c974d1b611610079578063c974d1b6146102a7578063d588c18f146102af578063d5f20ff6146102c2578063df93d8de146102e2578063f2fde38b146102ec578063fd7ac5e7146102ff575f80fd5b80639ba96b861461024c578063a3a65e481461025f578063b771b3bc14610272578063bc5fbfec14610280578063bee0a03f14610294575f80fd5b8063715018a6116100fa578063715018a6146101be578063732214f8146101c65780638280a25a146101db5780638da5cb5b146101f557806397fb70d414610239575f80fd5b80630322ed981461013657806320d91b7a1461014b578063467ef06f1461015e57806360305d621461017157806366435abf14610193575b5f80fd5b610149610144366004612b01565b610312565b005b610149610159366004612b30565b610529565b61014961016c366004612b7e565b610a15565b610179601481565b60405163ffffffff90911681526020015b60405180910390f35b6101a66101a1366004612b01565b610a23565b6040516001600160401b03909116815260200161018a565b610149610a37565b6101cd5f81565b60405190815260200161018a565b6101e3603081565b60405160ff909116815260200161018a565b7f9016d09d72d40fdae2fd8ceac6b6234c7706214fd39c1cd1e609a0528c199300546001600160a01b03165b6040516001600160a01b03909116815260200161018a565b610149610247366004612b01565b610a4a565b6101cd61025a366004612bad565b610a5f565b61014961026d366004612b7e565b610a7b565b6102216005600160991b0181565b6101cd5f8051602061370d83398151915281565b6101496102a2366004612b01565b610c04565b6101e3601481565b6101496102bd366004612c06565b610d41565b6102d56102d0366004612b01565b610e4f565b60405161018a9190612cc3565b6101a66202a30081565b6101496102fa366004612d43565b610f9e565b6101cd61030d366004612d65565b610fdb565b5f8181525f8051602061372d8339815191526020526040808220815160e0810190925280545f8051602061370d83398151915293929190829060ff16600581111561035f5761035f612c42565b600581111561037057610370612c42565b815260200160018201805461038490612dd0565b80601f01602080910402602001604051908101604052809291908181526020018280546103b090612dd0565b80156103fb5780601f106103d2576101008083540402835291602001916103fb565b820191905f5260205f20905b8154815290600101906020018083116103de57829003601f168201915b505050918352505060028201546001600160401b038082166020840152600160401b820481166040840152600160801b820481166060840152600160c01b909104811660808301526003928301541660a0909101529091508151600581111561046657610466612c42565b146104a2575f8381526007830160205260409081902054905163170cc93360e21b81526104999160ff1690600401612e08565b60405180910390fd5b6005600160991b016001600160a01b031663ee5b48eb6104c78584606001515f611036565b6040518263ffffffff1660e01b81526004016104e39190612e16565b6020604051808303815f875af11580156104ff573d5f803e3d5ffd5b505050506040513d601f19601f820116820180604052508101906105239190612e28565b50505050565b7fe92546d698950ddd38910d2e15ed1d923cd0a7b3dde9e2a6a3f380565559cb09545f8051602061370d8339815191529060ff161561057b57604051637fab81e560e01b815260040160405180910390fd5b6005600160991b016001600160a01b0316634213cf786040518163ffffffff1660e01b8152600401602060405180830381865afa1580156105be573d5f803e3d5ffd5b505050506040513d601f19601f820116820180604052508101906105e29190612e28565b83602001351461060b576040516372b0a7e760e11b815260208401356004820152602401610499565b3061061c6060850160408601612d43565b6001600160a01b03161461065f5761063a6060840160408501612d43565b604051632f88120d60e21b81526001600160a01b039091166004820152602401610499565b5f61066d6060850185612e3f565b905090505f805b828163ffffffff161015610955575f6106906060880188612e3f565b8363ffffffff168181106106a6576106a6612e84565b90506020028101906106b89190612e98565b6106c190612fbc565b80516040519192505f9160088801916106d991613035565b9081526020016040518091039020541461070957805160405163a41f772f60e01b81526104999190600401612e16565b5f6002885f01358460405160200161073892919091825260e01b6001600160e01b031916602082015260240190565b60408051601f198184030181529082905261075291613035565b602060405180830381855afa15801561076d573d5f803e3d5ffd5b5050506040513d601f19601f820116820180604052508101906107909190612e28565b90508086600801835f01516040516107a89190613035565b90815260408051602092819003830181209390935560e0830181526002835284518284015284810180516001600160401b03908116858401525f60608601819052915181166080860152421660a085015260c0840181905284815260078a01909252902081518154829060ff1916600183600581111561082a5761082a612c42565b0217905550602082015160018201906108439082613091565b506040828101516002830180546060860151608087015160a08801516001600160401b039586166001600160801b031990941693909317600160401b92861692909202919091176001600160801b0316600160801b918516919091026001600160c01b031617600160c01b9184169190910217905560c0909301516003909201805467ffffffffffffffff1916928416929092179091558301516108e8911685613164565b82516040519195506108f991613035565b60408051918290038220908401516001600160401b031682529082907f9d47fef9da077661546e646d61830bfcbda90506c2e5eed38195e82c4eb1cbdf9060200160405180910390a350508061094e90613177565b9050610674565b50600483018190555f61097361096a86611085565b6040015161119b565b90505f61097f87611328565b90505f6002826040516109929190613035565b602060405180830381855afa1580156109ad573d5f803e3d5ffd5b5050506040513d601f19601f820116820180604052508101906109d09190612e28565b90508281146109fc57604051631872fc8d60e01b81526004810182905260248101849052604401610499565b5050506009909201805460ff1916600117905550505050565b610a1e81611561565b505050565b5f610a2d82610e4f565b6080015192915050565b610a3f61189f565b610a485f6118fa565b565b610a5261189f565b610a5b8161196a565b5050565b5f610a6861189f565b610a728383611c4e565b90505b92915050565b5f8051602061370d8339815191525f80610aa0610a9785611085565b604001516121a1565b9150915080610ac657604051632d07135360e01b81528115156004820152602401610499565b5f82815260068401602052604090208054610ae090612dd0565b90505f03610b045760405163089938b360e11b815260048101839052602401610499565b60015f83815260078501602052604090205460ff166005811115610b2a57610b2a612c42565b14610b5d575f8281526007840160205260409081902054905163170cc93360e21b81526104999160ff1690600401612e08565b5f8281526006840160205260408120610b7591612a75565b5f828152600784016020908152604091829020805460ff1916600290811782550180546001600160401b0342818116600160c01b026001600160c01b0390931692909217928390558451600160801b9093041682529181019190915283917ff8fd1c90fb9cfa2ca2358fdf5806b086ad43315d92b221c929efc7f105ce7568910160405180910390a250505050565b5f8181527fe92546d698950ddd38910d2e15ed1d923cd0a7b3dde9e2a6a3f380565559cb066020526040902080545f8051602061370d8339815191529190610c4b90612dd0565b90505f03610c6f5760405163089938b360e11b815260048101839052602401610499565b60015f83815260078301602052604090205460ff166005811115610c9557610c95612c42565b14610cc8575f8281526007820160205260409081902054905163170cc93360e21b81526104999160ff1690600401612e08565b5f82815260068201602052604090819020905163ee5b48eb60e01b81526005600160991b019163ee5b48eb91610d019190600401613199565b6020604051808303815f875af1158015610d1d573d5f803e3d5ffd5b505050506040513d601f19601f82011682018060405250810190610a1e9190612e28565b7ff0c57e16840df040f15088dc2f81fe391c3923bec73e23a9662efc9c229c6a008054600160401b810460ff1615906001600160401b03165f81158015610d855750825b90505f826001600160401b03166001148015610da05750303b155b905081158015610dae575080155b15610dcc5760405163f92ee8a960e01b815260040160405180910390fd5b845467ffffffffffffffff191660011785558315610df657845460ff60401b1916600160401b1785555b610e00878761235d565b8315610e4657845460ff60401b19168555604051600181527fc7f505b2f371ae2175ee4913f4499e1f2633a7b5936321eed1cdaeb6115181d29060200160405180910390a15b50505050505050565b610e57612aac565b5f8281525f8051602061372d833981519152602052604090819020815160e0810190925280545f8051602061370d833981519152929190829060ff166005811115610ea457610ea4612c42565b6005811115610eb557610eb5612c42565b8152602001600182018054610ec990612dd0565b80601f0160208091040260200160405190810160405280929190818152602001828054610ef590612dd0565b8015610f405780601f10610f1757610100808354040283529160200191610f40565b820191905f5260205f20905b815481529060010190602001808311610f2357829003601f168201915b505050918352505060028201546001600160401b038082166020840152600160401b820481166040840152600160801b820481166060840152600160c01b9091048116608083015260039092015490911660a0909101529392505050565b610fa661189f565b6001600160a01b038116610fcf57604051631e4fbdf760e01b81525f6004820152602401610499565b610fd8816118fa565b50565b6040515f905f8051602061370d833981519152907fe92546d698950ddd38910d2e15ed1d923cd0a7b3dde9e2a6a3f380565559cb089061101e9086908690613223565b90815260200160405180910390205491505092915050565b604080515f6020820152600360e01b602282015260268101949094526001600160c01b031960c093841b811660468601529190921b16604e830152805180830360360181526056909201905290565b60408051606080820183525f8083526020830152918101919091526040516306f8253560e41b815263ffffffff831660048201525f9081906005600160991b0190636f825350906024015f60405180830381865afa1580156110e9573d5f803e3d5ffd5b505050506040513d5f823e601f3d908101601f191682016040526111109190810190613241565b915091508061113257604051636b2f19e960e01b815260040160405180910390fd5b815115611158578151604051636ba589a560e01b81526004810191909152602401610499565b60208201516001600160a01b031615611194576020820151604051624de75d60e31b81526001600160a01b039091166004820152602401610499565b5092915050565b5f81516026146111d057815160405163cc92daa160e01b815263ffffffff909116600482015260266024820152604401610499565b5f805b600281101561121f576111e7816001613313565b6111f2906008613326565b61ffff1684828151811061120857611208612e84565b016020015160f81c901b91909117906001016111d3565b5061ffff8116156112495760405163407b587360e01b815261ffff82166004820152602401610499565b5f805b60048110156112a457611260816003613313565b61126b906008613326565b63ffffffff168561127d836002613164565b8151811061128d5761128d612e84565b016020015160f81c901b919091179060010161124c565b5063ffffffff8116156112ca57604051635b60892f60e01b815260040160405180910390fd5b5f805b602081101561131f576112e181601f613313565b6112ec906008613326565b866112f8836006613164565b8151811061130857611308612e84565b016020015160f81c901b91909117906001016112cd565b50949350505050565b60605f8083356020850135601461134487870160408901612d43565b6113516060890189612e3f565b60405160f09790971b6001600160f01b0319166020880152602287019590955250604285019290925260e090811b6001600160e01b0319908116606286015260609290921b6bffffffffffffffffffffffff191660668501529190911b16607a820152607e0160405160208183030381529060405290505f5b6113d76060850185612e3f565b9050811015611194576113ed6060850185612e3f565b828181106113fd576113fd612e84565b905060200281019061140f9190612e98565b61141d90602081019061333d565b905060301461143f5760405163180ffa0d60e01b815260040160405180910390fd5b8161144d6060860186612e3f565b8381811061145d5761145d612e84565b905060200281019061146f9190612e98565b611479908061333d565b90506114886060870187612e3f565b8481811061149857611498612e84565b90506020028101906114aa9190612e98565b6114b4908061333d565b6114c16060890189612e3f565b868181106114d1576114d1612e84565b90506020028101906114e39190612e98565b6114f190602081019061333d565b6114fe60608b018b612e3f565b8881811061150e5761150e612e84565b90506020028101906115209190612e98565b61153190606081019060400161337f565b6040516020016115479796959493929190613398565b60408051601f1981840301815291905291506001016113ca565b5f61156a612aac565b5f8051602061370d8339815191525f80611586610a9787611085565b9150915080156115ad57604051632d07135360e01b81528115156004820152602401610499565b5f828152600784016020526040808220815160e081019092528054829060ff1660058111156115de576115de612c42565b60058111156115ef576115ef612c42565b815260200160018201805461160390612dd0565b80601f016020809104026020016040519081016040528092919081815260200182805461162f90612dd0565b801561167a5780601f106116515761010080835404028352916020019161167a565b820191905f5260205f20905b81548152906001019060200180831161165d57829003601f168201915b505050918352505060028201546001600160401b038082166020840152600160401b820481166040840152600160801b820481166060840152600160c01b909104811660808301526003928301541660a090910152909150815160058111156116e5576116e5612c42565b14158015611706575060018151600581111561170357611703612c42565b14155b1561172757805160405163170cc93360e21b81526104999190600401612e08565b60038151600581111561173c5761173c612c42565b0361174a576004815261174f565b600581525b8360080181602001516040516117659190613035565b90815260408051602092819003830190205f908190558581526007870190925290208151815483929190829060ff191660018360058111156117a9576117a9612c42565b0217905550602082015160018201906117c29082613091565b5060408201516002820180546060850151608086015160a08701516001600160401b039586166001600160801b031990941693909317600160401b92861692909202919091176001600160801b0316600160801b918516919091026001600160c01b031617600160c01b9184169190910217905560c0909201516003909101805467ffffffffffffffff1916919092161790558051600581111561186857611868612c42565b60405184907f1c08e59656f1a18dc2da76826cdc52805c43e897a17c50faefb8ab3c1526cc16905f90a39196919550909350505050565b336118d17f9016d09d72d40fdae2fd8ceac6b6234c7706214fd39c1cd1e609a0528c199300546001600160a01b031690565b6001600160a01b031614610a485760405163118cdaa760e01b8152336004820152602401610499565b7f9016d09d72d40fdae2fd8ceac6b6234c7706214fd39c1cd1e609a0528c19930080546001600160a01b031981166001600160a01b03848116918217845560405192169182907f8be0079c531659141344cd1fd0a4f28419497f9722a3daafe3b4186f6b6457e0905f90a3505050565b611972612aac565b5f8281525f8051602061372d8339815191526020526040808220815160e0810190925280545f8051602061370d83398151915293929190829060ff1660058111156119bf576119bf612c42565b60058111156119d0576119d0612c42565b81526020016001820180546119e490612dd0565b80601f0160208091040260200160405190810160405280929190818152602001828054611a1090612dd0565b8015611a5b5780601f10611a3257610100808354040283529160200191611a5b565b820191905f5260205f20905b815481529060010190602001808311611a3e57829003601f168201915b50505091835250506002828101546001600160401b038082166020850152600160401b820481166040850152600160801b820481166060850152600160c01b9091048116608084015260039093015490921660a09091015290915081516005811115611ac957611ac9612c42565b14611afc575f8481526007830160205260409081902054905163170cc93360e21b81526104999160ff1690600401612e08565b60038152426001600160401b031660c08201525f84815260078301602052604090208151815483929190829060ff19166001836005811115611b4057611b40612c42565b021790555060208201516001820190611b599082613091565b5060408201516002820180546060850151608086015160a08701516001600160401b039586166001600160801b031990941693909317600160401b92861692909202919091176001600160801b0316600160801b918516919091026001600160c01b031617600160c01b9184169190910217905560c0909201516003909101805467ffffffffffffffff1916919092161790555f611bf78582612377565b6080840151604080516001600160401b03909216825242602083015291935083925087917f13d58394cf269d48bcf927959a29a5ffee7c9924dafff8927ecdf3c48ffa7c67910160405180910390a3509392505050565b7fe92546d698950ddd38910d2e15ed1d923cd0a7b3dde9e2a6a3f380565559cb09545f9060ff16611c9257604051637fab81e560e01b815260040160405180910390fd5b5f8051602061370d83398151915242611cb1606086016040870161337f565b6001600160401b0316111580611ceb5750611ccf6202a30042613164565b611cdf606086016040870161337f565b6001600160401b031610155b15611d2557611d00606085016040860161337f565b604051635879da1360e11b81526001600160401b039091166004820152602401610499565b6030611d34602086018661333d565b905014611d6657611d48602085018561333d565b6040516326475b2f60e11b8152610499925060040190815260200190565b611d70848061333d565b90505f03611d9d57611d82848061333d565b604051633e08a12560e11b8152600401610499929190613401565b5f60088201611dac868061333d565b604051611dba929190613223565b90815260200160405180910390205414611df357611dd8848061333d565b60405163a41f772f60e01b8152600401610499929190613401565b611dfd835f6124ce565b6040805160e08101909152815481525f908190611f099060208101611e22898061333d565b8080601f0160208091040260200160405190810160405280939291908181526020018383808284375f92019190915250505090825250602090810190611e6a908a018a61333d565b8080601f0160208091040260200160405190810160405280939291908181526020018383808284375f92019190915250505090825250602001611eb360608a0160408b0161337f565b6001600160401b03168152602001611ece60608a018a61342f565b611ed790613443565b8152602001611ee960808a018a61342f565b611ef290613443565b8152602001876001600160401b03168152506126a8565b5f82815260068601602052604090209193509150611f278282613091565b508160088401611f37888061333d565b604051611f45929190613223565b9081526040519081900360200181209190915563ee5b48eb60e01b81525f906005600160991b019063ee5b48eb90611f81908590600401612e16565b6020604051808303815f875af1158015611f9d573d5f803e3d5ffd5b505050506040513d601f19601f82011682018060405250810190611fc19190612e28565b6040805160e081019091529091508060018152602001611fe1898061333d565b8080601f0160208091040260200160405190810160405280939291908181526020018383808284375f9201829052509385525050506001600160401b0389166020808401829052604080850184905260608501929092526080840183905260a0909301829052868252600788019092522081518154829060ff1916600183600581111561207057612070612c42565b0217905550602082015160018201906120899082613091565b5060408201516002820180546060850151608086015160a08701516001600160401b039586166001600160801b031990941693909317600160401b92861692909202919091176001600160801b0316600160801b918516919091026001600160c01b031617600160c01b9184169190910217905560c0909201516003909101805467ffffffffffffffff19169190921617905580612127888061333d565b604051612135929190613223565b6040518091039020847fb77297e3befc691bfc864a81e241f83e2ef722b6e7becaa2ecec250c6d52b430898b6040016020810190612173919061337f565b604080516001600160401b0393841681529290911660208301520160405180910390a4509095945050505050565b5f8082516027146121d757825160405163cc92daa160e01b815263ffffffff909116600482015260276024820152604401610499565b5f805b6002811015612226576121ee816001613313565b6121f9906008613326565b61ffff1685828151811061220f5761220f612e84565b016020015160f81c901b91909117906001016121da565b5061ffff8116156122505760405163407b587360e01b815261ffff82166004820152602401610499565b5f805b60048110156122ab57612267816003613313565b612272906008613326565b63ffffffff1686612284836002613164565b8151811061229457612294612e84565b016020015160f81c901b9190911790600101612253565b5063ffffffff81166002146122d357604051635b60892f60e01b815260040160405180910390fd5b5f805b6020811015612328576122ea81601f613313565b6122f5906008613326565b87612301836006613164565b8151811061231157612311612e84565b016020015160f81c901b91909117906001016122d6565b505f8660268151811061233d5761233d612e84565b016020015191976001600160f81b03199092161515965090945050505050565b612365612895565b61236e826128de565b610a5b816128f7565b5f8281525f8051602061372d833981519152602052604081206002015481905f8051602061370d83398151915290600160801b90046001600160401b03166123bf85826124ce565b5f6123c987612908565b5f8881526007850160205260408120600201805467ffffffffffffffff60801b1916600160801b6001600160401b038b16021790559091506005600160991b0163ee5b48eb6124198a858b611036565b6040518263ffffffff1660e01b81526004016124359190612e16565b6020604051808303815f875af1158015612451573d5f803e3d5ffd5b505050506040513d601f19601f820116820180604052508101906124759190612e28565b604080516001600160401b038a811682526020820184905282519394508516928b927f07de5ff35a674a8005e661f3333c907ca6333462808762d19dc7b3abb1a8c1df928290030190a3909450925050505b9250929050565b5f8051602061370d8339815191525f6001600160401b038084169085161115612502576124fb838561350a565b905061250f565b61250c848461350a565b90505b6040805160808101825260028401548082526003850154602083015260048501549282019290925260058401546001600160401b031660608201524291158061257157506001840154815161256d916001600160401b031690613164565b8210155b15612597576001600160401b0383166060820152818152604081015160208201526125b6565b82816060018181516125a9919061352a565b6001600160401b03169052505b60608101516125c690606461354a565b602082015160018601546001600160401b0392909216916125f19190600160401b900460ff16613326565b101561262157606081015160405163dfae880160e01b81526001600160401b039091166004820152602401610499565b856001600160401b03168160400181815161263c9190613164565b9052506040810180516001600160401b038716919061265c908390613313565b905250805160028501556020810151600385015560408101516004850155606001516005909301805467ffffffffffffffff19166001600160401b039094169390931790925550505050565b5f60608260400151516030146126d15760405163180ffa0d60e01b815260040160405180910390fd5b82516020808501518051604080880151606089015160808a01518051908701515193515f98612712988a986001989297929690959094909390929101613575565b60405160208183030381529060405290505f5b846080015160200151518110156127845781856080015160200151828151811061275157612751612e84565b602002602001015160405160200161276a92919061362f565b60408051601f198184030181529190529150600101612725565b5060a08401518051602091820151516040516127a4938593929101613665565b60405160208183030381529060405290505f5b8460a00151602001515181101561281657818560a001516020015182815181106127e3576127e3612e84565b60200260200101516040516020016127fc92919061362f565b60408051601f1981840301815291905291506001016127b7565b5060c084015160405161282d9183916020016136a0565b604051602081830303815290604052905060028160405161284e9190613035565b602060405180830381855afa158015612869573d5f803e3d5ffd5b5050506040513d601f19601f8201168201806040525081019061288c9190612e28565b94909350915050565b7ff0c57e16840df040f15088dc2f81fe391c3923bec73e23a9662efc9c229c6a0054600160401b900460ff16610a4857604051631afcd79f60e31b815260040160405180910390fd5b6128e6612895565b6128ee61297d565b610fd881612985565b6128ff612895565b610fd881612a6d565b5f8181525f8051602061372d8339815191526020526040812060020180545f8051602061370d833981519152919060089061295290600160401b90046001600160401b03166136d1565b91906101000a8154816001600160401b0302191690836001600160401b031602179055915050919050565b610a48612895565b61298d612895565b80355f8051602061370d83398151915290815560146129b260608401604085016136ec565b60ff1611806129d157506129cc60608301604084016136ec565b60ff16155b15612a05576129e660608301604084016136ec565b604051634a59bbff60e11b815260ff9091166004820152602401610499565b612a1560608301604084016136ec565b60018201805460ff92909216600160401b0260ff60401b19909216919091179055612a46604083016020840161337f565b600191909101805467ffffffffffffffff19166001600160401b0390921691909117905550565b610fa6612895565b508054612a8190612dd0565b5f825580601f10612a90575050565b601f0160209004905f5260205f2090810190610fd89190612ae9565b6040805160e08101909152805f81526060602082018190525f604083018190529082018190526080820181905260a0820181905260c09091015290565b5b80821115612afd575f8155600101612aea565b5090565b5f60208284031215612b11575f80fd5b5035919050565b803563ffffffff81168114612b2b575f80fd5b919050565b5f8060408385031215612b41575f80fd5b82356001600160401b03811115612b56575f80fd5b830160808186031215612b67575f80fd5b9150612b7560208401612b18565b90509250929050565b5f60208284031215612b8e575f80fd5b610a7282612b18565b80356001600160401b0381168114612b2b575f80fd5b5f8060408385031215612bbe575f80fd5b82356001600160401b03811115612bd3575f80fd5b830160a08186031215612be4575f80fd5b9150612b7560208401612b97565b6001600160a01b0381168114610fd8575f80fd5b5f808284036080811215612c18575f80fd5b6060811215612c25575f80fd5b508291506060830135612c3781612bf2565b809150509250929050565b634e487b7160e01b5f52602160045260245ffd5b60068110612c7257634e487b7160e01b5f52602160045260245ffd5b9052565b5f5b83811015612c90578181015183820152602001612c78565b50505f910152565b5f8151808452612caf816020860160208601612c76565b601f01601f19169290920160200192915050565b60208152612cd5602082018351612c56565b5f602083015160e06040840152612cf0610100840182612c98565b905060408401516001600160401b0380821660608601528060608701511660808601528060808701511660a08601528060a08701511660c08601528060c08701511660e086015250508091505092915050565b5f60208284031215612d53575f80fd5b8135612d5e81612bf2565b9392505050565b5f8060208385031215612d76575f80fd5b82356001600160401b0380821115612d8c575f80fd5b818501915085601f830112612d9f575f80fd5b813581811115612dad575f80fd5b866020828501011115612dbe575f80fd5b60209290920196919550909350505050565b600181811c90821680612de457607f821691505b602082108103612e0257634e487b7160e01b5f52602260045260245ffd5b50919050565b60208101610a758284612c56565b602081525f610a726020830184612c98565b5f60208284031215612e38575f80fd5b5051919050565b5f808335601e19843603018112612e54575f80fd5b8301803591506001600160401b03821115612e6d575f80fd5b6020019150600581901b36038213156124c7575f80fd5b634e487b7160e01b5f52603260045260245ffd5b5f8235605e19833603018112612eac575f80fd5b9190910192915050565b634e487b7160e01b5f52604160045260245ffd5b604051606081016001600160401b0381118282101715612eec57612eec612eb6565b60405290565b604080519081016001600160401b0381118282101715612eec57612eec612eb6565b604051601f8201601f191681016001600160401b0381118282101715612f3c57612f3c612eb6565b604052919050565b5f6001600160401b03821115612f5c57612f5c612eb6565b50601f01601f191660200190565b5f82601f830112612f79575f80fd5b8135612f8c612f8782612f44565b612f14565b818152846020838601011115612fa0575f80fd5b816020850160208301375f918101602001919091529392505050565b5f60608236031215612fcc575f80fd5b612fd4612eca565b82356001600160401b0380821115612fea575f80fd5b612ff636838701612f6a565b8352602085013591508082111561300b575f80fd5b5061301836828601612f6a565b60208301525061302a60408401612b97565b604082015292915050565b5f8251612eac818460208701612c76565b601f821115610a1e57805f5260205f20601f840160051c8101602085101561306b5750805b601f840160051c820191505b8181101561308a575f8155600101613077565b5050505050565b81516001600160401b038111156130aa576130aa612eb6565b6130be816130b88454612dd0565b84613046565b602080601f8311600181146130f1575f84156130da5750858301515b5f19600386901b1c1916600185901b178555613148565b5f85815260208120601f198616915b8281101561311f57888601518255948401946001909101908401613100565b508582101561313c57878501515f19600388901b60f8161c191681555b505060018460011b0185555b505050505050565b634e487b7160e01b5f52601160045260245ffd5b80820180821115610a7557610a75613150565b5f63ffffffff80831681810361318f5761318f613150565b6001019392505050565b5f60208083525f84546131ab81612dd0565b806020870152604060018084165f81146131cc57600181146131e857613215565b60ff19851660408a0152604084151560051b8a01019550613215565b895f5260205f205f5b8581101561320c5781548b82018601529083019088016131f1565b8a016040019650505b509398975050505050505050565b818382375f9101908152919050565b80518015158114612b2b575f80fd5b5f8060408385031215613252575f80fd5b82516001600160401b0380821115613268575f80fd5b908401906060828703121561327b575f80fd5b613283612eca565b8251815260208084015161329681612bf2565b828201526040840151838111156132ab575f80fd5b80850194505087601f8501126132bf575f80fd5b835192506132cf612f8784612f44565b83815288828587010111156132e2575f80fd5b6132f184838301848801612c76565b80604084015250819550613306818801613232565b9450505050509250929050565b81810381811115610a7557610a75613150565b8082028115828204841417610a7557610a75613150565b5f808335601e19843603018112613352575f80fd5b8301803591506001600160401b0382111561336b575f80fd5b6020019150368190038213156124c7575f80fd5b5f6020828403121561338f575f80fd5b610a7282612b97565b5f88516133a9818460208d01612c76565b60e089901b6001600160e01b031916908301908152868860048301378681019050600481015f8152858782375060c09390931b6001600160c01b0319166004939094019283019390935250600c019695505050505050565b60208152816020820152818360408301375f818301604090810191909152601f909201601f19160101919050565b5f8235603e19833603018112612eac575f80fd5b5f60408236031215613453575f80fd5b61345b612ef2565b61346483612b18565b81526020808401356001600160401b0380821115613480575f80fd5b9085019036601f830112613492575f80fd5b8135818111156134a4576134a4612eb6565b8060051b91506134b5848301612f14565b81815291830184019184810190368411156134ce575f80fd5b938501935b838510156134f857843592506134e883612bf2565b82825293850193908501906134d3565b94860194909452509295945050505050565b6001600160401b0382811682821603908082111561119457611194613150565b6001600160401b0381811683821601908082111561119457611194613150565b6001600160401b0381811683821602808216919082811461356d5761356d613150565b505092915050565b61ffff60f01b8a60f01b1681525f63ffffffff60e01b808b60e01b166002840152896006840152808960e01b1660268401525086516135bb81602a850160208b01612c76565b8651908301906135d281602a840160208b01612c76565b60c087901b6001600160c01b031916602a9290910191820152613604603282018660e01b6001600160e01b0319169052565b61361d603682018560e01b6001600160e01b0319169052565b603a019b9a5050505050505050505050565b5f8351613640818460208801612c76565b60609390931b6bffffffffffffffffffffffff19169190920190815260140192915050565b5f8451613676818460208901612c76565b6001600160e01b031960e095861b8116919093019081529290931b16600482015260080192915050565b5f83516136b1818460208801612c76565b60c09390931b6001600160c01b0319169190920190815260080192915050565b5f6001600160401b0380831681810361318f5761318f613150565b5f602082840312156136fc575f80fd5b813560ff81168114612d5e575f80fdfee92546d698950ddd38910d2e15ed1d923cd0a7b3dde9e2a6a3f380565559cb00e92546d698950ddd38910d2e15ed1d923cd0a7b3dde9e2a6a3f380565559cb07a164736f6c6343000819000a", "balance": "0x0", "nonce": "0x1" }, "0feedc0de0000000000000000000000000000000": { "code": "0x60806040523661001357610011610017565b005b6100115b61001f610169565b6001600160a01b0316330361015f5760606001600160e01b0319600035166364d3180d60e11b810161005a5761005361019c565b9150610157565b63587086bd60e11b6001600160e01b031982160161007a576100536101f3565b63070d7c6960e41b6001600160e01b031982160161009a57610053610239565b621eb96f60e61b6001600160e01b03198216016100b95761005361026a565b63a39f25e560e01b6001600160e01b03198216016100d9576100536102aa565b60405162461bcd60e51b815260206004820152604260248201527f5472616e73706172656e745570677261646561626c6550726f78793a2061646d60448201527f696e2063616e6e6f742066616c6c6261636b20746f2070726f78792074617267606482015261195d60f21b608482015260a4015b60405180910390fd5b815160208301f35b6101676102be565b565b60007fb53127684a568b3173ae13b9f8a6016e243e63b6e8ee1178d6a717850b5d61035b546001600160a01b0316919050565b60606101a66102ce565b60006101b53660048184610683565b8101906101c291906106c9565b90506101df816040518060200160405280600081525060006102d9565b505060408051602081019091526000815290565b60606000806102053660048184610683565b81019061021291906106fa565b91509150610222828260016102d9565b604051806020016040528060008152509250505090565b60606102436102ce565b60006102523660048184610683565b81019061025f91906106c9565b90506101df81610305565b60606102746102ce565b600061027e610169565b604080516001600160a01b03831660208201529192500160405160208183030381529060405291505090565b60606102b46102ce565b600061027e61035c565b6101676102c961035c565b61036b565b341561016757600080fd5b6102e28361038f565b6000825111806102ef5750805b15610300576102fe83836103cf565b505b505050565b7f7e644d79422f17c01e4894b5f4f588d331ebfa28653d42ae832dc59e38c9798f61032e610169565b604080516001600160a01b03928316815291841660208301520160405180910390a1610359816103fb565b50565b60006103666104a4565b905090565b3660008037600080366000845af43d6000803e80801561038a573d6000f35b3d6000fd5b610398816104cc565b6040516001600160a01b038216907fbc7cd75a20ee27fd9adebab32041f755214dbc6bffa90cc0225b39da2e5c2d3b90600090a250565b60606103f4838360405180606001604052806027815260200161083060279139610560565b9392505050565b6001600160a01b0381166104605760405162461bcd60e51b815260206004820152602660248201527f455243313936373a206e65772061646d696e20697320746865207a65726f206160448201526564647265737360d01b606482015260840161014e565b807fb53127684a568b3173ae13b9f8a6016e243e63b6e8ee1178d6a717850b5d61035b80546001600160a01b0319166001600160a01b039290921691909117905550565b60007f360894a13ba1a3210667c828492db98dca3e2076cc3735a920a3ca505d382bbc61018d565b6001600160a01b0381163b6105395760405162461bcd60e51b815260206004820152602d60248201527f455243313936373a206e657720696d706c656d656e746174696f6e206973206e60448201526c1bdd08184818dbdb9d1c9858dd609a1b606482015260840161014e565b807f360894a13ba1a3210667c828492db98dca3e2076cc3735a920a3ca505d382bbc610483565b6060600080856001600160a01b03168560405161057d91906107e0565b600060405180830381855af49150503d80600081146105b8576040519150601f19603f3d011682016040523d82523d6000602084013e6105bd565b606091505b50915091506105ce868383876105d8565b9695505050505050565b60608315610647578251600003610640576001600160a01b0385163b6106405760405162461bcd60e51b815260206004820152601d60248201527f416464726573733a2063616c6c20746f206e6f6e2d636f6e7472616374000000604482015260640161014e565b5081610651565b6106518383610659565b949350505050565b8151156106695781518083602001fd5b8060405162461bcd60e51b815260040161014e91906107fc565b6000808585111561069357600080fd5b838611156106a057600080fd5b5050820193919092039150565b80356001600160a01b03811681146106c457600080fd5b919050565b6000602082840312156106db57600080fd5b6103f4826106ad565b634e487b7160e01b600052604160045260246000fd5b6000806040838503121561070d57600080fd5b610716836106ad565b9150602083013567ffffffffffffffff8082111561073357600080fd5b818501915085601f83011261074757600080fd5b813581811115610759576107596106e4565b604051601f8201601f19908116603f01168101908382118183101715610781576107816106e4565b8160405282815288602084870101111561079a57600080fd5b8260208601602083013760006020848301015280955050505050509250929050565b60005b838110156107d75781810151838201526020016107bf565b50506000910152565b600082516107f28184602087016107bc565b9190910192915050565b602081526000825180602084015261081b8160408501602087016107bc565b601f01601f1916919091016040019291505056fe416464726573733a206c6f772d6c6576656c2064656c65676174652063616c6c206661696c6564a2646970667358221220b22984eb1f3348f5b2148862b6f80392e497e3c65d0d2cfbb5e53d737e5a6c6a64736f6c63430008190033", "storage": { "0x360894a13ba1a3210667c828492db98dca3e2076cc3735a920a3ca505d382bbc": "0x0000000000000000000000000c0deba5e0000000000000000000000000000000", "0xb53127684a568b3173ae13b9f8a6016e243e63b6e8ee1178d6a717850b5d6103": "0x000000000000000000000000c0ffee1234567890abcdef1234567890abcdef34" }, "balance": "0x0", "nonce": "0x1" }, "32aaa04b1c166d02b0ee152dd221367687f72108": { "balance": "0x2086ac351052600000" }, "48a90c916ad48a72f49fa72a9f889c1ba9cc9b4b": { "balance": "0x8ac7230489e80000" }, "8db97c7cece249c2b98bdc0226cc4c2a57bf52fc": { "balance": "0xd3c21bcecceda1000000" }, "c0ffee1234567890abcdef1234567890abcdef34": { "code": "0x60806040526004361061007b5760003560e01c80639623609d1161004e5780639623609d1461011157806399a88ec414610124578063f2fde38b14610144578063f3b7dead1461016457600080fd5b8063204e1c7a14610080578063715018a6146100bc5780637eff275e146100d35780638da5cb5b146100f3575b600080fd5b34801561008c57600080fd5b506100a061009b366004610499565b610184565b6040516001600160a01b03909116815260200160405180910390f35b3480156100c857600080fd5b506100d1610215565b005b3480156100df57600080fd5b506100d16100ee3660046104bd565b610229565b3480156100ff57600080fd5b506000546001600160a01b03166100a0565b6100d161011f36600461050c565b610291565b34801561013057600080fd5b506100d161013f3660046104bd565b610300565b34801561015057600080fd5b506100d161015f366004610499565b610336565b34801561017057600080fd5b506100a061017f366004610499565b6103b4565b6000806000836001600160a01b03166040516101aa90635c60da1b60e01b815260040190565b600060405180830381855afa9150503d80600081146101e5576040519150601f19603f3d011682016040523d82523d6000602084013e6101ea565b606091505b5091509150816101f957600080fd5b8080602001905181019061020d91906105e2565b949350505050565b61021d6103da565b6102276000610434565b565b6102316103da565b6040516308f2839760e41b81526001600160a01b038281166004830152831690638f283970906024015b600060405180830381600087803b15801561027557600080fd5b505af1158015610289573d6000803e3d6000fd5b505050505050565b6102996103da565b60405163278f794360e11b81526001600160a01b03841690634f1ef2869034906102c990869086906004016105ff565b6000604051808303818588803b1580156102e257600080fd5b505af11580156102f6573d6000803e3d6000fd5b5050505050505050565b6103086103da565b604051631b2ce7f360e11b81526001600160a01b038281166004830152831690633659cfe69060240161025b565b61033e6103da565b6001600160a01b0381166103a85760405162461bcd60e51b815260206004820152602660248201527f4f776e61626c653a206e6577206f776e657220697320746865207a65726f206160448201526564647265737360d01b60648201526084015b60405180910390fd5b6103b181610434565b50565b6000806000836001600160a01b03166040516101aa906303e1469160e61b815260040190565b6000546001600160a01b031633146102275760405162461bcd60e51b815260206004820181905260248201527f4f776e61626c653a2063616c6c6572206973206e6f7420746865206f776e6572604482015260640161039f565b600080546001600160a01b038381166001600160a01b0319831681178455604051919092169283917f8be0079c531659141344cd1fd0a4f28419497f9722a3daafe3b4186f6b6457e09190a35050565b6001600160a01b03811681146103b157600080fd5b6000602082840312156104ab57600080fd5b81356104b681610484565b9392505050565b600080604083850312156104d057600080fd5b82356104db81610484565b915060208301356104eb81610484565b809150509250929050565b634e487b7160e01b600052604160045260246000fd5b60008060006060848603121561052157600080fd5b833561052c81610484565b9250602084013561053c81610484565b9150604084013567ffffffffffffffff8082111561055957600080fd5b818601915086601f83011261056d57600080fd5b81358181111561057f5761057f6104f6565b604051601f8201601f19908116603f011681019083821181831017156105a7576105a76104f6565b816040528281528960208487010111156105c057600080fd5b8260208601602083013760006020848301015280955050505050509250925092565b6000602082840312156105f457600080fd5b81516104b681610484565b60018060a01b03831681526000602060406020840152835180604085015260005b8181101561063c57858101830151858201606001528201610620565b506000606082860101526060601f19601f83011685010192505050939250505056fea264697066735822122019f39983a6fd15f3cffa764efd6fb0234ffe8d71051b3ebddc0b6bd99f87fa9764736f6c63430008190033", "storage": { "0x0000000000000000000000000000000000000000000000000000000000000000": "0x00000000000000000000000048a90c916ad48a72f49fa72a9f889c1ba9cc9b4b" }, "balance": "0x0", "nonce": "0x1" } }, "airdropHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "airdropAmount": null, "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "baseFeePerGas": null, "excessBlobGas": null, "blobGasUsed": null } ``` Open a text editor and copy the preceding text into a file called `custom_genesis.json`. For full breakdown of the genesis file, see the [Genesis File](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#genesis). The `timestamp` field is the Unix timestamp of the genesis block. `0x677eb2d9` represents the timestamp 1736356569 which is the time this tutorial was written. You should use the timestamp when you create your genesis file. Create the Avalanche L1 Configuration[​](#create-the-avalanche-l1-configuration "Direct link to heading") --------------------------------------------------------------------------------------------- Now that you have your binary, it's time to create the Avalanche L1 configuration. This tutorial uses `myblockchain` as it's Avalanche L1 name. Invoke the Avalanche L1 Creation Wizard with this command: ```bash avalanche blockchain create myblockchain ``` ### Choose Your VM[​](#choose-your-vm "Direct link to heading") Select `Custom` for your VM. ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose your VM: Subnet-EVM ▸ Custom ``` ### Select Validator Manager type ```bash Which validator management type would you like to use in your blockchain?: ▸ Proof Of Authority Proof Of Stake Explain the difference ``` Select the Validator manager that matches the `deployedBytecode` in your genesis. This tutorial is using Proof Of Authority. Next, select the key that will be used to controller the PoA ValidatorManager contract: ```bash Which address do you want to enable as controller of ValidatorManager contract?: ▸ Get address from an existing stored key (created from avalanche key create or avalanche key import) Custom ``` This key can add, remove and change weight of the validator set. ### Enter the Path to Your Genesis[​](#enter-the-path-to-your-genesis "Direct link to heading") Enter the path to the genesis file you created in this [step](#create-a-custom-genesis). ```bash ✔ Enter path to custom genesis: ./custom_genesis.json ``` ### ICM Setup ```bash ? Do you want to connect your blockchain with other blockchains or the C-Chain?: Yes, I want to enable my blockchain to interoperate with other blockchains and the C-Chain ▸ No, I want to run my blockchain isolated Explain the difference ``` Select no for now as we can setup ICM after deployment. ### Enter the Path to Your VM Binary[​](#enter-the-path-to-your-vm-binary "Direct link to heading") ```bash ? How do you want to set up the VM binary?: Download and build from a git repository (recommended for cloud deployments) ▸ I already have a VM binary (local network deployments only) ``` Select `I already have a VM binary`. Next, enter the path to your VM binary. This should be the path to the `custom_evm.bin` you created [previously](#modify-and-build-subnet-evm). ```bash ✔ Enter path to vm binary: ./custom_vm.bin ``` ### Wrapping Up[​](#wrapping-up "Direct link to heading") If all worked successfully, the command prints: ```bash ✓ Successfully created blockchain configuration Run 'avalanche blockchain describe' to view all created addresses and what their roles are ``` Now it's time to deploy it. Deploy the Avalanche L1 Locally[​](#deploy-the-avalanche-l1-locally "Direct link to heading") --------------------------------------------------------------------------------- To deploy your Avalanche L1, run: ```bash avalanche blockchain deploy myblockchain ``` Make sure to substitute the name of your Avalanche L1 if you used a different one than `myblockchain`. Next, select `Local Network`: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose a network to deploy on: ▸ Local Network Fuji Mainnet ``` This command boots a five node Avalanche network on your machine. It needs to download the latest versions of AvalancheGo and Subnet-EVM. The command may take a couple minutes to run. If all works as expected, the command output should look something like this: ```bash Deploying [myblockchain] to Local Network Backend controller started, pid: 49158, output at: /Users/l1-dev/.avalanche-cli/runs/server_20250108_140532/avalanche-cli-backend.log Installing avalanchego-v1.12.1... avalanchego-v1.12.1 installation successful AvalancheGo path: /Users/l1-dev/.avalanche-cli/bin/avalanchego/avalanchego-v1.12.1/avalanchego Booting Network. Wait until healthy... Node logs directory: /Users/l1-dev/.avalanche-cli/runs/network_20250108_140538/node/logs Network ready to use. Your blockchain control keys: [P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p] Your subnet auth keys for chain creation: [P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p] CreateSubnetTx fee: 0.000010278 AVAX Subnet has been created with ID: GEieSy2doZ96bpMo5CuHPaX1LvaxpKZ9C72L22j94t6YyUb6X Now creating blockchain... CreateChainTx fee: 0.000095896 AVAX +-------------------------------------------------------------------+ | DEPLOYMENT RESULTS | +---------------+---------------------------------------------------+ | Chain Name | myblockchain | +---------------+---------------------------------------------------+ | Subnet ID | GEieSy2doZ96bpMo5CuHPaX1LvaxpKZ9C72L22j94t6YyUb6X | +---------------+---------------------------------------------------+ | VM ID | qDNV9vtxZYYNqm7TN1mYBuaaknLdefDbFK8bFmMLTJQJKaWjV | +---------------+---------------------------------------------------+ | Blockchain ID | 9FrNVEPkVpQyWDECQhEPDuT9oK98EhWQdg7anypKujVt9uSVT | +---------------+ | | P-Chain TXID | | +---------------+---------------------------------------------------+ Restarting node node2 to track subnet Restarting node node1 to track subnet Waiting for http://127.0.0.1:9652/ext/bc/9FrNVEPkVpQyWDECQhEPDuT9oK98EhWQdg7anypKujVt9uSVT/rpc to be available Waiting for http://127.0.0.1:9650/ext/bc/9FrNVEPkVpQyWDECQhEPDuT9oK98EhWQdg7anypKujVt9uSVT/rpc to be available ✓ Local Network successfully tracking myblockchain ✓ Subnet is successfully deployed Local Network ``` Use the describe command to find your L1s RPC: ```bash avalanche blockchain describe myblockchain ``` You can use the `RPC URL` to connect to and interact with your Avalanche L1. Interact with Your Avalanche L1[​](#interact-with-your-avalanche-l1 "Direct link to heading") --------------------------------------------------------------------------------- ### Check the Version[​](#check-the-version "Direct link to heading") You can verify that your Avalanche L1 has deployed correctly by querying the local node to see what Avalanche L1s it's running. You need to use the [`getNodeVersion`](/docs/rpcs/other/info-rpc#infogetnodeversion) endpoint. Try running this curl command: ```bash curl --location --request POST 'http://127.0.0.1:9650/ext/info' \ --header 'Content-Type: application/json' \ --data-raw '{ "jsonrpc":"2.0", "id" :1, "method" :"info.getNodeVersion", "params" :{ } }' ``` The command returns a list of all the VMs your local node is currently running along with their versions. ```json { "jsonrpc": "2.0", "result": { "version": "avalanche/1.10.8", "databaseVersion": "v1.4.5", "rpcProtocolVersion": "27", "gitCommit": "e70a17d9d988b5067f3ef5c4a057f15ae1271ac4", "vmVersions": { "avm": "v1.10.8", "evm": "v0.12.5", "platform": "v1.10.8", "qDMnZ895HKpRXA2wEvujJew8nNFEkvcrH5frCR9T1Suk1sREe": "v0.5.4@c0fe6506a40da466285f37dd0d3c044f494cce32" } }, "id": 1 } ``` Your results may be slightly different, but you can see that in addition to the X-Chain's `avm`, the C-Chain's `evm`, and the P-Chain's `platform` VM, the node is running the custom VM with commit `c0fe6506a40da466285f37dd0d3c044f494cce32`. ### Check a Balance[​](#check-a-balance "Direct link to heading") If you used the default genesis, your custom VM has a prefunded address. You can verify its balance with a curl command. Make sure to substitute the command's URL with the `RPC URL` from your deployment output. ```bash curl --location --request POST 'http://127.0.0.1:9650/ext/bc/myblockchain/rpc' \ --header 'Content-Type: application/json' \ --data-raw '{ "jsonrpc": "2.0", "method": "eth_getBalance", "params": [ "0x8db97c7cece249c2b98bdc0226cc4c2a57bf52fc", "latest" ], "id": 1 }' ``` The command should return: ```json { "jsonrpc": "2.0", "id": 1, "result": "0xd3c21bcecceda1000000" } ``` The balance is hex encoded, so this means the address has a balance of 1 million tokens. Note, this command doesn't work on all custom VMs, only VMs that implement the EVM's `eth_getBalance` interface. Next Steps[​](#next-steps "Direct link to heading") --------------------------------------------------- You've now unlocked the ability to deploy custom VMs. Go build something cool! # With Multisig Auth (/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-with-multisig-auth) --- title: With Multisig Auth description: Learn how to create an Avalanche L1 with a multisig authorization. --- Avalanche L1 creators can control critical Avalanche L1 operations with a N of M multisig. This multisig must be setup at deployment time and can't be edited afterward. Multisigs can are available on both the Fuji Testnet and Mainnet. To setup your multisig, you need to know the P-Chain address of each key holder and what you want your signing threshold to be. Avalanche-CLI requires Ledgers for Mainnet deployments. This how-to guide assumes the use of Ledgers for setting up your multisig. ## Prerequisites - [`Avalanche-CLI`](https://github.com/ava-labs/avalanche-cli) installed - Familiarity with process of [Deploying an Avalanche L1 on Testnet](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-fuji-testnet) and [Deploying a Permissioned Avalanche L1 on Mainnet](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-mainnet) - Multiple Ledger devices [configured for Avalanche](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-mainnet#setting-up-your-ledger) - an Avalanche L1 configuration ready to deploy to either Fuji Testnet or Mainnet Getting Started[​](#getting-started "Direct link to heading") ------------------------------------------------------------- When issuing the transactions to create the Avalanche L1, you need to sign the TXs with multiple keys from the multisig. ### Specify Network[​](#specify-network "Direct link to heading") Start the Avalanche L1 deployment with ```bash avalanche blockchain deploy testAvalanche L1 ``` First step is to specify `Fuji` or `Mainnet` as the network: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose a network to deploy on: Local Network Fuji ▸ Mainnet ``` ```bash Deploying [testblockchain] to Mainnet ``` Ledger is automatically recognized as the signature mechanism on `Mainnet`. After that, the CLI shows the first `Mainnet` Ledger address. ```bash Ledger address: P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 ``` ### Set Control Keys[​](#set-control-keys "Direct link to heading") Next the CLI asks the user to specify the control keys. This is where you setup your multisig. ```bash Configure which addresses may make changes to the Avalanche L1. These addresses are known as your control keys. You are going to also set how many control keys are required to make an Avalanche L1 change (the threshold). Use the arrow keys to navigate: ↓ ↑ → ← ? How would you like to set your control keys?: ▸ Use ledger address Custom list ``` Select `Custom list` and add every address that you'd like to be a key holder on the multisig. ```bash ✔ Custom list ? Enter control keys: ▸ Add Delete Preview More Info ↓ Done ``` Use the given menu to add each key, and select `Done` when finished. The output at this point should look something like: ```bash ✔ Custom list ✔ Add Enter P-Chain address (Example: P-...): P-avax1wryu62weky9qjlp40cpmnqf6ml2hytnagj5q28 ✔ Add Enter P-Chain address (Example: P-...): P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 ✔ Add Enter P-Chain address (Example: P-...): P-avax12gcy0xl0al6gcjrt0395xqlcuq078ml93wl5h8 ✔ Add Enter P-Chain address (Example: P-...): P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af ✔ Add Enter P-Chain address (Example: P-...): P-avax1g4eryh40dtcsltmxn9zk925ny07gdq2xyjtf4g ✔ Done Your Avalanche L1's control keys: [P-avax1wryu62weky9qjlp40cpmnqf6ml2hytnagj5q28 P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 P-avax12gcy0xl0al6gcjrt0395xqlcuq078ml93wl5h8 P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af P-avax1g4eryh40dtcsltmxn9zk925ny07gdq2xyjtf4g] ``` When deploying an Avalanche L1 with Ledger, you must include the Ledger's default address determined in [Specify Network](#specify-network) for the deployment to succeed. You may see an error like ``` Error: wallet does not contain Avalanche L1 auth keys exit status 1 ``` ### Set Threshold[​](#set-threshold "Direct link to heading") Next, specify the threshold. In your N of M multisig, your threshold is N, and M is the number of control keys you added in the previous step. ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Select required number of control key signatures to make an Avalanche L1 change: ▸ 1 2 3 4 5 ``` ### Specify Control Keys to Sign the Chain Creation TX[​](#specify-control-keys-to-sign-the-chain-creation-tx "Direct link to heading") You now need N of your key holders to sign the Avalanche L1 deployment transaction. You must select which addresses you want to sign the TX. ```bash ? Choose an Avalanche L1 auth key: ▸ P-avax1wryu62weky9qjlp40cpmnqf6ml2hytnagj5q28 P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 P-avax12gcy0xl0al6gcjrt0395xqlcuq078ml93wl5h8 P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af P-avax1g4eryh40dtcsltmxn9zk925ny07gdq2xyjtf4g ``` A successful control key selection looks like: ```bash ✔ 2 ✔ P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 ✔ P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af Your subnet auth keys for chain creation: [P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af] *** Please sign Avalanche L1 creation hash on the ledger device *** ``` #### Potential Errors[​](#potential-errors "Direct link to heading") If the currently connected Ledger address isn't included in your TX signing group, the operation fails with: ```bash ✔ 2 ✔ P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af ✔ P-avax1g4eryh40dtcsltmxn9zk925ny07gdq2xyjtf4g Your Avalanche L1 auth keys for chain creation: [P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af P-avax1g4eryh40dtcsltmxn9zk925ny07gdq2xyjtf4g] Error: wallet does not contain Avalanche L1 auth keys exit status 1 ``` This can happen either because the original specified control keys -previous step- don't contain the Ledger address, or because the Ledger address control key wasn't selected in the current step. If the user has the correct address but doesn't have sufficient balance to pay for the TX, the operation fails with: ```bash ✔ 2 ✔ P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af ✔ P-avax1g4eryh40dtcsltmxn9zk925ny07gdq2xyjtf4g Your Avalanche L1 auth keys for chain creation: [P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af P-avax1g4eryh40dtcsltmxn9zk925ny07gdq2xyjtf4g] *** Please sign Avalanche L1 creation hash on the ledger device *** Error: insufficient funds: provided UTXOs need 1000000000 more units of asset "rgNLkDPpANwqg3pHC4o9aGJmf2YU4GgTVUMRKAdnKodihkqgr" exit status 1 ``` ### Sign Avalanche L1 Deployment TX with the First Address[​](#sign-avalanche-l1-deployment-tx-with-the-first-address "Direct link to heading") The Avalanche L1 Deployment TX is ready for signing. ```bash *** Please sign Avalanche L1 creation hash on the ledger device *** ``` This activates a `Please review` window on the Ledger. Navigate to the Ledger's `APPROVE` window by using the Ledger's right button, and then authorize the request by pressing both left and right buttons. ```bash Avalanche L1 has been created with ID: 2qUKjvPx68Fgc1NMi8w4mtaBt5hStgBzPhsQrS1m7vSub2q9ew. Now creating blockchain... *** Please sign blockchain creation hash on the ledger device *** ``` After successful Avalanche L1 creation, the CLI asks the user to sign the blockchain creation TX. This activates a `Please review` window on the Ledger. Navigate to the Ledger's `APPROVE` window by using the Ledger's right button, and then authorize the request by pressing both left and right buttons. On success, the CLI provides Avalanche L1 deploy details. As only one address signed the chain creation TX, the CLI writes a file to disk to save the TX to continue the signing process with another command. ```bash +--------------------+----------------------------------------------------+ | DEPLOYMENT RESULTS | | +--------------------+----------------------------------------------------+ | Chain Name | testblockchain | +--------------------+----------------------------------------------------+ | Subnet ID | 2qUKjvPx68Fgc1NMi8w4mtaBt5hStgBzPhsQrS1m7vSub2q9ew | +--------------------+----------------------------------------------------+ | VM ID | rW1esjm6gy4BtGvxKMpHB2M28MJGFNsqHRY9AmnchdcgeB3ii | +--------------------+----------------------------------------------------+ 1 of 2 required Blockchain Creation signatures have been signed. Saving TX to disk to enable remaining signing. Path to export partially signed TX to: ``` Enter the name of file to write to disk, such as `partiallySigned.txt`. This file shouldn't exist already. ```bash Path to export partially signed TX to: partiallySigned.txt Addresses remaining to sign the tx: P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af Connect a ledger with one of the remaining addresses or choose a stored key and run the signing command, or send "partiallySigned.txt" to another user for signing. Signing command: avalanche transaction sign testblockchain --input-tx-filepath partiallySigned.txt ``` Gather Remaining Signatures and Issue the Avalanche L1 Deployment TX[​](#gather-remaining-signatures-and-issue-the-avalanche-l1-deployment-tx "Direct link to heading") ----------------------------------------------------------------------------------------------------------------------------------------------------------- So far, one address has signed the Avalanche L1 deployment TX, but you need N signatures. Your Avalanche L1 has not been fully deployed yet. To get the remaining signatures, you may connect a different Ledger to the same computer you've been working on. Alternatively, you may send the `partiallySigned.txt` file to other users to sign themselves. The remainder of this section assumes that you are working on a machine with access to both the remaining keys and the `partiallySigned.txt` file. ### Issue the Command to Sign the Chain Creation TX[​](#issue-the-command-to-sign-the-chain-creation-tx "Direct link to heading") Avalanche-CLI can detect the deployment network automatically. For `Mainnet` TXs, it uses your Ledger automatically. For `Fuji Testnet`, the CLI prompts the user to choose the signing mechanism. You can start the signing process with the `transaction sign` command: ```bash avalanche transaction sign testblockchain --input-tx-filepath partiallySigned.txt ``` ```bash Ledger address: P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af *** Please sign TX hash on the ledger device *** ``` Next, the CLI starts a new signing process for the Avalanche L1 deployment TX. If the Ledger isn't the correct one, the following error should appear instead: ```bash Ledger address: P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 Error: wallet does not contain Avalanche L1 auth keys exit status 1 ``` This activates a `Please review` window on the Ledger. Navigate to the Ledger's `APPROVE` window by using the Ledger's right button, and then authorize the request by pressing both left and right buttons. Repeat this processes until all required parties have signed the TX. You should see a message like this: ```bash All 2 required Tx signatures have been signed. Saving TX to disk to enable commit. Overwriting partiallySigned.txt Tx is fully signed, and ready to be committed Commit command: avalanche transaction commit testblockchain --input-tx-filepath partiallySigned.txt ``` Now, `partiallySigned.txt` contains a fully signed TX. ### Commit the Avalanche L1 Deployment TX[​](#commit-the-avalanche-l1-deployment-tx "Direct link to heading") To run submit the fully signed TX, run: ```bash avalanche transaction commit testblockchain --input-tx-filepath partiallySigned.txt ``` The CLI recognizes the deployment network automatically and submits the TX appropriately. ```bash +--------------------+-------------------------------------------------------------------------------------+ | DEPLOYMENT RESULTS | | +--------------------+-------------------------------------------------------------------------------------+ | Chain Name | testblockchain | +--------------------+-------------------------------------------------------------------------------------+ | Subnet ID | 2qUKjvPx68Fgc1NMi8w4mtaBt5hStgBzPhsQrS1m7vSub2q9ew | +--------------------+-------------------------------------------------------------------------------------+ | VM ID | rW1esjm6gy4BtGvxKMpHB2M28MJGFNsqHRY9AmnchdcgeB3ii | +--------------------+-------------------------------------------------------------------------------------+ | Blockchain ID | 2fx9EF61C964cWBu55vcz9b7gH9LFBkPwoj49JTSHA6Soqqzoj | +--------------------+-------------------------------------------------------------------------------------+ | RPC URL | http://127.0.0.1:9650/ext/bc/2fx9EF61C964cWBu55vcz9b7gH9LFBkPwoj49JTSHA6Soqqzoj/rpc | +--------------------+-------------------------------------------------------------------------------------+ | P-Chain TXID | 2fx9EF61C964cWBu55vcz9b7gH9LFBkPwoj49JTSHA6Soqqzoj | +--------------------+-------------------------------------------------------------------------------------+ ``` Your Avalanche L1 successfully deployed with a multisig. Add Validators Using the Multisig[​](#add-validators-using-the-multisig "Direct link to heading") ------------------------------------------------------------------------------------------------- The `addValidator` command also requires use of the multisig. Before starting, make sure to connect, unlock, and run the Avalanche Ledger app. ```bash avalanche blockchain addValidator testblockchain ``` ### Select Network[​](#select-network "Direct link to heading") First specify the network. Select either `Fuji` or `Mainnet`: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Choose a network to add validator to.: ▸ Fuji Mainnet ``` ### Choose Signing Keys[​](#choose-signing-keys "Direct link to heading") Then, similar to the `deploy` command, the command asks the user to select the N control keys needed to sign the TX. ```bash ✔ Mainnet Use the arrow keys to navigate: ↓ ↑ → ← ? Choose an Avalanche L1 auth key: ▸ P-avax1wryu62weky9qjlp40cpmnqf6ml2hytnagj5q28 P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 P-avax12gcy0xl0al6gcjrt0395xqlcuq078ml93wl5h8 P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af P-avax1g4eryh40dtcsltmxn9zk925ny07gdq2xyjtf4g ``` ```bash ✔ Mainnet ✔ P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 ✔ P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af Your subnet auth keys for add validator TX creation: [P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af]. ``` ### Finish Assembling the TX[​](#finish-assembling-the-tx "Direct link to heading") Take a look at [Add a Validator](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-mainnet#add-a-validator) for additional help issuing this transaction. If setting up a multisig, don't select your validator start time to be in one minute. Finishing the signing process takes significantly longer when using a multisig. ```bash Next, we need the NodeID of the validator you want to whitelist. Check https://build.avax.network/docs/rpcs/other/info-rpc#info-getnodeid for instructions about how to query the NodeID from your node (Edit host IP address and port to match your deployment, if needed). What is the NodeID of the validator you'd like to whitelist?: NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg ✔ Default (20) When should your validator start validating? If your validator is not ready by this time, Avalanche L1 downtime can occur. ✔ Custom When should the validator start validating? Enter a UTC datetime in 'YYYY-MM-DD HH:MM:SS' format: 2022-11-22 23:00:00 ✔ Until primary network validator expires NodeID: NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg Network: Local Network Start time: 2022-11-22 23:00:00 End time: 2023-11-22 15:57:27 Weight: 20 Inputs complete, issuing transaction to add the provided validator information... ``` ```bash Ledger address: P-avax1kdzq569g2c9urm9887cmldlsa3w3jhxe0knfy5 *** Please sign add validator hash on the ledger device *** ``` After that, the command shows the connected Ledger's address, and asks the user to sign the TX with the Ledger. ```bash Partial TX created 1 of 2 required Add Validator signatures have been signed. Saving TX to disk to enable remaining signing. Path to export partially signed TX to: ``` Because you've setup a multisig, TX isn't fully signed, and the commands asks a file to write into. Use something like `partialAddValidatorTx.txt`. ```bash Path to export partially signed TX to: partialAddValidatorTx.txt Addresses remaining to sign the tx: P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af Connect a Ledger with one of the remaining addresses or choose a stored key and run the signing command, or send "partialAddValidatorTx.txt" to another user for signing. Signing command: avalanche transaction sign testblockchain --input-tx-filepath partialAddValidatorTx.txt ``` Sign and Commit the Add Validator TX[​](#sign-and-commit-the-add-validator-tx "Direct link to heading") ------------------------------------------------------------------------------------------------------- The process is very similar to signing of Avalanche L1 Deployment TX. So far, one address has signed the TX, but you need N signatures. To get the remaining signatures, you may connect a different Ledger to the same computer you've been working on. Alternatively, you may send the `partialAddValidatorTx.txt` file to other users to sign themselves. The remainder of this section assumes that you are working on a machine with access to both the remaining keys and the `partialAddValidatorTx.txt` file. ### Issue the Command to Sign the Add Validator TX[​](#issue-the-command-to-sign-the-add-validator-tx "Direct link to heading") Avalanche-CLI can detect the deployment network automatically. For `Mainnet` TXs, it uses your Ledger automatically. For `Fuji Testnet`, the CLI prompts the user to choose the signing mechanism. ```bash avalanche transaction sign testblockchain --input-tx-filepath partialAddValidatorTx.txt ``` ```bash Ledger address: P-avax1g7nkguzg8yju8cq3ndzc9lql2yg69s9ejqa2af *** Please sign TX hash on the ledger device *** ``` Next, the command is going to start a new signing process for the Add Validator TX. This activates a `Please review` window on the Ledger. Navigate to the Ledger's `APPROVE` window by using the Ledger's right button, and then authorize the request by pressing both left and right buttons. Repeat this processes until all required parties have signed the TX. You should see a message like this: ```bash All 2 required Tx signatures have been signed. Saving TX to disk to enable commit. Overwriting partialAddValidatorTx.txt Tx is fully signed, and ready to be committed Commit command: avalanche transaction commit testblockchain --input-tx-filepath partialAddValidatorTx.txt ``` Now, `partialAddValidatorTx.txt` contains a fully signed TX. ### Issue the Command to Commit the add validator TX[​](#issue-the-command-to-commit-the-add-validator-tx "Direct link to heading") To run submit the fully signed TX, run: ```bash avalanche transaction commit testblockchain --input-tx-filepath partialAddValidatorTx.txt ``` The CLI recognizes the deployment network automatically and submits the TX appropriately. ```bash Transaction successful, transaction ID: K7XNSwcmgjYX7BEdtFB3hEwQc6YFKRq9g7hAUPhW4J5bjhEJG ``` You've successfully added the validator to the Avalanche L1. # Teleporter on Devnet (/docs/tooling/avalanche-cli/cross-chain/teleporter-devnet) --- title: Teleporter on Devnet description: This how-to guide focuses on deploying Teleporter-enabled Avalanche L1s to a Devnet. --- After this tutorial, you would have created a Devnet and deployed two Avalanche L1s in it, and have enabled them to cross-communicate with each other and with the C-Chain through Teleporter and the underlying Warp technology. For more information on cross chain messaging through Teleporter and Warp, check: - [Cross Chain References](/docs/cross-chain) Note that currently only [Subnet-EVM](https://github.com/ava-labs/subnet-evm) and [Subnet-EVM-Based](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1) virtual machines support Teleporter. ## Prerequisites Before we begin, you will need to have: - Created an AWS account and have an updated AWS `credentials` file in home directory with \[default\] profile Note: the tutorial uses AWS hosts, but Devnets can also be created and operated in other supported cloud providers, such as GCP. Create Avalanche L1s Configurations[​](#create-avalanche-l1s-configurations "Direct link to heading") ----------------------------------------------------------------------------------------- For this section we will follow this [steps](/docs/tooling/avalanche-cli/cross-chain/teleporter-local-network#create-avalanche-l1s-configurations), to create two Teleporter-enabled Avalanche L1s, `` and ``. Create a Devnet and Deploy an Avalanche L1 in It[​](#create-a-devnet-and-deploy-a-avalanche-l1-in-it "Direct link to heading") ----------------------------------------------------------------------------------------------------------------- Let's use the `devnet wiz` command to create a devnet `` and deploy `` in it. The devnet will be created in the `us-east-1` region of AWS, and will consist of 5 validators only. ```bash avalanche node devnet wiz --aws --node-type default --region us-east-1 --num-validators 5 --num-apis 0 --enable-monitoring=false --default-validator-params Creating the devnet... Creating new EC2 instance(s) on AWS... ... Deploying [chain1] to Cluster ... configuring AWM RElayer on host i-0f1815c016b555fcc Setting the nodes as subnet trackers ... Setting up teleporter on subnet Teleporter Messenger successfully deployed to chain1 (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) Teleporter Registry successfully deployed to chain1 (0xb623C4495220C603D0A939D32478F55891a61750) Teleporter Messenger successfully deployed to c-chain (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) Teleporter Registry successfully deployed to c-chain (0x5DB9A7629912EBF95876228C24A848de0bfB43A9) Starting AWM Relayer Service setting AWM Relayer on host i-0f1815c016b555fcc to relay subnet chain1 updating configuration file ~/.avalanche-cli/nodes/i-0f1815c016b555fcc/services/awm-relayer/awm-relayer-config.json Devnet is successfully created and is now validating subnet chain1! Subnet RPC URL: http://67.202.23.231:9650/ext/bc/fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p/rpc ✓ Cluster information YAML file can be found at ~/.avalanche-cli/nodes/inventories//clusterInfo.yaml at local host ``` Notice some details here: - Two smart contracts are deployed to the Avalanche L1: Teleporter Messenger and Teleporter Registry - Both Teleporter smart contracts are also deployed to `C-Chain` - [AWM Teleporter Relayer](https://github.com/ava-labs/awm-relayer) is installed and configured as a service into one of the nodes (A Relayer [listens](/docs/cross-chain/teleporter/overview#data-flow) for new messages being generated on a source Avalanche L1 and sends them to the destination Avalanche L1.) CLI configures the Relayer to enable every Avalanche L1 to send messages to all other Avalanche L1s. If you add more Avalanche L1s to the Devnet, the Relayer will be automatically reconfigured. Checking Devnet Configuration and Relayer Logs[​](#checking-devnet-configuration-and-relayer-logs "Direct link to heading") --------------------------------------------------------------------------------------------------------------------------- Execute `node list` command to get a list of the devnet nodes: ```bash avalanche node list Cluster "" (Devnet) Node i-0f1815c016b555fcc (NodeID-91PGQ7keavfSV1XVFva2WsQXWLWZqqqKe) 67.202.23.231 [Validator,Relayer] Node i-026392a651571232c (NodeID-AkPyyTs9e9nPGShdSoxdvWYZ6X2zYoyrK) 52.203.183.68 [Validator] Node i-0d1b98d5d941d6002 (NodeID-ByEe7kuwtrPStmdMgY1JiD39pBAuFY2mS) 50.16.235.194 [Validator] Node i-0c291f54bb38c2984 (NodeID-8SE2CdZJExwcS14PYEqr3VkxFyfDHKxKq) 52.45.0.56 [Validator] Node i-049916e2f35231c29 (NodeID-PjQY7xhCGaB8rYbkXYddrr1mesYi29oFo) 3.214.163.110 [Validator] ``` Notice that, in this case, `i-0f1815c016b555fcc` was set as Relayer. This host contains a `systemd` service called `awm-relayer` that can be used to check the Relayer logs, and set the execution status. To view the Relayer logs, the following command can be used: ```bash avalanche node ssh i-0f1815c016b555fcc "journalctl -u awm-relayer --no-pager" [Node i-0f1815c016b555fcc (NodeID-91PGQ7keavfSV1XVFva2WsQXWLWZqqqKe) 67.202.23.231 [Validator,Relayer]] Warning: Permanently added '67.202.23.231' (ED25519) to the list of known hosts. -- Logs begin at Fri 2024-04-05 14:11:43 UTC, end at Fri 2024-04-05 14:30:24 UTC. -- Apr 05 14:15:06 ip-172-31-47-187 systemd[1]: Started AWM Relayer systemd service. Apr 05 14:15:07 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:07.018Z","logger":"awm-relayer","caller":"main/main.go:66","msg":"Initializing awm-relayer"} Apr 05 14:15:07 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:07.018Z","logger":"awm-relayer","caller":"main/main.go:71","msg":"Set config options."} Apr 05 14:15:07 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:07.018Z","logger":"awm-relayer","caller":"main/main.go:78","msg":"Initializing destination clients"} Apr 05 14:15:07 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:07.021Z","logger":"awm-relayer","caller":"main/main.go:97","msg":"Initializing app request network"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.159Z","logger":"awm-relayer","caller":"main/main.go:309","msg":"starting metrics server...","port":9090} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.160Z","logger":"awm-relayer","caller":"main/main.go:251","msg":"Creating relayer","originBlockchainID":"fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.160Z","logger":"awm-relayer","caller":"main/main.go:251","msg":"Creating relayer","originBlockchainID":"2EfJg86if9Ka5Ag73JRfoqWz4EGuFwtemaNf4XiBBpUW4YngS6"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.160Z","logger":"awm-relayer","caller":"relayer/relayer.go:114","msg":"Creating relayer","subnetID":"11111111111111111111111111111111LpoYY","subnetIDHex":"0000000000000000000000000000000000000000000000000000000000000000","blockchainID":"2EfJg86if9Ka5Ag73JRfoqWz4EGuFwtemaNf4XiBBpUW4YngS6","blockchainIDHex":"a2b6b947cf2b9bf6df03c8caab08e38ab951d8b120b9c37265d9be01d86bb170"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.160Z","logger":"awm-relayer","caller":"relayer/relayer.go:114","msg":"Creating relayer","subnetID":"giY8tswWgZmcAWzPkoNrmjjrykited7GJ9799SsFzTiq5a1ML","subnetIDHex":"5a2e2d87d74b4ec62fdd6626e7d36a44716484dfcc721aa4f2168e8a61af63af","blockchainID":"fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p","blockchainIDHex":"582fc7bd55472606c260668213bf1b6d291df776c9edf7e042980a84cce7418a"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.171Z","logger":"awm-relayer","caller":"evm/subscriber.go:247","msg":"Successfully subscribed","blockchainID":"2EfJg86if9Ka5Ag73JRfoqWz4EGuFwtemaNf4XiBBpUW4YngS6"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.171Z","logger":"awm-relayer","caller":"relayer/relayer.go:161","msg":"processed-missed-blocks set to false, starting processing from chain head","blockchainID":"2EfJg86if9Ka5Ag73JRfoqWz4EGuFwtemaNf4XiBBpUW4YngS6"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.172Z","logger":"awm-relayer","caller":"relayer/message_relayer.go:662","msg":"Updating latest processed block in database","relayerID":"0xea06381426934ec1800992f41615b9d362c727ad542f6351dbfa7ad2849a35bf","latestBlock":6} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.173Z","logger":"awm-relayer","caller":"relayer/message_relayer.go:662","msg":"Updating latest processed block in database","relayerID":"0x175e14327136d57fe22d4bdd295ff14bea8a7d7ab1884c06a4d9119b9574b9b3","latestBlock":6} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.173Z","logger":"awm-relayer","caller":"main/main.go:272","msg":"Created relayer","blockchainID":"2EfJg86if9Ka5Ag73JRfoqWz4EGuFwtemaNf4XiBBpUW4YngS6"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.173Z","logger":"awm-relayer","caller":"main/main.go:295","msg":"Relayer initialized. Listening for messages to relay.","originBlockchainID":"2EfJg86if9Ka5Ag73JRfoqWz4EGuFwtemaNf4XiBBpUW4YngS6"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.178Z","logger":"awm-relayer","caller":"evm/subscriber.go:247","msg":"Successfully subscribed","blockchainID":"fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.178Z","logger":"awm-relayer","caller":"relayer/relayer.go:161","msg":"processed-missed-blocks set to false, starting processing from chain head","blockchainID":"fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.179Z","logger":"awm-relayer","caller":"relayer/message_relayer.go:662","msg":"Updating latest processed block in database","relayerID":"0xe584ccc0df44506255811f6b54375e46abd5db40a4c84fd9235a68f7b69c6f06","latestBlock":6} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.179Z","logger":"awm-relayer","caller":"relayer/message_relayer.go:662","msg":"Updating latest processed block in database","relayerID":"0x70f14d33bde4716928c5c4723d3969942f9dfd1f282b64ffdf96f5ac65403814","latestBlock":6} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.180Z","logger":"awm-relayer","caller":"main/main.go:272","msg":"Created relayer","blockchainID":"fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p"} Apr 05 14:15:08 ip-172-31-47-187 awm-relayer[6886]: {"level":"info","timestamp":"2024-04-05T14:15:08.180Z","logger":"awm-relayer","caller":"main/main.go:295","msg":"Relayer initialized. Listening for messages to relay.","originBlockchainID":"fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p"} ``` Deploying the Second Avalanche L1[​](#deploying-the-second-avalanche-l1 "Direct link to heading") ------------------------------------------------------------------------------------- Let's use the `devnet wiz` command again to deploy ``. When deploying Avalanche L1 ``, the two Teleporter contracts will not be deployed to C-Chain in Local Network as they have already been deployed when we deployed the first Avalanche L1. ```bash avalanche node devnet wiz --default-validator-params Adding subnet into existing devnet ... ... Deploying [chain2] to Cluster ... Stopping AWM Relayer Service Setting the nodes as subnet trackers ... Setting up teleporter on subnet Teleporter Messenger successfully deployed to chain2 (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) Teleporter Registry successfully deployed to chain2 (0xb623C4495220C603D0A939D32478F55891a61750) Teleporter Messenger has already been deployed to c-chain Starting AWM Relayer Service setting AWM Relayer on host i-0f1815c016b555fcc to relay subnet chain2 updating configuration file ~/.avalanche-cli/nodes/i-0f1815c016b555fcc/services/awm-relayer/awm-relayer-config.json Devnet is now validating subnet chain2 Subnet RPC URL: http://67.202.23.231:9650/ext/bc/7gKt6evRnkA2uVHRfmk9WrH3dYZH9gEVVxDAknwtjvtaV3XuQ/rpc ✓ Cluster information YAML file can be found at ~/.avalanche-cli/nodes/inventories//clusterInfo.yaml at local host ``` Verify Teleporter Is Successfully Set Up[​](#verify-teleporter-is-successfully-set-up "Direct link to heading") --------------------------------------------------------------------------------------------------------------- To verify that Teleporter is successfully, let's send a couple of cross messages: ```bash avalanche teleporter msg C-Chain chain1 "Hello World" --cluster Delivering message "this is a message" to source subnet "C-Chain" (2EfJg86if9Ka5Ag73JRfoqWz4EGuFwtemaNf4XiBBpUW4YngS6) Waiting for message to be received at destination subnet subnet "chain1" (fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p) Message successfully Teleported! ``` ```bash avalanche teleporter msg chain2 chain1 "Hello World" --cluster Delivering message "this is a message" to source subnet "chain2" (29WP91AG7MqPUFEW2YwtKnsnzVrRsqcWUpoaoSV1Q9DboXGf4q) Waiting for message to be received at destination subnet subnet "chain1" (fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p) Message successfully Teleported! ``` You have Teleport-ed your first message in the Devnet! Obtaining Information on Teleporter Deploys[​](#obtaining-information-on-teleporter-deploys "Direct link to heading") --------------------------------------------------------------------------------------------------------------------- ### Obtaining Avalanche L1 Information[​](#obtaining-avalanche-l1-information "Direct link to heading") By executing `blockchain describe` on a Teleporter enabled Avalanche L1, the following relevant information can be found: - Blockchain RPC URL - Blockchain ID in cb58 format - Blockchain ID in plain hex format - Teleporter Messenger address - Teleporter Registry address Let's get the information for ``: ```bash avalanche blockchain describe _____ _ _ _ | __ \ | | (_) | | | | | ___| |_ __ _ _| |___ | | | |/ _ \ __/ _ | | / __| | |__| | __/ || (_| | | \__ \ |_____/ \___|\__\__,_|_|_|___/ +--------------------------------+----------------------------------------------------------------------------------------+ | PARAMETER | VALUE | +--------------------------------+----------------------------------------------------------------------------------------+ | Blockchain Name | chain1 | +--------------------------------+----------------------------------------------------------------------------------------+ | ChainID | 1 | +--------------------------------+----------------------------------------------------------------------------------------+ | Token Name | TOKEN1 Token | +--------------------------------+----------------------------------------------------------------------------------------+ | Token Symbol | TOKEN1 | +--------------------------------+----------------------------------------------------------------------------------------+ | VM Version | v0.6.3 | +--------------------------------+----------------------------------------------------------------------------------------+ | VM ID | srEXiWaHjFEgKSgK2zBgnWQUVEy2MZA7UUqjqmBSS7MZYSCQ5 | +--------------------------------+----------------------------------------------------------------------------------------+ | Cluster SubnetID | giY8tswWgZmcAWzPkoNrmjjrykited7GJ9799SsFzTiq5a1ML | +--------------------------------+----------------------------------------------------------------------------------------+ | Cluster RPC URL | http://67.202.23.231:9650/ext/bc/fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p/rpc | +--------------------------------+----------------------------------------------------------------------------------------+ | Cluster | fqcM24LNb3kTV7KD1mAvUJXYy5XunwP8mrE44YuNwPjgZHY6p | | BlockchainID | | + +----------------------------------------------------------------------------------------+ | | 0x582fc7bd55472606c260668213bf1b6d291df776c9edf7e042980a84cce7418a | | | | +--------------------------------+----------------------------------------------------------------------------------------+ | Cluster Teleporter| 0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf | | Messenger Address | | +--------------------------------+----------------------------------------------------------------------------------------+ | Cluster Teleporter| 0xb623C4495220C603D0A939D32478F55891a61750 | | Registry Address | | +--------------------------------+----------------------------------------------------------------------------------------+ ... ``` ### Obtaining C-Chain Information[​](#obtaining-c-chain-information "Direct link to heading") Similar information can be found for C-Chain by using `primary describe`: ```bash avalanche primary describe --cluster _____ _____ _ _ _____ / ____| / ____| | (_) | __ \ | | ______| | | |__ __ _ _ _ __ | |__) |_ _ _ __ __ _ _ __ ___ ___ | | |______| | | '_ \ / _ | | '_ \ | ___/ _ | '__/ _ | '_ _ \/ __| | |____ | |____| | | | (_| | | | | | | | | (_| | | | (_| | | | | | \__ \ \_____| \_____|_| |_|\__,_|_|_| |_| |_| \__,_|_| \__,_|_| |_| |_|___/ +------------------------------+--------------------------------------------------------------------+ | PARAMETER | VALUE | +------------------------------+--------------------------------------------------------------------+ | RPC URL | http://67.202.23.231:9650/ext/bc/C/rpc | +------------------------------+--------------------------------------------------------------------+ | EVM Chain ID | 43112 | +------------------------------+--------------------------------------------------------------------+ | TOKEN SYMBOL | AVAX | +------------------------------+--------------------------------------------------------------------+ | Address | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | +------------------------------+--------------------------------------------------------------------+ | Balance | 49999489.815751426 | +------------------------------+--------------------------------------------------------------------+ | Private Key | 56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027 | +------------------------------+--------------------------------------------------------------------+ | BlockchainID | 2EfJg86if9Ka5Ag73JRfoqWz4EGuFwtemaNf4XiBBpUW4YngS6 | + +--------------------------------------------------------------------+ | | 0xa2b6b947cf2b9bf6df03c8caab08e38ab951d8b120b9c37265d9be01d86bb170 | +------------------------------+--------------------------------------------------------------------+ | ICM Messenger Address | 0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf | +------------------------------+--------------------------------------------------------------------+ | ICM Registry Address | 0x5DB9A7629912EBF95876228C24A848de0bfB43A9 | +------------------------------+--------------------------------------------------------------------+ ``` Controlling Relayer Execution[​](#controlling-relayer-execution "Direct link to heading") ----------------------------------------------------------------------------------------- CLI provides two commands to remotely control Relayer execution: ```bash avalanche interchain relayer stop --cluster ✓ Remote AWM Relayer on i-0f1815c016b555fcc successfully stopped ``` ```bash avalanche interchain relayer start --cluster ✓ Remote AWM Relayer on i-0f1815c016b555fcc successfully started ``` # Teleporter on Local Network (/docs/tooling/avalanche-cli/cross-chain/teleporter-local-network) --- title: Teleporter on Local Network description: This how-to guide focuses on deploying Teleporter-enabled Avalanche L1s to a local Avalanche network. --- After this tutorial, you would have created and deployed two Avalanche L1s to the local network and have enabled them to cross-communicate with each other and with the local C-Chain (through Teleporter and the underlying Warp technology.) For more information on cross chain messaging through Teleporter and Warp, check: - [Cross Chain References](/docs/cross-chain) Note that currently only [Subnet-EVM](https://github.com/ava-labs/subnet-evm) and [Subnet-EVM-Based](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1) virtual machines support Teleporter. ## Prerequisites - [Avalanche-CLI installed](/docs/tooling/avalanche-cli) ## Create Avalanche L1 Configurations Let's create an Avalanche L1 called `` with the latest Subnet-EVM version, a chain ID of 1, TOKEN1 as the token name, and with default Subnet-EVM parameters (more information regarding Avalanche L1 creation can be found [here](/docs/tooling/avalanche-cli#create-your-avalanche-l1-configuration)): ```bash avalanche blockchain create --evm --latest\ --evm-chain-id 1 --evm-token TOKEN1 --evm-defaults creating genesis for configuring airdrop to stored key "subnet__airdrop" with address 0x0EF8151A3e6ad1d4e17C8ED4128b20EB5edc58B1 loading stored key "cli-teleporter-deployer" for teleporter deploys (evm address, genesis balance) = (0xE932784f56774879e03F3624fbeC6261154ec711, 600000000000000000000) using latest teleporter version (v1.0.0) ✓ Successfully created subnet configuration ``` Notice that by default, Teleporter is enabled and a stored key is created to fund Teleporter related operations (that is deploy Teleporter smart contracts, fund Teleporter Relayer). To disable Teleporter in your Avalanche L1, use the flag `--teleporter=false` when creating the Avalanche L1. To disable Relayer in your Avalanche L1, use the flag `--relayer=false` when creating the Avalanche L1. Now let's create a second Avalanche L1 called ``, with similar settings: ```bash avalanche blockchain create --evm --latest\ --evm-chain-id 2 --evm-token TOKEN2 --evm-defaults creating genesis for configuring airdrop to stored key "subnet__airdrop" with address 0x0EF815FFFF6ad1d4e17C8ED4128b20EB5edAABBB loading stored key "cli-teleporter-deployer" for teleporter deploys (evm address, genesis balance) = (0xE932784f56774879e03F3624fbeC6261154ec711, 600000000000000000000) using latest teleporter version (v1.0.0) ✓ Successfully created subnet configuration ``` Deploy the Avalanche L1s to Local Network[​](#deploy-the-avalanche-l1s-to-local-network "Direct link to heading") ----------------------------------------------------------------------------------------------------- Let's deploy ``: ```bash avalanche blockchain deploy --local Deploying [] to Local Network Backend controller started, pid: 149427, output at: ~/.avalanche-cli/runs/server_20240229_165923/avalanche-cli-backend.log Booting Network. Wait until healthy... Node logs directory: ~/.avalanche-cli/runs/network_20240229_165923/node/logs Network ready to use. Deploying Blockchain. Wait until network acknowledges... Teleporter Messenger successfully deployed to c-chain (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) Teleporter Registry successfully deployed to c-chain (0x17aB05351fC94a1a67Bf3f56DdbB941aE6c63E25) Teleporter Messenger successfully deployed to (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) Teleporter Registry successfully deployed to (0x9EDc4cB4E781413b1b82CC3A92a60131FC111F58) Using latest awm-relayer version (v1.1.0) Executing AWM-Relayer... Blockchain ready to use. Local network node endpoints: +-------+-----------+------------------------------------------------------------------------------------+--------------------------------------------+ | NODE | VM | URL | ALIAS URL | +-------+-----------+------------------------------------------------------------------------------------+--------------------------------------------+ | node1 | | http://127.0.0.1:9650/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9650/ext/bc//rpc | +-------+-----------+------------------------------------------------------------------------------------+--------------------------------------------+ | node2 | | http://127.0.0.1:9652/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9652/ext/bc//rpc | +-------+-----------+------------------------------------------------------------------------------------+--------------------------------------------+ | node3 | | http://127.0.0.1:9654/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9654/ext/bc//rpc | +-------+-----------+------------------------------------------------------------------------------------+--------------------------------------------+ | node4 | | http://127.0.0.1:9656/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9656/ext/bc//rpc | +-------+-----------+------------------------------------------------------------------------------------+--------------------------------------------+ | node5 | | http://127.0.0.1:9658/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9658/ext/bc//rpc | +-------+-----------+------------------------------------------------------------------------------------+--------------------------------------------+ Browser Extension connection details (any node URL from above works): RPC URL: http://127.0.0.1:9650/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc Funded address: 0x0EF8151A3e6ad1d4e17C8ED4128b20EB5edc58B1 with 1000000 (10^18) - private key: 16289399c9466912ffffffdc093c9b51124f0dc54ac7a766b2bc5ccf558d8eee Network name: Chain ID: 1 Currency Symbol: TOKEN1 ``` Notice some details here: - Two smart contracts are deployed to each Avalanche L1: Teleporter Messenger and Teleporter Registry - Both Teleporter smart contracts are also deployed to `C-Chain` in the Local Network - [AWM Teleporter Relayer](https://github.com/ava-labs/awm-relayer) is installed, configured and executed in background (A Relayer [listens](/docs/cross-chain/teleporter/overview#data-flow) for new messages being generated on a source Avalanche L1 and sends them to the destination Avalanche L1.) CLI configures the Relayer to enable every Avalanche L1 to send messages to all other Avalanche L1s. If you add more Avalanche L1s, the Relayer will be automatically reconfigured. When deploying Avalanche L1 ``, the two Teleporter contracts will not be deployed to C-Chain in Local Network as they have already been deployed when we deployed the first Avalanche L1. ```bash avalanche blockchain deploy --local Deploying [] to Local Network Deploying Blockchain. Wait until network acknowledges... Teleporter Messenger has already been deployed to c-chain Teleporter Messenger successfully deployed to (0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf) Teleporter Registry successfully deployed to (0x9EDc4cB4E781413b1b82CC3A92a60131FC111F58) Using latest awm-relayer version (v1.1.0) Executing AWM-Relayer... Blockchain ready to use. Local network node endpoints: +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | NODE | VM | URL | ALIAS URL | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node1 | | http://127.0.0.1:9650/ext/bc/2tVGwEQmeXtdnFURW1YSq5Yf4jbJPfTBfVcu68KWHdHe5e5gX5/rpc | http://127.0.0.1:9650/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node1 | | http://127.0.0.1:9650/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9650/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node2 | | http://127.0.0.1:9652/ext/bc/2tVGwEQmeXtdnFURW1YSq5Yf4jbJPfTBfVcu68KWHdHe5e5gX5/rpc | http://127.0.0.1:9652/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node2 | | http://127.0.0.1:9652/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9652/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node3 | | http://127.0.0.1:9654/ext/bc/2tVGwEQmeXtdnFURW1YSq5Yf4jbJPfTBfVcu68KWHdHe5e5gX5/rpc | http://127.0.0.1:9654/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node3 | | http://127.0.0.1:9654/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9654/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node4 | | http://127.0.0.1:9656/ext/bc/2tVGwEQmeXtdnFURW1YSq5Yf4jbJPfTBfVcu68KWHdHe5e5gX5/rpc | http://127.0.0.1:9656/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node4 | | http://127.0.0.1:9656/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9656/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node5 | | http://127.0.0.1:9658/ext/bc/MzN4AbtFzQ3eKqPhFaDpwCMJmagciWSCgghkZx6YeC6jRdvb6/rpc | http://127.0.0.1:9658/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ | node5 | | http://127.0.0.1:9658/ext/bc/2tVGwEQmeXtdnFURW1YSq5Yf4jbJPfTBfVcu68KWHdHe5e5gX5/rpc | http://127.0.0.1:9658/ext/bc//rpc | +-------+-----------+-------------------------------------------------------------------------------------+--------------------------------------------+ Browser Extension connection details (any node URL from above works): RPC URL: http://127.0.0.1:9650/ext/bc/2tVGwEQmeXtdnFURW1YSq5Yf4jbJPfTBfVcu68KWHdHe5e5gX5/rpc Funded address: 0x0EF815FFFF6ad1d4e17C8ED4128b20EB5edAABBB with 1000000 (10^18) - private key: 56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027 Network name: Chain ID: 2 Currency Symbol: TOKEN2 ``` Verify Teleporter Is Successfully Set Up[​](#verify-teleporter-is-successfully-set-up "Direct link to heading") --------------------------------------------------------------------------------------------------------------- To verify that Teleporter is successfully, let's send a couple of cross messages (from C-Chain to chain1): ```bash avalanche teleporter sendMsg C-Chain chain1 "Hello World" --local ``` Results: ```bash Delivering message "this is a message" to source subnet "C-Chain" Waiting for message to be received at destination subnet subnet "chain1" Message successfully Teleported! ``` To verify that Teleporter is successfully deployed, let's send a couple of cross-chain messages (from chain2 to chain1): ```bash avalanche teleporter sendMsg chain2 chain1 "Hello World" --local ``` Results: ```bash Delivering message "this is a message" to source subnet "chain2" Waiting for message to be received at destination subnet subnet "chain1" Message successfully Teleported! ``` You have Teleport-ed your first message in the Local Network! Relayer related logs can be found at `~/.avalanche-cli/runs/awm-relayer.log`, and Relayer configuration can be found at `~/.avalanche-cli/runs/awm-relayer-config.json` Obtaining Information on Teleporter Deploys[​](#obtaining-information-on-teleporter-deploys "Direct link to heading") --------------------------------------------------------------------------------------------------------------------- ### Obtaining Avalanche L1 Information[​](#obtaining-avalanche-l1-information "Direct link to heading") By executing `blockchain describe` on a Teleporter enabled Avalanche L1, the following relevant information can be found: - Blockchain RPC URL - Blockchain ID in cb58 format - Blockchain ID in plain hex format - Teleporter Messenger address - Teleporter Registry address Let's get the information for ``: ```bash avalanche blockchain describe _____ _ _ _ | __ \ | | (_) | | | | | ___| |_ __ _ _| |___ | | | |/ _ \ __/ _ | | / __| | |__| | __/ || (_| | | \__ \ |_____/ \___|\__\__,_|_|_|___/ +--------------------------------+-------------------------------------------------------------------------------------+ | PARAMETER | VALUE | +--------------------------------+-------------------------------------------------------------------------------------+ | Blockchain Name | chain1 | +--------------------------------+-------------------------------------------------------------------------------------+ | ChainID | 1 | +--------------------------------+-------------------------------------------------------------------------------------+ | Token Name | TOKEN1 Token | +--------------------------------+-------------------------------------------------------------------------------------+ | Token Symbol | TOKEN1 | +--------------------------------+-------------------------------------------------------------------------------------+ | VM Version | v0.6.3 | +--------------------------------+-------------------------------------------------------------------------------------+ | VM ID | srEXiWaHjFEgKSgK2zBgnWQUVEy2MZA7UUqjqmBSS7MZYSCQ5 | +--------------------------------+-------------------------------------------------------------------------------------+ | Local Network SubnetID | 2CZP2ndbQnZxTzGuZjPrJAm5b4s2K2Bcjh8NqWoymi8NZMLYQk | +--------------------------------+-------------------------------------------------------------------------------------+ | Local Network RPC URL | http://127.0.0.1:9650/ext/bc/2cFWSgGkmRrmKtbPkB8yTpnq9ykK3Dc2qmxphwYtiGXCvnSwg8/rpc | +--------------------------------+-------------------------------------------------------------------------------------+ | Local Network BlockchainID | 2cFWSgGkmRrmKtbPkB8yTpnq9ykK3Dc2qmxphwYtiGXCvnSwg8 | + +-------------------------------------------------------------------------------------+ | | 0xd3bc5f71e6946d17c488d320cd1f6f5337d9dce75b3fac5023433c4634b6e91e | +--------------------------------+-------------------------------------------------------------------------------------+ | Local Network ICM | 0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf | | Messenger Address | | +--------------------------------+-------------------------------------------------------------------------------------+ | Local Network ICM | 0xbD9e8eC38E43d34CAB4194881B9BF39d639D7Bd3 | | Registry Address | | +--------------------------------+-------------------------------------------------------------------------------------+ ... ``` ### Obtaining C-Chain Information[​](#obtaining-c-chain-information "Direct link to heading") Similar information can be found for C-Chain by using `primary describe`: ```bash avalanche primary describe --local _____ _____ _ _ _____ / ____| / ____| | (_) | __ \ | | ______| | | |__ __ _ _ _ __ | |__) |_ _ _ __ __ _ _ __ ___ ___ | | |______| | | '_ \ / _ | | '_ \ | ___/ _ | '__/ _ | '_ _ \/ __| | |____ | |____| | | | (_| | | | | | | | | (_| | | | (_| | | | | | \__ \ \_____| \_____|_| |_|\__,_|_|_| |_| |_| \__,_|_| \__,_|_| |_| |_|___/ +------------------------------+--------------------------------------------------------------------+ | PARAMETER | VALUE | +------------------------------+--------------------------------------------------------------------+ | RPC URL | http://127.0.0.1:9650/ext/bc/C/rpc | +------------------------------+--------------------------------------------------------------------+ | EVM Chain ID | 43112 | +------------------------------+--------------------------------------------------------------------+ | TOKEN SYMBOL | AVAX | +------------------------------+--------------------------------------------------------------------+ | Address | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | +------------------------------+--------------------------------------------------------------------+ | Balance | 49999489.829989485 | +------------------------------+--------------------------------------------------------------------+ | Private Key | 56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027 | +------------------------------+--------------------------------------------------------------------+ | BlockchainID | 2JeJDKL9Bvn1vLuuPL1DpUccBCVUh7iRnkv3a5pV9kJW5HbuQz | + +--------------------------------------------------------------------+ | | 0xabc1bd35cb7313c8a2b62980172e6d7ef42aaa532c870499a148858b0b6a34fd | +------------------------------+--------------------------------------------------------------------+ | ICM Messenger Address | 0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf | +------------------------------+--------------------------------------------------------------------+ | ICM Registry Address | 0x17aB05351fC94a1a67Bf3f56DdbB941aE6c63E25 | +------------------------------+--------------------------------------------------------------------+ ``` Controlling Relayer Execution[​](#controlling-relayer-execution "Direct link to heading") ----------------------------------------------------------------------------------------- Besides having the option to not use a Relayer at Avalanche L1 creation time, the Relayer can be stopped and restarted on used request. To stop the Relayer: ```bash avalanche interchain relayer stop --local ✓ Local AWM Relayer successfully stopped ``` To start it again: ```bash avalanche interchain relayer start --local using latest awm-relayer version (v1.1.0) Executing AWM-Relayer... ✓ Local AWM Relayer successfully started Logs can be found at ~/.avalanche-cli/runs/awm-relayer.log ``` # Teleporter Token Bridge (/docs/tooling/avalanche-cli/cross-chain/teleporter-token-bridge) --- title: Teleporter Token Bridge description: Deploy an example Teleporter Token Bridge on the local network. --- Teleporter Token Bridge enables users to transfer tokens between Avalanche L1s. The bridge is a set of smart contracts that are deployed across multiple Avalanche L1s, and leverages Teleporter for cross-chain communication. For more information on Teleporter Token Bridge, check: - [Teleporter Token Bridge README](https://github.com/ava-labs/teleporter-token-bridge) ## How to Deploy Teleporter Token Bridge on a Local Network This how-to guide focuses on deploying Teleporter Token Bridge on a local Avalanche network. After this tutorial, you would have learned how to transfer an ERC-20 token between two Teleporter-enabled Avalanche L1s and between C-Chain and a Teleporter-enabled Avalanche L1. ## Prerequisites For our example, you will first need to create and deploy a Teleporter-enabled Avalanche L1 in Local Network. We will name our Avalanche L1 `testblockchain`. - To create a Teleporter-enabled Avalanche L1 configuration, [visit here](/docs/tooling/avalanche-cli/cross-chain/teleporter-local-network#create-subnet-configurations) - To deploy a Teleporter-enabled Avalanche L1, [visit here](/docs/tooling/avalanche-cli/cross-chain/teleporter-local-network#deploy-the-subnets-to-local-network) ## Deploy ERC-20 Token in C-Chain First, let's create an ERC-20 Token and deploy it to C-Chain. For our example, it will be called TOK. Sample script to deploy the ERC-20 Token can be found [here](https://github.com/ava-labs/avalanche-cli/blob/main/cmd/contractcmd/deploy_erc20.go). To deploy the ERC-20 Token to C-Chain, we will call: ```bash avalanche contract deploy erc20 ``` When the command is run, our EWOQ address `0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC` would have received 100000 TOK tokens in C-Chain. Note that `0x5DB9A7629912EBF95876228C24A848de0bfB43A9` is our ERC-20 Token address, which we will use in our next command. ## Deploy Teleporter Token Bridge Next, we will now deploy Teleporter Token Bridge to our Local Network, where we will deploy the Home Contract to C-Chain and the Remote Contract to our Avalanche L1. ```bash avalanche teleporter bridge deploy ✔ Local Network ✔ C-Chain ✔ Deploy a new Home for the token ✔ An ERC-20 token Enter the address of the ERC-20 Token: 0x5DB9A7629912EBF95876228C24A848de0bfB43A9 ✔ Subnet testblockchain Downloading Bridge Contracts Compiling Bridge Home Deployed to http://127.0.0.1:9650/ext/bc/C/rpc Home Address: 0x4Ac1d98D9cEF99EC6546dEd4Bd550b0b287aaD6D Remote Deployed to http://127.0.0.1:9650/ext/bc/2TnSWd7odhkDWKYFDZHqU7CvtY8G6m46gWxUnhJRNYu4bznrrc/rpc Remote Address: 0x7DD1190e6F6CE8eE13C08F007FdAEE2f881B45D0 ``` Before we transfer our ERC-20 token from C-Chain to our Avalanche L1, we will first call `avalanche key list` command to check our initial balances in C-Chain and Avalanche L1. We will inquire the balances of our ERC-20 Token TOK both in C-Chain and our Avalanche L1, which has the address of `0x5DB9A7629912EBF95876228C24A848de0bfB43A9` in the C-Chain and address of `0x7DD1190e6F6CE8eE13C08F007FdAEE2f881B45D0` in our Avalanche L1 `testblockchain`. ```bash `avalanche key list --local --keys ewoq,blockchain_airdrop --subnets c,testblockchain --tokens 0x5DB9A7629912EBF95876228C24A848de0bfB43A9,0x7DD1190e6F6CE8eE13C08F007FdAEE2f881B45D0` +--------+--------------------+------------+--------------------------------------------+---------------+-----------------+---------------+ | KIND | NAME | SUBNET | ADDRESS | TOKEN | BALANCE | NETWORK | +--------+--------------------+---------+--------------------------------------------+---------------+-----------------+---------------+ | stored | ewoq | testblockchain | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | TOK (0x7DD1.) | 0 | Local Network | + + +---------+--------------------------------------------+---------------+-----------------+---------------+ | | | C-Chain | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | TOK (0x5DB9.) | 100000.000000000| Local Network | + +--------------------+---------+--------------------------------------------+---------------+-----------------+---------------+ | | blockchain | testblockchain | 0x5a4601D594Aa3848cA5EE0770b7883d3DBC666f6 | TOK (0x7DD1.) | 0 | Local Network | + + _airdrop +---------+--------------------------------------------+---------------+-----------------+---------------+ | | | C-Chain | 0x5a4601D594Aa3848cA5EE0770b7883d3DBC666f6 | TOK (0x5DB9.) | 0 | Local Network | +--------+--------------------+------------+--------------------------------------------+---------------+-----------------+---------------+ ``` ## Transfer the Token from C-Chain to Our Avalanche L1 Now we will transfer 100 TOK tokens from our `ewoq` address in C-Chain to blockchain_airdrop address in our Avalanche L1 `testblockchain`. Note that we will be using the Home contract address `0x4Ac1d98D9cEF99EC6546dEd4Bd550b0b287aaD6D` and Remote contract address `0x7DD1190e6F6CE8eE13C08F007FdAEE2f881B45D0`. ```bash avalanche key transfer ✔ Local Network ✔ C-Chain ✔ Subnet testblockchain Enter the address of the Bridge on c-chain: 0x4Ac1d98D9cEF99EC6546dEd4Bd550b0b287aaD6D Enter the address of the Bridge on testblockchain: 0x7DD1190e6F6CE8eE13C08F007FdAEE2f881B45D0 ✔ ewoq ✔ Key ✔ blockchain_airdrop Amount to send (TOKEN units): 100 ``` ## Verify That Transfer Is Successful We will call `avalanche key list` command again to verify that the transfer is successful. `blockchain_airdrop` should now have 100 TOK tokens in our Avalanche L1 `testblockchain` and our EWOQ account now has 99900 TOK tokens in C-Chain. ```bash avalanche key list --local --keys ewoq,blockchain_airdrop --subnets c,testblockchain --tokens 0x5DB9A7629912EBF95876228C24A848de0bfB43A9,0x7DD1190e6F6CE8eE13C08F007FdAEE2f881B45D0 +--------+--------------------+------------+--------------------------------------------+---------------+-----------------+---------------+ | KIND | NAME | SUBNET | ADDRESS | TOKEN | BALANCE | NETWORK | +--------+--------------------+---------+--------------------------------------------+---------------+-----------------+---------------+ | stored | ewoq | testblockchain | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | TOK (0x7DD1.) | 0 | Local Network | + + +---------+--------------------------------------------+---------------+-----------------+---------------+ | | | C-Chain | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | TOK (0x5DB9.) | 99900.000000000 | Local Network | + +--------------------+---------+--------------------------------------------+---------------+-----------------+---------------+ | | blockchain | testblockchain | 0x5a4601D594Aa3848cA5EE0770b7883d3DBC666f6 | TOK (0x7DD1.) | 100.000000000 | Local Network | + + _airdrop +---------+--------------------------------------------+---------------+-----------------+---------------+ | | | C-Chain | 0x5a4601D594Aa3848cA5EE0770b7883d3DBC666f6 | TOK (0x5DB9.) | 0 | Local Network | +--------+--------------------+------------+--------------------------------------------+---------------+-----------------+---------------+ ``` And that's it! You have now successfully completed your first transfer from C-Chain to Avalanche L1 using Teleporter Token Bridge! # Import an Avalanche L1 (/docs/tooling/avalanche-cli/guides/import-avalanche-l1) --- title: Import an Avalanche L1 description: Learn how to import an Avalanche-l1 into Avalanche-CLI. --- Context[​](#context "Direct link to heading") --------------------------------------------- In previous instances, Avalanche L1s might have been manually created through transaction issuance to node APIs, whether it was done using a local node or public API nodes. However, the current focus is on integrating Avalanche-CLI. To achieve this integration, this guide demonstrates the process of importing an Avalanche L1 to the Avalanche-CLI to enable better management of the Avalanche L1's configuration. This how-to uses the BEAM Avalanche L1 deployed on Fuji Testnet as the example Avalanche L1. Requirements[​](#requirements "Direct link to heading") ------------------------------------------------------- For the import to work properly, you need: - The Avalanche L1's genesis file, stored on disk - The Avalanche L1's SubnetID Import the Avalanche L1[​](#import-the-avalanche-l1 "Direct link to heading") ----------------------------------------------------------------- For these use cases, Avalanche-CLI now supports the `import public` command. Start the import by issuing ``` avalanche blockchain import public ``` The tool prompts for the network from which to import. The invariant assumption here is that the network is a public network, either the Fuji testnet or Mainnet. In other words, importing from a local network isn't supported. ``` Use the arrow keys to navigate: ↓ ↑ → ← ? Choose a network to import from: ▸ Fuji Mainnet ``` As stated earlier, this is from Fuji, so select it. As a next step, Avalanche-CLI asks for the path of the genesis file on disk: ``` ✗ Provide the path to the genesis file: /tmp/subnet_evm.genesis.json ``` The wizard checks if the file at the provided path exists, refer to the checkmark at the beginning of the line: ``` ✔ Provide the path to the genesis file: /tmp/subnetevm_genesis.json ``` Subsequently, the wizard asks if nodes have already been deployed for this Avalanche L1. ``` Use the arrow keys to navigate: ↓ ↑ → ← ? Have nodes already been deployed to this subnet?: Yes ▸ No ``` ### Nodes are Already Validating This Avalanche L1[​](#nodes-are-already-validating-this-avalanche-l1 "Direct link to heading") If nodes already have been deployed, the wizard attempts to query such a node for detailed data like the VM version. This allows the tool to skip querying GitHub (or wherever the VM's repository is hosted) for the VM's version, but rather we'll get the exact version which is actually running on the node. For this to work, a node API URL is requested from the user, which is used for the query. This requires that the node's API IP and port are accessible from the machine running Avalanche-CLI, or the node is obviously not reachable, and thus the query times out and fails, and the tool exits. The node should also be validating the given Avalanche L1 for the import to be meaningful, otherwise, the import fails with missing information. If the query succeeded, the wizard jumps to prompt for the Avalanche L1 ID (SubnetID). ``` Please provide an API URL of such a node so we can query its VM version (e.g. http://111.22.33.44:5555): http://154.42.240.119:9650 What is the ID of the subnet?: ie1wUBR2bQDPkGCRf2CBVzmP55eSiyJsFYqeGXnTYt2r33aKW ``` The rest of the wizard is identical to the next section, except that there is no prompt for the VM version anymore. ### Nodes Aren't Yet Validating this Avalanche L1, the Nodes API URL are Unknown, or Inaccessible (Firewalls)[​](#nodes-arent-yet-validating-this-avalanche-l1-the-nodes-api-url-are-unknown-or-inaccessible-firewalls "Direct link to heading") If you don't have a node's API URL at hand, or it's not reachable from the machine running Avalanche-CLI, or maybe no nodes have even been deployed yet because only the `CreateSubnet` transaction has been issued, for example, you can query the public APIs. You can't know for sure what Avalanche L1 VM versions the validators are running though, therefore the tool has to prompt later. So, select `No` when the tool asks for deployed nodes: Thus, at this point the wizard requests the Avalanche L1's ID, without which it can't know what to import. Remember the ID is different on different networks. From the [Testnet Avalanche L1 Explorer](https://subnets-test.avax.network/beam) you can see that BEAM's Avalanche L1 ID (SubnetID) is `ie1wUBR2bQDPkGCRf2CBVzmP55eSiyJsFYqeGXnTYt2r33aKW`: ``` ✔ What is the ID of the subnet?: ie1wUBR2bQDPkGCRf2CBVzmP55eSiyJsFYqeGXnTYt2r33aKW ``` Notice the checkmark at line start, it signals that there is ID format validation. If you hit `enter` now, the tool queries the public APIs for the given network, and if successful, it prints some information about the Avalanche L1, and proceeds to ask about the Avalanche L1's type: ``` Getting information from the Fuji network... Retrieved information. BlockchainID: y97omoP2cSyEVfdSztQHXD9EnfnVP9YKjZwAxhUfGbLAPYT9t, Name: BEAM, VMID: kLPs8zGsTVZ28DhP1VefPCFbCgS7o5bDNez8JUxPVw9E6Ubbz Use the arrow keys to navigate: ↓ ↑ → ← ? What's this VM's type?: ▸ Subnet-EVM Custom ``` Avalanche-CLI needs to know the VM type, to hit its repository and select what VM versions are available. This works automatically for Ava Labs VMs (like Subnet-EVM). Custom VMs aren't supported yet at this point, but are next on the agenda. As the import is for BEAM, and you know that it's a Subnet-EVM type, select that. The tool then queries the (GitHub) repository for available releases, and prompts the user to pick the version she wants to use: ``` ✔ Subnet-EVM Use the arrow keys to navigate: ↓ ↑ → ← ? Pick the version for this VM: ▸ v0.4.5 v0.4.5-rc.1 v0.4.4 v0.4.4-rc.0 ↓ v0.4.3 ``` There is only so much the tool can help here, the Avalanche L1 manager/administrator should know what they want to use Avalanche-CLI for, how, and why they're importing the Avalanche L1. It's crucial to understand that the correct versions are only known to the user. The latest might be usually fine, but the tool can't make assumptions about it easily. This is why it's indispensable that the wizard prompts the user, and the tool requires her to choose. If you selected to query an actual Avalanche L1 validator, not the public APIs, in the preceding step. In such a scenario, the tool skips this picking. ``` ✔ v0.4.5 Subnet BEAM imported successfully ``` The choice finalizes the wizard, which hopefully signals that the import succeeded. If something went wrong, the error messages provide cause information. This means you can now use Avalanche-CLI to handle the imported Avalanche L1 in the accustomed way. For example, you could deploy the BEAM Avalanche L1 locally. For a complete description of options, flags, and the command, visit the [command reference](/docs/tooling/cli-commands#avalanche-l1-import). # Run with Docker (/docs/tooling/avalanche-cli/guides/run-with-docker) --- title: Run with Docker description: Instructions for running Avalanche-CLI in a Docker container. --- To run Avalanche-CLI in a docker container, you need to enable ipv6. Edit `/etc/docker/daemon.json`. Add this snippet then restart the docker service. ```json { "ipv6": true, "fixed-cidr-v6": "fd00::/80" } ``` # Add Validator (/docs/tooling/avalanche-cli/maintain/add-validator-l1) --- title: Add Validator description: Learn how to add a validator to an Avalanche L1. --- ### Add a Validator to an Avalanche L1 ```bash avalanche blockchain addValidator ``` #### Choose Network Choose the network where the operation will be ```bash ? Choose a network for the operation: ▸ Local Network Devnet Fuji Testnet Mainnet ``` #### Choose P-Chain Fee Payer Choose the key that will be used to pay for the transaction fees on the P-Chain. ```bash ? Which key should be used to pay for transaction fees on P-Chain?: ▸ Use stored key Use ledger ``` #### Enter Node ID Enter the NodeID of the node you want to add as a blockchain validator. ```bash ✗ What is the NodeID of the node you want to add as a blockchain validator?: ``` You can find the NodeID in the node's configuration file or the console when first started with avalanchego. An example of a NodeID is `NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg` #### Enter the BLS Public Key Enter the public key of the node's BLS ```bash Next, we need the public key and proof of possession of the node's BLS Check https://build.avax.network/docs/rpcs/other/info-rpc#infogetnodeid for instructions on calling info.getNodeID API ✗ What is the node's BLS public key?: ``` You can find the BLS public key in the node's configuration file or the console when first started with avalanchego. #### Enter BLS Proof of Possession Enter the proof of possession of the node's BLS ```bash ✗ What is the node's BLS proof of possession?: ``` You can find the BLS proof of possession in the node's configuration file or the console when first started with avalanchego. #### Enter AVAX Balance This balance will be used to pay the P-Chain continuous staking fee. ```bash ✗ What balance would you like to assign to the validator (in AVAX)?: ``` #### Enter Leftover AVAX Address This address will receive any leftover AVAX when the node is removed from the validator set. ```bash ? Which key would you like to set as change owner for leftover AVAX if the node is removed from validator set?: ▸ Get address from an existing stored key (created from avalanche key create or avalanche key import) Custom ``` #### Enter Disable Validator Address This address will be able to disable the validator using P-Chain transactions. ```bash Which address do you want to be able to disable the validator using P-Chain transactions?: ▸ Get address from an existing stored key (created from avalanche key create or avalanche key import) Custom ``` ### Proof of Stake specific parameters If your network was created with Proof of Stake validator manager, you will be asked for the following additional parameters. You can also pass these parameters as flags to the command. ```bash --delegation-fee uint16 delegation fee (in bips) --stake-amount uint amount of native tokens to stake --staking-period duration how long this validator will be staking ``` # Delete an Avalanche L1 (/docs/tooling/avalanche-cli/maintain/delete-avalanche-l1) --- title: Delete an Avalanche L1 description: Learn how to delete an Avalanche L1. --- Deleting an Avalanche L1 Configuration[​](#deleting-a-avalanche-l1-configuration "Direct link to heading") --------------------------------------------------------------------------------------------- To delete a created Avalanche L1 configuration, run: ```bash avalanche blockchain delete ``` Deleting a Deployed Avalanche L1[​](#deleting-a-deployed-avalanche-l1 "Direct link to heading") ----------------------------------------------------------------------------------- You can't delete Avalanche L1s deployed to Mainnet or the Fuji Testnet. However, you may delete Avalanche L1s deployed to a local network by cleaning the network state with below command: ```bash avalanche network clean ``` # Remove Validator (/docs/tooling/avalanche-cli/maintain/remove-validator-l1) --- title: Remove Validator description: Learn how to remove a validator from an Avalanche L1. --- ### Remove a Validator from an Avalanche L1 ```bash avalanche blockchain removeValidator ``` #### Choose the Network Choose the network where the validator is registered. ```bash ? Choose a network for the operation: ▸ Local Network Devnet Fuji Testnet Mainnet ``` #### Choose P-Chain fee payer Choose the key to pay for the transaction fees on the P-Chain. ```bash ? Which key should be used to pay for transaction fees on P-Chain?: ▸ Use stored key Use ledger ``` #### Enter Node-ID of the Validator to Remove Enter the Node-ID of the validator you want to remove. ```bash ✗ What is the NodeID of the node you want to remove as a blockchain validator?: ``` You can find the NodeID in the node's configuration file or the console when first started with avalanchego. An example of a NodeID is `NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg` #### Confirm the removal ```bash Validator manager owner 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC pays for the initialization of the validator's removal (Blockchain gas token) RPC Endpoint: http://127.0.0.1:9652/ext/bc/2qmU6w47Mp7D7fGhbRuZm6Z1Nn6FZXZAxKpaeTMFiRQW9CBErh/rpc Forcing removal of NodeID-7cQrriPWGXa5yuJGZUgsxxwH9j4T8pPkY as it is a PoS bootstrap validator Using validationID: 228zzCgDmAmuaJDGnFkFgnVqbbJPRF7qF1Xpd3dhtqGDhMjJK2 for nodeID: NodeID-7cQrriPWGXa5yuJGZUgsxxwH9j4T8pPkY ValidationID: 228zzCgDmAmuaJDGnFkFgnVqbbJPRF7qF1Xpd3dhtqGDhMjJK2 SetSubnetValidatorWeightTX fee: 0.000078836 AVAX SetSubnetValidatorWeightTx ID: 2FUimPZ37DscPJiQDLrtKtumER3LNr48MJi6VR2jGXkYEKpCaq ✓ Validator successfully removed from the Subnet ``` ### Proof of Authority Networks If the network is a Proof of Authority network, the validator must be removed from the network by the Validator Manager owner. ### Proof of Stake Networks If the network is a Proof of Stake network, the validator must be removed by the initial staker. Rewards will be distributed to the validator after the removal. It is important to note that the initial PoS Validator set are treated as bootstrap validators and are not elgible for rewards. # Troubleshooting (/docs/tooling/avalanche-cli/maintain/troubleshooting) --- title: Troubleshooting description: If you run into trouble deploying your Avalanche L1, use this document for tips to resolve common issues. --- Deployment Times Out[​](#deployment-times-out "Direct link to heading") ----------------------------------------------------------------------- During a local deployment, your network may fail to start. Your error may look something like this: ```bash [~]$ avalanche blockchain deploy myblockchain ✔ Local Network Deploying [myblockchain] to Local Network Backend controller started, pid: 26388, output at: /Users/user/.avalanche-cli/runs/server_20221231_111605/avalanche-cli-backend VMs ready. Starting network... .................................................................................. .................................................................................. ......Error: failed to query network health: rpc error: code = DeadlineExceeded desc = context deadline exceeded ``` Avalanche-CLI only supports running one local Avalanche network at a time. If other instances of AvalancheGo are running concurrently, your Avalanche-CLI network fails to start. To test for this error, start by shutting down any Avalanche nodes started by Avalanche-CLI. ```bash avalanche network clean --hard ``` Next, look for any lingering AvalancheGo processes with: ```bash ps aux | grep avalanchego ``` If any processes are running, you need to stop them before you can launch your VM with Avalanche-CLI. If you're running a validator node on the same box you're using Avalanche-CLI, **don't** end any of these lingering AvalancheGo processes. This may shut down your validator and could affect your validation uptime. Incompatible RPC Version for Custom VM[​](#incompatible-rpc-version-for-custom-vm "Direct link to heading") ----------------------------------------------------------------------------------------------------------- If you're locally deploying a custom VM, you may run into this error message. ```bash [~]$ avalanche blockchain deploy myblockchain ✔ Local Network Deploying [myblockchain] to Local Network Backend controller started, pid: 26388, output at: /Users/user/.avalanche-cli/runs/server_20221231_111605/avalanche-cli-backend VMs ready. Starting network... ......... Blockchain has been deployed. Wait until network acknowledges... .................................................................................. .................................................................................. ......Error: failed to query network health: rpc error: code = DeadlineExceeded desc = context deadline exceeded ``` This error has many possible causes, but a common cause is usually due to **an RPC protocol version mismatch.** AvalancheGo communicates with custom VMs over RPC using [gRPC](https://grpc.io/). gRPC defines a protocol specification shared by both AvalancheGo and the VM. **Both components must be running the same RPC version for VM deployment to work.** Your custom VM's RPC version is set by the version of AvalancheGo that you import. By default, Avalanche-CLI creates local Avalalanche networks that run the latest AvalancheGo release. ### Example[​](#example "Direct link to heading") Here's an example with real numbers from the AvalancheGo compatibility page: - If the latest AvalancheGo release is version v1.10.11, then Avalanche-CLI deploys a network with RPC version 28. - For your deploy to be successful, your VM must also have RPC version 28. Because only AvalancheGo versions v1.10.9, v1.10.10 and v1.10.11 supports RPC version 28, your VM **must** import one of those versions. ### Solution[​](#solution "Direct link to heading") Error: `RPCChainVM protocol version mismatch between AvalancheGo and Virtual Machine plugin` This error occurs when the RPCChainVM protocol version used by VMs like Subnet-EVM are incompatible with the protocol version of AvalancheGo. If your VM has an RPC version mismatch, you have two options: 1. Update the version of AvalancheGo you use in your VM. This is the correct long-term approach. 2. Use Avalanche-CLI to deploy an older version of AvalancheGo by using the `--avalanchego-version` flag. Both the [`blockchain deploy`](/docs/tooling/cli-commands#deploy) and [`network start`](/docs/tooling/cli-commands#start) commands support setting the AvalancheGo version explicitly. Although it's very important to keep your version of AvalancheGo up-to-date, this workaround helps you avoid broken builds in the short term. You must upgrade to the latest AvalancheGo version when deploying publicly to Fuji Testnet or Avalanche Mainnet. ### More Information[​](#more-information "Direct link to heading") Similar version matching is required in different tools on the ecosystem. Here is a compatibility table showing which RPCChainVM Version implements the more recent releases of AvalancheGo, Subnet-EVM, Precompile-EVM and HyperSDK. |RPCChainVM|AvalancheGo |Subnet-EVM |Precompile-EVM |HyperSDK | |----------|------------------|---------------|---------------|----------------| |26 |v1.10.1-v1.10.4 |v0.5.1-v0.5.2 |v0.1.0-v0.1.1 |v0.0.6-v0.0.9 | |27 |v1.10.5-v1.10.8 |v0.5.3 |v0.1.2 |v0.0.10-v0.0.12 | |28 |v1.10.9-v1.10.12 |v0.5.4-v0.5.6 |v0.1.3-v0.1.4 |v0.0.13-v0.0.15 | |30 |v1.10.15-v1.10.17 |v0.5.9-v0.5.10 |v0.1.6-v0.1.7 |- | |29 |v1.10.13-v1.10.14 |v0.5.7-v0.5.8 |v0.1.5 |- | |31 |v1.10.18- v1.10.19|v0.5.11 |v0.1.8 |v0.0.16 (latest)| |33 |v1.11.0 |v0.6.0-v0.6.1 |v0.2.0 |- | |34 |v1.11.1- v1.11.2 |v0.6.2 |- |- | |35 |v1.11.3 (latest) |v0.6.3 (latest)|v0.2.1 (latest)|- | You can view the full RPC compatibility broken down by release version for each tool here: [AvalancheGo](https://github.com/ava-labs/avalanchego/blob/master/version/compatibility.json). [Subnet-EVM](https://github.com/ava-labs/subnet-evm/blob/master/compatibility.json). [Precompile-EVM](https://github.com/ava-labs/precompile-evm/blob/main/compatibility.json). Updates to AvalancheGo's RPC version are **not** tied to its semantic version scheme. Minor AvalancheGo version bumps may include a breaking RPC version bump. Fix for MacBook Air M1/M2: ‘Bad CPU type in executable' Error[​](#fix-for-macbook-air-m1m2-bad-cpu-type-in-executable-error "Direct link to heading") ----------------------------------------------------------------------------------------------------------------------------------------------------- When running `avalanche blockchain deploy` via the Avalanche-CLI, the terminal may throw an error that contains the following: ```bash zsh: bad CPU type in executable: /Users/user.name/Downloads/build/avalanchego ``` This is because some Macs lack support for x86 binaries. Running the following command should fix this issue: ```bash /usr/sbin/softwareupdate --install-rosetta ``` # View Avalanche L1s (/docs/tooling/avalanche-cli/maintain/view-avalanche-l1s) --- title: View Avalanche L1s description: CLI commands for viewing avalanche-l1s. --- ## List Avalanche L1 Configurations You can list the Avalanche L1s you've created with: `avalanche blockchain list` Example: ```bash > avalanche blockchain list +--------------+--------------+----------+---------------------------------------------------+------------+------------+-----------+ | SUBNET | CHAIN | CHAINID | VMID | TYPE | VM VERSION | FROM REPO | +--------------+--------------+----------+---------------------------------------------------+------------+------------+-----------+ | myblockchain | myblockchain | 111 | qDNV9vtxZYYNqm7TN1mYBuaaknLdefDbFK8bFmMLTJQJKaWjV | Subnet-EVM | v0.7.0 | false | +--------------+--------------+----------+---------------------------------------------------+------------+------------+-----------+ ``` To see detailed information about your deployed Avalanche L1s, add the `--deployed` flag: ```bash > avalanche blockchain list --deployed +--------------+--------------+---------------------------------------------------+---------------+----------------+---------+ | SUBNET | CHAIN | VM ID | LOCAL NETWORK | FUJI (TESTNET) | MAINNET | +--------------+--------------+---------------------------------------------------+---------------+----------------+---------+ | myblockchain | myblockchain | qDNV9vtxZYYNqm7TN1mYBuaaknLdefDbFK8bFmMLTJQJKaWjV | Yes | No | No | +--------------+--------------+---------------------------------------------------+---------------+----------------+---------+ ```bash ## Describe Avalanche L1 Configurations To see the details of a specific configuration, run: `avalanche blockchain describe ` Example: ```bash > avalanche blockchain describe myblockchain +---------------------------------------------------------------------------------------------------------------------------------+ | MYBLOCKCHAIN | +---------------+-----------------------------------------------------------------------------------------------------------------+ | Name | myblockchain | +---------------+-----------------------------------------------------------------------------------------------------------------+ | VM ID | qDNV9vtxZYYNqm7TN1mYBuaaknLdefDbFK8bFmMLTJQJKaWjV | +---------------+-----------------------------------------------------------------------------------------------------------------+ | VM Version | v0.7.0 | +---------------+-----------------------------------------------------------------------------------------------------------------+ | Validation | Proof Of Authority | +---------------+--------------------------+--------------------------------------------------------------------------------------+ | Local Network | ChainID | 12345 | | +--------------------------+--------------------------------------------------------------------------------------+ | | SubnetID | fvx83jt2BWyibBRL4SRMa6WzjWp7GSFUeUUeoeBe1AqJ5Ey5w | | +--------------------------+--------------------------------------------------------------------------------------+ | | BlockchainID (CB58) | 2QGB9GbEhsFJLSRVii2mKs8dxugHzmK98G5391P2bvXSCb4sED | | +--------------------------+--------------------------------------------------------------------------------------+ | | BlockchainID (HEX) | 0xb883b54815c84a3f0903dbccd289ed5563395dd61c189db626e2d2680546b990 | | +--------------------------+--------------------------------------------------------------------------------------+ | | RPC Endpoint | http://127.0.0.1:60538/ext/bc/2QGB9GbEhsFJLSRVii2mKs8dxugHzmK98G5391P2bvXSCb4sED/rpc | +---------------+--------------------------+--------------------------------------------------------------------------------------+ +------------------------------------------------------------------------------------+ | ICM | +---------------+-----------------------+--------------------------------------------+ | Local Network | ICM Messenger Address | 0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf | | +-----------------------+--------------------------------------------+ | | ICM Registry Address | 0x695Ea5FbeBBdc99cA679F5fD7768f179d2281d74 | +---------------+-----------------------+--------------------------------------------+ +-------------------------------+ | TOKEN | +--------------+----------------+ | Token Name | TUTORIAL Token | +--------------+----------------+ | Token Symbol | TUTORIAL | +--------------+----------------+ +----------------------------------------------------------------------------------------------------------------------------------------+ | INITIAL TOKEN ALLOCATION | +-------------------------+------------------------------------------------------------------+---------------+---------------------------+ | DESCRIPTION | ADDRESS AND PRIVATE KEY | AMOUNT (OWEN) | AMOUNT (WEI) | +-------------------------+------------------------------------------------------------------+---------------+---------------------------+ | Main funded account | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | 1000000 | 1000000000000000000000000 | | ewoq | 56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027 | | | +-------------------------+------------------------------------------------------------------+---------------+---------------------------+ | Used by ICM | 0x001CBe3650FAD190d9ccBd57b289124F5131AA57 | 600 | 600000000000000000000 | | cli-teleporter-deployer | d00b93e1526d05a30b681911a3e0f5e5528add205880c1cafa4f84cdb2746b00 | | | +-------------------------+------------------------------------------------------------------+---------------+---------------------------+ +-----------------------------------------------------------------------------------------------------------------+ | SMART CONTRACTS | +-----------------------+--------------------------------------------+--------------------------------------------+ | DESCRIPTION | ADDRESS | DEPLOYER | +-----------------------+--------------------------------------------+--------------------------------------------+ | Proxy Admin | 0xC0fFEE1234567890aBCdeF1234567890abcDef34 | 0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC | +-----------------------+--------------------------------------------+--------------------------------------------+ | PoA Validator Manager | 0x0C0DEbA5E0000000000000000000000000000000 | | +-----------------------+--------------------------------------------+--------------------------------------------+ | Transparent Proxy | 0x0Feedc0de0000000000000000000000000000000 | | +-----------------------+--------------------------------------------+--------------------------------------------+ +----------------------------------------------------------------------+ | INITIAL PRECOMPILE CONFIGS | +------------+-----------------+-------------------+-------------------+ | PRECOMPILE | ADMIN ADDRESSES | MANAGER ADDRESSES | ENABLED ADDRESSES | +------------+-----------------+-------------------+-------------------+ | Warp | n/a | n/a | n/a | +------------+-----------------+-------------------+-------------------+ +--------------------------------------------------------------------------+ | NODES | +-------+------------------------------------------+-----------------------+ | NAME | NODE ID | LOCALHOST ENDPOINT | +-------+------------------------------------------+-----------------------+ | node1 | NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg | http://127.0.0.1:9650 | +-------+------------------------------------------+-----------------------+ | node2 | NodeID-MFrZFVCXPv5iCn6M9K6XduxGTYp891xXZ | http://127.0.0.1:9652 | +-------+------------------------------------------+-----------------------+ +--------------------------------------------------------------------------------------------------------+ | WALLET CONNECTION | +-----------------+--------------------------------------------------------------------------------------+ | Network RPC URL | http://127.0.0.1:60538/ext/bc/2QGB9GbEhsFJLSRVii2mKs8dxugHzmK98G5391P2bvXSCb4sED/rpc | +-----------------+--------------------------------------------------------------------------------------+ | Network Name | myblockchain | +-----------------+--------------------------------------------------------------------------------------+ | Chain ID | 12345 | +-----------------+--------------------------------------------------------------------------------------+ | Token Symbol | TUTORIAL | +-----------------+--------------------------------------------------------------------------------------+ | Token Name | TUTORIAL Token | +-----------------+--------------------------------------------------------------------------------------+ ``` ## Viewing a Genesis File If you'd like to see the raw genesis file, supply the `--genesis` flag to the describe command: `avalanche blockchain describe --genesis` Example: ```bash > avalanche blockchain describe myblockchain --genesis { "config": { "berlinBlock": 0, "byzantiumBlock": 0, "chainId": 111, "constantinopleBlock": 0, "eip150Block": 0, "eip155Block": 0, "eip158Block": 0, "feeConfig": { "gasLimit": 12000000, "targetBlockRate": 2, "minBaseFee": 25000000000, "targetGas": 60000000, "baseFeeChangeDenominator": 36, "minBlockGasCost": 0, "maxBlockGasCost": 1000000, "blockGasCostStep": 200000 }, "homesteadBlock": 0, "istanbulBlock": 0, "londonBlock": 0, "muirGlacierBlock": 0, "petersburgBlock": 0, "warpConfig": { "blockTimestamp": 1734549536, "quorumNumerator": 67, "requirePrimaryNetworkSigners": true } }, "nonce": "0x0", "timestamp": "0x67632020", "extraData": "0x", "gasLimit": "0xb71b00", "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "alloc": { "001cbe3650fad190d9ccbd57b289124f5131aa57": { "balance": "0x2086ac351052600000" }, "0c0deba5e0000000000000000000000000000000": { "code": "", "balance": "0x0", "nonce": "0x1" }, "0feedc0de0000000000000000000000000000000": { "code": "", "storage": { "0x360894a13ba1a3210667c828492db98dca3e2076cc3735a920a3ca505d382bbc": "0x0000000000000000000000000c0deba5e0000000000000000000000000000000", //sslot for proxy implementation "0xb53127684a568b3173ae13b9f8a6016e243e63b6e8ee1178d6a717850b5d6103": "0x000000000000000000000000c0ffee1234567890abcdef1234567890abcdef34" //sslot for proxy admin }, "balance": "0x0", "nonce": "0x1" }, "8db97c7cece249c2b98bdc0226cc4c2a57bf52fc": { "balance": "0xd3c21bcecceda1000000" }, "c0ffee1234567890abcdef1234567890abcdef34": { "code": "", "storage": { "0x0000000000000000000000000000000000000000000000000000000000000000": "0x0000000000000000000000008db97c7cece249c2b98bdc0226cc4c2a57bf52fc" //sslot for owner }, "balance": "0x0", "nonce": "0x1" } }, "airdropHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "airdropAmount": null, "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "baseFeePerGas": null, "excessBlobGas": null, "blobGasUsed": null } ``` # Ledger P-Chain Transfer (/docs/tooling/avalanche-cli/transactions/ledger-p-chain-transfer) --- title: Ledger P-Chain Transfer description: Transferring funds between P-Chain using Avalanche CLI. --- Transferring funds between P-Chain wallets becomes necessary in certain situations: 1. Funds need to be sent to the Avalanche L1 control key, which might have a zero balance due to fee payments. The Avalanche L1 control key requires funding to ensure proper support for Avalanche L1 operations. 2. Funds need to be moved from one Ledger address index to another. A Ledger manages an infinite sequence of addresses all derived from a master private key and can sign for any of those addresses. Each one is referred to by an index, or the associated address. Avalanche-CLI usually expects to use index 0, but sometimes, the funds are in a different index. Occasionally, a transfer made to a ledger can be made to an address different from the default one used by the CLI. To enable direct transfers between P-Chain addresses, use the command `avalanche key transfer`. This operation involves a series of import/export actions with the P-Chain and X-Chain. The fee for this operation is four times the typical import operation fee, which comes out to 0.004 AVAX. You can find more information about fees [here](/docs/rpcs/other/guides/txn-fees). The `key transfer` command can also be applied to the stored keys managed by the CLI. It enables moving funds from one stored key to another, and from a ledger to a stored key or the other way. This how-to guide focuses on transferring funds between ledger accounts. ## Prerequisites - [`Avalanche-CLI`](/docs/tooling/avalanche-cli) installed - Multiple Ledger devices [configured for Avalanche](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-on-mainnet#setting-up-your-ledger) Example: Sending All Funds From One Ledger to Another[​](#example-sending-all-funds-from-one-ledger-to-another "Direct link to heading") ---------------------------------------------------------------------------------------------------------------------------------------- - Source address: ledger A, index 2 (the web wallet shows 4.5 AVAX for this ledger) - Target address: ledger B, index 0 (the web wallet shows 0 AVAX for this ledger) ### Determine Sender Address Index[​](#determine-sender-address-index "Direct link to heading") A ledger can manage an infinite amount of addresses derived from a main private key. Because of this, many operations require the user to specify an address index. After confirming with a web wallet that 4.5 AVAX is available on p-chain address `P-avax10an3cucdfqru984pnvv6y0rspvvclz63e523m0`, connect ledger A. With the avalanche app running, execute: ```bash avalanche key list --mainnet --ledger 0,1,2,3,4,5 ``` To see p-chain addresses and balances for the first 6 indices in the ledger derived owner addresses. ```bash +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | KIND | NAME | CHAIN | ADDRESS | BALANCE | NETWORK | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | ledger | index 0 | P-Chain (Bech32 format) | P-avax1g8yucm7j0cnwwru4rp5lkzw6dpdxjmc2rfkqs9 | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 1 | | P-avax1drppshkst2ccygyq37m2z9e3ex2jhkd2txcm5r | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 2 | | P-avax10an3cucdfqru984pnvv6y0rspvvclz63e523m0 | 4.5 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 3 | | P-avax1yfpm7v5y5rej2nu7t2r0ffgrlpfq36je0rc5k6 | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 4 | | P-avax17nqvwcqsa8ddgeww8gzmfe932pz2syaj2vyd89 | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 5 | | P-avax1jzvnd05vsfksrtatm2e3rzu6eux9a287493yf8 | 0 | Mainnet | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ ``` The address `P-avax10an3cucdfqru984pnvv6y0rspvvclz63e523m0` has 4.5 AVAX and is associated with index 2 of ledger A. ### Determine Receiver Address Index[​](#determine-receiver-address-index "Direct link to heading") In this case the user wants to use index 0, the one CLI by default expects to contain funds. For the transfer command, it is also needed to know the target p-chain address. Do the following to obtain it: With the ledger B connected and the avalache app running, execute: ```bash avalanche key list --mainnet --ledger 0 ``` ```bash +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | KIND | NAME | CHAIN | ADDRESS | BALANCE | NETWORK | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | ledger | index 0 | P-Chain (Bech32 format) | P-avax1r4aceznjkz8ch4pmpqrmkq4f3sl952mdrdt6xm | 0 | Mainnet | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ ``` Target address to be used is `P-avax1r4aceznjkz8ch4pmpqrmkq4f3sl952mdrdt6xm`, containing 0 funds. ### Send the Transfer[​](#send-the-transfer "Direct link to heading") A P-Chain to P-chain transfer is a two-part operation. There is no need for the two parts to be executed on the same machine, only for them to have some common params. For each part, the appropriate ledger (either source or target) must be connected to the machine executing it. The first step moves the money out of the source account into a X-Chain account owner by the receiver. It needs to be signed by the sending ledger. Enter the amount of AVAX to send to the recipient. This amount does not include fees. Note that the sending ledger pays all the fees. Then start the command: ```bash avalanche key transfer ``` First step is to specify the network. `Mainnet` in this case: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Network to use: ▸ Mainnet Fuji Local Network ``` Next, the step of the transfer must be specified. Send in this case: ```bash ? Step of the transfer: ▸ Send Receive ``` Next, the key source for the sender address. That is, the key that is going to sign the sending transactions. Select `Use ledger`: ```bash ? Which key source should be used to for the sender address?: Use stored key ▸ Use ledger ``` Next, the ledger index is asked for. Input `2`: ```bash ✗ Ledger index to use: 2 ``` Next, the amount to be sent is asked for: ```bash ✗ Amount to send (AVAX units): 4.496 ``` The, the target address is required: ```bash ✗ Receiver address: P-avax1r4aceznjkz8ch4pmpqrmkq4f3sl952mdrdt6xm ``` After that, a confirmation message is printed. Read carefully and choose `Yes`: ```bash this operation is going to: - send 4.496000000 AVAX from P-avax10an3cucdfqru984pnvv6y0rspvvclz63e523m0 to target address P-avax1r4aceznjkz8ch4pmpqrmkq4f3sl952mdrdt6xm - take a fee of 0.004000000 AVAX from source address P-avax10an3cucdfqru984pnvv6y0rspvvclz63e523m0 Use the arrow keys to navigate: ↓ ↑ → ← ? Confirm transfer: No ▸ Yes ``` After this, the first part is completed: ### Receive the Transfer[​](#receive-the-transfer "Direct link to heading") In this step, Ledger B signs the transaction to receive the funds. It imports the funds on the X-Chain before exporting them back to the desired P-Chain address. Connect ledger B and execute avalanche app. Then start the command: ```bash avalanche key transfer ``` Specify the `Mainnet` network: ```bash Use the arrow keys to navigate: ↓ ↑ → ← ? Network to use: ▸ Mainnet Fuji Local Network ``` Next, the step of the transfer must be specified. Receive in this case: ```bash ? Step of the transfer: Send ▸ Receive ``` Then, select Ledger as the key source that is going to sign the receiver operations. ```bash ? Which key source should be used to for the receiver address?: Use stored key ▸ Use ledger ``` Next, the ledger index is asked for. Input `0`: ```bash ✗ Ledger index to use: 0 ``` Next, the amount to receive is asked for: ```bash ✗ Amount to send (AVAX units): 4.496 ``` After that, a confirmation message is printed. Select `Yes`: ```bash this operation is going to: - receive 4.496000000 AVAX at target address P-avax1r4aceznjkz8ch4pmpqrmkq4f3sl952mdrdt6xm: Use the arrow keys to navigate: ↓ ↑ → ← ? Confirm transfer: No ▸ Yes ``` Finally, the second part of the operation is executed and the transfer is completed. ```bash Issuing ImportTx P -> X Issuing ExportTx X -> P Issuing ImportTx X -> P ``` ### Verifying Results of the Transfer Operation using `key list`[​](#verifying-results-of-the-transfer-operation-using-key-list "Direct link to heading") First verify ledger A accounts. Connect ledger A and open the avalanche app: ```bash avalanche key list --mainnet --ledger 0,1,2,3,4,5 ``` With result: ```bash +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | KIND | NAME | CHAIN | ADDRESS | BALANCE | NETWORK | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | ledger | index 0 | P-Chain (Bech32 format) | P-avax1g8yucm7j0cnwwru4rp5lkzw6dpdxjmc2rfkqs9 | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 1 | | P-avax1drppshkst2ccygyq37m2z9e3ex2jhkd2txcm5r | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 2 | | P-avax10an3cucdfqru984pnvv6y0rspvvclz63e523m0 | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 3 | | P-avax1yfpm7v5y5rej2nu7t2r0ffgrlpfq36je0rc5k6 | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 4 | | P-avax17nqvwcqsa8ddgeww8gzmfe932pz2syaj2vyd89 | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 5 | | P-avax1jzvnd05vsfksrtatm2e3rzu6eux9a287493yf8 | 0 | Mainnet | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ ``` Next, verify ledger B accounts. Connect ledger B and open the avalanche app: ```bash avalanche key list --mainnet --ledger 0,1,2,3,4,5 ``` With result: ```bash +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | KIND | NAME | CHAIN | ADDRESS | BALANCE | NETWORK | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ | ledger | index 0 | P-Chain (Bech32 format) | P-avax1r4aceznjkz8ch4pmpqrmkq4f3sl952mdrdt6xm | 4.496 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 1 | | P-avax18e9qsm30du590lhkwydhmkfwhcc9999gvxcaez | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 2 | | P-avax1unkkjstggvdty5gtnfhc0mgnl7qxa52z2d4c9y | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 3 | | P-avax1ek7n0zky3py7prxcrgnmh44y3wm6lc7r7x5r8e | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 4 | | P-avax1rsz6nt6qht5ep37qjk7ht0u9h30mgfhehsmqea | 0 | Mainnet | + +---------+ +-----------------------------------------------+---------+---------+ | | index 5 | | P-avax17u5wm4tfex7xr27xlwejm28pyk84tj0jzp42zz | 0 | Mainnet | +--------+---------+-------------------------+-----------------------------------------------+---------+---------+ ``` ### Recovery Steps[​](#recovery-steps "Direct link to heading") As a multi step operation, the receiving part of the transfer can have intermediate errors, due for example to temporal network connections on the client side. The CLI is going to capture errors and provide the user with a recovery message of the kind: ```bash ERROR: restart from this step by using the same command with extra arguments: --receive-recovery-step 1 ``` If this happen, the receiving operation should be started the same way, choosing the same options, but adding the extra suggested parameter: ```bash avalanche key transfer --receive-recovery-step 1 ``` Then, the CLI is going to resume where it left off. # Send AVAX on C/P-Chain (/docs/tooling/avalanche-cli/transactions/native-send) --- title: Send AVAX on C/P-Chain description: Learn how to execute a native transfer on the C or P-Chain using the Avalanche CLI. --- # Prerequisites - Install the [Avalanche CLI](/docs/tooling/avalanche-cli). - Use the CLI to [create a key](/docs/tooling/cli-commands#key-create). - Fund the key with AVAX. You can use the [faucet](https://test.core.app/tools/testnet-faucet/?subnet=c&token=c) with coupon code `devrel-avax-0112` to get testnet AVAX. - *Optionally*, you can [export](/docs/tooling/cli-commands#key-export) your private key for use in scripting or other tools. ## Initiate the `transfer` Command and Walk Through the Prompts In your terminal, run the following command: ```zsh avalanche key transfer ``` This command and all of its flags are documented [here](/docs/tooling/cli-commands#key-transfer). You will be prompted to answer the following questions: ```zsh ? On what Network do you want to execute the transfer?: ▸ Mainnet Fuji Testnet Devnet Local Network ``` If you select "Devnet", you must input the RPC URL. If your devnet's C-Chain RPC is `https://demo.avax-dev.network/ext/bc/C/rpc`, you should input the URL as: ```zsh ✔ Devnet Endpoint: https://demo.avax-dev.network ``` Select the chain you want to transfer funds from: ```zsh ? Where are the funds to transfer?: ▸ P-Chain C-Chain My blockchain isn't listed ``` Select the chain you want to transfer funds to: ```zsh ? Destination Chain: ▸ P-Chain X-Chain ``` Select the step of the transfer process you want to execute: ```zsh ? Step of the transfer: ▸ Send Receive ``` If you are performing a native transfer where the sender and receiver address are on the same chain, you only need to complete a "send" transaction. If you wish to perform a cross-chain transfer (i.e. from C to P-Chain), you should abort this flow and reinitiate the command as `avalanche key transfer --fund-p-chain` or `avalanche key transfer --fund-x-chain`, completing both the "send" and "receive" flows with keys stored in the CLI. You can fund your CLI-stored key with AVAX on the C-Chain using the [faucet](https://test.core.app/tools/testnet-faucet/?subnet=c&token=c) with coupon code `devrel-avax-0112`. Select the sender address: ```zsh ? Which key should be used as the sender?: ▸ Use stored key Use ledger ? Which stored key should be used as the sender address?: ▸ DemoKey MyKey ewoq ``` Specify the amount to send, input the destination address: ```zsh ✗ Amount to send (AVAX units): 100 ✗ Destination address: P-avax1zgjx8zj7z7zj7z7zj7z7zj7z7zj7zj7zj7zj7e ``` Review the transaction details and confirm/abort: ```zsh this operation is going to: - send 100.000000000 AVAX from P-avax1gmuqt8xg9j4h88kj3hyprt23nf50azlfg8txn2 to destination address P-avax1f630gvct4ht35ragcheapnn2n5cv2tkmq73ec0 - take a fee of 0.001000000 AVAX from source address P-avax1gmuqt8xg9j4h88kj3hyprt23nf50azlfg8txn2 ? Confirm transfer: No ▸ Yes ``` After a successful transfer, you can check your CLI keys' balances with the [command](/docs/tooling/cli-commands#key-list): `avalanche key list`. # Precompile Configs (/docs/tooling/avalanche-cli/upgrade/avalanche-l1-precompile-config) --- title: Precompile Configs description: Learn how to upgrade your Subnet-EVM precompile configurations. --- You can customize Subnet-EVM based Avalanche L1s after deployment by enabling and disabling precompiles. To do this, create a `upgrade.json` file and place it in the appropriate directory. This document describes how to perform such network upgrades. It's specific for Subnet-EVM upgrades. The document [Upgrade an Avalanche L1](/docs/avalanche-l1s/upgrade/considerations) describes all the background information required regarding Avalanche L1 upgrades. It's very important that you have read and understood the previously linked document. Failing to do so can potentially grind your network to a halt. This tutorial assumes that you have already [installed](/docs/tooling/avalanche-cli) Avalanche-CLI. It assumes you have already created and deployed an Avalanche L1 called `testblockchain`. Generate the Upgrade File[​](#generate-the-upgrade-file "Direct link to heading") --------------------------------------------------------------------------------- The [Precompiles](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#network-upgrades-enabledisable-precompiles) documentation describes what files the network upgrade requires, and where to place them. To generate a valid `upgrade.json` file, run: ```bash avalanche blockchain upgrade generate testblockchain ``` If you didn't create `testblockchain` yet, you would see this result: ```bash avalanche blockchain upgrade generate testblockchain The provided Avalanche L1 name "testblockchain" does not exist ``` Again, it makes no sense to try the upgrade command if the Avalanche L1 doesn't exist. If that's the case, please go ahead and [create](/docs/tooling/avalanche-cli) the Avalanche L1 first. If the Avalanche L1 definition exists, the tool launches a wizard. It may feel a bit redundant, but you first see some warnings, to draw focus to the dangers involved: ```bash avalanche blockchain upgrade generate testblockchain Performing a network upgrade requires coordinating the upgrade network-wide. A network upgrade changes the rule set used to process and verify blocks, such that any node that upgrades incorrectly or fails to upgrade by the time that upgrade goes into effect may become out of sync with the rest of the network. Any mistakes in configuring network upgrades or coordinating them on validators may cause the network to halt and recovering may be difficult. Please consult https://build.avax.network/docs/subnets/customize-a-subnet#network-upgrades-enabledisable-precompiles for more information Use the arrow keys to navigate: ↓ ↑ → ← ? Press [Enter] to continue, or abort by choosing 'no': ▸ Yes No ``` Go ahead and select `Yes` if you understand everything and you agree. You see a last note, before the actual configuration wizard starts: ```bash Avalanchego and this tool support configuring multiple precompiles. However, we suggest to only configure one per upgrade. Use the arrow keys to navigate: ↓ ↑ → ← ? Select the precompile to configure: ▸ Contract Deployment Allow List Manage Fee Settings Native Minting Transaction Allow List ``` Refer to [Precompiles](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#precompiles) for a description of available precompiles and how to configure them. Make sure you understand precompiles thoroughly and how to configure them before attempting to continue. For every precompile in the list, the wizard guides you to provide correct information by prompting relevant questions. For the sake of this tutorial, select `Transaction Allow List`. The document [Restricting Who Can Submit Transactions](/docs/avalanche-l1s/evm-configuration/customize-avalanche-l1#restricting-who-can-submit-transactions) describes what this precompile is about. ```bash ✔ Transaction Allow List Set parameters for the "Manage Fee Settings" precompile Use the arrow keys to navigate: ↓ ↑ → ← ? When should the precompile be activated?: ▸ In 5 minutes In 1 day In 1 week In 2 weeks Custom ``` This is actually common to all precompiles: they require an activation timestamp. If you think about it, it makes sense: you want a synchronized activation of your precompile. So think for a moment about when you want to set the activation timestamp to. You can select one of the suggested times in the future, or you can pick a custom one. After picking `Custom`, it shows the following prompt: ```bash ✔ Custom ✗ Enter the block activation UTC datetime in 'YYYY-MM-DD HH:MM:SS' format: ``` The format is `YYYY-MM-DD HH:MM:SS`, therefore `2023-03-31 14:00:00` would be a valid timestamp. Notice that the timestamp is in UTC. Please make sure you have converted the time from your timezone to UTC. Also notice the `✗` at the beginning of the line. The CLI tool does input validation, so if you provide a valid timestamp, the `x` disappears: ```bash ✔ Enter the block activation UTC datetime in 'YYYY-MM-DD HH:MM:SS' format: 2023-03-31 14:00:00 ``` The timestamp must be in the **future**, so make sure you use such a timestamp should you be running this tutorial after `2023-03-31 14:00:00`. After you provided the valid timestamp, proceed with the precompile specific configurations: ```bash The chosen block activation time is 2023-03-31 14:00:00 Use the arrow keys to navigate: ↓ ↑ → ← ? Add 'adminAddresses'?: ▸ Yes No ``` This will enable the addresses added in this section to add other admins and/or add enabled addresses for transaction issuance. The addresses provided in this tutorial are fake. However, make sure you or someone you trust have full control over the addresses. Otherwise, you might bring your Avalanche L1 to a halt. ```bash ✔ Yes Use the arrow keys to navigate: ↓ ↑ → ← ? Provide 'adminAddresses': ▸ Add Delete Preview More Info ↓ Done ``` The prompting runs with a pattern used throughout the tool: 1. Select an operation: - `Add`: adds a new address to the current list - `Delete`: removes an address from the current list - `Preview`: prints the current list 2. `More info` prints additional information for better guidance, if available 3. Select `Done` when you completed the list Go ahead and add your first address: ```bash ✔ Add ✔ Add an address: 0xaaaabbbbccccddddeeeeffff1111222233334444 ``` Add another one: ```bash ✔ Add Add an address: 0xaaaabbbbccccddddeeeeffff1111222233334444 ✔ Add ✔ Add an address: 0x1111222233334444aaaabbbbccccddddeeeeffff ``` Select `Preview` this time to confirm the list is correct: ```bash ✔ Preview 0. 0xaaaAbbBBCccCDDddEeEEFFfF1111222233334444 1. 0x1111222233334444aAaAbbBBCCCCDdDDeEeEffff Use the arrow keys to navigate: ↓ ↑ → ← ? Provide 'adminAddresses': ▸ Add Delete Preview More Info ↓ Done ``` If it looks good, select `Done` to continue: ```bash ✔ Done Use the arrow keys to navigate: ↓ ↑ → ← ? Add 'enabledAddresses'?: ▸ Yes No ``` Add one such enabled address, these are addresses which can issue transactions: ```bash ✔ Add ✔ Add an address: 0x55554444333322221111eeeeaaaabbbbccccdddd█ ``` After you added this address, and selected `Done`, the tool asks if you want to add another precompile: ```bash ✔ Done Use the arrow keys to navigate: ↓ ↑ → ← ? Should we configure another precompile?: ▸ No Yes ``` If you needed to add another one, you would select `Yes` here. The wizard would guide you through the other available precompiles, excluding already configured ones. To avoid making this tutorial too long, the assumption is you're done here. Select `No`, which ends the wizard. This means you have successfully terminated the generation of the upgrade file, often called upgrade bytes. The tool stores them internally. You shouldn't move files around manually. Use the `export` and `import` commands to get access to the files. So at this point you can either: - Deploy your upgrade bytes locally - Export your upgrade bytes to a file, for installation on a validator running on another machine - Import a file into a different machine running Avalanche-CLI How To Upgrade a Local Network[​](#how-to-upgrade-a-local-network "Direct link to heading") ------------------------------------------------------------------------------------------- The normal use case for this operation is that: - You already created an Avalanche L1 - You already deployed the Avalanche L1 locally - You already generated the upgrade file with the preceding command or imported into the tool - This tool already started the network If the preceding requirements aren't met, the network upgrade command fails. Therefore, to apply your generated or imported upgrade configuration: ```bash avalanche blockchain upgrade apply testblockchain ``` A number of checks run. For example, if you created the Avalanche L1 but didn't deploy it locally: ```bash avalanche blockchain upgrade apply testblockchain Error: no deployment target available Usage: avalanche blockchain upgrade apply [blockchainName] [flags] Flags: --avalanchego-chain-config-dir string avalanchego's chain config file directory (default "/home/fabio/.avalanchego/chains") --config create upgrade config for future Avalanche L1 deployments (same as generate) --fuji fuji apply upgrade existing fuji deployment (alias for `testnet`) -h, --help help for apply --local local apply upgrade existing local deployment --mainnet mainnet apply upgrade existing mainnet deployment --print if true, print the manual config without prompting (for public networks only) --testnet testnet apply upgrade existing testnet deployment (alias for `fuji`) Global Flags: --log-level string log level for the application (default "ERROR") ``` Go ahead and [deploy](/docs/tooling/avalanche-cli/create-deploy-avalanche-l1s/deploy-locally) first your Avalanche L1 if that's your case. If you already had deployed the Avalanche L1 instead, you see something like this: ```bash avalanche blockchain upgrade apply testblockchain Use the arrow keys to navigate: ↓ ↑ → ← ? What deployment would you like to upgrade: ▸ Existing local deployment ``` Select `Existing local deployment`. This installs the upgrade file on all nodes of your local network running in the background. Et voilà. This is the output shown if all went well: ```bash ✔ Existing local deployment ....... Network restarted and ready to use. Upgrade bytes have been applied to running nodes at these endpoints. The next upgrade will go into effect 2023-03-31 09:00:00 +-------+------------+-----------------------------------------------------------------------------------+ | NODE | VM | URL | +-------+------------+-----------------------------------------------------------------------------------+ | node1 | testblockchain | http://0.0.0.0:9650/ext/bc/2YTRV2roEhgvwJz7D7vr33hUZscpaZgcYgUTjeMK9KH99NFnsH/rpc | +-------+------------+-----------------------------------------------------------------------------------+ | node2 | testblockchain | http://0.0.0.0:9652/ext/bc/2YTRV2roEhgvwJz7D7vr33hUZscpaZgcYgUTjeMK9KH99NFnsH/rpc | +-------+------------+-----------------------------------------------------------------------------------+ | node3 | testblockchain | http://0.0.0.0:9654/ext/bc/2YTRV2roEhgvwJz7D7vr33hUZscpaZgcYgUTjeMK9KH99NFnsH/rpc | +-------+------------+-----------------------------------------------------------------------------------+ | node4 | testblockchain | http://0.0.0.0:9656/ext/bc/2YTRV2roEhgvwJz7D7vr33hUZscpaZgcYgUTjeMK9KH99NFnsH/rpc | +-------+------------+-----------------------------------------------------------------------------------+ | node5 | testblockchain | http://0.0.0.0:9658/ext/bc/2YTRV2roEhgvwJz7D7vr33hUZscpaZgcYgUTjeMK9KH99NFnsH/rpc | +-------+------------+-----------------------------------------------------------------------------------+ ``` There is only so much the tool can do here for you. It installed the upgrade bytes _as-is_ as you configured respectively provided them to the tool. You should verify yourself that the upgrades were actually installed correctly, for example issuing some transactions - mind the timestamp!. Apply the Upgrade to a Public Node (Fuji or Mainnet)[​](#apply-the-upgrade-to-a-public-node-fuji-or-mainnet "Direct link to heading") ------------------------------------------------------------------------------------------------------------------------------------- For this scenario to work, you should also have deployed the Avalanche L1 to the public network (Fuji or Mainnet) with this tool. Otherwise, the tool won't know the details of the Avalanche L1, and won't be able to guide you. Assuming the Avalanche L1 has been already deployed to Fuji, when running the `apply` command, the tool notices the deployment: ```bash avalanche blockchain upgrade apply testblockchain Use the arrow keys to navigate: ↓ ↑ → ← ? What deployment would you like to upgrade: Existing local deployment ▸ Fuji ``` If not, you would not find the `Fuji` entry here. This scenario assumes that you are running the `fuji` validator on the same machine which is running Avalanche-CLI. If this is the case, the tool tries to install the upgrade file at the expected destination. If you use default paths, it tries to install at `$HOME/.avalanchego/chains/`, creating the chain id directory, so that the file finally ends up at `$HOME/.avalanchego/chains//upgrade.json`. If you are _not_ using default paths, you can configure the path by providing the flag `--avalanchego-chain-config-dir` to the tool. For example: ```bash avalanche blockchain upgrade apply testblockchain --avalanchego-chain-config-dir /path/to/your/chains ``` Make sure to identify correctly where your chain config dir is, or the node might fail to find it. If all is correct, the file gets installed: ```bash avalanche blockchain upgrade apply testblockchain ✔ Fuji The chain config dir avalanchego uses is set at /home/fabio/.avalanchego/chains Trying to install the upgrade files at the provided /home/fabio/.avalanchego/chains path Successfully installed upgrade file ``` If however the node is _not_ running on this same machine where you are executing Avalanche-CLI, there is no point in running this command for a Fuji node. In this case, you might rather export the file and install it at the right location. To see the instructions about how to go about this, add the `--print` flag: ```bash avalanche blockchain upgrade apply testblockchain --print ✔ Fuji To install the upgrade file on your validator: 1. Identify where your validator has the avalanchego chain config dir configured. The default is at $HOME/.avalanchego/chains (/home/user/.avalanchego/chains on this machine). If you are using a different chain config dir for your node, use that one. 2. Create a directory with the blockchainID in the configured chain-config-dir (e.g. $HOME/.avalanchego/chains/ExDKhjXqiVg7s35p8YJ56CJpcw6nJgcGCCE7DbQ4oBknZ1qXi) if doesn't already exist. 3. Create an `upgrade.json` file in the blockchain directory with the content of your upgrade file. This is the content of your upgrade file as configured in this tool: { "precompileUpgrades": [ { "txAllowListConfig": { "adminAddresses": [ "0xb3d82b1367d362de99ab59a658165aff520cbd4d" ], "enabledAddresses": null, "blockTimestamp": 1677550447 } } ] } ****************************************************************************************************************** * Upgrades are tricky. The syntactic correctness of the upgrade file is important. * * The sequence of upgrades must be strictly observed. * * Make sure you understand https://build.avax.network/docs/nodes/configure/configs-flags#subnet-chain-configs * * before applying upgrades manually. * ****************************************************************************************************************** ``` The instructions also show the content of your current upgrade file, so you can just select that if you wish. Or actually export the file. Export the Upgrade File[​](#export-the-upgrade-file "Direct link to heading") ----------------------------------------------------------------------------- If you have generated the upgrade file, you can export it: ```bash avalanche blockchain upgrade export testblockchain ✔ Provide a path where we should export the file to: /tmp/testblockchain-upgrade.json ``` Just provide a valid path to the prompt, and the tool exports the file there. ```bash avalanche blockchain upgrade export testblockchain Provide a path where we should export the file to: /tmp/testblockchain-upgrade.json Writing the upgrade bytes file to "/tmp/testblockchain-upgrade.json"... File written successfully. ``` You can now take that file and copy it to validator nodes, see preceding instructions. Import the Upgrade File[​](#import-the-upgrade-file "Direct link to heading") ----------------------------------------------------------------------------- You or someone else might have generated the file elsewhere, or on another machine. And now you want to install it on the validator machine, using Avalanche-CLI. You can import the file: ```bash avalanche blockchain upgrade import testblockchain Provide the path to the upgrade file to import: /tmp/testblockchain-upgrade.json ``` An existing file with the same path and filename would be overwritten. After you have imported the file, you can `apply` it either to a local network or to a locally running validator. Follow the instructions for the appropriate use case. # Virtual Machine (/docs/tooling/avalanche-cli/upgrade/avalanche-l1-virtual-machine) --- title: Virtual Machine description: This how-to guide explains how to upgrade the VM of an already-deployed Avalanche L1. --- To upgrade a local Avalanche L1, you first need to pause the local network. To do so, run: ```bash avalanche network stop ``` Next, you need to select the new VM to run your Avalanche L1 on. If you're running a Subnet-EVM Avalanche L1, you likely want to bump to the latest released version. If you're running a Custom VM, you'll want to choose another custom binary. Start the upgrade wizard with: ```bash avalanche blockchain upgrade vm ``` where you replace `` with the name of the Avalanche L1 you would like to upgrade. ## Selecting a VM Deployment to Upgrade After starting the Avalanche L1 Upgrade Wizard, you should see something like this: ```bash ? What deployment would you like to upgrade: ▸ Update config for future deployments Existing local deployment ``` If you select the first option, Avalanche-CLI updates your Avalanche L1's config and any future calls to `avalanche blockchain deploy` use the new version you select. However, any existing local deployments continue to use the old version. If you select the second option, the opposite occurs. The existing local deployment switches to the new VM but subsequent deploys use the original. ## Select a VM to Upgrade To The next option asks you to select your new virtual machine. ```bash ? How would you like to update your Avalanche L1's virtual machine: ▸ Update to latest version Update to a specific version Update to a custom binary ``` If you're using the Subnet-EVM, you'll have the option to upgrade to the latest released version. You can also select a specific version or supply a custom binary. If your Avalanche L1 already uses a custom VM, you need to select another custom binary. Once you select your VM, you should see something like: ```bash Upgrade complete. Ready to restart the network. ``` ## Restart the Network If you are running multiple Avalanche L1s concurrently, you may need to update multiple Avalanche L1s to restart the network. All of your deployed must be using the same RPC Protocol version. You can see more details about this [here](/docs/nodes/maintain/upgrade#incompatible-rpc-version-for-custom-vm). Finally, restart the network with: ```bash avalanche network start ``` If the network starts correctly, your Avalanche L1 is now running the upgraded VM. # avm.getAssetDescription (/docs/rpcs/x-chain/chain/avm_getAssetDescription) --- title: avm.getAssetDescription full: true _openapi: method: POST route: /ext/bc/X#avm.getAssetDescription toc: [] structuredData: headings: [] contents: - content: >- Get information about an asset including name, symbol, and denomination. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Get information about an asset including name, symbol, and denomination. # avm.getBlock (/docs/rpcs/x-chain/chain/avm_getBlock) --- title: avm.getBlock full: true _openapi: method: POST route: /ext/bc/X#avm.getBlock toc: [] structuredData: headings: [] contents: - content: Returns the block with the given id. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the block with the given id. # avm.getBlockByHeight (/docs/rpcs/x-chain/chain/avm_getBlockByHeight) --- title: avm.getBlockByHeight full: true _openapi: method: POST route: /ext/bc/X#avm.getBlockByHeight toc: [] structuredData: headings: [] contents: - content: Returns block at the given height. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns block at the given height. # avm.getHeight (/docs/rpcs/x-chain/chain/avm_getHeight) --- title: avm.getHeight full: true _openapi: method: POST route: /ext/bc/X#avm.getHeight toc: [] structuredData: headings: [] contents: - content: Returns the height of the last accepted block. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the height of the last accepted block. # avm.getTx (/docs/rpcs/x-chain/chain/avm_getTx) --- title: avm.getTx full: true _openapi: method: POST route: /ext/bc/X#avm.getTx toc: [] structuredData: headings: [] contents: - content: Returns the specified transaction. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Returns the specified transaction. # avm.getTxFee (/docs/rpcs/x-chain/chain/avm_getTxFee) --- title: avm.getTxFee full: true _openapi: method: POST route: /ext/bc/X#avm.getTxFee toc: [] structuredData: headings: [] contents: - content: Get the transaction fees of the network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Get the transaction fees of the network. # avm.getUTXOs (/docs/rpcs/x-chain/chain/avm_getUTXOs) --- title: avm.getUTXOs full: true _openapi: method: POST route: /ext/bc/X#avm.getUTXOs toc: [] structuredData: headings: [] contents: - content: > Gets the UTXOs that reference a given address. If sourceChain is specified, then it will retrieve the atomic UTXOs exported from that chain to the X Chain. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Gets the UTXOs that reference a given address. If sourceChain is specified, then it will retrieve the atomic UTXOs exported from that chain to the X Chain. # avm.issueTx (/docs/rpcs/x-chain/chain/avm_issueTx) --- title: avm.issueTx full: true _openapi: method: POST route: /ext/bc/X#avm.issueTx toc: [] structuredData: headings: [] contents: - content: Send a signed transaction to the network. --- {/* This file was generated by Fumadocs. Do not edit this file directly. Any changes should be made by running the generation command again. */} Send a signed transaction to the network. # Authentication (/docs/tooling/avalanche-sdk/chainkit/authentication) --- title: Authentication description: Authentication for the ChainKit SDK icon: Lock --- ### Per-Client Security Schemes This SDK supports the following security scheme globally: | Name | Type | Scheme | | -------- | ------ | ------- | | `apiKey` | apiKey | API key | The ChainKit SDK can be used without an API key, but rate limits will be lower. Adding an API key allows for higher rate limits. To get an API key, create one via [Builder Console](/console/utilities/data-api-keys) and securely store it. Whether or not you use an API key, you can still interact with the SDK effectively, but the API key provides performance benefits for higher request volumes. ```javascript import { Avalanche } from "@avalanche-sdk/chainkit"; const avalancheSDK = new Avalanche({ apiKey: "", chainId: "43114", network: "mainnet", }); async function run() { const result = await avalancheSDK.metrics.healthCheck(); // Handle the result console.log(result); } run(); ``` Never hardcode your API key directly into your code. Instead, securely store it and retrieve it from an environment variable, a secrets manager, or a dedicated configuration storage mechanism. This ensures that sensitive information remains protected and is not exposed in version control or publicly accessible code. # Custom HTTP Client (/docs/tooling/avalanche-sdk/chainkit/custom-http) --- title: Custom HTTP Client description: Custom HTTP Client for the ChainKit SDK icon: Server --- The TypeScript SDK makes API calls using an HTTPClient that wraps the native [Fetch API](https://developer.mozilla.org/en-US/docs/Web/API/Fetch_API). This client is a thin wrapper around `fetch` and provides the ability to attach hooks around the request lifecycle that can be used to modify the request or handle errors and response. The `HTTPClient` constructor takes an optional `fetcher` argument that can be used to integrate a third-party HTTP client or when writing tests to mock out the HTTP client and feed in fixtures. The following example shows how to use the `beforeRequest` hook to to add a custom header and a timeout to requests and how to use the `requestError` hook to log errors: ```javascript import { Avalanche } from "@avalanche-sdk/chainkit"; import { HTTPClient } from "@avalanche-sdk/chainkit/lib/http"; const httpClient = new HTTPClient({ // fetcher takes a function that has the same signature as native `fetch`. fetcher: (request) => { return fetch(request); }, }); httpClient.addHook("beforeRequest", (request) => { const nextRequest = new Request(request, { signal: request.signal || AbortSignal.timeout(5000), }); nextRequest.headers.set("x-custom-header", "custom value"); return nextRequest; }); httpClient.addHook("requestError", (error, request) => { console.group("Request Error"); console.log("Reason:", `${error}`); console.log("Endpoint:", `${request.method} ${request.url}`); console.groupEnd(); }); const sdk = new Avalanche({ httpClient }); ``` # Error Handling (/docs/tooling/avalanche-sdk/chainkit/errors) --- title: Error Handling description: Error Handling for the ChainKit SDK icon: Bug --- All SDK methods return a response object or throw an error. If Error objects are specified in your OpenAPI Spec, the SDK will throw the appropriate Error type. | Error Object | Status Code | Content Type | | :------------------------- | :---------- | :--------------- | | errors.BadRequest | 400 | application/json | | errors.Unauthorized | 401 | application/json | | errors.Forbidden | 403 | application/json | | errors.NotFound | 404 | application/json | | errors.TooManyRequests | 429 | application/json | | errors.InternalServerError | 500 | application/json | | errors.BadGateway | 502 | application/json | | errors.ServiceUnavailable | 503 | application/json | | errors.SDKError | 4xx-5xx | / | Validation errors can also occur when either method arguments or data returned from the server do not match the expected format. The SDKValidationError that is thrown as a result will capture the raw value that failed validation in an attribute called `rawValue`. Additionally, a `pretty()` method is available on this error that can be used to log a nicely formatted string since validation errors can list many issues and the plain error string may be difficult read when debugging. ```javascript import { Avalanche } from "@avalanche-sdk/chainkit"; import { BadGateway, BadRequest, Forbidden, InternalServerError, NotFound, SDKValidationError, ServiceUnavailable, TooManyRequests, Unauthorized, } from "@avalanche-sdk/chainkit/models/errors"; const avalancheSDK = new Avalanche({ apiKey: "", chainId: "43114", network: "mainnet", }); async function run() { try { await avalancheSDK.data.nfts.reindex({ address: "0xB97EF9Ef8734C71904D8002F8b6Bc66Dd9c48a6E", tokenId: "145", }); } catch (err) { switch (true) { case err instanceof SDKValidationError: { // Validation errors can be pretty-printed console.error(err.pretty()); // Raw value may also be inspected console.error(err.rawValue); return; } case err instanceof BadRequest: { // Handle err.data$: BadRequestData console.error(err); return; } case err instanceof Unauthorized: { // Handle err.data$: UnauthorizedData console.error(err); return; } case err instanceof Forbidden: { // Handle err.data$: ForbiddenData console.error(err); return; } case err instanceof NotFound: { // Handle err.data$: NotFoundData console.error(err); return; } case err instanceof TooManyRequests: { // Handle err.data$: TooManyRequestsData console.error(err); return; } case err instanceof InternalServerError: { // Handle err.data$: InternalServerErrorData console.error(err); return; } case err instanceof BadGateway: { // Handle err.data$: BadGatewayData console.error(err); return; } case err instanceof ServiceUnavailable: { // Handle err.data$: ServiceUnavailableData console.error(err); return; } default: { throw err; } } } } run(); ``` # Getting Started (/docs/tooling/avalanche-sdk/chainkit/getting-started) --- title: Getting Started description: Get started with the ChainKit SDK icon: Rocket --- ### ChainKit SDK The ChainKit SDK provides web3 application developers with multi-chain data related to Avalanche's primary network, Avalanche L1s, and Ethereum. With the Data API, you can easily build products that leverage real-time and historical transaction and transfer history, native and token balances, and various types of token metadata. **Migration Notice**: This SDK was previously known as the AvaCloud SDK. We have made namespace changes and will discontinue the AvaCloud SDK in favor of the ChainKit SDK. For migration guidance and specific method updates, please refer to the individual method documentation. The SDK is currently available in TypeScript, with more languages coming soon. If you are interested in a language that is not listed, please reach out to us in the [#avalanche-sdk](https://discord.com/channels/578992315641626624/1416238478915665961) channel in the [Avalanche Discord](https://discord.gg/avax). [https://www.npmjs.com/package/@avalanche-sdk/chainkit](https://www.npmjs.com/package/@avalanche-sdk/chainkit) [https://github.com/ava-labs/avalanche-sdk-typescript](https://github.com/ava-labs/avalanche-sdk-typescript) ### SDK Installation ```bash npm install @avalanche-sdk/client ``` ```bash yarn add @avalanche-sdk/client ``` ```bash bun add @avalanche-sdk/client ``` ### SDK Example Usage ```javascript import { Avalanche } from "@avalanche-sdk/chainkit"; const avalancheSDK = new Avalanche({ apiKey: "", chainId: "43114", network: "mainnet", }); async function run() { const result = await avalancheSDK.metrics.healthCheck(); // Handle the result console.log(result); } run(); ``` Refer to the code samples provided for each route to see examples of how to use them in the SDK. Explore routes here [Data API](/docs/api-reference/data-api/getting-started), [Metrics API](/docs/api-reference/metrics-api/getting-started) & [Webhooks API](/docs/api-reference/webhook-api). # Global Parameters (/docs/tooling/avalanche-sdk/chainkit/global-parameters) --- title: Global Parameters description: Global parameters for the ChainKit SDK icon: Globe --- Certain parameters are configured globally. These parameters may be set on the SDK client instance itself during initialization. When configured as an option during SDK initialization, These global values will be used as defaults on the operations that use them. When such operations are called, there is a place in each to override the global value, if needed. For example, you can set `chainId` to `43114` at SDK initialization and then you do not have to pass the same value on calls to operations like getBlock. But if you want to do so you may, which will locally override the global setting. See the example code below for a demonstration. ### Available Globals The following global parameters are available. | Name | Type | Required | Description | | :-------- | :---------------------------- | :------- | :------------------------------------------------------- | | `chainId` | string | No | A supported EVM chain id, chain alias, or blockchain id. | | `network` | components.GlobalParamNetwork | No | A supported network type, either mainnet or a testnet. | Example ```javascript import { Avalanche } from "@avalanche-sdk/chainkit"; const avalancheSDK = new Avalanche({ apiKey: "", chainId: "43114", // Sets chainId globally, will be used if not passed during method call. network: "mainnet", }); async function run() { const result = await avalancheSDK.data.evm.blocks.get({ blockId: "0x17533aeb5193378b9ff441d61728e7a2ebaf10f61fd5310759451627dfca2e7c", chainId: "", // Override the globally set chain id. }); // Handle the result console.log(result); } run(); ``` # Pagination (/docs/tooling/avalanche-sdk/chainkit/pagination) --- title: Pagination description: Pagination for the ChainKit SDK icon: StickyNote --- Some of the endpoints in this SDK support pagination. To use pagination, you make your SDK calls as usual, but the returned response object will also be an async iterable that can be consumed using the `for await...of` syntax. Here's an example of one such pagination call: ```javascript import { Avalanche } from "@avalanche-sdk/chainkit"; const avalancheSDK = new Avalanche({ apiKey: "", chainId: "43114", network: "mainnet", }); async function run() { const result = await avalancheSDK.metrics.chains.list({ network: "mainnet", }); for await (const page of result) { // Handle the page console.log(page); } } run(); ``` # Retries (/docs/tooling/avalanche-sdk/chainkit/retries) --- title: Retries description: Retries for the ChainKit SDK icon: RotateCcw --- Some of the endpoints in this SDK support retries. If you use the SDK without any configuration, it will fall back to the default retry strategy provided by the API. However, the default retry strategy can be overridden on a per-operation basis, or across the entire SDK. To change the default retry strategy for a single API call, simply provide a retryConfig object to the call: ```javascript import { Avalanche } from "@avalanche-sdk/chainkit"; const avalancheSDK = new Avalanche({ apiKey: "", chainId: "43114", network: "mainnet", }); async function run() { const result = await avalancheSDK.metrics.healthCheck({ retries: { strategy: "backoff", backoff: { initialInterval: 1, maxInterval: 50, exponent: 1.1, maxElapsedTime: 100, }, retryConnectionErrors: false, }, }); // Handle the result console.log(result); } run(); ``` If you'd like to override the default retry strategy for all operations that support retries, you can provide a retryConfig at SDK initialization: ```javascript import { Avalanche } from "@avalanche-sdk/chainkit"; const avalancheSDK = new Avalanche({ retryConfig: { strategy: "backoff", backoff: { initialInterval: 1, maxInterval: 50, exponent: 1.1, maxElapsedTime: 100, }, retryConnectionErrors: false, }, apiKey: "", chainId: "43114", network: "mainnet", }); async function run() { const result = await avalancheSDK.metrics.healthCheck(); // Handle the result console.log(result); } run(); ``` # Client & Transports (/docs/tooling/avalanche-sdk/client/clients-transports) --- title: Client & Transports icon: Plug --- ## Overview Clients provide type-safe interfaces for interacting with Avalanche. Transports handle the communication layer. This separation lets you switch between HTTP, WebSocket, or custom providers without changing your code. The SDK is built on [viem](https://viem.sh), so you get full Ethereum compatibility plus native support for P-Chain, X-Chain, and C-Chain operations. ## Clients Clients are TypeScript interfaces that abstract RPC calls and provide type-safe APIs. ### Avalanche Client (Public Client) The read-only client for querying blockchain data across all Avalanche chains. ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http", }, }); // Access different chains const pChainHeight = await client.pChain.getHeight(); const cChainBalance = await client.getBalance({ address: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", }); ``` ### Avalanche Wallet Client Extends the public client with transaction signing and sending capabilities. ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avalanche } from "@avalanche-sdk/client/chains"; import { avaxToWei } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http", }, }); // Send AVAX const hash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: avaxToWei(0.001), }); ``` ### Chain-Specific Clients Access chain-specific operations through sub-clients: - `client.pChain` - Validator operations, staking, subnet management - `client.xChain` - Asset transfers, UTXO operations - `client.cChain` - Atomic transactions - API clients - Admin, Info, Health, Index API, Proposervm operations ## Transports Transports handle data transmission between your application and Avalanche nodes. They abstract RPC protocol implementation. ### HTTP Transport Uses standard HTTP/HTTPS connections. Most common choice for production applications. ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http", // Optional: specify custom URL // url: "https://api.avax.network/ext/bc/C/rpc", }, }); ``` ### WebSocket Transport Maintains a persistent connection for real-time subscriptions and event streaming. ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "ws", // Optional: specify custom WebSocket URL // url: "wss://api.avax.network/ext/bc/C/ws", }, }); ``` ### Custom Transport (EIP-1193) Supports custom transport implementations, including EIP-1193 providers (MetaMask, WalletConnect, etc.). ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; import "@avalanche-sdk/client/window"; // Using window.ethereum (Core, MetaMask, etc.) const walletClient = createAvalancheWalletClient({ account: account, chain: avalanche, transport: { type: "custom", provider: window.ethereum, // Or // provider: window.avalanche, }, }); ``` ## Transport Configuration ### Mainnet/Testnet ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche, avalancheFuji } from "@avalanche-sdk/client/chains"; // Mainnet const mainnetClient = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); // Testnet (Fuji) const testnetClient = createAvalancheClient({ chain: avalancheFuji, transport: { type: "http" }, }); ``` ### Custom Endpoints ```typescript const client = createAvalancheClient({ chain: avalanche, transport: { type: "http", url: "https://your-custom-rpc-endpoint.com/ext/bc/C/rpc", // Optional: Add headers for authentication // fetchOptions: { // headers: { // Authorization: `Bearer ${apiKey}`, // }, // }, }, }); ``` ### Switching Transports Switch between transports without changing your application logic: ```typescript // HTTP client const httpClient = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); // WebSocket client const wsClient = createAvalancheClient({ chain: avalanche, transport: { type: "ws" }, }); // Both have the same API const height1 = await httpClient.pChain.getHeight(); const height2 = await wsClient.pChain.getHeight(); ``` ## Client Selection ### Public Client vs Wallet Client | Feature | Public Client | Wallet Client | | ----------------------- | ------------- | --------------------- | | **Read Operations** | ✅ Yes | ✅ Yes (inherits all) | | **Transaction Signing** | ❌ No | ✅ Yes | | **Transaction Sending** | ❌ No | ✅ Yes | | **Account Required** | ❌ No | ✅ Yes | **Use Public Client for:** Reading blockchain data, querying balances, fetching validator info, reading smart contract state. **Use Wallet Client for:** Sending transactions, signing messages, transferring assets, interacting with smart contracts. ### Chain-Specific Clients The main client provides access to all chains. You can also create standalone chain-specific clients: ```typescript // Main client - access all chains const client = createAvalancheClient({ ... }); await client.pChain.getHeight(); await client.xChain.getBalance({ ... }); // Chain-specific client import { createPChainClient } from "@avalanche-sdk/client"; const pChainOnly = createPChainClient({ ... }); await pChainOnly.getHeight(); ``` **Use chain-specific clients when:** Your app only interacts with one chain, you want smaller bundle size, or need specialized configuration. **Use main client when:** Your app uses multiple chains or you want unified configuration. ## Next Steps - **[Avalanche Client](clients/avalanche-client)** - Read-only operations - **[Avalanche Wallet Client](clients/wallet-client)** - Transaction operations - **[Chain-Specific Clients](clients/p-chain-client)** - P-Chain, X-Chain, and C-Chain clients - **[Public Actions](methods/public-methods/p-chain)** - Read operations reference - **[Wallet Actions](methods/wallet-methods/wallet)** - Write operations reference The SDK follows the same transport patterns as [viem](https://viem.sh/docs/clients/public.html#transport) for compatibility. # Getting Started (/docs/tooling/avalanche-sdk/client/getting-started) --- title: Getting Started icon: Rocket description: Get started with the Avalanche Client SDK - your gateway to building on Avalanche with TypeScript. --- ## Overview The Avalanche Client SDK provides a TypeScript interface for interacting with Avalanche. Built on [viem](https://viem.sh), it offers full Ethereum compatibility plus native support for P-Chain, X-Chain, and C-Chain operations. [https://www.npmjs.com/package/@avalanche-sdk/client](https://www.npmjs.com/package/@avalanche-sdk/client) [https://github.com/ava-labs/avalanche-sdk-typescript](https://github.com/ava-labs/avalanche-sdk-typescript) ## Installation Install the Avalanche Client SDK using your preferred package manager: ```bash npm install @avalanche-sdk/client ``` ```bash yarn add @avalanche-sdk/client ``` ```bash bun add @avalanche-sdk/client ``` ### Requirements - Node.js >= 20.0.0 - TypeScript >= 5.0.0 (recommended) - Modern browsers: Chrome 88+, Firefox 85+, Safari 14+, Edge 88+ ## Quick Start ### Public Client Create a read-only client: ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); // Read operations const pChainHeight = await client.pChain.getHeight(); const balance = await client.getBalance({ address: "0xA0Cf798816D4b9b9866b5330EEa46a18382f251e", }); ``` ### Wallet Client Create a wallet client for transactions: ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avalanche } from "@avalanche-sdk/client/chains"; import { avaxToWei } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // Send AVAX const hash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: avaxToWei(0.001), }); ``` ## Account Creation ### Private Key ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount("0x..."); ``` ### Mnemonic ```typescript import { mnemonicsToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = mnemonicsToAvalancheAccount("test test test..."); ``` ### HD Key ```typescript import { hdKeyToAvalancheAccount, HDKey } from "@avalanche-sdk/client/accounts"; const hdKey = HDKey.fromMasterSeed(seed); const account = hdKeyToAvalancheAccount(hdKey); ``` [Learn more about accounts →](accounts) ## Transport Configuration ### HTTP ```typescript const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); ``` ### WebSocket ```typescript const client = createAvalancheClient({ chain: avalanche, transport: { type: "ws" }, }); ``` ### Custom Endpoint ```typescript const client = createAvalancheClient({ chain: avalanche, transport: { type: "http", url: "https://your-custom-rpc-endpoint.com/ext/bc/C/rpc", }, }); ``` [Learn more about transports →](clients-transports) ## Avalanche Chains Avalanche has three primary chains: - **P-Chain (Platform Chain)**: Validators, staking, subnets - **X-Chain (Exchange Chain)**: Asset transfers (UTXO model) - **C-Chain (Contract Chain)**: Smart contracts (Ethereum-compatible) ```typescript // P-Chain const validators = await client.pChain.getCurrentValidators({}); // X-Chain const balance = await client.xChain.getBalance({ address: "X-avax1example...", assetID: "AVAX", }); // C-Chain const balance = await client.getBalance({ address: "0x..." }); ``` ## Using viem Features The SDK is built on viem, so you have access to all viem functionality: ```typescript import { formatEther, parseEther } from "@avalanche-sdk/client/utils"; const valueInWei = parseEther("1.0"); const valueInAvax = formatEther(1000000000000000000n); const receipt = await walletClient.waitForTransactionReceipt({ hash }); ``` See the [viem documentation](https://viem.sh/docs/getting-started) for more utilities. ## Next Steps - **[Clients & Transports](clients-transports)** - Understanding clients and transports - **[Account Management](accounts)** - Creating and managing accounts - **[Wallet Operations](methods/wallet-methods/wallet)** - Sending transactions - **[P-Chain Operations](methods/public-methods/p-chain)** - Validator and staking - **[X-Chain Operations](methods/public-methods/x-chain)** - Asset transfers - **[C-Chain Operations](methods/public-methods/c-chain)** - EVM operations ## Need Help? - [Discord community](https://discord.gg/avax) - [GitHub examples](https://github.com/ava-labs/avalanche-sdk-typescript/tree/main/client/examples) - [Open an issue](https://github.com/ava-labs/avalanche-sdk-typescript/issues) # Getting Started (/docs/tooling/avalanche-sdk/interchain/getting-started) --- title: Getting Started description: Install and configure the Interchain SDK icon: rocket --- ## Installation npm install @avalanche-sdk/interchain @avalanche-sdk/client pnpm add @avalanche-sdk/interchain @avalanche-sdk/client yarn add @avalanche-sdk/interchain @avalanche-sdk/client bun add @avalanche-sdk/interchain @avalanche-sdk/client ## Setup ### 1. Create Wallet Client ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalancheFuji } from "@avalanche-sdk/client/chains"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount("0x..."); const wallet = createAvalancheWalletClient({ account, chain: avalancheFuji, transport: { type: "http" }, }); ``` ### 2. Initialize ICM Client ```typescript import { createICMClient } from "@avalanche-sdk/interchain"; import { avalancheFuji, dispatch } from "@avalanche-sdk/interchain/chains"; const icm = createICMClient(wallet, avalancheFuji, dispatch); ``` ## Send Your First Message ```typescript async function sendMessage() { const hash = await icm.sendMsg({ sourceChain: avalancheFuji, destinationChain: dispatch, message: "Hello from Avalanche!", }); console.log("Message sent:", hash); } ``` ## Send Your First Token Transfer ```typescript import { createICTTClient } from "@avalanche-sdk/interchain"; const ictt = createICTTClient(avalancheFuji, dispatch); // Deploy token and contracts (one-time setup) const { contractAddress: tokenAddress } = await ictt.deployERC20Token({ walletClient: wallet, sourceChain: avalancheFuji, name: "My Token", symbol: "MTK", initialSupply: 1000000, }); // Send tokens const { txHash } = await ictt.sendToken({ walletClient: wallet, sourceChain: avalancheFuji, destinationChain: dispatch, tokenHomeContract: "0x...", tokenRemoteContract: "0x...", recipient: "0x...", amountInBaseUnit: 100, }); ``` ## Next Steps - Learn about [Interchain Messaging](/avalanche-sdk/interchain/icm) - Explore [Token Transfers](/avalanche-sdk/interchain/ictt) - Understand [Warp Messages](/avalanche-sdk/interchain/warp) # Interchain SDK (/docs/tooling/avalanche-sdk/interchain) --- title: Interchain SDK icon: network description: Send cross-chain messages and transfer tokens between Avalanche chains and subnets --- ## Overview The Interchain SDK enables cross-chain communication on Avalanche. Send messages and transfer ERC20 tokens between Avalanche C-Chain and subnets using the Teleporter protocol. **Key Features:** - **Interchain Messaging (ICM)** - Send arbitrary messages across chains - **Interchain Token Transfers (ICTT)** - Transfer ERC20 tokens between chains - **Warp Messages** - Parse and build Warp protocol messages - **Type-safe** - Full TypeScript support with IntelliSense ## Quick Start ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { createICMClient } from "@avalanche-sdk/interchain"; import { avalancheFuji, dispatch } from "@avalanche-sdk/interchain/chains"; // Setup wallet const account = privateKeyToAvalancheAccount("0x..."); const wallet = createAvalancheWalletClient({ account, chain: avalancheFuji, transport: { type: "http" }, }); // Create ICM client const icm = createICMClient(wallet); // Send message const hash = await icm.sendMsg({ sourceChain: avalancheFuji, destinationChain: dispatch, message: "Hello from Avalanche!", }); ``` ## What's Next # Account Management (/docs/tooling/avalanche-sdk/client/accounts) --- title: Account Management icon: users description: Learn how to create and manage accounts in the Avalanche Client SDK with support for EVM, X-Chain, and P-Chain operations. --- ## Overview Avalanche accounts work across all three chains—P-Chain, X-Chain, and C-Chain—with a single account. Each account provides both EVM addresses (for C-Chain) and XP addresses (for X/P-Chain), so you can interact with the entire Avalanche network without managing separate accounts. ## Account Structure Every Avalanche account has an EVM account for C-Chain and an optional XP account for X/P-Chain: ```typescript type AvalancheAccount = { evmAccount: Account; // C-Chain xpAccount?: XPAccount; // X/P-Chain getEVMAddress: () => Address; getXPAddress: (chain?: "X" | "P" | "C", hrp?: string) => XPAddress; }; ``` ### Quick Start ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // Get addresses for all chains const evmAddress = account.getEVMAddress(); // 0x742d35Cc... const xChainAddress = account.getXPAddress("X"); // X-avax1... const pChainAddress = account.getXPAddress("P"); // P-avax1... ``` ## Account Types ### Local Accounts Local accounts store keys on your machine and sign transactions before broadcasting. Use these for server-side apps, bots, or when you need full control. - [Private Key Accounts](accounts/local/private-key) - Simple and direct - [Mnemonic Accounts](accounts/local/mnemonic) - Easy recovery with seed phrases - [HD Key Accounts](accounts/local/hd-key) - Advanced key derivation ### JSON-RPC Accounts JSON-RPC accounts use external wallets (MetaMask, Core, etc.) for signing. Perfect for browser-based dApps where users control their own keys. [Learn more about JSON-RPC accounts →](accounts/json-rpc) ## Working with Accounts ### EVM Account The `evmAccount` handles all C-Chain operations—smart contracts, ERC-20 transfers, and standard EVM interactions. ```typescript const evmAccount = account.evmAccount; console.log(evmAccount.address); // 0x742d35Cc... ``` ### XP Account The `xpAccount` handles X-Chain and P-Chain operations—UTXO transactions, asset transfers, and staking. ```typescript if (account.xpAccount) { const xpAccount = account.xpAccount; console.log(xpAccount.publicKey); } ``` ### Getting Addresses ```typescript // C-Chain address const evmAddress = account.getEVMAddress(); // 0x742d35Cc... // X/P-Chain addresses const xChainAddress = account.getXPAddress("X"); // X-avax1... const pChainAddress = account.getXPAddress("P"); // P-avax1... // Network-specific (mainnet vs testnet) const mainnet = account.getXPAddress("X", "avax"); const testnet = account.getXPAddress("X", "fuji"); ``` ## Creating Accounts ### Private Key ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount("0x..."); ``` [Private Key Accounts →](accounts/local/private-key) ### Mnemonic ```typescript import { mnemonicsToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = mnemonicsToAvalancheAccount("abandon abandon abandon..."); ``` [Mnemonic Accounts →](accounts/local/mnemonic) ### HD Key ```typescript import { hdKeyToAvalancheAccount, HDKey } from "@avalanche-sdk/client/accounts"; const hdKey = HDKey.fromMasterSeed(seed); const account = hdKeyToAvalancheAccount(hdKey, { accountIndex: 0 }); ``` [HD Key Accounts →](accounts/local/hd-key) ## Address Formats - **C-Chain:** `0x...` (Ethereum-compatible) - **X/P-Chain:** `avax1...` or `X-avax1...` / `P-avax1...` (Bech32-encoded) [Network-Specific Addresses →](accounts/local/addresses) ## Security **Never expose private keys or mnemonics in client-side code or commit them to version control. Use environment variables.** ```typescript // ✅ Good const account = privateKeyToAvalancheAccount(process.env.PRIVATE_KEY!); // ❌ Bad const account = privateKeyToAvalancheAccount("0x1234..."); ``` ## Comparison Table | Feature | Private Key | Mnemonic | HD Key | JSON-RPC | | ----------------- | ----------- | --------- | -------- | ------------ | | **Ease of Use** | ⭐⭐⭐⭐⭐ | ⭐⭐⭐⭐ | ⭐⭐⭐ | ⭐⭐⭐⭐⭐ | | **Recovery** | ❌ | ✅ | ✅ | ❌ | | **Multi-Account** | ❌ | ✅ | ✅ | ❌ | | **Security** | ⚠️ High | ✅ High | ✅ High | ✅ Very High | | **Use Case** | Server/Bots | User Apps | Advanced | User Apps | ## Next Steps - [Private Key Accounts](accounts/local/private-key) - Simple and direct - [Mnemonic Accounts](accounts/local/mnemonic) - Easy recovery - [HD Key Accounts](accounts/local/hd-key) - Advanced key derivation - [JSON-RPC Accounts](accounts/json-rpc) - Browser wallet integration - [Account Utilities](accounts/local/utilities) - Helper functions - [Wallet Operations](methods/wallet-methods/wallet) - Send transactions # API Clients (/docs/tooling/avalanche-sdk/client/clients/api-clients) --- title: API Clients --- ## Overview API clients provide access to node-level operations. They're included with the main Avalanche Client and handle administrative tasks, node information, health monitoring, and indexed blockchain queries. ## Accessing from Avalanche Client All API clients are available on the main Avalanche Client: ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); // Admin API - Node configuration and profiling const admin = client.admin; // Info API - Node and network information const info = client.info; // Health API - Node health monitoring const health = client.health; // ProposerVM API - ProposerVM operations per chain const proposervmPChain = client.proposerVM.pChain; const proposervmXChain = client.proposerVM.xChain; const proposervmCChain = client.proposerVM.cChain; // Index API - Indexed blockchain queries const indexPChainBlock = client.indexBlock.pChain; const indexCChainBlock = client.indexBlock.cChain; const indexXChainBlock = client.indexBlock.xChain; const indexXChainTx = client.indexTx.xChain; ``` ## Admin API Client Node configuration, aliases, logging, and profiling. ### From Avalanche Client ```typescript const admin = client.admin; // Example: Set logger level await admin.setLoggerLevel({ loggerName: "C", logLevel: "DEBUG", }); ``` ### Create Standalone Client ```typescript import { createAdminApiClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const adminClient = createAdminApiClient({ chain: avalanche, transport: { type: "http", url: "https://api.avax.network/ext/admin", }, }); await adminClient.alias({ endpoint: "bc/X", alias: "myAlias", }); ``` [View all Admin API methods →](methods/public-methods/api#admin-api-client) ## Info API Client Node and network information, statistics, and status. ### From Avalanche Client ```typescript const info = client.info; // Example: Get network info const networkID = await info.getNetworkID(); const version = await info.getNodeVersion(); ``` ### Create Standalone Client ```typescript import { createInfoApiClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const infoClient = createInfoApiClient({ chain: avalanche, transport: { type: "http" }, }); const networkID = await infoClient.getNetworkID(); const version = await infoClient.getNodeVersion(); ``` [View all Info API methods →](methods/public-methods/api#info-api-client) ## Health API Client Node health monitoring and status checks. ### From Avalanche Client ```typescript const health = client.health; // Example: Check node health const status = await health.health({}); const isAlive = await health.liveness(); ``` ### Create Standalone Client ```typescript import { createHealthApiClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const healthClient = createHealthApiClient({ chain: avalanche, transport: { type: "http" }, }); const health = await healthClient.health({}); const liveness = await healthClient.liveness(); ``` [View all Health API methods →](methods/public-methods/api#health-api-client) ## ProposerVM API Client ProposerVM operations for each chain. ### From Avalanche Client ```typescript // Access ProposerVM for each chain const proposervmPChain = client.proposerVM.pChain; const proposervmXChain = client.proposerVM.xChain; const proposervmCChain = client.proposerVM.cChain; ``` ### Create Standalone Client ```typescript import { createProposervmApiClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; // P-Chain ProposerVM const proposervmPChain = createProposervmApiClient({ chain: avalanche, transport: { type: "http" }, clientType: "proposervmPChain", }); // X-Chain ProposerVM const proposervmXChain = createProposervmApiClient({ chain: avalanche, transport: { type: "http" }, clientType: "proposervmXChain", }); // C-Chain ProposerVM const proposervmCChain = createProposervmApiClient({ chain: avalanche, transport: { type: "http" }, clientType: "proposervmCChain", }); // Example: Get proposed height const pChainHeight = await proposervmPChain.getProposedHeight(); ``` ## Index API Clients Fast indexed queries for blockchain data. ### From Avalanche Client ```typescript // Block indexes const indexPChainBlock = client.indexBlock.pChain; const indexCChainBlock = client.indexBlock.cChain; const indexXChainBlock = client.indexBlock.xChain; // Transaction index const indexXChainTx = client.indexTx.xChain; // Example: Get last accepted block const lastBlock = await indexPChainBlock.getLastAccepted({ encoding: "hex", }); ``` ### Create Standalone Client ```typescript import { createIndexApiClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; // P-Chain block index const indexPChainBlock = createIndexApiClient({ chain: avalanche, transport: { type: "http" }, clientType: "indexPChainBlock", }); // C-Chain block index const indexCChainBlock = createIndexApiClient({ chain: avalanche, transport: { type: "http" }, clientType: "indexCChainBlock", }); // X-Chain block index const indexXChainBlock = createIndexApiClient({ chain: avalanche, transport: { type: "http" }, clientType: "indexXChainBlock", }); // X-Chain transaction index const indexXChainTx = createIndexApiClient({ chain: avalanche, transport: { type: "http" }, clientType: "indexXChainTx", }); // Example: Get container by index const block = await indexPChainBlock.getContainerByIndex({ index: 12345, encoding: "hex", }); ``` [View all Index API methods →](methods/public-methods/api#index-api-clients) ## Quick Examples ### Node Health Check ```typescript const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); const health = await client.health.health({}); const liveness = await client.health.liveness(); console.log("Node healthy:", health.healthy); ``` ### Get Node Information ```typescript const version = await client.info.getNodeVersion(); const networkID = await client.info.getNetworkID(); const nodeID = await client.info.getNodeID(); console.log(`Node ${nodeID.nodeID} v${version} on network ${networkID}`); ``` ### Query Indexed Blocks ```typescript const lastBlock = await client.indexBlock.pChain.getLastAccepted({ encoding: "hex", }); const block = await client.indexBlock.cChain.getContainerByIndex({ index: 12345, encoding: "hex", }); ``` ## When to Use - **Admin API**: Node configuration, profiling, logging (requires admin access) - **Info API**: Node and network information - **Health API**: Health monitoring and status checks - **Index API**: Fast indexed queries for blocks and transactions - **ProposerVM API**: ProposerVM operations per chain **Note:** Admin API operations require administrative access and may not be available on public endpoints. ## Next Steps - **[API Methods Reference](methods/public-methods/api)** - Complete method documentation - **[Avalanche Client](clients/avalanche-client)** - Main client operations - **[Wallet Client](clients/wallet-client)** - Transaction operations # Avalanche Client (/docs/tooling/avalanche-sdk/client/clients/avalanche-client) --- title: Avalanche Client --- ## Overview The Avalanche Client (also known as the Public Client) is the main client for read-only operations across all Avalanche chains. It provides a unified interface for querying data from P-Chain, X-Chain, C-Chain, and various API endpoints. **When to use:** Use the Avalanche Client when you need to query blockchain data but don't need to send transactions. ## Installation & Setup For setup instructions, see the [Getting Started](/avalanche-sdk/client-sdk/getting-started) guide. ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); ``` ## Available Clients The Avalanche Client automatically provides access to all chain-specific and API clients: ```typescript // Chain clients client.pChain; // P-Chain operations (validators, staking, subnets) client.xChain; // X-Chain operations (assets, UTXOs) client.cChain; // C-Chain operations (EVM, atomic transactions) // API clients client.admin; // Admin API operations client.info; // Info API operations client.health; // Health API operations client.proposerVM.pChain; // ProposerVM API for P Chain client.proposerVM.xChain; // ProposerVM API for X Chain client.proposerVM.cChain; // ProposerVM API for C Chain client.indexBlock.pChain; // P-Chain block index client.indexBlock.cChain; // C-Chain block index client.indexBlock.xChain; // X-Chain block index client.indexTx.xChain; // X-Chain transaction index ``` ## Available Methods The Avalanche Client extends viem's Public Client and provides additional Avalanche-specific methods: ### Avalanche-Specific Methods - **Public Methods**: `baseFee`, `getChainConfig`, `maxPriorityFeePerGas`, `feeConfig`, `getActiveRulesAt` For complete documentation, see [Public Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/public). ### Chain-Specific Methods Access methods through chain clients: - **P-Chain Methods**: See [P-Chain Client](/avalanche-sdk/client-sdk/clients/p-chain-client) and [P-Chain Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/p-chain) - **X-Chain Methods**: See [X-Chain Client](/avalanche-sdk/client-sdk/clients/x-chain-client) and [X-Chain Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/x-chain) - **C-Chain Methods**: See [C-Chain Client](/avalanche-sdk/client-sdk/clients/c-chain-client) and [C-Chain Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/c-chain) ### viem Public Client Methods The client extends viem's Public Client, providing access to all standard EVM actions: - `getBalance`, `getBlock`, `getBlockNumber`, `getTransaction`, `getTransactionReceipt` - `readContract`, `call`, `estimateGas`, `getCode`, `getStorageAt` - And many more... See the [viem documentation](https://viem.sh/docs/getting-started) for all available EVM actions. ## Common Operations ### Query P-Chain Data ```typescript // Get current block height const height = await client.pChain.getHeight(); // Get current validators const validators = await client.pChain.getCurrentValidators({ subnetID: "11111111111111111111111111111111LpoYY", }); // Get subnet information const subnet = await client.pChain.getSubnet({ subnetID: "11111111111111111111111111111111LpoYY", }); // Get balance const balance = await client.pChain.getBalance({ addresses: ["P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p"], }); ``` ### Query X-Chain Data ```typescript // Get balance for specific asset const balance = await client.xChain.getBalance({ addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], assetID: "AVAX", }); // Get all balances const allBalances = await client.xChain.getAllBalances({ addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], }); // Get asset information const asset = await client.xChain.getAssetDescription({ assetID: "FvwEAhmxKfeiG8SnEvq42hc6whRyY3EFYAvebMqDNDGCgxN5Z", }); ``` ### Query C-Chain Data ```typescript // Get EVM balance (viem action) const balance = await client.getBalance({ address: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", }); // Get transaction receipt (viem action) const receipt = await client.getTransactionReceipt({ hash: "0x...", }); // Get base fee (Avalanche-specific) const baseFee = await client.baseFee(); // Get chain config const chainConfig = await client.getChainConfig(); // Get atomic transaction const atomicTx = await client.cChain.getAtomicTx({ txID: "2QouvMUbQ6oy7yQ9tLvL3L8tGQG2QK1wJ1q1wJ1q1wJ1q1wJ1q1wJ1q1wJ1", }); ``` ### Query API Data ```typescript // Admin API - Get peers const peers = await client.admin.getPeers(); // Info API - Get node version const version = await client.info.getNodeVersion(); // Health API - Get health status const health = await client.health.health(); // Index API - Get block by index const block = await client.indexPChainBlock.getContainerByIndex({ index: 12345, }); ``` ## Error Handling Always handle errors appropriately: ```typescript import { BaseError } from "viem"; try { const balance = await client.getBalance({ address: "0x...", }); } catch (error) { if (error instanceof BaseError) { console.error("RPC Error:", error.message); } else { console.error("Unknown error:", error); } } ``` ## When to Use This Client - ✅ Querying blockchain data - ✅ Reading balances and transaction history - ✅ Checking validator information - ✅ Monitoring network status - ✅ Inspecting smart contract state **Don't use this client for:** - ❌ Sending transactions (use [Wallet Client](/avalanche-sdk/client-sdk/clients/wallet-client)) - ❌ Signing messages (use [Wallet Client](/avalanche-sdk/client-sdk/clients/wallet-client)) - ❌ Cross-chain transfers (use [Wallet Client](/avalanche-sdk/client-sdk/clients/wallet-client)) ## Best Practices ### Use Specific Clients ```typescript // Good: Use P-Chain client for platform operations const validators = await client.pChain.getCurrentValidators({}); // Good: Use X-Chain client for asset operations const balance = await client.xChain.getBalance({ addresses: ["X-avax..."], assetID: "AVAX", }); // Good: Use C-Chain client for EVM operations const atomicTx = await client.cChain.getAtomicTx({ txID: "0x...", }); ``` ### Using viem Actions Since the Avalanche Client extends viem's Public Client, you have access to all viem actions: ```typescript // Use viem's readContract action const result = await client.readContract({ address: "0x...", abi: contractABI, functionName: "balanceOf", args: ["0x..."], }); // Use viem's getTransaction action const tx = await client.getTransaction({ hash: "0x...", }); // Use viem's estimateGas action const gas = await client.estimateGas({ to: "0x...", value: parseEther("0.001"), }); ``` See the [viem documentation](https://viem.sh/docs/getting-started) for all available actions. ## Next Steps - **[Wallet Client](/avalanche-sdk/client-sdk/clients/wallet-client)** - Transaction signing and sending - **[P-Chain Client](/avalanche-sdk/client-sdk/clients/p-chain-client)** - Detailed P-Chain operations - **[X-Chain Client](/avalanche-sdk/client-sdk/clients/x-chain-client)** - Asset and UTXO operations - **[C-Chain Client](/avalanche-sdk/client-sdk/clients/c-chain-client)** - EVM and atomic operations - **[Public Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/public)** - Complete public method documentation # C-Chain Client (/docs/tooling/avalanche-sdk/client/clients/c-chain-client) --- title: C-Chain Client --- ## Overview The C-Chain (Contract Chain) Client provides an interface for interacting with Avalanche's Contract Chain, which is an instance of the Ethereum Virtual Machine (EVM) with additional Avalanche-specific features like cross-chain atomic transactions. **When to use:** Use the C-Chain Client for EVM operations and atomic transactions (cross-chain transfers). ## Installation & Setup For setup instructions, see the [Getting Started](/avalanche-sdk/client-sdk/getting-started) guide. ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); const cChainClient = client.cChain; ``` Or create a standalone C-Chain client: ```typescript import { createCChainClient } from "@avalanche-sdk/client"; const cChainClient = createCChainClient({ chain: avalanche, transport: { type: "http" }, }); ``` ## Available Methods The C-Chain Client provides methods for: - **Atomic Transaction Operations**: `getAtomicTx`, `getAtomicTxStatus` - **UTXO Operations**: `getUTXOs` - **Transaction Operations**: `issueTx` Additionally, the C-Chain Client extends viem's Public Client, providing access to all standard EVM actions such as `getBalance`, `getBlock`, `readContract`, `call`, and more. For complete method documentation with signatures, parameters, and examples, see the [C-Chain Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/c-chain). ## Common Use Cases ### Query Atomic Transactions ```typescript // Get atomic transaction details const atomicTx = await client.cChain.getAtomicTx({ txID: "2QouvMUbQ6oy7yQ9tLvL3L8tGQG2QK1wJ1q1wJ1q1wJ1q1wJ1q1wJ1q1wJ1", }); console.log("Source chain:", atomicTx.sourceChain); console.log("Destination chain:", atomicTx.destinationChain); console.log("Transfers:", atomicTx.transfers); // Get atomic transaction status const status = await client.cChain.getAtomicTxStatus({ txID: "2QouvMUbQ6oy7yQ9tLvL3L8tGQG2QK1wJ1q1wJ1q1wJ1q1wJ1q1wJ1q1wJ1", }); console.log("Status:", status.status); ``` ### Query UTXOs ```typescript // Get UTXOs for C-Chain addresses const utxos = await client.cChain.getUTXOs({ addresses: ["0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6"], limit: 100, }); console.log("Number of UTXOs:", utxos.utxos.length); ``` ## Using viem Actions The C-Chain Client extends viem's Public Client, so you have access to all standard EVM actions: ```typescript // Get EVM balance const balance = await client.getBalance({ address: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", }); // Get transaction receipt const receipt = await client.getTransactionReceipt({ hash: "0x...", }); // Get block number const blockNumber = await client.getBlockNumber(); // Read smart contract const result = await client.readContract({ address: "0x...", abi: contractABI, functionName: "balanceOf", args: ["0x..."], }); // Get block information const block = await client.getBlock({ blockNumber: blockNumber, }); ``` See the [viem documentation](https://viem.sh/docs/getting-started) for all available EVM actions. ## Wallet Operations For transaction operations (sending transactions, writing contracts), use the wallet client: ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { parseEther } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // Send AVAX const txHash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", value: parseEther("0.001"), }); console.log("Transaction hash:", txHash); ``` ### Cross-Chain Operations ```typescript // Export from C-Chain to P-Chain const exportTx = await walletClient.cChain.prepareExportTxn({ destinationChain: "P", to: account.getXPAddress("P"), amount: "0.001", }); const exportTxHash = await walletClient.sendXPTransaction(exportTx); console.log("Export transaction:", exportTxHash); // Import to C-Chain from P-Chain const importTx = await walletClient.cChain.prepareImportTxn({ to: account.getEVMAddress(), amount: "0.001", sourceChain: "P", }); const importTxHash = await walletClient.sendXPTransaction(importTx); console.log("Import transaction:", importTxHash); ``` For complete wallet operations documentation, see [C-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/c-chain-wallet). ## Next Steps - **[C-Chain Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/c-chain)** - Complete method documentation - **[C-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/c-chain-wallet)** - Transaction preparation and sending - **[Wallet Client](/avalanche-sdk/client-sdk/clients/wallet-client)** - Complete wallet operations - **[P-Chain Client](/avalanche-sdk/client-sdk/clients/p-chain-client)** - Validator operations - **[X-Chain Client](/avalanche-sdk/client-sdk/clients/x-chain-client)** - Asset operations # Clients (/docs/tooling/avalanche-sdk/client/clients) --- title: Clients --- ## Overview The SDK provides different client types for interacting with Avalanche. Each client is optimized for specific use cases. ## Client Architecture ```typescript Avalanche Client (Public) ├── P-Chain Client ├── X-Chain Client ├── C-Chain Client ├── Admin API Client ├── Info API Client ├── Health API Client ├── ProposerVM Client └── Index API Clients Avalanche Wallet Client ├── All Public Client Methods ├── P-Chain Wallet Operations ├── X-Chain Wallet Operations ├── C-Chain Wallet Operations └── ERC20 Token Operations ``` ## Client Types ### Main Clients - **[Avalanche Client](clients/avalanche-client)** - Read-only operations for all chains - **[Avalanche Wallet Client](clients/wallet-client)** - Transaction signing and sending ### Chain-Specific Clients - **[P-Chain Client](clients/p-chain-client)** - Validator and staking operations - **[X-Chain Client](clients/x-chain-client)** - Asset transfers and UTXO operations - **[C-Chain Client](clients/c-chain-client)** - EVM and atomic transaction operations ### API Clients - **[Admin API Client](clients/api-clients#admin-api-client)** - Administrative node operations - **[Info API Client](clients/api-clients#info-api-client)** - Node information and network statistics - **[Health API Client](clients/api-clients#health-api-client)** - Node health monitoring - **[ProposerVM Client](clients/api-clients#proposervm-client)** - ProposerVM operations - **[Index API Clients](clients/api-clients#index-api-clients)** - Indexed blockchain data queries ## Configuration All clients accept a common configuration: ```typescript interface AvalancheClientConfig { transport: Transport; // Required: HTTP, WebSocket, or Custom chain?: Chain; // Optional: Network configuration account?: Account | Address; // Optional: For wallet operations apiKey?: string; // Optional: For authenticated endpoints rlToken?: string; // Optional: Rate limit token key?: string; // Optional: Client key identifier name?: string; // Optional: Client name pollingInterval?: number; // Optional: Polling interval in ms (default: chain.blockTime / 3) cacheTime?: number; // Optional: Cache time in ms (default: chain.blockTime / 3) batch?: { multicall?: boolean | MulticallBatchOptions }; // Optional: Batch settings ccipRead?: | { request?: ( params: CcipRequestParameters ) => Promise; } | false; // Optional: CCIP Read config experimental_blockTag?: BlockTag; // Optional: Default block tag (default: 'latest') rpcSchema?: RpcSchema; // Optional: Typed JSON-RPC schema type?: string; // Optional: Client type } ``` ### Configuration Options | Option | Type | Required | Default | Description | | ----------------- | -------------------- | -------- | --------------------- | ------------------------------------------------- | | `transport` | `Transport` | ✅ Yes | - | Transport configuration (HTTP, WebSocket, Custom) | | `chain` | `Chain` | No | - | Network configuration (mainnet/testnet) | | `account` | `Account \| Address` | No | - | Account for signing operations | | `apiKey` | `string` | No | - | API key for authenticated endpoints | | `rlToken` | `string` | No | - | Rate limit token | | `key` | `string` | No | - | Client key identifier | | `name` | `string` | No | - | Client name | | `pollingInterval` | `number` | No | `chain.blockTime / 3` | Polling interval in milliseconds | | `cacheTime` | `number` | No | `chain.blockTime / 3` | Cache time in milliseconds | | `batch` | `object` | No | - | Batch settings (multicall configuration) | | `ccipRead` | `object \| false` | No | - | CCIP Read configuration | | `rpcSchema` | `RpcSchema` | No | - | Typed JSON-RPC schema | | `type` | `string` | No | - | Client type identifier | ## Usage Examples ### Public Client ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); // Read data from all chains const pHeight = await client.pChain.getHeight(); const balance = await client.getBalance({ address: "0x..." }); ``` ### Wallet Client ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avalanche } from "@avalanche-sdk/client/chains"; import { avaxToWei } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // Send transaction const txHash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: avaxToWei(0.001), }); ``` ### Accessing Sub-Clients ```typescript const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); // Chain clients client.pChain; // P-Chain operations client.xChain; // X-Chain operations client.cChain; // C-Chain operations // API clients client.admin; // Admin API client.info; // Info API client.health; // Health API client.proposerVM.pChain; // ProposerVM API for P Chain client.proposerVM.xChain; // ProposerVM API for X Chain client.proposerVM.cChain; // ProposerVM API for C Chain client.indexBlock.pChain; // P-Chain block index client.indexBlock.cChain; // C-Chain block index client.indexBlock.xChain; // X-Chain block index client.indexTx.xChain; // X-Chain transaction index ``` ## Next Steps - **[Avalanche Client](clients/avalanche-client)** - Read-only operations - **[Avalanche Wallet Client](clients/wallet-client)** - Transaction operations - **[Chain-Specific Clients](clients/p-chain-client)** - P, X, and C-Chain clients - **[API Clients](clients/api-clients)** - Admin, Info, Health, ProposerVM, and Index APIs # P-Chain Client (/docs/tooling/avalanche-sdk/client/clients/p-chain-client) --- title: P-Chain Client --- ## Overview The P-Chain (Platform Chain) Client provides an interface for interacting with Avalanche's Platform Chain, which is responsible for coordinating validators, managing subnets, creating blockchains, and handling staking operations. **When to use:** Use the P-Chain Client for validator operations, staking, subnet management, and blockchain creation. ## Installation & Setup For setup instructions, see the [Getting Started](/avalanche-sdk/client-sdk/getting-started) guide. ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); const pChainClient = client.pChain; ``` Or create a standalone P-Chain client: ```typescript import { createPChainClient } from "@avalanche-sdk/client"; const pChainClient = createPChainClient({ chain: avalanche, transport: { type: "http" }, }); ``` ## Available Methods The P-Chain Client provides methods for: - **Balance Operations**: `getBalance`, `getUTXOs` - **Validator Operations**: `getCurrentValidators`, `getValidatorsAt`, `sampleValidators`, `getL1Validator` - **Staking Operations**: `getStake`, `getTotalStake`, `getMinStake` - **Subnet Operations**: `getSubnet`, `getSubnets`, `getStakingAssetID` - **Blockchain Operations**: `getBlockchains`, `getBlockchainStatus`, `validatedBy`, `validates` - **Block Operations**: `getHeight`, `getBlock`, `getBlockByHeight`, `getProposedHeight`, `getTimestamp` - **Transaction Operations**: `getTx`, `getTxStatus`, `issueTx` - **Fee Operations**: `getFeeConfig`, `getFeeState` - **Supply Operations**: `getCurrentSupply` - **Reward Operations**: `getRewardUTXOs` For complete method documentation with signatures, parameters, and examples, see the [P-Chain Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/p-chain). ## Common Use Cases ### Query Validators ```typescript // Get current validators const validators = await client.pChain.getCurrentValidators({}); console.log("Total validators:", validators.validators.length); // Get validators at specific height const validatorsAt = await client.pChain.getValidatorsAt({ height: 1000001, subnetID: "11111111111111111111111111111111LpoYY", }); ``` ### Query Staking Information ```typescript // Get minimum stake requirements const minStake = await client.pChain.getMinStake({ subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Min validator stake:", minStake.minValidatorStake); console.log("Min delegator stake:", minStake.minDelegatorStake); // Get total stake for a subnet const totalStake = await client.pChain.getTotalStake({ subnetID: "11111111111111111111111111111111LpoYY", }); // Get stake for specific addresses const stake = await client.pChain.getStake({ addresses: ["P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p"], subnetID: "11111111111111111111111111111111LpoYY", }); ``` ### Query Subnet Information ```typescript // Get subnet information const subnet = await client.pChain.getSubnet({ subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Is permissioned:", subnet.isPermissioned); console.log("Control keys:", subnet.controlKeys); // Get all blockchains in the network const blockchains = await client.pChain.getBlockchains(); // Get blockchains validated by a subnet const validatedBlockchains = await client.pChain.validates({ subnetID: "11111111111111111111111111111111LpoYY", }); ``` ### Query Balance and UTXOs ```typescript // Get balance for addresses const balance = await client.pChain.getBalance({ addresses: ["P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p"], }); console.log("Total balance:", balance.balance); console.log("Unlocked:", balance.unlocked); // Get UTXOs const utxos = await client.pChain.getUTXOs({ addresses: ["P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p"], limit: 100, }); ``` ### Query Fee Information ```typescript // Get fee configuration const feeConfig = await client.pChain.getFeeConfig(); console.log("Fee weights:", feeConfig.weights); console.log("Min price:", feeConfig.minPrice); // Get current fee state const feeState = await client.pChain.getFeeState(); console.log("Current fee price:", feeState.price); console.log("Fee capacity:", feeState.capacity); ``` ## Wallet Operations For transaction operations (preparing and sending transactions), use the wallet client: ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // Prepare and send base transaction const baseTxn = await walletClient.pChain.prepareBaseTxn({ outputs: [ { addresses: [account.getXPAddress("P")], amount: 0.00001, }, ], }); const txID = await walletClient.sendXPTransaction(baseTxn); console.log("Transaction sent:", txID); ``` For complete wallet operations documentation, see [P-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/p-chain-wallet). ## Next Steps - **[P-Chain Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/p-chain)** - Complete method documentation - **[P-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/p-chain-wallet)** - Transaction preparation and signing - **[Wallet Client](/avalanche-sdk/client-sdk/clients/wallet-client)** - Complete wallet operations - **[X-Chain Client](/avalanche-sdk/client-sdk/clients/x-chain-client)** - Asset transfers - **[C-Chain Client](/avalanche-sdk/client-sdk/clients/c-chain-client)** - EVM operations # Avalanche Wallet Client (/docs/tooling/avalanche-sdk/client/clients/wallet-client) --- title: Avalanche Wallet Client --- ## Overview The Avalanche Wallet Client extends the Public Client with full transaction signing and sending capabilities. It enables cross-chain operations, atomic transactions, and comprehensive wallet management across all Avalanche chains. **When to use:** Use the Wallet Client when you need to sign and send transactions, sign messages, or manage accounts. ## Installation & Setup For setup instructions, see the [Getting Started](/avalanche-sdk/client-sdk/getting-started) guide. ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, // Hoist the account, otherwise we can pass a custom provider for injected provider or pass a account for each method chain: avalanche, transport: { type: "http" }, }); ``` ## Available Wallet Operations The Wallet Client provides access to: ```typescript // Chain wallet operations walletClient.pChain; // P-Chain wallet operations walletClient.xChain; // X-Chain wallet operations walletClient.cChain; // C-Chain wallet operations // Core wallet methods walletClient.send(); // Send transactions walletClient.sendXPTransaction(); // Send XP transactions walletClient.signXPMessage(); // Sign XP messages walletClient.signXPTransaction(); // Sign XP transactions walletClient.waitForTxn(); // Wait for transaction confirmation walletClient.getAccountPubKey(); // Get account public key ``` For complete method documentation, see: - **[Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/wallet)** - Core wallet operations - **[P-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/p-chain-wallet)** - P-Chain transactions - **[X-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/x-chain-wallet)** - X-Chain transactions - **[C-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/c-chain-wallet)** - C-Chain transactions ## Common Operations ### Send AVAX on C-Chain ```typescript import { avaxToNanoAvax } from "@avalanche-sdk/client/utils"; const hash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", value: avaxToNanoAvax(0.001), // 0.001 AVAX }); console.log("Transaction hash:", hash); ``` ### P-Chain Wallet Operations ```typescript // Prepare and send base transaction const baseTxn = await walletClient.pChain.prepareBaseTxn({ outputs: [ { addresses: [account.getXPAddress("P")], amount: avaxToNanoAvax(0.00001), }, ], }); const txID = await walletClient.sendXPTransaction(baseTxn); console.log("P-Chain transaction:", txID); ``` ### X-Chain Wallet Operations ```typescript // Prepare and send base transaction const xChainTx = await walletClient.xChain.prepareBaseTxn({ outputs: [ { addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], amount: avaxToNanoAvax(1), // 1 AVAX }, ], }); const txID = await walletClient.sendXPTransaction(xChainTx); console.log("X-Chain transaction:", txID); ``` ### Sign Messages ```typescript // Sign XP message const signedMessage = await walletClient.signXPMessage({ message: "Hello Avalanche", }); console.log("Signed message:", signedMessage); ``` ### Wait for Transaction Confirmation ```typescript try { await walletClient.waitForTxn({ txID: "0x...", chainAlias: "P", }); console.log("Transaction confirmed!"); } catch (error) { console.error("chain confirmation failed:", error); } ``` ## When to Use This Client - ✅ Sending transactions - ✅ Signing messages and transactions - ✅ Cross-chain transfers - ✅ Managing accounts - ✅ All wallet operations ## Next Steps - **[Wallet Methods Reference](/avalanche-sdk/client-sdk/methods/wallet-methods/wallet)** - Complete wallet method documentation - **[P-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/p-chain-wallet)** - P-Chain transaction operations - **[X-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/x-chain-wallet)** - X-Chain transaction operations - **[C-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/c-chain-wallet)** - C-Chain transaction operations - **[Account Management](/avalanche-sdk/client-sdk/accounts)** - Account types and management # X-Chain Client (/docs/tooling/avalanche-sdk/client/clients/x-chain-client) --- title: X-Chain Client --- ## Overview The X-Chain (Exchange Chain) Client provides an interface for interacting with Avalanche's Exchange Chain, which handles asset creation, trading, transfers, and UTXO management. **When to use:** Use the X-Chain Client for asset operations, UTXO management, and X-Chain transaction queries. ## Installation & Setup For setup instructions, see the [Getting Started](/avalanche-sdk/client-sdk/getting-started) guide. ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); const xChainClient = client.xChain; ``` Or create a standalone X-Chain client: ```typescript import { createXChainClient } from "@avalanche-sdk/client"; const xChainClient = createXChainClient({ chain: avalanche, transport: { type: "http" }, }); ``` ## Available Methods The X-Chain Client provides methods for: - **Balance Operations**: `getBalance`, `getAllBalances` - **Asset Operations**: `getAssetDescription`, `buildGenesis` - **UTXO Operations**: `getUTXOs` - **Block Operations**: `getHeight`, `getBlock`, `getBlockByHeight` - **Transaction Operations**: `getTx`, `getTxStatus`, `getTxFee`, `issueTx` For complete method documentation with signatures, parameters, and examples, see the [X-Chain Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/x-chain). ## Common Use Cases ### Query Balances ```typescript // Get balance for specific asset const balance = await client.xChain.getBalance({ addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], assetID: "AVAX", }); console.log("Balance:", balance.balance); // Get all balances for all assets const allBalances = await client.xChain.getAllBalances({ addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], }); console.log("All balances:", allBalances.balances); ``` ### Query Asset Information ```typescript // Get asset description const asset = await client.xChain.getAssetDescription({ assetID: "FvwEAhmxKfeiG8SnEvq42hc6whRyY3EFYAvebMqDNDGCgxN5Z", }); console.log("Asset name:", asset.name); console.log("Asset symbol:", asset.symbol); console.log("Denomination:", asset.denomination); ``` ### Query UTXOs ```typescript // Get UTXOs for address const utxos = await client.xChain.getUTXOs({ addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], sourceChain: "P", // Optional: specify source chain limit: 100, }); console.log("Number of UTXOs:", utxos.utxos.length); // Paginate through UTXOs if needed if (utxos.endIndex) { const moreUtxos = await client.xChain.getUTXOs({ addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], startIndex: utxos.endIndex, limit: 100, }); } ``` ### Query Transaction Information ```typescript // Get transaction const tx = await client.xChain.getTx({ txID: "11111111111111111111111111111111LpoYY", encoding: "hex", }); // Get transaction status const status = await client.xChain.getTxStatus({ txID: "11111111111111111111111111111111LpoYY", }); console.log("Transaction status:", status.status); // Get transaction fees const txFee = await client.xChain.getTxFee(); console.log("Transaction fee:", txFee.txFee); console.log("Create asset fee:", txFee.createAssetTxFee); ``` ### Query Block Information ```typescript // Get current height const height = await client.xChain.getHeight(); console.log("Current X-Chain height:", height); // Get block by height const block = await client.xChain.getBlockByHeight({ height: Number(height), encoding: "hex", }); // Get block by ID const blockById = await client.xChain.getBlock({ blockID: "d7WYmb8VeZNHsny3EJCwMm6QA37s1EHwMxw1Y71V3FqPZ5EFG", encoding: "hex", }); ``` ## Wallet Operations For transaction operations (preparing and sending transactions), use the wallet client: ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // Prepare and send base transaction const baseTxn = await walletClient.xChain.prepareBaseTxn({ outputs: [ { addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], amount: 1, // 1 AVAX }, ], }); const txID = await walletClient.sendXPTransaction(baseTxn); console.log("Transaction sent:", txID); ``` For complete wallet operations documentation, see [X-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/x-chain-wallet). ## Next Steps - **[X-Chain Methods Reference](/avalanche-sdk/client-sdk/methods/public-methods/x-chain)** - Complete method documentation - **[X-Chain Wallet Methods](/avalanche-sdk/client-sdk/methods/wallet-methods/x-chain-wallet)** - Transaction preparation and signing - **[Wallet Client](/avalanche-sdk/client-sdk/clients/wallet-client)** - Complete wallet operations - **[P-Chain Client](/avalanche-sdk/client-sdk/clients/p-chain-client)** - Validator and staking operations - **[C-Chain Client](/avalanche-sdk/client-sdk/clients/c-chain-client)** - EVM operations # Utilities (/docs/tooling/avalanche-sdk/client/utils) --- title: "Utilities" icon: "tools" --- ## Overview The Avalanche SDK provides utility functions for AVAX unit conversion, CB58 encoding/decoding, transaction serialization, and UTXO operations. All viem utilities are also re-exported for EVM operations. **Note:** All utility functions are synchronous unless marked as `async`. Handle errors appropriately when working with blockchain data. ## Importing Utilities Import utilities from `@avalanche-sdk/client/utils`: ```typescript import { // AVAX conversions avaxToNanoAvax, nanoAvaxToAvax, avaxToWei, weiToAvax, weiToNanoAvax, nanoAvaxToWei, // CB58 encoding CB58ToHex, hexToCB58, // Transaction serialization getTxFromBytes, getUnsignedTxFromBytes, // UTXO operations getUtxoFromBytes, getUtxosForAddress, buildUtxoBytes, } from "@avalanche-sdk/client/utils"; // Viem utilities are also available import { hexToBytes, bytesToHex, isAddress } from "@avalanche-sdk/client/utils"; ``` ## AVAX Unit Conversion Avalanche uses different units for different chains: - **AVAX**: Human-readable unit (1 AVAX) - **nanoAVAX (nAVAX)**: Smallest unit on P-Chain and X-Chain and C-Chain atomics (1 AVAX = 10^9 nAVAX) - **wei**: Used on C-Chain (1 AVAX = 10^18 wei) ### avaxToNanoAvax Converts AVAX to nanoAVAX for P-Chain/X-Chain or C-Chain Atomic operations. **Function Signature:** ```typescript function avaxToNanoAvax(amount: number): bigint; ``` **Parameters:** | Name | Type | Required | Description | | -------- | -------- | -------- | -------------- | | `amount` | `number` | Yes | Amount in AVAX | **Returns:** | Type | Description | | -------- | ------------------ | | `bigint` | Amount in nanoAVAX | **Example:** ```typescript import { avaxToNanoAvax } from "@avalanche-sdk/client/utils"; const nanoAvax = avaxToNanoAvax(1.5); console.log(nanoAvax); // 1500000000n // Use in P-Chain transaction const tx = await walletClient.pChain.prepareBaseTxn({ outputs: [ { addresses: ["P-avax1..."], amount: Number(nanoAvax), }, ], }); ``` ### nanoAvaxToAvax Converts nanoAVAX back to AVAX for display purposes. **Function Signature:** ```typescript function nanoAvaxToAvax(amount: bigint): number; ``` **Parameters:** | Name | Type | Required | Description | | -------- | -------- | -------- | ------------------ | | `amount` | `bigint` | Yes | Amount in nanoAVAX | **Returns:** | Type | Description | | -------- | -------------- | | `number` | Amount in AVAX | **Example:** ```typescript import { nanoAvaxToAvax } from "@avalanche-sdk/client/utils"; const balance = await walletClient.pChain.getBalance({ addresses: ["P-avax1..."], }); const avax = nanoAvaxToAvax(BigInt(balance.balance || 0)); console.log(`Balance: ${avax} AVAX`); ``` ### avaxToWei Converts AVAX to wei for C-Chain operations. **Function Signature:** ```typescript function avaxToWei(amount: number): bigint; ``` **Parameters:** | Name | Type | Required | Description | | -------- | -------- | -------- | -------------- | | `amount` | `number` | Yes | Amount in AVAX | **Returns:** | Type | Description | | -------- | ------------- | | `bigint` | Amount in wei | **Example:** ```typescript import { avaxToWei } from "@avalanche-sdk/client/utils"; const wei = avaxToWei(1.5); console.log(wei); // 1500000000000000000n // Use in C-Chain transaction const txHash = await walletClient.cChain.sendTransaction({ to: "0x...", value: wei, }); ``` ### weiToAvax Converts wei back to AVAX for display. **Function Signature:** ```typescript function weiToAvax(amount: bigint): bigint; ``` **Parameters:** | Name | Type | Required | Description | | -------- | -------- | -------- | ------------- | | `amount` | `bigint` | Yes | Amount in wei | **Returns:** | Type | Description | | -------- | -------------------------- | | `bigint` | Amount in AVAX (as bigint) | **Example:** ```typescript import { weiToAvax } from "@avalanche-sdk/client/utils"; const balance = await walletClient.cChain.getBalance({ address: "0x...", }); const avax = weiToAvax(balance); console.log(`Balance: ${avax} AVAX`); ``` ### weiToNanoAvax Converts wei to nanoAVAX for cross-chain operations. **Function Signature:** ```typescript function weiToNanoAvax(amount: bigint): bigint; ``` **Parameters:** | Name | Type | Required | Description | | -------- | -------- | -------- | ------------- | | `amount` | `bigint` | Yes | Amount in wei | **Returns:** | Type | Description | | -------- | ------------------ | | `bigint` | Amount in nanoAVAX | **Example:** ```typescript import { weiToNanoAvax } from "@avalanche-sdk/client/utils"; const cChainBalance = await walletClient.cChain.getBalance({ address: "0x...", }); // Convert to nanoAVAX for P-Chain transfer const nanoAvax = weiToNanoAvax(cChainBalance); ``` ### nanoAvaxToWei Converts nanoAVAX to wei for cross-chain operations. **Function Signature:** ```typescript function nanoAvaxToWei(amount: bigint): bigint; ``` **Parameters:** | Name | Type | Required | Description | | -------- | -------- | -------- | ------------------ | | `amount` | `bigint` | Yes | Amount in nanoAVAX | **Returns:** | Type | Description | | -------- | ------------- | | `bigint` | Amount in wei | **Example:** ```typescript import { nanoAvaxToWei } from "@avalanche-sdk/client/utils"; const pChainBalance = await walletClient.pChain.getBalance({ addresses: ["P-avax1..."], }); // Convert to wei for C-Chain transfer const wei = nanoAvaxToWei(BigInt(pChainBalance.balance || 0)); ``` ## CB58 Encoding/Decoding CB58 is Avalanche's base58 encoding format used for transaction IDs, asset IDs, and addresses. ### CB58ToHex Converts CB58-encoded strings to hexadecimal format. **Function Signature:** ```typescript function CB58ToHex(cb58: string): Hex; ``` **Parameters:** | Name | Type | Required | Description | | ------ | -------- | -------- | ------------------- | | `cb58` | `string` | Yes | CB58 encoded string | **Returns:** | Type | Description | | ----- | ----------------------------------- | | `Hex` | Hexadecimal string with `0x` prefix | **Example:** ```typescript import { CB58ToHex } from "@avalanche-sdk/client/utils"; const txId = "mYxFK3CWs6iMFFaRx4wmVLDUtnktzm2o9Mhg9AG6JSzRijy5V"; const hex = CB58ToHex(txId); console.log(hex); // 0x... // Use with hex-based APIs const tx = await client.pChain.getAtomicTx({ txID: hex }); ``` ### hexToCB58 Converts hexadecimal strings to CB58 format. **Function Signature:** ```typescript function hexToCB58(hex: Hex): string; ``` **Parameters:** | Name | Type | Required | Description | | ----- | ----- | -------- | ----------------------------------- | | `hex` | `Hex` | Yes | Hexadecimal string with `0x` prefix | **Returns:** | Type | Description | | -------- | ------------------- | | `string` | CB58 encoded string | **Example:** ```typescript import { hexToCB58 } from "@avalanche-sdk/client/utils"; const hex = "0x1234567890abcdef"; const cb58 = hexToCB58(hex); console.log(cb58); // CB58 encoded string ``` ## Transaction Serialization ### getTxFromBytes Parses signed transaction bytes to extract the transaction and credentials. **Function Signature:** ```typescript function getTxFromBytes( txBytes: string, chainAlias: "P" | "X" | "C" ): [Common.Transaction, Credential[]]; ``` **Parameters:** | Name | Type | Required | Description | | ------------ | ------------------- | -------- | ------------------------------- | | `txBytes` | `string` | Yes | Transaction bytes as hex string | | `chainAlias` | `"P" \| "X" \| "C"` | Yes | Chain alias | **Returns:** | Type | Description | | ------------------------------------ | -------------------------------------------------- | | `[Common.Transaction, Credential[]]` | Tuple containing transaction and credentials array | **Example:** ```typescript import { getTxFromBytes } from "@avalanche-sdk/client/utils"; const txHex = "0x1234567890abcdef..."; const [tx, credentials] = getTxFromBytes(txHex, "P"); console.log("Transaction ID:", tx.getId().toString()); console.log("Signatures:", credentials.length); ``` ### getUnsignedTxFromBytes Parses unsigned transaction bytes to get an unsigned transaction object. **Function Signature:** ```typescript function getUnsignedTxFromBytes( txBytes: string, chainAlias: "P" | "X" | "C" ): UnsignedTx; ``` **Parameters:** | Name | Type | Required | Description | | ------------ | ------------------- | -------- | ------------------------------- | | `txBytes` | `string` | Yes | Transaction bytes as hex string | | `chainAlias` | `"P" \| "X" \| "C"` | Yes | Chain alias | **Returns:** | Type | Description | | ------------ | ---------------------------------- | | `UnsignedTx` | Parsed unsigned transaction object | **Example:** ```typescript import { getUnsignedTxFromBytes } from "@avalanche-sdk/client/utils"; const txHex = "0x1234567890abcdef..."; const unsignedTx = getUnsignedTxFromBytes(txHex, "P"); console.log("Transaction ID:", unsignedTx.txID); console.log("Transaction bytes:", unsignedTx.toBytes()); ``` ## UTXO Operations ### getUtxoFromBytes Parses UTXO bytes to get a UTXO object. **Function Signature:** ```typescript function getUtxoFromBytes( utxoBytesOrHex: string | Uint8Array, chainAlias: "P" | "X" | "C" ): Utxo; ``` **Parameters:** | Name | Type | Required | Description | | ---------------- | ---------------------- | -------- | -------------------------------------- | | `utxoBytesOrHex` | `string \| Uint8Array` | Yes | UTXO bytes as hex string or Uint8Array | | `chainAlias` | `"P" \| "X" \| "C"` | Yes | Chain alias | **Returns:** | Type | Description | | ------ | ------------------ | | `Utxo` | Parsed UTXO object | **Example:** ```typescript import { getUtxoFromBytes } from "@avalanche-sdk/client/utils"; const utxoHex = "0x1234567890abcdef..."; const utxo = getUtxoFromBytes(utxoHex, "P"); console.log("UTXO ID:", utxo.utxoID); console.log("Asset ID:", utxo.assetID); console.log("Output:", utxo.output); ``` ### getUtxosForAddress Fetches all UTXOs for a given address on a specific chain. This function handles pagination automatically. **Function Signature:** ```typescript function getUtxosForAddress( client: AvalancheWalletCoreClient, params: { address: string; chainAlias: "P" | "X" | "C"; sourceChain?: string; } ): Promise; ``` **Parameters:** | Name | Type | Required | Description | | -------- | --------------------------- | -------- | -------------------------- | | `client` | `AvalancheWalletCoreClient` | Yes | The wallet client instance | | `params` | `object` | Yes | Parameters object | **params object:** | Name | Type | Required | Description | | ------------- | ------------------- | -------- | --------------------------------------- | | `address` | `string` | Yes | Address to query | | `chainAlias` | `"P" \| "X" \| "C"` | Yes | Chain alias | | `sourceChain` | `string` | No | Source chain ID for import transactions | **Returns:** | Type | Description | | ----------------- | --------------------- | | `Promise` | Array of UTXO objects | **Example:** ```typescript import { getUtxosForAddress } from "@avalanche-sdk/client/utils"; import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const walletClient = createAvalancheWalletClient({ account: myAccount, chain: avalanche, transport: { type: "http" }, }); const utxos = await getUtxosForAddress(walletClient, { address: "P-avax1...", chainAlias: "P", }); console.log(`Found ${utxos.length} UTXOs`); ``` ### buildUtxoBytes Builds UTXO bytes from parameters. Useful for reconstructing UTXOs or creating test data. **Function Signature:** ```typescript function buildUtxoBytes( txHash: string, outputIndex: number, assetId: string, amount: string, addresses: string[], locktime: string, threshold: number ): `0x${string}`; ``` **Parameters:** | Name | Type | Required | Description | | ------------- | ---------- | -------- | ------------------------------------------- | | `txHash` | `string` | Yes | Transaction hash in CB58 format | | `outputIndex` | `number` | Yes | Output index in the transaction | | `assetId` | `string` | Yes | Asset ID in CB58 format | | `amount` | `string` | Yes | Amount as string | | `addresses` | `string[]` | Yes | Array of addresses that can spend this UTXO | | `locktime` | `string` | Yes | UNIX timestamp locktime in seconds | | `threshold` | `number` | Yes | Signature threshold | **Returns:** | Type | Description | | ------------------- | ------------------------ | | `` `0x${string}` `` | UTXO bytes as hex string | **Example:** ```typescript import { buildUtxoBytes } from "@avalanche-sdk/client/utils"; const utxoBytes = buildUtxoBytes( "mYxFK3CWs6iMFFaRx4wmVLDUtnktzm2o9Mhg9AG6JSzRijy5V", 0, "U8iRqJoiJm8xZHAacmvYyZVwqQx6uDNtQeP3CQ6fcgQk3JqnK", "111947", ["P-fuji1nv6w7m6egkwhkcvz96ze3qmzyk5gt6csqz7ejq"], "0", 1 ); console.log("UTXO bytes:", utxoBytes); ``` ## Viem Utilities The SDK re-exports all utilities from viem for EVM operations. See the [viem utilities documentation](https://viem.sh/docs/utilities) for complete reference. **Common Categories:** - **Encoding/Decoding**: `bytesToHex`, `hexToBytes`, `stringToHex` - **ABI Operations**: `encodeAbiParameters`, `decodeAbiParameters`, `parseAbiItem` - **Address Operations**: `getAddress`, `isAddress`, `checksumAddress` - **Number Operations**: `bytesToBigInt`, `hexToNumber`, `numberToHex` - **Hash Operations**: `keccak256`, `sha256`, `ripemd160` - **Signature Operations**: `recoverAddress`, `verifyMessage` ## Common Patterns ### Converting Between Units ```typescript import { avaxToNanoAvax, nanoAvaxToAvax, avaxToWei, weiToAvax, } from "@avalanche-sdk/client/utils"; // P-Chain: AVAX → nanoAVAX const nanoAvax = avaxToNanoAvax(1.5); // C-Chain: AVAX → wei const wei = avaxToWei(1.5); // Display: nanoAVAX → AVAX const avax = nanoAvaxToAvax(nanoAvax); ``` ### Working with Transaction IDs ```typescript import { CB58ToHex, hexToCB58 } from "@avalanche-sdk/client/utils"; // Convert CB58 to hex for API calls const txId = "mYxFK3CWs6iMFFaRx4wmVLDUtnktzm2o9Mhg9AG6JSzRijy5V"; const hex = CB58ToHex(txId); // Convert hex back to CB58 for display const cb58 = hexToCB58(hex); ``` ### Parsing Transactions ```typescript import { getTxFromBytes } from "@avalanche-sdk/client/utils"; const txHex = "0x..."; const [tx, credentials] = getTxFromBytes(txHex, "P"); // Access transaction details const txId = tx.getId().toString(); const numSignatures = credentials.length; ``` ## Next Steps - **[Account Management](accounts)** - Working with accounts - **[Transaction Signing](methods/wallet-methods/wallet)** - Signing and sending transactions - **[Chain Clients](clients)** - Chain-specific operations - **[Viem Documentation](https://viem.sh/docs/utilities)** - Complete viem utilities reference # Chain Configuration (/docs/tooling/avalanche-sdk/interchain/chains) --- title: Chain Configuration icon: link --- ## Overview Chain configurations define the blockchain networks for interchain operations. Each chain includes network details and interchain contract addresses. ## Available Chains ### avalancheFuji Avalanche Fuji testnet configuration. ```typescript import { avalancheFuji } from "@avalanche-sdk/interchain/chains"; ``` ### dispatch Dispatch subnet configuration. ```typescript import { dispatch } from "@avalanche-sdk/interchain/chains"; ``` ## ChainConfig Type ```typescript interface ChainConfig { id: number; name: string; network: string; nativeCurrency: { name: string; symbol: string; decimals: number; }; rpcUrls: { default: { http: string[]; }; }; blockchainId: string; interchainContracts: { teleporterRegistry: Address; teleporterManager: Address; }; } ``` ## Using Chains ```typescript import { createICMClient } from "@avalanche-sdk/interchain"; import { avalancheFuji, dispatch } from "@avalanche-sdk/interchain/chains"; const icm = createICMClient(wallet, avalancheFuji, dispatch); // Or specify per call await icm.sendMsg({ sourceChain: avalancheFuji, destinationChain: dispatch, message: "Hello!", }); ``` ## Custom Chains You can define custom chains for interchain operations by extending the base chain configuration with interchain-specific properties. Custom chains are useful when working with custom subnets or L1 chains that support Teleporter. ### Defining a Custom Chain Use `defineChain` from `@avalanche-sdk/client` to create a chain configuration, then cast it to `ChainConfig` to add interchain contract addresses: ```typescript import { defineChain } from "@avalanche-sdk/client"; import type { ChainConfig } from "@avalanche-sdk/interchain/chains"; export const myCustomChain = defineChain({ id: 12345, // Your chain ID name: "My Custom Chain", network: "my-custom-chain", nativeCurrency: { decimals: 18, name: "Token", symbol: "TKN", }, rpcUrls: { default: { http: ["https://api.example.com/ext/bc/C/rpc"], }, }, blockExplorers: { default: { name: "Explorer", url: "https://explorer.example.com", }, }, // Interchain-specific properties blockchainId: "0x...", // Your blockchain ID (hex-encoded) interchainContracts: { teleporterRegistry: "0x...", // Teleporter registry contract address teleporterManager: "0x...", // Teleporter manager contract address }, }) as ChainConfig; ``` ### Required Properties | Property | Type | Description | | --------------------- | -------- | ------------------------------------------------ | | `id` | `number` | Unique chain identifier (EVM chain ID) | | `name` | `string` | Human-readable chain name | | `network` | `string` | Network identifier (used for wallet connections) | | `nativeCurrency` | `object` | Native token configuration | | `rpcUrls` | `object` | RPC endpoint URLs | | `blockchainId` | `string` | Avalanche blockchain ID (hex-encoded) | | `interchainContracts` | `object` | Teleporter contract addresses | ### Interchain Contracts The `interchainContracts` object must include: - **`teleporterRegistry`**: Address of the Teleporter registry contract on this chain - **`teleporterManager`**: Address of the Teleporter manager contract on this chain These contracts enable cross-chain messaging and token transfers. Ensure they are deployed and configured on your chain before using interchain operations. ### Example: Custom Subnet Chain ```typescript import { defineChain } from "@avalanche-sdk/client"; import type { ChainConfig } from "@avalanche-sdk/interchain/chains"; export const mySubnet = defineChain({ id: 54321, name: "My Subnet", network: "my-subnet", nativeCurrency: { decimals: 18, name: "Avalanche", symbol: "AVAX", }, rpcUrls: { default: { http: ["https://subnets.avax.network/mysubnet/mainnet/rpc"], }, }, blockExplorers: { default: { name: "Subnet Explorer", url: "https://subnets.avax.network/mysubnet", }, }, blockchainId: "0x1234567890abcdef1234567890abcdef12345678", interchainContracts: { teleporterRegistry: "0xF86Cb19Ad8405AEFa7d09C778215D2Cb6eBfB228", teleporterManager: "0x253b2784c75e510dD0fF1da844684a1aC0aa5fcf", }, }) as ChainConfig; ``` ### Using Custom Chains Once defined, use your custom chain with ICM and ICTT clients: ```typescript import { createICMClient } from "@avalanche-sdk/interchain"; import { myCustomChain } from "./chains/myCustomChain"; import { avalancheFuji } from "@avalanche-sdk/interchain/chains"; const icm = createICMClient(wallet, avalancheFuji, myCustomChain); // Send message to custom chain await icm.sendMsg({ sourceChain: avalancheFuji, destinationChain: myCustomChain, message: "Hello from Fuji to My Custom Chain!", }); ``` ### Tips - **Blockchain ID**: Use the hex-encoded blockchain ID from your chain's configuration. You can find this in your chain's genesis data or by querying the chain's info API. - **Contract Addresses**: Ensure Teleporter contracts are deployed on your chain before using interchain operations. Contact your chain operator or refer to your chain's documentation for the correct addresses. - **RPC URLs**: Provide reliable RPC endpoints. Consider using multiple endpoints for redundancy. - **Testnet vs Mainnet**: Use the `testnet` property to mark testnet chains, which helps with wallet integrations and explorer links. For more information on chain configuration, see the [Viem chains documentation](https://viem.sh/docs/chains/introduction). # Deployment Methods (/docs/tooling/avalanche-sdk/interchain/ictt/deployment) --- title: Deployment Methods icon: package --- ## deployERC20Token Deploys a new ERC20 token on the source chain. ### Parameters | Parameter | Type | Required | Description | | --------------- | -------------- | -------- | -------------------------------------------------------- | | `walletClient` | `WalletClient` | Yes | Wallet client for signing | | `sourceChain` | `ChainConfig` | Yes\* | Source chain configuration | | `name` | `string` | Yes | Token name | | `symbol` | `string` | Yes | Token symbol | | `initialSupply` | `number` | Yes | Initial token supply | | `recipient` | `Address` | No | Recipient of initial supply (defaults to wallet address) | \* Required if not set in client constructor ### Returns | Type | Description | | ---------------------------------------------------------------- | ------------------------------------- | | `Promise<{ txHash: 0x${string}, contractAddress: 0x${string} }>` | Transaction hash and contract address | ### Example ```typescript const { txHash, contractAddress } = await ictt.deployERC20Token({ walletClient: wallet, sourceChain: avalancheFuji, name: "My Token", symbol: "MTK", initialSupply: 1000000, }); ``` ## deployTokenHomeContract Deploys a token home contract on the source chain. ### Parameters | Parameter | Type | Required | Description | | -------------------------- | -------------- | -------- | -------------------------- | | `walletClient` | `WalletClient` | Yes | Wallet client for signing | | `sourceChain` | `ChainConfig` | Yes\* | Source chain configuration | | `erc20TokenAddress` | `Address` | Yes | ERC20 token address | | `minimumTeleporterVersion` | `number` | Yes | Minimum Teleporter version | | `tokenHomeCustomByteCode` | `string` | No | Custom bytecode | | `tokenHomeCustomABI` | `ABI` | No | Custom ABI | ### Returns | Type | Description | | ---------------------------------------------------------------- | ------------------------------------- | | `Promise<{ txHash: 0x${string}, contractAddress: 0x${string} }>` | Transaction hash and contract address | ### Example ```typescript const { txHash, contractAddress } = await ictt.deployTokenHomeContract({ walletClient: wallet, sourceChain: avalancheFuji, erc20TokenAddress: tokenAddress, minimumTeleporterVersion: 1, }); ``` ## deployTokenRemoteContract Deploys a token remote contract on the destination chain. ### Parameters | Parameter | Type | Required | Description | | --------------------------- | -------------- | -------- | ------------------------------- | | `walletClient` | `WalletClient` | Yes | Wallet client for signing | | `sourceChain` | `ChainConfig` | Yes\* | Source chain configuration | | `destinationChain` | `ChainConfig` | Yes\* | Destination chain configuration | | `tokenHomeContract` | `Address` | Yes | Token home contract address | | `tokenRemoteCustomByteCode` | `string` | No | Custom bytecode | | `tokenRemoteCustomABI` | `ABI` | No | Custom ABI | ### Returns | Type | Description | | ---------------------------------------------------------------- | ------------------------------------- | | `Promise<{ txHash: 0x${string}, contractAddress: 0x${string} }>` | Transaction hash and contract address | ### Example ```typescript const { txHash, contractAddress } = await ictt.deployTokenRemoteContract({ walletClient: wallet, sourceChain: avalancheFuji, destinationChain: dispatch, tokenHomeContract: tokenHomeAddress, }); ``` ## registerRemoteWithHome Registers the token remote contract with the token home contract. ### Parameters | Parameter | Type | Required | Description | | --------------------- | -------------- | -------- | ------------------------------- | | `walletClient` | `WalletClient` | Yes | Wallet client for signing | | `sourceChain` | `ChainConfig` | Yes\* | Source chain configuration | | `destinationChain` | `ChainConfig` | Yes\* | Destination chain configuration | | `tokenRemoteContract` | `Address` | Yes | Token remote contract address | | `feeTokenAddress` | `Address` | No | Fee token address | | `feeAmount` | `number` | No | Fee amount | ### Returns | Type | Description | | ---------------------------------- | ---------------- | | `Promise<{ txHash: 0x${string} }>` | Transaction hash | ### Example ```typescript const { txHash } = await ictt.registerRemoteWithHome({ walletClient: wallet, sourceChain: avalancheFuji, destinationChain: dispatch, tokenRemoteContract: tokenRemoteAddress, }); ``` # Interchain Token Transfers (/docs/tooling/avalanche-sdk/interchain/ictt) --- title: Interchain Token Transfers icon: coins --- ## Overview Transfer ERC20 tokens between Avalanche chains using the Teleporter protocol. Requires deploying token home and remote contracts for each token pair. ## Create Client ```typescript import { createICTTClient } from "@avalanche-sdk/interchain"; const ictt = createICTTClient(); // Or with default chains const ictt = createICTTClient(sourceChain, destinationChain); ``` ## Workflow 1. **Deploy ERC20 Token** - Deploy your token on the source chain 2. **Deploy Token Home** - Deploy home contract on source chain 3. **Deploy Token Remote** - Deploy remote contract on destination chain 4. **Register Remote** - Register remote with home contract 5. **Approve Token** - Approve home contract to spend tokens 6. **Send Tokens** - Transfer tokens cross-chain The wallet client's chain configuration must match the `sourceChain` used in your interchain operations. For example, if you're sending messages from Fuji testnet, ensure your wallet client is configured with the Fuji chain. Mismatched chains will result in an "invalid sender" error. ## Methods Deploy tokens and contracts Transfer tokens cross-chain # Transfer Methods (/docs/tooling/avalanche-sdk/interchain/ictt/transfers) --- title: Transfer Methods icon: arrow-right --- ## approveToken Approves the token home contract to spend tokens on the source chain. ### Parameters | Parameter | Type | Required | Description | | ------------------- | -------------- | -------- | --------------------------------- | | `walletClient` | `WalletClient` | Yes | Wallet client for signing | | `sourceChain` | `ChainConfig` | Yes\* | Source chain configuration | | `tokenHomeContract` | `Address` | Yes | Token home contract address | | `tokenAddress` | `Address` | Yes | ERC20 token address | | `amountInBaseUnit` | `number` | Yes | Amount to approve (in base units) | \* Required if not set in client constructor ### Returns | Type | Description | | ---------------------------------- | ---------------- | | `Promise<{ txHash: 0x${string} }>` | Transaction hash | ### Example ```typescript const { txHash } = await ictt.approveToken({ walletClient: wallet, sourceChain: avalancheFuji, tokenHomeContract: tokenHomeAddress, tokenAddress: tokenAddress, amountInBaseUnit: 1000, }); ``` ## sendToken Sends tokens from the source chain to the destination chain. ### Parameters | Parameter | Type | Required | Description | | --------------------- | -------------- | -------- | -------------------------------------- | | `walletClient` | `WalletClient` | Yes | Wallet client for signing | | `sourceChain` | `ChainConfig` | Yes\* | Source chain configuration | | `destinationChain` | `ChainConfig` | Yes\* | Destination chain configuration | | `tokenHomeContract` | `Address` | Yes | Token home contract address | | `tokenRemoteContract` | `Address` | Yes | Token remote contract address | | `recipient` | `Address` | Yes | Recipient address on destination chain | | `amountInBaseUnit` | `number` | Yes | Amount to send (in base units) | | `feeTokenAddress` | `Address` | No | Fee token address | | `feeAmount` | `number` | No | Fee amount | \* Required if not set in client constructor ### Returns | Type | Description | | ---------------------------------- | ---------------- | | `Promise<{ txHash: 0x${string} }>` | Transaction hash | ### Example ```typescript const { txHash } = await ictt.sendToken({ walletClient: wallet, sourceChain: avalancheFuji, destinationChain: dispatch, tokenHomeContract: tokenHomeAddress, tokenRemoteContract: tokenRemoteAddress, recipient: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amountInBaseUnit: 100, }); ``` ## Complete Workflow ```typescript import { createICTTClient } from "@avalanche-sdk/interchain"; import { avalancheFuji, dispatch } from "@avalanche-sdk/interchain/chains"; const ictt = createICTTClient(avalancheFuji, dispatch); // 1. Deploy token const { contractAddress: tokenAddress } = await ictt.deployERC20Token({ walletClient: wallet, sourceChain: avalancheFuji, name: "My Token", symbol: "MTK", initialSupply: 1000000, }); // 2. Deploy home contract const { contractAddress: tokenHomeAddress } = await ictt.deployTokenHomeContract({ walletClient: wallet, sourceChain: avalancheFuji, erc20TokenAddress: tokenAddress, minimumTeleporterVersion: 1, }); // 3. Deploy remote contract const { contractAddress: tokenRemoteAddress } = await ictt.deployTokenRemoteContract({ walletClient: wallet, sourceChain: avalancheFuji, destinationChain: dispatch, tokenHomeContract: tokenHomeAddress, }); // 4. Register remote with home await ictt.registerRemoteWithHome({ walletClient: wallet, sourceChain: avalancheFuji, destinationChain: dispatch, tokenRemoteContract: tokenRemoteAddress, }); // 5. Approve tokens await ictt.approveToken({ walletClient: wallet, sourceChain: avalancheFuji, tokenHomeContract: tokenHomeAddress, tokenAddress: tokenAddress, amountInBaseUnit: 1000, }); // 6. Send tokens const { txHash } = await ictt.sendToken({ walletClient: wallet, sourceChain: avalancheFuji, destinationChain: dispatch, tokenHomeContract: tokenHomeAddress, tokenRemoteContract: tokenRemoteAddress, recipient: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amountInBaseUnit: 100, }); ``` # Interchain Messaging (/docs/tooling/avalanche-sdk/interchain/icm) --- title: Interchain Messaging icon: message-square --- ## Overview Send arbitrary messages between Avalanche chains and subnets using the Teleporter protocol. Messages are encoded as strings and delivered cross-chain. ## Create Client ```typescript import { createICMClient } from "@avalanche-sdk/interchain"; import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avalancheFuji, dispatch } from "@avalanche-sdk/interchain/chains"; // Setup wallet const account = privateKeyToAvalancheAccount("0x..."); const wallet = createAvalancheWalletClient({ account, chain: avalancheFuji, transport: { type: "http" }, }); const icm = createICMClient(wallet); // Or with default chains const icm = createICMClient(wallet, sourceChain, destinationChain); ``` The wallet client's chain configuration must match the `sourceChain` used in your interchain operations. For example, if you're sending messages from Fuji testnet, ensure your wallet client is configured with the Fuji chain. Mismatched chains will result in an "invalid sender" error. ## Methods Send a cross-chain message # Methods (/docs/tooling/avalanche-sdk/interchain/icm/methods) --- title: Methods icon: code --- ## sendMsg Sends a cross-chain message to the specified destination chain. ### Parameters | Parameter | Type | Required | Description | | ------------------------- | --------------------------------------------- | -------- | -------------------------------------------- | | `message` | `string` | Yes | Message content to send | | `sourceChain` | `ChainConfig` | Yes\* | Source chain configuration | | `destinationChain` | `ChainConfig` | Yes\* | Destination chain configuration | | `recipientAddress` | `0x${string}` | No | Recipient address (defaults to zero address) | | `feeInfo` | `{ feeTokenAddress: string, amount: bigint }` | No | Fee token and amount | | `requiredGasLimit` | `bigint` | No | Gas limit for execution (default: 100000) | | `allowedRelayerAddresses` | `string[]` | No | Allowed relayer addresses | \* Required if not set in client constructor ### Returns | Type | Description | | ----------------- | ---------------- | | `Promise` | Transaction hash | ### Example ```typescript import { createICMClient } from "@avalanche-sdk/interchain"; import { avalancheFuji, dispatch } from "@avalanche-sdk/interchain/chains"; const icm = createICMClient(wallet); // Simple message const hash = await icm.sendMsg({ sourceChain: avalancheFuji, destinationChain: dispatch, message: "Hello from Avalanche!", }); // With options const hash = await icm.sendMsg({ sourceChain: avalancheFuji, destinationChain: dispatch, message: "Hello from Avalanche!", recipientAddress: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", feeInfo: { feeTokenAddress: "0x0000000000000000000000000000000000000000", amount: 0n, }, requiredGasLimit: 200000n, }); ``` # Building Warp Messages (/docs/tooling/avalanche-sdk/interchain/warp/building) --- title: Building Warp Messages icon: hammer --- ## Building Messages Build unsigned Warp messages for signing and broadcasting. ## RegisterL1ValidatorMessage ### Methods | Method | Parameters | Returns | Description | | ------------ | ------------------------------------------------------ | ---------------------------- | ----------------- | | `fromValues` | `nodeID: string, publicKey: string, signature: string` | `RegisterL1ValidatorMessage` | Build from values | | `toHex` | - | `string` | Convert to hex | ### Example ```typescript import { RegisterL1ValidatorMessage } from "@avalanche-sdk/interchain/warp"; const msg = RegisterL1ValidatorMessage.fromValues( "NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg", "0x...", "0x..." ); const hex = msg.toHex(); ``` ## L1ValidatorWeightMessage ### Methods | Method | Parameters | Returns | Description | | ------------ | --------------------------------------------------- | -------------------------- | ----------------- | | `fromValues` | `nodeID: string, weight: bigint, startTime: bigint` | `L1ValidatorWeightMessage` | Build from values | | `toHex` | - | `string` | Convert to hex | ### Example ```typescript import { L1ValidatorWeightMessage } from "@avalanche-sdk/interchain/warp"; const msg = L1ValidatorWeightMessage.fromValues( "NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg", 4n, 41n ); const hex = msg.toHex(); ``` ## AddressedCall Build AddressedCall payload from a message. ### Methods | Method | Parameters | Returns | Description | | ------------ | ----------------------------------------- | --------------- | ----------------- | | `fromValues` | `sourceAddress: Address, payload: string` | `AddressedCall` | Build from values | | `toHex` | - | `string` | Convert to hex | ### Example ```typescript import { AddressedCall, L1ValidatorWeightMessage, } from "@avalanche-sdk/interchain/warp"; const msg = L1ValidatorWeightMessage.fromValues( "NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg", 4n, 41n ); const addressedCall = AddressedCall.fromValues( "0x35F884853114D298D7aA8607f4e7e0DB52205f07", msg.toHex() ); ``` ## WarpUnsignedMessage Build unsigned Warp message from AddressedCall. ### Methods | Method | Parameters | Returns | Description | | ------------ | ------------------------------------------------------------------------ | --------------------- | ----------------- | | `fromValues` | `networkID: number, sourceChainID: string, addressedCallPayload: string` | `WarpUnsignedMessage` | Build from values | | `toHex` | - | `string` | Convert to hex | ### Example ```typescript import { AddressedCall, L1ValidatorWeightMessage, WarpUnsignedMessage, } from "@avalanche-sdk/interchain/warp"; // Build message const msg = L1ValidatorWeightMessage.fromValues( "NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg", 4n, 41n ); // Build AddressedCall const addressedCall = AddressedCall.fromValues( "0x35F884853114D298D7aA8607f4e7e0DB52205f07", msg.toHex() ); // Build unsigned Warp message const warpUnsignedMsg = WarpUnsignedMessage.fromValues( 1, "251q44yFiimeVSHaQbBk69TzoeYqKu9VagGtLVqo92LphUxjmR", addressedCall.toHex() ); const hex = warpUnsignedMsg.toHex(); ``` # Warp Messages (/docs/tooling/avalanche-sdk/interchain/warp) --- title: Warp Messages icon: layers --- ## Overview Warp messages enable cross-chain communication in Avalanche. Parse and build Warp protocol messages for validator registration, weight updates, and subnet conversions. ## Supported Message Types - **RegisterL1ValidatorMessage** - Register L1 validators - **L1ValidatorWeightMessage** - Update validator weights - **L1ValidatorRegistrationMessage** - L1 validator registration - **SubnetToL1ConversionMessage** - Subnet to L1 conversion ## Quick Start ```typescript import { WarpMessage, RegisterL1ValidatorMessage, } from "@avalanche-sdk/interchain/warp"; // Parse a signed Warp message const signedWarpMsg = WarpMessage.fromHex(signedWarpMsgHex); // Parse specific message type const registerMsg = RegisterL1ValidatorMessage.fromHex(signedWarpMsgHex); ``` ## Methods Parse Warp messages Build Warp messages # Parsing Warp Messages (/docs/tooling/avalanche-sdk/interchain/warp/parsing) --- title: Parsing Warp Messages icon: search --- ## WarpMessage Parse a signed Warp message from hex. ### Methods | Method | Parameters | Returns | Description | | --------- | ------------- | ------------- | ------------------------- | | `fromHex` | `hex: string` | `WarpMessage` | Parse signed Warp message | ### Example ```typescript import { WarpMessage } from "@avalanche-sdk/interchain/warp"; const signedWarpMsgHex = "0x..."; const warpMsg = WarpMessage.fromHex(signedWarpMsgHex); // Access message properties console.log(warpMsg.networkID); console.log(warpMsg.sourceChainID); console.log(warpMsg.addressedCallPayload); console.log(warpMsg.signatures); ``` ## RegisterL1ValidatorMessage Parse a Register L1 Validator message. ### Methods | Method | Parameters | Returns | Description | | --------- | ------------- | ---------------------------- | -------------- | | `fromHex` | `hex: string` | `RegisterL1ValidatorMessage` | Parse from hex | ### Example ```typescript import { RegisterL1ValidatorMessage } from "@avalanche-sdk/interchain/warp"; const msg = RegisterL1ValidatorMessage.fromHex(signedWarpMsgHex); console.log(msg.nodeID); console.log(msg.publicKey); console.log(msg.signature); ``` ## L1ValidatorWeightMessage Parse an L1 Validator Weight message. ### Methods | Method | Parameters | Returns | Description | | --------- | ------------- | -------------------------- | -------------- | | `fromHex` | `hex: string` | `L1ValidatorWeightMessage` | Parse from hex | ### Example ```typescript import { L1ValidatorWeightMessage } from "@avalanche-sdk/interchain/warp"; const msg = L1ValidatorWeightMessage.fromHex(signedWarpMsgHex); console.log(msg.nodeID); console.log(msg.weight); console.log(msg.startTime); ``` ## L1ValidatorRegistrationMessage Parse an L1 Validator Registration message. ### Methods | Method | Parameters | Returns | Description | | --------- | ------------- | -------------------------------- | -------------- | | `fromHex` | `hex: string` | `L1ValidatorRegistrationMessage` | Parse from hex | ## SubnetToL1ConversionMessage Parse a Subnet to L1 Conversion message. ### Methods | Method | Parameters | Returns | Description | | --------- | ------------- | ----------------------------- | -------------- | | `fromHex` | `hex: string` | `SubnetToL1ConversionMessage` | Parse from hex | ### Example ```typescript import { SubnetToL1ConversionMessage } from "@avalanche-sdk/interchain/warp"; const msg = SubnetToL1ConversionMessage.fromHex(signedWarpMsgHex); console.log(msg.subnetID); console.log(msg.assetID); console.log(msg.initialSupply); ``` # JSON-RPC Accounts (/docs/tooling/avalanche-sdk/client/accounts/json-rpc) --- title: JSON-RPC Accounts icon: globe description: Learn how to use JSON-RPC accounts with browser wallets like MetaMask and Core in the Avalanche Client SDK. --- ## Overview A JSON-RPC Account is an Account whose signing keys are stored on an external Wallet. It **defers** signing of transactions & messages to the target Wallet over JSON-RPC. Examples of such wallets include Browser Extension Wallets (like MetaMask or Core) or Mobile Wallets over WalletConnect. ## Supported Wallets ### Core Browser Extension Core is Avalanche's official browser extension wallet that provides native support for Avalanche networks (C/P/X-Chains). ```typescript import "@avalanche-sdk/client/window"; import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; try { // Check if Core extension is available const provider = window.avalanche; if (!provider) { throw new Error( "Core extension not found. Please install Core. https://core.app" ); } // Create wallet client with Core provider const walletClient = createAvalancheWalletClient({ chain: avalanche, transport: { type: "custom", provider, }, }); } catch (error) { console.error("Failed to initialize Core provider:", error); } ``` ### MetaMask MetaMask can be used with Avalanche networks through custom network configuration for C-Chain evm operations. ```typescript import "@avalanche-sdk/client/window"; import { createAvalancheWalletClient, custom } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; // Use MetaMask provider const provider = window.ethereum; if (!provider) { throw new Error("MetaMask not found. Please install MetaMask."); } const walletClient = createAvalancheWalletClient({ chain: avalanche, transport: { type: "custom", provider, }, }); ``` ## Basic Usage ### 1. Request Account Connection ```typescript try { // Request accounts from the wallet const accounts: string[] = await walletClient.requestAddresses(); const address: string = accounts[0]; // Get the first account console.log("Connected address:", address); } catch (error) { console.error("Failed to request addresses:", error); } ``` ### 2. Send Transactions ```typescript try { // Send a transaction (will prompt user to sign) const txHash: string = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: 0.001, }); console.log("Transaction hash:", txHash); } catch (error) { console.error("Failed to send transaction:", error); } ``` ### 3. Switch Networks ```typescript import { avalanche, avalancheFuji } from "@avalanche-sdk/client/chains"; try { // Switch to Avalanche mainnet await walletClient.switchChain({ id: avalanche.id, }); console.log("Switched to Avalanche mainnet"); // Switch to Fuji testnet await walletClient.switchChain({ id: avalancheFuji.id, }); console.log("Switched to Fuji testnet"); } catch (error) { console.error("Failed to switch chain:", error); } ``` ## React Integration Example Here's a complete React component for wallet connection using Core: ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche, avalancheFuji } from "@avalanche-sdk/client/chains"; import { useState, useCallback } from "react"; import "@avalanche-sdk/client/window"; export function ConnectWallet() { const [connected, setConnected] = useState(false); const [address, setAddress] = useState(null); const [chain, setChain] = useState<"mainnet" | "fuji">("fuji"); const selectedChain = chain === "fuji" ? avalancheFuji : avalanche; const connect = useCallback(async () => { try { const provider = window.avalanche; if (!provider) { throw new Error("Core extension not found. Please install Core."); } const walletClient = createAvalancheWalletClient({ chain: selectedChain, transport: { type: "custom", provider }, }); const accounts = await walletClient.requestAddresses(); const addr = accounts[0]; setAddress(addr); setConnected(true); } catch (error) { console.error("Connection failed:", error); } }, [selectedChain]); const sendTransaction = useCallback(async () => { if (!connected || !address) return; try { const provider = (window as any).avalanche; const walletClient = createAvalancheWalletClient({ chain: selectedChain, transport: { type: "custom", provider }, }); const txHash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: 0.001, }); console.log("Transaction sent:", txHash); } catch (error) { console.error("Transaction failed:", error); } }, [connected, address, selectedChain]); return (

Wallet Connection

{!connected ? ( ) : (

Connected: {address}

Network: {selectedChain.name}

)}
); } ``` ## Cross-Chain Operations JSON-RPC accounts support cross-chain operations through the Avalanche Client SDK: ```typescript // P-Chain export transaction const pChainExportTxn = await walletClient.pChain.prepareExportTxn({ destinationChain: "C", fromAddress: address, exportedOutput: { addresses: [address], amount: avaxToWei(0.001), }, }); const txHash = await walletClient.sendXPTransaction(pChainExportTxn); ``` ## Best Practices ### 1. Check Provider Availability ```typescript // Always check if the provider is available if (typeof window !== "undefined" && window.avalanche) { // Core is available } else if (typeof window !== "undefined" && window.ethereum) { // MetaMask is available } else { // No wallet provider found } ``` ### 2. Handle Network Switching ```typescript // Check if wallet is on the correct network const currentChainId = await walletClient.getChainId(); if (currentChainId !== avalanche.id) { await walletClient.switchChain({ id: avalanche.id }); } ``` ### 3. Graceful Error Handling ```typescript const handleWalletError = (error: any) => { switch (error.code) { case 4001: return "User rejected the request"; case -32002: return "Request already pending"; case -32602: return "Invalid parameters"; default: return error.message || "Unknown error occurred"; } }; ``` ## Troubleshooting ### Common Issues **Provider Not Found** ```typescript // Check if provider exists if (!window.avalanche && !window.ethereum) { throw new Error("No wallet provider found. Please install Core or MetaMask."); } ``` **Wrong Network** ```typescript // Ensure wallet is on the correct network const chainId = await walletClient.getChainId(); if (chainId !== avalanche.id) { await walletClient.switchChain({ id: avalanche.id }); } ``` **User Rejection** ```typescript try { await walletClient.send({ to: address, amount: 0.001 }); } catch (error) { if (error.code === 4001) { console.log("User rejected transaction"); } } ``` ## Next Steps - **[Local Accounts](accounts/local)** - Learn about local account management - **[Wallet Operations](methods/wallet-methods/wallet)** - Learn how to send transactions - **[Cross-Chain Transfers](methods/wallet-methods/wallet#cross-chain-transfers)** - Moving assets between chains # Network-Specific Addresses (/docs/tooling/avalanche-sdk/client/accounts/local/addresses) --- title: "Network-Specific Addresses" icon: "map-pin" --- ## Overview Avalanche uses different address formats for each chain. EVM addresses work the same across networks, but XP addresses use network-specific HRPs (Human-Readable Prefixes). ## Address Formats ### EVM Addresses (C-Chain) EVM addresses are the same across all networks: ```typescript const evmAddress = account.getEVMAddress(); // 0x742d35Cc... ``` ### XP Addresses (X/P-Chain) XP addresses use network-specific HRPs: ```typescript // Mainnet const mainnetX = account.getXPAddress("X", "avax"); // X-avax1... const mainnetP = account.getXPAddress("P", "avax"); // P-avax1... // Testnet (Fuji) const fujiX = account.getXPAddress("X", "fuji"); // X-fuji1... const fujiP = account.getXPAddress("P", "fuji"); // P-fuji1... ``` ## Network Configuration ```typescript // Mainnet addresses const mainnet = { evm: account.getEVMAddress(), xChain: account.getXPAddress("X", "avax"), pChain: account.getXPAddress("P", "avax"), }; // Testnet addresses const testnet = { evm: account.getEVMAddress(), xChain: account.getXPAddress("X", "fuji"), pChain: account.getXPAddress("P", "fuji"), }; ``` ## Next Steps - **[Account Utilities](accounts/local/utilities)** - Account validation and utilities - **[Using Accounts with Clients](accounts/local/clients)** - Client integration patterns # Using Accounts with Clients (/docs/tooling/avalanche-sdk/client/accounts/local/clients) --- title: "Using Accounts with Clients" icon: "link" --- ## Overview Accounts work with both public clients (read-only) and wallet clients (transactions). You can hoist the account into the client or pass it to each method. ## Public Client (Read-Only) ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); const account = privateKeyToAvalancheAccount("0x..."); // Read operations const balance = await client.getBalance({ address: account.getEVMAddress() }); const height = await client.pChain.getHeight(); ``` ## Wallet Client (Transactions) ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avaxToWei } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); // Hoist account (recommended) const walletClient = createAvalancheWalletClient({ account, // Account is hoisted chain: avalanche, transport: { type: "http" }, }); // C-Chain transaction const txHash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: avaxToWei(0.001), }); // X/P-Chain transaction const xpTx = await walletClient.xChain.prepareBaseTxn({ outputs: [{ addresses: [account.getXPAddress("X")], amount: 1 }], }); await walletClient.sendXPTransaction(xpTx); ``` ## Account Hoisting You can hoist the account into the client (recommended) or pass it to each method: ```typescript // Hoisted (recommended) const walletClient = createAvalancheWalletClient({ account, // No need to pass to each method chain: avalanche, transport: { type: "http" }, }); await walletClient.send({ to: "0x...", amount: 0.001 }); // Or pass per method const walletClient = createAvalancheWalletClient({ chain: avalanche, transport: { type: "http" }, }); await walletClient.send({ account, to: "0x...", amount: 0.001 }); ``` ## Cross-Chain Operations Cross-chain transfers use the export/import pattern. Export from the source chain, wait for confirmation, then import to the destination chain. [Learn more about cross-chain transfers →](methods/wallet-methods/wallet#cross-chain-transfers) ## Next Steps - **[Wallet Operations](methods/wallet-methods/wallet)** - Learn how to send transactions - **[P-Chain Operations](methods/public-methods/p-chain)** - Validator and staking operations - **[X-Chain Operations](methods/public-methods/x-chain)** - Asset transfers and UTXO operations - **[C-Chain Operations](methods/public-methods/c-chain)** - EVM and smart contract operations # HD Key Accounts (/docs/tooling/avalanche-sdk/client/accounts/local/hd-key) --- title: "HD Key Accounts" icon: "tree" --- ## Overview HD Key Accounts create Avalanche accounts from hierarchical deterministic (HD) keys with custom derivation paths. This allows for advanced key management and multiple account generation from a single seed. ## Creating HD Key Accounts ### Basic Usage ```typescript import { hdKeyToAvalancheAccount, HDKey } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const seed: Uint8Array = new Uint8Array(64); // Your seed const hdKey: HDKey = HDKey.fromMasterSeed(seed); const account: AvalancheAccount = hdKeyToAvalancheAccount(hdKey); ``` ### Parameters - **`hdKey: HDKey`** - The HD key instance (required) - **`options?: HDKeyToAvalancheAccountOptions`** - Custom derivation path options (optional) ### Options ```typescript interface HDKeyToAvalancheAccountOptions { accountIndex?: number; // Account index (default: 0) addressIndex?: number; // Address index (default: 0) changeIndex?: number; // Change index (default: 0) xpAccountIndex?: number; // XP account index (default: 0) xpAddressIndex?: number; // XP address index (default: 0) xpChangeIndex?: number; // XP change index (default: 0) path?: string; // Custom derivation path for EVM Account xpPath?: string; // Custom derivation path for XP Account } ``` ## Derivation Paths ### Default Derivation Paths HD Key accounts use BIP-44 derivation paths to generate deterministic keys from a seed. By default, the SDK uses separate paths for EVM (C-Chain) and XP (X/P-Chain) accounts: **EVM (C-Chain) Path:** ``` m/44'/60'/{accountIndex}'/{changeIndex}/{addressIndex} ``` **XP (X/P-Chain) Path:** ``` m/44'/9000'/{xpAccountIndex}'/{xpChangeIndex}/{xpAddressIndex} ``` **Path Components:** - `m` - Master key - `44'` - BIP-44 purpose (hardened) - `60'` (EVM) or `9000'` (XP) - Coin type (hardened) - `60` is the standard Ethereum coin type (used for C-Chain) - `9000` is the Avalanche coin type (used for X/P-Chain) - `{accountIndex}'` - Account index (hardened, default: 0) - `{changeIndex}` - Change index (default: 0) - `0` is typically used for external addresses - `1` is typically used for change addresses - `{addressIndex}` - Address index (default: 0) **Default Values:** When no options are provided, both paths default to `m/44'/60'/0'/0/0` (EVM) and `m/44'/9000'/0'/0/0` (XP). ### How Index Options Affect Paths The following table shows how different index combinations affect the derivation paths: | Option | EVM Path | XP Path | Notes | | ---------------------------------- | ------------------ | -------------------- | ------------------------------- | | Default (no options) | `m/44'/60'/0'/0/0` | `m/44'/9000'/0'/0/0` | Both use index 0 | | `accountIndex: 1` | `m/44'/60'/1'/0/0` | `m/44'/9000'/1'/0/0` | Both use account index 1 | | `addressIndex: 2` | `m/44'/60'/0'/0/2` | `m/44'/9000'/0'/0/2` | Both use address index 2 | | `changeIndex: 1` | `m/44'/60'/0'/1/0` | `m/44'/9000'/0'/1/0` | Both use change index 1 | | `accountIndex: 1, addressIndex: 2` | `m/44'/60'/1'/0/2` | `m/44'/9000'/1'/0/2` | Combined indices | | `xpAccountIndex: 2` | `m/44'/60'/0'/0/0` | `m/44'/9000'/2'/0/0` | XP uses different account index | | `xpAddressIndex: 3` | `m/44'/60'/0'/0/0` | `m/44'/9000'/0'/0/3` | XP uses different address index | | `xpChangeIndex: 1` | `m/44'/60'/0'/0/0` | `m/44'/9000'/0'/1/0` | XP uses different change index | **Important Notes:** - When you specify `accountIndex`, `addressIndex`, or `changeIndex`, they apply to EVM path. - XP-specific options (`xpAccountIndex`, `xpAddressIndex`, `xpChangeIndex`) only affect the XP path, allowing you to use different indices for XP accounts while keeping EVM indices separate. ### Custom Path Override **Important Limitation**: When the `path` or `xpPath` option is provided, it overrides the EVM or XP derivation paths. When you provide a custom `path` or `xpPath`, it completely replaces the default path calculation for EVM and XP accounts: ```typescript import { hdKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; // ⚠️ WARNING: This path will be used for EVM accounts const account: AvalancheAccount = hdKeyToAvalancheAccount(hdKey, { path: "m/44'/60'/0'/0/0", // EVM will use this path }); // ⚠️ WARNING: This path will be used for XP accounts const account: AvalancheAccount = hdKeyToAvalancheAccount(hdKey, { xpPath: "m/44'/60'/0'/0/0", // XP Account will use this path }); // The following options are IGNORED when path is provided: // accountIndex, addressIndex, changeIndex // xpAccountIndex, xpAddressIndex, xpChangeIndex ``` **When to Use Custom Paths:** - When you need to match a specific wallet's derivation path - When migrating from another wallet implementation - When you need full control over the derivation path **When NOT to Use Custom Paths:** - When you want different paths for EVM and XP accounts (use index options instead) - When you want to leverage the default BIP-44 compliant paths - In most standard use cases ### Examples ```typescript import { hdKeyToAvalancheAccount, HDKey } from "@avalanche-sdk/client/accounts"; const hdKey = HDKey.fromMasterSeed(seed); // Default paths (EVM: m/44'/60'/0'/0/0, XP: m/44'/9000'/0'/0/0) const account = hdKeyToAvalancheAccount(hdKey); // Different indices const account1 = hdKeyToAvalancheAccount(hdKey, { accountIndex: 1 }); const account2 = hdKeyToAvalancheAccount(hdKey, { addressIndex: 1 }); // Separate EVM and XP indices const account3 = hdKeyToAvalancheAccount(hdKey, { accountIndex: 0, // EVM xpAccountIndex: 2, // XP }); // Custom path (⚠️ applies to both EVM and XP) const account4 = hdKeyToAvalancheAccount(hdKey, { path: "m/44'/60'/0'/0/0", }); ``` ## Multiple Accounts Generate multiple accounts from the same HD key: ```typescript import { hdKeyToAvalancheAccount, HDKey } from "@avalanche-sdk/client/accounts"; const hdKey = HDKey.fromMasterSeed(seed); const account1 = hdKeyToAvalancheAccount(hdKey, { addressIndex: 0 }); const account2 = hdKeyToAvalancheAccount(hdKey, { addressIndex: 1 }); const account3 = hdKeyToAvalancheAccount(hdKey, { addressIndex: 2 }); ``` ## Using with Wallet Client ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); const txHash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: avaxToWei(0.001), }); ``` ## Security **Never expose seeds in client-side code or commit them to version control. Use environment variables.** ```typescript // ✅ Good const seed = new Uint8Array(Buffer.from(process.env.SEED!, "hex")); const hdKey = HDKey.fromMasterSeed(seed); // ❌ Bad const seed = new Uint8Array(64); // Hardcoded seed ``` ## Next Steps - **[Account Utilities](utilities)** - Account validation and utilities - **[Using Accounts with Clients](clients)** - Client integration patterns # Local Accounts (/docs/tooling/avalanche-sdk/client/accounts/local) --- title: Local Accounts icon: shield description: Learn how to create and manage local accounts in the Avalanche Client SDK with private keys, mnemonics, and HD keys. --- ## Overview Local accounts store keys on your machine and sign transactions before broadcasting. Use these for server-side apps, bots, or when you need full control. **Security:** Never expose private keys or mnemonics in client-side code or commit them to version control. Use environment variables. ## Quick Start ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount(process.env.PRIVATE_KEY!); console.log(account.getEVMAddress()); // 0x742d35Cc... console.log(account.getXPAddress("X")); // X-avax1... ``` ## Account Types ### Private Key Simplest option—create an account directly from a private key. ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount("0x..."); ``` [Private Key Accounts →](local/private-key) ### Mnemonic User-friendly option—create an account from a seed phrase. ```typescript import { mnemonicsToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = mnemonicsToAvalancheAccount("abandon abandon abandon..."); ``` [Mnemonic Accounts →](local/mnemonic) ### HD Key Advanced option—create accounts from HD keys with custom derivation paths. ```typescript import { hdKeyToAvalancheAccount, HDKey } from "@avalanche-sdk/client/accounts"; const hdKey = HDKey.fromMasterSeed(seed); const account = hdKeyToAvalancheAccount(hdKey, { accountIndex: 0 }); ``` [HD Key Accounts →](local/hd-key) ## Instantiation ### Setup Wallet Client ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avaxToWei } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount(process.env.PRIVATE_KEY!); const walletClient = createAvalancheWalletClient({ account, // Hoist account to avoid passing it to each method chain: avalanche, transport: { type: "http" }, }); // Use wallet methods const txHash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: avaxToWei(0.001), }); // Use public methods const balance = await walletClient.getBalance({ address: account.getEVMAddress(), }); ``` ## Account Generation ### Generate Private Key ```typescript import { generatePrivateKey, privateKeyToAvalancheAccount, } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const privateKey: string = generatePrivateKey(); const account: AvalancheAccount = privateKeyToAvalancheAccount(privateKey); ``` ### Generate Mnemonic ```typescript import { generateMnemonic, mnemonicsToAvalancheAccount, } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const mnemonic: string = generateMnemonic(); const account: AvalancheAccount = mnemonicsToAvalancheAccount(mnemonic); ``` ## Address Management ### Get All Addresses ```typescript const addresses = { evm: account.getEVMAddress(), xChain: account.getXPAddress("X"), pChain: account.getXPAddress("P"), }; console.log("EVM Address:", addresses.evm); console.log("X-Chain Address:", addresses.xChain); console.log("P-Chain Address:", addresses.pChain); ``` **Learn more:** For network-specific addresses and detailed address management examples, see [Network-Specific Addresses](local/addresses). ## Security **Never expose private keys or mnemonics in client-side code or commit them to version control. Always use environment variables.** ```typescript // ✅ Good: Use environment variables const account = privateKeyToAvalancheAccount(process.env.PRIVATE_KEY!); // ❌ Bad: Hardcoded private key const account = privateKeyToAvalancheAccount("0x1234..."); ``` ## Learn More - [Account Generation](#account-generation) - Create secure accounts - [Address Management](#address-management) - Multi-network addresses - [Using with Clients](local/clients) - Client integration - [HD Key Accounts](local/hd-key) - Hierarchical deterministic accounts - [Account Utilities](local/utilities) - Validation and helpers - [Network-Specific Addresses](local/addresses) - Advanced address management # Mnemonic Accounts (/docs/tooling/avalanche-sdk/client/accounts/local/mnemonic) --- title: "Mnemonic Accounts" icon: "seedling" --- ## Overview Mnemonic Accounts create Avalanche accounts from mnemonic phrases (seed words). Mnemonics provide a human-readable way to backup and restore accounts, making them ideal for user-facing applications. **Best for:** - User-facing applications - Mobile wallets - Desktop wallets - Applications requiring easy account recovery ## Creating Mnemonic Accounts ### Basic Usage ```typescript import { mnemonicsToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const mnemonic = "abandon abandon abandon abandon abandon abandon abandon abandon abandon abandon abandon about"; const account: AvalancheAccount = mnemonicsToAvalancheAccount(mnemonic); console.log("EVM Address:", account.getEVMAddress()); console.log("X-Chain Address:", account.getXPAddress("X")); console.log("P-Chain Address:", account.getXPAddress("P")); ``` ### Parameters - **`mnemonic: string`** - The mnemonic phrase (required) - **`options?: MnemonicToAccountOptions`** - Optional derivation path configuration ### Options Interface ```typescript interface MnemonicToAccountOptions { accountIndex?: number; // Account index (default: 0) addressIndex?: number; // Address index (default: 0) changeIndex?: number; // Change index (default: 0) xpAccountIndex?: number; // XP account index (default: 0) xpAddressIndex?: number; // XP address index (default: 0) xpChangeIndex?: number; // XP change index (default: 0) path?: string; // Custom derivation path for EVM Account xpPath?: string; // Custom derivation path for XP Account } ``` ## Generating Mnemonics ### Generate Random Mnemonic ```typescript import { generateMnemonic, mnemonicsToAvalancheAccount, } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const mnemonic: string = generateMnemonic(); console.log("Generated mnemonic:", mnemonic); const account: AvalancheAccount = mnemonicsToAvalancheAccount(mnemonic); console.log("EVM address:", account.getEVMAddress()); console.log("X-Chain address:", account.getXPAddress("X")); console.log("P-Chain address:", account.getXPAddress("P")); // ⚠️ IMPORTANT: Store mnemonic securely // Never log it in production or commit to version control ``` ### Generate Mnemonic in Different Languages ```typescript import { generateMnemonic, english, spanish, japanese, } from "@avalanche-sdk/client/accounts"; // Generate mnemonic in different languages const englishMnemonic = generateMnemonic(english); const spanishMnemonic = generateMnemonic(spanish); const japaneseMnemonic = generateMnemonic(japanese); // Also available: french, italian, portuguese, czech, korean, simplifiedChinese, traditionalChinese ``` ## Derivation Paths ### Default Derivation Paths The Avalanche Client SDK uses different derivation paths for EVM and XP accounts: ```typescript // EVM (C-Chain) derivation path // Standard BIP44 path for Ethereum const evmPath = "m/44'/60'/0'/0/0"; // m/44'/60'/{accountIndex}'/{changeIndex}/{addressIndex} // XP (X/P-Chain) derivation path // Standard BIP44 path for Avalanche const xpPath = "m/44'/9000'/0'/0/0"; // m/44'/9000'/{xpAccountIndex}'/{xpChangeIndex}/{xpAddressIndex} ``` ### Custom Derivation Paths ```typescript import { mnemonicsToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const mnemonic = "abandon abandon abandon..."; // Create account with custom derivation paths const account: AvalancheAccount = mnemonicsToAvalancheAccount(mnemonic, { accountIndex: 0, addressIndex: 0, changeIndex: 0, path: "m/44'/60'/0'/0/0", // Custom path }); ``` ### Multiple Accounts from Same Mnemonic ```typescript import { mnemonicsToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const mnemonic = "abandon abandon abandon..."; // Different account indices const account0 = mnemonicsToAvalancheAccount(mnemonic, { accountIndex: 0 }); const account1 = mnemonicsToAvalancheAccount(mnemonic, { accountIndex: 1 }); // Different address indices const addr0 = mnemonicsToAvalancheAccount(mnemonic, { addressIndex: 0 }); const addr1 = mnemonicsToAvalancheAccount(mnemonic, { addressIndex: 1 }); ``` ## Getting Addresses ```typescript const account = mnemonicsToAvalancheAccount(mnemonic); // All chain addresses const evmAddress = account.getEVMAddress(); const xChainAddress = account.getXPAddress("X"); const pChainAddress = account.getXPAddress("P"); // Network-specific const mainnet = account.getXPAddress("X", "avax"); const testnet = account.getXPAddress("X", "fuji"); ``` ## Using with Wallet Client ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; import { mnemonicsToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = mnemonicsToAvalancheAccount(process.env.MNEMONIC!); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // C-Chain transaction const txHash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: 0.001, }); // X/P-Chain transaction const xpTx = await walletClient.xChain.prepareBaseTxn({ outputs: [{ addresses: [account.getXPAddress("X")], amount: 1 }], }); await walletClient.sendXPTransaction(xpTx); ``` ## Security **Never expose mnemonics in client-side code or commit them to version control. Use environment variables.** ```typescript // ✅ Good const account = mnemonicsToAvalancheAccount(process.env.MNEMONIC!); // ❌ Bad const account = mnemonicsToAvalancheAccount("abandon abandon abandon..."); ``` ## Next Steps - **[HD Key Accounts](accounts/local/hd-key)** - Learn about hierarchical deterministic accounts - **[Account Utilities](accounts/local/utilities)** - Account validation and utilities - **[Using Accounts with Clients](accounts/local/clients)** - Client integration patterns - **[Network-Specific Addresses](accounts/local/addresses)** - Multi-network support # Private Key Accounts (/docs/tooling/avalanche-sdk/client/accounts/local/private-key) --- title: "Private Key Accounts" icon: "key" --- ## Overview Private Key Accounts provide the simplest way to create an Avalanche account from a single private key. They support both EVM (C-Chain) and X/P (X-Chain/P-Chain) operations with unified address management. **Best for:** - Server-side applications - Automated bots and services - Testing and development - Scripts and tools **Security:** Private keys must be kept secure. Never expose private keys in client-side code or commit them to version control. Use environment variables in production. ## Creating Private Key Accounts ### Basic Usage ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const privateKey = "0x1234...your_private_key_here"; const account: AvalancheAccount = privateKeyToAvalancheAccount(privateKey); console.log("EVM Address:", account.getEVMAddress()); console.log("X-Chain Address:", account.getXPAddress("X")); console.log("P-Chain Address:", account.getXPAddress("P")); ``` ### Working with Environment Variables ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount(process.env.PRIVATE_KEY!); ``` ## Generating Private Keys ### Generate Random Private Key ```typescript import { generatePrivateKey, privateKeyToAvalancheAccount, } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const privateKey: string = generatePrivateKey(); console.log("Generated private key:", privateKey); const account: AvalancheAccount = privateKeyToAvalancheAccount(privateKey); console.log("EVM Address:", account.getEVMAddress()); console.log("X-Chain Address:", account.getXPAddress("X")); console.log("P-Chain Address:", account.getXPAddress("P")); ``` ## Account Properties ### EVM Account Each Avalanche account contains an EVM account for C-Chain operations: ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const account: AvalancheAccount = privateKeyToAvalancheAccount("0x..."); // Access EVM account properties const evmAccount = account.evmAccount; console.log("Address:", evmAccount.address); console.log("Type:", evmAccount.type); // "local" console.log("Source:", evmAccount.source); // "privateKey" // Get public key (if available) if (evmAccount.publicKey) { console.log("Public Key:", evmAccount.publicKey); } ``` ### XP Account Each Avalanche account contains an XP account for X-Chain and P-Chain operations: ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount, LocalXPAccount, } from "@avalanche-sdk/client/accounts"; const account: AvalancheAccount = privateKeyToAvalancheAccount("0x..."); // Access XP account properties if (account.xpAccount) { const xpAccount: LocalXPAccount = account.xpAccount; console.log("Public Key:", xpAccount.publicKey); console.log("Type:", xpAccount.type); // "local" console.log("Source:", xpAccount.source); // "privateKey" } ``` ## Address Management ### Get All Addresses ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const account: AvalancheAccount = privateKeyToAvalancheAccount("0x..."); // Get all addresses const addresses = { evm: account.getEVMAddress(), // "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6" xChain: account.getXPAddress("X"), // "X-avax1..." pChain: account.getXPAddress("P"), // "P-avax1..." base: account.getXPAddress(), // "avax1..." (without chain prefix) }; console.log("All Addresses:", addresses); ``` ### Network-Specific Addresses ```typescript import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount } from "@avalanche-sdk/client/accounts"; const account: AvalancheAccount = privateKeyToAvalancheAccount("0x..."); // Mainnet addresses (default) const mainnetAddresses = { evm: account.getEVMAddress(), xChain: account.getXPAddress("X", "avax"), pChain: account.getXPAddress("P", "avax"), }; // Testnet (Fuji) addresses const testnetAddresses = { evm: account.getEVMAddress(), xChain: account.getXPAddress("X", "fuji"), pChain: account.getXPAddress("P", "fuji"), }; console.log("Mainnet:", mainnetAddresses); console.log("Testnet:", testnetAddresses); ``` ## Using with Wallet Client ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount(process.env.PRIVATE_KEY!); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // C-Chain transaction const txHash = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: 0.001, }); // X/P-Chain transaction const xpTx = await walletClient.xChain.prepareBaseTxn({ outputs: [{ addresses: [account.getXPAddress("X")], amount: 1 }], }); await walletClient.sendXPTransaction(xpTx); ``` ## Message Signing ```typescript import { signMessage } from "@avalanche-sdk/client/accounts"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; const account = privateKeyToAvalancheAccount("0x..."); // EVM message signing const evmSignature = await signMessage({ account: account.evmAccount, message: "Hello Avalanche!", }); // XP message signing if (account.xpAccount) { const xpSignature = await account.xpAccount.signMessage("Hello Avalanche!"); const isValid = account.xpAccount.verify("Hello Avalanche!", xpSignature); } ``` ## Security **Never expose private keys in client-side code or commit them to version control. Use environment variables.** ```typescript // ✅ Good const account = privateKeyToAvalancheAccount(process.env.PRIVATE_KEY!); // ❌ Bad const account = privateKeyToAvalancheAccount("0x1234..."); ``` ## Next Steps - **[Mnemonic Accounts](mnemonic)** - Learn about mnemonic-based accounts - **[HD Key Accounts](hd-key)** - Learn about hierarchical deterministic accounts - **[Account Utilities](utilities)** - Account validation and utilities - **[Network-Specific Addresses](addresses)** - Working with different network addresses # Account Utilities (/docs/tooling/avalanche-sdk/client/accounts/local/utilities) --- title: "Account Utilities" icon: "hammer" --- ## Overview Account utilities provide validation, parsing, and helper functions for working with Avalanche accounts and addresses. ## Account Validation ### Parse Avalanche Account ```typescript function parseAvalancheAccount( account: Address | AvalancheAccount | undefined ): AvalancheAccount | undefined; ``` **Parameters:** - `account` (`Address | AvalancheAccount | undefined`): The account or address to parse. Can be an EVM address string, an existing `AvalancheAccount`, or `undefined`. **Returns:** - `AvalancheAccount | undefined`: Returns an `AvalancheAccount` when an address or account is provided, or `undefined` when the input is `undefined`. **Behavior:** The function behaves differently based on the input type: 1. **When an address string is passed**: Returns an `AvalancheAccount` with only `evmAccount` populated. The `xpAccount` property will be `undefined` because an address string alone doesn't contain the private key information needed to derive XP account details. 2. **When an AvalancheAccount is passed**: Returns the account as-is without modification. This is useful for normalizing function parameters that accept both addresses and accounts. 3. **When undefined is passed**: Returns `undefined`. This allows for optional account parameters in functions. **Limitations:** - When parsing from an address string, the returned account will only have `evmAccount` populated. The `xpAccount` property will be `undefined`, which means: - You cannot perform X-Chain or P-Chain operations that require signing (e.g., `account.xpAccount.signMessage()`) - You can still use the account for read-only operations or C-Chain (EVM) operations - To get XP account functionality, you need to create an account from a private key or mnemonic or use a custom provider **Example:** ```typescript import { parseAvalancheAccount } from "@avalanche-sdk/client/accounts"; import type { AvalancheAccount, Address } from "@avalanche-sdk/client/accounts"; // Parse from address string (only evmAccount populated) const address: Address = "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6"; const account = parseAvalancheAccount(address); // account.xpAccount is undefined - can only use for C-Chain operations // Parse existing account (returns as-is) const fullAccount: AvalancheAccount = /* ... */; const normalized = parseAvalancheAccount(fullAccount); // Returns as-is // Handle undefined const optional = parseAvalancheAccount(undefined); // Returns undefined ``` ## Address Utilities ### Private Key to XP Address ```typescript function privateKeyToXPAddress(privateKey: string, hrp: string): XPAddress; ``` **Parameters:** - `privateKey` (`string`): The private key with `0x` prefix. - `hrp` (`string`): The human-readable prefix for the address. Use `"avax"` for mainnet or `"fuji"` for testnet. **Returns:** - `XPAddress`: The Bech32-encoded XP address as a string. **Example:** ```typescript import { privateKeyToXPAddress } from "@avalanche-sdk/client/accounts"; const mainnet = privateKeyToXPAddress("0x...", "avax"); const testnet = privateKeyToXPAddress("0x...", "fuji"); ``` ### Public Key to XP Address ```typescript function publicKeyToXPAddress(publicKey: string, hrp: string): XPAddress; ``` **Parameters:** - `publicKey` (`string`): The public key with `0x` prefix. - `hrp` (`string`): The human-readable prefix for the address. Use `"avax"` for mainnet or `"fuji"` for testnet. **Returns:** - `XPAddress`: The Bech32-encoded XP address as a string. **Example:** ```typescript import { publicKeyToXPAddress } from "@avalanche-sdk/client/accounts"; const xpAddress = publicKeyToXPAddress("0x...", "avax"); ``` ### Private Key to XP Public Key ```typescript function privateKeyToXPPublicKey(privateKey: string): string; ``` **Parameters:** - `privateKey` (`string`): The private key with `0x` prefix. **Returns:** - `string`: The compressed public key in hex format with `0x` prefix. **Example:** ```typescript import { privateKeyToXPPublicKey, publicKeyToXPAddress, } from "@avalanche-sdk/client/accounts"; const publicKey = privateKeyToXPPublicKey("0x..."); const xpAddress = publicKeyToXPAddress(publicKey, "avax"); ``` ## Message Signing ### XP Message Signing ```typescript function xpSignMessage(message: string, privateKey: string): Promise; ``` **Parameters:** - `message` (`string`): The message to sign. - `privateKey` (`string`): The private key with `0x` prefix to sign with. **Returns:** - `Promise`: A promise that resolves to a base58-encoded signature string. **Example:** ```typescript import { xpSignMessage } from "@avalanche-sdk/client/accounts"; const signature = await xpSignMessage("Hello Avalanche!", "0x..."); // Returns base58-encoded signature (e.g., "2k5Jv...") ``` ### XP Transaction Signing ```typescript function xpSignTransaction( txHash: string | Uint8Array, privateKey: string | Uint8Array ): Promise; ``` **Parameters:** - `txHash` (`string | Uint8Array`): The transaction hash to sign. Can be a hex string with `0x` prefix or a `Uint8Array`. - `privateKey` (`string | Uint8Array`): The private key to sign with. Can be a hex string with `0x` prefix or a `Uint8Array`. **Returns:** - `Promise`: A promise that resolves to a hex-encoded signature string with `0x` prefix. **Example:** ```typescript import { xpSignTransaction } from "@avalanche-sdk/client/accounts"; const signature = await xpSignTransaction("0x...", "0x..."); // Returns hex-encoded signature (e.g., "0x1234...") ``` ### Signature Verification ```typescript function xpVerifySignature( signature: string, message: string, publicKey: string ): boolean; ``` **Parameters:** - `signature` (`string`): The signature to verify in hex format with `0x` prefix. - `message` (`string`): The message that was signed. - `publicKey` (`string`): The public key to verify with in hex format with `0x` prefix. **Returns:** - `boolean`: `true` if the signature is valid, `false` otherwise. **Note:** This function expects hex format signatures. For base58 signatures created with `xpSignMessage`, use `xpAccount.verify()` instead. **Example:** ```typescript import { xpVerifySignature } from "@avalanche-sdk/client/accounts"; const isValid = xpVerifySignature("0x...", "Hello Avalanche!", "0x..."); // For base58 signatures from xpSignMessage, use xpAccount.verify() instead ``` ### Public Key Recovery ```typescript function xpRecoverPublicKey(message: string, signature: string): string; ``` **Parameters:** - `message` (`string`): The message that was signed. - `signature` (`string`): The signature in hex format with `0x` prefix. **Returns:** - `string`: The recovered public key as a hex string with `0x` prefix. **Example:** ```typescript import { xpRecoverPublicKey } from "@avalanche-sdk/client/accounts"; const publicKey = xpRecoverPublicKey("Hello Avalanche!", "0x..."); ``` ## XP Account Creation ### Private Key to XP Account ```typescript function privateKeyToXPAccount(privateKey: string): XPAccount; ``` **Parameters:** - `privateKey` (`string`): The private key with `0x` prefix. **Returns:** - `XPAccount`: An XP account object with the following properties: - `publicKey` (`string`): The compressed public key in hex format. - `signMessage(message: string)` (`Promise`): Signs a message and returns a base58-encoded signature. - `signTransaction(txHash: string | Uint8Array)` (`Promise`): Signs a transaction hash and returns a hex-encoded signature. - `verify(message: string, signature: string)` (`boolean`): Verifies a message signature. - `type` (`"local"`): The account type. - `source` (`"privateKey"`): The account source. **Note:** Creates an XP-only account from a private key. Lighter weight than `privateKeyToAvalancheAccount` since it skips EVM account initialization. Use this when you only need X-Chain or P-Chain operations. **Limitations**: No EVM account—can't use for C-Chain operations. If you need both XP and EVM functionality, use `privateKeyToAvalancheAccount` instead. **Example:** ```typescript import { privateKeyToXPAccount } from "@avalanche-sdk/client/accounts"; const xpAccount = privateKeyToXPAccount("0x..."); // Sign message const signature = await xpAccount.signMessage("Hello Avalanche!"); const isValid = xpAccount.verify("Hello Avalanche!", signature); // Sign transaction const txSignature = await xpAccount.signTransaction("0x..."); ``` ## Next Steps - **[Using Accounts with Clients](accounts/local/clients)** - Client integration patterns - **[Wallet Operations](methods/wallet-methods/wallet)** - Learn how to send transactions - **[Account Management](accounts)** - Overview of account management # API Methods (/docs/tooling/avalanche-sdk/client/methods/public-methods/api) --- title: API Methods description: Complete reference for Admin, Info, Health, Index, and ProposerVM API methods --- ## Overview The Avalanche Client SDK provides access to node-level API methods through specialized API clients. These include administrative operations, informational queries, health monitoring, indexed blockchain data access, and ProposerVM operations. ## Admin API Client Provides administrative operations for managing node aliases, logging, and profiling. **Access:** `client.admin` ### alias Assign an API endpoint an alias. **Function Signature:** ```typescript function alias(params: AliasParameters): Promise; interface AliasParameters { endpoint: string; alias: string; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ---------------------- | | `endpoint` | `string` | Yes | API endpoint to alias | | `alias` | `string` | Yes | Alias for the endpoint | **Returns:** | Type | Description | | --------------- | --------------- | | `Promise` | No return value | **Example:** ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); await client.admin.alias({ endpoint: "bc/X", alias: "myAlias", }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/admin-rpc#adminalias) --- ### aliasChain Give a blockchain an alias. **Function Signature:** ```typescript function aliasChain(params: AliasChainParameters): Promise; interface AliasChainParameters { chain: string; alias: string; } ``` **Parameters:** | Name | Type | Required | Description | | ------- | -------- | -------- | ------------------------ | | `chain` | `string` | Yes | Blockchain ID to alias | | `alias` | `string` | Yes | Alias for the blockchain | **Returns:** | Type | Description | | --------------- | --------------- | | `Promise` | No return value | **Example:** ```typescript await client.admin.aliasChain({ chain: "sV6o671RtkGBcno1FiaDbVcFv2sG5aVXMZYzKdP4VQAWmJQnM", alias: "myBlockchainAlias", }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/admin-rpc#adminaliaschain) --- ### getChainAliases Get the aliases of a chain. **Function Signature:** ```typescript function getChainAliases(params: GetChainAliasesParameters): Promise; interface GetChainAliasesParameters { chain: string; } ``` **Parameters:** | Name | Type | Required | Description | | ------- | -------- | -------- | ---------------------- | | `chain` | `string` | Yes | Blockchain ID to query | **Returns:** | Type | Description | | ------------------- | ------------------------------ | | `Promise` | Array of aliases for the chain | **Example:** ```typescript const aliases = await client.admin.getChainAliases({ chain: "sV6o671RtkGBcno1FiaDbVcFv2sG5aVXMZYzKdP4VQAWmJQnM", }); console.log("Chain aliases:", aliases); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/admin-rpc#admingetchainaliases) --- ### Additional Admin API Methods - **getLoggerLevel** - Get log and display levels of loggers - **setLoggerLevel** - Set log and display levels of loggers - **loadVMs** - Dynamically loads virtual machines - **lockProfile** - Writes mutex statistics to `lock.profile` - **memoryProfile** - Writes memory profile to `mem.profile` - **startCPUProfiler** - Start CPU profiling - **stopCPUProfiler** - Stop CPU profiler See the [Admin API documentation](clients/api-clients#admin-api-client) for complete details. --- ## Info API Client Provides node information and network statistics. **Access:** `client.info` ### getNetworkID Get the ID of the network this node is participating in. **Function Signature:** ```typescript function getNetworkID(): Promise; interface GetNetworkIDReturnType { networkID: string; } ``` **Returns:** | Type | Description | | ------------------------ | ----------------- | | `GetNetworkIDReturnType` | Network ID object | **Return Object:** | Property | Type | Description | | ----------- | -------- | ---------------------------------------------- | | `networkID` | `string` | Network ID (1 for Mainnet, 5 for Fuji testnet) | **Example:** ```typescript const result = await client.info.getNetworkID(); if (result.networkID === "1") { console.log("Connected to Mainnet"); } else if (result.networkID === "5") { console.log("Connected to Fuji testnet"); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infogetnetworkid) --- ### getNetworkName Get the name of the network this node is participating in. **Function Signature:** ```typescript function getNetworkName(): Promise; interface GetNetworkNameReturnType { networkName: string; } ``` **Returns:** | Type | Description | | -------------------------- | ------------------- | | `GetNetworkNameReturnType` | Network name object | **Return Object:** | Property | Type | Description | | ------------- | -------- | -------------------------------------- | | `networkName` | `string` | Network name (e.g., "mainnet", "fuji") | **Example:** ```typescript const result = await client.info.getNetworkName(); console.log("Network:", result.networkName); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infogetnetworkname) --- ### getNodeVersion Get the version of this node. **Function Signature:** ```typescript function getNodeVersion(): Promise; interface GetNodeVersionReturnType { version: string; databaseVersion: string; gitCommit: string; vmVersions: Map; rpcProtocolVersion: string; } ``` **Returns:** | Type | Description | | -------------------------- | ------------------- | | `GetNodeVersionReturnType` | Node version object | **Return Object:** | Property | Type | Description | | -------------------- | --------------------- | -------------------------------------- | | `version` | `string` | Node version (e.g., "avalanche/1.9.4") | | `databaseVersion` | `string` | Database version | | `gitCommit` | `string` | Git commit hash | | `vmVersions` | `Map` | Map of VM IDs to their versions | | `rpcProtocolVersion` | `string` | RPC protocol version | **Example:** ```typescript const version = await client.info.getNodeVersion(); console.log("Node version:", version.version); console.log("Database version:", version.databaseVersion); console.log("VM versions:", Object.fromEntries(version.vmVersions)); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infogetnodeversion) --- ### getNodeID Get the node ID, BLS key, and proof of possession. **Function Signature:** ```typescript function getNodeID(): Promise; interface GetNodeIDReturnType { nodeID: string; nodePOP: { publicKey: string; proofOfPossession: string; }; } ``` **Returns:** | Type | Description | | --------------------- | -------------- | | `GetNodeIDReturnType` | Node ID object | **Return Object:** | Property | Type | Description | | --------------------------- | -------- | ----------------------------------------------- | | `nodeID` | `string` | Unique identifier of the node | | `nodePOP.publicKey` | `string` | 48 byte hex representation of the BLS key | | `nodePOP.proofOfPossession` | `string` | 96 byte hex representation of the BLS signature | **Example:** ```typescript const nodeID = await client.info.getNodeID(); console.log("Node ID:", nodeID.nodeID); console.log("BLS Public Key:", nodeID.nodePOP.publicKey); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infogetnodeid) --- ### getNodeIP Get the IP address of the node. **Function Signature:** ```typescript function getNodeIP(): Promise; interface GetNodeIPReturnType { ip: string; } ``` **Returns:** | Type | Description | | --------------------- | -------------- | | `GetNodeIPReturnType` | Node IP object | **Return Object:** | Property | Type | Description | | -------- | -------- | ---------------------- | | `ip` | `string` | IP address of the node | **Example:** ```typescript const result = await client.info.getNodeIP(); console.log("Node IP:", result.ip); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infogetnodeip) --- ### getBlockchainID Get blockchain ID from alias. **Function Signature:** ```typescript function getBlockchainID( params: GetBlockchainIDParameters ): Promise; interface GetBlockchainIDParameters { alias: string; } interface GetBlockchainIDReturnType { blockchainID: string; } ``` **Parameters:** | Name | Type | Required | Description | | ------- | -------- | -------- | --------------------------------- | | `alias` | `string` | Yes | Blockchain alias (e.g., "X", "P") | **Returns:** | Type | Description | | --------------------------- | -------------------- | | `GetBlockchainIDReturnType` | Blockchain ID object | **Return Object:** | Property | Type | Description | | -------------- | -------- | -------------------- | | `blockchainID` | `string` | ID of the blockchain | **Example:** ```typescript const result = await client.info.getBlockchainID({ alias: "X" }); console.log("X-Chain ID:", result.blockchainID); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infogetblockchainid) --- ### getTxFee Get transaction fees for various operations. **Function Signature:** ```typescript function getTxFee(): Promise; interface GetTxFeeReturnType { txFee: bigint; createAssetTxFee: bigint; createSubnetTxFee: bigint; transformSubnetTxFee: bigint; createBlockchainTxFee: bigint; addPrimaryNetworkValidatorFee: bigint; addPrimaryNetworkDelegatorFee: bigint; addSubnetValidatorFee: bigint; addSubnetDelegatorFee: bigint; } ``` **Returns:** | Type | Description | | -------------------- | ----------------------- | | `GetTxFeeReturnType` | Transaction fees object | **Return Object:** | Property | Type | Description | | ------------------------------- | -------- | ------------------------------------------ | | `txFee` | `bigint` | Base transaction fee | | `createAssetTxFee` | `bigint` | Fee for creating an asset | | `createSubnetTxFee` | `bigint` | Fee for creating a subnet | | `transformSubnetTxFee` | `bigint` | Fee for transforming a subnet | | `createBlockchainTxFee` | `bigint` | Fee for creating a blockchain | | `addPrimaryNetworkValidatorFee` | `bigint` | Fee for adding a primary network validator | | `addPrimaryNetworkDelegatorFee` | `bigint` | Fee for adding a primary network delegator | | `addSubnetValidatorFee` | `bigint` | Fee for adding a subnet validator | | `addSubnetDelegatorFee` | `bigint` | Fee for adding a subnet delegator | **Example:** ```typescript const fees = await client.info.getTxFee(); console.log("Base transaction fee:", fees.txFee); console.log("Create asset fee:", fees.createAssetTxFee); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infogettxfee) --- ### getVMs Get supported virtual machines. **Function Signature:** ```typescript function getVMs(): Promise; interface GetVMsReturnType { vms: { [key: string]: string[]; }; } ``` **Returns:** | Type | Description | | ------------------ | ----------- | | `GetVMsReturnType` | VMs object | **Return Object:** | Property | Type | Description | | -------- | ----------------------------- | ------------------------------ | | `vms` | `{ [key: string]: string[] }` | Map of VM IDs to their aliases | **Example:** ```typescript const vms = await client.info.getVMs(); console.log("Supported VMs:", vms.vms); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infogetvms) --- ### isBootstrapped Check whether a given chain is done bootstrapping. **Function Signature:** ```typescript function isBootstrapped( params: IsBootstrappedParameters ): Promise; interface IsBootstrappedParameters { chain: string; } interface IsBootstrappedReturnType { isBootstrapped: boolean; } ``` **Parameters:** | Name | Type | Required | Description | | ------- | -------- | -------- | ----------------------------- | | `chain` | `string` | Yes | Chain ID or alias (e.g., "X") | **Returns:** | Type | Description | | -------------------------- | ------------------- | | `IsBootstrappedReturnType` | Bootstrapped status | **Return Object:** | Property | Type | Description | | ---------------- | --------- | --------------------------------------- | | `isBootstrapped` | `boolean` | Whether the chain is done bootstrapping | **Example:** ```typescript const result = await client.info.isBootstrapped({ chain: "X" }); if (result.isBootstrapped) { console.log("X-Chain is bootstrapped"); } else { console.log("X-Chain is still bootstrapping"); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infoisbootstrapped) --- ### peers Get peer information. **Function Signature:** ```typescript function peers(params: PeersParameters): Promise; interface PeersParameters { nodeIDs?: string[]; } interface PeersReturnType { numPeers: number; peers: { ip: string; publicIP: string; nodeID: string; version: string; lastSent: string; lastReceived: string; benched: string[]; observedUptime: number; }[]; } ``` **Parameters:** | Name | Type | Required | Description | | --------- | ---------- | -------- | ------------------------------------ | | `nodeIDs` | `string[]` | No | Optional array of node IDs to filter | **Returns:** | Type | Description | | ----------------- | ------------ | | `PeersReturnType` | Peers object | **Return Object:** | Property | Type | Description | | ---------- | -------- | --------------------------------- | | `numPeers` | `number` | Number of connected peers | | `peers` | `array` | Array of peer information objects | **Peer Object:** | Property | Type | Description | | ---------------- | ---------- | -------------------------------------------------- | | `ip` | `string` | Remote IP of the peer | | `publicIP` | `string` | Public IP of the peer | | `nodeID` | `string` | Prefixed Node ID of the peer | | `version` | `string` | Version the peer is running | | `lastSent` | `string` | Timestamp of last message sent to the peer | | `lastReceived` | `string` | Timestamp of last message received from the peer | | `benched` | `string[]` | Array of chain IDs the peer is benched on | | `observedUptime` | `number` | Node's primary network uptime observed by the peer | **Example:** ```typescript const peers = await client.info.peers(); console.log("Number of peers:", peers.numPeers); console.log("Peer details:", peers.peers); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infopeers) --- ### uptime Get node uptime statistics. **Function Signature:** ```typescript function uptime(): Promise; interface UptimeReturnType { rewardingStakePercentage: number; weightedAveragePercentage: number; } ``` **Returns:** | Type | Description | | ------------------ | ------------- | | `UptimeReturnType` | Uptime object | **Return Object:** | Property | Type | Description | | --------------------------- | -------- | ----------------------------------------------------------------------- | | `rewardingStakePercentage` | `number` | Percent of stake which thinks this node is above the uptime requirement | | `weightedAveragePercentage` | `number` | Stake-weighted average of all observed uptimes for this node | **Example:** ```typescript const uptime = await client.info.uptime(); console.log("Rewarding stake percentage:", uptime.rewardingStakePercentage); console.log("Weighted average percentage:", uptime.weightedAveragePercentage); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infouptime) --- ### upgrades Get upgrade history. **Function Signature:** ```typescript function upgrades(): Promise; interface UpgradesReturnType { apricotPhase1Time: string; apricotPhase2Time: string; apricotPhase3Time: string; apricotPhase4Time: string; apricotPhase4MinPChainHeight: number; apricotPhase5Time: string; apricotPhasePre6Time: string; apricotPhase6Time: string; apricotPhasePost6Time: string; banffTime: string; cortinaTime: string; cortinaXChainStopVertexID: string; durangoTime: string; etnaTime: string; fortunaTime?: string; } ``` **Returns:** | Type | Description | | -------------------- | --------------- | | `UpgradesReturnType` | Upgrades object | **Return Object:** | Property | Type | Description | | ------------------------------ | --------- | ------------------------------------------ | | `apricotPhase1Time` | `string` | Timestamp of Apricot Phase 1 upgrade | | `apricotPhase2Time` | `string` | Timestamp of Apricot Phase 2 upgrade | | `apricotPhase3Time` | `string` | Timestamp of Apricot Phase 3 upgrade | | `apricotPhase4Time` | `string` | Timestamp of Apricot Phase 4 upgrade | | `apricotPhase4MinPChainHeight` | `number` | Minimum P-Chain height for Apricot Phase 4 | | `apricotPhase5Time` | `string` | Timestamp of Apricot Phase 5 upgrade | | `apricotPhasePre6Time` | `string` | Timestamp of Apricot Phase Pre-6 upgrade | | `apricotPhase6Time` | `string` | Timestamp of Apricot Phase 6 upgrade | | `apricotPhasePost6Time` | `string` | Timestamp of Apricot Phase Post-6 upgrade | | `banffTime` | `string` | Timestamp of Banff upgrade | | `cortinaTime` | `string` | Timestamp of Cortina upgrade | | `cortinaXChainStopVertexID` | `string` | X-Chain stop vertex ID for Cortina upgrade | | `durangoTime` | `string` | Timestamp of Durango upgrade | | `etnaTime` | `string` | Timestamp of Etna upgrade | | `fortunaTime` | `string?` | Timestamp of Fortuna upgrade (optional) | **Example:** ```typescript const upgrades = await client.info.upgrades(); console.log("Apricot Phase 1:", upgrades.apricotPhase1Time); console.log("Banff upgrade:", upgrades.banffTime); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infoupgrades) --- ### acps Get peer preferences for Avalanche Community Proposals. **Function Signature:** ```typescript function acps(): Promise; interface AcpsReturnType { acps: Map< number, { supportWeight: bigint; supporters: Set; objectWeight: bigint; objectors: Set; abstainWeight: bigint; } >; } ``` **Returns:** | Type | Description | | ---------------- | ----------- | | `AcpsReturnType` | ACPs object | **Return Object:** | Property | Type | Description | | -------- | ----- | ---------------------------------------- | | `acps` | `Map` | Map of ACP IDs to their peer preferences | **ACP Object:** | Property | Type | Description | | --------------- | ------------- | --------------------------------------- | | `supportWeight` | `bigint` | Weight of stake supporting the ACP | | `supporters` | `Set` | Set of node IDs supporting the ACP | | `objectWeight` | `bigint` | Weight of stake objecting to the ACP | | `objectors` | `Set` | Set of node IDs objecting to the ACP | | `abstainWeight` | `bigint` | Weight of stake abstaining from the ACP | **Example:** ```typescript const acps = await client.info.acps(); console.log("ACP preferences:", acps.acps); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/info-rpc#infoacps) --- ## Health API Client Provides health monitoring for the node. **Access:** `client.health` ### health Get health check results for the node. **Function Signature:** ```typescript function health(params: HealthParameters): Promise; interface HealthParameters { tags?: string[]; } interface HealthReturnType { healthy: boolean; checks: { C: ChainHealthCheck; P: ChainHealthCheck; X: ChainHealthCheck; bootstrapped: { message: any[]; timestamp: string; duration: number; }; database: { timestamp: string; duration: number; }; diskspace: { message: { availableDiskBytes: number; }; timestamp: string; duration: number; }; network: { message: { connectedPeers: number; sendFailRate: number; timeSinceLastMsgReceived: string; timeSinceLastMsgSent: string; }; timestamp: string; duration: number; }; router: { message: { longestRunningRequest: string; outstandingRequests: number; }; timestamp: string; duration: number; }; }; } type ChainHealthCheck = { message: { engine: { consensus: { lastAcceptedHeight: number; lastAcceptedID: string; longestProcessingBlock: string; processingBlocks: number; }; vm: null; }; networking: { percentConnected: number; }; }; timestamp: string; duration: number; }; ``` **Parameters:** | Name | Type | Required | Description | | ------ | ---------- | -------- | ------------------------------------- | | `tags` | `string[]` | No | Optional tags to filter health checks | **Returns:** | Type | Description | | ------------------ | -------------------- | | `HealthReturnType` | Health check results | **Return Object:** | Property | Type | Description | | --------- | --------- | --------------------------------------- | | `healthy` | `boolean` | Overall health status of the node | | `checks` | `object` | Health check results for each component | **Example:** ```typescript const healthStatus = await client.health.health({ tags: ["11111111111111111111111111111111LpoYY"], }); console.log("Node healthy:", healthStatus.healthy); console.log("C-Chain health:", healthStatus.checks.C); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/health-rpc#healthhealth) --- ### liveness Get liveness check indicating if the node is alive and can handle requests. **Function Signature:** ```typescript function liveness(): Promise; interface LivenessReturnType { checks: object; healthy: boolean; } ``` **Returns:** | Type | Description | | -------------------- | --------------------- | | `LivenessReturnType` | Liveness check result | **Return Object:** | Property | Type | Description | | --------- | --------- | ------------------------------------------------------ | | `checks` | `object` | Liveness check details | | `healthy` | `boolean` | Indicates if the node is alive and can handle requests | **Example:** ```typescript const livenessStatus = await client.health.liveness(); if (livenessStatus.healthy) { console.log("Node is alive and responding"); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/health-rpc#healthliveness) --- ### readiness Get readiness check indicating if the node has finished initializing. **Function Signature:** ```typescript function readiness(params: ReadinessParameters): Promise; interface ReadinessParameters { tags?: string[]; } interface ReadinessReturnType { checks: { [key: string]: { message: { timestamp: string; duration: number; contiguousFailures: number; timeOfFirstFailure: string | null; }; healthy: boolean; }; }; healthy: boolean; } ``` **Parameters:** | Name | Type | Required | Description | | ------ | ---------- | -------- | ---------------------------------------- | | `tags` | `string[]` | No | Optional tags to filter readiness checks | **Returns:** | Type | Description | | --------------------- | ---------------------- | | `ReadinessReturnType` | Readiness check result | **Return Object:** | Property | Type | Description | | --------- | --------- | ------------------------------------------ | | `checks` | `object` | Readiness check results for each component | | `healthy` | `boolean` | Overall readiness status of the node | **Example:** ```typescript const readinessStatus = await client.health.readiness({ tags: ["11111111111111111111111111111111LpoYY"], }); if (readinessStatus.healthy) { console.log("Node is ready to handle requests"); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/health-rpc#healthreadiness) --- ## Index API Clients Provides indexed blockchain data queries for fast container lookups. **Access:** - `client.indexBlock.pChain` - P-Chain block index - `client.indexBlock.cChain` - C-Chain block index - `client.indexBlock.xChain` - X-Chain block index - `client.indexTx.xChain` - X-Chain transaction index ### getContainerByIndex Get container by its index. **Function Signature:** ```typescript function getContainerByIndex( params: GetContainerByIndexParameters ): Promise; interface GetContainerByIndexParameters { index: number; encoding: "hex"; } interface GetContainerByIndexReturnType { id: string; bytes: string; timestamp: string; encoding: "hex"; index: string; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ----------------------------------------------- | | `index` | `number` | Yes | Container index (first container is at index 0) | | `encoding` | `"hex"` | Yes | Encoding format (only "hex" is supported) | **Returns:** | Type | Description | | ------------------------------- | ---------------- | | `GetContainerByIndexReturnType` | Container object | **Return Object:** | Property | Type | Description | | ----------- | -------- | ------------------------------------------------- | | `id` | `string` | Container's ID | | `bytes` | `string` | Byte representation of the container | | `timestamp` | `string` | Time at which this node accepted the container | | `encoding` | `"hex"` | Encoding format used | | `index` | `string` | How many containers were accepted before this one | **Example:** ```typescript const container = await client.indexBlock.pChain.getContainerByIndex({ index: 12345, encoding: "hex", }); console.log("Container ID:", container.id); console.log("Container bytes:", container.bytes); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/index-rpc#indexgetcontainerbyindex) --- ### getContainerByID Get container by its ID. **Function Signature:** ```typescript function getContainerByID( params: GetContainerByIDParameters ): Promise; interface GetContainerByIDParameters { id: string; encoding: "hex"; } interface GetContainerByIDReturnType { id: string; bytes: string; timestamp: string; encoding: "hex"; index: string; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ----------------------------------------- | | `id` | `string` | Yes | Container's ID | | `encoding` | `"hex"` | Yes | Encoding format (only "hex" is supported) | **Returns:** | Type | Description | | ---------------------------- | ---------------- | | `GetContainerByIDReturnType` | Container object | **Return Object:** | Property | Type | Description | | ----------- | -------- | ------------------------------------------------- | | `id` | `string` | Container's ID | | `bytes` | `string` | Byte representation of the container | | `timestamp` | `string` | Time at which this node accepted the container | | `encoding` | `"hex"` | Encoding format used | | `index` | `string` | How many containers were accepted before this one | **Example:** ```typescript const container = await client.indexBlock.cChain.getContainerByID({ id: "0x123...", encoding: "hex", }); console.log("Container index:", container.index); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/index-rpc#indexgetcontainerbyid) --- ### getContainerRange Get range of containers by index. **Function Signature:** ```typescript function getContainerRange( params: GetContainerRangeParameters ): Promise; interface GetContainerRangeParameters { startIndex: number; endIndex: number; encoding: "hex"; } interface GetContainerRangeReturnType { containers: Array<{ id: string; bytes: string; timestamp: string; encoding: "hex"; index: string; }>; } ``` **Parameters:** | Name | Type | Required | Description | | ------------ | -------- | -------- | --------------------------------------------------- | | `startIndex` | `number` | Yes | Index of the first container to retrieve | | `endIndex` | `number` | Yes | Index of the last container to retrieve (inclusive) | | `encoding` | `"hex"` | Yes | Encoding format (only "hex" is supported) | **Returns:** | Type | Description | | ----------------------------- | ---------------------- | | `GetContainerRangeReturnType` | Container range object | **Return Object:** | Property | Type | Description | | ------------ | ------- | -------------------------- | | `containers` | `array` | Array of container details | **Container Object:** | Property | Type | Description | | ----------- | -------- | ------------------------------------------------- | | `id` | `string` | Container's ID | | `bytes` | `string` | Byte representation of the container | | `timestamp` | `string` | Time at which this node accepted the container | | `encoding` | `"hex"` | Encoding format used | | `index` | `string` | How many containers were accepted before this one | **Example:** ```typescript const range = await client.indexBlock.xChain.getContainerRange({ startIndex: 1000, endIndex: 1010, encoding: "hex", }); console.log("Containers:", range.containers.length); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/index-rpc#indexgetcontainerrange) --- ### getIndex Get container index by ID. **Function Signature:** ```typescript function getIndex(params: GetIndexParameters): Promise; interface GetIndexParameters { id: string; encoding: "hex"; } interface GetIndexReturnType { index: string; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ----------------------------------------- | | `id` | `string` | Yes | Container's ID | | `encoding` | `"hex"` | Yes | Encoding format (only "hex" is supported) | **Returns:** | Type | Description | | -------------------- | ------------ | | `GetIndexReturnType` | Index object | **Return Object:** | Property | Type | Description | | -------- | -------- | ------------------------------------------------------ | | `index` | `string` | Index of the container (first container is at index 0) | **Example:** ```typescript const result = await client.indexTx.xChain.getIndex({ id: "0x123...", encoding: "hex", }); console.log("Container index:", result.index); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/index-rpc#indexgetindex) --- ### getLastAccepted Get last accepted container. **Function Signature:** ```typescript function getLastAccepted( params: GetLastAcceptedParameters ): Promise; interface GetLastAcceptedParameters { encoding: "hex"; } interface GetLastAcceptedReturnType { id: string; bytes: string; timestamp: string; encoding: "hex"; index: string; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | ------- | -------- | ----------------------------------------- | | `encoding` | `"hex"` | Yes | Encoding format (only "hex" is supported) | **Returns:** | Type | Description | | --------------------------- | ------------------------------ | | `GetLastAcceptedReturnType` | Last accepted container object | **Return Object:** | Property | Type | Description | | ----------- | -------- | ------------------------------------------------- | | `id` | `string` | Container's ID | | `bytes` | `string` | Byte representation of the container | | `timestamp` | `string` | Time at which this node accepted the container | | `encoding` | `"hex"` | Encoding format used | | `index` | `string` | How many containers were accepted before this one | **Example:** ```typescript const lastAccepted = await client.indexBlock.pChain.getLastAccepted({ encoding: "hex", }); console.log("Last accepted container ID:", lastAccepted.id); console.log("Last accepted index:", lastAccepted.index); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/index-rpc#indexgetlastaccepted) --- ### isAccepted Check if container is accepted in the index. **Function Signature:** ```typescript function isAccepted( params: IsAcceptedParameters ): Promise; interface IsAcceptedParameters { id: string; encoding: "hex"; } interface IsAcceptedReturnType { isAccepted: boolean; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ----------------------------------------- | | `id` | `string` | Yes | Container's ID | | `encoding` | `"hex"` | Yes | Encoding format (only "hex" is supported) | **Returns:** | Type | Description | | ---------------------- | ------------------------ | | `IsAcceptedReturnType` | Acceptance status object | **Return Object:** | Property | Type | Description | | ------------ | --------- | -------------------------------------- | | `isAccepted` | `boolean` | Whether the container is in this index | **Example:** ```typescript const result = await client.indexBlock.cChain.isAccepted({ id: "0x123...", encoding: "hex", }); if (result.isAccepted) { console.log("Container is accepted"); } else { console.log("Container is not accepted"); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/other/index-rpc#indexisaccepted) --- ## ProposerVM API Client Provides ProposerVM operations for each chain. ProposerVM is responsible for proposing blocks and managing consensus. **Access:** - `client.proposerVM.pChain` - P-Chain ProposerVM - `client.proposerVM.xChain` - X-Chain ProposerVM - `client.proposerVM.cChain` - C-Chain ProposerVM ### getProposedHeight Get the current proposed height for the chain. **Function Signature:** ```typescript function getProposedHeight(): Promise; interface GetProposedHeightReturnType { height: string; } ``` **Returns:** | Type | Description | | ----------------------------- | ---------------------- | | `GetProposedHeightReturnType` | Proposed height object | **Return Object:** | Property | Type | Description | | -------- | -------- | -------------------------------------- | | `height` | `string` | This node's current proposer VM height | **Example:** ```typescript const pChainHeight = await client.proposerVM.pChain.getProposedHeight(); console.log("P-Chain proposed height:", pChainHeight.height); const xChainHeight = await client.proposerVM.xChain.getProposedHeight(); console.log("X-Chain proposed height:", xChainHeight.height); const cChainHeight = await client.proposerVM.cChain.getProposedHeight(); console.log("C-Chain proposed height:", cChainHeight.height); ``` **Related:** - [API Reference](https://build.avax.network/docs/api-reference/proposervm-api#proposervmgetproposedheight) --- ### getCurrentEpoch Get the current epoch information. **Function Signature:** ```typescript function getCurrentEpoch(): Promise; interface GetCurrentEpochReturnType { number: string; startTime: string; pChainHeight: string; } ``` **Returns:** | Type | Description | | --------------------------- | -------------------- | | `GetCurrentEpochReturnType` | Current epoch object | **Return Object:** | Property | Type | Description | | -------------- | -------- | --------------------------------------------- | | `number` | `string` | The current epoch number | | `startTime` | `string` | The epoch start time (Unix timestamp) | | `pChainHeight` | `string` | The P-Chain height at the start of this epoch | **Example:** ```typescript const epoch = await client.proposerVM.pChain.getCurrentEpoch(); console.log("Current epoch:", epoch.number); console.log("Epoch start time:", epoch.startTime); console.log("P-Chain height at epoch start:", epoch.pChainHeight); ``` **Related:** - [API Reference](https://build.avax.network/docs/api-reference/proposervm-api#proposervmgetcurrentepoch) --- ## Next Steps - **[API Clients Documentation](clients/api-clients)** - Detailed API client reference - **[Main Clients](clients)** - Client architecture overview - **[Getting Started](getting-started)** - Quick start guide # C-Chain Methods (/docs/tooling/avalanche-sdk/client/methods/public-methods/c-chain) --- title: C-Chain Methods description: Complete reference for C-Chain (Contract Chain) methods and EVM compatibility --- ## Overview The C-Chain (Contract Chain) is Avalanche's instance of the Ethereum Virtual Machine (EVM), providing full Ethereum compatibility with additional Avalanche-specific features like cross-chain atomic transactions and UTXO management. **Note:** The Avalanche Client SDK fully extends [viem](https://viem.sh), meaning all standard EVM methods are also available. See the [viem documentation](https://viem.sh/docs) for complete EVM method reference. ## Atomic Transaction Operations ### getAtomicTx Get an atomic transaction by its ID. Atomic transactions enable cross-chain transfers between the C-Chain and other Avalanche chains (P-Chain, X-Chain). **Function Signature:** ```typescript function getAtomicTx( params: GetAtomicTxParameters ): Promise; interface GetAtomicTxParameters { txID: string; encoding?: "hex"; } interface GetAtomicTxReturnType { tx: string; blockHeight: string; encoding: "hex"; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ------------------------------------------------------- | | `txID` | `string` | Yes | Transaction ID in CB58 format | | `encoding` | `"hex"` | No | Encoding format for the transaction (defaults to "hex") | **Returns:** | Type | Description | | ----------------------- | ------------------------- | | `GetAtomicTxReturnType` | Atomic transaction object | **Return Object:** | Property | Type | Description | | ------------- | -------- | ---------------------------------------------- | | `tx` | `string` | Transaction bytes in hex format | | `blockHeight` | `string` | Height of the block containing the transaction | | `encoding` | `"hex"` | Encoding format used | **Example:** ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); const atomicTx = await client.cChain.getAtomicTx({ txID: "2QouvMUbQ6oy7yQ9tLvL3L8tGQG2QK1wJ1q1wJ1q1wJ1q1wJ1q1wJ1q1wJ1", }); console.log("Transaction:", atomicTx.tx); console.log("Block height:", atomicTx.blockHeight); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#avaxgetatomictx) - [getAtomicTxStatus](#getatomictxstatus) - Get transaction status --- ### getAtomicTxStatus Get the status of an atomic transaction. Returns the current processing state and block information. **Function Signature:** ```typescript function getAtomicTxStatus( params: GetAtomicTxStatusParameters ): Promise; interface GetAtomicTxStatusParameters { txID: string; } interface GetAtomicTxStatusReturnType { status: CChainAtomicTxStatus; blockHeight: string; } type CChainAtomicTxStatus = "Accepted" | "Processing" | "Dropped" | "Unknown"; ``` **Parameters:** | Name | Type | Required | Description | | ------ | -------- | -------- | ----------------------------- | | `txID` | `string` | Yes | Transaction ID in CB58 format | **Returns:** | Type | Description | | ----------------------------- | ------------------------- | | `GetAtomicTxStatusReturnType` | Transaction status object | **Return Object:** | Property | Type | Description | | ------------- | ---------------------- | --------------------------------------------------------------------- | | `status` | `CChainAtomicTxStatus` | Transaction status: "Accepted", "Processing", "Dropped", or "Unknown" | | `blockHeight` | `string` | Height of the block containing the transaction (if accepted) | **Status Values:** - **Accepted**: Transaction is (or will be) accepted by every node - **Processing**: Transaction is being voted on by this node - **Dropped**: Transaction was dropped by this node because it thought the transaction invalid - **Unknown**: Transaction hasn't been seen by this node **Example:** ```typescript const status = await client.cChain.getAtomicTxStatus({ txID: "2QouvMUbQ6oy7yQ9tLvL3L8tGQG2QK1wJ1q1wJ1q1wJ1q1wJ1q1wJ1q1wJ1", }); console.log("Status:", status.status); if (status.status === "Accepted") { console.log("Block height:", status.blockHeight); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#avaxgetatomictxstatus) - [getAtomicTx](#getatomictx) - Get transaction details --- ## UTXO Operations ### getUTXOs Get the UTXOs (Unspent Transaction Outputs) for a set of addresses. UTXOs represent unspent native AVAX on the C-Chain from imported transactions. **Function Signature:** ```typescript function getUTXOs(params: GetUTXOsParameters): Promise; interface GetUTXOsParameters { addresses: string[]; limit?: number; startIndex?: { address: string; utxo: string; }; sourceChain?: string; encoding?: "hex"; } interface GetUTXOsReturnType { numFetched: number; utxos: string[]; endIndex: { address: string; utxo: string; }; } ``` **Parameters:** | Name | Type | Required | Description | | ------------- | ----------------------------------- | -------- | -------------------------------------------- | | `addresses` | `string[]` | Yes | Array of C-Chain addresses | | `limit` | `number` | No | Maximum number of UTXOs to return (max 1024) | | `startIndex` | `{ address: string; utxo: string }` | No | Pagination cursor for next page | | `sourceChain` | `string` | No | Source chain ID for filtering UTXOs | | `encoding` | `"hex"` | No | Encoding format for returned UTXOs | **Returns:** | Type | Description | | -------------------- | ------------------------- | | `GetUTXOsReturnType` | UTXO data with pagination | **Return Object:** | Property | Type | Description | | ------------ | ----------------------------------- | ---------------------------------------- | | `numFetched` | `number` | Number of UTXOs fetched in this response | | `utxos` | `string[]` | Array of UTXO bytes (hex encoded) | | `endIndex` | `{ address: string; utxo: string }` | Pagination cursor for fetching next page | **Example:** ```typescript // Get UTXOs from X-Chain const utxos = await client.cChain.getUTXOs({ addresses: ["0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6"], limit: 100, sourceChain: "X", }); console.log("Number of UTXOs:", utxos.numFetched); console.log("UTXOs:", utxos.utxos); // Get next page if needed if (utxos.endIndex) { const moreUTXOs = await client.cChain.getUTXOs({ addresses: ["0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6"], startIndex: utxos.endIndex, limit: 100, }); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#avaxgetutxos) - [C-Chain Wallet Methods](../wallet-methods/c-chain-wallet) - Atomic transaction operations --- ## Transaction Operations ### issueTx Issue a transaction to the C-Chain. Submits a signed transaction for processing. **Function Signature:** ```typescript function issueTx(params: IssueTxParameters): Promise; interface IssueTxParameters { tx: string; encoding: "hex"; } interface IssueTxReturnType { txID: string; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ------------------------------- | | `tx` | `string` | Yes | Transaction bytes in hex format | | `encoding` | `"hex"` | Yes | Encoding format (must be "hex") | **Returns:** | Type | Description | | ------------------- | --------------------- | | `IssueTxReturnType` | Transaction ID object | **Return Object:** | Property | Type | Description | | -------- | -------- | ----------------------------- | | `txID` | `string` | Transaction ID in CB58 format | **Example:** ```typescript const txID = await client.cChain.issueTx({ tx: "0x00000009de31b4d8b22991d51aa6aa1fc733f23a851a8c9400000000000186a0...", encoding: "hex", }); console.log("Transaction ID:", txID.txID); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#avaxissuetx) --- ## Admin Operations These methods are available for node administration and debugging. They require admin access to the node. ### setLogLevel Set the log level for the C-Chain node. **Function Signature:** ```typescript function setLogLevel(params: SetLogLevelParameters): Promise; interface SetLogLevelParameters { level: string; } ``` **Parameters:** | Name | Type | Required | Description | | ------- | -------- | -------- | -------------------------------------------------- | | `level` | `string` | Yes | Log level (e.g., "debug", "info", "warn", "error") | **Returns:** | Type | Description | | ------ | -------------------------------------- | | `void` | Promise resolves when log level is set | **Example:** ```typescript await client.cChain.setLogLevel({ level: "info", }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#adminsetloglevel) --- ### startCPUProfiler Start the CPU profiler for performance analysis. **Function Signature:** ```typescript function startCPUProfiler(): Promise; ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | ------ | ----------------------------------------- | | `void` | Promise resolves when profiler is started | **Example:** ```typescript await client.cChain.startCPUProfiler(); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#adminstartcpuprofiler) - [stopCPUProfiler](#stopcpuprofiler) - Stop the CPU profiler --- ### stopCPUProfiler Stop the CPU profiler. **Function Signature:** ```typescript function stopCPUProfiler(): Promise; ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | ------ | ----------------------------------------- | | `void` | Promise resolves when profiler is stopped | **Example:** ```typescript await client.cChain.stopCPUProfiler(); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#adminstopcpuprofiler) - [startCPUProfiler](#startcpuprofiler) - Start the CPU profiler --- ### memoryProfile Get the memory profile of the C-Chain node. **Function Signature:** ```typescript function memoryProfile(): Promise; ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | ------ | ------------------------------------------------- | | `void` | Promise resolves when memory profile is retrieved | **Example:** ```typescript await client.cChain.memoryProfile(); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#adminmemoryprofile) --- ### lockProfile Lock the profile to prevent modifications. **Function Signature:** ```typescript function lockProfile(): Promise; ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | ------ | --------------------------------------- | | `void` | Promise resolves when profile is locked | **Example:** ```typescript await client.cChain.lockProfile(); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#adminlockprofile) --- ## Standard EVM Methods The C-Chain client extends viem's Public Client, providing access to all standard Ethereum methods. Here are some commonly used methods: ### Block Operations ```typescript // Get block number const blockNumber = await client.getBlockNumber(); // Get block by number const block = await client.getBlock({ blockNumber: 12345n, }); // Get block by hash const blockByHash = await client.getBlock({ blockHash: "0x...", }); ``` ### Balance Operations ```typescript // Get balance const balance = await client.getBalance({ address: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", }); // Get balance with block number const balanceAtBlock = await client.getBalance({ address: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", blockNumber: 12345n, }); ``` ### Transaction Operations ```typescript // Get transaction const tx = await client.getTransaction({ hash: "0x...", }); // Get transaction receipt const receipt = await client.getTransactionReceipt({ hash: "0x...", }); // Get transaction count (nonce) const nonce = await client.getTransactionCount({ address: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", }); ``` ### Gas Operations ```typescript // Get gas price const gasPrice = await client.getGasPrice(); // Get max priority fee per gas const maxPriorityFee = await client.maxPriorityFeePerGas(); // Estimate gas const estimatedGas = await client.estimateGas({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", value: parseEther("0.001"), }); ``` ### Contract Operations ```typescript // Read contract const result = await client.readContract({ address: "0x...", abi: [...], functionName: "balanceOf", args: [address], }); // Simulate contract const { request } = await client.simulateContract({ address: "0x...", abi: [...], functionName: "transfer", args: [to, amount], }); ``` **For complete EVM method reference, see:** [Viem Documentation](https://viem.sh/docs) --- ## Next Steps - **[C-Chain Wallet Methods](../wallet-methods/c-chain-wallet)** - Atomic transaction operations - **[Wallet Client](../../clients/wallet-client)** - Complete wallet operations - **[Account Management](../../accounts)** - Account types and management - **[Viem Documentation](https://viem.sh/docs)** - Complete EVM method reference # P-Chain Methods (/docs/tooling/avalanche-sdk/client/methods/public-methods/p-chain) --- title: P-Chain Methods description: Complete reference for P-Chain (Platform Chain) methods --- ## Overview The P-Chain (Platform Chain) is Avalanche's coordinating chain responsible for managing validators, delegators, subnets, and blockchains. This reference covers all read-only P-Chain operations available through the Avalanche Client SDK. ## Balance Operations ### getBalance Get the balance of AVAX controlled by a given address. **Function Signature:** ```typescript function getBalance( params: GetBalanceParameters ): Promise; interface GetBalanceParameters { addresses: string[]; } interface GetBalanceReturnType { balance: bigint; unlocked: bigint; lockedStakeable: bigint; lockedNotStakeable: bigint; utxoIDs: { txID: string; outputIndex: number; }[]; } ``` **Parameters:** | Name | Type | Required | Description | | ----------- | ---------- | -------- | ----------------------------------- | | `addresses` | `string[]` | Yes | Array of P-Chain addresses to query | **Returns:** | Type | Description | | ---------------------- | -------------------------- | | `GetBalanceReturnType` | Balance information object | **Return Object:** | Property | Type | Description | | -------------------- | -------- | ------------------------------------------- | | `balance` | `bigint` | Total balance | | `unlocked` | `bigint` | Unlocked balance | | `lockedStakeable` | `bigint` | Locked and stakeable balance | | `lockedNotStakeable` | `bigint` | Locked but not stakeable balance | | `utxoIDs` | `array` | Array of UTXO IDs referencing the addresses | **Example:** ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); const balance = await client.pChain.getBalance({ addresses: ["P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p"], }); console.log("Total balance:", balance.balance); console.log("Unlocked:", balance.unlocked); console.log("Locked stakeable:", balance.lockedStakeable); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetbalance) - [getUTXOs](#getutxos) - Get UTXOs for addresses --- ### getUTXOs Get the UTXOs (Unspent Transaction Outputs) controlled by a set of addresses. **Function Signature:** ```typescript function getUTXOs(params: GetUTXOsParameters): Promise; interface GetUTXOsParameters { addresses: string[]; sourceChain?: string; limit?: number; startIndex?: { address: string; utxo: string; }; encoding?: "hex"; } interface GetUTXOsReturnType { numFetched: number; utxos: string[]; endIndex: { address: string; utxo: string; }; sourceChain?: string; encoding: "hex"; } ``` **Parameters:** | Name | Type | Required | Description | | ------------- | ----------------------------------- | -------- | ----------------------------------------------- | | `addresses` | `string[]` | Yes | Array of P-Chain addresses | | `sourceChain` | `string` | No | Source chain ID (e.g., "X" for X-Chain) | | `limit` | `number` | No | Maximum number of UTXOs to return | | `startIndex` | `{ address: string; utxo: string }` | No | Pagination cursor for next page | | `encoding` | `"hex"` | No | Encoding format (can only be "hex" if provided) | **Returns:** | Type | Description | | -------------------- | ------------------------- | | `GetUTXOsReturnType` | UTXO data with pagination | **Return Object:** | Property | Type | Description | | ------------- | ----------------------------------- | ---------------------------------------- | | `numFetched` | `number` | Number of UTXOs fetched in this response | | `utxos` | `string[]` | Array of UTXO bytes (hex encoded) | | `endIndex` | `{ address: string; utxo: string }` | Pagination cursor for fetching next page | | `sourceChain` | `string` | Source chain ID (if specified) | | `encoding` | `"hex"` | Encoding format used | **Example:** ```typescript // Get first page const utxos = await client.pChain.getUTXOs({ addresses: ["P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p"], limit: 100, }); console.log("Fetched UTXOs:", utxos.numFetched); console.log("UTXOs:", utxos.utxos); // Get next page if needed if (utxos.endIndex) { const moreUTXOs = await client.pChain.getUTXOs({ addresses: ["P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p"], startIndex: utxos.endIndex, limit: 100, }); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetutxos) - [getBalance](#getbalance) - Get balance summary --- ## Validator Operations ### getCurrentValidators Get the current validators of the specified Subnet. **Function Signature:** ```typescript function getCurrentValidators( params: GetCurrentValidatorsParameters ): Promise; interface GetCurrentValidatorsParameters { subnetID?: string | Buffer; nodeIDs?: string[]; } interface GetCurrentValidatorsReturnType { validators: Array<{ accruedDelegateeReward: string; txID: string; startTime: string; endTime?: string; stakeAmount: string; nodeID: string; weight: string; validationRewardOwner?: { locktime: string; threshold: string; addresses: string[]; }; delegationRewardOwner?: { locktime: string; threshold: string; addresses: string[]; }; signer?: { publicKey: string; proofOfPosession: string; }; delegatorCount?: string; delegatorWeight?: string; potentialReward?: string; delegationFee?: string; uptime?: string; connected?: boolean; delegators?: Array<{ txID: string; startTime: string; endTime: string; stakeAmount: string; nodeID: string; rewardOwner: { locktime: string; threshold: string; addresses: string[]; }; potentialReward: string; }>; }>; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | ------------------ | -------- | --------------------------------------- | | `subnetID` | `string \| Buffer` | No | Subnet ID (defaults to Primary Network) | | `nodeIDs` | `string[]` | No | Specific NodeIDs to query | **Returns:** | Type | Description | | -------------------------------- | ---------------------- | | `GetCurrentValidatorsReturnType` | Validators list object | **Return Object:** | Property | Type | Description | | ------------ | ------- | ------------------------------------------- | | `validators` | `array` | List of validators for the specified Subnet | **Note:** Many fields in the validator object are omitted if `subnetID` is not the Primary Network. The `delegators` field is only included when `nodeIDs` specifies a single NodeID. **Example:** ```typescript // Get all validators on Primary Network const validators = await client.pChain.getCurrentValidators({}); console.log("Total validators:", validators.validators.length); // Get validators for specific subnet const subnetValidators = await client.pChain.getCurrentValidators({ subnetID: "11111111111111111111111111111111LpoYY", }); // Get specific validators const specificValidators = await client.pChain.getCurrentValidators({ subnetID: "11111111111111111111111111111111LpoYY", nodeIDs: ["NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg"], }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetcurrentvalidators) - [getValidatorsAt](#getvalidatorsat) - Get validators at specific height - [getAllValidatorsAt](#getallvalidatorsat) - Get all validators at height - [sampleValidators](#samplevalidators) - Sample validators --- ### getValidatorsAt Get the validators at a specific height. **Function Signature:** ```typescript function getValidatorsAt( params: GetValidatorsAtParameters ): Promise; interface GetValidatorsAtParameters { height: number; subnetID?: string; } interface GetValidatorsAtReturnType { validators: Record; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | --------------------------------------- | | `height` | `number` | Yes | Block height to query | | `subnetID` | `string` | No | Subnet ID (defaults to Primary Network) | **Returns:** | Type | Description | | --------------------------- | --------------------- | | `GetValidatorsAtReturnType` | Validators map object | **Return Object:** | Property | Type | Description | | ------------ | ------------------------ | ------------------------------------------- | | `validators` | `Record` | Map of validator IDs to their stake amounts | **Example:** ```typescript const validators = await client.pChain.getValidatorsAt({ height: 1000001, subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Validators at height:", validators.validators); ``` **Links:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetvalidatorsat) - [Related: getCurrentValidators](#getcurrentvalidators) - Get current validators - [Related: getAllValidatorsAt](#getallvalidatorsat) - Get all validators at height - [Related: getHeight](#getheight) - Get current height --- ### getAllValidatorsAt Get all validators at a specific height across all Subnets and the Primary Network. **Function Signature:** ```typescript function getAllValidatorsAt( params: GetAllValidatorsAtParameters ): Promise; interface GetAllValidatorsAtParameters { height: number | "proposed"; } interface GetAllValidatorsAtReturnType { validatorSets: Record< string, { validators: Array<{ publicKey: string; weight: string; nodeIDs: string[]; }>; totalWeight: string; } >; } ``` **Parameters:** | Name | Type | Required | Description | | -------- | ---------------------- | -------- | -------------------------------------------------- | | `height` | `number \| "proposed"` | Yes | P-Chain height or "proposed" for proposervm height | **Returns:** | Type | Description | | ------------------------------ | --------------------- | | `GetAllValidatorsAtReturnType` | Validator sets object | **Return Object:** | Property | Type | Description | | --------------- | -------- | ------------------------------------------------ | | `validatorSets` | `object` | Map of Subnet IDs to their validator information | **Note:** The public API (api.avax.network) only supports height within 1000 blocks from the P-Chain tip. **Example:** ```typescript // Get all validators at specific height const validators = await client.pChain.getAllValidatorsAt({ height: 1000001, }); // Get validators at proposed height const proposedValidators = await client.pChain.getAllValidatorsAt({ height: "proposed", }); console.log("Subnet IDs:", Object.keys(validators.validatorSets)); Object.entries(validators.validatorSets).forEach(([subnetID, set]) => { console.log(`Subnet ${subnetID}:`); console.log(` Total weight: ${set.totalWeight}`); console.log(` Validators: ${set.validators.length}`); }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetallvalidatorsat) - [getCurrentValidators](#getcurrentvalidators) - Get current validators - [getValidatorsAt](#getvalidatorsat) - Get validators at height for specific subnet --- ### sampleValidators Sample validators from the specified Subnet. **Function Signature:** ```typescript function sampleValidators( params: SampleValidatorsParameters ): Promise; interface SampleValidatorsParameters { samplingSize: number; subnetID?: string; pChainHeight?: number; } interface SampleValidatorsReturnType { validators: string[]; } ``` **Parameters:** | Name | Type | Required | Description | | -------------- | -------- | -------- | --------------------------------------- | | `samplingSize` | `number` | Yes | Number of validators to sample | | `subnetID` | `string` | No | Subnet ID (defaults to Primary Network) | | `pChainHeight` | `number` | No | Block height (defaults to current) | **Returns:** | Type | Description | | ---------------------------- | ------------------------- | | `SampleValidatorsReturnType` | Sampled validators object | **Return Object:** | Property | Type | Description | | ------------ | ---------- | ---------------------------------- | | `validators` | `string[]` | Array of sampled validator NodeIDs | **Example:** ```typescript const sampled = await client.pChain.sampleValidators({ samplingSize: 5, subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Sampled validators:", sampled.validators); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformsamplevalidators) - [getCurrentValidators](#getcurrentvalidators) - Get all current validators --- ## Block Operations ### getHeight Get the height of the last accepted block. **Function Signature:** ```typescript function getHeight(): Promise; interface GetHeightReturnType { height: number; } ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | --------------------- | ------------- | | `GetHeightReturnType` | Height object | **Return Object:** | Property | Type | Description | | -------- | -------- | ---------------------------- | | `height` | `number` | Current P-Chain block height | **Example:** ```typescript const height = await client.pChain.getHeight(); console.log("Current P-Chain height:", height.height); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetheight) - [getBlockByHeight](#getblockbyheight) - Get block by height - [getProposedHeight](#getproposedheight) - Get proposed height --- ### getBlockByHeight Get a block by its height. **Function Signature:** ```typescript function getBlockByHeight( params: GetBlockByHeightParameters ): Promise; interface GetBlockByHeightParameters { height: number; encoding?: "hex" | "json"; } interface GetBlockByHeightReturnType { encoding: "hex" | "json"; block: string | object; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | ----------------- | -------- | ----------------------------------- | | `height` | `number` | Yes | Block height | | `encoding` | `"hex" \| "json"` | No | Encoding format (defaults to "hex") | **Returns:** | Type | Description | | ---------------------------- | ----------------- | | `GetBlockByHeightReturnType` | Block data object | **Return Object:** | Property | Type | Description | | ---------- | ------------------ | ------------------------------------------- | | `encoding` | `"hex" \| "json"` | Encoding format used | | `block` | `string \| object` | Block data in the specified encoding format | **Example:** ```typescript const block = await client.pChain.getBlockByHeight({ height: 12345, encoding: "hex", }); console.log("Block data:", block.block); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetblockbyheight) - [getBlock](#getblock) - Get block by ID - [getHeight](#getheight) - Get current height --- ### getBlock Get a block by its ID. **Function Signature:** ```typescript function getBlock(params: GetBlockParameters): Promise; interface GetBlockParameters { blockId: string; encoding?: "hex" | "json"; } interface GetBlockReturnType { encoding: "hex" | "json"; block: string | object; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | ----------------- | -------- | ----------------------------------- | | `blockId` | `string` | Yes | Block ID in CB58 format | | `encoding` | `"hex" \| "json"` | No | Encoding format (defaults to "hex") | **Returns:** | Type | Description | | -------------------- | ----------------- | | `GetBlockReturnType` | Block data object | **Return Object:** | Property | Type | Description | | ---------- | ------------------ | ------------------------------------------- | | `encoding` | `"hex" \| "json"` | Encoding format used | | `block` | `string \| object` | Block data in the specified encoding format | **Example:** ```typescript const block = await client.pChain.getBlock({ blockId: "d7WYmb8VeZNHsny3EJCwMm6QA37s1EHwMxw1Y71V3FqPZ5EFG", encoding: "hex", }); console.log("Block:", block.block); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetblock) - [getBlockByHeight](#getblockbyheight) - Get block by height --- ## Staking Operations ### getStake Get the stake amount for a set of addresses. **Function Signature:** ```typescript function getStake(params: GetStakeParameters): Promise; interface GetStakeParameters { addresses: string[]; subnetID: string; } interface GetStakeReturnType { stakeAmount: bigint; } ``` **Parameters:** | Name | Type | Required | Description | | ----------- | ---------- | -------- | ----------------- | | `addresses` | `string[]` | Yes | P-Chain addresses | | `subnetID` | `string` | Yes | Subnet ID | **Returns:** | Type | Description | | -------------------- | ------------------- | | `GetStakeReturnType` | Stake amount object | **Return Object:** | Property | Type | Description | | ------------- | -------- | ------------------------------------ | | `stakeAmount` | `bigint` | Total stake amount for the addresses | **Example:** ```typescript const stake = await client.pChain.getStake({ addresses: ["P-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p"], subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Stake amount:", stake.stakeAmount); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetstake) - [getTotalStake](#gettotalstake) - Get total subnet stake - [getMinStake](#getminstake) - Get minimum stake requirements --- ### getTotalStake Get the total amount of stake for a Subnet. **Function Signature:** ```typescript function getTotalStake( params: GetTotalStakeParameters ): Promise; interface GetTotalStakeParameters { subnetID: string; } interface GetTotalStakeReturnType { stake: bigint; weight: bigint; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ----------- | | `subnetID` | `string` | Yes | Subnet ID | **Returns:** | Type | Description | | ------------------------- | ------------------ | | `GetTotalStakeReturnType` | Total stake object | **Return Object:** | Property | Type | Description | | -------- | -------- | --------------------------------- | | `stake` | `bigint` | Total stake amount for the subnet | | `weight` | `bigint` | Total weight for the subnet | **Example:** ```typescript const totalStake = await client.pChain.getTotalStake({ subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Total stake:", totalStake.stake); console.log("Total weight:", totalStake.weight); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgettotalstake) - [getStake](#getstake) - Get stake for addresses - [getMinStake](#getminstake) - Get minimum stake --- ### getMinStake Get the minimum stake required to validate or delegate. **Function Signature:** ```typescript function getMinStake( params: GetMinStakeParameters ): Promise; interface GetMinStakeParameters { subnetID: string; } interface GetMinStakeReturnType { minValidatorStake: bigint; minDelegatorStake: bigint; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ----------- | | `subnetID` | `string` | Yes | Subnet ID | **Returns:** | Type | Description | | ----------------------- | -------------------- | | `GetMinStakeReturnType` | Minimum stake object | **Return Object:** | Property | Type | Description | | ------------------- | -------- | -------------------------------------------- | | `minValidatorStake` | `bigint` | Minimum stake required to become a validator | | `minDelegatorStake` | `bigint` | Minimum stake required to delegate | **Example:** ```typescript const minStake = await client.pChain.getMinStake({ subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Min validator stake:", minStake.minValidatorStake); console.log("Min delegator stake:", minStake.minDelegatorStake); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetminstake) - [getTotalStake](#gettotalstake) - Get total subnet stake --- ## Subnet Operations ### getSubnet Get information about a subnet. **Function Signature:** ```typescript function getSubnet(params: GetSubnetParameters): Promise; interface GetSubnetParameters { subnetID: string; } interface GetSubnetReturnType { isPermissioned: boolean; controlKeys: string[]; threshold: string; locktime: string; subnetTransformationTxID: string; conversionID: string; managerChainID: string; managerAddress: string | null; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | -------------------- | | `subnetID` | `string` | Yes | The ID of the subnet | **Returns:** | Type | Description | | --------------------- | ------------------------- | | `GetSubnetReturnType` | Subnet information object | **Return Object:** | Property | Type | Description | | -------------------------- | ---------------- | ------------------------------------ | | `isPermissioned` | `boolean` | Whether the subnet is permissioned | | `controlKeys` | `string[]` | Control keys for the subnet | | `threshold` | `string` | Signature threshold | | `locktime` | `string` | Locktime for the subnet | | `subnetTransformationTxID` | `string` | Subnet transformation transaction ID | | `conversionID` | `string` | Conversion ID | | `managerChainID` | `string` | Manager chain ID | | `managerAddress` | `string \| null` | Manager address (null if not set) | **Example:** ```typescript const subnet = await client.pChain.getSubnet({ subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Is permissioned:", subnet.isPermissioned); console.log("Control keys:", subnet.controlKeys); console.log("Threshold:", subnet.threshold); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetsubnet) - [getSubnets](#getsubnets) - Get multiple subnets --- ### getSubnets Get information about multiple subnets. **Function Signature:** ```typescript function getSubnets( params: GetSubnetsParameters ): Promise; interface GetSubnetsParameters { ids: string[]; } interface GetSubnetsReturnType { subnets: { id: string; controlKeys: string[]; threshold: string; }[]; } ``` **Parameters:** | Name | Type | Required | Description | | ----- | ---------- | -------- | ---------------------------- | | `ids` | `string[]` | Yes | Array of subnet IDs to query | **Returns:** | Type | Description | | ---------------------- | -------------------------- | | `GetSubnetsReturnType` | Subnets information object | **Return Object:** | Property | Type | Description | | --------- | ------- | ----------------------------------- | | `subnets` | `array` | Array of subnet information objects | **Example:** ```typescript const subnets = await client.pChain.getSubnets({ ids: [ "11111111111111111111111111111111LpoYY", "SubnetID-11111111111111111111111111111111LpoYY", ], }); console.log("Number of subnets:", subnets.subnets.length); subnets.subnets.forEach((subnet) => { console.log("Subnet ID:", subnet.id); console.log("Control keys:", subnet.controlKeys); }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetsubnets) - [getSubnet](#getsubnet) - Get single subnet --- ### getStakingAssetID Get the staking asset ID for a subnet. **Function Signature:** ```typescript function getStakingAssetID( params: GetStakingAssetIDParameters ): Promise; interface GetStakingAssetIDParameters { subnetID: string; } interface GetStakingAssetIDReturnType { assetID: string; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | -------------------- | | `subnetID` | `string` | Yes | The ID of the subnet | **Returns:** | Type | Description | | ----------------------------- | ----------------------- | | `GetStakingAssetIDReturnType` | Staking asset ID object | **Return Object:** | Property | Type | Description | | --------- | -------- | --------------------------------------- | | `assetID` | `string` | Asset ID used for staking on the subnet | **Example:** ```typescript const stakingAsset = await client.pChain.getStakingAssetID({ subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Staking asset ID:", stakingAsset.assetID); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetstakingassetid) - [getSubnet](#getsubnet) - Get subnet information --- ## Blockchain Operations ### getBlockchains Get all the blockchains that exist (excluding the P-Chain). **Function Signature:** ```typescript function getBlockchains(): Promise; interface GetBlockchainsReturnType { blockchains: { id: string; name: string; subnetID: string; vmID: string; }[]; } ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | -------------------------- | ----------------------- | | `GetBlockchainsReturnType` | Blockchains list object | **Return Object:** | Property | Type | Description | | ------------- | ------- | --------------------------------------- | | `blockchains` | `array` | Array of blockchain information objects | **Example:** ```typescript const blockchains = await client.pChain.getBlockchains(); console.log("Number of blockchains:", blockchains.blockchains.length); blockchains.blockchains.forEach((blockchain) => { console.log("Blockchain:", blockchain.name); console.log(" ID:", blockchain.id); console.log(" Subnet ID:", blockchain.subnetID); console.log(" VM ID:", blockchain.vmID); }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetblockchains) - [getBlockchainStatus](#getblockchainstatus) - Get blockchain status --- ### getBlockchainStatus Get the status of a blockchain. **Function Signature:** ```typescript function getBlockchainStatus( params: GetBlockchainStatusParameters ): Promise; interface GetBlockchainStatusParameters { blockchainId: string; } interface GetBlockchainStatusReturnType { status: "Validating" | "Created" | "Preferred" | "Syncing" | "Unknown"; } ``` **Parameters:** | Name | Type | Required | Description | | -------------- | -------- | -------- | ------------------------ | | `blockchainId` | `string` | Yes | The ID of the blockchain | **Returns:** | Type | Description | | ------------------------------- | ------------------------ | | `GetBlockchainStatusReturnType` | Blockchain status object | **Return Object:** | Property | Type | Description | | -------- | -------- | -------------------------------------------------------------------------------- | | `status` | `string` | Blockchain status: "Validating", "Created", "Preferred", "Syncing", or "Unknown" | **Status Values:** - **Validating**: The blockchain is being validated by this node - **Created**: The blockchain exists but isn't being validated by this node - **Preferred**: The blockchain was proposed to be created and is likely to be created, but the transaction isn't yet accepted - **Syncing**: This node is participating in the blockchain as a non-validating node - **Unknown**: The blockchain either wasn't proposed or the proposal isn't preferred **Example:** ```typescript const status = await client.pChain.getBlockchainStatus({ blockchainId: "11111111111111111111111111111111LpoYY", }); console.log("Blockchain status:", status.status); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetblockchainstatus) - [getBlockchains](#getblockchains) - Get all blockchains --- ## Transaction Operations ### getTx Get a transaction by its ID. **Function Signature:** ```typescript function getTx(params: GetTxParameters): Promise; interface GetTxParameters { txID: string; encoding?: "hex" | "json"; } interface GetTxReturnType { encoding: "hex" | "json"; tx: string | object; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | ----------------- | -------- | ----------------------------------- | | `txID` | `string` | Yes | Transaction ID in CB58 format | | `encoding` | `"hex" \| "json"` | No | Encoding format (defaults to "hex") | **Returns:** | Type | Description | | ----------------- | ----------------------- | | `GetTxReturnType` | Transaction data object | **Return Object:** | Property | Type | Description | | ---------- | ------------------ | ------------------------------------------------- | | `encoding` | `"hex" \| "json"` | Encoding format used | | `tx` | `string \| object` | Transaction data in the specified encoding format | **Example:** ```typescript const tx = await client.pChain.getTx({ txID: "11111111111111111111111111111111LpoYY", encoding: "hex", }); console.log("Transaction:", tx); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgettx) - [getTxStatus](#gettxstatus) - Get transaction status - [issueTx](#issuetx) - Issue a transaction --- ### getTxStatus Get the status of a transaction. **Function Signature:** ```typescript function getTxStatus( params: GetTxStatusParameters ): Promise; interface GetTxStatusParameters { txID: string; } interface GetTxStatusReturnType { status: "Committed" | "Pending" | "Dropped" | "Unknown"; reason?: string; } ``` **Parameters:** | Name | Type | Required | Description | | ------ | -------- | -------- | ----------------------------- | | `txID` | `string` | Yes | Transaction ID in CB58 format | **Returns:** | Type | Description | | ----------------------- | ------------------------- | | `GetTxStatusReturnType` | Transaction status object | **Return Object:** | Property | Type | Description | | -------- | -------- | ------------------------------------------------------------------- | | `status` | `string` | Transaction status: "Committed", "Pending", "Dropped", or "Unknown" | | `reason` | `string` | Optional reason for the status (if dropped) | **Status Values:** - **Committed**: The transaction is (or will be) accepted by every node - **Pending**: The transaction is being voted on by this node - **Dropped**: The transaction will never be accepted by any node in the network - **Unknown**: The transaction hasn't been seen by this node **Example:** ```typescript const txStatus = await client.pChain.getTxStatus({ txID: "11111111111111111111111111111111LpoYY", }); console.log("Transaction status:", txStatus.status); if (txStatus.reason) { console.log("Reason:", txStatus.reason); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgettxstatus) - [getTx](#gettx) - Get transaction details - [issueTx](#issuetx) - Issue a transaction --- ### issueTx Issue a transaction to the Platform Chain. **Function Signature:** ```typescript function issueTx(params: IssueTxParameters): Promise; interface IssueTxParameters { tx: string; encoding: "hex"; } interface IssueTxReturnType { txID: string; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ------------------------------- | | `tx` | `string` | Yes | Transaction bytes in hex format | | `encoding` | `"hex"` | Yes | Encoding format (must be "hex") | **Returns:** | Type | Description | | ------------------- | --------------------- | | `IssueTxReturnType` | Transaction ID object | **Return Object:** | Property | Type | Description | | -------- | -------- | ----------------------------- | | `txID` | `string` | Transaction ID in CB58 format | **Example:** ```typescript const txID = await client.pChain.issueTx({ tx: "0x00000009de31b4d8b22991d51aa6aa1fc733f23a851a8c9400000000000186a0...", encoding: "hex", }); console.log("Transaction issued:", txID.txID); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformissuetx) - [getTx](#gettx) - Get transaction details - [getTxStatus](#gettxstatus) - Get transaction status --- ## Block Operations ### getProposedHeight Get the proposed height of the P-Chain. **Function Signature:** ```typescript function getProposedHeight(): Promise; interface GetProposedHeightReturnType { height: number; } ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | ----------------------------- | ---------------------- | | `GetProposedHeightReturnType` | Proposed height object | **Return Object:** | Property | Type | Description | | -------- | -------- | ----------------------------- | | `height` | `number` | Proposed P-Chain block height | **Example:** ```typescript const proposedHeight = await client.pChain.getProposedHeight(); console.log("Proposed height:", proposedHeight.height); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetproposedheight) - [getHeight](#getheight) - Get current accepted height --- ### getTimestamp Get the current timestamp of the P-Chain. **Function Signature:** ```typescript function getTimestamp(): Promise; interface GetTimestampReturnType { timestamp: string; } ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | ------------------------ | ---------------- | | `GetTimestampReturnType` | Timestamp object | **Return Object:** | Property | Type | Description | | ----------- | -------- | ------------------------------------ | | `timestamp` | `string` | Current timestamp in ISO 8601 format | **Example:** ```typescript const timestamp = await client.pChain.getTimestamp(); console.log("Current timestamp:", timestamp.timestamp); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgettimestamp) - [getHeight](#getheight) - Get current height --- ## Fee Operations ### getFeeConfig Get the fee configuration for the P-Chain. **Function Signature:** ```typescript function getFeeConfig(): Promise; interface GetFeeConfigReturnType { weights: [ bandwidth: number, dbRead: number, dbWrite: number, compute: number, ]; maxCapacity: bigint; maxPerSecond: bigint; targetPerSecond: bigint; minPrice: bigint; excessConversionConstant: bigint; } ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | ------------------------ | ------------------------ | | `GetFeeConfigReturnType` | Fee configuration object | **Return Object:** | Property | Type | Description | | -------------------------- | -------- | -------------------------------------------------- | | `weights` | `array` | Fee weights: [bandwidth, dbRead, dbWrite, compute] | | `maxCapacity` | `bigint` | Maximum capacity | | `maxPerSecond` | `bigint` | Maximum per second | | `targetPerSecond` | `bigint` | Target per second | | `minPrice` | `bigint` | Minimum price | | `excessConversionConstant` | `bigint` | Excess conversion constant | **Example:** ```typescript const feeConfig = await client.pChain.getFeeConfig(); console.log("Fee weights:", feeConfig.weights); console.log("Max capacity:", feeConfig.maxCapacity); console.log("Target per second:", feeConfig.targetPerSecond); console.log("Min price:", feeConfig.minPrice); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetfeeconfig) - [getFeeState](#getfeestate) - Get current fee state --- ### getFeeState Get the current fee state of the P-Chain. **Function Signature:** ```typescript function getFeeState(): Promise; interface GetFeeStateReturnType { capacity: bigint; excess: bigint; price: bigint; timestamp: string; } ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | ----------------------- | ---------------- | | `GetFeeStateReturnType` | Fee state object | **Return Object:** | Property | Type | Description | | ----------- | -------- | -------------------------- | | `capacity` | `bigint` | Current fee capacity | | `excess` | `bigint` | Current fee excess | | `price` | `bigint` | Current fee price | | `timestamp` | `string` | Timestamp of the fee state | **Example:** ```typescript const feeState = await client.pChain.getFeeState(); console.log("Fee capacity:", feeState.capacity); console.log("Fee excess:", feeState.excess); console.log("Fee price:", feeState.price); console.log("Timestamp:", feeState.timestamp); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetfeestate) - [getFeeConfig](#getfeeconfig) - Get fee configuration --- ## Supply Operations ### getCurrentSupply Get the current supply of AVAX tokens. **Function Signature:** ```typescript function getCurrentSupply( params?: GetCurrentSupplyParameters ): Promise; interface GetCurrentSupplyParameters { subnetId?: string; } interface GetCurrentSupplyReturnType { supply: bigint; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | -------------------------------------------------- | | `subnetId` | `string` | No | Subnet ID (defaults to Primary Network if omitted) | **Returns:** | Type | Description | | ---------------------------- | ------------- | | `GetCurrentSupplyReturnType` | Supply object | **Return Object:** | Property | Type | Description | | -------- | -------- | ---------------------------------------------- | | `supply` | `bigint` | Upper bound on the number of tokens that exist | **Example:** ```typescript // Get Primary Network supply const supply = await client.pChain.getCurrentSupply(); console.log("Primary Network supply:", supply.supply); // Get subnet-specific supply const subnetSupply = await client.pChain.getCurrentSupply({ subnetId: "11111111111111111111111111111111LpoYY", }); console.log("Subnet supply:", subnetSupply.supply); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetcurrentsupply) - [getBalance](#getbalance) - Get address balance --- ## Reward Operations ### getRewardUTXOs Get the reward UTXOs for a transaction. **Function Signature:** ```typescript function getRewardUTXOs( params: GetRewardUTXOsParameters ): Promise; interface GetRewardUTXOsParameters { txID: string; encoding?: "hex"; } interface GetRewardUTXOsReturnType { numFetched: number; utxos: string[]; encoding: "hex"; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ----------------------------------- | | `txID` | `string` | Yes | Transaction ID in CB58 format | | `encoding` | `"hex"` | No | Encoding format (defaults to "hex") | **Returns:** | Type | Description | | -------------------------- | ------------------- | | `GetRewardUTXOsReturnType` | Reward UTXOs object | **Return Object:** | Property | Type | Description | | ------------ | ---------- | ---------------------------------------- | | `numFetched` | `number` | Number of reward UTXOs fetched | | `utxos` | `string[]` | Array of reward UTXO bytes (hex encoded) | | `encoding` | `"hex"` | Encoding format used | **Example:** ```typescript const rewardUTXOs = await client.pChain.getRewardUTXOs({ txID: "11111111111111111111111111111111LpoYY", encoding: "hex", }); console.log("Reward UTXOs fetched:", rewardUTXOs.numFetched); console.log("UTXOs:", rewardUTXOs.utxos); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetrewardutxos) - [getUTXOs](#getutxos) - Get UTXOs for addresses --- ## L1 Validator Operations ### getL1Validator Get information about an L1 validator. **Function Signature:** ```typescript function getL1Validator( params: GetL1ValidatorParameters ): Promise; interface GetL1ValidatorParameters { validationID: string; } interface GetL1ValidatorReturnType { subnetID: string; nodeID: string; publicKey: string; remainingBalanceOwner: { addresses: string[]; locktime: string; threshold: string; }; deactivationOwner: { addresses: string[]; locktime: string; threshold: string; }; startTime: bigint; weight: bigint; minNonce?: bigint; balance?: bigint; height?: bigint; } ``` **Parameters:** | Name | Type | Required | Description | | -------------- | -------- | -------- | ------------------------------------------------------- | | `validationID` | `string` | Yes | The ID for L1 subnet validator registration transaction | **Returns:** | Type | Description | | -------------------------- | ------------------------------- | | `GetL1ValidatorReturnType` | L1 validator information object | **Return Object:** | Property | Type | Description | | ----------------------- | -------- | --------------------------------------------- | | `subnetID` | `string` | L1 subnet ID this validator is validating | | `nodeID` | `string` | Node ID of the validator | | `publicKey` | `string` | Compressed BLS public key of the validator | | `remainingBalanceOwner` | `object` | Owner that will receive any withdrawn balance | | `deactivationOwner` | `object` | Owner that can withdraw the balance | | `startTime` | `bigint` | Unix timestamp when validator was added | | `weight` | `bigint` | Weight used for consensus voting and ICM | | `minNonce` | `bigint` | Minimum nonce for SetL1ValidatorWeightTx | | `balance` | `bigint` | Current remaining balance for continuous fee | | `height` | `bigint` | Height of the last accepted block | **Example:** ```typescript const validator = await client.pChain.getL1Validator({ validationID: "11111111111111111111111111111111LpoYY", }); console.log("Subnet ID:", validator.subnetID); console.log("Node ID:", validator.nodeID); console.log("Weight:", validator.weight); console.log("Start time:", validator.startTime); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformgetl1validator) - [getCurrentValidators](#getcurrentvalidators) - Get current validators --- ## Chain Validation ### validatedBy Get the subnet that validates a given blockchain. **Function Signature:** ```typescript function validatedBy( params: ValidatedByParameters ): Promise; interface ValidatedByParameters { blockchainID: string; } interface ValidatedByReturnType { subnetID: string; } ``` **Parameters:** | Name | Type | Required | Description | | -------------- | -------- | -------- | ------------------- | | `blockchainID` | `string` | Yes | The blockchain's ID | **Returns:** | Type | Description | | ----------------------- | ---------------- | | `ValidatedByReturnType` | Subnet ID object | **Return Object:** | Property | Type | Description | | ---------- | -------- | ---------------------------------------------- | | `subnetID` | `string` | ID of the subnet that validates the blockchain | **Example:** ```typescript const validatedBy = await client.pChain.validatedBy({ blockchainID: "11111111111111111111111111111111LpoYY", }); console.log("Validated by subnet:", validatedBy.subnetID); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformvalidatedby) - [validates](#validates) - Get blockchains validated by subnet --- ### validates Get the IDs of the blockchains a subnet validates. **Function Signature:** ```typescript function validates(params: ValidatesParameters): Promise; interface ValidatesParameters { subnetID: string; } interface ValidatesReturnType { blockchainIDs: string[]; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | --------------- | | `subnetID` | `string` | Yes | The subnet's ID | **Returns:** | Type | Description | | --------------------- | --------------------- | | `ValidatesReturnType` | Blockchain IDs object | **Return Object:** | Property | Type | Description | | --------------- | ---------- | ----------------------------------------------- | | `blockchainIDs` | `string[]` | Array of blockchain IDs validated by the subnet | **Example:** ```typescript const validates = await client.pChain.validates({ subnetID: "11111111111111111111111111111111LpoYY", }); console.log("Number of blockchains:", validates.blockchainIDs.length); validates.blockchainIDs.forEach((blockchainID) => { console.log("Blockchain ID:", blockchainID); }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/p-chain#platformvalidates) - [validatedBy](#validatedby) - Get subnet validating blockchain ## Next Steps - **[P-Chain Wallet Methods](../wallet-methods/p-chain-wallet)** - Transaction preparation and signing - **[Wallet Client](../../clients/wallet-client)** - Complete wallet operations - **[Account Management](../../accounts)** - Account types and management # Public Methods (/docs/tooling/avalanche-sdk/client/methods/public-methods/public) --- title: Public Methods description: Complete reference for Avalanche-specific public client methods --- ## Overview The Avalanche Client extends viem's Public Client with Avalanche-specific methods for querying fee information, chain configuration, and active rules. These methods are available on both the main Avalanche Client and the C-Chain client. ## Fee Operations ### baseFee Get the base fee for the next block on the C-Chain. **Function Signature:** ```typescript function baseFee(): Promise; ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | -------- | -------------------------------------------------------------- | | `string` | Base fee for the next block as hex string (e.g., "0x3b9aca00") | **Example:** ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); const baseFee = await client.baseFee(); console.log("Base fee:", baseFee); // "0x3b9aca00" ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#eth_basefee) - [maxPriorityFeePerGas](#maxpriorityfeepergas) - Get max priority fee per gas --- ### maxPriorityFeePerGas Get the maximum priority fee per gas for the next block. **Function Signature:** ```typescript function maxPriorityFeePerGas(): Promise; ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | -------- | --------------------------------------------------------------- | | `string` | Maximum priority fee per gas as hex string (e.g., "0x3b9aca00") | **Example:** ```typescript const maxPriorityFee = await client.maxPriorityFeePerGas(); console.log("Max priority fee per gas:", maxPriorityFee); // Use in EIP-1559 transaction const txHash = await walletClient.sendTransaction({ to: "0x...", value: avaxToWei(1), maxFeePerGas: baseFee + maxPriorityFee, maxPriorityFeePerGas: maxPriorityFee, }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#eth_maxpriorityfeepergas) - [baseFee](#basefee) - Get base fee --- ### feeConfig Get the fee configuration for a specific block. Returns fee settings and when they were last changed. **Function Signature:** ```typescript function feeConfig(params: FeeConfigParameters): Promise; interface FeeConfigParameters { blk?: string; // Block number or hash, defaults to "latest" } interface FeeConfigReturnType { feeConfig: { [key: string]: string; }; lastChangedAt: string; } ``` **Parameters:** | Name | Type | Required | Description | | ----- | -------- | -------- | ------------------------------------------------------- | | `blk` | `string` | No | Block number or hash (hex string), defaults to "latest" | **Returns:** | Type | Description | | --------------------- | ------------------------ | | `FeeConfigReturnType` | Fee configuration object | **Return Object:** | Property | Type | Description | | --------------- | -------- | ------------------------------------------ | | `feeConfig` | `object` | Fee configuration key-value pairs | | `lastChangedAt` | `string` | Timestamp when fee config was last changed | **Example:** ```typescript // Get fee config for latest block const feeConfig = await client.feeConfig({}); console.log("Fee config:", feeConfig.feeConfig); console.log("Last changed:", feeConfig.lastChangedAt); // Get fee config for specific block const blockFeeConfig = await client.feeConfig({ blk: "0x123456" }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/subnet-evm#eth_feeconfig) - [baseFee](#basefee) - Get base fee --- ## Chain Configuration ### getChainConfig Get the chain configuration for the C-Chain, including fork blocks and Avalanche-specific upgrade timestamps. **Function Signature:** ```typescript function getChainConfig(): Promise; interface GetChainConfigReturnType { chainId: number; homesteadBlock: number; daoForkBlock: number; daoForkSupport: boolean; eip150Block: number; eip150Hash: string; eip155Block: number; eip158Block: number; byzantiumBlock: number; constantinopleBlock: number; petersburgBlock: number; istanbulBlock: number; muirGlacierBlock: number; apricotPhase1BlockTimestamp: number; apricotPhase2BlockTimestamp: number; apricotPhase3BlockTimestamp: number; apricotPhase4BlockTimestamp: number; apricotPhase5BlockTimestamp: number; } ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | -------------------------- | -------------------------- | | `GetChainConfigReturnType` | Chain configuration object | **Return Object:** | Property | Type | Description | | ----------------------------- | --------- | --------------------------------- | | `chainId` | `number` | Chain ID | | `homesteadBlock` | `number` | Homestead fork block | | `daoForkBlock` | `number` | DAO fork block | | `daoForkSupport` | `boolean` | DAO fork support flag | | `eip150Block` | `number` | EIP-150 fork block | | `eip150Hash` | `string` | EIP-150 fork hash | | `eip155Block` | `number` | EIP-155 fork block | | `eip158Block` | `number` | EIP-158 fork block | | `byzantiumBlock` | `number` | Byzantium fork block | | `constantinopleBlock` | `number` | Constantinople fork block | | `petersburgBlock` | `number` | Petersburg fork block | | `istanbulBlock` | `number` | Istanbul fork block | | `muirGlacierBlock` | `number` | Muir Glacier fork block | | `apricotPhase1BlockTimestamp` | `number` | Apricot Phase 1 upgrade timestamp | | `apricotPhase2BlockTimestamp` | `number` | Apricot Phase 2 upgrade timestamp | | `apricotPhase3BlockTimestamp` | `number` | Apricot Phase 3 upgrade timestamp | | `apricotPhase4BlockTimestamp` | `number` | Apricot Phase 4 upgrade timestamp | | `apricotPhase5BlockTimestamp` | `number` | Apricot Phase 5 upgrade timestamp | **Example:** ```typescript const chainConfig = await client.getChainConfig(); console.log("Chain ID:", chainConfig.chainId); console.log("Apricot Phase 1:", chainConfig.apricotPhase1BlockTimestamp); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/c-chain#eth_getchainconfig) --- ## Active Rules ### getActiveRulesAt Get the active rules (EIPs, precompiles) at a specific timestamp. Useful for determining which features are enabled at a given time. **Function Signature:** ```typescript function getActiveRulesAt( params: GetActiveRulesAtParameters ): Promise; interface GetActiveRulesAtParameters { timestamp: string; // Unix timestamp as hex string or "latest" } interface GetActiveRulesAtReturnType { ethRules: Map; avalancheRules: Map; precompiles: Map; } ``` **Parameters:** | Name | Type | Required | Description | | ----------- | -------- | -------- | --------------------------------------------------------------- | | `timestamp` | `string` | Yes | Unix timestamp as hex string (e.g., "0x1234567890") or "latest" | **Returns:** | Type | Description | | ---------------------------- | ------------------- | | `GetActiveRulesAtReturnType` | Active rules object | **Return Object:** | Property | Type | Description | | ---------------- | --------------------- | -------------------------------------------- | | `ethRules` | `Map` | Active Ethereum rules (EIPs) | | `avalancheRules` | `Map` | Active Avalanche-specific rules | | `precompiles` | `Map` | Active precompiles with their configurations | **Example:** ```typescript // Get active rules at current time const activeRules = await client.getActiveRulesAt({ timestamp: "latest", }); console.log("Ethereum rules:", Array.from(activeRules.ethRules.keys())); console.log("Avalanche rules:", Array.from(activeRules.avalancheRules.keys())); console.log("Precompiles:", Array.from(activeRules.precompiles.keys())); // Get active rules at specific timestamp const historicalRules = await client.getActiveRulesAt({ timestamp: "0x1234567890", }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/subnet-evm#eth_getactiverulesat) --- ## Viem Integration The Avalanche Client extends viem's Public Client, providing access to all standard Ethereum RPC methods. For complete method reference, see: - **[viem Documentation](https://viem.sh/docs)** - Complete EVM method reference - **[viem Actions](https://viem.sh/docs/actions/public)** - Public client actions - **[viem Utilities](https://viem.sh/docs/utilities)** - Utility functions ## Next Steps - **[C-Chain Methods](c-chain)** - C-Chain-specific methods - **[Wallet Client](../clients/wallet-client)** - Transaction operations - **[Account Management](../../accounts)** - Account types and management # X-Chain Methods (/docs/tooling/avalanche-sdk/client/methods/public-methods/x-chain) --- title: X-Chain Methods description: Complete reference for X-Chain (Exchange Chain) methods --- ## Overview The X-Chain (Exchange Chain) is Avalanche's DAG-based chain designed for creating and trading digital smart assets. It handles asset creation, transfers, UTXO management, and provides the foundation for the Avalanche ecosystem. This reference covers all read-only X-Chain operations available through the Avalanche Client SDK. ## Balance Operations ### getBalance Get the balance of a specific asset controlled by a given address. **Function Signature:** ```typescript function getBalance( params: GetBalanceParameters ): Promise; interface GetBalanceParameters { address: string; assetID: string; } interface GetBalanceReturnType { balance: bigint; utxoIDs: { txID: string; outputIndex: number; }[]; } ``` **Parameters:** | Name | Type | Required | Description | | --------- | -------- | -------- | ------------------------ | | `address` | `string` | Yes | X-Chain address to query | | `assetID` | `string` | Yes | Asset ID to query | **Returns:** | Type | Description | | ---------------------- | -------------------------- | | `GetBalanceReturnType` | Balance information object | **Return Object:** | Property | Type | Description | | --------- | -------- | ----------------------------------------- | | `balance` | `bigint` | Balance amount for the specified asset | | `utxoIDs` | `array` | Array of UTXO IDs referencing the address | **Example:** ```typescript import { createAvalancheClient } from "@avalanche-sdk/client"; import { avalanche } from "@avalanche-sdk/client/chains"; const client = createAvalancheClient({ chain: avalanche, transport: { type: "http" }, }); const balance = await client.xChain.getBalance({ address: "X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5", assetID: "FvwEAhmxKfeiG8SnEvq42hc6whRyY3EFYAvebMqDNDGCgxN5Z", // AVAX }); console.log("Balance:", balance.balance); console.log("UTXO IDs:", balance.utxoIDs); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgetbalance) - [getAllBalances](#getallbalances) - Get balances for all assets - [getUTXOs](#getutxos) - Get UTXOs for addresses --- ### getAllBalances Get the balances of all assets controlled by given addresses. **Function Signature:** ```typescript function getAllBalances( params: GetAllBalancesParameters ): Promise; interface GetAllBalancesParameters { addresses: string[]; } interface GetAllBalancesReturnType { balances: Array<{ assetID: string; balance: bigint; }>; } ``` **Parameters:** | Name | Type | Required | Description | | ----------- | ---------- | -------- | ----------------------------------- | | `addresses` | `string[]` | Yes | Array of X-Chain addresses to query | **Returns:** | Type | Description | | -------------------------- | --------------------- | | `GetAllBalancesReturnType` | Balances array object | **Return Object:** | Property | Type | Description | | ---------- | ------- | ------------------------------------------------- | | `balances` | `array` | Array of balance objects with assetID and balance | **Example:** ```typescript const allBalances = await client.xChain.getAllBalances({ addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], }); // Iterate over all assets allBalances.balances.forEach(({ assetID, balance }) => { console.log(`Asset ${assetID}: ${balance}`); }); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgetallbalances) - [getBalance](#getbalance) - Get balance for specific asset - [getAssetDescription](#getassetdescription) - Get asset information --- ## Asset Operations ### getAssetDescription Get information about an asset. **Function Signature:** ```typescript function getAssetDescription( params: GetAssetDescriptionParameters ): Promise; interface GetAssetDescriptionParameters { assetID: string; } interface GetAssetDescriptionReturnType { assetID: string; name: string; symbol: string; denomination: number; } ``` **Parameters:** | Name | Type | Required | Description | | --------- | -------- | -------- | ----------- | | `assetID` | `string` | Yes | Asset ID | **Returns:** | Type | Description | | ------------------------------- | ------------------------ | | `GetAssetDescriptionReturnType` | Asset information object | **Return Object:** | Property | Type | Description | | -------------- | -------- | --------------------------------------------- | | `assetID` | `string` | Asset ID | | `name` | `string` | Asset name | | `symbol` | `string` | Asset symbol | | `denomination` | `number` | Asset denomination (number of decimal places) | **Example:** ```typescript const asset = await client.xChain.getAssetDescription({ assetID: "FvwEAhmxKfeiG8SnEvq42hc6whRyY3EFYAvebMqDNDGCgxN5Z", }); console.log("Asset name:", asset.name); console.log("Asset symbol:", asset.symbol); console.log("Denomination:", asset.denomination); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgetassetdescription) - [getBalance](#getbalance) - Get balance for this asset --- ## Block Operations ### getHeight Get the current block height of the X-Chain. **Function Signature:** ```typescript function getHeight(): Promise; interface GetHeightReturnType { height: number; } ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | --------------------- | ------------- | | `GetHeightReturnType` | Height object | **Return Object:** | Property | Type | Description | | -------- | -------- | ---------------------------- | | `height` | `number` | Current X-Chain block height | **Example:** ```typescript const height = await client.xChain.getHeight(); console.log("Current X-Chain height:", height.height); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgetheight) - [getBlockByHeight](#getblockbyheight) - Get block at height --- ### getBlockByHeight Get a block by its height. **Function Signature:** ```typescript function getBlockByHeight( params: GetBlockByHeightParameters ): Promise; interface GetBlockByHeightParameters { height: number; encoding?: "hex" | "json"; } interface GetBlockByHeightReturnType { encoding: "hex" | "json"; block: string | object; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | ----------------- | -------- | ------------------------------------ | | `height` | `number` | Yes | Block height | | `encoding` | `"hex" \| "json"` | No | Encoding format (defaults to "json") | **Returns:** | Type | Description | | ---------------------------- | ----------------- | | `GetBlockByHeightReturnType` | Block data object | **Return Object:** | Property | Type | Description | | ---------- | ------------------ | ------------------------------------------- | | `encoding` | `"hex" \| "json"` | Encoding format used | | `block` | `string \| object` | Block data in the specified encoding format | **Example:** ```typescript const block = await client.xChain.getBlockByHeight({ height: 12345, encoding: "hex", }); console.log("Block data:", block.block); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgetblockbyheight) - [getBlock](#getblock) - Get block by ID - [getHeight](#getheight) - Get current height --- ### getBlock Get a block by its ID. **Function Signature:** ```typescript function getBlock(params: GetBlockParameters): Promise; interface GetBlockParameters { blockId: string; encoding?: "hex" | "json"; } interface GetBlockReturnType { encoding: "hex" | "json"; block: string | object; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | ----------------- | -------- | ------------------------------------ | | `blockId` | `string` | Yes | Block ID in CB58 format | | `encoding` | `"hex" \| "json"` | No | Encoding format (defaults to "json") | **Returns:** | Type | Description | | -------------------- | ----------------- | | `GetBlockReturnType` | Block data object | **Return Object:** | Property | Type | Description | | ---------- | ------------------ | ------------------------------------------- | | `encoding` | `"hex" \| "json"` | Encoding format used | | `block` | `string \| object` | Block data in the specified encoding format | **Example:** ```typescript const block = await client.xChain.getBlock({ blockId: "block-id-in-cb58-format", encoding: "hex", }); console.log("Block:", block.block); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgetblock) - [getBlockByHeight](#getblockbyheight) - Get block by height --- ## Transaction Operations ### getTx Get a transaction by its ID. **Function Signature:** ```typescript function getTx(params: GetTxParameters): Promise; interface GetTxParameters { txID: string; encoding?: "hex" | "json"; } interface GetTxReturnType { encoding: "hex" | "json"; tx: string | object; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | ----------------- | -------- | ------------------------------------ | | `txID` | `string` | Yes | Transaction ID in CB58 format | | `encoding` | `"hex" \| "json"` | No | Encoding format (defaults to "json") | **Returns:** | Type | Description | | ----------------- | ----------------------- | | `GetTxReturnType` | Transaction data object | **Return Object:** | Property | Type | Description | | ---------- | ------------------ | ------------------------------------------------- | | `encoding` | `"hex" \| "json"` | Encoding format used | | `tx` | `string \| object` | Transaction data in the specified encoding format | **Example:** ```typescript const tx = await client.xChain.getTx({ txID: "transaction-id", encoding: "hex", }); console.log("Transaction:", tx.tx); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgettx) - [getTxStatus](#gettxstatus) - Get transaction status - [issueTx](#issuetx) - Submit transaction --- ### getTxStatus Get the status of a transaction. **Function Signature:** ```typescript function getTxStatus( params: GetTxStatusParameters ): Promise; interface GetTxStatusParameters { txID: string; includeReason?: boolean | true; } interface GetTxStatusReturnType { status: "Accepted" | "Processing" | "Rejected" | "Unknown"; reason?: string; } ``` **Parameters:** | Name | Type | Required | Description | | --------------- | ----------------- | -------- | -------------------------------------------- | | `txID` | `string` | Yes | Transaction ID in CB58 format | | `includeReason` | `boolean \| true` | No | Whether to include the reason for the status | **Returns:** | Type | Description | | ----------------------- | ------------------------- | | `GetTxStatusReturnType` | Transaction status object | **Return Object:** | Property | Type | Description | | -------- | -------- | ---------------------------------------------------------------------- | | `status` | `string` | Transaction status: "Accepted", "Processing", "Rejected", or "Unknown" | | `reason` | `string` | Optional reason for the status (if rejected) | **Status Values:** - **Accepted**: Transaction has been accepted and included in a block - **Processing**: Transaction is being processed - **Rejected**: Transaction was rejected - **Unknown**: Transaction status cannot be determined **Example:** ```typescript const status = await client.xChain.getTxStatus({ txID: "transaction-id", }); if (status.status === "Accepted") { console.log("Transaction accepted!"); } else if (status.status === "Rejected") { console.log("Transaction rejected"); if (status.reason) { console.log("Reason:", status.reason); } } else { console.log("Transaction status:", status.status); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgettxstatus) - [getTx](#gettx) - Get transaction details --- ### getTxFee Get the transaction fee for the X-Chain. **Function Signature:** ```typescript function getTxFee(): Promise; interface GetTxFeeReturnType { txFee: number; createAssetTxFee: number; } ``` **Parameters:** No parameters required. **Returns:** | Type | Description | | -------------------- | ---------------------- | | `GetTxFeeReturnType` | Transaction fee object | **Return Object:** | Property | Type | Description | | ------------------ | -------- | ---------------------------- | | `txFee` | `number` | Standard transaction fee | | `createAssetTxFee` | `number` | Fee for creating a new asset | **Example:** ```typescript const fees = await client.xChain.getTxFee(); console.log("Standard transaction fee:", fees.txFee); console.log("Create asset fee:", fees.createAssetTxFee); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgettxfee) --- ## UTXO Operations ### getUTXOs Get the UTXOs controlled by a set of addresses. **Function Signature:** ```typescript function getUTXOs(params: GetUTXOsParameters): Promise; interface GetUTXOsParameters { addresses: string[]; sourceChain?: string; limit?: number; startIndex?: { address: string; utxo: string; }; encoding?: "hex"; } interface GetUTXOsReturnType { numFetched: number; utxos: string[]; endIndex: { address: string; utxo: string; }; sourceChain?: string; encoding: "hex"; } ``` **Parameters:** | Name | Type | Required | Description | | ------------- | ----------------------------------- | -------- | ----------------------------------------------- | | `addresses` | `string[]` | Yes | Array of X-Chain addresses | | `sourceChain` | `string` | No | Source chain ID (e.g., "P" for P-Chain) | | `limit` | `number` | No | Maximum number of UTXOs to return | | `startIndex` | `{ address: string; utxo: string }` | No | Pagination cursor for next page | | `encoding` | `"hex"` | No | Encoding format (can only be "hex" if provided) | **Returns:** | Type | Description | | -------------------- | ------------------------- | | `GetUTXOsReturnType` | UTXO data with pagination | **Return Object:** | Property | Type | Description | | ------------- | ----------------------------------- | ---------------------------------------- | | `numFetched` | `number` | Number of UTXOs fetched in this response | | `utxos` | `string[]` | Array of UTXO bytes (hex encoded) | | `endIndex` | `{ address: string; utxo: string }` | Pagination cursor for fetching next page | | `sourceChain` | `string` | Source chain ID (if specified) | | `encoding` | `"hex"` | Encoding format used | **Example:** ```typescript // Get first page const utxos = await client.xChain.getUTXOs({ addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], limit: 100, }); console.log("Number of UTXOs:", utxos.numFetched); // Get next page if needed if (utxos.endIndex) { const moreUTXOs = await client.xChain.getUTXOs({ addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], startIndex: utxos.endIndex, limit: 100, }); } ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgetutxos) - [getBalance](#getbalance) - Get balance summary --- ## Transaction Submission ### issueTx Issue a transaction to the X-Chain. **Function Signature:** ```typescript function issueTx(params: IssueTxParameters): Promise; interface IssueTxParameters { tx: string; encoding: "hex"; } interface IssueTxReturnType { txID: string; } ``` **Parameters:** | Name | Type | Required | Description | | ---------- | -------- | -------- | ------------------------------- | | `tx` | `string` | Yes | Transaction bytes in hex format | | `encoding` | `"hex"` | Yes | Encoding format (must be "hex") | **Returns:** | Type | Description | | ------------------- | --------------------- | | `IssueTxReturnType` | Transaction ID object | **Return Object:** | Property | Type | Description | | -------- | -------- | ----------------------------- | | `txID` | `string` | Transaction ID in CB58 format | **Example:** ```typescript const txID = await client.xChain.issueTx({ tx: "0x00000009de31b4d8b22991d51aa6aa1fc733f23a851a8c9400000000000186a0...", encoding: "hex", }); console.log("Transaction ID:", txID.txID); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmissuetx) - [getTxStatus](#gettxstatus) - Check transaction status --- ## Genesis Operations ### buildGenesis Build a genesis block for a custom blockchain. **Function Signature:** ```typescript function buildGenesis( params: BuildGenesisParameters ): Promise; interface BuildGenesisParameters { networkID: number; genesisData: { name: string; symbol: string; denomination: number; initialState: { fixedCap: { amount: number; addresses: string[]; }; }; }; encoding: "hex"; } interface BuildGenesisReturnType { bytes: string; encoding: "hex"; } ``` **Parameters:** | Name | Type | Required | Description | | ------------- | -------- | -------- | ------------------------------------------- | | `networkID` | `number` | Yes | Network ID | | `genesisData` | `object` | Yes | Genesis block data with asset configuration | | `encoding` | `"hex"` | Yes | Encoding format (must be "hex") | **Returns:** | Type | Description | | ------------------------ | -------------------------- | | `BuildGenesisReturnType` | Genesis block bytes object | **Return Object:** | Property | Type | Description | | ---------- | -------- | --------------------------------- | | `bytes` | `string` | Genesis block bytes in hex format | | `encoding` | `"hex"` | Encoding format used | **Example:** ```typescript const genesis = await client.xChain.buildGenesis({ networkID: 16, genesisData: { name: "myFixedCapAsset", symbol: "MFCA", denomination: 0, initialState: { fixedCap: { amount: 100000, addresses: ["X-custom18jma8ppw3nhx5r4ap8clazz0dps7rv5u9xde7p"], }, }, }, encoding: "hex", }); console.log("Genesis bytes:", genesis.bytes); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmbuildgenesis) --- ## Next Steps - **[X-Chain Wallet Methods](../wallet-methods/x-chain-wallet)** - Transaction preparation and signing - **[Wallet Client](../../clients/wallet-client)** - Complete wallet operations - **[Account Management](../../accounts)** - Account types and management # C-Chain Wallet Methods (/docs/tooling/avalanche-sdk/client/methods/wallet-methods/c-chain-wallet) --- title: C-Chain Wallet Methods description: Complete reference for C-Chain atomic transaction methods --- ## Overview The C-Chain Wallet Methods provide transaction preparation capabilities for atomic cross-chain transfers between the C-Chain and other Avalanche chains (P-Chain and X-Chain). These methods handle the export and import of native AVAX via atomic transactions. **Access:** `walletClient.cChain` ## prepareExportTxn Prepare a transaction to export AVAX from C-Chain to another chain (P-Chain or X-Chain). **Function Signature:** ```typescript function prepareExportTxn( params: PrepareExportTxnParameters ): Promise; interface PrepareExportTxnParameters { destinationChain: "P" | "X"; fromAddress: string; exportedOutput: { addresses: string[]; amount: bigint; locktime?: bigint; threshold?: number; }; context?: Context; } interface PrepareExportTxnReturnType { tx: UnsignedTx; exportTx: ExportTx; chainAlias: "C"; } ``` **Parameters:** | Name | Type | Required | Description | | ------------------ | ------------ | -------- | --------------------------------------------------- | | `destinationChain` | `"P" \| "X"` | Yes | Chain alias to export funds to (P-Chain or X-Chain) | | `fromAddress` | `string` | Yes | EVM address to export funds from | | `exportedOutput` | `object` | Yes | Consolidated exported output (UTXO) | | `context` | `Context` | No | Optional context for the transaction | **Exported Output Object:** | Name | Type | Required | Description | | ----------- | ---------- | -------- | ------------------------------------------------------------------ | | `addresses` | `string[]` | Yes | Addresses who can sign the consuming of this UTXO | | `amount` | `bigint` | Yes | Amount in nano AVAX held by this exported output | | `locktime` | `bigint` | No | Timestamp in seconds after which this UTXO can be consumed | | `threshold` | `number` | No | Threshold of `addresses`' signatures required to consume this UTXO | **Returns:** | Type | Description | | ---------------------------- | ------------------------- | | `PrepareExportTxnReturnType` | Export transaction object | **Return Object:** | Property | Type | Description | | ------------ | ------------ | ------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `exportTx` | `ExportTx` | The export transaction instance | | `chainAlias` | `"C"` | The chain alias | **Example:** ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avalanche } from "@avalanche-sdk/client/chains"; import { avaxToNanoAvax } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // Export from C-Chain to P-Chain const exportTx = await walletClient.cChain.prepareExportTxn({ destinationChain: "P", fromAddress: account.getEVMAddress(), exportedOutput: { addresses: [account.getXPAddress("P")], amount: avaxToNanoAvax(0.001), }, }); // Sign and send const { txHash } = await walletClient.sendXPTransaction({ txOrTxHex: exportTx, chainAlias: "C", }); console.log("Export transaction hash:", txHash); ``` **Related:** - [prepareImportTxn](#prepareimporttxn) - Import to C-Chain - [Wallet send method](./wallet#send) - Simplified cross-chain transfers - [getAtomicTxStatus](../public-methods/c-chain#getatomictxstatus) - Check transaction status --- ## prepareImportTxn Prepare a transaction to import AVAX from another chain (P-Chain or X-Chain) to C-Chain. **Function Signature:** ```typescript function prepareImportTxn( params: PrepareImportTxnParameters ): Promise; interface PrepareImportTxnParameters { account?: AvalancheAccount | Address | undefined; sourceChain: "P" | "X"; toAddress: string; fromAddresses?: string[]; utxos?: Utxo[]; context?: Context; } interface PrepareImportTxnReturnType { tx: UnsignedTx; importTx: ImportTx; chainAlias: "C"; } ``` **Parameters:** | Name | Type | Required | Description | | --------------- | ----------------------------- | -------- | ------------------------------------------------------------------------------- | | `account` | `AvalancheAccount \| Address` | No | Account to use for the transaction | | `sourceChain` | `"P" \| "X"` | Yes | Chain alias to import funds from (P-Chain or X-Chain) | | `toAddress` | `string` | Yes | EVM address to import funds to | | `fromAddresses` | `string[]` | No | Addresses to import funds from (auto-fetched if not provided) | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs (must be in atomic memory, auto-fetched if not provided) | | `context` | `Context` | No | Optional context for the transaction | **Returns:** | Type | Description | | ---------------------------- | ------------------------- | | `PrepareImportTxnReturnType` | Import transaction object | **Return Object:** | Property | Type | Description | | ------------ | ------------ | ------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `importTx` | `ImportTx` | The import transaction instance | | `chainAlias` | `"C"` | The chain alias | **Example:** ```typescript const importTx = await walletClient.cChain.prepareImportTxn({ sourceChain: "P", toAddress: account.getEVMAddress(), fromAddresses: [account.getXPAddress("P")], }); // Sign and send const { txHash } = await walletClient.sendXPTransaction({ txOrTxHex: importTx, chainAlias: "C", }); console.log("Import transaction hash:", txHash); ``` **Related:** - [prepareExportTxn](#prepareexporttxn) - Export from C-Chain - [getAtomicTxStatus](../public-methods/c-chain#getatomictxstatus) - Check transaction status --- ## Complete Cross-Chain Transfer Workflow ### Export from C-Chain to P-Chain ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avalanche } from "@avalanche-sdk/client/chains"; import { avaxToNanoAvax } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // 1. Export from C-Chain const exportTx = await walletClient.cChain.prepareExportTxn({ destinationChain: "P", fromAddress: account.getEVMAddress(), exportedOutput: { addresses: [account.getXPAddress("P")], amount: avaxToNanoAvax(1.0), }, }); // 2. Sign and send export transaction const { txHash: exportTxHash } = await walletClient.sendXPTransaction({ txOrTxHex: exportTx, chainAlias: "C", }); // 3. Wait for export to be committed await walletClient.waitForTxn({ txHash: exportTxHash, chainAlias: "C", }); console.log("Export completed:", exportTxHash); // 4. Import to P-Chain const importTx = await walletClient.pChain.prepareImportTxn({ sourceChain: "C", toAddresses: [account.getXPAddress("P")], }); const { txHash: importTxHash } = await walletClient.sendXPTransaction({ txOrTxHex: importTx, chainAlias: "P", }); console.log("Import completed:", importTxHash); ``` --- ## Next Steps - **[Wallet Methods](./wallet)** - General wallet operations - **[P-Chain Wallet Methods](./p-chain-wallet)** - P-Chain transaction preparation - **[X-Chain Wallet Methods](./x-chain-wallet)** - X-Chain transaction preparation - **[Account Management](../accounts)** - Account types and management # P-Chain Wallet Methods (/docs/tooling/avalanche-sdk/client/methods/wallet-methods/p-chain-wallet) --- title: P-Chain Wallet Methods description: Complete reference for P-Chain transaction preparation methods --- ## Overview The P-Chain Wallet Methods provide transaction preparation capabilities for the Platform Chain. These methods allow you to create unsigned transactions for various operations including base transfers, validator operations, delegator operations, subnet management, and cross-chain transfers. **Access:** `walletClient.pChain` ## prepareBaseTxn Prepare a base P-Chain transaction for transferring AVAX. **Function Signature:** ```typescript function prepareBaseTxn( params: PrepareBaseTxnParameters ): Promise; interface PrepareBaseTxnParameters { outputs?: Output[]; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface Output { addresses: string[]; amount: bigint; assetId?: string; locktime?: bigint; threshold?: number; } interface PrepareBaseTxnReturnType { tx: UnsignedTx; baseTx: BaseTx; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ---------- | -------- | --------------------------------------------- | | `outputs` | `Output[]` | No | Array of outputs to send funds to | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Output Object:** | Name | Type | Required | Description | | ----------- | ---------- | -------- | ------------------------------------------------------------------ | | `addresses` | `string[]` | Yes | Addresses who can sign the consuming of this UTXO | | `amount` | `bigint` | Yes | Amount in nano AVAX | | `assetId` | `string` | No | Asset ID of the UTXO | | `locktime` | `bigint` | No | Timestamp in seconds after which this UTXO can be consumed | | `threshold` | `number` | No | Threshold of `addresses`' signatures required to consume this UTXO | **Returns:** | Type | Description | | -------------------------- | ----------------------- | | `PrepareBaseTxnReturnType` | Base transaction object | **Return Object:** | Property | Type | Description | | ------------ | ------------ | ----------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `baseTx` | `BaseTx` | The base transaction instance | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avalanche } from "@avalanche-sdk/client/chains"; import { avaxToNanoAvax } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); const unsignedTx = await walletClient.pChain.prepareBaseTxn({ outputs: [ { addresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], amount: avaxToNanoAvax(1), }, ], }); // Sign and send const signedTx = await walletClient.signXPTransaction({ tx: unsignedTx.tx, chainAlias: "P", }); const { txHash } = await walletClient.sendXPTransaction({ txOrTxHex: signedTx.signedTxHex, chainAlias: "P", }); console.log("Transaction hash:", txHash); ``` **Related:** - [prepareExportTxn](#prepareexporttxn) - Cross-chain exports - [prepareImportTxn](#prepareimporttxn) - Cross-chain imports --- ## prepareAddPermissionlessValidatorTxn Prepare a transaction to add a permissionless validator to the Primary Network. **Function Signature:** ```typescript function prepareAddPermissionlessValidatorTxn( params: PrepareAddPermissionlessValidatorTxnParameters ): Promise; interface PrepareAddPermissionlessValidatorTxnParameters { nodeId: string; stakeInAvax: bigint; end: bigint; rewardAddresses: string[]; delegatorRewardAddresses: string[]; delegatorRewardPercentage: number; publicKey?: string; signature?: string; threshold?: number; locktime?: bigint; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareAddPermissionlessValidatorTxnReturnType { tx: UnsignedTx; addPermissionlessValidatorTx: AddPermissionlessValidatorTx; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | --------------------------- | ---------- | -------- | --------------------------------------------------------------------------------- | | `nodeId` | `string` | Yes | Node ID of the validator being added | | `stakeInAvax` | `bigint` | Yes | Amount of AVAX to stake (in nano AVAX) | | `end` | `bigint` | Yes | Unix time in seconds when validator will be removed | | `rewardAddresses` | `string[]` | Yes | Addresses which will receive validator rewards | | `delegatorRewardAddresses` | `string[]` | Yes | Addresses which will receive delegator fee rewards | | `delegatorRewardPercentage` | `number` | Yes | Percentage of delegator rewards as delegation fee (2-100, up to 3 decimal places) | | `publicKey` | `string` | No | BLS public key (in hex format) | | `signature` | `string` | No | BLS signature (in hex format) | | `threshold` | `number` | No | Number of signatures required to spend reward UTXO (default: 1) | | `locktime` | `bigint` | No | Unix timestamp after which reward UTXO can be spent (default: 0) | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ------------------------------------------------ | -------------------------------- | | `PrepareAddPermissionlessValidatorTxnReturnType` | Add validator transaction object | **Return Object:** | Property | Type | Description | | ------------------------------ | ------------------------------ | -------------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `addPermissionlessValidatorTx` | `AddPermissionlessValidatorTx` | The add validator transaction instance | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript import { avaxToNanoAvax } from "@avalanche-sdk/client/utils"; const validatorTx = await walletClient.pChain.prepareAddPermissionlessValidatorTxn({ nodeId: "NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg", stakeInAvax: avaxToNanoAvax(2000), end: BigInt(1716441600), rewardAddresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], delegatorRewardAddresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], delegatorRewardPercentage: 2.5, threshold: 1, }); // Sign and send const signedTx = await walletClient.signXPTransaction({ tx: validatorTx.tx, chainAlias: "P", }); const { txHash } = await walletClient.sendXPTransaction({ txOrTxHex: signedTx.signedTxHex, chainAlias: "P", }); ``` **Related:** - [prepareAddSubnetValidatorTxn](#prepareaddsubnetvalidatortxn) - Add to subnet - [prepareAddPermissionlessDelegatorTxn](#prepareaddpermissionlessdelegatortxn) - Add delegator --- ## prepareAddPermissionlessDelegatorTxn Prepare a transaction to add a permissionless delegator to a validator. **Function Signature:** ```typescript function prepareAddPermissionlessDelegatorTxn( params: PrepareAddPermissionlessDelegatorTxnParameters ): Promise; interface PrepareAddPermissionlessDelegatorTxnParameters { nodeId: string; stakeInAvax: bigint; end: bigint; rewardAddresses: string[]; threshold?: number; locktime?: bigint; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareAddPermissionlessDelegatorTxnReturnType { tx: UnsignedTx; addPermissionlessDelegatorTx: AddPermissionlessDelegatorTx; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ---------- | -------- | ---------------------------------------------------------------- | | `nodeId` | `string` | Yes | Node ID of the validator to delegate to | | `stakeInAvax` | `bigint` | Yes | Amount of AVAX to stake (in nano AVAX) | | `end` | `bigint` | Yes | Unix time in seconds when delegation stops | | `rewardAddresses` | `string[]` | Yes | Addresses which will receive rewards | | `threshold` | `number` | No | Number of signatures required to spend reward UTXO (default: 1) | | `locktime` | `bigint` | No | Unix timestamp after which reward UTXO can be spent (default: 0) | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ------------------------------------------------ | -------------------------------- | | `PrepareAddPermissionlessDelegatorTxnReturnType` | Add delegator transaction object | **Return Object:** | Property | Type | Description | | ------------------------------ | ------------------------------ | -------------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `addPermissionlessDelegatorTx` | `AddPermissionlessDelegatorTx` | The add delegator transaction instance | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const delegatorTx = await walletClient.pChain.prepareAddPermissionlessDelegatorTxn({ nodeId: "NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg", stakeInAvax: avaxToNanoAvax(25), end: BigInt(1716441600), rewardAddresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], threshold: 1, }); ``` **Related:** - [prepareAddPermissionlessValidatorTxn](#prepareaddpermissionlessvalidatortxn) - Add validator --- ## prepareExportTxn Prepare a transaction to export AVAX from P-Chain to another chain. **Function Signature:** ```typescript function prepareExportTxn( params: PrepareExportTxnParameters ): Promise; interface PrepareExportTxnParameters { destinationChain: "X" | "C"; exportedOutputs: Output[]; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareExportTxnReturnType { tx: UnsignedTx; exportTx: ExportTx; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ------------------ | ------------ | -------- | --------------------------------------------- | | `destinationChain` | `"X" \| "C"` | Yes | Chain alias to export funds to | | `exportedOutputs` | `Output[]` | Yes | Outputs to export | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ---------------------------- | ------------------------- | | `PrepareExportTxnReturnType` | Export transaction object | **Return Object:** | Property | Type | Description | | ------------ | ------------ | ------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `exportTx` | `ExportTx` | The export transaction instance | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const exportTx = await walletClient.pChain.prepareExportTxn({ destinationChain: "C", exportedOutputs: [ { addresses: [account.getEVMAddress()], amount: avaxToNanoAvax(0.001), }, ], }); // Sign and send const signedTx = await walletClient.signXPTransaction({ tx: exportTx.tx, chainAlias: "P", }); const { txHash } = await walletClient.sendXPTransaction({ txOrTxHex: signedTx.signedTxHex, chainAlias: "P", }); ``` **Related:** - [prepareImportTxn](#prepareimporttxn) - Import to P-Chain - [Wallet send method](./wallet#send) - Simplified cross-chain transfers --- ## prepareImportTxn Prepare a transaction to import AVAX from another chain to P-Chain. **Function Signature:** ```typescript function prepareImportTxn( params: PrepareImportTxnParameters ): Promise; interface PrepareImportTxnParameters { sourceChain: "X" | "C"; importedOutput: ImportedOutput; fromAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface ImportedOutput { addresses: string[]; locktime?: bigint; threshold?: number; } interface PrepareImportTxnReturnType { tx: UnsignedTx; importTx: ImportTx; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ---------------- | -------- | ----------------------------------------------- | | `sourceChain` | `"X" \| "C"` | Yes | Chain alias to import funds from | | `importedOutput` | `ImportedOutput` | Yes | Consolidated imported output from atomic memory | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Imported Output Object:** | Name | Type | Required | Description | | ----------- | ---------- | -------- | ----------------------------------------------------------------------------------- | | `addresses` | `string[]` | Yes | Addresses who can sign the consuming of this UTXO | | `locktime` | `bigint` | No | Timestamp in seconds after which this UTXO can be consumed | | `threshold` | `number` | No | Number of signatures required out of total `addresses` to spend the imported output | **Returns:** | Type | Description | | ---------------------------- | ------------------------- | | `PrepareImportTxnReturnType` | Import transaction object | **Return Object:** | Property | Type | Description | | ------------ | ------------ | ------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `importTx` | `ImportTx` | The import transaction instance | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const importTx = await walletClient.pChain.prepareImportTxn({ sourceChain: "C", importedOutput: { addresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], threshold: 1, }, }); // Sign and send const signedTx = await walletClient.signXPTransaction({ tx: importTx.tx, chainAlias: "P", }); const { txHash } = await walletClient.sendXPTransaction({ txOrTxHex: signedTx.signedTxHex, chainAlias: "P", }); ``` **Related:** - [prepareExportTxn](#prepareexporttxn) - Export from P-Chain --- ## prepareAddSubnetValidatorTxn Prepare a transaction to add a validator to a subnet. **Function Signature:** ```typescript function prepareAddSubnetValidatorTxn( params: PrepareAddSubnetValidatorTxnParameters ): Promise; interface PrepareAddSubnetValidatorTxnParameters { subnetId: string; nodeId: string; weight: bigint; end: bigint; subnetAuth: readonly number[]; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareAddSubnetValidatorTxnReturnType { tx: UnsignedTx; addSubnetValidatorTx: AddSubnetValidatorTx; subnetOwners: PChainOwner; subnetAuth: number[]; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ------------------- | -------- | -------------------------------------------------------------------------- | | `subnetId` | `string` | Yes | Subnet ID to add the validator to | | `nodeId` | `string` | Yes | Node ID of the validator being added | | `weight` | `bigint` | Yes | Weight of the validator used during consensus | | `end` | `bigint` | Yes | End timestamp in seconds after which validator will be removed | | `subnetAuth` | `readonly number[]` | Yes | Array of indices from subnet's owners array who will sign this transaction | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ---------------------------------------- | --------------------------------------- | | `PrepareAddSubnetValidatorTxnReturnType` | Add subnet validator transaction object | **Return Object:** | Property | Type | Description | | ---------------------- | ---------------------- | --------------------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `addSubnetValidatorTx` | `AddSubnetValidatorTx` | The add subnet validator transaction instance | | `subnetOwners` | `PChainOwner` | The subnet owners | | `subnetAuth` | `number[]` | Array of indices from subnet's owners array | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const addSubnetValidatorTx = await walletClient.pChain.prepareAddSubnetValidatorTxn({ subnetId: "2b175hLJhGdj3CzgXNUHXDPVY3wQo3y3VWqPjKpF5vK", nodeId: "NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg", weight: BigInt(1000000), end: BigInt(1716441600), subnetAuth: [0, 1], }); ``` **Related:** - [prepareRemoveSubnetValidatorTxn](#prepareremovesubnetvalidatortxn) - Remove subnet validator --- ## prepareRemoveSubnetValidatorTxn Prepare a transaction to remove a validator from a subnet. **Function Signature:** ```typescript function prepareRemoveSubnetValidatorTxn( params: PrepareRemoveSubnetValidatorTxnParameters ): Promise; interface PrepareRemoveSubnetValidatorTxnParameters { subnetId: string; nodeId: string; subnetAuth: readonly number[]; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareRemoveSubnetValidatorTxnReturnType { tx: UnsignedTx; removeSubnetValidatorTx: RemoveSubnetValidatorTx; subnetOwners: PChainOwner; subnetAuth: number[]; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ------------------- | -------- | -------------------------------------------------------------------------- | | `subnetId` | `string` | Yes | Subnet ID to remove the validator from | | `nodeId` | `string` | Yes | Node ID of the validator being removed | | `subnetAuth` | `readonly number[]` | Yes | Array of indices from subnet's owners array who will sign this transaction | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ------------------------------------------- | ------------------------------------------ | | `PrepareRemoveSubnetValidatorTxnReturnType` | Remove subnet validator transaction object | **Return Object:** | Property | Type | Description | | ------------------------- | ------------------------- | ------------------------------------------------ | | `tx` | `UnsignedTx` | The unsigned transaction | | `removeSubnetValidatorTx` | `RemoveSubnetValidatorTx` | The remove subnet validator transaction instance | | `subnetOwners` | `PChainOwner` | The subnet owners | | `subnetAuth` | `number[]` | Array of indices from subnet's owners array | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const removeSubnetValidatorTx = await walletClient.pChain.prepareRemoveSubnetValidatorTxn({ subnetId: "2b175hLJhGdj3CzgXNUHXDPVY3wQo3y3VWqPjKpF5vK", nodeId: "NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg", subnetAuth: [0, 1], }); ``` **Related:** - [prepareAddSubnetValidatorTxn](#prepareaddsubnetvalidatortxn) - Add subnet validator --- ## prepareCreateSubnetTxn Prepare a transaction to create a new subnet. **Function Signature:** ```typescript function prepareCreateSubnetTxn( params: PrepareCreateSubnetTxnParameters ): Promise; interface PrepareCreateSubnetTxnParameters { subnetOwners: SubnetOwners; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface SubnetOwners { addresses: string[]; threshold?: number; locktime?: bigint; } interface PrepareCreateSubnetTxnReturnType { tx: UnsignedTx; createSubnetTx: CreateSubnetTx; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | -------------- | -------- | --------------------------------------------- | | `subnetOwners` | `SubnetOwners` | Yes | Subnet owners configuration | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Subnet Owners Object:** | Name | Type | Required | Description | | ----------- | ---------- | -------- | ---------------------------------------------------------------------------------------- | | `addresses` | `string[]` | Yes | List of unique addresses (must be sorted lexicographically) | | `threshold` | `number` | No | Number of unique signatures required to spend the output (must be ≤ length of addresses) | | `locktime` | `bigint` | No | Unix timestamp after which the output can be spent | **Returns:** | Type | Description | | ---------------------------------- | -------------------------------- | | `PrepareCreateSubnetTxnReturnType` | Create subnet transaction object | **Return Object:** | Property | Type | Description | | ---------------- | ---------------- | -------------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `createSubnetTx` | `CreateSubnetTx` | The create subnet transaction instance | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const createSubnetTx = await walletClient.pChain.prepareCreateSubnetTxn({ subnetOwners: { addresses: [ "P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz", "P-fuji1y8zrxh9cvdny0e8n8n4n7h4q4h4q4h4q4h4q4h", ], threshold: 2, }, }); ``` **Related:** - [prepareCreateChainTxn](#preparecreatechaintxn) - Create chain on subnet --- ## prepareCreateChainTxn Prepare a transaction to create a new blockchain on a subnet. **Function Signature:** ```typescript function prepareCreateChainTxn( params: PrepareCreateChainTxnParameters ): Promise; interface PrepareCreateChainTxnParameters { subnetId: string; vmId: string; chainName: string; genesisData: Record; subnetAuth: readonly number[]; fxIds?: readonly string[]; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareCreateChainTxnReturnType { tx: UnsignedTx; createChainTx: CreateChainTx; subnetOwners: PChainOwner; subnetAuth: number[]; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ------------------------- | -------- | -------------------------------------------------------------------------- | | `subnetId` | `string` | Yes | Subnet ID to create the chain on | | `vmId` | `string` | Yes | VM ID of the chain being created | | `chainName` | `string` | Yes | Name of the chain being created | | `genesisData` | `Record` | Yes | Genesis JSON data of the chain being created | | `subnetAuth` | `readonly number[]` | Yes | Array of indices from subnet's owners array who will sign this transaction | | `fxIds` | `readonly string[]` | No | Array of FX IDs to be added to the chain | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | --------------------------------- | ------------------------------- | | `PrepareCreateChainTxnReturnType` | Create chain transaction object | **Return Object:** | Property | Type | Description | | --------------- | --------------- | ------------------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `createChainTx` | `CreateChainTx` | The create chain transaction instance | | `subnetOwners` | `PChainOwner` | The subnet owners | | `subnetAuth` | `number[]` | Array of indices from subnet's owners array | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const createChainTx = await walletClient.pChain.prepareCreateChainTxn({ subnetId: "2b175hLJhGdj3CzgXNUHXDPVY3wQo3y3VWqPjKpF5vK", vmId: "avm", chainName: "MyCustomChain", genesisData: { // Genesis configuration }, subnetAuth: [0, 1], }); ``` **Related:** - [prepareCreateSubnetTxn](#preparecreatesubnettxn) - Create subnet --- ## prepareConvertSubnetToL1Txn Prepare a transaction to convert a subnet to an L1 (Layer 1) blockchain. **Function Signature:** ```typescript function prepareConvertSubnetToL1Txn( params: PrepareConvertSubnetToL1TxnParameters ): Promise; interface PrepareConvertSubnetToL1TxnParameters { subnetId: string; blockchainId: string; managerContractAddress: string; validators: L1Validator[]; subnetAuth: readonly number[]; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface L1Validator { nodeId: string; nodePoP: { publicKey: string; proofOfPossession: string; }; weight: bigint; initialBalanceInAvax: bigint; remainingBalanceOwner: PChainOwnerJSON; deactivationOwner: PChainOwnerJSON; } interface PrepareConvertSubnetToL1TxnReturnType { tx: UnsignedTx; convertSubnetToL1Tx: ConvertSubnetToL1Tx; subnetOwners: PChainOwner; subnetAuth: number[]; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ------------------------ | ------------------- | -------- | -------------------------------------------------------------------------- | | `subnetId` | `string` | Yes | Subnet ID of the subnet to convert | | `blockchainId` | `string` | Yes | Blockchain ID of the L1 where validator manager contract is deployed | | `managerContractAddress` | `string` | Yes | Address of the validator manager contract | | `validators` | `L1Validator[]` | Yes | Initial set of L1 validators after conversion | | `subnetAuth` | `readonly number[]` | Yes | Array of indices from subnet's owners array who will sign this transaction | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **L1 Validator Object:** | Name | Type | Description | | --------------------------- | ----------------- | ------------------------------------------------------------------------ | | `nodeId` | `string` | Node ID of the validator | | `nodePoP.publicKey` | `string` | Public key of the validator | | `nodePoP.proofOfPossession` | `string` | Proof of possession of the public key | | `weight` | `bigint` | Weight of the validator on the L1 used during consensus participation | | `initialBalanceInAvax` | `bigint` | Initial balance in nano AVAX required for paying contiguous fee | | `remainingBalanceOwner` | `PChainOwnerJSON` | Owner information for remaining balance if validator is removed/disabled | | `deactivationOwner` | `PChainOwnerJSON` | Owner information which can remove or disable the validator | **Returns:** | Type | Description | | --------------------------------------- | --------------------------------------- | | `PrepareConvertSubnetToL1TxnReturnType` | Convert subnet to L1 transaction object | **Return Object:** | Property | Type | Description | | --------------------- | --------------------- | --------------------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `convertSubnetToL1Tx` | `ConvertSubnetToL1Tx` | The convert subnet to L1 transaction instance | | `subnetOwners` | `PChainOwner` | The subnet owners | | `subnetAuth` | `number[]` | Array of indices from subnet's owners array | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const convertSubnetToL1Tx = await walletClient.pChain.prepareConvertSubnetToL1Txn({ subnetId: "2b175hLJhGdj3CzgXNUHXDPVY3wQo3y3VWqPjKpF5vK", blockchainId: "2oYMBNV4eNHyqk2fjjV5nVwDzxvbmovtDAOwPJCTc9wqg8k9t", managerContractAddress: "0x1234567890123456789012345678901234567890", validators: [ { nodeId: "NodeID-7Xhw2mDxuDS44j42TCB6U5579esbSt3Lg", nodePoP: { publicKey: "0x...", proofOfPossession: "0x...", }, weight: BigInt(1000000), initialBalanceInAvax: avaxToNanoAvax(1000), remainingBalanceOwner: { addresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], threshold: 1, }, deactivationOwner: { addresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], threshold: 1, }, }, ], subnetAuth: [0, 1], }); ``` --- ## prepareRegisterL1ValidatorTxn Prepare a transaction to register an L1 validator. **Function Signature:** ```typescript function prepareRegisterL1ValidatorTxn( params: PrepareRegisterL1ValidatorTxnParameters ): Promise; interface PrepareRegisterL1ValidatorTxnParameters { initialBalanceInAvax: bigint; blsSignature: string; message: string; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareRegisterL1ValidatorTxnReturnType { tx: UnsignedTx; registerL1ValidatorTx: RegisterL1ValidatorTx; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ---------------------- | ---------- | -------- | -------------------------------------------------------------------------------------------- | | `initialBalanceInAvax` | `bigint` | Yes | Initial balance in nano AVAX required for paying contiguous fee | | `blsSignature` | `string` | Yes | BLS signature of the validator | | `message` | `string` | Yes | Signed warp message hex with `AddressedCall` payload containing `RegisterL1ValidatorMessage` | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ----------------------------------------- | ---------------------------------------- | | `PrepareRegisterL1ValidatorTxnReturnType` | Register L1 validator transaction object | **Return Object:** | Property | Type | Description | | ----------------------- | ----------------------- | ---------------------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `registerL1ValidatorTx` | `RegisterL1ValidatorTx` | The register L1 validator transaction instance | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const registerL1ValidatorTx = await walletClient.pChain.prepareRegisterL1ValidatorTxn({ initialBalanceInAvax: avaxToNanoAvax(1000), blsSignature: "0x...", message: "0x...", }); ``` --- ## prepareDisableL1ValidatorTxn Prepare a transaction to disable an L1 validator. **Function Signature:** ```typescript function prepareDisableL1ValidatorTxn( params: PrepareDisableL1ValidatorTxnParameters ): Promise; interface PrepareDisableL1ValidatorTxnParameters { validationId: string; disableAuth: number[]; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareDisableL1ValidatorTxnReturnType { tx: UnsignedTx; disableL1ValidatorTx: DisableL1ValidatorTx; disableOwners: PChainOwner; disableAuth: number[]; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ---------- | -------- | ---------------------------------------------------------------------------------------- | | `validationId` | `string` | Yes | Validation ID of the L1 validator | | `disableAuth` | `number[]` | Yes | Array of indices from L1 validator's disable owners array who will sign this transaction | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ---------------------------------------- | --------------------------------------- | | `PrepareDisableL1ValidatorTxnReturnType` | Disable L1 validator transaction object | **Return Object:** | Property | Type | Description | | ---------------------- | ---------------------- | --------------------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `disableL1ValidatorTx` | `DisableL1ValidatorTx` | The disable L1 validator transaction instance | | `disableOwners` | `PChainOwner` | The disable owners | | `disableAuth` | `number[]` | Array of indices from disable owners array | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const disableL1ValidatorTx = await walletClient.pChain.prepareDisableL1ValidatorTxn({ validationId: "0x...", disableAuth: [0, 1], }); ``` --- ## prepareSetL1ValidatorWeightTxn Prepare a transaction to set the weight of an L1 validator. **Function Signature:** ```typescript function prepareSetL1ValidatorWeightTxn( params: PrepareSetL1ValidatorWeightTxnParameters ): Promise; interface PrepareSetL1ValidatorWeightTxnParameters { message: string; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareSetL1ValidatorWeightTxnReturnType { tx: UnsignedTx; setL1ValidatorWeightTx: SetL1ValidatorWeightTx; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ---------- | -------- | --------------------------------------------------------------------------------------------- | | `message` | `string` | Yes | Signed warp message hex with `AddressedCall` payload containing `SetL1ValidatorWeightMessage` | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ------------------------------------------ | ------------------------------------------ | | `PrepareSetL1ValidatorWeightTxnReturnType` | Set L1 validator weight transaction object | **Return Object:** | Property | Type | Description | | ------------------------ | ------------------------ | ------------------------------------------------ | | `tx` | `UnsignedTx` | The unsigned transaction | | `setL1ValidatorWeightTx` | `SetL1ValidatorWeightTx` | The set L1 validator weight transaction instance | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const setL1ValidatorWeightTx = await walletClient.pChain.prepareSetL1ValidatorWeightTxn({ message: "0x...", }); ``` --- ## prepareIncreaseL1ValidatorBalanceTxn Prepare a transaction to increase the balance of an L1 validator. **Function Signature:** ```typescript function prepareIncreaseL1ValidatorBalanceTxn( params: PrepareIncreaseL1ValidatorBalanceTxnParameters ): Promise; interface PrepareIncreaseL1ValidatorBalanceTxnParameters { balanceInAvax: bigint; validationId: string; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareIncreaseL1ValidatorBalanceTxnReturnType { tx: UnsignedTx; increaseL1ValidatorBalanceTx: IncreaseL1ValidatorBalanceTx; chainAlias: "P"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ---------- | -------- | -------------------------------------------------------- | | `balanceInAvax` | `bigint` | Yes | Amount of AVAX to increase the balance by (in nano AVAX) | | `validationId` | `string` | Yes | Validation ID of the L1 validator | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ------------------------------------------------ | ------------------------------------------------ | | `PrepareIncreaseL1ValidatorBalanceTxnReturnType` | Increase L1 validator balance transaction object | **Return Object:** | Property | Type | Description | | ------------------------------ | ------------------------------ | ------------------------------------------------------ | | `tx` | `UnsignedTx` | The unsigned transaction | | `increaseL1ValidatorBalanceTx` | `IncreaseL1ValidatorBalanceTx` | The increase L1 validator balance transaction instance | | `chainAlias` | `"P"` | The chain alias | **Example:** ```typescript const increaseL1ValidatorBalanceTx = await walletClient.pChain.prepareIncreaseL1ValidatorBalanceTxn({ balanceInAvax: avaxToNanoAvax(500), validationId: "0x...", }); ``` --- ## Next Steps - **[Wallet Methods](./wallet)** - General wallet operations - **[X-Chain Wallet Methods](./x-chain-wallet)** - X-Chain transaction preparation - **[C-Chain Wallet Methods](./c-chain-wallet)** - C-Chain atomic transactions - **[Account Management](../accounts)** - Account types and management # Wallet Methods (/docs/tooling/avalanche-sdk/client/methods/wallet-methods/wallet) --- title: Wallet Methods description: Complete reference for Avalanche wallet operations --- ## Overview The Avalanche Wallet Client provides methods for sending transactions, signing messages and transactions, and managing accounts across all Avalanche chains (P-Chain, X-Chain, and C-Chain). This reference covers all wallet-specific methods available through the Avalanche Wallet Client SDK. **Access:** `walletClient` ## send Send tokens from the source chain to the destination chain. Automatically handles cross-chain transfers when needed. **Function Signature:** ```typescript function send(params: SendParameters): Promise; interface SendParameters { account?: AvalancheAccount; amount: bigint; to: Address | XPAddress; from?: Address | XPAddress; sourceChain?: "P" | "C"; destinationChain?: "P" | "C"; token?: "AVAX"; context?: Context; } interface SendReturnType { txHashes: TransactionDetails[]; } interface TransactionDetails { txHash: string; chainAlias: "P" | "C"; } ``` **Parameters:** | Name | Type | Required | Description | | ------------------ | ---------------------- | -------- | ----------------------------------------------------- | | `account` | `AvalancheAccount` | No | Account to send from (uses client account if omitted) | | `amount` | `bigint` | Yes | Amount to send in wei | | `to` | `Address \| XPAddress` | Yes | Destination address | | `from` | `Address \| XPAddress` | No | Source address (defaults to account address) | | `sourceChain` | `"P" \| "C"` | No | Source chain (default: "C") | | `destinationChain` | `"P" \| "C"` | No | Destination chain (default: "C") | | `token` | `"AVAX"` | No | Token to send (only AVAX supported) | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ---------------- | ------------------------- | | `SendReturnType` | Transaction hashes object | **Return Object:** | Property | Type | Description | | ---------- | ---------------------- | ---------------------------- | | `txHashes` | `TransactionDetails[]` | Array of transaction details | **Transaction Details Object:** | Property | Type | Description | | ------------ | ------------ | ---------------------------------- | | `txHash` | `string` | The hash of the transaction | | `chainAlias` | `"P" \| "C"` | The chain alias of the transaction | **Example:** ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avalanche } from "@avalanche-sdk/client/chains"; import { avaxToWei, avaxToNanoAvax } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); // Send AVAX on C-Chain const result = await walletClient.send({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", amount: avaxToWei(0.001), destinationChain: "C", }); console.log("Transaction hash:", result.txHashes[0].txHash); // Send AVAX from C-Chain to P-Chain const crossChainResult = await walletClient.send({ to: "P-avax1example...", amount: avaxToWei(1), sourceChain: "C", destinationChain: "P", }); console.log("Transfer transactions:", crossChainResult.txHashes); ``` **Related:** - [waitForTxn](#waitfortxn) - Wait for transaction confirmation - [signXPMessage](#signxpmessage) - Sign messages --- ## getAccountPubKey Get the public key associated with the wallet account in both EVM and XP formats. **Function Signature:** ```typescript function getAccountPubKey(): Promise; interface GetAccountPubKeyReturnType { evm: string; xp: string; } ``` **Returns:** | Type | Description | | ---------------------------- | ------------------ | | `GetAccountPubKeyReturnType` | Public keys object | **Return Object:** | Property | Type | Description | | -------- | -------- | ------------------------ | | `evm` | `string` | Public key in EVM format | | `xp` | `string` | Public key in XP format | **Example:** ```typescript const pubKeys = await walletClient.getAccountPubKey(); console.log("EVM public key:", pubKeys.evm); console.log("XP public key:", pubKeys.xp); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmgetaccountpubkey) - [Account Management](../accounts) - Account types and management --- ## waitForTxn Wait for a transaction to be confirmed on the network. **Function Signature:** ```typescript function waitForTxn(params: WaitForTxnParameters): Promise; interface WaitForTxnParameters { txHash: string; chainAlias: "X" | "P" | "C"; sleepTime?: number; maxRetries?: number; } ``` **Parameters:** | Name | Type | Required | Description | | ------------ | ------------------- | -------- | ------------------------------------------------------------ | | `txHash` | `string` | Yes | Transaction hash | | `chainAlias` | `"X" \| "P" \| "C"` | Yes | Chain where transaction was submitted | | `sleepTime` | `number` | No | Time to sleep between retries in milliseconds (default: 300) | | `maxRetries` | `number` | No | Maximum number of retries (default: 10) | **Returns:** | Type | Description | | --------------- | ----------------------------------------------------------------------------------- | | `Promise` | Promise that resolves when transaction is confirmed or rejects if transaction fails | **Example:** ```typescript const txHash = "0x..."; try { await walletClient.waitForTxn({ txHash, chainAlias: "C", sleepTime: 500, // Wait 500ms between checks maxRetries: 20, // Check up to 20 times }); console.log("Transaction confirmed!"); } catch (error) { console.error("Transaction failed:", error); } ``` **Related:** - [send](#send) - Send transactions - [Client tx status methods](../public-methods) - Check transaction status manually --- ## sendXPTransaction Send a signed XP transaction to the network (X-Chain, P-Chain, or C-Chain). **Function Signature:** ```typescript function sendXPTransaction( params: SendXPTransactionParameters ): Promise; interface SendXPTransactionParameters { account?: AvalancheAccount | Address; tx: string | UnsignedTx; chainAlias: "X" | "P" | "C"; externalIndices?: number[]; internalIndices?: number[]; utxoIds?: string[]; feeTolerance?: number; subnetAuth?: number[]; subnetOwners?: PChainOwner; disableOwners?: PChainOwner; disableAuth?: number[]; } interface SendXPTransactionReturnType { txHash: string; chainAlias: "X" | "P" | "C"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ----------------------------- | -------- | ----------------------------------------------------- | | `account` | `AvalancheAccount \| Address` | No | Account to use for the transaction | | `tx` | `string \| UnsignedTx` | Yes | Transaction to send (hex string or UnsignedTx object) | | `chainAlias` | `"X" \| "P" \| "C"` | Yes | Target chain | | `externalIndices` | `number[]` | No | External indices to use for the transaction | | `internalIndices` | `number[]` | No | Internal indices to use for the transaction | | `utxoIds` | `string[]` | No | UTXO IDs to use for the transaction | | `feeTolerance` | `number` | No | Fee tolerance to use for the transaction | | `subnetAuth` | `number[]` | No | Subnet auth to use for the transaction | | `subnetOwners` | `PChainOwner` | No | Subnet owners to use for the transaction | | `disableOwners` | `PChainOwner` | No | Disable owners to use for the transaction | | `disableAuth` | `number[]` | No | Disable auth to use for the transaction | **Returns:** | Type | Description | | ----------------------------- | ----------------------- | | `SendXPTransactionReturnType` | Transaction hash object | **Return Object:** | Property | Type | Description | | ------------ | ------------------- | --------------------------- | | `txHash` | `string` | The hash of the transaction | | `chainAlias` | `"X" \| "P" \| "C"` | The chain alias | **Example:** ```typescript // This is typically used with prepare methods from chain-specific wallets const unsignedTx = await walletClient.pChain.prepareBaseTxn({ outputs: [ { addresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], amount: avaxToNanoAvax(1), }, ], }); const signedTx = await walletClient.signXPTransaction({ tx: unsignedTx.tx, chainAlias: "P", }); const { txHash } = await walletClient.sendXPTransaction({ tx: signedTx.signedTxHex, chainAlias: "P", }); console.log("Transaction hash:", txHash); ``` **Related:** - [signXPTransaction](#signxptransaction) - Sign transactions - [P-Chain Wallet Methods](./p-chain-wallet) - P-Chain transaction preparation - [X-Chain Wallet Methods](./x-chain-wallet) - X-Chain transaction preparation --- ## signXPTransaction Sign an XP transaction (X-Chain, P-Chain, or C-Chain). **Function Signature:** ```typescript function signXPTransaction( params: SignXPTransactionParameters ): Promise; interface SignXPTransactionParameters { account?: AvalancheAccount | Address; tx?: string | UnsignedTx; signedTxHex?: string; chainAlias: "X" | "P" | "C"; utxoIds?: string[]; subnetAuth?: number[]; subnetOwners?: PChainOwner; disableOwners?: PChainOwner; disableAuth?: number[]; context?: Context; } interface Signatures { signature: string; sigIndices: number[]; } interface SignXPTransactionReturnType { signedTxHex: string; signatures: Signatures[]; chainAlias: "X" | "P" | "C"; subnetAuth?: number[]; subnetOwners?: PChainOwner; disableOwners?: PChainOwner; disableAuth?: number[]; } ``` **Parameters:** | Name | Type | Required | Description | | --------------- | ----------------------------- | -------- | ---------------------------------------------------------------------------- | | `account` | `AvalancheAccount \| Address` | No | Account to use for the transaction | | `tx` | `string \| UnsignedTx` | No | Unsigned transaction (either `tx` or `signedTxHex` must be provided) | | `signedTxHex` | `string` | No | Pre-signed transaction bytes (either `tx` or `signedTxHex` must be provided) | | `chainAlias` | `"X" \| "P" \| "C"` | Yes | Target chain | | `utxoIds` | `string[]` | No | UTXO IDs to use for the transaction | | `subnetAuth` | `number[]` | No | Subnet auth to use for the transaction | | `subnetOwners` | `PChainOwner` | No | Subnet owners to use for the transaction | | `disableOwners` | `PChainOwner` | No | Disable owners to use for the transaction | | `disableAuth` | `number[]` | No | Disable auth to use for the transaction | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ----------------------------- | ------------------------- | | `SignXPTransactionReturnType` | Signed transaction object | **Return Object:** | Property | Type | Description | | --------------- | ------------------- | --------------------------------------- | | `signedTxHex` | `string` | The signed transaction in hex format | | `signatures` | `Signatures[]` | Array of signatures for the transaction | | `chainAlias` | `"X" \| "P" \| "C"` | The chain alias | | `subnetAuth` | `number[]?` | Subnet auth used for the transaction | | `subnetOwners` | `PChainOwner?` | Subnet owners used for the transaction | | `disableOwners` | `PChainOwner?` | Disable owners used for the transaction | | `disableAuth` | `number[]?` | Disable auth used for the transaction | **Signatures Object:** | Property | Type | Description | | ------------ | ---------- | ------------------------------------------------------------------------- | | `signature` | `string` | The signature of the transaction with the current account | | `sigIndices` | `number[]` | The indices of the signatures. Contains [inputIndex, signatureIndex] pair | **Example:** ```typescript const unsignedTx = await walletClient.pChain.prepareBaseTxn({ outputs: [ { addresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], amount: avaxToNanoAvax(0.1), }, ], }); const signedTx = await walletClient.signXPTransaction({ tx: unsignedTx.tx, chainAlias: "P", }); // Now send the signed transaction const { txHash } = await walletClient.sendXPTransaction({ tx: signedTx.signedTxHex, chainAlias: "P", }); console.log("Transaction hash:", txHash); ``` **Related:** - [sendXPTransaction](#sendxptransaction) - Send signed transaction - [signXPMessage](#signxpmessage) - Sign messages --- ## signXPMessage Sign a message with an XP account (P-Chain or X-Chain addresses). **Function Signature:** ```typescript function signXPMessage( params: SignXPMessageParameters ): Promise; interface SignXPMessageParameters { account?: AvalancheAccount | Address; message: string; accountIndex?: number; } interface SignXPMessageReturnType { signature: string; } ``` **Parameters:** | Name | Type | Required | Description | | -------------- | ----------------------------- | -------- | --------------------------------------------------------------------------------- | | `account` | `AvalancheAccount \| Address` | No | Account to use for the message | | `message` | `string` | Yes | Message to sign | | `accountIndex` | `number` | No | Account index to use for the message from custom transport (e.g., core extension) | **Returns:** | Type | Description | | ------------------------- | ------------------------ | | `SignXPMessageReturnType` | Message signature object | **Return Object:** | Property | Type | Description | | ----------- | -------- | ------------------------------------ | | `signature` | `string` | Hex-encoded signature of the message | **Example:** ```typescript const { signature } = await walletClient.signXPMessage({ message: "Hello Avalanche", }); console.log("Signature:", signature); ``` **Related:** - [API Reference](https://build.avax.network/docs/rpcs/x-chain#avmsignmessage) - [signXPTransaction](#signxptransaction) - Sign transactions --- ## EVM Transaction Methods The Avalanche Wallet Client extends viem's Wallet Client, providing access to all standard Ethereum transaction methods. ### Standard viem Methods ```typescript // Send transaction const hash = await walletClient.sendTransaction({ to: "0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6", value: parseEther("0.001"), }); // Sign message const signature = await walletClient.signMessage({ message: "Hello World", }); // Sign typed data (EIP-712) const typedSignature = await walletClient.signTypedData({ domain: { ... }, types: { ... }, primaryType: "Message", message: { ... }, }); ``` **For complete EVM wallet method reference, see:** [Viem Documentation](https://viem.sh/docs) --- ## Chain-Specific Wallet Operations ### P-Chain Wallet Operations Access through `walletClient.pChain`: ```typescript // Prepare base transaction const baseTx = await walletClient.pChain.prepareBaseTxn({ outputs: [ { addresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], amount: avaxToNanoAvax(1), }, ], }); // Prepare export transaction const exportTx = await walletClient.pChain.prepareExportTxn({ destinationChain: "C", exportedOutputs: [ { addresses: ["0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6"], amount: avaxToNanoAvax(1), }, ], }); // Prepare import transaction const importTx = await walletClient.pChain.prepareImportTxn({ sourceChain: "C", importedOutput: { addresses: ["P-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], }, }); ``` See [P-Chain Wallet Methods](./p-chain-wallet) for complete reference. ### X-Chain Wallet Operations Access through `walletClient.xChain`: ```typescript // Prepare base transaction const baseTx = await walletClient.xChain.prepareBaseTxn({ outputs: [ { addresses: ["X-fuji19fc97zn3mzmwr827j4d3n45refkksgms4y2yzz"], amount: avaxToNanoAvax(1), }, ], }); ``` See [X-Chain Wallet Methods](./x-chain-wallet) for complete reference. ### C-Chain Wallet Operations Access through `walletClient.cChain`: ```typescript // Prepare export transaction const exportTx = await walletClient.cChain.prepareExportTxn({ destinationChain: "P", fromAddress: account.getEVMAddress(), exportedOutput: { addresses: [account.getXPAddress("P")], amount: avaxToNanoAvax(1), }, }); // Prepare import transaction const importTx = await walletClient.cChain.prepareImportTxn({ sourceChain: "P", toAddress: account.getEVMAddress(), }); ``` See [C-Chain Wallet Methods](./c-chain-wallet) for complete reference. --- ## Next Steps - **[P-Chain Wallet Methods](./p-chain-wallet)** - P-Chain transaction preparation - **[X-Chain Wallet Methods](./x-chain-wallet)** - X-Chain transaction preparation - **[C-Chain Wallet Methods](./c-chain-wallet)** - C-Chain atomic transactions - **[Account Management](../accounts)** - Account types and creation - **[Viem Documentation](https://viem.sh/docs)** - Complete EVM wallet reference # X-Chain Wallet Methods (/docs/tooling/avalanche-sdk/client/methods/wallet-methods/x-chain-wallet) --- title: X-Chain Wallet Methods description: Complete reference for X-Chain transaction preparation methods --- ## Overview The X-Chain Wallet Methods provide transaction preparation capabilities for the Exchange Chain. These methods allow you to create unsigned transactions for various operations including base transfers and cross-chain transfers. **Access:** `walletClient.xChain` ## prepareBaseTxn Prepare a base X-Chain transaction for transferring AVAX or other assets. **Function Signature:** ```typescript function prepareBaseTxn( params: PrepareBaseTxnParameters ): Promise; interface PrepareBaseTxnParameters { outputs?: Output[]; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface Output { addresses: string[]; amount: bigint; assetId?: string; locktime?: bigint; threshold?: number; } interface PrepareBaseTxnReturnType { tx: UnsignedTx; baseTx: BaseTx; chainAlias: "X"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ---------- | -------- | --------------------------------------------- | | `outputs` | `Output[]` | No | Array of outputs to send funds to | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Output Object:** | Name | Type | Required | Description | | ----------- | ---------- | -------- | ------------------------------------------------------------------ | | `addresses` | `string[]` | Yes | Addresses who can sign the consuming of this UTXO | | `amount` | `bigint` | Yes | Amount in nano AVAX | | `assetId` | `string` | No | Asset ID of the UTXO | | `locktime` | `bigint` | No | Timestamp in seconds after which this UTXO can be consumed | | `threshold` | `number` | No | Threshold of `addresses`' signatures required to consume this UTXO | **Returns:** | Type | Description | | -------------------------- | ----------------------- | | `PrepareBaseTxnReturnType` | Base transaction object | **Return Object:** | Property | Type | Description | | ------------ | ------------ | ----------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `baseTx` | `BaseTx` | The base transaction instance | | `chainAlias` | `"X"` | The chain alias | **Example:** ```typescript import { createAvalancheWalletClient } from "@avalanche-sdk/client"; import { privateKeyToAvalancheAccount } from "@avalanche-sdk/client/accounts"; import { avalanche } from "@avalanche-sdk/client/chains"; import { avaxToNanoAvax } from "@avalanche-sdk/client/utils"; const account = privateKeyToAvalancheAccount("0x..."); const walletClient = createAvalancheWalletClient({ account, chain: avalanche, transport: { type: "http" }, }); const unsignedTx = await walletClient.xChain.prepareBaseTxn({ outputs: [ { addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], amount: avaxToNanoAvax(1), }, ], }); // Sign and send const signedTx = await walletClient.signXPTransaction({ tx: unsignedTx.tx, chainAlias: "X", }); const { txHash } = await walletClient.sendXPTransaction({ tx: signedTx.signedTxHex, chainAlias: "X", }); console.log("Transaction hash:", txHash); ``` **Related:** - [prepareExportTxn](#prepareexporttxn) - Cross-chain exports - [prepareImportTxn](#prepareimporttxn) - Cross-chain imports --- ## prepareExportTxn Prepare a transaction to export AVAX or other assets from X-Chain to another chain. **Function Signature:** ```typescript function prepareExportTxn( params: PrepareExportTxnParameters ): Promise; interface PrepareExportTxnParameters { destinationChain: "P" | "C"; exportedOutputs: Output[]; fromAddresses?: string[]; changeAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface PrepareExportTxnReturnType { tx: UnsignedTx; exportTx: ExportTx; chainAlias: "X"; } ``` **Parameters:** | Name | Type | Required | Description | | ------------------ | ------------ | -------- | --------------------------------------------- | | `destinationChain` | `"P" \| "C"` | Yes | Chain alias to export funds to | | `exportedOutputs` | `Output[]` | Yes | Outputs to export | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `changeAddresses` | `string[]` | No | Addresses to receive change | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Returns:** | Type | Description | | ---------------------------- | ------------------------- | | `PrepareExportTxnReturnType` | Export transaction object | **Return Object:** | Property | Type | Description | | ------------ | ------------ | ------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `exportTx` | `ExportTx` | The export transaction instance | | `chainAlias` | `"X"` | The chain alias | **Example:** ```typescript const exportTx = await walletClient.xChain.prepareExportTxn({ destinationChain: "C", exportedOutputs: [ { addresses: ["0x742d35Cc6634C0532925a3b8D4C9db96C4b4d8b6"], amount: avaxToNanoAvax(1), }, ], }); // Sign and send const signedTx = await walletClient.signXPTransaction({ tx: exportTx.tx, chainAlias: "X", }); const { txHash } = await walletClient.sendXPTransaction({ tx: signedTx.signedTxHex, chainAlias: "X", }); ``` **Related:** - [prepareImportTxn](#prepareimporttxn) - Import to X-Chain - [Wallet send method](./wallet#send) - Simplified cross-chain transfers --- ## prepareImportTxn Prepare a transaction to import AVAX or other assets from another chain to X-Chain. **Function Signature:** ```typescript function prepareImportTxn( params: PrepareImportTxnParameters ): Promise; interface PrepareImportTxnParameters { sourceChain: "P" | "C"; importedOutput: ImportedOutput; fromAddresses?: string[]; utxos?: Utxo[]; memo?: string; minIssuanceTime?: bigint; context?: Context; } interface ImportedOutput { addresses: string[]; locktime?: bigint; threshold?: number; } interface PrepareImportTxnReturnType { tx: UnsignedTx; importTx: ImportTx; chainAlias: "X"; } ``` **Parameters:** | Name | Type | Required | Description | | ----------------- | ---------------- | -------- | ----------------------------------------------- | | `sourceChain` | `"P" \| "C"` | Yes | Chain alias to import funds from | | `importedOutput` | `ImportedOutput` | Yes | Consolidated imported output from atomic memory | | `fromAddresses` | `string[]` | No | Addresses to send funds from | | `utxos` | `Utxo[]` | No | UTXOs to use as inputs | | `memo` | `string` | No | Transaction memo | | `minIssuanceTime` | `bigint` | No | Earliest time this transaction can be issued | | `context` | `Context` | No | Transaction context (auto-fetched if omitted) | **Imported Output Object:** | Name | Type | Required | Description | | ----------- | ---------- | -------- | ----------------------------------------------------------------------------------- | | `addresses` | `string[]` | Yes | Addresses who can sign the consuming of this UTXO | | `locktime` | `bigint` | No | Timestamp in seconds after which this UTXO can be consumed | | `threshold` | `number` | No | Number of signatures required out of total `addresses` to spend the imported output | **Returns:** | Type | Description | | ---------------------------- | ------------------------- | | `PrepareImportTxnReturnType` | Import transaction object | **Return Object:** | Property | Type | Description | | ------------ | ------------ | ------------------------------- | | `tx` | `UnsignedTx` | The unsigned transaction | | `importTx` | `ImportTx` | The import transaction instance | | `chainAlias` | `"X"` | The chain alias | **Example:** ```typescript const importTx = await walletClient.xChain.prepareImportTxn({ sourceChain: "C", importedOutput: { addresses: ["X-avax18jma8ppw3nhx5r4ap8clazz0dps7rv5ukulre5"], threshold: 1, }, }); // Sign and send const signedTx = await walletClient.signXPTransaction({ tx: importTx.tx, chainAlias: "X", }); const { txHash } = await walletClient.sendXPTransaction({ tx: signedTx.signedTxHex, chainAlias: "X", }); ``` **Related:** - [prepareExportTxn](#prepareexporttxn) - Export from X-Chain --- ## Next Steps - **[Wallet Methods](./wallet)** - General wallet operations - **[P-Chain Wallet Methods](./p-chain-wallet)** - P-Chain transaction preparation - **[C-Chain Wallet Methods](./c-chain-wallet)** - C-Chain atomic transactions - **[Account Management](../accounts)** - Account types and management # Welcome to the Course (/academy/avalanche-l1/avacloudapis) --- title: Welcome to the Course description: Learn about AvaCloud APIs and the AvaCloud SDK. updated: 2024-09-03 authors: [owenwahlgren] icon: Smile --- ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-banner/avacloudapis-ThOanH9UQJiAizv9gKtgFufXxRywkQ.jpg) ## Why Take This Course? [AvaCloud APIs](https://developers.avacloud.io/introduction), built by [AvaCloud](https://avacloud.io/), provides Web3 developers with multi-chain data from Avalanche’s primary network and other Avalanche L1s. With the AvaCloud API, you can easily build products that utilize real-time and historical transaction data, transfer records, native and token balances, and various types of token metadata. ## Course Content - [AvaCloud API Overview](/academy/avacloudapis/02-overview/01-about) - [Environment Setup](/academy/avacloudapis/03-environment-setup/01-avacloud-account) - [Build an ERC-20 Token Balance App](/academy/avacloudapis/04-erc20-token-balance-app/01-overview) - [Build a Wallet Portfolio App](/academy/avacloudapis/05-wallet-portfolio-app/01-overview) - [Build a Basic Block Explorer](/academy/avacloudapis/06-block-explorer-app/01-overview) ## Prerequisites A general understanding of web development is required. While you won't need to write a lot of code, familiarity with key concepts is important. - **TypeScript:** Understanding of common concepts, as all exercises will use TypeScript. - **React:** Basic understanding of React is required, as all exercises will use React. - **NextJS:** Basic understanding of NextJS is required, as all exercises will use NextJS. ## Learning Outcomes By the end of this course, you will: - Be familiar with the AvaCloud API including the [Data API](https://developers.avacloud.io/data-api/overview) and [Webhooks API](https://developers.avacloud.io/webhooks-api/overview). - Learn how to use the [AvaCloudSDK](https://github.com/ava-labs/avacloud-sdk-typescript) to interact with [AvaCloud APIs](https://developers.avacloud.io/introduction). - Build multiple web apps using the [AvaCloudSDK](https://github.com/ava-labs/avacloud-sdk-typescript). # Course Completion Certificate (/academy/avalanche-l1/avalanche-fundamentals/get-certificate) --- title: Course Completion Certificate updated: 2024-09-09 authors: [ashucoder9] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course. Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to the Course (/academy/avalanche-l1/avalanche-fundamentals) --- title: Welcome to the Course description: Learn about the basics of Avalanche. updated: 2024-05-31 authors: [ashucoder9] icon: Smile --- Welcome to the Avalanche Fundamentals, an online course introducing you to the exciting world of the Avalanche technology! This course will provide you with a comprehensive understanding of the basic concepts making Avalanche unique. Throughout, you'll learn the key features and benefits of the platform, plus how to build on it. You can also ask our expert instructors questions. By the end of these courses, you'll have the knowledge and skills to leverage the power of blockchain technology for your own projects and applications. We're excited to have you join us on this journey and can't wait to see what you'll create with Avalanche! ## Prerequisites This course is for people with some blockchain knowledge. Check out this [guide](/guides/what-is-a-blockchain) to review what a blockchain is and this [blog](/blog/what-is-fuji-testnet) to understand why and how testnets work. Familiarity with the basic design of modern distributed software systems and common blockchain systems such as Bitcoin and Ethereum is also recommended. You do not need to know how to write code to successfully complete this course. Having these prerequisites will help you better understand the course material and engage in the activities. If you don't know whether you have the necessary foundation for this course, please contact the course instructor for guidance. ## Learning Outcomes By the end of this course, you will: - Understand how Avalanche consensus works and what makes it different. - Understand how Avalanche L1s enable scalability, customizability, and independence. - Understand the Primary Network, a special Avalanche L1, and how to interact with it. - Understand how Virtual Machines enable developers to create more optimized and capable blockchain systems and to tackle completely new use cases unachievable with previous solutions. You can evaluate your own understanding of the material through quizzes and claim a certificate for successful completion at the end. Overall, this course aims to provide a foundational understanding of Avalanche. By completing it, you will be better prepared to take on more advanced courses focused on building on Avalanche. # Course Completion Certificate (/academy/avalanche-l1/icm-chainlink/certificate) --- title: Course Completion Certificate updated: 2024-10-11 authors: [owenwahlgren] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course. Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to the course (/academy/avalanche-l1/icm-chainlink) --- title: Welcome to the course description: Enable Chainlink services on L1 networks that do not have direct Chainlink support. updated: 2024-05-31 authors: [martineckardt] icon: Smile --- In this course, you will learn how to integrate your own blockchain with the Chainlink services that are deployed on C-chain. To do this, we will use Avalanche Interchain Messaging and Chainlink VRF. ## Why Take This Course? As the blockchain ecosystem grows, developers require robust tools to build secure, scalable, and innovative applications. Chainlink provides a suite of decentralized services, including VRF (Verifiable Random Function), Automation, Chainlink Functions, and CCIP (Cross-Chain Interoperability Protocol), to empower developers in creating high-performance, trustless applications. These services are not integrated by default on Avalanche L1 chains. However, Avalanche’s Interchain Messaging (ICM) enables developers to consume Chainlink services, typically available on the C-Chain, directly within their own L1 environments. This course equips you with the knowledge to integrate all Chainlink services into your Avalanche L1 blockchain. You will start with Chainlink VRF and progressively expand to advanced features like Automation for task scheduling, Functions for off-chain data computations, and CCIP for bridging data between Ethereum and Avalanche. We suggest you to revisit this course as we will keep on adding new content. ## Course Content ### Introduction Overview of Chainlink services and their role in decentralized applications. Importance of integrating these tools into Avalanche L1 chains. ### Chainlink VRF Explanation of VRF and its use cases. Deploying VRF on Avalanche L1 and verifying randomness. ### Chainlink Functions Overview of off-chain computation and API integrations. Implementing Functions for real-time data feeds. ### Chainlink Automation Using Automation for task scheduling. Examples include automated smart contracts and dynamic pricing. ### Chainlink CCIP Bridging data and assets between Ethereum and Avalanche L1. Practical applications such as cross-chain governance and token transfers. ## Prerequisites Avalanche Interchain Messaging (ICM): A solid understanding of Avalanche’s ICM protocol is essential. You should have completed the ICM course, which covers: - The fundamentals of cross-chain communication in Avalanche - Message formats and flows - Security techniques for interchain messaging Blockchain and Development Knowledge - Solidity: Familiarity with the language’s key concepts, especially those related to smart contract interactions and randomness. - Oracles: While we will cover the basic components of Chainlink's VRF, having a sense of oracles is desirable. If any of this is unclear, we strongly recommend taking the Avalanche Interchain Messaging course first. ## Learning Outcomes By the end of this course, students will: - Understand the mechanics of Chainlink VRF and other Chainlink Services and its significance in decentralized applications. - Gain proficiency in setting up Avalanche L1 chains with Chainlink services enabled. - Integrate Chainlink VRF with Avalanche ICM for secure cross-chain randomness. - Use Chainlink functions for Off-chain data integration with on-chain logic. - Automated smart contract operations - Cross-Chain communication with ecosystems outside Avalanche trough Chainlink's CCIP - Apply best practices to ensure reliability, security, and cost-efficiency in their applications. This course prepares developers to leverage Chainlink’s powerful suite of tools for building next-generation blockchain solutions on Avalanche L1. # Welcome to the Course (/academy/avalanche-l1/customizing-evm) --- title: Welcome to the Course description: Learn how to customize the Ethereum Virtual Machine. updated: 2024-09-27 authors: [ashucoder9, owenwahlgren] icon: Smile --- import { Step, Steps } from 'fumadocs-ui/components/steps'; ## Why take this Course? A significant innovation in blockchain is the development of multi-chain systems, such as Avalanche, which provide a significant improvement in scalability, interoperability, and flexibility. At the core of these multi-chain systems is the ability to run multiple blockchains powered by different virtual machines simultaneously. Each VM of a chain is optimized for specialized use cases, thereby boosting the network's overall performance. Configuring and modifying the EVM is an efficient way to create a specialized virtual machine, as it allows developers to build upon years of active community work and leverage the extensive ecosystem surrounding the EVM, including wallets, explorers, and development frameworks. ## Course Content ### EVM Basics & Precompiles In the first section of the course we will go through some basic concepts of the EVM, such as the account-based model, keys, addresses, transactions, and blocks. Furthermore, we will explain what a precompile is and show you how to interact with a precompile on the Fuji testnet. ### Development Environment Setup We will explore various ways to set up a development environment for building customized EVMs. You'll learn about GitHub Codespaces and Development Containers (`.devcontainer`). If you choose a local setup, you'll install a code editor, the Go language, configure your shell, and install additional dependencies. ### Hands-On Exercises The following sections contain hands-on exercises where you customize the EVM. The difficulty of the customizations will increase from section to section. Find out more about each exercise by clicking its name below: - Learn how the Avalanche Network Runner Works - Create a your own Avalanche Network - Create an EVM Blockchain on your network - Connect Core Wallet to your blockchain - Learn what the genesis block is and how the data is structured - Create a custom gas fee structure for your blockchain - Define the initial token allocation at launch - Configure pre-installed precompiles - Create the blockchain and connect to it Learn about the basic building blocks of a precompile by building a precompile for the md5 hash function: - Generate boilerplate code for the precompile from a solidity interface - Learn how to unpack inputs and pack outputs into 32 byte arrays - Configure and register your md5 precompile - Create a new blockchain, connect to it and interact with your precompile Learn to build more complex precompiles by building a calculator precompile and master the following skills in addition to the previous section: - Unpack multiple inputs and pack multiple outputs into 32 byte arrays - Set a gas cost for your precompile - Add go tests for your precompile Learn to build stateful precompiles by building a counter precompile and master the following skills in addition to the previous sections: - Read from and write to the EVM state - Define the initial state in the precompileConfig - Add solidity tests for your precompile Learn to build permissioned precompiles by building a XXX precompile and master the following skills in addition to the previous sections: - Add permissions to only allow certain addresses to interact with the precompile - Define the initial permissions in the precompileConfig - Change the permissions on the fly ## Prerequisites ### Avalanche This course is intended for people with a solid understanding of the basic concepts of Avalanche. You should be familiar with these concepts: 1. **Virtual Machines**: What they are and what VM customization means 2. **Blockchains**: What the components are of a blockchain and how they interact, specifically how Avalanche L1s leverage precompiles. If some of this is not clear, I strongly recommend taking the [Avalanche Fundamentals](/academy/avalanche-l1/avalanche-fundamentals) and [Multi-Chain Architecture](/academy/multi-chain-architecture) courses first. ### Coding You will need a general understanding of software development. You won't have to write a lot of code, but you will have to be able to understand some. Therefore, we recommend: 1. **Solidity**: Basic knowledge, familiarity with types and interfaces. Familiarity with Foundry will help in advanced sections. 2. **Go**: You don't necessarily need to know Go, but should have some experience with an advanced object-oriented and typed language (C, C++, Java, Typescript) 3. **Testing**: It will help you in later sections if you are generally familiar with the concept of unit testing ## Learning Outcomes By the end of this course, students will be able to: - Understand what Precompiles are and when to use them. - Understand how developing precompiles allows developers to create more optimized and capable blockchain systems, enabling them to address entirely new use cases that were previously unattainable. - Apply the knowledge gained in the course by building multiple precompiles ![](/wolfie/wolfie-hack.png) # Welcome to the Course (/academy/avalanche-l1/erc20-bridge) --- title: Welcome to the Course description: Learn how to bridge ERC-20 tokens between Avalanche L1s using Interchain Token Transfer. updated: 2025-01-24 authors: [nicolasarnedo] icon: Smile --- ## ERC-20 to ERC-20 Bridge Welcome to the **ERC-20 to ERC-20 Bridge** course! This course is designed to give you a deep understanding of bridging ERC-20 tokens between Avalanche L1s using Avalanche Interchain Token Transfer (ICTT). By the end of this course, you will have practical skills in deploying token bridges, understanding bridge security, and implementing multi-chain token transfers using Avalanche's native interoperability features. ### Prerequisites Before starting this course, we recommend completing: - [Interchain Messaging](/academy/avalanche-l1/interchain-messaging) - Foundation in cross-chain communication with ICM - [L1 Native Tokenomics](/academy/avalanche-l1/l1-native-tokenomics) - Understanding tokens fundamentals ### What You'll Learn This comprehensive course will walk you through: - **Token Bridging Fundamentals** - Understanding bridge architecture, security considerations, and common bridge vulnerabilities - **Avalanche Interchain Token Transfer** - Learning the ICTT protocol design, TokenHome and TokenRemote contracts - **ERC-20 to ERC-20 Bridge** - Deploying your own token bridge, registering remote chains, and transferring tokens - **Tokens on Multiple Chains** - Managing tokens across multiple L1s and implementing multi-hop transfers ### Let's Get Started! Each section builds upon previous knowledge, so we recommend completing the course in order. Happy learning and building! # Course Completion Certificate (/academy/avalanche-l1/interchain-token-transfer/certificate) --- title: Course Completion Certificate updated: 2024-10-11 authors: [owenwahlgren] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course. Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to the Course (/academy/avalanche-l1/interchain-token-transfer) --- title: Welcome to the Course description: Learn about sending assets to another L1s with Avalanche Interchain Token Transfer. updated: 2024-05-31 authors: [ashucoder9] icon: Smile --- In this course, you will learn how to transfer assets across multiple Avalanche blockchains with Avalanche Interchain Token Transfer ICTT. ## Why Take This Course? A significant innovation in blockchain is the development of multi-chain systems, like Avalanche, which provide a significant improvement in scalability, interoperability, and flexibility. At the core of these multi-chain systems is the ability to run multiple blockchains that communicate. Each chain's VM is optimized for specialized use cases, thereby boosting the network's overall performance. Cross-chain communication is a crucial building block of multi-chain systems. Utilizing Avalanche Interchain Messaging and Interchain Token Transfer is an incredibly easy way to build cross-Avalanche L1 dApps, since developers can build on top of an extensive, audited development framework. Transfering tokens between multiple chains is a common use case in multi-chain systems. This course will help you understand how to transfer assets between multiple Avalanche blockchains using the Avalanche Interchain Token Transfer protocol. This course focuses on using the existing testnet chains (Fuji C-Chain, Echo, and Dispatch). If you want to create your own L1 blockchain, please refer to the [Creating an L1](/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/01-creating-an-l1) course. Since Interchain Token Transfer relies on Interchain Messaging (ICM), you must run your own relayer to enable cross-chain communication. Follow the [Running a Relayer](/academy/interchain-messaging/09-running-a-relayer/01-relayer-introduction) course to set up your relayer. ## Course Content ### Getting Started with Interchain Token Transfer In this section, you will learn how to use our Interchain Token Transfer toolbox to perform cross-chain operations. We'll guide you through the process of using our user-friendly interface to deploy contracts, create bridges, and transfer assets across the testnet chains (Fuji C-Chain, Echo, and Dispatch). ### Tokens and Token Types In this section, you will learn about the different types of tokens that can be transferred between Avalanche blockchains. We will cover ERC-20 and native tokens and how to deploy and transfer them using our toolbox. Furthermore, you will learn what wrapped native tokens are and how they can be used to transfer assets between chains. ### Token Bridging Next we will talk about the high level concepts of token bridging and demonstrate how to use our toolbox to create and manage bridge contracts for cross-chain transfers between the testnet chains. ### Interchain Token Transfer Architecture In this chapter we will look at the design of Avalanche Interchain Token Transfer. You will learn about the file structure of the contracts and the concepts of the token home and token remote. ### ERC-20 to ERC-20 Bridge Implementation You will learn how to use our toolbox to deploy ERC-20 tokens and create bridges to transfer them between the testnet chains. ### Multi-Chain Token Operations Here you will learn about the concept of multi-hops and how to use our toolbox to bridge tokens between multiple testnet chains. ### Native to ERC-20 Bridge Implementation In this chapter you will learn how to use our toolbox to bridge a native token as an ERC-20 token to another testnet chain. ### Send and Call Operations In this chapter you will learn how to use our toolbox to call smart contracts with the tokens after sending them to another testnet chain. ### Cross-Chain Token Swaps In this chapter you will learn how to perform cross-chain token swaps between the testnet chains using our toolbox. ## Prerequisites ### Avalanche Knowledge This course is intended for people with knowledge about Cross-Chain communication protocols, and a solid understanding of the basic concepts of Avalanche. You should be familiar with these concepts: 1. Avalanche Architecture: Be familiar with Avalanche blockchains. 2. Interchain Messaging: Know how to communicate between two Avalanche blockchains with ICM. If some of this is not clear, we strongly recommend taking the Avalanche Fundamentals, Multi-Chain Architecture, and Interchain Messaging courses first. ### Software Development You will need a general understanding of how to use Web3 applications. We recommend: 1. Basic understanding of how to use Core Wallet - Download from [core.app](https://core.app) 2. Test tokens for development - **Recommended:** Create a [Builder Hub account](https://build.avax.network/login) and connect your wallet to receive testnet tokens automatically - **Alternative:** Use external faucets like [core.app/tools/testnet-faucet](https://core.app/tools/testnet-faucet/?subnet=c&token=c) with code `avalanche-academy` 3. Understanding of token standards (ERC-20, etc.) ## Learning Outcomes By the end of this course, you will: - Understand what Avalanche Interchain Token Transfer is and when to use it. - Understand the different options for transferring assets between multiple chains. - Be able to deploy tokens and create bridges using our toolbox. - Be able to perform cross-chain token transfers between testnet chains using our toolbox. - Apply the knowledge gained in the course by enabling assets to be transferred between multiple Avalanche blockchains. # Course Completion Certificate (/academy/avalanche-l1/interchain-messaging/certificate) --- title: Course Completion Certificate updated: 2024-10-11 authors: [owenwahlgren] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course. Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to the course (/academy/avalanche-l1/interchain-messaging) --- title: Welcome to the course description: Learn about Interchain Messaging, the interoperability protocol of Avalanche. updated: 2025-05-13 authors: [martineckardt, nicolasarnedo] icon: Smile --- In this course, you will learn how to build cross-L1 Solidity dApps with Interchain Messaging and Avalanche Warp Messaging. ## Why Take This Course? A significant innovation in blockchain is the development of multi-chain systems, like Avalanche, which provide a significant improvement in scalability, interoperability, and flexibility. At the core of these multi-chain systems is the ability to run multiple blockchains that communicate. Each chain's VM is optimized for specialized use cases, thereby boosting the network's overall performance. Cross-chain communication is a crucial building block of multi-chain systems. Utilizing Interchain Messaging and Avalanche Warp Messaging is an incredible easy way to build cross-L1 dApps, since developers can build on top an extensive and audited development framework. ## Course Content Below you can find a 30 minute recording of a presentation about Avalanche Warp Messaging and Teleporter. This summarizes the content of the first chapters: ### Interoperability In the first section, we cover some basic concepts of interoperability in multi-chain systems. You will learn about examples of interoperability between blockchains and the terms "source," "destination," and "message." ### Avalanche Interchain Messaging In this section, we learn what Avalanche Interchain Messaging is and what is abstracted away from the general dApp developer. You will also build your first cross-L1 dApps. ### Securing Cross-Chain Communication In this section, we look at techniques to secure cross-chain communication. We dive into signature schemes, multi-signature schemes, and the BLS multi-signature scheme. ### Avalanche Interchain Messaging Protocol Avalanche blockchains can natively interoperate between one another using AWM. You will learn about the AWM message format and how the message flow works. ## Prerequisites ### Avalanche This course is meant for people with a solid understanding of the basic concepts of Avalanche. You should be familiar with these concepts: - **Virtual Machines:** What they are and what VM customization means - **Avalanche L1s & Blockchains:** What the difference between a VM, Blockchain, and an Avalanche L1 is If any of this is unclear, we strongly recommend taking the Avalanche Fundamentals and Multi-Chain Architecture courses first. ### Software Development You will need a general understanding of Software Development. You won't have to write a lot of code, but you will have to understand some. Therefore, we recommend: - **Solidity:** Familiarity with most concepts of the language. All exercises will mainly consist of writing cross-subnet dApps in Solidity. - **Docker:** The advanced exercises in the latter part of the course will occur in contained environments for easy setup. It will help if you're generally familiar with the concept of containerization, docker, and docker compose. - **Testing:** Having some experience or familiarity with unit testing is ideal. ## Learning Outcomes By the end of this course, students will: - Understand the challenges of cross-chain communication - Know what separates Avalanche Warp Messaging from other cross-chain communication protocols - Understand the differences between Avalanche Warp Messaging and Teleporter - Apply their knowledge by building cross-Avalanche L1 dApps, such as asset bridges Overall, this course aims to provide an advanced understanding of Teleporter. By completing this course, students will be better prepared to build advanced cross-Avalanche L1 blockchain applications. # Course Completion Certificate (/academy/avalanche-l1/permissioned-l1s/certificate) --- title: Course Completion Certificate description: Get your completion certificate for the Permissioned L1s course updated: 2025-03-19 authors: [nicolasarnedo] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course! Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to the Course (/academy/avalanche-l1/permissioned-l1s) --- title: Welcome to the Course description: Learn about L1 Validator Management for Permissioned Blockchains updated: 2025-07-15 authors: [nicolasrnedo] icon: Smile --- ## Permissioned L1s Welcome to the **Permissioned L1s** course! This course is designed to give you a deep understanding of configuring, launching and maintaining permissioned L1s on Avalanche. By the end of this course, you will have practical skills in deploying an L1 and managing the validator set in a Proof of Authority (PoA) network. ## Video ### What You'll Learn This comprehensive course will walk you through: - **Introduction** - P-Chain review, how Validator Manager Contracts use ICM & commonlys used Proxy Patterns - **Proof of Authority** - Understanding permissioning types for blockchains, what Proof of Authority is and the Validator Manager contract structure - **Create an L1** - Creating a Subnet, diving deep into the Transparent Proxy pattern, understanding genesis pre-deployed contracts and creating your L1 (recommended to first have created an L1 in the [Avalanche Fundamentals course](/academy/avalanche-l1/avalanche-fundamentals)) - **Validator Manager Deployment** - Deploying and configuring the Validator Manager Contract (VMC) on your new L1 - **Validator Manager Operations** - Adding, changing weights and removing validators - **Coming Soon... Multi-Sig Setup for PoA** - Implementing secure multi-signature governance with Safe/Ash wallets - **Coming Soon... Private L1s** - Configuring validator-only access and RPC node restrictions ### Let's Get Started! Each section builds upon previous knowledge, so we recommend completing the course in order. Happy learning and building! # Dapp's and L1's (/academy/avalanche-l1/l1-native-tokenomics/dappVsL1) --- title: Dapp's and L1's description: Listing tokenomics and infrastructure requirements to understand whether creating an L1 is neccessary for your business-case updated: 2025-08-21 authors: [nicolasarnedo] icon: Microscope --- So far you have learnt a lot of the basics around blockchains, how they work, architecture, consensus mechanism's, smart contract's, and also Avalanche-specific concepts. Before reading through this course however, now is a good moment to reflect on whether your use-case requires it's own L1 and native tokenomics. In order to do this, there are several economic factors which will dictate if we should deploy an application on a public blockchain (Avalanche C-chain, Ethereum) or create our own custom Layer 1 (L1) blockchain. Let's look into them... ### Transaction Volume and Value If your application processes a high volume of low-value transactions, a custom L1 may be more cost-effective in the long run. Conversely, if your application handles only a few high-value transactions, the cost savings may not justify the complexity of running a separate L1. ### Fee Stability On a public blockchain, you are at the mercy of network-wide fee fluctuations. With a custom L1, you can ensure fee stability, which is crucial for budgeting and long-term planning. ### Data Control and Customization You can control who interacts with your application equally when deploying an app to a public chain vs on your own L1, but if you want to have more control on the data; who can deploy smart contracts, isolating your data for compliance/KYC reasons, or who can validate transactions, then you will absolutely need an L1. If you do have to create an L1 - the primary cost of running it is the infrastructure required to support the validator set. Once you establish an appropriate number of validators based on your security requirements, the operational costs become mostly fixed. These costs are independent of the number and complexity of the transactions processed on your chain, providing predictable financial outlays as your application scales. ### Token Location Choose based on where your security and token economics must live. If your token must be native to the protocol (gas token, staking/slashing, fee burn/distribution, protocol‑level issuance or supply rules) and you need validator/permissioning guarantees, a custom L1 is appropriate. If your token’s utility is application‑level (access, rewards, governance without base‑fee mechanics) and you benefit from public‑chain security and liquidity, a dApp with an ERC‑20 on a public chain is the simpler path. Decide whether the required guarantees are protocol‑layer (L1) or app‑layer (public chain). Launching a blockchain application on a public permissionless blockchain or spinning up your own L1 on Avalanche is a decision that depends heavily on your application's transaction profile and economic model. Ultimately, the decision should be driven by a careful analysis of your transaction patterns, user experience goals, what will be the token utilty and the potential for fee volatility in public networks. By weighing these factors, you can make an informed decision that aligns with your application's long-term success. #### *Use-case Example* *Gaming application where users frequently make micro-transactions, high transaction fees on a public blockchain could be a significant barrier to user retention. By deploying your own L1, you can minimize or even eliminate these fees, thereby enhancing the user experience and driving higher engagement. This is particularly relevant for applications that target mainstream audiences, where a seamless and cost-effective user experience is paramount.* **Live Proof**: [Off The Grid](https://gunzillagames.com/en/) uses a dedicated Avalanche L1 to power a player‑driven economy with on‑chain item ownership (NFTs) and currency ($GUNZ). # Welcome to the Course (/academy/avalanche-l1/l1-native-tokenomics) --- title: Welcome to the Course description: Learn about the L1 Native Tokenomics updated: 2025-08-21 authors: [nicolasarnedo] icon: Smile --- Welcome to the **L1 Native Tokenomics** course! This course is designed to give you a deep understanding of how to create and manage native tokens on your own Avalanche L1 blockchain. By the end of this course, you will have practical skills in designing tokenomics, configuring native token allocation, and leveraging precompiles to create powerful token economies. ## Prerequisites Before starting this course, you should have completed the [Blockchain Fundamentals](/academy/blockchain-fundamentals) and [Avalanche Fundamentals](/academy/avalanche-l1/avalanche-fundamentals) courses of the [Avalanche Developers Academy](https://build.avax.network/academy#:~:text=Choose%20Your%20Learning%20Path) learning tree. ## Learning Outcomes By the end of this course, you will: - **Understand Token Fundamentals**: Gain deep insights into what tokens are, their differences, and the implications of creating native tokens versus ERC20 tokens. - **Master Native Token Creation**: Learn how to create custom native tokens and understand when you need them versus when ERC20 tokens are sufficient. - **Leverage Precompiles**: Understand how to use the Native Minter and Fee Config Precompiles to create powerful tokenomics. - **Design Token Distribution**: Create effective vesting schedules, bonding curves, and airdrop strategies for your native tokens. - **Implement Governance**: Develop governance structures including DAOs and quadratic voting models for decentralized decision-making. But before diving into the technical implementation, we've included two essential think pieces to help you make informed decisions: **Essential Reading**: [Dapp vs L1](/academy/l1-native-tokenomics/dapp-vs-l1) - A critical analysis to determine whether your use case actually requires its own L1 with native tokenomics, or if deploying on an existing chain would be more appropriate. **Highly Recommended**: [Token Ownership](/academy/l1-native-tokenomics/token-ownership) - Not strictly necessary for implementation, this deep dive into the philosophical and practical aspects of token ownership will give you a much richer understanding of the underlying concepts at play in tokenomics design. # Token Ownership (/academy/avalanche-l1/l1-native-tokenomics/token-ownership) --- title: Token Ownership description: Everything you need to know about token ownership on blockchains updated: 2025-08-21 authors: [nicolasarnedo] icon: Key --- ## A Short History and Why It Matters Token ownership means recording who controls a digital asset on a public ledger, enforced by cryptography and consensus rather than by legal registries alone. It unlocks portable, programmable, and verifiable property rights for anything that can be represented in bits. ### From Scarcity to Programmability - Bitcoin (2009) solved digital scarcity and established provable, bearer‑style ownership “by code.” - Ethereum (2015) generalized ownership with smart contracts, enabling tokens: programmable representations of value, access, or rights. The 2014–2018 wave of token sales showed how ownership could be distributed globally without intermediaries—sometimes as utility access, sometimes (mistakenly) as implied equity. The lesson: tokens coordinate, but value capture must be designed, not assumed. ### What “Ownership” Means On‑Chain On blockchains, ownership is: - Verifiable: anyone can audit balances and provenance. - Portable: assets move across apps and wallets with private keys. - Programmable: rights can encode governance, access, royalties, staking, or fee distribution. - Composable: tokens integrate with DeFi, marketplaces, and tooling by common standards. ### Token Classes at a Glance Classification of crypto assets At a high level: - Fungible tokens (e.g., ERC‑20) track interchangeable units (balances, payments, governance power). - Non‑fungible tokens (e.g., ERC‑721) track unique items and their provenance (collectibles, credentials, rights). - Hybrids and multi‑tokens (e.g., ERC‑1155) combine both models for efficient gaming/commerce flows. ### Why Tokenized Ownership Works Tokens drastically reduce friction to distribute and align ownership. Like equity, they can motivate long‑term contribution; unlike equity, they are programmable (e.g., automatic reward streams, on‑chain voting) and readily tradable. But not every token confers the same rights: designs differ in value capture (fee burns, staking rewards, access discounts), transferability, and governance—and must consider regulation. ### Looking Ahead As you move into native tokens and ERC‑20s next, keep this lens: token ownership is a coordination primitive. Good designs clearly define what is owned (rights), how value accrues (mechanics), and how ownership changes hands (standards and controls). With those pillars, tokens become reliable building blocks for open, interoperable economies. # Course Completion Certificate (/academy/avalanche-l1/permissionless-l1s/certificate) --- title: Course Completion Certificate description: Get your completion certificate for the Permissioned L1s course updated: 2025-03-19 authors: [nicolasarnedo] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course! Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to the Course (/academy/avalanche-l1/permissionless-l1s) --- title: Welcome to the Course description: Learn about L1 Validator Management for Permissionless Blockchains updated: 2025-01-15 authors: [nicolasarnedo] icon: Smile --- ## Permissionless L1s Welcome to the **Permissionless L1s** course! This course is designed to give you a deep understanding of configuring, launching and maintaining permissionless L1s on Avalanche. By the end of this course, you will have practical skills in deploying an L1 with Proof of Stake (PoS) consensus and managing the validator set in a permissionless network. ### Prerequisites Before starting this course, we recommend completing: - [L1 Native Tokenomics](/academy/l1-native-tokenomics) - Understanding tokenomics fundamentals - [Permissioned L1s](/academy/permissioned-l1s) - Foundation in L1 validator management If you just completed these recently, you can go ahead and skip the [Review chapter](). If not, we recommend giving it a read, it will cover: - P-Chain fundamentals - Multi-Chain Architecture - Permissioned L1s - Native Tokenomics ### What You'll Learn This comprehensive course will walk you through: - **Proof of Stake** - Understanding PoS consensus, staking token selection, and liquid staking considerations - **Transformation Requirements** - Basic precmpoiles (Native Minter and Reward Manager) needed to transform your L1 into a permissionless network - **Basic Setup**(*optional*) - Deploying Validator Manager Contract, upgrading proxy, and initializing validator configuration - **Staking Manager Setup** - Deploying and configuring staking managers for native token staking - **Staking Manager Operations** - Adding, changing weights, removing validators, and handling delegation - **Node Licenses** - Understanding validator licensing and real-world examples ### Let's Get Started! Each section builds upon previous knowledge, so we recommend completing the course in order. Happy learning and building! # Welcome to the course (/academy/blockchain/encrypted-erc) --- title: Welcome to the course description: Learn about the encrypted-ERC (eERC) token standard from AvaCloud. updated: 2025-07-21 authors: [alejandro99so] icon: Lock --- Welcome to the **eERC Token Standard** course! This course is designed to give you a deep understanding of encrypted ERC (eERC), a privacy preserving ERC-20 like token standard developed by AvaCloud, enabling confidential transactions on EVM-compatible blockchains. By the end of this course, you will understand the privacy limitations of traditional token standards, how eERC solves them, and how to create and integrate your own private tokens. ## Course Content ### 1. What is a Digital Asset? - **Standards**: ERC-20, ERC-721, ERC-1155 - **Current Uses**: How companies, DeFi protocols, and projects are using them today. - **Limitations**: Challenges companies face when trying to adopt these standards (scalability, privacy, compliance). ### 2. Real Privacy - **How Private is the Blockchain?**: Transparency vs confidentiality. - **Compliance**: Why regulatory alignment matters for privacy tokens. - **Necessities Solved with Privacy**: Situations where privacy is essential (e.g., sensitive transactions, enterprise use). ### 3. Encrypted Tokens - **What Kind of Privacy Does eERC Provide?**: Hidden balances, confidential transfers. - **Comparison: ERC-20 vs eERC**: Feature-by-feature breakdown. - **Technology Behind eERC**: Zero-knowledge proofs and homomorphic encryption. ### 4. Usability of eERC - **Standalone vs Converter Contract**: When to use each mode. - **Use Cases**: From DeFi to regulated financial institutions. ### 5. eERC Contracts Flow - **Step-by-Step**: Creating your own eERC token and considerations. - **Kinds of ZKProof to Use**: Selection criteria based on use case. - **User Flow**: How to interact with eERC as an end user. --- ## Prerequisites Before starting this course, you should have: ### Blockchain Fundamentals Familiarity with EVM-based blockchains and ERC token standards. ### Development Tools Basic knowledge of Solidity and comfort using TypeScript will help, especially when working with the Privacy functions. --- ## Learning Outcomes By the end of this course, you will: - Understand the **purpose and innovation** behind the eERC standard. - Compare **traditional ERC standards** with encrypted ERC for privacy and compliance. - Identify the **key benefits, architecture, and technical underpinnings** of eERC. - Differentiate between **Standalone** and **Converter** implementation modes. - Recognize **real-world use cases** where privacy and auditability are essential. - Create and deploy your own **eERC token** following a step-by-step process. - Understand how to **interact with eERC as a user** in different scenarios. # Course Completion Certificate (/academy/blockchain/blockchain-fundamentals/get-certificate) --- title: Course Completion Certificate updated: 2025-30-10 authors: [ashucoder9] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course. Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to the Course (/academy/blockchain/blockchain-fundamentals) --- title: Welcome to the Course description: Learn about the basics of blockchain technology. updated: 2025-10-30 authors: [ashucoder9] icon: Smile --- Welcome to the Blockchain Fundamentals, an online course introducing you to blockchain! This course will provide you with a comprehensive understanding of the basic concepts of blockchains. By the end of these courses, you'll have the knowledge and skills to leverage the power of blockchain technology for your own projects and applications. We're excited to have you join us on this journey and can't wait to see what you'll create with Avalanche! ## Course Content We will cover the following topics in this course: - What is a Blockchain? - Deep Dive into Payments - Cryptography: Signature schemes - Consensus Mechanisms - Sybil Defense Mechanisms - Smart contracts - Tokenomics - Virtual Machines ## Prerequisites Anyone can take this course! ## Learning Outcomes By the end of this course, you will have a good understanding of the basic concepts of blockchain technology. You can evaluate your own understanding of the material through quizzes and claim a certificate for successful completion at the end. # Decentralization (/academy/blockchain/blockchain-fundamentals/xx-decentralization) --- title: Decentralization description: TBD updated: 2024-05-31 authors: [martineckardt] icon: BookOpen --- ## Moving from a centralized Entity to a Collective of Validators Blockchain systems achieve decentralization through the use of a network of validators, sometimes referred to as nodes, miners, or stakers, depending on the underlying consensus mechanism. Validators are responsible for verifying and securing transactions, maintaining the integrity of the blockchain, and ensuring that the system remains decentralized and trustless. Decentralization is achieved by distributing the responsibility of maintaining the network across numerous independent participants. Decentralization in blockchain is achieved through a network of validators. These are independent entities that run the blockchain software, perform computations, and ensure the integrity of the blockchain. Here’s how it works: Computation Execution: Each validator independently performs the same computation. For example, let's consider a simple computation: 5 + 3. Consensus Process: After performing the computation, validators share their results with each other. They then use a process called consensus to agree on the correct result. You can think of it as a election, where all validators vote on the correct answer. The consensus process ensures that all validators reach an agreement on the correct result, given that the majority is honest. This agreement is crucial for maintaining the integrity and security of the blockchain. If a validator tries to cheat or provide an incorrect result, the other validators will detect the discrepancy, and the cheating validator will be penalized. # Tokens (/academy/blockchain/blockchain-fundamentals/xx-tokens) --- title: Tokens description: TBD updated: 2024-05-31 authors: [martineckardt] icon: Notebook --- Tokens are a concept that existed in societies for a long time. Tokens can be used to represent value. The most common valuable tokens we use every day are fiat currencies, like the US dollar. But there are also other kinds of tokens, such as points or miles in loyalty programs. Today we can also tokenize other assets, such as property titles. ## Fungible Tokens Fungibility means that different tokens can be considered of equal value. Let's take for example two one dollar bills. Most people will not care if they get one or the other. They both offer the same utility. ## Non-Fungible Tokens Non-fungible tokens are not considered equal. The most prominent use cases are Art-NFTs. While the tokens may follow a standard of how they can be transfered, they may not be interchangeable. Two pieces of art may have very different values. # Understanding ERC-721 Tokens (/academy/blockchain/nft-deployment/01-erc721-standard) --- title: Understanding ERC-721 Tokens description: Learn about the Non-Fungible Token Standard updated: 2024-11-20 authors: [nicolasarnedo] icon: Book --- Previously, we explored the ERC-20 interface, a contract standard which allowed for the implementation of fungible tokens. However, there is one important use case that the ERC-20 standard cannot support: **non-fungible assets**. ## What is Fungibility? To understand why we need ERC-721, let's first understand fungibility: - **Fungible tokens** (ERC-20): Each token is identical and interchangeable. 1 USDC is always equal to 1 USDC. - **Non-fungible tokens** (ERC-721): Each token is unique and has its own distinct value. One piece of digital art is not equal to another. ## Why ERC-721? Imagine you wanted to represent an art collection within a smart contract. The smart contract would need: - The ability to query the "balance" (i.e. the art holdings) of a particular user - The ability to transfer art pieces from one account to another - The ability to get information about the art collection The biggest difference between an ERC-20 token contract and an art collection is the **fungibility** of individual items. ERC-20 tokens are inherently fungible, while items in an art collection are not (since each piece varies in value). To account for use cases like art collections, digital collectibles, gaming items, and more, the **ERC-721 standard** was introduced. ## The ERC-721 Interface Formally, ERC-721 is a standard for non-fungible tokens. Below is the interface of the ERC-721 token from its original proposal: ```solidity interface ERC721 { /// @dev This emits when ownership of any NFT changes by any mechanism. event Transfer(address indexed _from, address indexed _to, uint256 indexed _tokenId); /// @dev This emits when the approved address for an NFT is changed or reaffirmed. event Approval(address indexed _owner, address indexed _approved, uint256 indexed _tokenId); /// @dev This emits when an operator is enabled or disabled for an owner. event ApprovalForAll(address indexed _owner, address indexed _operator, bool _approved); /// @notice Count all NFTs assigned to an owner function balanceOf(address _owner) external view returns (uint256); /// @notice Find the owner of an NFT function ownerOf(uint256 _tokenId) external view returns (address); /// @notice Transfers the ownership of an NFT from one address to another address function safeTransferFrom(address _from, address _to, uint256 _tokenId, bytes data) external payable; /// @notice Transfers the ownership of an NFT from one address to another address function safeTransferFrom(address _from, address _to, uint256 _tokenId) external payable; /// @notice Transfer ownership of an NFT function transferFrom(address _from, address _to, uint256 _tokenId) external payable; /// @notice Change or reaffirm the approved address for an NFT function approve(address _approved, uint256 _tokenId) external payable; /// @notice Enable or disable approval for a third party ("operator") to manage all assets function setApprovalForAll(address _operator, bool _approved) external; /// @notice Get the approved address for a single NFT function getApproved(uint256 _tokenId) external view returns (address); /// @notice Query if an address is an authorized operator for another address function isApprovedForAll(address _owner, address _operator) external view returns (bool); } ``` ## Key Differences from ERC-20 ### Token Identification **ERC-20:** ```solidity mapping(address => uint) balances; ``` **ERC-721:** ```solidity mapping(address => uint) balances; // Number of NFTs owned by each address mapping(uint => address) holders; // Owner of each specific token ID ``` The key difference is the addition of the `holders` mapping, which tracks which address owns each individual token by its unique ID. This allows each token to be distinct and non-fungible. ### Transfer Functions ERC-721 introduces `safeTransferFrom`, which includes a safety check to ensure the receiving address can handle NFTs. This prevents tokens from being permanently lost if sent to a contract that doesn't support them. ### Approval Mechanism Like ERC-20, ERC-721 supports approvals, but with two levels: - **Single token approval**: Approve someone to transfer a specific NFT - **Operator approval**: Approve someone to manage all your NFTs ## Common Use Cases ERC-721 tokens are used for: - **Digital Art**: Unique artwork pieces with verifiable ownership - **Collectibles**: Trading cards, virtual items, and memorabilia - **Gaming Assets**: In-game items, characters, and land - **Real Estate**: Tokenized property ownership - **Identity**: Unique credentials and certificates - **Domain Names**: Blockchain-based domain systems ## Next Steps Now that you understand the ERC-721 standard, you're ready to create your own NFT collection. In the next section, we'll prepare the files needed for your NFTs, including images and metadata. # Prepare NFT Files (/academy/blockchain/nft-deployment/02-prepare-nft-files) --- title: Prepare NFT Files description: Learn how to prepare and upload your NFT images and metadata to IPFS updated: 2024-11-20 authors: [Andrea Vargas, Ash, martineckardt] icon: BookOpen --- The first step of setting up an NFT smart contract is having your NFT files ready to use. In this guide, we'll upload files to [Pinata](https://www.pinata.cloud/), a pinning service that prevents files from being garbage collected on IPFS. If you don't already have a Pinata account, please [create one](https://www.pinata.cloud/) before proceeding. The free tier is sufficient for this tutorial. ## Preparing the Images This tutorial will create only 1 NFT, however, if you're interested in creating more, you're more than welcome to do so. ![Original NFT Photo](/images/nft-files1.jpeg) ### Organizing Your Images 1. Create a folder on your computer for your NFT images 2. Name your image file `0` (without any file extension visible) 3. If creating multiple NFTs, continue naming them sequentially: `0`, `1`, `2`, etc. **Important**: Some projects start file names with `0`, and others with `1`. That choice must be consistent with your smart contract code. For this tutorial, we'll start with `0`. ![Image Folder](/images/nft-files2.png) ### Uploading Images to Pinata 1. Log into your Pinata dashboard 2. Click the **Upload** button on the left sidebar 3. Select **Folder** from the upload options ![Pinata Dashboard](/images/nft-files3.png) ![Folder Button](/images/nft-files4.png) 4. Select the folder containing your image(s) 5. Confirm the upload if prompted by your browser ![Confirm Upload](/images/nft-files5.png) 6. Give your folder a descriptive name (this helps organize multiple collections) 7. Click **Upload** and wait for the process to complete Once the upload is complete, you'll see your folder in the dashboard: ![Uploaded Image Folder](/images/nft-files6.png) ### Getting Your Image URL 1. Click on the folder name to view it through the Pinata gateway 2. Right-click on your image and copy the URL 3. Save this URL - you'll need it for the metadata file Example URL: `https://gateway.pinata.cloud/ipfs/QmPWbixyMsaNkR9v612bBFbncKGmgXDKz9CgMtDDD7Bymw/0.png` ## Creating Metadata Files Now that we have the image uploaded, we need to create matching metadata files. Since we're creating an ERC-721 NFT, we'll use the standard metadata format used by marketplaces like [Joepegs.com](https://joepegs.com/). ### Metadata Structure The basic [metadata structure](https://docs.opensea.io/docs/metadata-standards#metadata-structure) looks like this: ```json { "name": "", "tokenId": 0, "image": "", "description": "", "attributes": [] } ``` ### Populating the Metadata Let's fill in each field: - **name**: Choose any name for your NFT - **tokenId**: Use `0` to correspond with your first image (increment for additional NFTs) - **image**: Paste the image URL you copied from Pinata - **description**: Describe your NFT - **attributes**: Optional array for traits (useful for collections with layers/rarity) Example completed metadata: ```json { "name": "Cool Photography", "tokenId": 0, "image": "https://gateway.pinata.cloud/ipfs/QmPWbixyMsaNkR9v612bBFbncKGmgXDKz9CgMtDDD7Bymw/0.png", "description": "A cool image" } ``` The `attributes` field is particularly useful for NFT collections with multiple layers. It's used to calculate rarity and rank NFTs based on how frequently their traits appear throughout the collection. For this simple example, we've omitted it. ### Saving the Metadata File 1. Save this JSON content as a file named `0` (matching your image name) 2. **Remove the file extension** so it's just `0`, not `0.json` - [Mac instructions](https://support.apple.com/guide/mac-help/show-or-hide-filename-extensions-on-mac-mchlp2304/mac) - [Windows instructions](https://www.techwalla.com/articles/how-to-remove-file-extensions) **Critical**: The metadata file must NOT have a `.json` extension when uploaded to Pinata. The IPFS gateway will serve it as a directory, and your smart contract will be able to fetch it correctly. 3. Place the metadata file in a **separate folder** from your images ![Metadata Folder](/images/nft-files7.png) ### Uploading Metadata to Pinata 1. Repeat the folder upload process for your metadata folder 2. Follow the same steps as you did for the images 3. Once uploaded, both folders should appear in your dashboard ![Uploaded Folders](/images/nft-files8.png) ### Getting Your Base URI 1. Click on the **metadata folder** to view it in the IPFS gateway 2. Copy the URL - this is your **Base URI** 3. **Important**: Use only the folder URL, not the individual file URL Example Base URI: `https://gateway.pinata.cloud/ipfs/QmYdWxbiwsfsYcW1CYQPgYujAc9FMLPG3fgFcxFskbSsFa` The smart contract will automatically append the token ID to this base URI when fetching metadata for each NFT. ## File Preparation Checklist Before moving to the next section, ensure you have: - ✅ Images uploaded to Pinata in a folder - ✅ Metadata files created with correct structure - ✅ Metadata files named to match image files (0, 1, 2, etc.) - ✅ Metadata files uploaded to Pinata in a **separate** folder - ✅ Base URI copied and saved ## Next Steps Now that your NFT files are prepared and uploaded to IPFS, you're ready to create and deploy your smart contract. In the next section, we'll use OpenZeppelin's Contract Wizard to generate an ERC-721 contract customized for your collection. # Create Your NFT Smart Contract (/academy/blockchain/nft-deployment/03-create-smart-contract) --- title: Create Your NFT Smart Contract description: Use OpenZeppelin to generate a customized ERC-721 contract updated: 2024-11-20 authors: [Andrea Vargas, Ash, martineckardt] icon: BookOpen --- Now that your NFT files are prepared, it's time to create the smart contract that will manage your NFT collection. We'll use [OpenZeppelin](https://docs.openzeppelin.com/), a trusted library for building secure smart contracts. ## Why OpenZeppelin? OpenZeppelin provides battle-tested, audited smart contract implementations that follow industry standards. Their [Contract Wizard](https://wizard.openzeppelin.com/#erc721) allows you to generate customized contracts without writing code from scratch, reducing the risk of security vulnerabilities. ## Using the Contract Wizard ### Step 1: Access the Wizard Navigate to [wizard.openzeppelin.com/#erc721](https://wizard.openzeppelin.com/#erc721) ![Contract Wizard](/images/nft-collection4.png) ### Step 2: Select ERC-721 Make sure the **ERC-721** tab is selected. This will create a contract in the [Solidity programming language](https://docs.soliditylang.org/) specifically for non-fungible tokens. ### Step 3: Configure Basic Settings The wizard provides a template contract that you'll customize: **Name**: Give your NFT collection a name (e.g., "Photography") **Symbol**: Choose a short symbol for your collection (e.g., "FOTO") **Base URI**: Paste the metadata folder URL you saved from Pinata Example: `https://gateway.pinata.cloud/ipfs/QmYdWxbiwsfsYcW1CYQPgYujAc9FMLPG3fgFcxFskbSsFa` ![Contract Wizard Populated](/images/nft-collection5.png) ### Step 4: Add Minting Functionality Check the following boxes to add essential features: **Mintable**: Adds a `safeMint` function to create new NFTs **Auto Increment Ids**: Automatically assigns sequential token IDs This will automatically check **Ownable**, which restricts the `safeMint` function to the contract owner. ![Contract Wizard SafeMint](/images/nft-collection6.png) ## Understanding the Generated Contract Let's examine the key parts of your generated contract: ```solidity // SPDX-License-Identifier: MIT pragma solidity ^0.8.20; import "@openzeppelin/contracts/token/ERC721/ERC721.sol"; import "@openzeppelin/contracts/access/Ownable.sol"; contract Photography is ERC721, Ownable { uint256 private _nextTokenId; string private _baseTokenURI; constructor(address initialOwner) ERC721("Photography", "FOTO") Ownable(initialOwner) { _baseTokenURI = "https://gateway.pinata.cloud/ipfs/QmYdWxbiwsfsYcW1CYQPgYujAc9FMLPG3fgFcxFskbSsFa/"; } function _baseURI() internal view override returns (string memory) { return _baseTokenURI; } function safeMint(address to) public onlyOwner { uint256 tokenId = _nextTokenId++; _safeMint(to, tokenId); } } ``` ### Key Components **Inheritance**: Your contract inherits from `ERC721` (the standard) and `Ownable` (access control) **Constructor**: Sets the collection name, symbol, and base URI when deployed **_baseURI()**: Returns the base URI that will be combined with token IDs to fetch metadata **safeMint()**: Creates new NFTs and assigns them sequential IDs The `onlyOwner` modifier means only the contract owner can mint NFTs. For a public mint, you would remove this modifier and add payment logic. ## About the safeMint Function The current `safeMint` function: - Mints one NFT at a time - Can mint to any address (not just the owner's) - Charges no fee (except gas) - Functions as an "airdrop" mechanism This is perfect for: - Personal collections - Gifting NFTs - Controlled distributions - Testing your contract For a public sale, you would modify this function to: - Accept payment (e.g., `payable` with price checks) - Remove the `onlyOwner` modifier - Add supply limits - Implement per-wallet minting limits ## Next Steps Your smart contract is now ready! Click **Open in Remix** at the top of the wizard to prepare for deployment. ![Contract Wizard Open Remix](/images/nft-collection7.png) In the next section, we'll deploy this contract to the Avalanche network and mint your first NFT. # Deploy and Mint Your NFT (/academy/blockchain/nft-deployment/04-deploy-and-mint) --- title: Deploy and Mint Your NFT description: Deploy your ERC-721 contract to Avalanche and mint your first NFT updated: 2024-11-20 authors: [Andrea Vargas, Ash, martineckardt] icon: BookOpen --- Now it's time to deploy your NFT smart contract to the Avalanche network and mint your first NFT! ## Prerequisites Before deploying, ensure you have: ### Core Wallet Extension You'll need the Core browser extension to fund and deploy your contract. If you haven't installed it yet: 1. Download [Core Extension](https://chrome.google.com/webstore/detail/core-crypto-wallet-nft-ex/agoakfejjabomempkjlepdflaleeobhb) 2. Create or import a wallet 3. Enable **Testnet Mode**: - Go to **Settings** → **Advanced** - Turn on **Testnet Mode** - Core will automatically switch to Fuji Testnet ![Settings image 1](/images/nft-collection1.png) ![Settings image 2](/images/nft-collection2.png) **Other Wallets**: If using MetaMask or another wallet, add Fuji Testnet manually: - **Network Name**: Avalanche Fuji C-Chain - **RPC URL**: `https://api.avax-test.network/ext/bc/C/rpc` - **Chain ID**: `43113` - **Symbol**: AVAX - **Explorer**: `https://testnet.snowtrace.io` ### Testnet AVAX You'll need AVAX on the Fuji testnet to pay for gas fees. **Option 1 (Recommended)**: - Create a [Builder Hub account](https://build.avax.network/login) - Connect your wallet to receive testnet AVAX automatically **Option 2**: - Use the [Avalanche Faucet](https://core.app/tools/testnet-faucet/) - If you have AVAX on Mainnet, paste your C-Chain address and request test tokens - Otherwise, request a faucet coupon on [Guild](https://guild.xyz/avalanche) ![Avalanche Faucet](/images/nft-collection3.png) ## Deploying with Remix IDE [Remix IDE](https://remix.ethereum.org/) is a browser-based Solidity compiler that makes it easy to compile and deploy smart contracts without installing any software. ### Step 1: Compile Your Contract After importing your contract from OpenZeppelin Wizard: 1. Click the **Compile** button on the left sidebar (or press `Ctrl/Cmd + S`) 2. Wait for the green checkmark to appear ![Remix Compile](/images/nft-collection8.png) You may see options to "Publish on IPFS" or "Publish on Swarm" - these aren't necessary for this tutorial. ### Step 2: Configure Deployment 1. Click the **Deploy & Run Transactions** tab (bottom icon on left sidebar) ![Remix Deploy Page](/images/nft-collection9.png) 2. Change the **Environment** dropdown to **Injected Provider - MetaMask** ![Remix Web3](/images/nft-collection10.png) 3. Core will prompt you to connect - approve the connection 4. Verify the connection by checking that the **Account** matches your Core address ![Remix account](/images/nft-collection11.png) ![Core account](/images/nft-collection12.png) ### Step 3: Select Your Contract In the **Contract** dropdown, select your contract (it will have the name you gave it in the wizard). ![Remix Contract](/images/nft-collection13.png) ### Step 4: Deploy 1. Click the orange **Deploy** button 2. Core will open and ask you to confirm the transaction 3. Review the gas fee and click **Confirm** ![Core Accept](/images/nft-collection14.png) 4. Wait for the transaction to be confirmed Your deployed contract will appear under **Deployed Contracts**: ![Remix Record](/images/nft-collection15.png) ### Step 5: Verify on Snowtrace 1. Copy your contract address from Remix 2. Open [Snowtrace Testnet Explorer](https://testnet.snowtrace.io/) 3. Paste the address in the search bar You'll see your contract information, including the deployment transaction: ![Snowtrace](/images/nft-collection16.png) ## Minting Your First NFT Now that your contract is deployed, let's mint an NFT! ### Step 1: Access the safeMint Function 1. In Remix, expand your deployed contract 2. You'll see a list of available functions ![Remix Functions](/images/nft-collection17.png) 3. Click the dropdown arrow next to **safeMint** to expand it ![safeMint function](/images/nft-collection18.png) ### Step 2: Mint to Your Address 1. Copy your Core wallet address 2. Paste it into the `to` address field 3. Click the orange **transact** button You can mint to any address, not just your own. This is useful for gifting NFTs or airdrops! 4. Confirm the transaction in Core 5. Wait for the green checkmark in the Remix terminal ![Remix Confirm Mint](/images/nft-collection19.png) ### Step 3: Verify the Mint 1. Return to your contract page on Snowtrace 2. Refresh the page 3. You should see a new transaction for `safeMint` ![Snowtrace Mint](/images/nft-collection20.png) 4. Click on the [TX Hash](https://testnet.snowtrace.io/tx/0x8b698ac72bd20b2a640167c5d9bacdcbb3d86fd696eb8cde6f28347f6f99a2c9) to view details ![Snowtrace Transaction](/images/nft-collection21.png) Congratulations! You've successfully minted your first NFT! 🎉 ## Viewing Your NFT Your NFT is now: - Recorded on the Avalanche blockchain - Owned by your wallet address - Linked to your metadata and image on IPFS You can view it: - On Snowtrace (under the "Token Transfers" tab) - In your Core wallet (NFT section) - On NFT marketplaces that support Avalanche testnet ## Deploying to Mainnet When you're ready to launch your project on Mainnet, the process is identical except: 1. **Switch to Mainnet**: Disable Testnet Mode in Core 2. **Get Real AVAX**: You'll need actual AVAX to pay for gas fees 3. **Use Mainnet Snowtrace**: View transactions at [snowtrace.io](https://snowtrace.io/) 4. **List on Marketplaces**: Your NFTs can be listed on platforms like [Joepegs](https://joepegs.com/) **Before Mainnet Deployment**: - Thoroughly test your contract on testnet - Consider a professional audit for valuable collections - Ensure your IPFS files are permanently pinned - Have a clear minting strategy and pricing ## Next Steps Now that you've deployed and minted your NFT, you might want to: - Mint additional NFTs from your collection - Learn about token URIs and metadata standards - Explore advanced features like royalties and allowlists - Build a custom minting dApp for your collection In the next section, we'll dive deeper into how token URIs work and how your NFTs connect to their metadata. # Understanding Token URIs (/academy/blockchain/nft-deployment/05-token-uris) --- title: Understanding Token URIs description: Learn how NFTs connect to their metadata and images updated: 2024-11-20 authors: [Andrea Vargas, Ash, martineckardt] icon: BookOpen --- Now that you've deployed your NFT collection, let's understand how your on-chain tokens connect to their off-chain metadata and images through **Token URIs**. ## What is a Token URI? A Token URI (Uniform Resource Identifier) is a unique string that points to a JSON file containing an NFT's metadata. This metadata includes: - The NFT's name - Description - Image URL - Attributes/traits - Other properties ## How Token URIs Work When you call `tokenURI(tokenId)` on an ERC-721 contract, it returns a complete URL by combining: ``` Base URI + Token ID = Token URI ``` ### Example If your base URI is: ``` https://gateway.pinata.cloud/ipfs/QmYdWxbiwsfsYcW1CYQPgYujAc9FMLPG3fgFcxFskbSsFa/ ``` And you query token ID `0`, the contract returns: ``` https://gateway.pinata.cloud/ipfs/QmYdWxbiwsfsYcW1CYQPgYujAc9FMLPG3fgFcxFskbSsFa/0 ``` This URL points to your metadata file on IPFS. ## The Metadata Standard The JSON file at the Token URI follows the [OpenSea Metadata Standard](https://docs.opensea.io/docs/metadata-standards): ```json { "name": "Cool Photography #0", "description": "A cool image from my photography collection", "image": "https://gateway.pinata.cloud/ipfs/QmPWbixyMsaNkR9v612bBFbncKGmgXDKz9CgMtDDD7Bymw/0.png", "attributes": [ { "trait_type": "Background", "value": "Blue" }, { "trait_type": "Style", "value": "Abstract" } ] } ``` ### Metadata Fields **name**: The NFT's display name (often includes the token ID) **description**: A detailed description of the NFT **image**: The URL to the actual image file (also on IPFS) **attributes**: An array of traits that define the NFT's characteristics ## Why Use IPFS? IPFS (InterPlanetary File System) is preferred for NFT storage because: **Decentralized**: No single point of failure **Content-Addressed**: Files are identified by their content, not location **Permanent**: Files remain accessible as long as they're pinned **Immutable**: Content can't be changed without changing the hash ### IPFS URLs IPFS URLs follow this format: ``` https://gateway.pinata.cloud/ipfs/[CONTENT_HASH]/[FILE_NAME] ``` The content hash (e.g., `QmYdWxbiwsfsYcW1CYQPgYujAc9FMLPG3fgFcxFskbSsFa`) uniquely identifies your folder on IPFS. ## URI Storage in Your Contract In your OpenZeppelin contract, the base URI is stored and accessed like this: ```solidity contract Photography is ERC721, Ownable { string private _baseTokenURI; constructor(address initialOwner) ERC721("Photography", "FOTO") Ownable(initialOwner) { _baseTokenURI = "https://gateway.pinata.cloud/ipfs/QmYdWxbiwsfsYcW1CYQPgYujAc9FMLPG3fgFcxFskbSsFa/"; } function _baseURI() internal view override returns (string memory) { return _baseTokenURI; } function tokenURI(uint256 tokenId) public view virtual override returns (string memory) { require(_exists(tokenId), "Token does not exist"); return string(abi.encodePacked(_baseURI(), Strings.toString(tokenId))); } } ``` ### How It Works 1. `tokenURI()` is called with a token ID 2. The function checks if the token exists 3. It concatenates the base URI with the token ID 4. Returns the complete URL to the metadata ## Advanced URI Features ### URI Storage Extension OpenZeppelin provides a `ERC721URIStorage` extension that allows setting individual URIs for each token: ```solidity import "@openzeppelin/contracts/token/ERC721/extensions/ERC721URIStorage.sol"; contract MyNFT is ERC721URIStorage { function mint(address to, uint256 tokenId, string memory uri) public { _safeMint(to, tokenId); _setTokenURI(tokenId, uri); } } ``` This is useful when: - Each NFT has a completely different metadata structure - You want to update metadata after minting - Your collection doesn't follow a sequential pattern ### Updating Base URI You might want to update the base URI after deployment to: - Move to a different IPFS gateway - Migrate to a custom domain - Update to revealed metadata (for mystery drops) Add this function to your contract: ```solidity function setBaseURI(string memory newBaseURI) public onlyOwner { _baseTokenURI = newBaseURI; } ``` Be cautious when updating URIs. Changing metadata after minting can be controversial and may affect trust in your collection. ## Best Practices ### 1. Consistent File Naming Ensure your metadata files are named to match token IDs: - Token 0 → file named `0` - Token 1 → file named `1` - And so on... ### 2. Include Trailing Slash Always include a trailing slash in your base URI: ``` ✅ https://gateway.pinata.cloud/ipfs/QmHash/ ❌ https://gateway.pinata.cloud/ipfs/QmHash ``` ### 3. Test Before Minting Before minting, manually test your URIs: ``` Base URI + 0 should return valid JSON Base URI + 1 should return valid JSON ``` ### 4. Pin Your Files Ensure your files are permanently pinned on IPFS. Services like Pinata provide pinning to prevent garbage collection. ### 5. Use IPFS Gateways Wisely While Pinata's gateway works well, consider: - Using multiple gateways for redundancy - Setting up your own IPFS node for large collections - Using a CDN for faster loading ## Viewing Token URIs You can view your NFT's token URI in several ways: ### 1. Remix IDE In your deployed contract, call `tokenURI` with a token ID: ```solidity tokenURI(0) // Returns the full URI for token 0 ``` ### 2. Snowtrace On your contract page, go to "Read Contract" and call `tokenURI`. ### 3. Programmatically Using ethers.js: ```javascript const tokenURI = await contract.tokenURI(0); console.log(tokenURI); ``` ## Common Issues ### "Token does not exist" This error means you're querying a token ID that hasn't been minted yet. ### 404 Not Found If the URI returns 404: - Check that your metadata files are uploaded to IPFS - Verify the file names match token IDs - Ensure the base URI has a trailing slash ### Invalid JSON If marketplaces can't read your metadata: - Validate your JSON syntax - Ensure all required fields are present - Check that the file has no extension ## Next Steps Now that you understand how token URIs work, you're ready to: - Create larger NFT collections with multiple tokens - Implement reveal mechanisms for mystery drops - Build custom metadata structures for your use case - Integrate your NFTs with marketplaces and dApps Congratulations on completing the NFT Deployment course! You now have the knowledge to create, deploy, and manage your own NFT collections on Avalanche. # Welcome to NFT Deployment (/academy/blockchain/nft-deployment) --- title: Welcome to NFT Deployment description: Learn how to create, prepare, and deploy your own NFT collection on Avalanche updated: 2024-11-20 authors: [Andrea Vargas, Ash, martineckardt] icon: Smile --- In this course, you will learn how to deploy your own NFT (Non-Fungible Token) collection on the Avalanche network. ## Why Take This Course? NFTs have revolutionized digital ownership, enabling creators to tokenize unique digital assets like art, collectibles, and more. This course will guide you through the entire process of creating and deploying an NFT collection, from understanding the ERC-721 standard to preparing your files and deploying your smart contract. ## Course Content ### ERC-721 Token Standard Learn about the ERC-721 standard, the foundation for non-fungible tokens, and understand how it differs from fungible tokens like ERC-20. ### Preparing NFT Files Discover how to prepare your NFT images and metadata files, and upload them to IPFS using Pinata for decentralized storage. ### Creating the Smart Contract Use OpenZeppelin's Contract Wizard to generate a customized ERC-721 smart contract for your NFT collection. ### Deploying on Avalanche Deploy your NFT collection to the Avalanche C-Chain using Remix IDE and mint your first NFT. ### Understanding Token URIs Learn how token URIs work and how they connect your on-chain NFTs to their off-chain metadata and images. ## Prerequisites ### Blockchain / Web3 This course is meant for people with some experience in web3. You should be familiar with: - **Wallets**: What they are and how to create one - **dApps**: What a decentralized application is and how to interact with one - **Transactions**: How to send and confirm blockchain transactions If any of this is unclear, we strongly recommend taking the Blockchain Fundamentals course first. ### Software Development You will need a general understanding of software development: - **Programming**: Familiarity with basic programming concepts like variables, functions, and data structures - **Solidity Basics**: Understanding of smart contracts (covered in the Intro to Solidity course) - **IDE**: Familiarity with web-based development tools like Remix ## Learning Outcomes By the end of this course, you will be able to: - Understand the ERC-721 token standard and how NFTs work - Prepare and upload NFT files to IPFS using Pinata - Create a customized ERC-721 smart contract using OpenZeppelin - Deploy your NFT collection to Avalanche C-Chain - Mint NFTs from your deployed contract - Understand token URIs and metadata standards - View your NFTs on blockchain explorers ## Tools You'll Use - **Pinata**: For storing NFT images and metadata on IPFS - **OpenZeppelin Wizard**: To generate your ERC-721 smart contract - **Remix IDE**: To compile and deploy your contract - **Core Wallet**: To manage transactions and pay gas fees - **Snowtrace**: To view your deployed contract and transactions # Welcome to the course (/academy/blockchain/solidity-foundry) --- title: Welcome to the course description: Learn the basics about programming Smart Contracts in Solidity for an EVM Blockchain updated: 2024-05-31 authors: [Andrea Vargas] icon: Smile --- In this course, you will learn how to build Solidity dApps on Avalanche. ## Why Take This Course? A significant innovation in blockchain is the development of multi-chain systems, like Avalanche, which provide a significant improvement in scalability, interoperability, and flexibility. While a blockchain on Avalanche can be run with any VM, the most prominent choice currently is the Ethereum Virtual Machine (EVM). Users can deploy their own logic in the form of smart contracts to the EVM. These smart contracts can be written in Solidity. Learning Solidity can enable you to leverage the features of blockchain for your dApp. ## Course Content ### Smart Contracts In the first section, we will look at what smart contracts are, their basic structure and how they work. ### Hello World Part I In this section we will look at the primitive types (strings, integers, bool, ...) and function as well as the Solidity file structure. ### Hello World Part II We will look at control flows (if & else), data structures and constructors. Furthermore, we learn about inheritance from other contracts and modifiers and events. ### Contract Standardization You will learn how contracts can be standardized and how inheritance and interfaces can help us to do so. ## Prerequisites ### Blockchain / Web3 This course is meant for people with a some experience when it comes to web3. You should be familiar with these concepts: - Wallet: What they are and how to create one - dApp: What a decentralized application is and how to interact with one If any of this is unclear, we strongly recommend taking the Avalanche Fundamentals and Subnet Architecture courses first, that give a soft introduction into these topics from a user stand point. ### Software Development You will need a general understanding of Software Development. Therefore, we recommend: - Programming: Familiarity with most basic concepts of programming, such as variables, control flows (if, else) and loops. All exercises will consist of writing small contracts in Solidity. - IDE: It will help if you're generally familiar with the concept of an integrated developer environment. We will be leveraging Remix. ## Learning Outcomes By the end of this course, students will: - Interact and Deploy contracts using Foundry - Get familiar with ERC20 and ERC721 token standards - Understand important concepts such as inheritance, modifiers, and events. - Apply their knowledge by building their own smart contracts. # Course Completion Certificate (/academy/blockchain/x402-payment-infrastructure/get-certificate) --- title: Course Completion Certificate updated: 2025-11-03 authors: [Federico Nardelli] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; Congratulations! You've completed the x402 Payment Infrastructure course. Let's verify your progress and get your certificate. Thank you for taking this course! You now have the knowledge to build instant, permissionless payment infrastructure on Avalanche using the x402 protocol. We hope you'll use what you've learned to create innovative payment-enabled applications and contribute to the future of machine-to-machine commerce. # Welcome to the Course (/academy/blockchain/x402-payment-infrastructure) --- title: Welcome to the Course description: Learn about the x402 protocol for instant, permissionless HTTP-native payments on Avalanche. updated: 2025-11-03 authors: [Federico Nardelli] icon: Coins --- ## Why Take This Course? The x402 protocol is revolutionizing how payments work on the internet by activating HTTP 402 "Payment Required" status code for instant, permissionless transactions. Built on blockchain technology, x402 enables seamless machine-to-machine payments, making it perfect for AI agents, micropayments, and API monetization. Traditional payment systems are slow, expensive, and require accounts, KYC, and complex integrations. x402 eliminates these friction points with 2-second settlement times, zero protocol fees, and no account requirements. Payments are gasless for end users—facilitators sponsor the minimal blockchain gas fees (~\$0.001 on Avalanche with current network conditions). For developers building on Avalanche, x402 leverages the network's low fees and fast finality to create an ideal environment for high-frequency micropayments. ## Course Content - [Introduction to x402](/academy/blockchain/x402-payment-infrastructure/02-introduction/01-what-is-x402) - [Technical Architecture](/academy/blockchain/x402-payment-infrastructure/03-technical-architecture/01-payment-flow) - [x402 on Avalanche](/academy/blockchain/x402-payment-infrastructure/04-x402-on-avalanche/01-why-avalanche) ## Prerequisites Before taking this course, you should have: - **Blockchain Fundamentals:** Basic understanding of blockchain technology and how transactions work. - **Avalanche Fundamentals:** Familiarity with the Avalanche network, particularly the C-Chain. - **HTTP/APIs:** Understanding of HTTP protocols, status codes, and API development. - **Programming:** Basic knowledge of JavaScript/TypeScript or another programming language. - **Smart Contracts (Optional):** Helpful but not required for understanding payment verification. ## Learning Outcomes By the end of this course, you will: - Understand the x402 protocol and how it activates HTTP 402 for internet-native payments. - Learn the complete payment flow from request to settlement, including facilitator roles. - Discover why Avalanche is ideal for x402 implementations with its low fees and fast finality. - Explore different x402 facilitator implementations available on Avalanche (Thirdweb, PayAI, Ultravioleta DAO, x402-rs). - Implement x402 middleware in your own applications and configure endpoint pricing. - Build use cases for AI agent payments, micropayments, and API monetization. - Master security best practices and scaling considerations for production deployments. # Course Completion Certificate (/academy/entrepreneur/foundations-web3-venture/certificate) --- title: Course Completion Certificate updated: 2025-09-05 authors: [nicolasarnedo] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course! Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Entrepreneur Academy (/academy/entrepreneur/foundations-web3-venture) --- title: Entrepreneur Academy description: Building a Successful Web3 Startup updated: 2025-07-31 authors: [nicolasarnedo] icon: Smile --- ## Level 1: Foundations of a Web3 Venture (Module 1 - 3) These three modules are designed to give you a strong foundation for building and scaling your startup with confidence. You’ll begin by setting up your company on solid ground, mastering the essential legal, financial, compliance, and security principles that safeguard your business. From there, you’ll learn to shape and refine your vision through the Business Model Canvas, ensuring your strategy is both sustainable and customer-focused. Finally, you’ll dive deep into understanding the people who matter most—your stakeholders and users—by identifying their needs, creating personas, and translating insights into impactful solutions. Together, these modules equip you with the practical tools to launch, grow, and sustain a successful venture. # Course Completion Certificate (/academy/entrepreneur/fundraising-finance/certificate) --- title: Course Completion Certificate updated: 2025-09-05 authors: [nicolasarnedo] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course! Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to the Course (/academy/entrepreneur/fundraising-finance) --- title: Welcome to the Course description: Building a Successful Web3 Startup — Navigating Avalanche Foundation Grants updated: 2025-07-31 authors: [nicolasarnedo] icon: Smile --- ## Level 4: Fundraising and Finance Pro (Module 9-11) These modules focus on preparing you to secure the resources and relationships that fuel startup growth. You’ll start by exploring best practices for engaging with VCs and designing equity incentive plans that both attract top talent and align stakeholder interests. From there, you’ll learn how to identify, apply for, and secure grants that provide vital funding to support your mission and impact. Finally, you’ll master the art of fundraising through powerful pitch decks, compelling storytelling, and proven presentation techniques that set you up for successful campaigns. Together, these modules equip you with the skills and strategies to confidently navigate the fundraising landscape and build lasting investor relationships. # Course Completion Certificate (/academy/entrepreneur/go-to-market/certificate) --- title: Course Completion Certificate updated: 2025-09-05 authors: [nicolasarnedo] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course! Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to Go-to-Market Strategies (/academy/entrepreneur/go-to-market) --- title: Welcome to Go-to-Market Strategies description: Master go-to-market strategies, sales, and pricing for your Web3 startup updated: 2025-01-31 authors: [nicolasarnedo] icon: Smile --- ## Level 2: Go-To-Market Strategist (Module 4 - 6) These modules focus on turning opportunities into tangible growth by sharpening your sales and go-to-market skills. You’ll start by learning how to generate quality leads and spot the signals that indicate real potential, ensuring your efforts are targeted where they matter most. Next, you’ll master sales and messaging techniques to craft value propositions that resonate, connect authentically with your audience, and convert leads into lasting customer relationships. Finally, you’ll develop pricing strategies that not only reflect the true value of your product but also drive sustainable growth and align with your market. Together, these modules equip you to build a sales engine that accelerates your startup’s success. # Course Completion Certificate (/academy/entrepreneur/web3-community-architect/certificate) --- title: Course Completion Certificate updated: 2025-09-05 authors: [nicolasarnedo] icon: BadgeCheck --- import CertificatePage from '@/components/quizzes/certificates'; You've made it to the end of the course! Let's check your progress and get your certificate. Thank you for participating in this course. We hope you found it informative and enjoyable! # Welcome to Web3 Community Architecture (/academy/entrepreneur/web3-community-architect) --- title: Welcome to Web3 Community Architecture description: Master the art of building and nurturing thriving Web3 communities that drive adoption and growth updated: 2025-07-31 authors: [nicolasarnedo] icon: Smile --- ## Level 3: Web3 Community Architect (Module 7 and 8) These modules are designed to help you amplify your startup’s reach, build lasting relationships, and explore innovative growth models. You’ll begin by discovering how to cultivate and leverage engaged communities that fuel loyalty, advocacy, and long-term impact. Next, you’ll learn to harness the power of social media and events strategically—strengthening your brand, deepening audience engagement, and creating momentum for growth. Finally, you’ll dive into the principles of token design, exploring economic models and distribution strategies that enable fair, effective, and sustainable ecosystems. Together, these modules equip you with the tools to grow your startup’s presence, influence, and value. # Features (/academy/avalanche-l1/avacloudapis/02-overview/01-about) --- title: Features description: Learn about the features of the AvaCloud API. updated: 2024-09-03 authors: [owenwahlgren] icon: Book --- ## What is the Data API? The Data API provides web3 application developers with multi-chain data related to Avalanche’s primary network, Avalanche L1s, and Ethereum. With the Data API, you can easily build products that leverage real-time and historical transaction and transfer history, native and token balances, and various types of token metadata. ### Data API Features - **Extensive L1 Support**: Gain access to data from over 100+ L1s across both mainnet and testnet. If an L1 is listed on the [Avalanche Explorer](https://subnets.avax.network/stats/), you can query its data using the Data API. - **Transactions and UTXOs**: Easily retrieve details related to transactions, UTXOs, and token transfers from Avalanche EVMs, Ethereum, and Avalanche’s Primary Network (P-Chain, X-Chain and C-Chain). - **Blocks**: Retrieve latest blocks and block details - **Balances**: Fetch balances of native, ERC-20, ERC-721, and ERC-1155 tokens along with relevant metadata. - **Tokens**: Augment your user experience with asset details. - **Staking**: Get staking related data for active and historical validations. ## What is the Metrics API? The Metrics API equips web3 developers with a robust suite of tools to access and analyze on-chain activity across Avalanche’s primary network, Avalanche L1s, and other supported EVM chains. This API delivers comprehensive metrics and analytics, enabling you to seamlessly integrate historical data on transactions, gas consumption, throughput, staking, and more into your applications. The Metrics API, along with the Data API are the driving force behind every graph you see on the [Avalanche Explorer](https://subnets.avax.network/stats/). From transaction trends to staking insights, the visualizations and data presented are all powered by these APIs, offering real-time and historical insights that are essential for building sophisticated, data-driven blockchain products. ### Metrics API Features - **Chain Throughput**: Retrieve detailed metrics on gas consumption, Transactions Per Second (TPS), and gas prices, including rolling windows of data for granular analysis. - **Cumulative Metrics**: Access cumulative data on addresses, contracts, deployers, and transaction counts, providing insights into network growth over time. - **Staking Information**: Obtain staking-related data, including the number of validators and delegators, along with their respective weights, across different L1s. - **Blockchains and L1s**: Get information about supported blockchains, including EVM Chain IDs, blockchain IDs, and L1s associations, facilitating multi-chain analytics. - **Composite Queries**: Perform advanced queries by combining different metric types and conditions, enabling detailed and customizable data retrieval. ## What is the AvaCloudSDK? The [AvaCloud SDK](https://developers.avacloud.io/avacloud-sdk/getting-started) provides web3 application developers with multi-chain data related to Avalanche’s primary network, Avalanche L1s, and Ethereum. With the Data API, you can easily build products that leverage real-time and historical transaction and transfer history, native and token balances, and various types of token metadata. The SDK is currently available in TypeScript, with more languages coming soon. If you are interested in a language that is not listed, please reach out to us in the [`#dev-tools`](https://discord.com/login?redirect_to=%2Flogin%3Fredirect_to%3D%252Fchannels%252F578992315641626624%252F1280920394236297257) channel in the [Avalanche Discord](https://discord.com/invite/avax). # APIs vs RPCs (/academy/avalanche-l1/avacloudapis/02-overview/02-apis-vs-rpc) --- title: APIs vs RPCs description: Learn how the AvaCloud Data API differs from RPC calls updated: 2024-09-03 authors: [owenwahlgren] icon: Book --- Blockchain RPCs and APIs both facilitate interactions with a network, but they differ significantly in how they operate. ### RPCs **Blockchain RPCs** allow you to communicate directly with a blockchain node, performing tasks like querying data or submitting transactions. These are low-level, synchronous calls, requiring a deep understanding of the blockchain's structure and specific commands. To get a more comprehensive understanding of Ethereum's JSON-RPC API, you can refer to the [official Ethereum documentation](https://ethereum.org/en/developers/docs/apis/json-rpc/). ### APIs **Blockchain APIs**, like the AvaCloud Data API, abstract away much of the complexity. They offer higher-level, user-friendly endpoints that streamline interactions, making it easier to build and manage blockchain applications without needing in-depth knowledge of the underlying blockchain protocols. To get a more comprehensive understanding of the AvaCloud Data API, you can refer to the [official AvaCloud Data API documentation](https://developers.avacloud.io/data-api/overview). ### Example Use Case For example, querying a user's ERC-20 portfolio using an RPC involves a series of complex calls to retrieve and parse raw blockchain data. Using just RPCs, you would need to: 1. Query every block on the network for transaction logs. 2. Parse each transaction log to identify ERC-20 token transfers. 3. Extract the ERC-20 token contract address. 4. For each ERC-20 token contract, query the user's address to get the balance. 5. Parse and aggregate the data to present the user's portfolio. While it may seem simple in theory, this process can be time-consuming and error-prone, especially when dealing with multiple blockchains. With the AvaCloud Data API, you could simply use a dedicated endpoint such as: ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/balances:listErc20 \ --header 'x-glacier-api-key: ' ``` to get a neatly formatted response with the user's ERC-20 portfolio, significantly reducing development time and complexity. ```json { "nextPageToken": "", "erc20TokenBalances": [ { "address": "0x71C7656EC7ab88b098defB751B7401B5f6d8976F", "name": "Wrapped AVAX", "symbol": "WAVAX", "decimals": 18, "logoUri": "https://images.ctfassets.net/gcj8jwzm6086/5VHupNKwnDYJvqMENeV7iJ/fdd6326b7a82c8388e4ee9d4be7062d4/avalanche-avax-logo.svg", "ercType": "ERC-20", "price": { "currencyCode": "usd", "value": "42.42" }, "chainId": "43114", "balance": "2000000000000000000", "balanceValue": { "currencyCode": "usd", "value": "42.42" } } ] } ``` # Data API (/academy/avalanche-l1/avacloudapis/02-overview/03-dataapi-endpoints) --- title: Data API description: Learn about AvaCloud Data API. updated: 2024-09-03 authors: [owenwahlgren] icon: Book --- ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/glacier-data-api-7knGxPQ6gpsJcZehfeZVYcRUAr6u1l.png) The AvaCloud Data API provides a comprehensive set of endpoints to interact with Avalanche networks. These endpoints allow you to query information about blocks, transactions, assets, and more. Below are some of the key endpoints available in the Data API. A more comprehensive list of Data API endpoints can be found [here](https://developers.avacloud.io/data-api/overview). ## Data API Reference ### EVM Endpoints - [List All Chains](https://developers.avacloud.io/data-api/evm-chains/list-chains) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains \ --header 'accept: application/json' ``` - [Get Chain Information](https://developers.avacloud.io/data-api/evm-chains/get-chain-information) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId} \ --header 'accept: application/json' ``` - [List Latest Blocks](https://developers.avacloud.io/data-api/evm-chains/list-latest-blocks) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/blocks \ --header 'accept: application/json' ``` - [Get Block Information](https://developers.avacloud.io/data-api/evm-chains/getblock) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/blocks/{blockId} \ --header 'accept: application/json' ``` - [Get Deployment Transaction](https://developers.avacloud.io/data-api/evm-transactions/get-deployment-transaction) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/contracts/{address}/transactions:getDeployment \ --header 'accept: application/json' ``` - [List Deployed Contracts](https://developers.avacloud.io/data-api/evm-transactions/list-deployed-contracts) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/contracts/{address}/deployments \ --header 'accept: application/json' ``` - [List ERC Transfers](https://developers.avacloud.io/data-api/evm-transactions/list-erc-transfers) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/tokens/{address}/transfers \ --header 'accept: application/json' ``` - [List Transactions](https://developers.avacloud.io/data-api/evm-transactions/list-transactions) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/transactions \ --header 'accept: application/json' ``` - [List Native Transactions](https://developers.avacloud.io/data-api/evm-transactions/list-native-transactions) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/transactions:listNative \ --header 'accept: application/json' ``` - [List ERC-20 Transfers](https://developers.avacloud.io/data-api/evm-transactions/list-erc-20-transfers) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/transactions:listErc20 \ --header 'accept: application/json' ``` - [List ERC-721 Transfers](https://developers.avacloud.io/data-api/evm-transactions/list-erc-721-transfers) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/transactions:listErc721 \ --header 'accept: application/json' ``` - [List ERC-1155 Transfers](https://developers.avacloud.io/data-api/evm-transactions/list-erc-1155-transfers) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/transactions:listErc1155 \ --header 'accept: application/json' ``` - [List Internal Transactions](https://developers.avacloud.io/data-api/evm-transactions/list-internal-transactions) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/transactions:listInternals \ --header 'accept: application/json' ``` - [Get Transaction](https://developers.avacloud.io/data-api/evm-transactions/get-transaction) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/transactions/{txHash} \ --header 'accept: application/json' ``` - [List Transactions For a Block](https://developers.avacloud.io/data-api/evm-transactions/list-transactions-for-a-block) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/blocks/{blockId}/transactions \ --header 'accept: application/json' ``` - [List Latest Transactions](https://developers.avacloud.io/data-api/evm-transactions/list-latest-transactions) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/transactions \ --header 'accept: application/json' ``` - [Get Native Token Balance](https://developers.avacloud.io/data-api/evm-balances/get-native-token-balance) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/balances:getNative \ --header 'accept: application/json' ``` - [List ERC-20 Balances](https://developers.avacloud.io/data-api/evm-balances/list-erc-20-balances) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/balances:listErc20 \ --header 'accept: application/json' ``` - [List ERC-721 Balances](https://developers.avacloud.io/data-api/evm-balances/list-erc-721-balances) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/balances:listErc721 \ --header 'accept: application/json' ``` - [List ERC-1155 Balances](https://developers.avacloud.io/data-api/evm-balances/list-erc-1155-balances) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/balances:listErc1155 \ --header 'accept: application/json' ``` - [List Collectible (ERC-721 and ERC-1155) Balances](https://developers.avacloud.io/data-api/evm-balances/list-collectible-erc-721erc-1155-balances) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address}/balances:listCollectibles \ --header 'accept: application/json' ``` - [Get Contract Metadata](https://developers.avacloud.io/data-api/evm-contracts/get-contract-metadata) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/addresses/{address} \ --header 'accept: application/json' ``` - [Reindex NFT Metadata](https://developers.avacloud.io/data-api/nfts/reindex-nft-metadata) ```bash curl --request POST \ --url https://glacier-api.avax.network/v1/chains/{chainId}/nfts/collections/{address}/tokens/tokenId:reindex \ --header 'accept: application/json' ``` - [List Tokens](https://developers.avacloud.io/data-api/nfts/list-tokens) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/nfts/collections/{address}/tokens \ --header 'accept: application/json' ``` - [Get Token Details](https://developers.avacloud.io/data-api/nfts/get-token-details) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/chains/{chainId}/nfts/collections/{address}/tokens/tokenId \ --header 'accept: application/json' ``` ### Avalanche Primary Network Endpoints - [Get Chain Interactions for Addresses](https://developers.avacloud.io/data-api/primary-network/get-chain-interactions-for-addresses) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/{network}/addresses:listChainIds \ --header 'accept: application/json' ``` - [Get Network Details](https://developers.avacloud.io/data-api/primary-network/get-network-details) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/{network} \ --header 'accept: application/json' ``` - [List Blockchains](https://developers.avacloud.io/data-api/primary-network/list-blockchains) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/{network}/blockchains \ --header 'accept: application/json' ``` - [List Subnets](https://developers.avacloud.io/data-api/primary-network/list-subnets) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/subnets \ --header 'accept: application/json' ``` - [Get Subnet Details by ID](https://developers.avacloud.io/data-api/primary-network/get-subnet-details-by-id) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/subnets/{subnetId} \ --header 'accept: application/json' ``` - [List Validators](https://developers.avacloud.io/data-api/primary-network/list-validators) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/validators \ --header 'accept: application/json' ``` - [Get Single Validator Details](https://developers.avacloud.io/data-api/primary-network/get-single-validator-details) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/validators/{nodeId} \ --header 'accept: application/json' ``` - [List Delegators](https://developers.avacloud.io/data-api/primary-network/list-delegators) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/delegators \ --header 'accept: application/json' ``` - [Get Block](https://developers.avacloud.io/data-api/primary-network-blocks/get-block) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/11111111111111111111111111111111LpoYY/blocks/{blockId} \ --header 'accept: application/json' ``` - [List Blocks Proposed by Node](https://developers.avacloud.io/data-api/primary-network-blocks/list-blocks-proposed-by-node) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/11111111111111111111111111111111LpoYY/nodes/{nodeId}/blocks \ --header 'accept: application/json' ``` - [List Latest Blocks](https://developers.avacloud.io/data-api/primary-network-blocks/list-latest-blocks) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/11111111111111111111111111111111LpoYY/blocks \ --header 'accept: application/json' ``` - [List Vertices](https://developers.avacloud.io/data-api/primary-network-vertices/list-vertices) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/2oYMBNV4eNHyqk2fjjV5nVQLDbtmNJzq5s3qs3Lo6ftnC6FByM/vertices \ --header 'accept: application/json' ``` - [Get Vertex](https://developers.avacloud.io/data-api/primary-network-vertices/get-vertex) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/2oYMBNV4eNHyqk2fjjV5nVQLDbtmNJzq5s3qs3Lo6ftnC6FByM/vertices/vertexHash \ --header 'accept: application/json' ``` - [List Vertices by Height](https://developers.avacloud.io/data-api/primary-network-vertices/list-vertices-by-height) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/2oYMBNV4eNHyqk2fjjV5nVQLDbtmNJzq5s3qs3Lo6ftnC6FByM/vertices:listByHeight \ --header 'accept: application/json' ``` - [Get Transaction](https://developers.avacloud.io/data-api/primary-network-transactions/get-transaction) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/{network}/blockchains/{blockchainId}/transactions/{txHash} \ --header 'accept: application/json' ``` - [List Latest Transactions](https://developers.avacloud.io/data-api/primary-network-transactions/list-latest-transactions) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/{network}/blockchains/{blockchainId}/transactions \ --header 'accept: application/json' ``` - [List Staking Transactions](https://developers.avacloud.io/data-api/primary-network-transactions/list-staking-transactions) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/11111111111111111111111111111111LpoYY/transactions:listStaking \ --header 'accept: application/json' ``` - [List Asset Transactions](https://developers.avacloud.io/data-api/primary-network-transactions/list-asset-transactions) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/2oYMBNV4eNHyqk2fjjV5nVQLDbtmNJzq5s3qs3Lo6ftnC6FByM/assets/{assetId}/transactions \ --header 'accept: application/json' ``` - [List UTXOs](https://developers.avacloud.io/data-api/primary-network-utxos/list-utxos) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/11111111111111111111111111111111LpoYY/utxos \ --header 'accept: application/json' ``` - [Get Balances](https://developers.avacloud.io/data-api/primary-network-balances/get-balances) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/11111111111111111111111111111111LpoYY/balances \ --header 'accept: application/json' ``` - [List Pending Rewards](https://developers.avacloud.io/data-api/primary-network-rewards/list-pending-rewards) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/rewards:listPending \ --header 'accept: application/json' ``` - [List Historical Rewards](https://developers.avacloud.io/data-api/primary-network-rewards/list-historical-rewards) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/rewards \ --header 'accept: application/json' ``` - [Get Asset Details](https://developers.avacloud.io/data-api/primary-network/get-asset-details) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/networks/mainnet/blockchains/2oYMBNV4eNHyqk2fjjV5nVQLDbtmNJzq5s3qs3Lo6ftnC6FByM/assets/{assetId} \ --header 'accept: application/json' ``` # Webhooks API (/academy/avalanche-l1/avacloudapis/02-overview/04-webhooks) --- title: Webhooks API description: Learn about AvaCloud Webhooks API. updated: 2024-09-03 authors: [owenwahlgren] icon: Book --- ## What is a Webhook? A webhook is a communication mechanism to provide applications with real-time information. It delivers data to other applications as it happens, meaning you get data immediately, unlike typical APIs where you would need to poll for data to get it in "real-time". This makes webhooks much more efficient for both providers and consumers. Webhooks work by registering a URL to send notifications once certain events occur. You can create receiver endpoints in your server in any programming language and those will have an associated URL. This object contains all the relevant information about what just happened, including the type of event and the data associated with that event. ## What are AvaCloud Webhooks? With the Webhooks API, you can monitor real-time events on the Avalanche C-Chain and L1s. For example, you can monitor smart contract events, track NFT transfers, and observe wallet-to-wallet transactions. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/glacier-webhooks-xpLeH8o7slcnvOdWsIorDJSUeNlz04.png) ### Key Features: - **Real-time notifications:** Receive immediate updates on specified on-chain activities without polling. - **Customizable:** Specify the desired event type to listen for, customizing notifications according to individual requirements. - **Secure:** Employ shared secrets and signature-based verification to guarantee that notifications originate from a trusted source. - **Broad Coverage:** Support for C-chain mainnet, testnet, and L1s within the Avalanche ecosystem, ensuring wide-ranging monitoring capabilities. ### Use Cases: - **NFT Marketplace Transactions:** Get alerts for NFT minting, transfers, auctions, bids, sales, and other interactions within NFT marketplaces. - **Wallet Notifications:** Receive alerts when an address performs actions such as sending, receiving, swapping, or burning assets. - **DeFi Activities:** Receive notifications for various DeFi activities such as liquidity provisioning, yield farming, borrowing, lending, and liquidations. ## Webhooks API Reference [Create a new webhook](https://developers.avacloud.io/webhooks-api/webhooks/create-a-webhook) ```bash curl --request POST \ --url https://glacier-api.avax.network/v1/webhooks \ --header 'accept: application/json' \ --header 'content-type: application/json' \ --data ' { "eventType": "address_activity" } ``` [Lists webhooks for the user.](https://developers.avacloud.io/webhooks-api/webhooks/list-webhooks) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/webhooks \ --header 'accept: application/json' ``` [Retrieves a webhook by ID.](https://developers.avacloud.io/webhooks-api/webhooks/get-a-webhook-by-id) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/webhooks/id \ --header 'accept: application/json' ``` [Deactivates a webhook by ID.](https://developers.avacloud.io/webhooks-api/webhooks/deactivate-a-webhook) ```bash curl --request DELETE \ --url https://glacier-api.avax.network/v1/webhooks/id \ --header 'accept: application/json' ``` [Updates an existing webhook.](https://developers.avacloud.io/webhooks-api/webhooks/update-a-webhook) ```bash curl --request PATCH \ --url https://glacier-api.avax.network/v1/webhooks/id \ --header 'accept: application/json' \ --header 'content-type: application/json' ``` [Generates a new shared secret.](https://developers.avacloud.io/webhooks-api/webhooks/generate-a-shared-secret) ```bash curl --request POST \ --url https://glacier-api.avax.network/v1/webhooks:generateOrRotateSharedSecret \ --header 'accept: application/json' ``` [Get a previously generated shared secret.](https://developers.avacloud.io/webhooks-api/webhooks/get-a-shared-secret) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/webhooks:getSharedSecret \ --header 'accept: application/json' ``` [Add addresses to webhook.](https://developers.avacloud.io/webhooks-api/webhooks/add-addresses-to-webhook) ```bash curl --request PATCH \ --url https://glacier-api.avax.network/v1/webhooks/id/addresses \ --header 'accept: application/json' \ --header 'content-type: application/json' ``` [Remove addresses from webhook.](https://developers.avacloud.io/webhooks-api/webhooks/remove-addresses-from-webhook) ```bash curl --request DELETE \ --url https://glacier-api.avax.network/v1/webhooks/id/addresses \ --header 'accept: application/json' \ --header 'content-type: application/json' ``` [List adresses by webhook.](https://developers.avacloud.io/webhooks-api/webhooks/list-adresses-by-webhook) ```bash curl --request GET \ --url https://glacier-api.avax.network/v1/webhooks/id/addresses \ --header 'accept: application/json' ``` # Create API Key (/academy/avalanche-l1/avacloudapis/03-environment-setup/01-avacloud-account) --- title: Create API Key description: Get an API key for AvaCloud updated: 2024-09-03 authors: [owenwahlgren] icon: Book --- import { Step, Steps } from 'fumadocs-ui/components/steps'; ## Get an AvaCloud API Key In order to utilize your accounts rate limits, you will need to make API requests with an API key. You can generate API Keys from the [AvaCloud portal](https://app.avacloud.io/glacier-api/). Create an account on [AvaCloud](https://avacloud.io). Click on the `Web3 Data API` [tab](https://app.avacloud.io/glacier-api/). ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/create-api-key-gfBR9O5rSJilgNzws8JWyHXctbsXox.png) Click `+ Add API Key` and create a new name for your API key. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/name-api-key-NuNRHpnSFC3dLvLYdbztDTlAf8Ax6k.png) **Save your API key** in a secure location. We will need it in the next step. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/grab-api-key-KN2CdMQVWrHPKjPY4vxS4H6pIZVJmW.png) After generating the API keys the AvaCloud page should look like this: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/final-api-key-5ydE6hNLZajRH3hNEAYE5IFFmNBdPX.png) Once you've created and retrieved the key, you will be able to make authenticated queries by passing in your API key in the `x-glacier-api-key` header of your HTTP request. An example curl request to the Data API: ```bash curl -H "Content-Type: Application/json" -H "x-glacier-api-key: " \ "https://glacier-api.avax.network/v1/chains" ``` # Setup AvaCloudSDK Starter Kit (/academy/avalanche-l1/avacloudapis/03-environment-setup/02-setup-starter-kit) --- title: Setup AvaCloudSDK Starter Kit description: Set up the AvaCloudSDK Starter Kit in a GitHub Codespace updated: 2024-09-03 authors: [owenwahlgren] icon: Book --- import Link from 'next/link'; import { cn } from '@/utils/cn'; import { buttonVariants } from '@/components/ui/button.tsx' import { Step, Steps } from 'fumadocs-ui/components/steps'; In this course we will run the AvaCloudSDK Starter Kit in a Github Codepsace. This is the quickest way to get started. The `AvaCloudSDK Starter Kit` contains everything we need to get started quickly with the AvaCloud API. ### Open the AvaCloudSDK Starter Kit Github Repository: **Make sure you are on the `follow-along` branch!** Open AvaCloudSDK Starter Kit ### Create a Codespace [![Open in GitHub Codespaces](https://github.com/codespaces/badge.svg)](https://github.com/codespaces/new?hide_repo_select=true&ref=follow-along&repo=851861669&machine=standardLinux32gb) The Codespace will open in a new tab. Wait a few minutes until it's fully built. ### Verify everything is working correctly Open the terminal with `` Ctrl + ` `` or by opening it through the menu: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/terminal-08TThSFqM438J1Jd5E1bh1OyMYAXWg.png) ### Set the `AVACLOUD_API_KEY` environment variable Create a `.env` file in the root of the project and add your API key from [the previous step](/academy/avacloudapis/03-environment-setup/01-avacloud-account): ```bash AVACLOUD_API_KEY=ac_rGIKESl9_9DWuLfJJQLSV5nlzbKR7eHxym6XW3XEQJeNBDRxI... ``` ### Start the NextJS app Now we can run the NextJS app in hot reload mode: ```bash yarn dev ``` It should preview within the Codespace: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/site-running-neUxhhADHqXs34Jrgw1uSJhqokItAC.png) ### Optional: Open Codespace locally in Visual Studio Code You can switch any time from the browser IDE to Visual Studio Code: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/vs-code-DNVuxWt4Z4ffoDsszoGDyUuhXvhC8m.png) The first time you switch, you will be asked to install the [Codespaces extension](https://marketplace.visualstudio.com/items?itemName=GitHub.codespaces) and connect VS Code to you GitHub account, if it is not already connceted. # Time to Build! (/academy/avalanche-l1/avacloudapis/03-environment-setup/03-what-we-build) --- title: Time to Build! description: Learn about what we will build in this course updated: 2024-09-03 authors: [owenwahlgren] icon: Book --- ### Finished Setup Once your environment is set up, we can start building some applications using the AvaCloud API and the AvaCloudSDK. The home page should look like this: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/preview-L1zktfNDP4fWzdESdhIQ7KxsfnQJj0.png) ### What We Will Build Here is a brief overview of what we will be building in this course: - ERC-20 Balance App - Wallet Portfolio App - Block Explorer App Each of these applications will utilize the Data API to get data from the Avalanche network. We will fetch data such as ERC-20 token balances, NFT balances, recent transactions from an address, block information and much more. # Overview (/academy/avalanche-l1/avacloudapis/04-erc20-token-balance-app/01-overview) --- title: Overview description: Use the AvaCloud Data API to create a simple web app that displays a user's ERC-20 token balances. updated: 2024-09-13 authors: [owenwahlgren] icon: Book --- In this section we will use the Data API to create a simple web app that displays a user's ERC-20 token portfolio. This app will allow users to input their Avalanche C-Chain address and view a list of their ERC-20 token balances. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/balance-app-9ggCriiHBsggku1bFGF8tL1lyThSx4.png) We will use two endpoints from the Data API to accomplish this: - [`data.evm.blocks.getLatestBlocks`](https://developers.avacloud.io/data-api/evm-blocks/list-latest-blocks) - [`data.evm.balances.listErc20Balances`](https://developers.avacloud.io/data-api/evm-balances/list-erc-20-balances) # Understanding the Code (/academy/avalanche-l1/avacloudapis/04-erc20-token-balance-app/02-understanding-code) --- title: Understanding the Code description: Before we start coding, let's take a look at the code we will be working with. updated: 2024-09-13 authors: [owenwahlgren] icon: Book --- import { Step, Steps } from 'fumadocs-ui/components/steps'; There will be two main files that we will be working with in this section. ### `Page.tsx` This is the code that will be rendered on the client side, as distinguished by `"use client";` at the top of the file. It contains the React components that will be displayed to the user and is responsible for making the API calls to our backend, which in turn calls the Data API. It is important to understand that when you `"use client"` in a NextJS project, it will be rendered on the client side. This means that the code will be executed in the user's browser and not on the server. This is important to keep in mind when working with sensitive data or when you want to keep your API keys secure. Besides this, we have two main functions that we will be working with in this file: ```tsx title="src/app/balance-app/page.tsx" const handleSetAddress = async () => { // // TODO: Implement handleSetAddress // }; ``` `handleSetAddress` is a simple function that will be called when the user clicks the "Set Address" button. It will ensure the address is valid then set the inputted address to the React State. Next, we call our next function `fetchERC20Balances` to get the user's balance. ```tsx title="src/app/balance-app/page.tsx" const fetchERC20Balances = async (address: string) => { // // TODO: Implement fetchERC20Balances // }; ``` `fetchERC20Balances` is a function that will make a call to our backend to get the user's ERC-20 token balances. It will first get the current block height, then call the `listErc20Balances` method on our backend with the user's address and the block height. It will then return the balances as an array of `Erc20TokenBalance` objects. ### `Route.ts` This code will be executed on the server side, as distinguished by `"use server";` at the top of the file. It contains the code that will be executed on the server side and is responsible for making the API calls to the Data API. There are a few key components to understand in this file: ```tsx title="src/app/api/balance/route.ts" import { AvaCloudSDK } from "@avalabs/avacloud-sdk"; const avaCloudSDK = new AvaCloudSDK({ apiKey: process.env.AVACLOUD_API_KEY, chainId: "43114", // Avalanche Mainnet network: "mainnet", }); ``` Here we initialize the `AvaCloudSDK` with our AvaCloud API key and the chainId of `43114` for the Avalanche Mainnet. This will allow us to make calls to the Data API. ```tsx title="src/app/api/balance/route.ts" export async function GET(request: Request) { const { searchParams } = new URL(request.url) const method = searchParams.get('method') try { let result switch (method) { case 'getBlockHeight': result = await getBlockHeight() break case 'listErc20Balances': const address: string = searchParams.get('address')! const blockNumber: string = searchParams.get('blockNumber')! result = await listErc20Balances(address, blockNumber); break default: return NextResponse.json({ error: 'Invalid method' }, { status: 400 }) } return NextResponse.json(result) } catch (error) { return NextResponse.json({ error: 'Internal Server Error' }, { status: 500 }) } } ``` Here we define the internal API methods for our backend. We have two methods that we will be working with in this section: `getBlockHeight` and `listErc20Balances`. We create both of these methods internally, then forward the request to the Data API. We then return the result to the client. ```tsx title="src/app/api/balance/route.ts" async function getBlockHeight() { // // TODO: Implement getBlockHeight // } async function listErc20Balances(address: string, blockNumber: string) { // // TODO: Implement listErc20Balances // } ``` In the next section, we will implement the `listErc20Balances` and `getBlockHeight` function to call the Data API through the AvaCloudSDK. # Modifying the Code (/academy/avalanche-l1/avacloudapis/04-erc20-token-balance-app/03-modifying-code) --- title: Modifying the Code description: Lets modify the code to implement the Data API. updated: 2024-09-13 authors: [owenwahlgren] icon: Book --- import { Step, Steps } from 'fumadocs-ui/components/steps'; In this section we will modify the code to implement the Data API. ### Modify Backend `src/app/api/balance/route.ts` First we will implement the `getBlockHeight` function. The goal of this function is to fetch recent blocks from the Data API then to return the highest block in the first position. Reference the [AvaCloud SDK documentation](https://developers.avacloud.io/data-api/evm-blocks/list-latest-blocks) to see how to fetch the latest blocks. ```tsx title="src/app/api/balance/route.ts" async function getBlockHeight() { const result = await avaCloudSDK.data.evm.blocks.getLatestBlocks({ pageSize: 1, }); return result.result.blocks[0].blockNumber } ``` Next we will implement the `listErc20Balances` function. The goal of this function is to fetch the ERC-20 token balances for a given address at a specific block height. Reference the [AvaCloud SDK documentation](https://developers.avacloud.io/data-api/evm-balances/list-erc-20-balances) to see how to fetch ERC-20 token balances. Note the `Erc20TokenBalance` type that is imported, we should use this to combine paged results. ```tsx title="src/app/api/balance/route.ts" async function listErc20Balances(address: string, blockNumber: string) { const result = await avaCloudSDK.data.evm.balances.listErc20Balances({ blockNumber: blockNumber, pageSize: 10, address: address, }); const balances: Erc20TokenBalance[] = []; for await (const page of result) { balances.push(...page.result.erc20TokenBalances); } return balances } ``` ### Modify Frontend `src/app/balance-app/page.tsx` First we will implement the `fetchERC20Balances` function. The goal of this function is to make a call to our backend to get the user's ERC-20 token balances. Make a call to our backend first for the most recent block height, then our `listErc20Balances` API. Finally return the results. ```tsx title="src/app/balance-app/page.tsx" const fetchERC20Balances = async (address: string) => { const blockResult = await fetch("api/balance?method=getBlockHeight"); const blockNumber = await blockResult.json(); const balanceResult = await fetch("api/balance?method=listErc20Balances&address=" + address + "&blockNumber=" + blockNumber); const balances = await balanceResult.json(); return balances as Erc20TokenBalance[]; }; ``` Next we will implement the `handleSetAddress` function. The goal of this function is to set the address in the state and fetch the ERC-20 token balances for that address using our `fetchERC20Balances` function. First make sure the address is valid, then update the state for `Address` and `Balances` ```tsx title="src/app/balance-app/page.tsx" const handleSetAddress = async () => { const addressInput = document.getElementById("address") as HTMLInputElement; const address = addressInput.value; const addressPattern = /^0x[a-fA-F0-9]{40}$/; if (addressInput && addressPattern.test(address)) { setAddress(address); setBalances(await fetchERC20Balances(address)); } }; ``` # Final Result (/academy/avalanche-l1/avacloudapis/04-erc20-token-balance-app/04-final) --- title: Final Result description: The final result of the ERC-20 token balance app. updated: 2024-09-03 authors: [owenwahlgren] icon: Book --- If we implemented the code correctly, we should have a working ERC-20 token balance app that displays the user's token balances. The app will look like the following: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/balance-app-init-bIVbTrMxCmFteBLTTcDRHGuVU75Kcd.png) After setting the address field, the app will display the user's ERC-20 token balances: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/balance-app-9ggCriiHBsggku1bFGF8tL1lyThSx4.png) Notice how the app also displays images for each token. This is done by fetching the token metadata from `listErc20Balances` and displaying the token's logo. # Overview (/academy/avalanche-l1/avacloudapis/05-wallet-portfolio-app/01-overview) --- title: Overview description: Use the Data API to create a simple web app that displays data and metrics on a connected wallet. updated: 2024-09-13 authors: [owenwahlgren] icon: Book --- In this section we will expand on the ERC-20 Balance App with NFTs (ERC-721) and ERC-1155 tokens. We will also add a connect wallet button to allow users to connect their own wallet and view their own token balances. Here is a preview of what we will build: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/nfts-v4LwE4Ij450GkYThM5JQG7ghKtT1LQ.png) ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/tokens-ILhHQF5XpddcXcg3pbyG6aQ8hbd9XJ.png) We will use a few additional endpoints from the Data API to accomplish this: - [`data.evm.balances.listErc721Balances`](https://developers.avacloud.io/data-api/evm-balances/list-erc-721-balances) - [`data.evm.balances.listErc1155Balances`](https://developers.avacloud.io/data-api/evm-balances/list-erc-1155-balances) - [`data.evm.transactions.listTransactions`](https://developers.avacloud.io/data-api/evm-transactions/list-transactions) # Understanding the Code (/academy/avalanche-l1/avacloudapis/05-wallet-portfolio-app/02-understanding-code) --- title: Understanding the Code description: Before we start coding, let's take a look at the code we will be working with. updated: 2024-09-13 authors: [owenwahlgren] icon: Book --- import { Step, Steps } from 'fumadocs-ui/components/steps'; There will be two main files that we will be working with in this section. ### `Page.tsx` This is the code that will be rendered on the client side, as distinguished by `"use client";` at the top of the file. It contains the React components that will be displayed to the user and is responsible for making the API calls to our backend, which in turn calls the Data API. It is important to understand that when you `"use client"` in a NextJS project, it will be rendered on the client side. This means that the code will be executed in the user's browser and not on the server. This is important to keep in mind when working with sensitive data or when you want to keep your API keys secure. Besides this, we have three main functions that we will be working with in this file: ```tsx title="src/app/basic-wallet/page.tsx" const fetchERC721Balances = async (address: string) => { // // TODO: Implement this! // return [] as Erc721TokenBalance[]; } ``` `fetchERC721Balances` is a function that will make a call to our backend to get the user's ERC-721 token balances. It will call the `listErc721Balances` method on our backend with the user's address. It will then return the balances as an array of `Erc721TokenBalance` objects. ```tsx title="src/app/basic-wallet/page.tsx" const fetchERC1155Balances = async (address: string) => { // // TODO: Implement this! // return [] as Erc1155TokenBalance[]; } ``` `fetchERC1155Balances` is a function that will make a call to our backend to get the user's ERC-1155 token balances. It will call the `listErc1155Balances` method on our backend with the user's address. It will then return the balances as an array of `Erc1155TokenBalance` objects. ```tsx title="src/app/basic-wallet/page.tsx" const fetchRecentTransactions = async (address: string) => { // // TODO: Implement this! // return {} as TransactionDetails; } ``` `fetchRecentTransactions` is a function that will make a call to our backend to get the user's recent transactions for all tokens. It will call the `listRecentTransactions` method on our backend with the user's address. It will then return the balances as an object of type `TransactionDetails`. ### `Route.ts` This code will be executed on the server side, as distinguished by `"use server";` at the top of the file. It contains the code that will be executed on the server side and is responsible for making the API calls to the Data API. There are a few key components to understand in this file: ```tsx title="src/app/api/wallet/route.ts" import { AvaCloudSDK } from "@avalabs/avacloud-sdk"; const avaCloudSDK = new AvaCloudSDK({ apiKey: process.env.AVACLOUD_API_KEY, chainId: "43114", // Avalanche Mainnet network: "mainnet", }); ``` Here we initialize the `AvaCloudSDK` with our AvaCloud API key and the chainId of `43114` for the Avalanche Mainnet. This will allow us to make calls to the Data API. ```tsx title="src/app/api/wallet/route.ts" export async function GET(request: Request) { const { searchParams } = new URL(request.url) const method = searchParams.get('method') let address try { let result switch (method) { case 'listERC721Balances': address = searchParams.get('address')! result = await listERC721Balances(address) break case 'listERC1155Balances': address = searchParams.get('address')! result = await listErc1155Balances(address) break case 'listRecentTransactions': address = searchParams.get('address')! result = await listRecentTransactions(address) break default: return NextResponse.json({ error: 'Invalid method' }, { status: 400 }) } return NextResponse.json(result) } catch (error) { return NextResponse.json({ error: 'Internal Server Error' }, { status: 500 }) } } ``` Here we define the internal API methods for our backend. We have two methods that we will be working with in this section: `getBlockHeight`, `listERC721Balances`, `listErc1155Balances` and `listRecentTransactions`. We create all of these methods internally, then forward the request to the Data API. We then return the result to the client. ```tsx title="src/app/api/wallet/route.ts" async function getBlockHeight() { // // TODO: Implement this! // return } const listERC721Balances = async (address: string) => { // // TODO: Implement this! // return } const listErc1155Balances = async (address: string) => { // // TODO: Implement this! // return } const listRecentTransactions = async (address: string) => { // // TODO: Implement this! // return } ``` In the next section, we will implement these functions to call the Data API through the AvaCloudSDK. # Modifying the Code (/academy/avalanche-l1/avacloudapis/05-wallet-portfolio-app/03-modifying-code) --- title: Modifying the Code description: Lets modify the code to implement the Data API. updated: 2024-09-13 authors: [owenwahlgren] icon: Book --- import { Step, Steps } from 'fumadocs-ui/components/steps'; In this section, we will modify the code to implement the Data API. ### Modify Backend `src/app/api/wallet/route.ts` First we will implement the `getBlockHeight` function. This function is the same as the one in ERC20 Balance App, but we will repeat it for the sake of the tutorial. The goal of this function is to fetch recent blocks from the Data API then to return the highest block in the first position. Reference the [AvaCloud SDK documentation](https://developers.avacloud.io/data-api/evm-blocks/list-latest-blocks) to see how to fetch the latest blocks. ```tsx title="src/app/api/wallet/route.ts" async function getBlockHeight() { const result = await avaCloudSDK.data.evm.blocks.getLatestBlocks({ pageSize: 1, }); return result.result.blocks[0].blockNumber } ``` Next we will implement the `listERC721Balances` function. The goal of this function is to fetch the ERC-721 token balances for a given address. Reference the [AvaCloud SDK documentation](https://developers.avacloud.io/data-api/evm-balances/list-erc-721-balances) to see how to fetch ERC-721 token balances. Note the `Erc721TokenBalance` type that is imported, we should use this to combine paged results. ```tsx title="src/app/api/wallet/route.ts" const listERC721Balances = async (address: string) => { const result = await avaCloudSDK.data.evm.balances.listErc721Balances({ pageSize: 10, address: address, }); const balances: Erc721TokenBalance[] = []; for await (const page of result) { balances.push(...page.result.erc721TokenBalances); } return balances } ``` Now we will implement the `listErc1155Balances` function. The goal of this function is to fetch the ERC-1155 token balances for a given address. Reference the [AvaCloud SDK documentation](https://developers.avacloud.io/data-api/evm-balances/list-erc-1155-balances) to see how to fetch ERC-1155 token balances. Note the `Erc1155TokenBalance` type that is imported, we should use this to combine paged results. ```tsx title="src/app/api/wallet/route.ts" const listErc1155Balances = async (address: string) => { const result = await avaCloudSDK.data.evm.balances.listErc1155Balances({ pageSize: 10, address: address, }); const balances: Erc1155TokenBalance[] = []; for await (const page of result) { balances.push(...page.result.erc1155TokenBalances); } return balances } ``` Finally we will implement the `listRecentTransactions` function. The goal of this function is to fetch recent transactions for a given address given a block start and end. Reference the [AvaCloud SDK documentation](https://developers.avacloud.io/data-api/evm-transactions/list-transactions) to see how to fetch recent transactions. Note the `TransactionDetails` type that is imported, we should use this to combine and sort paged results. ```tsx title="src/app/api/wallet/route.ts" const listRecentTransactions = async (address: string) => { const blockHeight = await getBlockHeight() const result = await avaCloudSDK.data.evm.transactions.listTransactions({ pageSize: 10, startBlock: blockHeight - 100000, endBlock: blockHeight, address: address, sortOrder: "desc", }); const transactions: TransactionDetails = { erc20Transfers: [], erc721Transfers: [], erc1155Transfers: [], nativeTransaction: { blockNumber: '', blockTimestamp: 0, blockHash: '', blockIndex: 0, txHash: '', txStatus: '', txType: 0, gasLimit: '', gasUsed: '', gasPrice: '', nonce: '', from: { name: undefined, symbol: undefined, decimals: undefined, logoUri: undefined, address: '' }, to: { name: undefined, symbol: undefined, decimals: undefined, logoUri: undefined, address: '' }, value: '' }, } for await (const page of result) { for (const transaction of page.result.transactions) { if (transaction.erc20Transfers) { if (transactions.erc20Transfers) { transactions.erc20Transfers.push(...transaction.erc20Transfers); } } else if (transaction.erc721Transfers) { if (transactions.erc721Transfers) { transactions.erc721Transfers.push(...transaction.erc721Transfers); } } else if (transaction.erc1155Transfers) { if (transactions.erc1155Transfers) { transactions.erc1155Transfers.push(...transaction.erc1155Transfers); } } } } return transactions } ``` ### Modify Frontend `src/app/basic-wallet/page.tsx` Now we will modify the frontend to make calls to our backend. First we will implement the `fetchERC20Balances` function. The goal of this function is to make a call to our backend to get the user's ERC-20 token balances. Make a call to our backend first for the most recent block height, then our `listErc20Balances` API. Finally return the results. ```tsx title="src/app/basic-wallet/page.tsx" const fetchERC20Balances = async (address: string) => { const blockResult = await fetch("api/balance?method=getBlockHeight"); const blockNumber = await blockResult.json(); const balanceResult = await fetch("api/balance?method=listErc20Balances&address=" + address + "&blockNumber=" + blockNumber); const balances = await balanceResult.json(); return balances as Erc20TokenBalance[]; }; ``` Next we will implement the `fetchERC721Balances` function. The goal of this function is to call our `listErc721Balances` function on the backend and return it as a `Erc721TokenBalance` array. Make a call to our backend then parse the result as json. Return it as `Erc721TokenBalance[]`. ```tsx title="src/app/basic-wallet/page.tsx" const fetchERC721Balances = async (address: string) => { const result = await fetch(`api/wallet?method=listERC721Balances&address=${address}`); const balances = await result.json(); return balances as Erc721TokenBalance[]; } ``` Now we will implement the `fetchERC1155Balances` function. The goal of this function is to call our `listERC1155Balances` function on the backend and return it as a `Erc1155TokenBalance` array. Make a call to our backend then parse the result as json. Return it as `Erc1155TokenBalance[]`. ```tsx title="src/app/basic-wallet/page.tsx" const fetchERC1155Balances = async (address: string) => { const result = await fetch(`api/wallet?method=listERC1155Balances&address=${address}`); const balances = await result.json(); return balances as Erc1155TokenBalance[]; } ``` Finally we will implement the `fetchRecentTransactions` function. The goal of this function is to call our `listRecentTransactions` function on the backend and return it as an object of type `TransactionDetails`. Make a call to our backend then parse the result as json. Return it as type of `TransactionDetails`. ```tsx title="src/app/basic-wallet/page.tsx" const fetchRecentTransactions = async (address: string) => { const result = await fetch(`api/wallet?method=listRecentTransactions&address=${address}`); const transactions = await result.json(); return transactions as TransactionDetails; } ``` # Overview (/academy/avalanche-l1/avacloudapis/06-block-explorer-app/01-overview) --- title: Overview description: Use the Data API to create a simple block explorer. updated: 2024-09-13 authors: [owenwahlgren] icon: Book --- In this section we will build a basic block explorer using the Data API. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avacloudsdk/explorer-Uahzju9LouXAGd61AQvm38Vxtq4cG5.png) We will use a couple additional endpoints from the Data API to accomplish this: - [`data.evm.blocks.getBlockHeight`](https://developers.avacloud.io/data-api/evm-blocks/list-latest-blocks) - [`data.evm.transactions.listLatestTransactions`](https://developers.avacloud.io/data-api/evm-transactions/list-latest-transactions) # Understanding the Code (/academy/avalanche-l1/avacloudapis/06-block-explorer-app/02-understanding-code) --- title: Understanding the Code description: Before we start coding, let's take a look at the code we will be working with. updated: 2024-10-09 authors: [owenwahlgren] icon: Book --- import { Step, Steps } from 'fumadocs-ui/components/steps'; There will be two main files that we will be working with in this section. ### `Page.tsx` This is the code that will be rendered on the client side, as distinguished by `"use client";` at the top of the file. It contains the React components that will be displayed to the user and is responsible for making the API calls to our backend, which in turn calls the Data API. It is important to understand that when you `"use client"` in a NextJS project, it will be rendered on the client side. This means that the code will be executed in the user's browser and not on the server. This is important to keep in mind when working with sensitive data or when you want to keep your API keys secure. Besides this, we have three main functions that we will be working with in this file: ```tsx title="src/app/basic-explorer/page.tsx" const fetchRecentTransactions = async () => { // // TODO: Implement this! // return data as NativeTransaction[] } ``` `fetchRecentTransactions` is a function that will make a call to our backend to get the most recent transactions from the chain. It will call the `getRecentTransactions` method on our backend. It will then return the transactions as an array of `NativeTransaction` objects. ```tsx title="src/app/basic-explorer/page.tsx" const fetchRecentBlocks = async () => { // // TODO: Implement this! // return data as EvmBlock[] } ``` `fetchRecentBlocks` is a function that will make a call to our backend to get the most recent blocks from the chain. It will call the `getRecentBlocks` method on our backend. It will then return the blocks as an array of `EvmBlock` objects. ### `Route.ts` This code will be executed on the server side, as distinguished by `"use server";` at the top of the file. It contains the code that will be executed on the server side and is responsible for making the API calls to the Data API. There are a few key components to understand in this file: ```tsx title="src/app/api/explorer/route.ts" import { AvaCloudSDK } from "@avalabs/avacloud-sdk"; const avaCloudSDK = new AvaCloudSDK({ apiKey: process.env.AVACLOUD_API_KEY, chainId: "43114", // Avalanche Mainnet network: "mainnet", }); ``` Here we initialize the `AvaCloudSDK` with our AvaCloud API key and the chainId of `43114` for the Avalanche Mainnet. This will allow us to make calls to the Data API. ```tsx title="src/app/api/explorer/route.ts" export async function GET(request: Request) { const { searchParams } = new URL(request.url) const method = searchParams.get('method') try { let result switch (method) { case 'getRecentTransactions': result = await getRecentTransactions() break case 'getRecentBlocks': result = await getRecentBlocks() break default: return NextResponse.json({ error: 'Invalid method' }, { status: 400 }) } return NextResponse.json(result) } catch (error) { return NextResponse.json({ error: 'Internal Server Error' }, { status: 500 }) } } ``` Here we define the internal API methods for our backend. We have two methods that we will be working with in this section: `getRecentBlocks` and `getRecentTransactions`. We create all of these methods internally, then forward the request to the Data API. We then return the result to the client. ```tsx title="src/app/api/explorer/route.ts" const getRecentBlocks = async () => { // // TODO: Implement this! // } const getRecentTransactions = async () => { // // TODO: Implement this! // } ``` In the next section, we will implement these functions to call the Data API through the AvaCloudSDK. # Modifying the Code (/academy/avalanche-l1/avacloudapis/06-block-explorer-app/03-modifying-code) --- title: Modifying the Code description: Lets modify the code to implement the Data API. updated: 2024-10-09 authors: [owenwahlgren] icon: Book --- import { Step, Steps } from 'fumadocs-ui/components/steps'; In this section we will modify the code to implement the Data API. ### Modify Backend `src/app/api/explorer/route.ts` First we will implement the `getRecentBlocks` function. The goal of this function is to fetch recent blocks from the Data API with all its information. Reference the [AvaCloud SDK documentation](https://developers.avacloud.io/data-api/evm-blocks/list-latest-blocks) to see how to fetch the latest blocks. ```tsx title="src/app/api/explorer/route.ts" const getRecentBlocks = async () => { const result = await avaCloudSDK.data.evm.blocks.getLatestBlocks({ pageSize: 1, }); let count = 0; const blocks: EvmBlock[] = []; for await (const page of result) { if (count === 20) { break; } blocks.push(...page.result.blocks); count++; } return blocks } ``` Next we will implement the `getRecentTransactions` function. The goal of this function is to fetch all native token transfers from the Data API. Reference the [AvaCloud SDK documentation](https://developers.avacloud.io/data-api/evm-transactions/list-latest-transactions) to see how to fetch latest transactions. Note the `NativeTransaction` type that is imported, we should use this to combine paged results. ```tsx title="src/app/api/explorer/route.ts" const getRecentTransactions = async () => { const result = await avaCloudSDK.data.evm.transactions.listLatestTransactions({ pageSize: 3, }); let count = 0; const transactions: NativeTransaction[] = []; for await (const page of result) { if (count === 20) { break; } transactions.push(...page.result.transactions); count++; } return transactions; } ``` ### Modify Frontend `src/app/basic-explorer/page.tsx` First we will implement the `fetchRecentTransactions` function. The goal of this function is to make a call to our backend to get recent transactions. Make a call to our backend first for our `getRecentTransactions` method. Finally return the results. ```tsx title="src/app/basic-explorer/page.tsx" const fetchRecentTransactions = async () => { const response = await fetch(`/api/explorer?method=getRecentTransactions`) const data = await response.json() return data as NativeTransaction[] } ``` Next we will implement the `fetchRecentBlocks` function. The goal of this function is to make a call to our backend to get recent block information. Make a call to our backend first for our `getRecentBlocks` method. Finally return the results. ```tsx title="src/app/basic-explorer/page.tsx" const fetchRecentBlocks = async () => { const response = await fetch(`/api/explorer?method=getRecentBlocks`) const data = await response.json() return data as EvmBlock[] } ``` # Overview (/academy/avalanche-l1/avacloudapis/07-using-webhooks/01-overview) --- title: Overview description: Coming soon! updated: 2024-09-13 authors: [owenwahlgren] icon: Book --- # Avalanche Consensus (/academy/avalanche-l1/avalanche-fundamentals/02-avalanche-consensus-intro/01-avalanche-consensus-intro) --- title: Avalanche Consensus description: Learn how blockchains arrive at consensus using different mechanisms. updated: 2024-05-31 authors: [martineckardt] icon: Book --- Avalanche Consensus is a novel consensus protocol that is used in the Avalanche network. It is a leaderless, decentralized, and scalable consensus protocol that is used to achieve consensus on the state of the network. ## What You Will Learn In this section, you will go through the following topics: - **Consensus Mechanisms:** Understand what consensus mechanisms are and how they work - **Snowman Consensus:** Learn about the Snowman consensus protocol - **TPS vs TTF:** Understand the difference between transactions per second (TPS) and time to finality (TTF) # Consensus Mechanisms (/academy/avalanche-l1/avalanche-fundamentals/02-avalanche-consensus-intro/02-consensus-mechanisms) --- title: Consensus Mechanisms description: Learn how blockchains arrive at consensus using different mechanisms. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- Consensus plays a crucial role in [blockchain networks](/guides/what-is-a-blockchain) by resolving conflicts and ensuring that all validators agree on the current state of the distributed ledger. The main objective of a consensus mechanism is to create a single version of truth that is universally accepted by network participants. Validators can reach a consensus by following a set of steps called a consensus protocol. This way, they collectively decide on the state of the system and all state changes. Different consensus mechanisms have different approaches. All aim to ensure that validators reach a majority agreement on network state. ## Ordering through Consensus Consensus is needed to agree on the order of state changes in a blockchain. This allows the validators to decide between two conflicting states. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/1-aWL9i9BFicUEF7ntMjBFuUejfadAUS.png) ## Double Spending Attack A Double Spending Attack is when a user attempts to spend more crypto than they own by creating multiple transactions that reference the same funds. Let's look at an Example: Alice owns 5 AVAX ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/2-2fU6eqsUiCq76Sy04VEfvD5rLo3eVc.png) Now Alice issues two transactions at the same time to different validators: 1. Send 5 AVAX to Bob 2. Send 5 AVAX to Charly It is important that there is only a limited notion of time in blockchain systems. Even if Alice does not issue these transactions at the exact same time, validators cannot identify which was issued first. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/3-8GHqtWHuf44Nilsugj6yC9sC0BFsZh.png) Each of the transaction in itself is valid. Alice owns 5 AVAX and should be able to send them to whomever she wants. However, she should only be able to send the amount she actually owns. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/4-GeSctGjJKsmXFWvwMpZmYpDcGquZcg.png) Therefore, validators have to collectively come to consensus on which of the two conflicting transactions will be included in the blockchain first, and therefore be accepted by all validators as the next state. To illustrate, we will color the validators preferring Charlie yellow and the validators preferring Bob blue. # Snowman Consensus (/academy/avalanche-l1/avalanche-fundamentals/02-avalanche-consensus-intro/03-snowman-consensus) --- title: Snowman Consensus description: Learn about the Avalanche Snowman consensus protocol. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- Protocols in the Avalanche family operate through repeated sub-sampled voting. When a validator is determining whether a block should be accepted, it asks a small, random subset of validators on their preferences. Based on the responses the validator gets, it might change its own preference. Let's visualize this with an example. You are a validator in a set of validators that is performing the Avalanche Consensus protocol to agree on whether to send the funds to Charlie (yellow) or to Bob (blue). It is important to understand that none of the validators really cares whether it is going to be yellow or blue, as long as all correctly operating validators decide for the same outcome at the end of the process. The starting preference is chosen randomly by each validator. ## Changing Preference You start by sampling the current preference of five other nodes and they reply: 2 prefer yellow (Charlie) and 3 prefer blue (Bob). ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/5-f6WnJHv0VAKRNOSd8gFHbO2Mar4mWl.png) Avalanche consensus dictates that a validator changes its preference if an α-majority of the sampled validators agree on another option, and it goes along with this popular choice. Let's set the alpha value to 3 in our example, meaning that we change our preference when 3 out of 5 sampled nodes have another preference. Since 3 out of 5 have replied with blue (Bob) we are changing our own preference to Bob. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/6-TscORkJchAtrT2rG8rG5CPFPilUR1b.png) From now on you will respond with blue, when another validators queries you for your current preference. ## Consecutive Successes Avalanche Consensus does not run for a fixed number of rounds, but until a decision threshold is hit. This means the validator keeps sampling until their preference is confirmed for beta (β) consecutive rounds. Now you query another five validators for their preference. Again, three of the five reply with the preference blue (Bob). Since your current preference is confirmed, you increment a counter for consecutive successes by one. You repeat this sampling process until their preference is confirmed for 8 consecutive rounds. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/7-KYmL0QWax9tmW7uT8bdqu9R5sNwgSs.png) ## Parameters of Avalanche Consensus In our example we used fixed values for how many nodes are sampled, how many are needed to change our preference and how many consecutive rounds of successes we require to finalize our decision. These consensus parameters are formalized in the table below and can be chosen by every node individually to meet their needs. |Symbol|Name|Range|Explanation| |---|---|---|---| |n |Number of Participants|1 to ∞|How many participants take part in the system?| |k |Sample Size|1 to n|How many of these participants get asked every round of sub-sampling?| |α |Quorum Size|1 to k|How many of the asked participants have to have the same preference for me to change my preference?| |β |Decision Threshold|>= 1|How many times does the quorum have to confirm my preference until I finalize my decision?| With these parameters we can illustrate the consensus algorithm as pseudo code: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/8-XzHBlGu1fdnPniQecAkpFfC5JTegVD.png) ## Finalization In the common case when a transaction has no conflicts, finalization happens very quickly. When conflicts exist, honest validators quickly cluster around conflicting transactions, entering a positive feedback loop until all correct validators prefer that transaction. This leads to the acceptance of non-conflicting transactions and the rejection of conflicting transactions. Avalanche Consensus guarantees (with high probability based on system parameters) that if any honest validator accepts a transaction, all honest validators will come to the same conclusion. # Throughput vs. Time to Finality (/academy/avalanche-l1/avalanche-fundamentals/02-avalanche-consensus-intro/04-tps-vs-ttf) --- title: Throughput vs. Time to Finality description: Learn how metrics like throughput and time to finality are different. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- To measure blockchain performance we can use two metrics: - Throughput: How many transaction are finalized per second measured in transactions per second (TPS) - Time to Finality: How long does it take a transaction to go from being submitted to validators to being unchangeable. These metrics are very different. Blockchain builders aspire to high throughput and very short time to finality. ## Highway Analogy Let's take an analogy of a highway. Each car represents a transaction and they all travel the same speed. When you click *send* in your wallet, you're like a car entering the highway. When the transaction is *finalized* and unchangeable, it's like the car reaching its destination. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/9-JT3ORUzCZAILlQJjQaY2nJvFZHEVRL.png) Throughput could be likened to the number of lanes, determining how many cars can pass on the highway in a given amount of time. The more lanes you have, the more cars can pass through, thus increasing the throughput. In a blockchain network, increasing the block size (analogous to adding more lanes) can increase throughput. Now, imagine you're driving to a specific destination (finality). The time it takes you to get from your starting point (initiation of the transaction) to your destination (confirmation of the transaction) is analogous to the "time to finality." As soon as a car reaches finality, it cannot return or abort the travel. Our goal is to build highways with many lanes (high throughput) but that bring us to our destination as fast as possible (short time to finality). ### Throughput and Finality of Popular Blockchain Networks |Network|Throughput|Time to Finality| |---|---|---| |Bitcoin|7 TPS|60 min| |Ethereum|30 TPS|6.4 min| |Avalanche / Avalanche L1|2500 TPS|~0.8 seconds| **TPS** → **Transactions per Second** Returning to the highway analogy, these networks would look like this: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/10-M9xrguxF39gS0MkB03LHE1DcNDGsIV.png) # Multi-Chain Architecture (/academy/avalanche-l1/avalanche-fundamentals/03-multi-chain-architecture-intro/01-multi-chain-architecture) --- title: Multi-Chain Architecture description: Learn about the Multi-Chain Architecture. updated: 2024-05-31 authors: [ashucoder9] icon: Book --- Multi-chain systems are a significant innovation, which provide greater scalability, customizability, and independence. At the core of multi-chain systems is the ability to run multiple blockchains simultaneously. Each blockchain is optimized for specialized use cases, thereby boosting the network's overall performance. ## What You Will Learn In this section, you will go through the following topics: - **Avalanche L1s:** Understand what Avalanche L1s are and how they work - **Setup Core Wallet:** Learn how to setup the Core wallet browser extension - **Use Dexalot:** Use your first Avalanche L1 # Avalanche L1s (/academy/avalanche-l1/avalanche-fundamentals/03-multi-chain-architecture-intro/02-L1) --- title: Avalanche L1s description: Learn about the Multi-Chain Architecture. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- > An Avalanche L1 is an independent blockchain with its own set of rules regarding validator membership, tokenomics, and the execution layer. It has it's own validator set that comes to consensus and validates the blockchain. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/l1s.png) These specialized L1 blockchains can be tailored to meet specific needs for a variety of applications, including DeFi, NFTs, gaming, and enterprise solutions. - They specify their own execution logic. - They determine their own fee structures. - They maintain their own state. - They facilitate their own networking. - They provide their own security. This independence ensures that L1s don't have to share execution threads, storage, or networking with other L1s networks or the Primary Network. ## Avalanche Network The Avalanche network is a network of independent interoperable L1s. They can communicate with each other and assets can be transferred between them, while they maintain interoperability. As a result, the Avalanche network can: - Scale up easily - Achieve higher overall transactions per second (TPS) - Offer lower transaction costs By leveraging L1s, Avalanche creates a flexible and scalable ecosystem that can adapt to a wide range of use cases and requirements. # Features & Benefits of Avalanche L1s (/academy/avalanche-l1/avalanche-fundamentals/03-multi-chain-architecture-intro/03-benefits) --- title: Features & Benefits of Avalanche L1s description: Learn about various benefits of using Avalanche L1s, such as Scalability, Independence, Customizability, Privacy, and Interoperability. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- ## Scalability of the Avalanche Network Every blockchain has a limited capacity for computation and data storage. Therefore, the transactions it can process in a given time frame and the state it can store are limited. In order to scale horizontally and to offer more blockspace, we can just add more blockchains to the Avalanche Network. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/11-KyUqqw9iwrH60hF4wnYPOWRTBOGRhT.png) We can use the analogy of a highway to visualize this concept. A highway can only handle a certain number of cars at a time. If too many cars try to enter the highway at once, traffic congestion will occur and they have to wait to enter the highway. The idea is similiar to building many highways in parallel and create additional space for cars to drive on. This allows for more transactions to be processed in parallel, and therefore increases the overall throughput of the network. The beauty of this approach is its simplicity. It doesn't require any new untested innovations. The challenge, rather, is optimizing how Avalanche L1s interoperate and making switching from one Avalanche L1 to the other easy. ## Independence From Other Avalanche L1s Separating the ecosystem into different chains creates independence from another. If congestion builds on one chain due to high network activity (e.g. an NFT drop, high volatility in token prices, new game launched), other chains are unaffected. One chain's congestion or increasing fees won't impact other chains. Going back to our highway analogy, we can think of the scaling through multiple chains as building many short highways in parallel. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/12-B730ft1bJPU6lxd3G4B7rpdExaNuC6.png) Coming back to our highway analogy, we can imagine a scenario where congestion builds up on one highway. The other highways are not directly affected. Some cars may choose to take a different highway and the traffic bottleneck may decrease. In single-chain systems, like Ethereum, congestion and rising fees affect everyone, including parties that have nothing to do with the cause of the activity increase. While the unified, or monolithic, blockchain design does offer certain advantages (like unified liquidity, fewer bridges, and potential for enhanced user experience via co-location of dApps), it also introduces notable drawbacks. Validators must have powerful, costly machines to support a diverse array of applications, increasing centralization due to high operational costs of running a node. Lack of modularity can halt all on-chain activities during network disruptions, potentially causing significant financial losses. Additionally, each new dApp competes for the same block space as all others, leading to overcrowding. ## Customizability The creator of an Avalanche L1 can customize it to meet their needs. This can happen in numerous ways, including introducing a custom own gas token, using a different Virtual Machine (e.g. a WASM or Move VM), or limiting access to the Avalanche L1. This is very hard to do in a single-chain system because it would require a majority of users to agree. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/13-VegJrRJXmD83CRfgpx2wTbzLkszjBB.png) In our highway analogy, let's think of some travelers having a very unique requirement: They would like to travel by boat instead of a car. While technically possible to build a water lane on a single highway system, this would be challenging. However, when these custom requirements are met in a Avalanche L1, it's easy to do. The ability to choose or create custom Virtual Machines (VMs) offers unprecedented flexibility. Avalanche L1s allow for developers to have: - Multiple VM Support: Unlike single-VM networks like Bitcoin or Ethereum, Avalanche L1s can host multiple blockchain instances with different VMs. - Ease of Use: Leverage existing VMs like the Subnet-EVM or create entirely new custom VMs using our SDKs to suit your specific needs. - Network Effects: This flexible architecture creates network effects both within individual blockchains and across different Avalanche L1s and blockchains. ## Enhanced Privacy, Compliance and Access Control While public blockchains offer transparency, many business scenarios require controlled visibility of transaction data. Developers building an Avalanche L1 can optionally enable: - Selective Transparency: Private blockchains allow you to limit transaction visibility to authorized participants. - Data Protection: Implement transaction encryption to safeguard sensitive information. - Granular Access: Control which data is visible to which participants, supporting "need-to-know" access models. ## Interoperability Avalanche L1s come with native interoperability and can leverage: - Cross-Chain Communication: Facilitate seamless interaction between different custom blockchains in the Avalanche network leverage Avalanche Interchain Messaging. - Asset Bridges: Create efficient bridges for asset transfers between your custom blockchain and other networks such as the Avalanche Interchain Token Transfer. # Avalanche9000 Upgrade (/academy/avalanche-l1/avalanche-fundamentals/03-multi-chain-architecture-intro/03a-etna-upgrade) --- title: Avalanche9000 Upgrade description: Learn about how the Avalanche9000 upgrade changes the network architecture. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- import EtnaUpgradeMotivation from '@/content/common/multi-chain-architecture/etna-upgrade-motivation.mdx'; # Avalanche L1s vs Layer 2 (/academy/avalanche-l1/avalanche-fundamentals/03-multi-chain-architecture-intro/04-custom-blockchains-vs-layer-2) --- title: Avalanche L1s vs Layer 2 description: Comparing different blockchain scaling approaches. updated: 2024-06-28 authors: [usmaneth] icon: BookOpen --- Layer 2 blockchain solutions, such as rollups, are another innovation in the blockchain landscape. Layer 2s aim to enhance the scalability and performance of the Ethereum network. Rollups essentially perform computations off-chain and submit the resultant state changes to the base layer, thereby reducing the computational load on the main Ethereum chain. While both Avalanche Custom Blockchains and Layer 2 rollups strive to improve blockchain scalability and performance, they use different methods and each have their unique advantages and trade-offs. ## Decentralization and Security Avalanche Custom Blockchains are part of the base layer itself. Each blockchain in Avalanche maintains its security, hence a compromise in one blockchain doesn't necessarily impact the others. On the other hand, rollups delegate security to the Ethereum mainnet. As long as the mainnet remains secure, so does the Layer 2 solution, given the rollup performs properly. However, a security breach on the mainnet can potentially affect all Layer 2 solutions. ## Interoperability and Flexibility Avalanche's multi-chain structure offers great interoperability and flexibility, as each custom blockchain network can define its own rules and validate multiple blockchains of different virtual machines. This means Avalanche can cater to a vast array of use cases. Conversely, Layer 2 solutions are primarily designed to augment the Ethereum mainnet and might not offer the same flexibility. ## Performance and Cost Both approaches aim to offer higher transaction throughput and lower fees compared to traditional single-chain systems. Avalanche achieves this through parallel processing across its Avalanche L1s, while rollups offload computation off-chain. However, users of Layer 2 solutions might experience delays when transferring assets back to Layer 1. Furthermore, since Layer 2 systems need to checkpoint their activity to the L1, which effectively sets a price floor and couples the prices of the L1 gas token to the L2 gas token. In Avalanche, the gas tokens of an Avalanche L1 are completely independent from AVAX. # Set Up Core Wallet (/academy/avalanche-l1/avalanche-fundamentals/03-multi-chain-architecture-intro/05-setup-core) --- title: Set Up Core Wallet description: Learn about how to setup your own Core Wallet. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; import InstallCoreExtension from "@/content/common/core-wallet/install.mdx" import CreateWallet from "@/content/common/core-wallet/create-wallet.mdx" import TestnetMode from "@/content/common/core-wallet/testnet-mode.mdx" import Faucet from "@/content/common/core-wallet/faucet.mdx" To grasp the concept of the Avalanche L1s better we will interact with a chain. To do that, we will use Core. Core is an all-in-one command center built for multi-chain systems. It supports Avalanche, Bitcoin, Ethereum, and all EVM-compatible blockchains. Core has a browser extension, a web wallet, and a mobile app. It is optimized for multiple chains and makes navigating between them easy. ### Install Core Extension ### Create a Wallet ### Switch to Testnet ### Get Testnet Tokens ## Managing MetaMask & Core Extensions If had Metamask already installed, you could face some problems. We recommend temporarily disabling Metamask for the time being. Open the extensions page in browser. You can also type `chrome://extensions` in your address bar to open it. Scroll through your list of installed extensions, or use the search bar at the top of the page, to find the Metamask extension. Once you find Metamask, you will see a toggle switch next to it. Click on this switch to disable the extension. You can reenable it any time. When the switch is in the off position, Metamask is disabled, and you should be all set. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/14-7yGvfoSga3HSD9JF2bokKPBFd3OvdV.png) # Use Dexalot L1 (/academy/avalanche-l1/avalanche-fundamentals/03-multi-chain-architecture-intro/06-use-dexalot) --- title: Use Dexalot L1 description: Get first hand experience with an Avalanche L1. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; In this activity, we'll interact with our first Avalanche L1. The Dexalot Avalanche L1 aims to replicate the user experience of a centralized exchange (CEX) with greater decentralization and transparency. By using a Avalanche L1, Dexalot can offer cheaper transaction fees than other traditional decentralized exchanges while keeping the transparency that centralized exchanges lack. ### Display the Dexalot Avalanche L1 in Core Make sure your Core Wallet is set to Testnet mode, so we do not use real funds. Open your Core Wallet Browser Extension and click "Show all Networks." To display Dexalot to our home screen, click the star icon next to its name. ### Bridge Tokens to Dexalot Head over to the [Dexalot Testnet](https://app.dexalot-test.com/trade), connect your wallet (top right), and click on the `Deposit` button next to the pink icon with your connected wallet. You will have to authenticate your wallet for the first time you interact with Dexalot. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/Dexalot1.png) Once you clicked the `Deposit` button, select to deposit into the Dexalot L1. Enter 1 AVAX and click Deposit. Confirm the transaction in your wallet. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/Dexalot2.png) A few moments later, your balances should be updated and you should be able to see that on the `Dashboard` tab: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/Dexalot3.png) ### Swap Tokens on Dexalot L1 Now head to the `Trade` tab and sell 0.5 AVAX for USDC. You can select the trading pair AVAX/USDC on the top right. The website will prompt your wallet to switch networks to the Dexalot L1. Confirm the switch and then sign the transaction. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/Dexalot3.png) Now, head back to the `Dashboard` tab and check how the balances updated. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/Dexalot4.png) ### Withdraw to Fuji C-Chain From the `Dashboard` tab, withdraw your AVAX and USDC back to the Fuji C-Chain by clicking on the "Withdraw" gray button on the left: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/Dexalot5.png) Make sure the network is set to Fuji C-Chain and enter the amount you want to withdraw. Click on the Withdraw button and confirm the transaction in your wallet. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/Dexalot6.png) ## What just happened? On the surface, it might feel like a regular decentralized swap. However, there is a substantial difference. We performed our operation not on the C-Chain, but bridged our tokens to a Avalanche L1, performed the operations there, and bridged our tokens back to the C-Chain. The Avalanche L1 (Dexalot) we used was highly specialized for our use case and very cheap. We actually got all the gas token ALOT we needed airdropped, just for bridging assets over. The only fees we had to pay were for bridging. Usually, we would not have done this for a single operation, so these costs do not occur for a single trade, but only for depositing and withdrawing from the portfolio. # Creating an L1 (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/01-creating-an-l1) --- title: Creating an L1 description: Learn how to create an L1 blockchain in the Avalanche network using the Builder Tooling. updated: 2024-05-31 authors: [martineckardt] icon: Book --- Now that we've gone over what Avalanche L1s are and how Interoperability works, you are probably eager to test out the functionality of Avalanche L1s by creating one yourself! In this section, you will learn how to create an L1 blockchain using the the Avalanche Builder Tooling. For production deployments you can leverage a [Blockchain-as-a-Service Provider](/integrations#Blockchain%20as%20a%20Service) to oursurce the setup and maintenance of the L1 infrastructure. ## Video You can watch a video how an L1 is created: ## What You Will Learn In this section, you will go through the following steps: ### Claim Testnet AVAX Tokens In the first step we will show you how to set up the Core wallet chrome extension. After, we will show how to claim some testnet AVAX tokens from the faucet. Finally, you will learn how to bridge the tokens from the C-Chain to the P-Chain. ### Create the P-Chain records for the a Subnet and blockchain Here we will show you how to create the P-Chain records for the Subnet and the blockchain. You will issue a `CreateSubnetTx` transaction on the P-Chain to create a Subnet record. Then you will add a belockchain to the Subnet by issuing a `CreateChainTx` transaction on the P-Chain. ### Set up a node to track the Subnet In this step you will learn how to set up a node to track the Subnet. We will leverage Docker to set up a node on a cloud server. When the node is up and running, you will connect your wallet to it. ### Convert to an L1 To finish the process, you will convert the Subnet to an L1. This is done by issuing a `ConvertSubnetToL1Tx` transaction on the P-Chain. This will turn your node into an actual validator for the L1. ### Test the L1 In the final step, you will deploy a ERC-20 token on the L1 you had launched. # Create Builder Account (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/01a-create-builder-account) --- title: Create Builder Account description: Create a Builder Account for easier access. updated: 2025-03-13 authors: [martineckardt] icon: CircleUserRound --- Before you start creating your first L1, we recommend you to create an Avalanche Builder Account. This will allow you to easily access many features of Builder Hub. You can complete the course without a Builder Account, but it will be much more convenient to have one. ### Benefits of a Builder Account - **Faucet**: With a Builder Account, you can claim testnet AVAX on the C-Chain and P-Chain right from the Builder Console without the need of a coupon code or holding a mainnet balance. - **Free Managed Testnet Infrastructure**: With a Builder Account, we will provide free managed testnet nodes and ICM relayers for your L1. This infrastructure is not suitable for production use, but it is great for testing and development. # Install Core Wallet (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/02-connect-core) --- title: Install Core Wallet description: Learn how to install the Core wallet browser extension and create a wallet. updated: 2025-03-13 authors: [owenwahlgren] icon: Wallet --- In this section you will learn how to set up Core wallet and get some testnet AVAX on the P-Chain so you can launch your first L1. ### Download Core Wallet If you don't have Core Wallet installed already, download the Core Extension for Chrome: [Core Wallet Extension](https://chromewebstore.google.com/detail/core-crypto-wallet-nft-ex/agoakfejjabomempkjlepdflaleeobhb) Core is the only wallet that supports issuing P-Chain transactions, so it is not possible to use other wallets such as MetaMask or Rabby. ### Create a Wallet in Core Create a new wallet in Core by clicking the `Continue with Google` or by manually creating a new Wallet. Congratulations! You have successfully set up your Core wallet. # Claim Testnet Tokens (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/02a-claim-testnet-tokens) --- title: Claim Testnet Tokens description: Learn how to connect Core wallet and claim testnet AVAX. updated: 2025-03-13 authors: [owenwahlgren] icon: Coins --- Connect your Core wallet below to claim testnet AVAX on the C-Chain and P-Chain. With a Builder Hub account, **tokens are automatically sent to your wallet** - no manual claims or coupon codes needed! **Automated Faucet:** Once you connect your wallet with a Builder Hub account, testnet tokens are automatically sent to your wallet when needed. You can also manually request tokens using the buttons above. ## Alternative Faucet If you don't want to create a [Builder Hub Account](https://build.avax.network/login), you can use the external [Avalanche Faucet](https://core.app/tools/testnet-faucet/?subnet=c&token=c) with coupon code `avalanche-academy` or `avalanche-academy25` to get 2 AVAX on the C-Chain. After you have claimed some AVAX on the C-Chain, you can bridge it to the P-Chain using this tool: # Network Architecture (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/03-network-architecture) --- title: Network Architecture description: Learn about the network architecture of Avalanche and the role of the P-Chain. updated: 2025-03-13 authors: [owenwahlgren] icon: BookOpen --- To create an L1 you need to follow these steps: 1. Create a Subnet record on the P-Chain with the `CreateSubnet` transaction 2. Add one or more chains to the Subnet with the `CreateChain` transaction 3. Convert the Subnet to an L1 and add the initial validators with the `ConvertSubnetToL1` transaction Let's dive into what that means: ## Validators in a Multi-Chain Network Validators are nodes of a blockchain that secure the network by validating the transactions. Each L1 in the Avalanche network has it's own set of validators that is running the `AvalancheGo` client. L1 Creation ## Platform Chain The Platform Chain is the backbone for the native interoperability of the Avalanche network. It is a registry of all validators in the Avalanche network. This includes the validators of the Primary Network (including the C- and P-Chain), as well as all L1s and legacy Subnet validators. For each validator the P-Chain stores the following information: - A unique node ID identifying the validator - A BLS Public Key - The Stake Weight - The Balance of the Validator for the continous interoperability fee following graphic shows a simplified data model of the P-Chain: P-Chain Architecture Builders can create new L1 blockchains in the Avalanche Network by issuing transactions on the P-Chain. The P-Chain runs a special-purpose virtual machine called the [platformvm](https://github.com/ava-labs/avalanchego/tree/master/vms/platformvm). It is not EVM-based and therefore to interact with it you need a compatible wallet like Core wallet. Creating new records for L1 blockchains on the P-Chain is done by issuing transactions like the `CreateSubnetTx`. The P-Chain is secured by the Primary Network validators. L1 validators are syncing the P-Chain, meaning they always have the latest view of the validator set of all blockchains in the Avalanche network, but are not participating in the consensus of the P-Chain. ## Subnets When the Avalanche network was created the architecture included the concepts of Subnets. Subnets are blockchains that were validated by a *subset of the Primary Network validators*. Each Primary Network validator can be a member of multiple subnets, and each Subnet can have multiple validators. Since Primary network validators have to fullfil the Primary Network staking requirements of `2,000 AVAX`, this was also necessary for every validator that was validating a Subnet. There was no option to opt-out of validating the Primary Network. Primary Network

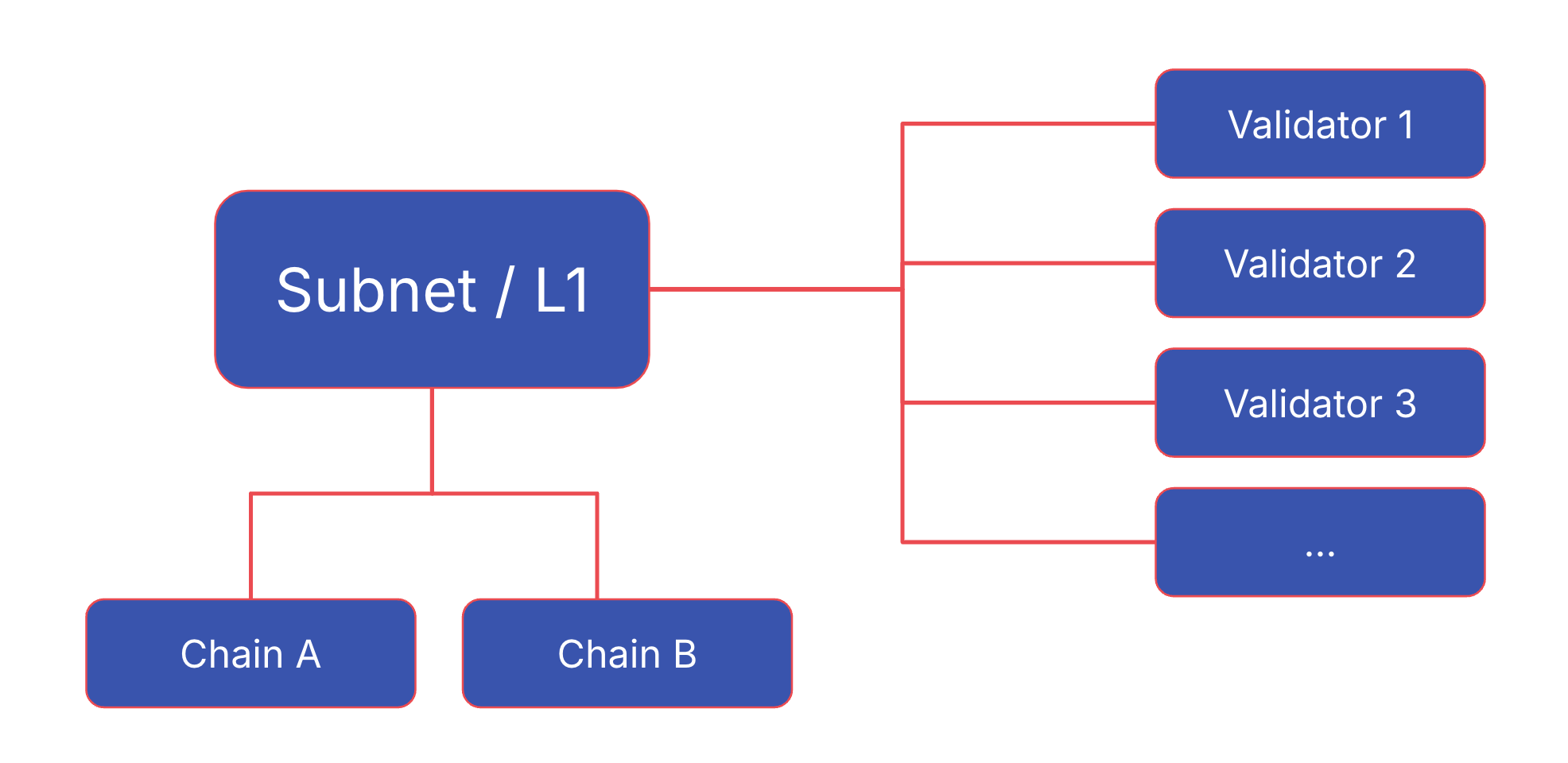

Architecture While the concept of Subnets is still supported in the Avalanche network, it is recommended to launch new blockchains as L1s to take advantage of the benefits outlined earlier. Since the naming of Subnets is deep enshrined in the Avalanche network, you will still see it sometimes in the code or the transaction names. # Create a Blockchain (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/05-create-blockchain) --- title: Create a Blockchain description: Learn how to configure a blockchain and create a record for it on the P-Chain by issuing a CreateChainTx transaction using the Builder Tooling. updated: 2025-03-13 authors: [owenwahlgren] icon: SquareMousePointer --- Now that you have Core wallet set up and some AVAX on the P-Chain you can create a Subnet. You will do this by issuing a `CreateSubnetTx` transaction. This will create a Subnet that is uniquely identified by the transaction hash of the `CreateSubnetTx` transaction. The `CreateSubnetTx` transaction only has a single parameter: The owner of the Subnet. The owner can add blockchains to the Subnet and convert it to an L1. With the conversion to an L1 the owner will loose it's privileges. Therefore, the owner is only relevant during the creation time and does not have to be secured by a mulit-sig if a immediate conversion to an L1 is planned. We will just use your P-Chain address as the owner. Then you will issue the `CreateChainTx` on the P-Chain to create the blockchain record. The `CreateChainTx` transaction as the following parameters: - `name`: The name of the chain - `subnetID`: The ID of the Subnet you want to add the chain to - `vmID`: The ID of the Virtual Machine that will be used to run the chain. - `genesisData`: The genesis configuration of the chain The Genesis Builder tool allows us to configure many aspects of the blockchain like permissioning, it's tokenonomics and the transaction fee mechanism. Feel free to browse through the different configuration options, but for now don't change any of the defaults and just click the `View Genesis JSON` button. Then click `Create Chain` This will create the P-Chain record for your blockchain and associate it with the Subnet created in the previous step. The blockchain will be uniquely identified by the transaction hash of the `CreateChainTx` transaction. Congratulations! You have successfully created a blockchain record on the P-Chain. The blockchain does not have any validator nodes yet, so we can't connect our wallet to it or issue any transactions just yet. You will learn how to do that in the next section. # Set up Validator Nodes (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/06-run-a-node) --- title: Set up Validator Nodes description: Learn how to deploy validator nodes for your L1 using managed infrastructure or self-hosted Docker deployments. updated: 2025-03-19 authors: [owenwahlgren] icon: Terminal --- import AvalancheGoDocker from "@/components/toolbox/console/layer-1/AvalancheGoDockerL1"; import ToolboxMdxWrapper from "@/components/toolbox/academy/wrapper/ToolboxMdxWrapper.tsx"; Now that the P-Chain records are set up, you can start syncing the node with your Subnet. ## Run Your L1 Node Use our free managed testnet infrastructure to instantly deploy a node for your L1, no need for Docker or Cloud Provider account set up with credits. Enjoy the benefits of: - Instant deployment with one click - Automatic configuration for your Subnet - Free for testnet development - Monitor and manage through the [Builder Console](/console/testnet-infra/nodes) Managed nodes automatically shut down after 3 days. For production or extended testing, see the self-hosted option below. ## Optional Alternative: Self-Hosted Infrastructure The free managed testnet nodes are a great option for playing around with Avalanche L1s, but are not intended for running on production environments. They are shut down automatically after 3 days. If you want to test out your production environment, running beyond 3 days, or anything more complex you should run nodes on your own infrastructure using Docker: # Convert a Subnet to an L1 (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/07-convert-subnet-l1) --- title: Convert a Subnet to an L1 description: Learn how to convert a Subnet to an L1 on the P-Chain by issuing a ConvertSubnetToL1Tx transaction using the Builder Tooling. updated: 2025-03-13 authors: [owenwahlgren] icon: SquareMousePointer --- The node you have just launched is tracking the Subnet but is not yet a validator. In fact, since the Subnet does not have any validators yet it cannot process any transactions. In this step we will do two things at once: 1. Convert the Subnet to an L1 2. Add your node as a validator Converting a Subnet to an L1 requires the Subnet owner issuing a `ConvertSubnetToL1Tx` transaction on the P-Chain. This transaction establishes a new validator set for your blockchain and transforms it from a Subnet into a sovereign L1 chain. The `ConvertSubnetToL1Tx` transaction is a one-time transaction that can only be executed once by the Subnet owner(s). After the conversion the subnet owner looses all privileges and the L1 is controlled by a validator manager contract, that manages the validator set. You will learn more about this in the next chapter. The `ConvertSubnetToL1Tx` has the following parameters: - **Subnet ID** - The unique identifier of your Subnet - **Validator Manager Blockchain ID** - The ID of the blockchain where the Validator Manager contract will be deployed. This blockchain can belong to the L1, be the C-Chain or belong to any other L1 in the Avalanche network - **Validator Manager Address** - The address of the contract on that blockchain - **Validators** - The initial set of validators for the L1 The **Validator Manager Address** is initially set to an OpenZeppelin [TransparentUpgradeableProxy](https://docs.openzeppelin.com/contracts/4.x/api/proxy) contract pre-deployed in the `genesis.json`. After conversion, you'll deploy the actual `ValidatorManager` implementation contract and update the proxy to point to it. ## Conversion Tool Use the following tool to convert your Subnet to an L1: # Test your L1 (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/08-test-l1) --- title: Test your L1 description: Test your freshly created L1 by deploying an ERC-20 using the Builder Tooling. updated: 2025-03-13 authors: [martineckardt] icon: SquareMousePointer --- Congratulations! You have successfully created your own L1. Now, let's deploy an ERC-20 token on your L1 and test it. You have just launched your own blockchain on Avalanche and already deployed your first token on it. In this following chapters you will learn more on how you can tailor your L1 to your applications needs. # Remove Node (/academy/avalanche-l1/avalanche-fundamentals/04-creating-an-l1/09-remove-node) --- title: Remove Node description: Learn how to stop and remove a node running on Docker. updated: 2025-03-19 authors: [martineckardt] icon: Terminal --- Now that you have tested your L1, you can stop and remove the node. This is useful if you want to free up resources or if you want to start a new node with different parameters. ### Stop Node To stop the node, you can use the following command: ```bash docker stop avago ``` The node credentials and the blockchain state is persisted in the `~/.avalanchego` directory. When you restart the node with `docker start avago` it will pick up where it left off. ### Remove Node ```bash docker rm avago ``` This will not remove the state and credentials of the node. To remove these you need to delete the `~/.avalanchego` directory. # Introduction (/academy/avalanche-l1/avalanche-fundamentals/05-interoperability/01-introduction) --- title: Introduction description: Learn about interoperability in the Avalanche ecosystem and its importance in multichain systems updated: 2024-08-26 authors: [martineckardt, nicolasarnedo] icon: Book --- Now that we know about [Avalanche's Multichain Architecture](/academy/avalanche-l1/avalanche-fundamentals/03-multi-chain-architecture-intro/01-multi-chain-architecture) it is important we understand how we achieve **native interoperability** between all of these chains. ## What is Interoperability Interoperability refers to the ability of different blockchain networks to communicate, share data, and interact with each other seamlessly. This capability allows assets, information, and functionalities to move between separate blockchain ecosystems without the need for intermediaries. These interactions can take many forms, including: - Asset Bridging (Tokens, NFTs, etc.) - DAO Voting across Chains - Cross-Chain Liquidity Pools - Decentralized Data Feeds - Cross-Chain Smart Contract Calls ## Why Interoperability Matters Without interoperability, blockchains face significant challenges: - **Lack of Liquidity**: New blockchains struggle to attract sufficient liquidity for tokens and financial instruments, limiting their viability and user adoption. - **Limited Developer Adoption**: Developers are hesitant to build on new blockchains without access to existing tools, communities, and infrastructure from established networks. - **Restricted User Access**: Users face barriers entering new blockchains due to lack of direct on-ramp services and limited asset availability. ## How Avalanche Achieves Interoperability Avalanche enables native cross-chain communication through a layered approach: ### Avalanche Warp Messaging (AWM) The foundational protocol that enables L1s to exchange authenticated messages. AWM leverages BLS multi-signatures where validators sign outgoing messages, and these signatures are aggregated for efficient verification on the destination chain. ### Interchain Messaging Contracts (ICM) Smart contracts that provide a developer-friendly interface on top of AWM. They handle message encoding/decoding, relayer incentives, and cross-chain dApp communication patterns. ### Interchain Token Transfer (ICTT) Built on Interchain Messaging contracts, ICTT enables asset transfers between L1s by locking tokens on the source chain and minting representations on the destination chain. ## What You'll Learn In this section, we'll explore: 1. **Interoperability Fundamentals** - Understanding the core concepts and use cases 2. **Securing Cross-Chain Communication** - Cryptographic foundations including BLS signatures 3. **Avalanche's Interoperability Solutions** - Deep dive into AWM and ICTT protocols 4. **Practical Implementation** - How these technologies work together in real applications Let's begin by understanding the fundamental concepts that make secure cross-chain communication possible. # Source, Message and Destination (/academy/avalanche-l1/avalanche-fundamentals/05-interoperability/02-source-message-destination) --- title: Source, Message and Destination description: Learn about interoperability and it's importance in multichain systems. updated: 2024-05-31 authors: [martineckardt] icon: BookOpen --- Interoperability is achieved by enabling blockchains to pass messages to one another. Each message originates from a source chain and is sent to one or more destination chains. These messages encode arbitrary data that can attest some event on the source chains, such as the deposit of an asset or the result of a vote.
![](/common-images/teleporter/source.png) # Source - Origin of communication - Sender calls contract
![](/common-images/teleporter/message.png) # Message - Contains source, destination, and encoded data - Signature guarantees authenticity
![](/common-images/teleporter/destination.png) # Destination - Submission of message as transaction - Verifies signatures
## Source Chain The source chain in a cross-blockchain communication system refers to the original blockchain where data, assets, or information originate before being communicated to another blockchain. It acts as the starting point for initiating cross-chain interactions. When a user intends to communicate with another blockchain, they utilize protocols or smart contracts to initiate the communication process from the source chain. ## Message The message is the data structure that will be sent to to the destination chain. It contains some metadata, the encoded message, and a signature. The signature attests the authenticity of the message, meaning that whatever the message claims has actually happened on the source chain. ## Destination Chain Conversely, the destination chain is the recipient blockchain where the communicated data, assets, or instructions will be received and processed. Validators, nodes, or protocols associated with the cross-blockchain communication system on the destination chain receive and authenticate the information relayed from the source chain. Once validated, the destination chain processes the data or executes the specified instructions. # ICM, ICM Contracts & ICTT (/academy/avalanche-l1/avalanche-fundamentals/05-interoperability/03-icm-icmContracts-and-ictt) --- title: ICM, ICM Contracts & ICTT description: Learn how Avalanche implements secure interoperability with ICM, ICM Contracts (Teleporter), and ICTT updated: 2025-07-21 authors: [nicolasarnedo] icon: BookOpen --- We can look at Avalanche's Native Interoperability with a layered approach, each step guaranteeing that our message is securely sent across systems. In order to understand the fundamentals of cross-chain messaging, here are 5 concepts that we will be covering in this chapter that make it possible: 1. **Secure Signatures** - The foundation that ensures messages can be trusted 2. **ICM (Interchain Messaging)** - Native blockchain feature that enables cross-chain communication 3. **ICM Contracts** - Developer-friendly tools that make building cross-chain apps easier 4. **ICTT (Interchain Token Transfer)** - Ready-to-use solution for moving tokens between chains *(not always used)* 5. **Relayers** - service that helps deliver messages between chains by collecting signatures and submitting transactions ![Interchain Messaging Layers](/common-images/avalanche-fundamentals/InterchainMessagingLayers+Relayer.png) Knowing the components is the first piece of the puzzle, grasping how they interact with each other is the next step. In the next image we can see ## Interchain Messaging (ICM) ICM is the foundation of cross-chain communication on Avalanche. It's built directly into every Avalanche blockchain, making it a native feature rather than an add-on. ### What ICM Does Think of ICM as a built-in postal system for blockchains: - **Creates Messages**: Smart contracts can create messages to send to other blockchains - **Signs Messages**: Validators sign these messages to prove they're authentic - **Verifies Messages**: Destination blockchains can verify that messages are genuine ### The Warp Precompile At the heart of ICM is the "warp precompile" - a special smart contract that comes pre-installed on every Avalanche blockchain. Unlike regular smart contracts that developers deploy, this one is built into the blockchain software itself (and is written in go unlike most smart contracts that are in solidity). ### Simple Message Flow ![Interchain Messaging Flow](/common-images/avalanche-fundamentals/InterchainMessagingExampleFlow.png) 1. A smart contract creates a message using the warp precompile 2. The blockchain emits an event saying "I have a message to send" 3. Validators sign this message to prove it's legitimate 4. A relayer picks up the message and signatures 5. The relayer delivers everything to the destination blockchain 6. The destination blockchain verifies the signatures and accepts the message ## ICM Contracts (Teleporter) While ICM provides the basic messaging capability, developers need an easier way to use it. That's where ICM Contracts come in - specifically a contract called "Teleporter". ### What Teleporter Does Teleporter is like a user-friendly interface for ICM: - **Simple Functions**: Instead of complex operations, developers just call `sendCrossChainMessage()` - **Message Management**: Automatically handles encoding, tracking, and delivering messages - **Fee Handling**: Manages payments to relayers for delivering messages - **Security**: Prevents messages from being delivered twice or replayed ### Why Developers Use Teleporter - It's deployed at the same address on every blockchain - It handles all the complex parts of cross-chain messaging - It provides a standard way for contracts to communicate across chains - It makes building cross-chain applications much simpler ## Relayers Relayers are the delivery service of the cross-chain messaging system. They're responsible for physically moving messages from one blockchain to another. ### What Relayers Do 1. **Monitor Blockchains**: Watch for new cross-chain messages 2. **Collect Signatures**: Gather validator signatures that prove a message is valid 3. **Submit Transactions**: Create and submit the transaction on the destination blockchain 4. **Pay Gas Fees**: Cover the transaction costs on the destination chain (and get reimbursed) ### Key Points About Relayers - Anyone can run a relayer - it's permissionless - Relayers need wallets with tokens on destination chains to pay for gas - They can be configured to handle specific routes or all messages - They're incentivized through fee mechanisms built into Teleporter ## ICTT: An Example Cross-Chain Application ICTT (Interchain Token Transfer) is not a core component of cross-chain messaging - it's an application built on top of ICM, Teleporter, and relayers. Think of it as one of many possible cross-chain applications. ### What ICTT Does ICTT is a pre-built solution specifically for moving tokens between blockchains: - **Token Home**: Manages the original tokens on their native blockchain - **Token Remote**: Creates wrapped versions of tokens on other blockchains - **Transfer Logic**: Handles locking, minting, burning, and releasing tokens ### Why ICTT is Special While anyone could build their own token bridge using ICM and Teleporter, ICTT provides: - A tested, secure implementation - Standard contracts that work the same way everywhere - Support for both native tokens and ERC-20 tokens - Advanced features like "send and call" for composability Think of ICTT like a pre-built e-commerce platform - you could build your own, but using the existing solution saves time and reduces risk. ## Summary Avalanche's cross-chain messaging system works like a well-coordinated postal service: **The Core Components:** - **ICM**: The built-in messaging system in every blockchain - **ICM Contracts (Teleporter)**: The easy-to-use interface for developers - **Relayers**: The delivery service that moves messages between chains **Why It Works So Well:** - **Trust**: Messages are secured by the same validators that run the blockchains - **Simplicity**: Developers can send messages with just a function call - **Flexibility**: Anyone can build cross-chain applications (like ICTT for tokens) - **Speed**: Messages are delivered in seconds, not minutes or hours This design means developers can focus on building their applications instead of worrying about the complex infrastructure of cross-chain communication. ## What Powers This System? Now that we understand how messages travel from one blockchain to another, you might wonder: what makes this system secure? How do we know a message really came from the source blockchain and hasn't been tampered with? The answer lies in cryptographic signatures - the digital equivalent of a tamper-proof seal. In the next sections, we'll explore: - How validators create these digital signatures - Why multiple signatures make the system secure - How signatures can be efficiently combined and verified Understanding these concepts will complete your knowledge of how Avalanche achieves secure, native interoperability. For hands-on practice with cross-chain messaging, check out the [Academy Interchain Messaging](/academy/interchain-messaging) course. # Signature Schemes (/academy/avalanche-l1/avalanche-fundamentals/05-interoperability/04-signature-schemes) --- title: Signature Schemes description: Learn how Signature Schemes work and enable secure cross-chain communication updated: 2024-05-31 authors: [martineckardt] icon: BookOpen --- import SignatureSchemes from "@/content/common/cryptography/signature-schemes.mdx" import defaultMdxComponents from "fumadocs-ui/mdx"; # Use a Signature Scheme (/academy/avalanche-l1/avalanche-fundamentals/05-interoperability/05-signature-demo) --- title: Use a Signature Scheme description: Hands-on demonstration of BLS signature schemes updated: 2024-05-31 authors: [martineckardt] icon: Terminal --- import SignatureSchemesDemo from "@/content/common/cryptography/signature-schemes-demo.mdx" # Multi-Signature Schemes (/academy/avalanche-l1/avalanche-fundamentals/05-interoperability/06-multi-signatures) --- title: Multi-Signature Schemes description: Learn how multiple signatures provide Byzantine fault tolerance updated: 2024-05-31 authors: [martineckardt] icon: BookOpen --- import MultiSignatureSchemes from "@/content/common/cryptography/multi-signature-schemes.mdx" # Use Multi-Signature Schemes (/academy/avalanche-l1/avalanche-fundamentals/05-interoperability/07-multi-signature-demo) --- title: Use Multi-Signature Schemes description: Hands-on demonstration of multi-signature schemes with BLS updated: 2024-05-31 authors: [martineckardt] icon: Terminal --- import SignatureSchemesDemo from "@/content/common/cryptography/multi-signature-schemes-demo.mdx" # BLS Signature Aggregation (/academy/avalanche-l1/avalanche-fundamentals/05-interoperability/08-signature-aggregation) --- title: BLS Signature Aggregation description: Learn how signature aggregation enables efficient multi-party verification updated: 2024-05-31 authors: [martineckardt] icon: BookOpen --- import SignatureKeyAggregation from "@/content/common/cryptography/signature-key-aggregation.mdx" import defaultMdxComponents from "fumadocs-ui/mdx"; # Use Cases (/academy/avalanche-l1/avalanche-fundamentals/05-interoperability/09-use-cases) --- title: Use Cases description: Learn about the practical applications of interoperability on Avalanche updated: 2024-08-26 authors: [owenwahlgren] icon: BookOpen --- Interoperability enables various use cases that enhance user experience and expand the Avalanche ecosystem's capabilities. Let's explore the key applications: ## 1. Cross-Chain Token Transfers Tokens can be seamlessly transferred across different L1 blockchains without centralized exchanges: - **Seamless Transfers**: Move tokens (like USDC) between chains with minimal fees and fast transaction times - **Liquidity Access**: Leverage liquidity from various networks for DeFi activities, trading, or payments - **Decentralization**: Maintain control over assets during transfers without third-party intermediaries ## 2. Decentralized Data Feeds Smart contracts can access reliable price feeds and other data from specialized oracle chains: - **Chainlink Integration**: Utilize real-time price data to power DeFi applications - **Trustless Access**: Obtain data directly from decentralized oracles - **Cross-Chain Applications**: Build financial applications that rely on consistent data across networks ## 3. Cross-Chain Token Swaps Direct token swaps between different blockchain networks without centralized exchanges: - **Decentralized Exchange**: Swap assets in a trustless environment - **Multi-Chain Access**: Access tokens from various ecosystems - **Lower Costs**: Avoid high fees of centralized platforms ## 4. Cross-Chain NFTs NFTs can be transferred and utilized across different blockchain networks: - **Broad Exposure**: NFTs can be showcased and traded across multiple chains - **Enhanced Utility**: Use NFTs in gaming, art, and virtual worlds across platforms - **Ownership Preservation**: Maintain authenticity and provenance across chains ## 5. Interoperable DeFi Protocols DeFi protocols can interact across chains for enhanced functionality: - **Cross-Chain Yield Farming**: Maximize returns across multiple chains - **Cross-Chain Collateralization**: Use assets from any chain as collateral - **Composability**: Build innovative financial products leveraging multiple networks ## 6. Cross-Chain Governance Decentralized governance that spans multiple blockchains: - **Unified Governance**: Govern multi-chain protocols from a single platform - **Decentralized Voting**: Enable participation from token holders on different chains - **Enhanced Participation**: More diverse and representative decision-making ## Real-World Example: Gaming Consider a gaming ecosystem where: - Game assets (NFTs) are minted on one L1 optimized for low fees - The game logic runs on another L1 optimized for high throughput - Rewards are distributed on a third L1 with established DeFi infrastructure Interoperability makes this seamless for users who can play, trade, and earn across all chains without friction. # Independent Tokenomics (/academy/avalanche-l1/avalanche-fundamentals/07-independent-tokenomics/01-independent-tokenomics) --- title: Independent Tokenomics description: Quickly recap our past learnings about Avalanche Custom Blockchains. updated: 2024-06-28 authors: [usmaneth] icon: Book --- Avalanche Custom Blockchains offer multiple ways to implement independent tokenomics. This gives developers more control and can enable new business models that would not be economically feasible on single-chain systems. The customizations include: - **Native Token:** Every Avalanche L1 has its own native token used for paying transaction fees. - **Transaction Fees:** We can configure how the transaction fees should be calculated. - **Initial Native Token Allocation:** We can specify how the inital token supply is distributed. - **Native Token Minting Rights:** We can specify if and who can mint more native tokens. - **Staking Token:** If our Avalanche L1 allows public and permissionless validation, we can define our logic how a node can become a validator. You will learn about all these topics and get hands-on experience how you can configure the tokenomics of your own custom blockchain. # Staking Token (/academy/avalanche-l1/avalanche-fundamentals/07-independent-tokenomics/11-staking-token) --- title: Staking Token description: Learn about staking tokens in blockchain networks. updated: 2024-06-28 authors: [usmaneth] icon: BookOpen --- In many networks, such as Ethereum, the same token is used for staking and paying for gas. In the Avalanche network staking tokens and gas tokens can be separated, since they fullfil different purposes within the blockchain ecosystem. Staking tokens are used for securing public permissionless Avalanche L1s through a proof-of-stake (PoS) consensus mechanism. Holders of staking tokens can run validators and participate in the consensus process by staking a certain amount of tokens as collateral. Validators propose and validate new blocks of your L1 blockchain. Staking tokens play a crucial role in maintaining network security and incentivizing their participation. Not all Avalanche L1s are public and permissionless. Many enterprises choose a Proof-of-Authority setup, where the validators are selected by the enterprise. These blockchains do not have a staking token. You will learn about setting up Proof-of-Stake in the L1 Validator Management course. # Introduction to VM Customization (/academy/avalanche-l1/avalanche-fundamentals/07b-vm-customization/00-vm-customization) --- title: Introduction to VM Customization description: Learn about customizing Virtual Machines. updated: 2024-05-31 authors: [ashucoder9] icon: Book --- For some use cases, it may be necessary to use a customized VM too. This is the case if an application cannot be built on a regular EVM on the C-Chain, or if it would result in gas costs too high to be economical for its users or creators. Depending on a builder's needs, Avalanche allows for different VM customizations: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/32-BJ1Orj9c9p0VxpSTUJlWH1jPvo8nlD.png) Customizing the EVM on the Ethereum network is difficult, requiring a wide consensus that the proposed change is mutually beneficial for all network participants. This can make customizations for unique use cases challenging, if not impossible. Additionally, Ethereum doesn't give users the option to add different chains. In Avalanche, every Avalanche L1 has autonomy over their Virtual Machines. Their creators can customize VMs to fit their unique requirements. This is one of the biggest advantages of multi-chain systems. In this section, we will see the three way to customize Virtual Machines at a high level. In later courses, we will dive deeper and learn how to actually customize each. # VM Configuration (/academy/avalanche-l1/avalanche-fundamentals/07b-vm-customization/01-configuration) --- title: VM Configuration description: Learn about customizing Virtual Machines. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- When building a VM, it is possible to define certain parameters that can change the behavior of the VM. In our soda dispenser analogy these may be the products and prices offered by the dispenser. We might want to have two dispenser blockchains that offer different products and prices. If the VM is built in a way that it has parameters for the products and prices, it can be easily reused for different use items. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/33-AibP9P6YHVSun8IyXBAkKAJMeXVLqp.png) This is a massive advantage over one-chain-fits-all systems, where the parameters have to be a compromise between all network participants. In Avalanche it is possible to have different blockchain with the same VM, but different parameters. Using VM Configuration we can easily create EVM-chains for different use cases such as trading a cheap gaming NFT or valuable Real estate on chain. These blockchains may differ in fees (low fees for cheap NFTs, high fees for valuable goods) and security levels (low security for cheap NFTs, high security for valuable goods). Examples of the configurable parameters of the subnetEVM include: **trxAllowList:** Define a whitelist of accounts that restrict which account's transactions are accepted by the VM. **contractDeployerAllowlist:** Defined a whitelist of accounts that restricts which account can deploy contracts on the blockchain Using these parameters we can adapt the VM to our requirements without writing a single line of code. This is by far the easiest, but also least flexible way to customize a VM to one's requirements. ```json { "config": { "chainId": 99999, "homesteadBlock": 0, "eip150Block": 0, "eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0", "eip155Block": 0, "eip158Block": 0, "byzantiumBlock": 0, "constantinopleBlock": 0, "petersburgBlock": 0, "istanbulBlock": 0, "muirGlacierBlock": 0, "subnetEVMTimestamp": 0, "feeConfig": { "gasLimit": 20000000, "minBaseFee": 1000000000, "targetGas": 100000000, "baseFeeChangeDenominator": 48, "minBlockGasCost": 0, "maxBlockGasCost": 10000000, "targetBlockRate": 2, "blockGasCostStep": 500000 }, "contractDeployerAllowListConfig": { "blockTimestamp": 0, "adminAddresses": [ "0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC" ] } }, "alloc": { "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { "balance": "0x52B7D2DCC80CD2E4000000" }, "0x0Fa8EA536Be85F32724D57A37758761B86416123": { "balance": "0x52B7D2DCC80CD2E4000000" } }, "nonce": "0x0", "timestamp": "0x0", "extraData": "0x00", "gasLimit": "0x1312D00", "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000" } ``` You can find more examples of Genesis files [here](https://github.com/ava-labs/subnet-evm/tree/master/tests/precompile/genesis). # VM Modification (/academy/avalanche-l1/avalanche-fundamentals/07b-vm-customization/02-modification) --- title: VM Modification description: Learn about modifying Virtual Machines. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- The next more powerful way to customize a VM is VM Modification. To meet our requirements, we can modify and extend our existing VM. In our soda dispenser analogy, we might want to customize our soda dispenser to accept card payments. Our current soda dispenser machine simply does not have this feature. Instead of reinventing the wheel and building a new dispenser with the new feature from the ground up, we simply extend the existing VM using a plugin. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/34-C4A2siQ7sVC3E0NAYfJ60Kr6AJDVQA.png) In Avalanche, creating modified VMs is straightforward. The subnetEVM for instance can be customized through the development of plugins as well as precompiles. # VM Creation (/academy/avalanche-l1/avalanche-fundamentals/07b-vm-customization/03-creation) --- title: VM Creation description: Learn about creating Virtual Machines. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- For some use cases it might be necessary to create entirely new VMs. In our analogy this would be the case if we require completely different features, let's say we want to build a car VM. There is simply no way we can configure or extend a soda dispenser to turn it into a car. Instead we have to build a new VM from ground up. These newly created VMs can cater to much more specialized use cases and therefore this enables completely new blockchain applications not possible before. VM Creation is by far the most complex way, but also the most powerful way to customize a VM. It requires a deep understanding of the blockchain space and software development skill. There might be certain basic elements in most VMs, such as the notion of transaction, accounts and authentication. Therefore, Avalanche provides some SDKs, such as the HyperSDK, to make the creation of VMs in languages like Go and Rust easier. When creating a VM, there are two very distinct design patterns, that greatly vary in their intended use case. ## Special Purpose VMs Special Purpose VMs are highly optimized for a specific use case. They only allow a very limited set of operations closely knit to its use case. A popular example for this would be the VM of the Bitcoin blockchain. The operations are much more limited than the ones of the Ethereum Virtual Machines, hence it only allows transactions related to the transfer of BTC. ## General Purpose General Purpose VMs introduce another layer - commonly know as Smart Contracts or Programs - that can be submitted to the VM and enable user of the chain to interact with these. This way it allows its users to introduce their own logic to the VM. The most common General Purpose VM is the Ethereum Virtual Machine (EVM). However, some Avalanche L1s creators might want to create a VM that utilizes another language, such as Move, instead of Solidity as its smart contract language. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/avalanche-fundamentals/35-ZGXXBzP8NzWvLQm5y1giGjRTfATKwO.png) One of the EVM's key features is its capability to execution of smart contracts in a deterministic and trustless manner, ensuring that the outcome of their execution is predictable and verifiable by all network participants. Developers can create decentralized applications and deploy them on the Ethereum blockchain. This enables a wide range of use cases including decentralized finance (DeFi), tokenization, supply chain management, and more. The EVM's flexibility, security, and compatibility have made it a fundamental component of the Ethereum ecosystem, powering a vibrant and rapidly evolving ecosystem of decentralized applications and services. # Permissioning (/academy/avalanche-l1/avalanche-fundamentals/08-permissioning-users/01-permissioning) --- title: Permissioning description: Learn about different ways of permissioning your Avalanche L1 blockchain. updated: 2024-06-28 authors: [usmaneth] icon: Book --- Permissioning your Avalanche L1 is an optional feature of having your own L1 blockchain. There may be many reasons why a blockchain creator may want to permission their network including these: - **Privacy and Confidentiality:** In industries where data privacy is crucial, such as finance or healthcare, permissioned blockchains allow only authorized parties to access sensitive information. This ensures that confidential data remains protected from unauthorized access. - **Regulatory Compliance:** Many industries are subject to strict regulatory requirements regarding data handling and security. Permissioned blockchains enable organizations to implement necessary controls to ensure compliance with regulatory standards without compromising the integrity of the blockchain. - **Cost-efficiency:** Restricting the usage of a blockchain to certain use cases may make it more cost efficient. Blockchain operators may be able to avoid transaction fee spikes caused events such as NFT drops by imposing restrictions. These permissions don't necessarily have to be administered by a centralized entity. There could also be a DAO in charge of determining who should be allowed to use the blockchain. In the upcoming lessons, you will learn about the different levels of Permissions and how they can be configured for your Avalanche L1. # Compliance (/academy/avalanche-l1/avalanche-fundamentals/08-permissioning-users/02-compliance) --- title: Compliance description: Learn how you can configure compliance for your Avalanche L1. updated: 2024-06-28 authors: [usmaneth] icon: BookOpen --- For institutions, reputational damage and legal complications could arise if their blockchain systems were inadvertently used for criminal activities. Regulatory bodies might impose penalties on such institutions if they were to fail to create sufficient controls to prevent these activities. Most institutions have nuanced compliance requirements. Therefore, many institutions need flexible blockchains that can meet these needs. ## Interacting with Criminal Actors In permissionless systems, the counterparty on a trade is unknown. If a user performs a swap on a decentralized exchange on a permissionless blockchain, such as Ethereum or the Avalanche C-Chain, the origin of funds that are received are mostly unknown. To solve this problem, each Avalanche L1 can restrict who can interact with the blockchain. Only a whitelist of accounts can issue transactions. One could build a blockchain where only accounts that went through a KYC process are permitted. ## Interacting with Illegal Services An additional risk to consider is that businesses may operate within an environment prone to illicit activities, or they may inadvertently become involved in such actions. In a permissionless system, any individual has the capability to deploy any contract, regardless of its compliance with the legal framework. Avalanche L1s can limit who deploys smart contracts on the blockchain. Consequently, those involved in the creation of contracts can be held accountable. This level of control reassures institutions, ensuring that all protocols they engage with are fully compliant with existing laws. Beyond compliance advantages, this approach helps to maintain a blockchain free from an excess of smart contracts that could otherwise congest the system. # Transaction Allowlist (/academy/avalanche-l1/avalanche-fundamentals/08-permissioning-users/04-tx-allowlist) --- title: Transaction Allowlist description: Learn how to restrict transactions to a specific set of addresses. updated: 2024-06-28 authors: [usmaneth] icon: BookOpen --- import TxAllowList from "@/content/common/evm-precompiles/transaction-allowlist.mdx"; # Activate Transaction Allowlist (/academy/avalanche-l1/avalanche-fundamentals/08-permissioning-users/05-activate-tx-allowlist) --- title: Activate Transaction Allowlist description: Learn how to activate the the transaction allowlist precompile in the genesis. updated: 2024-06-28 authors: [martineckardt] icon: Terminal --- Avalanche L1s do not implement permissioning by default. To enable permissioning, you need to activate the transaction allowlist precompile in the genesis. This allows only approved addresses to issue transactions on your blockchain. # Contract Deployer Allowlist (/academy/avalanche-l1/avalanche-fundamentals/08-permissioning-users/06-contract-deployer-allowlist) --- title: Contract Deployer Allowlist description: Learn how to restrict contract deployment to a specific set of addresses. updated: 2024-06-28 authors: [martineckardt] icon: BookOpen --- import ContractDeployerAllowlist from "@/content/common/evm-precompiles/contract-deployer-allowlist.mdx"; # Activate Contract Deployer Allowlist (/academy/avalanche-l1/avalanche-fundamentals/08-permissioning-users/07-activate-contract-deployer-allowlist) --- title: Activate Contract Deployer Allowlist description: Learn how to activate the contract deployer allowlist precompile in the genesis. updated: 2024-06-28 authors: [martineckardt] icon: Terminal --- Analogous to the transaction allowlist, Avalanche L1s do not implement contract deployer allowlist by default. To enable permissioning, you need to activate the contract deployer allowlist precompile in the genesis. This allows only approved addresses to deploy contracts on your blockchain. # Permissioning Validators (/academy/avalanche-l1/avalanche-fundamentals/09-permissioning-validators/01-permissioning-validators) --- title: Permissioning Validators description: Learn about different ways of permissioning your Avalanche L1 blockchain. updated: 2024-06-28 authors: [usmaneth] icon: Book --- The ability to control a blockchain's validator set has many benefits that can significantly enhance the efficiency, security, and governance of the network. It allows blockchain participants to have greater influence over the consensus process and decision-making, leading to a more robust and adaptable ecosystem. There are two ways to structure the validator set: - **Permissionless Validation:** Anyone can participate in the validation process and be rewarded in tokens to cover their costs for the hardware and running the validator. In Avalanche, we call Avalanche L1s that take this approach Elastic Avalanche L1s. - **Permissioned Validation:** Only whitelisted validators can validate the Avalanche L1. A permissioned Avalanche L1 can be turned into a Elastic Avalanche L1 at any time, but not the other way round. There are many reasons why the creators might want a permissioned validator set for their Avalanche L1. You will learn in detail about the technical options in the L1 Validator Management course. ## Enterprises and Corporations: Large enterprises and corporations often require blockchain solutions for their internal operations or specific industry use cases. A permissioned validator set allows them to control who can participate in the network and validate transactions. This is particularly relevant in industries with strict regulatory requirements, where entities need to ensure compliance and data privacy. ## Consortiums and Industry Associations: Consortiums or industry associations comprising multiple organizations with shared interests can benefit from a permissioned validator set. These entities often collaborate on initiatives requiring a distributed ledger, such as supply chain management, healthcare data sharing, or financial transactions. By establishing a permissioned validator set, the consortium can ensure that trusted participants from within the consortium validate the transactions. ## Government Agencies: Government entities may find value in launching a blockchain with a permissioned validator set to manage critical infrastructure, public services, or regulatory processes. They can select validators from trusted institutions or stakeholders to maintain control over the network while ensuring compliance with legal and governance requirements. Examples include land registry systems, voting platforms, or identity management solutions. ## Financial Institutions: Banks, payment processors, and other financial institutions could be interested in a permissioned validator set for blockchain solutions related to payments, remittances, or settlement systems. These institutions often require a level of control over the network to maintain regulatory compliance, prevent money laundering, and ensure adherence to Anti-Money Laundering (AML) regulations. # Private Blockchains (/academy/avalanche-l1/avalanche-fundamentals/09-permissioning-validators/02-private-blockchains) --- title: Private Blockchains description: Learn about different ways of permissioning your Avalanche L1 blockchain. updated: 2024-06-28 authors: [usmaneth] icon: BookOpen --- On a public blockchain, every transaction and change to the blockchain's state is visible to all. Anyone with internet access can see the transaction data. Block Explorers are one way to conveniently access the data on a chain. Although the identities of participants are often pseudonymous, the transaction data itself is open for anyone to see. However, there are many instances, especially in business or enterprise settings, where such transparency isn't desirable. A company might be conducting a high-value transaction that it doesn't want competitors or others in the market to see. There might also be legal or regulatory reasons for needing to keep transaction data private. In a private, permissioned blockchain, the visibility of transactions is limited to a select group of individuals or entities. This way, sensitive data isn't exposed. Only those who have been granted the necessary permissions can view the transaction data, and these permissions can be tightly controlled and monitored by network administrators. Further, transactions in a private blockchain can be encrypted, adding an extra layer of security. Even within the network, details about specific transactions can be hidden from certain participants, based on their level of permission. This allows for a much higher degree of confidentiality, as specific data can be revealed only on a need-to-know basis. In summary, privacy in the context of private, permissioned blockchains isn't just about restricting who can join. It's about having granular control over who can see what data, and when. It's about providing a secure, confidential environment where sensitive transactions can occur without the risk of exposure to unintended parties. This has made private, permissioned blockchains an attractive option for businesses and organizations dealing with sensitive data, high-value transactions, or strict confidentiality requirements. ## Private Blockchains The data of Avalanche L1s, by default, are publicly available. This means that every node can sync and listen to ongoing transactions/blocks in these blockchains, even if they're not validating the network. Nodes may do this for indexing purposes or just having access to the current state of the blockchain without relying on third-parties. Avalanche L1 validators can choose not to publish data from their blockchains. If a node sets `validatorOnly` to true, the node exchanges messages only with the blockchain's validators. Other peers won't be able to learn contents of this blockchain from their nodes. # Intain Markets Case Study (/academy/avalanche-l1/avalanche-fundamentals/09-permissioning-validators/03-case-study-intain-markets) --- title: Intain Markets Case Study description: Learn about Intain's permissioned Avalanche L1. updated: 2024-06-28 authors: [usmaneth] icon: Microscope --- Intain operates a structured finance platform. It has **IntainMARKETS**, a marketplace for tokenized asset-backed securities built as an Avalanche L1. The digital marketplace automates and integrates functions of key stakeholders in structured finance, including issuer, verification agent, underwriter, rating agency, servicer, trustee, and investor. Rather than replacing trust intermediaries, it integrates them onto a single platform to enable digital issuance and investment with a complete on-chain workflow. All parties work together in a transparent but private environment. ## Permissioned Validators and Tokenomics The **IntainMARKETS L1** also uses other ways to adhere to regulatory requirements. It has U.S-hosted infrastructure, which allows data to reside domestically, while validators chosen by network participants must also be verified U.S. entities and individuals. The Avalanche L1 economics are not dependent on any public token, and transaction costs are independent from those of the Avalanche C-Chain and other Avalanche L1s. Further Readings: [Intain Launch Announcement](https://medium.com/avalancheavax/intain-launches-avalanche-subnet-to-usher-in-new-era-for-multi-trillion-dollar-securitized-877c7cc1031f) # Introduction (/academy/avalanche-l1/icm-chainlink/01-access-chainlink-vrf-services/01-introduction) --- title: Introduction description: Learn how to use ICM to access Chainlink VRF services on L1 networks that do not have direct Chainlink support. updated: 2024-10-21 authors: [0xstt] icon: Book --- As decentralized applications (dApps) expand across multiple blockchains, some Layer 1 (L1) networks lack direct support from essential services like **Chainlink VRF (Verifiable Random Functions)**. This presents a significant challenge for developers who rely on verifiable randomness for use cases such as gaming, lotteries, NFT minting, and other decentralized functions that require unbiased, unpredictable random numbers. The challenge arises because not every L1 network has integrated with Chainlink, meaning developers on those chains are left without native access to VRF services. Without verifiable randomness, critical aspects of dApps, such as fairness and security, can be compromised. ### Why ICM is Necessary To address this gap, **Interchain Messaging (ICM)** provides a solution by allowing L1 networks that don’t have direct Chainlink support to still access these services. Through ICM, any blockchain can request VRF outputs from a Chainlink-supported network (e.g., Fuji) and receive the results securely on their own L1. This cross-chain solution unlocks the ability to use Chainlink VRF on unsupported networks, bypassing the need for native integration and ensuring that dApp developers can continue building secure and fair decentralized applications. In the following sections, we will explore how to use ICM to access Chainlink VRF services across different chains by deploying two key smart contracts: one on the Chainlink-supported network and another on the target L1. # Understanding the Flow (/academy/avalanche-l1/icm-chainlink/01-access-chainlink-vrf-services/02-understanding-the-flow) --- title: Understanding the Flow description: Learn how requests for random words flow across chains using ICM. updated: 2024-10-21 authors: [0xstt] icon: BookOpen --- import { Step, Steps } from 'fumadocs-ui/components/steps'; This section explains how random words are requested and fulfilled using Chainlink VRF across two different blockchains through **Interchain Messaging (ICM)**. The entire process involves several key components: the decentralized application (DApp), `CrossChainVRFConsumer`, `CrossChainVRFWrapper`, and `TeleporterMessenger`. Let’s walk through the flow step by step: ### DApp Submits Request for Random Words The DApp, running on an L1 without direct Chainlink support, initiates a request for verifiable randomness by interacting with the `CrossChainVRFConsumer` contract deployed on its chain. ### `CrossChainVRFConsumer` Sends Cross-Chain Message Once the DApp submits the request, the `CrossChainVRFConsumer` prepares a message containing the necessary VRF request parameters (such as `keyHash`, `request confirmations`, `gas limit`, etc.). This message is sent across chains via the `TeleporterMessenger` to the `CrossChainVRFWrapper` on the Chainlink-supported network (e.g., Fuji). ### `TeleporterMessenger` Receives Message & Calls `CrossChainVRFWrapper` 1. On the Chainlink-supported network, the `TeleporterMessenger` receives the cross-chain message sent by the `CrossChainVRFConsumer`. It passes the message to the `CrossChainVRFWrapper`, which is authorized to handle VRF requests. 2. The `CrossChainVRFWrapper` contract, deployed on the supported network, sends the request to **Chainlink VRF** for random words, using the parameters received in the message (e.g., `subscription ID`, `callback gas limit`, etc.). ### Chainlink VRF Fulfills Random Words Request 1. The **Chainlink VRF** fulfills the request and returns the random words to the `CrossChainVRFWrapper` contract by invoking its callback function. 2. Once the random words are received, the `CrossChainVRFWrapper` encodes the fulfilled random words and sends them back as a cross-chain message to the `CrossChainVRFConsumer` on the original L1. ### `TeleporterMessenger` Returns Random Words to `CrossChainVRFConsumer` The `TeleporterMessenger` on the original L1 receives the message containing the random words and passes it to the `CrossChainVRFConsumer`. ### `CrossChainVRFConsumer` Returns Random Words to the DApp Finally, the `CrossChainVRFConsumer` processes the random words and sends them to the DApp that originally requested them, completing the flow. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/interchain-messaging/cross-chain-vrf-NiG2EHgc4ulWBUx9Ekx0DZxTGdoHXk.png) This end-to-end process demonstrates how decentralized applications on unsupported L1 networks can request verifiable randomness from Chainlink VRF, leveraging **ICM** to handle cross-chain communication. # Orchestrating VRF Requests Over Multiple Chains (Wrapper) (/academy/avalanche-l1/icm-chainlink/01-access-chainlink-vrf-services/03-orchestrating-vrf-requests) --- title: Orchestrating VRF Requests Over Multiple Chains (Wrapper) description: Learn how the CrossChainVRFWrapper contract on a Chainlink-supported L1 handles cross-chain requests for VRF. updated: 2024-10-21 authors: [0xstt] icon: BookOpen --- import { Step, Steps } from 'fumadocs-ui/components/steps'; The `CrossChainVRFWrapper` contract plays a critical role in handling requests for randomness from an unsupported L1. It is deployed on a **Chainlink-supported network** (like Avalanche Fuji) and serves as the intermediary that interacts with Chainlink VRF to request random words. Here’s how it functions as the provider for VRF services: ## Receives Cross-Chain Messages When the `CrossChainVRFConsumer` on the unsupported L1 initiates a request for randomness, it sends a cross-chain message via the `TeleporterMessenger` to the `CrossChainVRFWrapper` on the supported network. The `CrossChainVRFWrapper` verifies that the request came from an authorized address. This is essential to ensure that only verified consumers can request randomness. Upon receiving a valid request, the **VRFWrapper** calls **Chainlink VRF** and sends the request with the required parameters, such as the number of random words, request confirmations, and gas limits. The `CrossChainVRFWrapper` keeps track of all pending requests using a mapping, associating each request ID with its destination (the L1 where the `CrossChainVRFConsumer` resides). This ensures that the random words are returned to the correct destination once fulfilled. ```solidity function receiveTeleporterMessage( bytes32 originChainID, address originSenderAddress, bytes calldata message ) external { require(msg.sender == address(teleporterMessenger), "Caller is not the TeleporterMessenger"); // Verify that the origin sender address is authorized require(authorizedSubscriptions[originSenderAddress].isAuthorized, "Origin sender is not authorized"); uint256 subscriptionId = authorizedSubscriptions[originSenderAddress].subscriptionId; // Verify that the subscription ID belongs to the correct owner (,,,, address[] memory consumers) = s_vrfCoordinator.getSubscription(subscriptionId); // Check wrapper contract is a consumer of the subscription bool isConsumer = false; for (uint256 i = 0; i < consumers.length; i++) { if (consumers[i] == address(this)) { isConsumer = true; break; } } require(isConsumer, "Contract is not a consumer of this subscription"); // Decode message to get the VRF parameters CrossChainRequest memory vrfMessage = abi.decode(message, (CrossChainRequest)); // Request random words VRFV2PlusClient.RandomWordsRequest memory req = VRFV2PlusClient.RandomWordsRequest({ keyHash: vrfMessage.keyHash, subId: subscriptionId, requestConfirmations: vrfMessage.requestConfirmations, callbackGasLimit: vrfMessage.callbackGasLimit, numWords: vrfMessage.numWords, extraArgs: VRFV2PlusClient._argsToBytes(VRFV2PlusClient.ExtraArgsV1({nativePayment: vrfMessage.nativePayment})) }); uint256 requestId = s_vrfCoordinator.requestRandomWords(req); pendingRequests[requestId] = CrossChainReceiver({ destinationBlockchainId: originChainID, destinationAddress: originSenderAddress }); } ``` ## Handles Callback from Chainlink VRF When **Chainlink VRF** fulfills the randomness request, the `CrossChainVRFWrapper` receives the random words through a callback function. This ensures that the request has been successfully processed. After receiving the random words, the `CrossChainVRFWrapper` encodes the result and sends it back as a cross-chain message to the `CrossChainVRFConsumer` on the unsupported L1. This is done using the `TeleporterMessenger`. ```solidity function fulfillRandomWords(uint256 requestId, uint256[] calldata randomWords) internal override { require(pendingRequests[requestId].destinationAddress != address(0), "Invalid request ID"); // Create CrossChainResponse struct CrossChainResponse memory crossChainResponse = CrossChainResponse({ requestId: requestId, randomWords: randomWords }); bytes memory encodedMessage = abi.encode(crossChainResponse); // Send cross chain message using ITeleporterMessenger interface TeleporterMessageInput memory messageInput = TeleporterMessageInput({ destinationBlockchainID: pendingRequests[requestId].destinationBlockchainId, destinationAddress: pendingRequests[requestId].destinationAddress, feeInfo: TeleporterFeeInfo({ feeTokenAddress: address(0), amount: 0 }), requiredGasLimit: 100000, allowedRelayerAddresses: new address[](0), message: encodedMessage }); teleporterMessenger.sendCrossChainMessage(messageInput); delete pendingRequests[requestId]; } ``` In summary, the `CrossChainVRFWrapper` contract acts as the **bridge** between the unsupported L1 and Chainlink’s VRF services, ensuring that random words are requested, fulfilled, and delivered back across chains efficiently. # Bringing Chainlink VRF to Unsupported L1s (Consumer) (/academy/avalanche-l1/icm-chainlink/01-access-chainlink-vrf-services/04-bring-vrf-to-unsupported-l1) --- title: Bringing Chainlink VRF to Unsupported L1s (Consumer) description: Learn how to request VRF from an unsupported L1 using CrossChainVRFConsumer. updated: 2024-10-21 authors: [0xstt] icon: BookOpen --- import { Step, Steps } from 'fumadocs-ui/components/steps'; The `CrossChainVRFConsumer` contract enables DApps on an unsupported L1 to request random words from Chainlink VRF using a cross-chain communication mechanism. Since Chainlink does not natively support all blockchains, this setup allows developers to access Chainlink's VRF service even on networks that don’t have direct support. ## Requesting Random Words The `CrossChainVRFConsumer` contract sends a cross-chain message to the `CrossChainVRFWrapper` on a Chainlink-supported L1, requesting random words. This request is sent using `TeleporterMessenger`, which handles cross-chain communication. ```solidity function requestRandomWords( bytes32 keyHash, uint16 requestConfirmations, uint32 callbackGasLimit, uint32 numWords, bool nativePayment, uint32 requiredGasLimit ) external { // Create CrossChainRequest struct CrossChainRequest memory crossChainRequest = CrossChainRequest({ keyHash: keyHash, requestConfirmations: requestConfirmations, callbackGasLimit: callbackGasLimit, numWords: numWords, nativePayment: nativePayment }); // Send Teleporter message bytes memory encodedMessage = abi.encode(crossChainRequest); TeleporterMessageInput memory messageInput = TeleporterMessageInput({ destinationBlockchainID: DATASOURCE_BLOCKCHAIN_ID, destinationAddress: vrfRequesterContract, feeInfo: TeleporterFeeInfo({ feeTokenAddress: address(0), amount: 0 }), requiredGasLimit: requiredGasLimit, allowedRelayerAddresses: new address[](0), message: encodedMessage }); teleporterMessenger.sendCrossChainMessage(messageInput); } ``` ## Processing the Request Once the request is received by the `CrossChainVRFWrapper`, it interacts with the Chainlink VRF Coordinator to request the random words on behalf of the consumer on the unsupported L1. ## Receiving Random Words Once Chainlink fulfills the request, the `CrossChainVRFWrapper` sends the random words back to the `CrossChainVRFConsumer` via a cross-chain message, enabling the DApp on the unsupported L1 to use them. ```solidity function receiveTeleporterMessage( bytes32 originChainID, address originSenderAddress, bytes calldata message ) external { require(originChainID == DATASOURCE_BLOCKCHAIN_ID, "Invalid originChainID"); require(msg.sender == address(teleporterMessenger), "Caller is not the TeleporterMessenger"); require(originSenderAddress == vrfRequesterContract, "Invalid sender"); // Decode the message to get the request ID and random words CrossChainResponse memory response = abi.decode(message, (CrossChainResponse)); // Fulfill the request by calling the internal function fulfillRandomWords(response.requestId, response.randomWords); } function fulfillRandomWords(uint256 requestId, uint256[] memory randomWords) internal { // Logic to handle the fulfillment of random words // Implement your custom logic here // Emit event for received random words emit RandomWordsReceived(requestId); } ``` # Deploy Wrapper (/academy/avalanche-l1/icm-chainlink/01-access-chainlink-vrf-services/05-deploy-vrf-wrapper) --- title: Deploy Wrapper description: Learn how to deploy the CrossChainVRFWrapper contract to handle cross-chain VRF requests. updated: 2024-10-21 authors: [0xstt] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; Once you have set up your Chainlink VRF subscription and have your LINK tokens ready, the next step is to deploy the **CrossChainVRFWrapper** contract. This contract will act as the bridge between your unsupported L1 and the Chainlink VRF network on a supported L1, enabling cross-chain requests for random words. ## Prerequisites Before deployment, make sure you have: - A valid **Chainlink VRF Subscription ID** (see previous section for details). - The `TeleporterMessenger` contract address on your supported L1 (e.g., Avalanche Fuji). ## Deploy the Contract Using the `forge create` command, deploy the `CrossChainVRFWrapper` contract to the supported L1 (e.g., Avalanche Fuji). ```bash forge create --rpc-url --private-key --broadcast --constructor-args src/CrossChainVRFWrapper.sol:CrossChainVRFWrapper ``` Replace the following: - ``: The RPC URL for the L1. - ``: The private key for the account used to deploy the contract. - ``: The address of the deployed `TeleporterMessenger` contract. After deployment, save the `Deployed to` address in an environment variable for future use. ```bash export VRF_WRAPPER=
``` ## Verify the Deployment After deploying the contract, verify that the `CrossChainVRFWrapper` has been successfully deployed by checking its address on a block explorer. ## Configure Authorized Subscriptions Once deployed, the `CrossChainVRFWrapper` contract needs to be configured with authorized subscriptions to process requests for random words. - Call the `addAuthorizedAddress` function to authorize a specific address with a given subscription ID. - This ensures that only authorized addresses can request random words via the wrapper. ```bash cast send --rpc-url --private-key $VRF_WRAPPER "addAuthorizedAddress(address caller, uint256 subscriptionId)" ``` Replace the following: - ``: The address that will be authorized to request random words. - ``: The ID of your Chainlink VRF subscription. # Deploy Consumer (/academy/avalanche-l1/icm-chainlink/01-access-chainlink-vrf-services/06-deploy-vrf-consumer) --- title: Deploy Consumer description: Learn how to deploy the CrossChainVRFConsumer contract on any L1 that does not support Chainlink VRF. updated: 2024-10-21 authors: [0xstt] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; Now that the `CrossChainVRFWrapper` is deployed on a Chainlink-supported L1, it’s time to deploy the `CrossChainVRFConsumer` contract on the L1 where Chainlink VRF is not supported. This contract will handle requests for random words and interact with the **TeleporterMessenger** to communicate with the supported L1. ## Prerequisites Make sure you have: - The `TeleporterMessenger` contract address on the unsupported L1. - The deployed `CrossChainVRFWrapper` on the supported L1. `($VRF_WRAPPER)` ## Deploy the Contract Use the following command to deploy the `CrossChainVRFConsumer` contract on your unsupported L1. ```bash forge create --rpc-url --private-key --broadcast --constructor-args $VRF_WRAPPER src/CrossChainVRFConsumer.sol:CrossChainVRFConsumer ``` Replace the following: - ``: The RPC URL for the L1. - ``: The private key for the account used to deploy the contract. - ``: The address of the `TeleporterMessenger` contract on your unsupported L1. After deployment, save the `Deployed to` address in an environment variable for future use. ```bash export VRF_CONSUMER=
``` ## Verify the Deployment Once the `CrossChainVRFConsumer` contract is deployed, verify the contract’s address and confirm that it has been successfully deployed on your L1 using a block explorer. # Create Chainlink VRF Subscription (/academy/avalanche-l1/icm-chainlink/01-access-chainlink-vrf-services/07-create-vrf-subscription) --- title: Create Chainlink VRF Subscription description: Learn how to create a Chainlink VRF subscription to enable cross-chain randomness requests. updated: 2024-10-21 authors: [0xstt] icon: BookOpen --- import { Step, Steps } from 'fumadocs-ui/components/steps'; Before you can request random words using Chainlink VRF, you need to set up a **Chainlink VRF subscription**. This subscription allows you to fund requests for randomness and manage the list of consumers that are authorized to use the VRF service. ## Access Chainlink's VRF Subscription Manager To create a subscription, go to the Chainlink VRF Subscription Manager on the network where you plan to request VRF (e.g., Avalanche Fuji). You can access the manager here: [VRF | Subscription Management for Fuji](https://vrf.chain.link/fuji). ![](/common-images/chainlink-vrf/visit-subscription-management.png) ## Create a New Subscription Once on the subscription manager, create a new subscription. The subscription will have a unique ID, which you'll need to reference in your `CrossChainVRFWrapper` contract. This ID is used to track your random word requests and the balance associated with them. ![](/common-images/chainlink-vrf/create-subscription.png) ## Fund the Subscription After creating the subscription, you need to fund it with LINK tokens. These tokens are used to pay for the randomness requests made through Chainlink VRF. Make sure your subscription has enough funds to cover your requests. You can get testnet LINK tokens from the Fuji Faucet: [Chainlink Faucet for Fuji](https://faucets.chain.link/fuji) ![](/common-images/chainlink-vrf/faucet.png) ![](/common-images/chainlink-vrf/add-funds.png) ## Add Consumers After funding your subscription, add the `CrossChainVRFWrapper` contract `($VRF_WRAPPER)` as a consumer. This step authorizes the contract to make randomness requests on behalf of your subscription. You can add other consumers, such as other contracts or addresses, depending on your use case. ![](/common-images/chainlink-vrf/add-consumer.png) ## Save Subscription ID After completing these steps, save your subscription ID. You will need this ID when configuring the `CrossChainVRFWrapper` contract to request random words. ```bash export VRF_SUBSCRIPTION_ID= ``` --- # Request Random Words (/academy/avalanche-l1/icm-chainlink/01-access-chainlink-vrf-services/08-request-random-words) --- title: Request Random Words description: Learn how to request random words using CrossChainVRFConsumer. updated: 2024-10-21 authors: [0xstt] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; In this section, you will learn how to request random words from Chainlink VRF using both the `CrossChainVRFConsumer` contracts. ## Authorize an Address to Request Random Words After deploying the `CrossChainVRFWrapper` contract, the first step is to authorize an address to make requests for random words. This ensures that only specific addresses linked to a subscription can request VRF. - Use the `addAuthorizedAddress` function to authorize a specific address with a given subscription ID. This step allows the address to make random word requests through the wrapper. ```bash cast send --rpc-url --private-key $VRF_WRAPPER "addAuthorizedAddress(address caller, uint256 subscriptionId)" $VRF_CONSUMER $VRF_SUBSCRIPTION_ID ``` ## Request Random Words from `CrossChainVRFConsumer` Once the address is authorized, the next step is to send a request for random words from the `CrossChainVRFConsumer` contract on the unsupported L1. This request is then sent to the `CrossChainVRFWrapper` via a cross-chain message. ```bash cast send --rpc-url --private-key $VRF_CONSUMER "requestRandomWords(bytes32 keyHash, uint16 requestConfirmations, uint32 callbackGasLimit, uint32 numWords, bool nativePayment, uint32 requiredGasLimit)" ``` Replace the placeholders with: - ``: The VRF key hash used for random word generation. - ``: Number of confirmations required for the request. - ``: The gas limit for the VRF callback function. - ``: The number of random words requested. - ``: Indicates whether the payment will be made in the native token. - ``: The gas limit required for the cross-chain message to be processed. # Introduction (/academy/avalanche-l1/icm-chainlink/02-access-chainlink-functions/01-introduction) --- title: Introduction description: Learn how to use ICM to access Chainlink VRF services on L1 networks that do not have direct Chainlink support. updated: 2024-10-21 authors: [Andrea] icon: Book --- TBD # Introduction (/academy/avalanche-l1/icm-chainlink/03-access-chainlink-automation/01-introduction) --- title: Introduction description: Learn how to use ICM to access Chainlink VRF services on L1 networks that do not have direct Chainlink support. updated: 2024-10-21 authors: [Andrea] icon: Book --- TBD # Introduction (/academy/avalanche-l1/icm-chainlink/04-ccip-icm/01-introduction) --- title: Introduction description: Learn how to use ICM to access Chainlink VRF services on L1 networks that do not have direct Chainlink support. updated: 2024-10-21 authors: [Andrea] icon: Book --- TBD # Origin of the EVM (/academy/avalanche-l1/customizing-evm/02-intro-to-evm/01-origin-of-evm) --- title: Origin of the EVM description: Learn about the origin of the Ethereum Virtual Machine. updated: 2024-09-27 authors: [ashucoder9, owenwahlgren] icon: BookOpen --- The **Ethereum Virtual Machine (EVM)** is a fundamental component of Ethereum’s infrastructure, responsible for executing smart contracts across the network. The origins of the EVM can be traced back to the creation of the Ethereum blockchain itself, proposed in a whitepaper by **Vitalik Buterin** in late 2013. Buterin and the founding Ethereum team envisioned a platform where developers could build **decentralized applications (dApps)** on a blockchain. To accomplish this, they needed a way to execute arbitrary, complex computations in a secure and decentralized manner. This is how the concept of the EVM was born. The EVM, an integral part of the Ethereum ecosystem, operates as a **quasi-Turing complete machine**. This means it can run nearly any algorithm, given enough resources. It's isolated from the main network, providing a sandboxed environment for smart contract execution. Following the publication of the whitepaper, the Ethereum project moved into development. The first live version of the Ethereum network, including the EVM, launched on **July 30, 2015**. The Ethereum blockchain was designed with the EVM at the protocol level, enabling users to create and execute smart contracts. These smart contracts are essentially programs that autonomously execute the terms of an agreement. They are written in high-level languages like **Solidity** or **Vyper**, which are then compiled down to EVM bytecode for execution on the EVM. Since its creation, the EVM has become a crucial component of the Ethereum blockchain and has set a standard for other blockchain platforms that have adopted similar models for executing smart contracts. The advent of the EVM has undoubtedly revolutionized the blockchain world by introducing the concept of **programmable blockchains**. # Accounts, Keys, and Addresses (/academy/avalanche-l1/customizing-evm/02-intro-to-evm/02-accounts-keys-address) --- title: Accounts, Keys, and Addresses description: Learn about Accounts, Keys, and Addresses in EVM. updated: 2024-09-27 authors: [ashucoder9, owenwahlgrne] icon: BookOpen --- ## Accounts In the EVM, there are two types of accounts: 1. **Externally Owned Accounts (EOAs)**: These accounts are controlled by private keys and do not have associated code. They can send transactions by creating and signing them with their private keys. If you're an end user of Ethereum, you're likely using an EOA. 2. **Contract Accounts**: These accounts have associated code (smart contracts). Contract accounts can't initiate transactions on their own; instead, they only perform actions when instructed by an EOA. This could be as simple as a token transfer or a function call within a smart contract. ## Public and Private Keys In Ethereum, as in many blockchain platforms, the **Elliptic Curve Digital Signature Algorithm (ECDSA)** is used to generate a pair of keys: a public key and a private key. - The **private key** is a 32-byte number generated randomly. - The **public key** is derived from the private key using elliptic curve cryptography. It is 64 bytes long, made up of two concatenated 32-byte coordinates. ## Addresses An EVM address is derived from the public key through the following steps: 1. **Keccak-256 Hashing**: The public key is first passed through the Keccak-256 hashing function (the version of SHA-3 used by Ethereum). Keccak-256 outputs a 64-byte string, for example: `025ad33e2479a53b02dc0be66eb0ce272fc0f4358c57a8f0a442410c3d831a` 2. **Rightmost 20 bytes**: The resulting string is truncated to keep only the last 20 bytes. In hexadecimal, this means retaining the rightmost 40 hex digits (since two hex digits represent one byte), like so: `e66eb0ce272fc0f4358c57a8f0a442410c3d831a` 3. **Adding '0x'**: Finally, "0x" is prefixed to the address for a total of 42 characters. The "0x" indicates that the following characters represent a hexadecimal number, a common convention in Ethereum: `0xe66eb0ce272fc0f4358c57a8f0a442410c3d831a` This process ensures that each Ethereum address uniquely corresponds to a public key. Since the address is a truncated hash of the public key, it's impossible to reverse-engineer the public key from the address. # Transactions and Blocks (/academy/avalanche-l1/customizing-evm/02-intro-to-evm/03-transactons-and-blocks) --- title: Transactions and Blocks description: Learn about another fundamental aspect of the Ethereum ecosystem - Transactions and Blocks. updated: 2024-09-27 authors: [ashucoder9, owenwahlgren] icon: BookOpen --- ## Transactions In the EVM, a transaction is the smallest unit of work that can be included in a block. It represents a **state transition**, modifying account data and transferring Ether across the network. Transactions can either transfer Ether or invoke smart contracts. Each transaction includes the following components: - **Nonce**: A unique value set by the sender to ensure the transaction is processed only once, preventing replay attacks. - **Gas Price**: The amount the sender is willing to pay per unit of gas, typically measured in `nanoAvax` (1 `nAvax` = 1/(10^9) Avax). It consists of three parts: - **Base Gas Fee**: The minimum `nAvax` required per unit of gas. - **Maximum Priority Gas Fee**: Additional `nAvax` the sender is willing to pay on top of the base fee. - **Maximum Total Gas Fee**: The maximum `nAvax` the sender is willing to spend per unit of gas. If the sum of the base gas fee and the priority gas fee exceeds this amount, the gas price paid will be capped at the maximum total gas fee. - **Gas Limit**: The maximum amount of gas units the sender is willing to pay for executing the transaction. If this limit is reached, the transaction fails, preventing indefinite execution. - **To**: The recipient's Ethereum address or the target smart contract. - **V, R, S**: Cryptographic data used to create the sender's signature. ## Blocks A block in the EVM is a bundle of validated transactions, grouped together and linked to the previous block. Each block contains: - **Block Number**: The index of the block, representing its position in a zero-indexed linked list. - **Timestamp**: The time the block was mined. - **Transactions Root**: The Merkle root of all transactions within the block. - **Receipts Root**: The Merkle root of all transaction receipts. - **State Root**: A hash of the entire Ethereum state after executing all transactions in the block. - **Parent Hash**: The hash of the previous (parent) block. - **Gas Limit**: The maximum gas all transactions in the block can consume. - **Gas Used**: The total gas consumed by all transactions in the block. - **Extra Data**: An optional field for including arbitrary data up to 32 bytes. - **Validator**: The address of the node that proposed the block. # Different Versions of EVM (/academy/avalanche-l1/customizing-evm/02-intro-to-evm/05-different-evm-versions) --- title: Different Versions of EVM description: Learn about the different versions of the Ethereum Virtual Machine in the Avalanche ecosystem. updated: 2024-09-27 authors: [ashucoder9, owenwahlgren] icon: BookOpen --- ## Geth Geth (or [go-ethereum](https://github.com/ethereum/go-ethereum)) is the official implementation of an Ethereum client, written in the Go programming language. It is one of the original and most widely used Ethereum clients today. Geth handles transactions, deploys and executes smart contracts, and contains the Ethereum Virtual Machine. ## Coreth [Coreth](https://github.com/ava-labs/coreth) is a fork of Geth maintained by Ava Labs. It implements the EVM for the C-Chain and has been adapted to work with Avalanche Consensus. ## Subnet-EVM [Subnet-EVM](https://github.com/ava-labs/subnet-evm) is a fork of Coreth designed to facilitate launching customized EVM-based blockchains on an Avalanche L1. It differs from Coreth in the following ways: - **Configurable Fees and Gas Limits**: Customizable fees and gas limits can be set in the genesis file. - **Unified Subnet-EVM Hardfork**: All Avalanche hardforks are merged into a single "Subnet-EVM" hardfork. - **Atomic Transactions and Shared Memory Removed**: Support for atomic transactions and shared memory has been removed. - **Multicoin Contracts and State Removed**: Multicoin contracts and state tracking are no longer supported. ## Precompile-EVM Precompile-EVM allows precompiles to be registered with Subnet-EVM without needing to fork the Subnet-EVM codebase. This simplifies common customizations to Subnet-EVM, making them more accessible and easier to maintain. It also streamlines updates for Subnet-EVM. # Set Up Development Environment (/academy/avalanche-l1/customizing-evm/03-development-env-setup/00-intro) --- title: Set Up Development Environment description: Start by setting up your development environment. updated: 2024-05-31 authors: [ashucoder9] icon: Book --- It's time to set up the development environment necessary for customizing the EVM! While the primary focus of this course is teaching you about precompiles, it's also crucial to configure a development environment that ensures a smooth and efficient workflow. In this section, we will cover the following: - Creating a GitHub repository for our customized EVM - Setting up a default test account in your Core Wallet - Exploring different types of development setups - Choosing the setup for developing precompiles Let's get started! 🚀 # Create Codespaces (/academy/avalanche-l1/customizing-evm/03-development-env-setup/02-create-codespaces) --- title: Create Codespaces description: Learn how to create GitHub Codespaces. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- ## Open Precompile-EVM Repository in a Github Codespace Open a Codespace on the [Precompile-EVM](https://github.com/ava-labs/precompile-evm/tree/avalanche-academy-start) Repository on the `avalanche-academy-start` branch by clicking the button below: [![Open in GitHub Codespaces](https://github.com/codespaces/badge.svg)](https://github.com/codespaces/new?hide_repo_select=true&ref=avalanche-academy-start&repo=605560683&machine=standardLinux32gb) Next a window opens and the Codespace is built. This may take a few minutes. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/customizing-evm/11-Z5CM89rf9qvVIENBpZF2wlKt3bALSq.png) When the building is completed, you can access the Codespace through the browser IDE. ## Closing Codespaces The codespace time out after 30 minutes of inactivity by default. So if you are not too worried about the 30 hour/month limit, just close the window or the tab. Alternatively, you can open the command prompt (Cmd + Shift + P) and issue the command: **Stop Current Codespace**. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/customizing-evm/12-rESxJrPr97KL08SWhP30BMEjHN7UAS.png) ## Reopen Codespaces You can see your Codespaces on https://github.com/codespaces/. There you can stop them, reopen them and delete them. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/customizing-evm/13-BHHk6FjT3nu1ATITEUdeJhezVCpd6G.png) # Codespace in VS Code (/academy/avalanche-l1/customizing-evm/03-development-env-setup/03-codespace-in-vscode) --- title: Codespace in VS Code description: Learn how to setup GitHub Codespaces. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- ## Switch from Browser to VS Code You can switch any time from the browser IDE to Visual Studio Code: ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/customizing-evm/14-aVKH0qkDNUpTwxRaB1qSFNuSk55Mfu.png) The first time you switch, you will be asked to install the [Codespaces extension](https://marketplace.visualstudio.com/items?itemName=GitHub.codespaces) and connect VS Code to you GitHub account, if it is not already connceted. # Your Own EVM Blockchain (/academy/avalanche-l1/customizing-evm/04-your-evm-blockchain/00-intro) --- title: Your Own EVM Blockchain description: Learn how to spin up your own EVM blockchain. updated: 2024-09-27 authors: [ashucoder9, owenwahlgren] icon: Book --- In this part of the course, we'll explore how to run your own Avalanche L1 with a custom EVM. Running your own EVM allows you to address specific use cases, showcasing one of the key advantages of multi-chain systems over monolithic blockchains. ## Topics We’ll cover the following topics: - **Avalanche CLI**: Learn how to configure and launch an Avalanche L1 using the Avalanche CLI. - **Token Transfer**: Explore how to perform token transfers with Foundry. This hands-on exercise will solidify your knowledge and allow you to observe how customizations impact EVM performance. ## Learning Objective By the end of this section, you’ll have the skills to effectively run your own Avalanche L1 with a custom EVM blockchain, empowering you to start building your blockchain projects! # Avalanche CLI (/academy/avalanche-l1/customizing-evm/04-your-evm-blockchain/01-avalanche-cli) --- title: Avalanche CLI description: Learn about the Avalanche Command-Line Interface tooling. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- ## What is the Avalanche CLI? The Avalanche CLI is a command-line tool that gives developers comprehensive access to Avalanche's functionalities, making it easier to build and test independent blockchains. Each Avalanche network includes the Primary Network, which consists of the Contract (C), Platform (P), and Exchange (X) chains. It's important to note that "Primary Network" refers to a special Avalanche L1 rather than a distinct, standalone network. Your local network operates independently from both the Mainnet and Fuji Testnet. You can even run an Avalanche L1 offline. Local Avalanche networks support, but are not limited to, the following commands: - **Start and Stop a Network**: Easily start or stop a local network. - **Health Check**: Check the health status of each node in the network. - **Create Blockchains**: Spin up new blockchains with custom parameters. Managing a local network with multiple nodes can be complex, but the Avalanche CLI simplifies the process with user-friendly commands. ## Usage The Precompile-EVM repository comes preloaded with the Avalanche CLI and Foundry, so you don’t need to install additional tools when working within Codespaces. Just use the terminal in your Codespace to run Avalanche CLI commands and start building. # Create Your Blockchain (/academy/avalanche-l1/customizing-evm/04-your-evm-blockchain/02-create-your-blockchain) --- title: Create Your Blockchain description: Learn how to use Avalanche-CLI to spin up your own EVM blockchain. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import CreateDefaultBlockchain from "@/content/common/avalanche-starter-kit/create-default-blockchain.mdx"; import defaultMdxComponents from "fumadocs-ui/mdx"; # Sending Tokens (/academy/avalanche-l1/customizing-evm/04-your-evm-blockchain/03-sending-tokens) --- title: Sending Tokens description: Learn how to send tokens on your EVM blockchain. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- To ensure that the blockchain is up and running, let's perform a simple token transfer to a random address, `0x321f6B73b6dFdE5C73731C39Fd9C89c7788D5EBc`, using Foundry: ```bash cast send --rpc-url myblockchain --private-key $PK 0x321f6B73b6dFdE5C73731C39Fd9C89c7788D5EBc --value 1ether ``` To verify if the transaction was successful, check the balance of the address with the following command: ```bash cast balance --rpc-url myblockchain 0x321f6B73b6dFdE5C73731C39Fd9C89c7788D5EBc ``` ```bash 1000000000000000000 ``` You should see that the balance of the address `0x321f6B73b6dFdE5C73731C39Fd9C89c7788D5EBc` is now 1 (1 * 10^18). Congratulations! You have successfully sent tokens on your EVM blockchain. 🎉 # EVM Configuration (/academy/avalanche-l1/customizing-evm/05-genesis-configuration/00-vm-configuration) --- title: EVM Configuration description: Learn about Virtual Machine configuration. updated: 2024-09-27 authors: [ashucoder9] icon: Book --- In this part of the course, we'll explore how to optimize your EVM through chain configuration, tailoring it to fit specific use cases. Customizing EVM configurations is a key advantage of multi-chain systems. ## Exercise In this section, you won’t need to write any Go code. Instead, we’ll adjust values in the JSON file of the genesis block. ## Topics We will cover the following topics: - **Genesis Block**: The foundation of any blockchain. We’ll review its components and how to customize its properties. - **Fee Configuration**: Learn how to balance validator incentives with user affordability. This is crucial for managing network congestion and discouraging wasteful transactions on public networks. - **Initial Token Allocation**: Understand how to define the initial token distribution in your custom EVM, setting your network up for success. - **Preinstalled Precompiles**: Discover how to configure preinstalled precompiles to leverage features like restricting who can issue transactions or deploy contracts on your chain. Finally, we’ll demonstrate how to run a local EVM with a custom Genesis Block. This exercise will solidify your understanding and allow you to observe the performance impact of your EVM customizations. ## Learning Objective By the end of this section, you'll be able to effectively customize the EVM in Avalanche, unlocking new possibilities for your blockchain projects. Let’s dive into EVM customization and chain configuration together! # Genesis Block (/academy/avalanche-l1/customizing-evm/05-genesis-configuration/01-genesis-block) --- title: Genesis Block description: Learn about the Genesis Block. updated: 2024-09-27 authors: [ashucoder9] icon: BookOpen --- ## Background Each blockchain begins with a genesis state when it is created. For instance, the Ethereum mainnet genesis block included the addresses and balances from the Ethereum pre-sale, marking the initial distribution of ether. For Subnet-EVM and Precompile-EVM, the genesis block contains additional parameters that allow us to configure the behavior of our customized EVM to meet specific requirements. Since each blockchain has its own genesis block, you can create two blockchains with the same VM but different genesis blocks. ## Format Here’s an example of a genesis block: ```json { "config": { "chainId": 43214, "homesteadBlock": 0, "eip150Block": 0, "eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0", "eip155Block": 0, "eip158Block": 0, "byzantiumBlock": 0, "constantinopleBlock": 0, "petersburgBlock": 0, "istanbulBlock": 0, "muirGlacierBlock": 0, "subnetEVMTimestamp": 0, "feeConfig": { "gasLimit": 15000000, "minBaseFee": 25000000000, "targetGas": 15000000, "baseFeeChangeDenominator": 36, "minBlockGasCost": 0, "maxBlockGasCost": 1000000, "targetBlockRate": 2, "blockGasCostStep": 200000 }, "allowFeeRecipients": false, "txAllowListConfig": { "blockTimestamp": 0, "adminAddresses": [ "0x8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC" ] } }, "alloc": { "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { "balance": "0x295BE96E64066972000000" } }, "nonce": "0x0", "timestamp": "0x0", "extraData": "0x00", "gasLimit": "0xe4e1c0", "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000" } ``` We will explore the relevant configurable parameters in the upcoming activities. Some parameters (e.g., `eip150Block`, `byzantiumBlock`) are omitted here as they are not relevant for most use cases. This version provides a clean and concise explanation of the genesis block and its structure, keeping the focus on what's essential. # Create Your Genesis File (/academy/avalanche-l1/customizing-evm/05-genesis-configuration/02-create-your-genesis) --- title: Create Your Genesis File description: Learn how to create your own genesis file. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Callout } from 'fumadocs-ui/components/callout'; ## Create File In your Precompile-EVM project, create a file called `evm-configuration-genesis.json` in the directory `tests/precompile/genesis/` and open it. You can use the command below as a shortcut to open the file in VSCode: ```bash code ./tests/precompile/genesis/evm-configuration-genesis.json ``` ## Fill with template Paste the following template in the new file: ```json { "config": { "chainId": , "homesteadBlock": 0, "eip150Block": 0, "eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0", "eip155Block": 0, "eip158Block": 0, "byzantiumBlock": 0, "constantinopleBlock": 0, "petersburgBlock": 0, "istanbulBlock": 0, "muirGlacierBlock": 0, "subnetEVMTimestamp": 0, "feeConfig": { "gasLimit": , "minBaseFee": , "targetGas": , "baseFeeChangeDenominator": 36, "minBlockGasCost": , "maxBlockGasCost": , "targetBlockRate": , "blockGasCostStep": }, "allowFeeRecipients": false }, "alloc": { "": { "balance": "" } }, "nonce": "0x0", "timestamp": "0x0", "extraData": "0x00", "gasLimit": , "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000" } ``` If you do decide to set your own gasLimit, please set all gasLimit keys equal to the same value! If you set the 'gasLimit' keys to different values, you will still be able to deploy a blockchain, but it will halt during initialization! # Setup Your ChainID (/academy/avalanche-l1/customizing-evm/05-genesis-configuration/03-setup-chainid) --- title: Setup Your ChainID description: Learn how to setup ChainID for your own blockchain. updated: 2024-09-27 authors: [ashucoder9] icon: Terminal --- ## What is ChainID? The `ChainID` of an EVM blockchain is a unique identifier that distinguishes Ethereum chains from one another. Introduced in Ethereum Improvement Proposal (EIP) 155, this mechanism prevents transaction replay attacks, which could occur when the same transaction is valid across multiple chains. ## Setting the ChainID To set the `ChainID` for your blockchain, configure it in the `genesis` JSON file at the top level with the value `99999`. If you wish to use a custom `ChainID`, check [chainlist.org](https://chainlist.org) to ensure your proposed `ChainID` is not in use by any other network. Be sure to cross-check with Testnets as well! ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/customizing-evm/28-LNcOo16PhvaDVIb7crVasGVKvs8kR6.png) # Gas Fees and Gas Limit (/academy/avalanche-l1/customizing-evm/05-genesis-configuration/04-gas-fees-and-limit) --- title: Gas Fees and Gas Limit description: Learn about Gas Fees and Gas Limit in the context of the EVM. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- ## Background In the context of the EVM, gas is a unit that measures the computational effort required to execute specific operations. Each operation performed by a contract or transaction on an EVM chain consumes a certain number of gas units based on its complexity. Operations that require more computational resources cost more gas. The EVM calculates the required gas units automatically, and developers are encouraged to optimize their contract code to reduce gas consumption. The cost of executing a transaction is determined by the gas units consumed and the gas price, calculated as follows: ``` Transaction Cost = Gas Units * Gas Price ``` For EVM Avalanche L1s, gas payment can be configured to better suit the use case of the Avalanche L1. This means that the Avalanche L1 design can decide whether the gas fees are burned, paid to incentivize validators, or used for any other custom behavior. ## Purpose The primary goal of setting and enforcing computational costs via gas is to prevent spam and abuse on the network. By requiring users to pay for each computational step, the network deters malicious actors from launching denial-of-service (DoS) attacks, which involve flooding the network with spurious transactions. Essentially, the gas system serves as a deterrent against such attacks. ## Gas Price and Gas Limit Each transaction specifies the gas price and gas limit: **`Gas Price`:** The gas price is the amount of the Avalanche L1's native token that the sender is willing to spend per unit of gas, typically denoted in `gwei` (1 native token = 1,000,000,000 `gwei`). A well-designed gas mechanism adapts the gas price according to network activity to protect the network from spam. **`Gas Limit`:** The gas limit is the maximum amount of gas the sender is willing to use for the transaction. It was introduced to prevent infinite loops in contract execution. In a Turing-complete language like Solidity (the main programming language in the EVM), it is possible to write a contract with an infinite loop, either accidentally or intentionally. While an infinite loop might be a nuisance in traditional computing, it could cause significant issues in a decentralized blockchain by causing the network to hang as it attempts to process a never-ending transaction. The gas limit prevents this by halting execution once the gas consumed reaches the limit. If a transaction exceeds the gas limit, it fails, but the fee amounting to the gas limit is still paid by the sender. # Gas Fees Configuration (/academy/avalanche-l1/customizing-evm/05-genesis-configuration/05-gas-fee-configuration) --- title: Gas Fees Configuration description: Learn how to configure gas fees in your EVM blockchain. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- ## Configuration Format The fees are configured in the `chainConfig` in the `feeConfig` field: ```json { "config": { // ... "feeConfig": { // [!code highlight] "gasLimit": 15000000, "minBaseFee": 25000000000, "targetGas": 15000000, "baseFeeChangeDenominator": 36, "minBlockGasCost": 0, "maxBlockGasCost": 1000000, "targetBlockRate": 2, "blockGasCostStep": 200000 }, "allowFeeRecipients": false }, "alloc": { // ... }, // ... "gasLimit": 0xe4e1c0, // ... } ``` ## Gas Configuration Parameters ### `gasLimit` Sets the maximum amount of gas consumed per block. This restriction caps the computational capacity of a single block and thereby limits the maximum gas usage allowed for any single transaction. For reference, the C-Chain value is set to 15,000,000. You might notice that the `gasLimit` field appears twice. This is because Avalanche introduced its own fee configuration under the `feeConfig` key while maintaining compatibility with the standard EVM configuration. Ensure that both fields have the same decimal and hexadecimal equivalent values. ### `targetBlockRate` Specifies the target rate of block production in seconds. For instance, a target of 2 aims to produce a block every 2 seconds. If blocks are produced faster than this rate, it signals that more blocks are being issued to the network than anticipated, leading to an increase in base fees. For C-Chain, this value is set to 2. ### `minBaseFee` Establishes a lower bound on the EIP-1559 base fee for a block. This minimum base fee effectively sets the minimum gas price for any transaction included in that block. ### `targetGas` Indicates the targeted amount of gas (including block gas cost) to be consumed within a rolling 10-second window. The dynamic fee algorithm adjusts the base fee proportionally based on how actual network activity compares to this target. If network activity exceeds the `targetGas`, the base fee is increased accordingly. ### `baseFeeChangeDenominator` Determines how much to adjust the base fee based on the difference between actual and target utilization. A larger denominator results in a slower-changing base fee, while a smaller denominator allows for quicker adjustments. For C-Chain, this value is set to 36, meaning the base fee changes by a factor of 1/36 of the parent block's base fee. ### `minBlockGasCost` Sets the minimum amount of gas charged for the production of a block. In the C-Chain, this value is set to 0. ### `maxBlockGasCost` Specifies the maximum amount of gas charged for the production of a block. ### `blockGasCostStep` Defines how much to increase or decrease the block gas cost based on the time elapsed since the previous block. If a block is produced at the target rate, the block gas cost remains the same as the parent block. If the production rate deviates from the target, the block gas cost is adjusted by the `blockGasCostStep` value for each second faster or slower than the target block rate. # Configure Gas Fees (/academy/avalanche-l1/customizing-evm/05-genesis-configuration/06-configuring-gas-fees) --- title: Configure Gas Fees description: Learn how to configure gas fees in your EVM blockchain. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- ## Benchmarks You can take these numbers below as a benchmark: ```json "feeConfig": { "gasLimit": 15000000, "minBaseFee": 25000000000, "targetGas": 15000000, "baseFeeChangeDenominator": 36, "minBlockGasCost": 0, "maxBlockGasCost": 1000000, "targetBlockRate": 2, "blockGasCostStep": 200000 }, "gasLimit": 0xe4e1c0, ``` ## Choose Your Own Values ### `gasLimit` As previously discussed, the `gasLimit` acts as a restriction on the amount of computation that can be executed in a single block, and hence caps the maximum transaction size, as the entire transaction needs to be processed within the same block. Your choice of `gasLimit` values should depend on the specific use case and computational demands of your application. Here are some considerations: **High Throughput:** If your application requires a high volume of transactions, you might want to allow for more transactions (i.e., more computation) to be packed into a single block. This increases the block capacity and enables handling a higher transaction load. **Heavy Transactions:** Transactions that involve deploying large contracts or executing complex operations tend to consume more gas. If your application involves such operations, ensure that your `gasLimit` accommodates the full execution of these heavy transactions or contract deployments. Be cautious with setting excessively high `gasLimit` values. Larger computational allowances per block can translate to increased hardware requirements for your blockchain. Therefore, align the `gasLimit` with your use case and infrastructure requirements for validators. Avoid setting an unusually large value "just in case." For reference, consider that a typical native token transaction costs around 21,000 gas units, and the C-Chain `gasLimit` is set to 15,000,000. ### Gas Price Parameters The following parameters affect the gas pricing and dynamic adjustments in your network: - **`minBaseFee`**: Sets the minimum base fee per unit of gas, establishing the lower bound for transaction costs in a block. - **`targetGas`**: Defines the target amount of gas to be consumed within a rolling 10-second window. Adjust this based on the expected network activity under normal conditions. - **`baseFeeChangeDenominator`**: Controls how quickly the base fee adjusts in response to fluctuations in gas usage. A smaller denominator allows for faster adjustments. - **`minBlockGasCost`**: Specifies the minimum gas cost for producing a block. - **`maxBlockGasCost`**: Sets the maximum gas cost for producing a block. - **`targetBlockRate`**: Determines the desired block production rate in seconds. Choose this based on your expected block issuance frequency. - **`blockGasCostStep`**: Adjusts the block gas cost based on the deviation from the target block rate. A higher step value increases the block gas cost more rapidly with deviations. These parameters should be selected based on the stability of gas usage in your network. Since gas fees are crucial for protecting against spam and abuse, carefully consider how these parameters will adapt to changes in network activity. The goal is to dynamically adjust transaction costs during irregular activity periods while maintaining stability under normal conditions. # Initial Token Allocation (/academy/avalanche-l1/customizing-evm/05-genesis-configuration/07-initial-token-allocation) --- title: Initial Token Allocation description: Learn about the initial token allocation and configure in your EVM blockchain. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Callout } from 'fumadocs-ui/components/callout'; ## Background `Alloc` defines the initial balances of addresses at the time of chain creation. This field should be modified according to the specific requirements of each chain. If no genesis allocation is provided, you won't be able to interact with your new chain, as all transactions require a fee to be paid from the sender's balance. Without an initial allocation, there will be no funds available to cover transaction fees. ## Format The `alloc` field expects key-value pairs. Keys must be valid addresses, and the balance field in each value can be either a hexadecimal or decimal number representing the initial balance of the address. ```json { "config": { // ... }, "alloc": { // [!code highlight] "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { "balance": "0x295BE96E64066972000000" // 50,000,000 tokens } }, // ... } ``` Keys in the allocation are hex addresses without the canonical 0x prefix. Balances are denominated in `Wei` (10^18 `Wei` = 1 Whole Unit of the native token of the chain) and expressed as hex strings with the canonical 0x prefix. Use [this converter](https://www.rapidtables.com/convert/number/hex-to-decimal.html) for translating between decimal and hex numbers. The default configuration for testing purposes allocates a significant number of tokens to the address `8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC`. The private key for this address (as defined in the `.devcontainer`) is: `56289e99c94b6912bfc12adc093c9b51124f0dc54ac7a766b2bc5ccf558d8027`. Never use this address or private key for anything other than testing on a local test network. The private key is publicly known, and any real funds transferred to this address are likely to be stolen. ## Configure Allocate tokens to two addresses: - The well-known test address `8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC`. - Another test address that you have created (avoid using addresses associated with real funds). ```json { "config": { // ... }, "alloc": { "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { // [!code highlight] "balance": "0x295BE96E64066972000000" // 50,000,000 tokens }, "": { // [!code highlight] "balance": "0x295BE96E64066972000000" // 50,000,000 tokens } }, // ... } ``` # Build and Run Custom Genesis EVM (/academy/avalanche-l1/customizing-evm/05-genesis-configuration/08-build-and-run-custom-genesis-blockchain) --- title: Build and Run Custom Genesis EVM description: Learn how to build and run your blockchain with custom genesis file. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- ### Build Your Precompile-EVM There's a simple build script in the Precompile-EVM we can utilize to build. First, make sure you are in the root folder of you Precompile-EVM: ```bash cd $GOPATH/src/github.com/ava-labs/precompile-evm ``` Then run the command to initiate the build script: ```bash ./scripts/build.sh ``` ### Create your blockchain configuration You can run your Precompile-EVM by using the Avalanche CLI. First, create the configuration for your blockchain: ```bash avalanche blockchain create myblockchain \ --custom \ --vm $VM_PATH \ --genesis "./.devcontainer/genesis-example.json" \ --force \ --sovereign=false \ --evm-token "TOK" \ --warp \ --icm ``` ### Launch L1 with you customized EVM ```bash avalanche blockchain deploy myblockchain --local ``` After around 1 minute, the blockchain should have been created, and additional output will appear in the terminal. You'll also see the RPC URL of your blockchain in the terminal. # What are Precompiles? (/academy/avalanche-l1/customizing-evm/06-precompiles/01-what-are-precompiles) --- title: What are Precompiles? description: Learn about Precompiled Smart Contracts in EVM. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- Precompiled contracts allow the execution of code written in the low-level programming language Go from the EVM, which is significantly faster and more efficient than Solidity. ## Overview If you're familiar with Python, you might recognize a similar concept where many Python functions and libraries are implemented in C for efficiency. Python developers can import these precompiled modules and call functions as if they were written in Python. The main difference is that the modules execute faster and more efficiently. Precompiles can be called from a Solidity smart contract just like any other contract. The EVM maintains a list of reserved addresses mapped to precompiles. When a smart contract calls a function of a contract at one of these addresses, the EVM executes the precompile written in Go instead of the Solidity contract. For example, if we map the address `0x030...01` to the SHA256 precompile that hashes its input using the SHA256 hash function, we can call the precompile as follows: ```solidity // SPDX-License-Identifier: MIT pragma solidity >=0.8.0; interface ISHA256 { // Computes the SHA256 hash of value function hashWithSHA256(string memory value) external view returns(bytes32 hash); } contract MyContract { ISHA256 mySHA256Precompile = ISHA256(0x0300000000000000000000000000000000000001); function doSomething() public { bytes32 hash = mySHA256Precompile.hashWithSHA256("test"); } } ``` In the code above, we call the precompile using the defined interface for our SHA256 precompile within `MyContract`. Note that there is no implementation of the precompile in Solidity itself. This will only work if the precompile is implemented in Go and registered at the address `0x030...01`. ### PrecompiledContract Interface When implementing a precompile in the Avalanche L1-EVM, the following function of the `StatefulPrecompiledContract` interface must be implemented in Go: ```go // StatefulPrecompiledContract is the interface for executing a precompiled contract type StatefulPrecompiledContract interface { // Run executes the precompiled contract. Run(accessibleState AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) } ``` We will cover the meaning of "stateful" and the first parameter `accessibleState` later. For now, let's focus on the function that specifies the logic of our precompile, which provides access to the following data: - caller: The address of the account that called the precompile. - addr: The address of the precompile being called. - input: All inputs encoded in a byte array. - suppliedGas: The amount of gas supplied for the precompile call. - readOnly: A boolean flag indicating if the interaction is only reading or modifying the state. The precompile implementation must return the following values: - ret: All return values encoded in a byte array. - remainingGas: The amount of gas remaining after execution. - err: If an error occurs, return it. Otherwise, return nil. # Why Precompiles? (/academy/avalanche-l1/customizing-evm/06-precompiles/02-why-precompiles) --- title: Why Precompiles? description: Learn about why you should utilize Precompiles in your smart contracts. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- Adding precompiles to the EVM offers several significant advantages, which we will outline in this chapter. ## Performance Optimization Precompiles primarily optimize the performance of specific computations. Introducing a new precompile can greatly reduce the computational resources required for certain tasks, thereby enhancing the performance of smart contracts and decentralized applications (DApps) that rely on these tasks. For instance, the SHA256 hash function (0x02) and the RIPEMD160 hash function (0x03) serve as examples of precompiles that significantly boost performance. Implementing these functions within a smart contract would be computationally expensive and slow, whereas as precompiles, they execute quickly and efficiently. ## Security Incorporating a function as a precompile allows developers to leverage libraries that have been thoroughly reviewed and audited, thus reducing the risk of bugs and vulnerabilities, which enhances overall security. For example, the ModExp (0x05) precompile safely performs modular exponentiation, a complex mathematical operation utilized in various cryptographic functions. ## Access to Go Libraries Precompiles are implemented in Go, allowing access to the rich ecosystem of existing Go libraries. This access eliminates the need for reimplementation, which can be labor-intensive and carries the risk of introducing bugs during the translation from Go to Solidity. Consider the implementation of the SHA256 hash algorithm to understand the complexity involved in reimplementing it in Solidity. ## Gas Efficiency Introducing a new precompile to the EVM can enhance gas efficiency for specific computations, thereby lowering execution costs. This makes it feasible to incorporate more complex operations into smart contracts, expanding their functionality without significantly increasing transaction costs. The identity precompile (0x04), which copies and returns input data, exemplifies this. Though simple, it provides gas efficiency by being faster and cheaper than implementing the same functionality in a standard contract. ## Advanced Features and Functionality By adding new precompiles to the EVM, developers can introduce advanced features and functionalities, such as complex mathematical calculations, advanced cryptographic operations, and new data structures. This can unlock new possibilities for DApps and smart contracts, enabling them to execute tasks that would otherwise be too computationally demanding or technically challenging. Precompiles for elliptic curve operations, such as ecadd (0x06), ecmul (0x07), and ecpairing (0x08), enable advanced cryptographic functionality within EVM smart contracts. These precompiles are crucial for implementing zk-SNARKs, a form of zero-knowledge proof, in Ethereum. ## Interoperability Certain precompiles can enhance the interoperability of the EVM with other blockchains or systems. For instance, precompiles can be utilized to verify proofs from other chains or perform operations compatible with different cryptographic standards. The BLS12-381 elliptic curve operations precompiles (0x0a through 0x13, added in the Istanbul upgrade) improve EVM interoperability by allowing operations that are compatible with the BLS signature scheme, potentially facilitating inter-blockchain communication. # Interact with a Precompile (/academy/avalanche-l1/customizing-evm/06-precompiles/03-interact-wtih-precompile) --- title: Interact with a Precompile description: Learn about why you should utilize Precompiles in your smart contracts. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- So let's get to it and interact with a precompile on the C-Chain of your local network. The SHA256 precompile is already available on the C-Chain. ## Call Precompile from Foundry In this example, we will call the SHA256 precompile to generate hash of the input string. **Precompile Address:** `0x0000000000000000000000000000000000000002` ```bash cast call --rpc-url local-c --private-key $PK 0x0000000000000000000000000000000000000002 "run(string)(bytes32)" "test" ``` You should see a bytes32 hash of the input string `test` as the output. ```bash 0xa770b926e13a31fb823282e9473fd1da9e85afe23690336770c490986ef1b1fc ``` # Overview (/academy/avalanche-l1/customizing-evm/07-hash-function-precompile/00-intro) --- title: Overview description: Learn how to create a Hash Function Precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Book --- import {Step, Steps} from 'fumadocs-ui/components/steps'; ## What We're Building In this section, we'll create a precompile for the MD5 hash function. By utilizing the existing Go library for this hash function, we can avoid reimplementing the algorithm in Solidity and take advantage of Go's superior efficiency. A hash function is a special type of function that takes input data of any size (such as a letter, a word, the text of a book, or even all combined texts available on the internet) and converts it into a fixed-size output. This output, known as a hash value, represents the original data. The process is often referred to as "hashing." Hash functions possess several key properties: - **Deterministic**: Given the same input, a hash function will always produce the same output. For instance, hashing the word "apple" a thousand times will yield the same hash value each time. - **Fixed Size**: Regardless of the input data size—whether it's a single character or an entire novel—the hash function always produces an output (the hash value) of a consistent length. - **Fast Computation**: Hash functions are designed to be quick and efficient, returning a hash value with minimal computational resources and time. - **Preimage Resistance**: It's computationally infeasible to retrieve the original input data from the hash value alone. This property is especially crucial in cryptographic hash functions for data security. - **Avalanche Effect**: A small change to the input should cause significant changes in the output, making the new hash value appear uncorrelated with the old one. For example, hashing "apple" and "Apple" should produce completely different hash values. - **Collision Resistance**: It is highly unlikely for two different pieces of input data to yield the same hash value. However, due to the limited length of hash values, collisions are theoretically possible. A good hash function minimizes the occurrence of such collisions. Hash functions are utilized in various applications across computer science, including data retrieval, data integrity verification, password storage, and in blockchain technology for cryptocurrencies like Bitcoin. ## Reference Implementation To aid your understanding of building precompiles, we will compare each step with a reference example: a precompile for the SHA256 hash function. Both precompiles are quite similar, featuring a single function that returns the hashed value. ## Overview of Steps Here's an overview of the steps involved: Create a Solidity interface for the precompile. Generate the ABI. Write the precompile code in Go. Configure and register the precompile. Build and run your customized EVM. Connect Remix to your customized EVM and interact with the precompile. Let's get started! # Create an MD5 Solidity Interface (/academy/avalanche-l1/customizing-evm/07-hash-function-precompile/01-create-solidity-interface) --- title: Create an MD5 Solidity Interface description: Learn how to create an MD5 Solidity Interface updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- The first step is defining the interface that will wrap the precompile implementation and that other contracts and users will interact with. In addition to declaring the way users can interact with our MD5 precompile, defining the MD5 interface will also allow us to utilize a generator script. A precompile consists of many files, and generating boilerplate Go files will make implementing the precompile much easier. ## SHA-256 Precompile Interface Before defining the MD5 interface, we will first look at the interface of the very similar SHA-256 precompile. This reference implementation is included in the repository we have created earlier. ```solidity title="contracts/contracts/interfaces/ISHA256.sol" // SPDX-License-Identifier: MIT pragma solidity >=0.8.0; interface ISHA256 { /// Compute the hash of value /// @param value the value to be hashed /// @return hash the hash of the value function hashWithSHA256(string memory value) external view returns(bytes32 hash); } ``` ISHA256 contains a single function `hashWithSHA256`. `hashWithSHA256` takes in a value of type string, which is the value which is to be hashed, and outputs a 32-byte hash. ## Creating the Solidity Interface For The MD5 Precompile Now it's your turn to define a precompile interface! Create the interface for the MD5 hash function. Start by going into the same directory where `ISHA256.sol` lives (`contracts/contracts/interfaces/`) and create a new file named `IMD5.sol`. Note that: → MD5 returns a 16-byte hash instead of a 32-byte hash → Make sure to name all parameters and return values ```solidity title="contracts/contracts/interfaces/IMD5.sol" // SPDX-License-Identifier: MIT pragma solidity >=0.8.0; interface IMD5 { function hashWithMD5(string memory value) external view returns (bytes16 hash); } ``` ## Generate the ABI Now that we have an interface of our precompile, let's create an ABI of our Solidity interface. Open the integrated VS Code terminal (control + \`), and change to the `/contracts` directory. ```bash cd contracts ``` Run the command to compile the solidity interface to the ABI: ```bash npx solc@latest --abi ./contracts/interfaces/IMD5.sol -o ./abis --base-path . --include-path ./node_modules ``` Rename the file: ```bash mv ./abis/contracts_interfaces_IMD5_sol_IMD5.abi ./abis/IMD5.abi ``` Now, you should have a file called `IMD5.abi` in the folder `/contracts/abis` with the following content: ```json [ { "inputs": [ { "internalType": "string", "name": "value", "type": "string" } ], "name": "hashWithMD5", "outputs": [ { "internalType": "bytes16", "name": "hash", "type": "bytes16" } ], "stateMutability": "view", "type": "function" } ] ``` # Generate the Precompile (/academy/avalanche-l1/customizing-evm/07-hash-function-precompile/02-generate-the-precompile) --- title: Generate the Precompile description: Learn how to generate your precompile. updated: 2024-09-27 authors: [ashucoder9, owenwahlgren] icon: Terminal comments: true --- import { File, Files, Folder } from 'fumadocs-ui/components/files'; In the last section, we created the ABI for our precompile contract. Now, we'll use the precompile generation script provided by the precompile-evm template to generate a boilerplate code in go for the precompile implementation that will be wrapped in the solidity interface we created in the previous step. ## Running the Generation Script To start, go to the root directory of your precompile-evm project: ```bash cd .. ``` Now generate the files necessary for the precompile. ```bash ./scripts/generate_precompile.sh --abi ./contracts/abis/IMD5.abi --type Md5 --pkg md5 --out ./md5 ``` Now you should have a new directory in your root directory called `md5`: ### `contract.go` For the rest of this chapter, we'll work with the `md5/contract.go` file. If you generated the Go files related to your precompile, `contract.go` should look like the code below. Do not be intimidated if much of this code does not make sense to you. We'll cover the different parts and add some code to implement the logic of our MD5 precompile. ```go // Code generated // This file is a generated precompile contract config with stubbed abstract functions. // The file is generated by a template. Please inspect every code and comment in this file before use. package md5 import ( "errors" "fmt" "math/big" "github.com/ava-labs/subnet-evm/accounts/abi" "github.com/ava-labs/subnet-evm/precompile/contract" "github.com/ava-labs/subnet-evm/vmerrs" _ "embed" "github.com/ethereum/go-ethereum/common" ) const ( // Gas costs for each function. These are set to 1 by default. // You should set a gas cost for each function in your contract. // Generally, you should not set gas costs very low as this may cause your network to be vulnerable to DoS attacks. // There are some predefined gas costs in contract/utils.go that you can use. HashWithMD5GasCost uint64 = 1 /* SET A GAS COST HERE */ ) // CUSTOM CODE STARTS HERE // Reference imports to suppress errors from unused imports. This code and any unnecessary imports can be removed. var ( _ = abi.JSON _ = errors.New _ = big.NewInt _ = vmerrs.ErrOutOfGas _ = common.Big0 ) // Singleton StatefulPrecompiledContract and signatures. var ( // Md5RawABI contains the raw ABI of Md5 contract. //go:embed contract.abi Md5RawABI string Md5ABI = contract.ParseABI(Md5RawABI) Md5Precompile = createMd5Precompile() ) // UnpackHashWithMD5Input attempts to unpack [input] into the string type argument // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackHashWithMD5Input(input []byte) (string, error) { res, err := Md5ABI.UnpackInput("hashWithMD5", input) if err != nil { return "", err } unpacked := *abi.ConvertType(res[0], new(string)).(*string) return unpacked, nil } // PackHashWithMD5 packs [value] of type string into the appropriate arguments for hashWithMD5. // the packed bytes include selector (first 4 func signature bytes). // This function is mostly used for tests. func PackHashWithMD5(value string) ([]byte, error) { return Md5ABI.Pack("hashWithMD5", value) } // PackHashWithMD5Output attempts to pack given hash of type [16]byte // to conform the ABI outputs. func PackHashWithMD5Output(hash [16]byte) ([]byte, error) { return Md5ABI.PackOutput("hashWithMD5", hash) } // UnpackHashWithMD5Output attempts to unpack given [output] into the [16]byte type output // assumes that [output] does not include selector (omits first 4 func signature bytes) func UnpackHashWithMD5Output(output []byte) ([16]byte, error) { res, err := Md5ABI.Unpack("hashWithMD5", output) if err != nil { return [16]byte{}, err } unpacked := *abi.ConvertType(res[0], new([16]byte)).(*[16]byte) return unpacked, nil } func hashWithMD5(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, HashWithMD5GasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the HashWithMD5Input. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackHashWithMD5Input(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output [16]byte // CUSTOM CODE FOR AN OUTPUT packedOutput, err := PackHashWithMD5Output(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } // createMd5Precompile returns a StatefulPrecompiledContract with getters and setters for the precompile. func createMd5Precompile() contract.StatefulPrecompiledContract { var functions []*contract.StatefulPrecompileFunction abiFunctionMap := map[string]contract.RunStatefulPrecompileFunc{ "hashWithMD5": hashWithMD5, } for name, function := range abiFunctionMap { method, ok := Md5ABI.Methods[name] if !ok { panic(fmt.Errorf("given method (%s) does not exist in the ABI", name)) } functions = append(functions, contract.NewStatefulPrecompileFunction(method.ID, function)) } // Construct the contract with no fallback function. statefulContract, err := contract.NewStatefulPrecompileContract(nil, functions) if err != nil { panic(err) } return statefulContract } ``` # Packing and Unpacking (/academy/avalanche-l1/customizing-evm/07-hash-function-precompile/03-unpack-input-pack-output) --- title: Packing and Unpacking description: Learn how to unpack inputs and pack outputs. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- In this first segment of examining the `contract.go` file generated for us, we will go over the packing and unpacking functions in this file. ## The Notion of Packing Those eager to implement the MD5 algorithm might be wondering why we're discussing packing. However, there is good reason to discuss packing, and it comes down to the specification of the `staticcall` function in Solidity. We begin by referring to the example of calling the SHA-256 precompiled contract: ```go (bool ok, bytes memory out) = address(2).staticcall(abi.encode(numberToHash)); ``` As seen above, the `staticcall` function accepts input in bytes format, generated by `abi.encode`, and returns a boolean value indicating success, along with a bytes format output. Therefore, our precompiled contract should be designed to accept and return data in bytes format, involving the packing and unpacking of values. Since packing is a deterministic process, there's no concern about data corruption during translation. However, some preprocessing or postprocessing is necessary to ensure the contract functions correctly. ## Unpacking Inputs In `contract.go`, the function `UnpackHashWithMd5Input` unpacks our data and converts it into a type relevant to us. It takes a byte array as an input and returns a Go string. We will look at more complex precompiles that have multiple functions that may take multiple inputs later. ```go // UnpackHashWithMD5Input attempts to unpack [input] into the string type argument // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackHashWithMD5Input(input []byte) (string, error) { res, err := Md5ABI.UnpackInput("hashWithMD5", input) if err != nil { return "", err } unpacked := *abi.ConvertType(res[0], new(string)).(*string) return unpacked, nil } ``` ## Packing Outputs Ignoring `hashWithMD5` for now, note that whatever value `hashWithMD5` outputs, we will need to postprocess it (i.e. pack it). `PackHashWithMD5Output` does just this, taking in an input of type [16]byte and outputting a byte array which can be returned by `staticcall`. ```go // PackHashWithMd5Output attempts to pack given hash of type [16]byte // to conform the ABI outputs. func PackHashWithMd5Output(hash [16]byte) ([]byte, error) { return Md5ABI.PackOutput("hash_with_md5", hash) } ``` This may seem trivial, but if our Solidity interface defined our function to return a uint or string, the type of our input to this function would differ accordingly. # Implement the Precompile (/academy/avalanche-l1/customizing-evm/07-hash-function-precompile/04-implementing-precompile) --- title: Implement the Precompile description: Learn how to implement the Precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- Now, we'll implement the logic of the precompile in Go. We'll hash our string using the MD5 algorithm. ## SHA-256 Precompile Implementation Before defining the logic of our MD5 precompile, let's look at the logic of the function `hashWithSHA256` (located in `sha256/contract.go`), which computes the SHA-256 hash of a string: ```go title="sha256/contract.go" import ( "crypto/sha256" //... ) // ... func hashWithSHA256(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, HashWithSHA256GasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the HashWithSHA256Input. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackHashWithSHA256Input(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output [32]byte // CUSTOM CODE FOR AN OUTPUT output = sha256.Sum256([]byte(inputStruct)) packedOutput, err := PackHashWithSHA256Output(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` As you can see, we're performing the following steps: - Line 1: Importing the sha256 function from the crypto library (at the top of the Go file) - Line 15: Unpacking the input to the variable inputStruct. It doesn't make sense that the variable has Struct in its name, but you will see why it is done like this when we have multiple inputs in a later example - Line 24: Calling the sha256 function and assign its result to the output variable - Line 26: Packing the output into a byte array - Line 32: Returning the packed output, the remaining gas and nil, since no error has occurred ## Implementing the MD5 Precompile in `contract.go` Go ahead and implement the `md5/contract.go` for the MD5 precompile. You should only have to write a few lines of code. If you're unsure which function to use, the following documentation might help: [Go Documentation Crypto/md5](https://pkg.go.dev/crypto/md5#Sum) ```go title="md5/contract.go" import ( "crypto/md5" // ... ) // ... func hashWithMD5(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) {func hashWithMD5(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, HashWithMD5GasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the HashWithMD5Input. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackHashWithMD5Input(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output [16]byte // CUSTOM CODE FOR AN OUTPUT output = md5.Sum([]byte(inputStruct)) packedOutput, err := PackHashWithMD5Output(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` To solve this task, we did the following things: - Import the md5 function from the crypto library - Unpack the input to a variable inputStruct (It does not make sense that the variable has Struct in its name, but you will see why it is done like this when we have multiple inputs in a later example) - Call the md5 function and assign it's result to the output variable - Pack the output into a byte array - Return the packed output, the remaining gas and nil, since no error has occurred # ConfigKey, ContractAddress, and Genesis (/academy/avalanche-l1/customizing-evm/07-hash-function-precompile/05-configkey-and-contractaddr) --- title: ConfigKey, ContractAddress, and Genesis description: Learn how to set ConfigKey, ContractAddress, and update the genesis configuration. updated: 2024-09-27 authors: [ashucoder9, owenwahlgren] icon: Terminal --- ## Config Key The precompile config key is used to configure the precompile in the `chainConfig`. It's set in the `module.go` file of our precompile. The generator chooses an initial value that should be sufficient for many cases. In our case: ```go title="md5/module.go" // ConfigKey is the key used in json config files to specify this precompile precompileconfig. // must be unique across all precompiles. const ConfigKey = "md5Config" ``` This key is used for each precompile in the geneis configuration to set the activation timestamp of the precompile. ## Contract Address Each precompile has a unique contract address we can use to call it. This is the address we used earlier to instantiate the precompile in our solidity code or in remix when we interacted with the sha256 precompile. ```go title="md5/module.go" // ContractAddress is the defined address of the precompile contract. // This should be unique across all precompile contracts. // See precompile/registry/registry.go for registered precompile contracts and more information. var ContractAddress = common.HexToAddress("{ASUITABLEHEXADDRESS}") // SET A SUITABLE HEX ADDRESS HERE ``` The `0x01` range is reserved for precompiles added by Ethereum. The `0x02` range is reserved for precompiles provided by Avalanche. The `0x03` range is reserved for custom precompiles. Lets set our contract address to `0x0300000000000000000000000000000000000002` ```go title="md5/module.go" var ContractAddress = common.HexToAddress("0x0300000000000000000000000000000000000002") // SET A SUITABLE HEX ADDRESS HERE ``` ## Update Genesis Configuration Now that the `ConfigKey` and `ContractAddress` are set, we need to update the genesis configuration to register the precompile. ```json title=".devcontainer/genesis-example.json" { "config": { "chainId": 99999, "homesteadBlock": 0, "eip150Block": 0, "eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0", "eip155Block": 0, "eip158Block": 0, "byzantiumBlock": 0, "constantinopleBlock": 0, "petersburgBlock": 0, "istanbulBlock": 0, "muirGlacierBlock": 0, "subnetEVMTimestamp": 0, "feeConfig": { "gasLimit": 20000000, "minBaseFee": 1000000000, "targetGas": 100000000, "baseFeeChangeDenominator": 48, "minBlockGasCost": 0, "maxBlockGasCost": 10000000, "targetBlockRate": 2, "blockGasCostStep": 500000 }, "sha256Config": { "blockTimestamp": 0 }, "md5Config": { // [!code highlight:3] "blockTimestamp": 0 } }, "alloc": { "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { "balance": "0x52B7D2DCC80CD2E4000000" } }, "nonce": "0x0", "timestamp": "0x0", "extraData": "0x00", "gasLimit": "0x1312D00", "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000" } ``` # Register Your Precompile (/academy/avalanche-l1/customizing-evm/07-hash-function-precompile/06-register-precompile) --- title: Register Your Precompile description: Learn how to register your precompile. updated: 2024-09-27 authors: [owenwahlgren] icon: Terminal --- The next step in developing our precompile is to **register it with precompile-evm**. Take a look at `plugin/main.go`. You should see the following file: ```go title="plugin/main.go" // (c) 2019-2023, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. package main import ( "fmt" "github.com/ava-labs/avalanchego/version" "github.com/ava-labs/subnet-evm/plugin/evm" "github.com/ava-labs/subnet-evm/plugin/runner" // Each precompile generated by the precompilegen tool has a self-registering init function // that registers the precompile with the subnet-evm. Importing the precompile package here // will cause the precompile to be registered with the subnet-evm. // ADD YOUR PRECOMPILE HERE //_ "github.com/ava-labs/precompile-evm/{yourprecompilepkg}" ) const Version = "v0.1.4" func main() { versionString := fmt.Sprintf("Precompile-EVM/%s Avalanche L1-EVM/%s [AvalancheGo=%s, rpcchainvm=%d]", Version, evm.Version, version.Current, version.RPCChainVMProtocol) runner.Run(versionString) } ``` As of now, we do not have any precompile registered. To reigster a precompile, simply import the precompile package in the `plugin/main.go` file. ```go title="plugin/main.go" // (c) 2019-2023, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. package main import ( "fmt" "github.com/ava-labs/avalanchego/version" "github.com/ava-labs/subnet-evm/plugin/evm" "github.com/ava-labs/subnet-evm/plugin/runner" // Each precompile generated by the precompilegen tool has a self-registering init function // that registers the precompile with the subnet-evm. Importing the precompile package here // will cause the precompile to be registered with the subnet-evm. _ "github.com/ava-labs/precompile-evm/sha256"// [!code highlight:2] _ "github.com/ava-labs/precompile-evm/md5" ) const Version = "v0.1.4" func main() { versionString := fmt.Sprintf("Precompile-EVM/%s Avalanche L1-EVM/%s [AvalancheGo=%s, rpcchainvm=%d]", Version, evm.Version, version.Current, version.RPCChainVMProtocol) runner.Run(versionString) } ``` # Build and Run (/academy/avalanche-l1/customizing-evm/07-hash-function-precompile/07-build-and-run) --- title: Build and Run description: Learn how to build and run your custom VM on a local network. updated: 2024-09-27 authors: [ashucoder9, owenwahlgren] icon: Terminal --- Time to build and run your customized EVM. Follow the steps below to build and run your custom VM on a local network. ### Build Your Custom VM There's a simple build script in the Precompile-EVM we can utilize to build. First, make sure you are in the root folder of you Precompile-EVM: ```bash cd $GOPATH/src/github.com/ava-labs/precompile-evm ``` Then run the command to initiate the build script: ```bash ./scripts/build.sh ``` If you do not see any error, the build was successful. ### Create your blockchain configuration You can run you customized Precompile-EVM by using the Avalanche CLI. First, create the configuration for your blockchain with custom VM. ```bash avalanche blockchain create myblockchain \ --custom \ --vm $VM_PATH \ --genesis "./.devcontainer/genesis-example.json" \ --force \ --sovereign=false \ --evm-token "TOK" \ --warp \ --icm ``` ### Launch L1 with you customized EVM Next, launch the Avalanche L1 with your custom VM: ```bash avalanche blockchain deploy myblockchain --local ``` After around 1 minute the blockchain should have been created and some more output should appear in the terminal. You'll also see the RPC URL of your blockchain in the terminal. # Interact with Precompile (/academy/avalanche-l1/customizing-evm/07-hash-function-precompile/08-interact-with-md5) --- title: Interact with Precompile description: Interact with the MD5 precompile we just deployed. updated: 2024-08-27 authors: [owenwahlgren] icon: Terminal --- ## Call Precompile from Foundry Now we will call our MD5 precompile to generate a bytes16 hash of the input string. **MD5 Precompile Address:** `0x0300000000000000000000000000000000000002` ```bash cast call --rpc-url myblockchain --private-key $PK 0x0300000000000000000000000000000000000002 "hashWithMD5(string)(bytes16)" "test" ``` You should see the bytes16 hash of the input string `test` as the output. ```bash 0x098f6bcd4621d373cade4e832627b4f6 ``` # Overview (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/00-intro) --- title: Overview description: Learn how to create a Calculator precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Book --- import { Step, Steps } from 'fumadocs-ui/components/steps'; ## Reference Implementation In this section, we will showcase how to build a more complex precompile that offers selected simple math operations. Our calculator will support the following operations: 1. Add two numbers and return the result (3 + 5 = 8) 2. Get the next two greater numbers (7 => 8, 9) 3. Repeat a string x times (4, b => bbbb) This is somewhat odd calculator and real-life usability might not be the best, but as you will see in a bit the operations have been chosen to demonstrate some different scenarios we might face while building precompiles. ## What You Are Building Similar to the Calculator precompile, you will be building a precompile called **CalculatorPlus** which contains the following mathematical functions: - **Powers of Three**: takes in as input an integer base; returns the square, cube, and 4th power of the input - **Modulo+**: takes in as input two arguments: the dividend and the divisor. Returns how many times the dividend fits in the divisor, and the remainder. - **Simplify Fraction**: takes in two arguments: the numerator and the denominator. Returns the simplfied version of the fraction (if the denominator is 0, we return 0) ## Overview of Steps Compared to the process before, we will now also add tests for our precompile. Here's a quick overview of the steps we're going to follow: Create a Solidity interface for the precompile Generate the ABI Write the precompile code in Go Configure and register the precompile Add and run tests Build and run your customized EVM Connect Remix to your customized EVM and interact with the precompile This tutorial will help you understand how to create more complex precompiles. Let's begin! # Create Solidity Interface (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/01-create-solidity-interface) --- title: Create Solidity Interface description: Learn how to create the Solidity interface for your calculator precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- Just like in the MD5 section, we will start off by first demonstrating the Solidity interface for the Calculator precompile before guiding you on how to build the **CalculatorPlus** precompile. To start, let's take a look at the Calculator Solidity interface: ```solidity title="contracts/contracts/interfaces/ICalculator.sol" // SPDX-License-Identifier: MIT pragma solidity >=0.8.0; interface ICalculator { function add(uint value1, uint value2) external view returns(uint result); function nextTwo(uint value1) external view returns(uint result1, uint result2); function repeat(uint times, string memory text) external view returns(string memory result); } ``` With this in mind, let's define the CalculatorPlus Solidity interface. Your interface should have the following three functions: 1. `powOfThree`: takes in an unsigned integer base, and returns three unsigned integers named secondPow, thirdPow, fourthPow . 2. `moduloPlus`: takes in unsigned integers dividend and divisor as input, and returns two unsigned integers named multiple and remainder . 3. `simplFrac`: takes in unsigned integers named numerator and denominator, and returns two unsigned integers named simplNum and simplDenom ```solidity title="solidity/interfaces/ICalculatorPlus.sol" // SPDX-License-Identifier: MIT pragma solidity >=0.8.0; interface ICalculatorPlus { function powOfThree(uint256 base) external view returns(uint256 secondPow, uint256 thirdPow, uint256 fourthPow); function moduloPlus(uint256 dividend, uint256 divisor) external view returns(uint256 multiple, uint256 remainder); function simplFrac(uint256 numerator, uint256 denominator) external view returns(uint256 simplNum, uint256 simplDenom); } ``` ## Generate the ABI Now that we have an interface of our precompile, let's create an ABI of our Solidity interface. Open the terminal (control + \`), change to the `/contracts` directory and run the following command to compile the solidity interface to the ABI: ```bash # Go to the upper contracts directory of your project cd contracts # Compile ICalculatorPlus.sol to ABI npx solc@latest --abi ./contracts/interfaces/ICalculatorPlus.sol -o ./abis --base-path . --include-path ./node_modules # Rename using this script or manually mv ./abis/contracts_interfaces_ICalculatorPlus_sol_ICalculatorPlus.abi ./abis/ICalculatorPlus.abi ``` Now you should have a file called `ICalculatorPlus.abi` in the folder `/contracts/abis` with the following content: ```json title="/contracts/abis/ICalculatorPlus.abi" [ { "inputs": [ { "internalType": "uint256", "name": "dividend", "type": "uint256" }, { "internalType": "uint256", "name": "divisor", "type": "uint256" } ], "name": "moduloPlus", "outputs": [ { "internalType": "uint256", "name": "multiple", "type": "uint256" }, { "internalType": "uint256", "name": "remainder", "type": "uint256" } ], "stateMutability": "view", "type": "function" }, { "inputs": [ { "internalType": "uint256", "name": "base", "type": "uint256" } ], "name": "powOfThree", "outputs": [ { "internalType": "uint256", "name": "secondPow", "type": "uint256" }, { "internalType": "uint256", "name": "thirdPow", "type": "uint256" }, { "internalType": "uint256", "name": "fourthPow", "type": "uint256" } ], "stateMutability": "view", "type": "function" }, { "inputs": [ { "internalType": "uint256", "name": "numerator", "type": "uint256" }, { "internalType": "uint256", "name": "denominator", "type": "uint256" } ], "name": "simplFrac", "outputs": [ { "internalType": "uint256", "name": "simplNum", "type": "uint256" }, { "internalType": "uint256", "name": "simplDenom", "type": "uint256" } ], "stateMutability": "view", "type": "function" } ] ``` # Generating the Precompile (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/02-generating-precompile) --- title: Generating the Precompile description: Learn how to generating the precompile updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- In this step, we will again utilize the precompile generation script to generate all the Go files based on the ABI for your calculator. ## Run Generation Script Change to the root directory of your precompile-evm project and run the command to generate the go files: ```bash # Change to root cd .. # Generate go files ./scripts/generate_precompile.sh --abi ./contracts/abis/ICalculatorPlus.abi --type Calculatorplus --pkg calculatorplus --out ./calculatorplus ``` Now you should have a new directory called `calculatorplus` in the root directory of your project. If you check our the generated contract.go file you will see right away that it is much longer than in our hash function precompile from earlier. This is due to the fact that our calculator precompile has more functions and parameters. Browse through the code and see if you can spot the new elements: ```go title="contract.go" // Code generated // This file is a generated precompile contract config with stubbed abstract functions. // The file is generated by a template. Please inspect every code and comment in this file before use. package calculatorplus import ( "errors" "fmt" "math/big" "github.com/ava-labs/subnet-evm/accounts/abi" "github.com/ava-labs/subnet-evm/precompile/contract" "github.com/ava-labs/subnet-evm/vmerrs" _ "embed" "github.com/ethereum/go-ethereum/common" ) const ( // Gas costs for each function. These are set to 1 by default. // You should set a gas cost for each function in your contract. // Generally, you should not set gas costs very low as this may cause your network to be vulnerable to DoS attacks. // There are some predefined gas costs in contract/utils.go that you can use. ModuloPlusGasCost uint64 = 1 /* SET A GAS COST HERE */ PowOfThreeGasCost uint64 = 1 /* SET A GAS COST HERE */ SimplFracGasCost uint64 = 1 /* SET A GAS COST HERE */ ) // CUSTOM CODE STARTS HERE // Reference imports to suppress errors from unused imports. This code and any unnecessary imports can be removed. var ( _ = abi.JSON _ = errors.New _ = big.NewInt _ = vmerrs.ErrOutOfGas _ = common.Big0 ) // Singleton StatefulPrecompiledContract and signatures. var ( // CalculatorplusRawABI contains the raw ABI of Calculatorplus contract. //go:embed contract.abi CalculatorplusRawABI string CalculatorplusABI = contract.ParseABI(CalculatorplusRawABI) CalculatorplusPrecompile = createCalculatorplusPrecompile() ) type ModuloPlusInput struct { Dividend *big.Int Divisor *big.Int } type ModuloPlusOutput struct { Multiple *big.Int Remainder *big.Int } type PowOfThreeOutput struct { SecondPow *big.Int ThirdPow *big.Int FourthPow *big.Int } type SimplFracInput struct { Numerator *big.Int Denominator *big.Int } type SimplFracOutput struct { SimplNum *big.Int SimplDenom *big.Int } // UnpackModuloPlusInput attempts to unpack [input] as ModuloPlusInput // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackModuloPlusInput(input []byte) (ModuloPlusInput, error) { inputStruct := ModuloPlusInput{} err := CalculatorplusABI.UnpackInputIntoInterface(&inputStruct, "moduloPlus", input) return inputStruct, err } // PackModuloPlus packs [inputStruct] of type ModuloPlusInput into the appropriate arguments for moduloPlus. func PackModuloPlus(inputStruct ModuloPlusInput) ([]byte, error) { return CalculatorplusABI.Pack("moduloPlus", inputStruct.Dividend, inputStruct.Divisor) } // PackModuloPlusOutput attempts to pack given [outputStruct] of type ModuloPlusOutput // to conform the ABI outputs. func PackModuloPlusOutput(outputStruct ModuloPlusOutput) ([]byte, error) { return CalculatorplusABI.PackOutput("moduloPlus", outputStruct.Multiple, outputStruct.Remainder, ) } // UnpackModuloPlusOutput attempts to unpack [output] as ModuloPlusOutput // assumes that [output] does not include selector (omits first 4 func signature bytes) func UnpackModuloPlusOutput(output []byte) (ModuloPlusOutput, error) { outputStruct := ModuloPlusOutput{} err := CalculatorplusABI.UnpackIntoInterface(&outputStruct, "moduloPlus", output) return outputStruct, err } func moduloPlus(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, ModuloPlusGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the ModuloPlusInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackModuloPlusInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output ModuloPlusOutput // CUSTOM CODE FOR AN OUTPUT packedOutput, err := PackModuloPlusOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } // UnpackPowOfThreeInput attempts to unpack [input] into the *big.Int type argument // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackPowOfThreeInput(input []byte) (*big.Int, error) { res, err := CalculatorplusABI.UnpackInput("powOfThree", input) if err != nil { return new(big.Int), err } unpacked := *abi.ConvertType(res[0], new(*big.Int)).(**big.Int) return unpacked, nil } // PackPowOfThree packs [base] of type *big.Int into the appropriate arguments for powOfThree. // the packed bytes include selector (first 4 func signature bytes). // This function is mostly used for tests. func PackPowOfThree(base *big.Int) ([]byte, error) { return CalculatorplusABI.Pack("powOfThree", base) } // PackPowOfThreeOutput attempts to pack given [outputStruct] of type PowOfThreeOutput // to conform the ABI outputs. func PackPowOfThreeOutput(outputStruct PowOfThreeOutput) ([]byte, error) { return CalculatorplusABI.PackOutput("powOfThree", outputStruct.SecondPow, outputStruct.ThirdPow, outputStruct.FourthPow, ) } // UnpackPowOfThreeOutput attempts to unpack [output] as PowOfThreeOutput // assumes that [output] does not include selector (omits first 4 func signature bytes) func UnpackPowOfThreeOutput(output []byte) (PowOfThreeOutput, error) { outputStruct := PowOfThreeOutput{} err := CalculatorplusABI.UnpackIntoInterface(&outputStruct, "powOfThree", output) return outputStruct, err } func powOfThree(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, PowOfThreeGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the PowOfThreeInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackPowOfThreeInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output PowOfThreeOutput // CUSTOM CODE FOR AN OUTPUT packedOutput, err := PackPowOfThreeOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } // UnpackSimplFracInput attempts to unpack [input] as SimplFracInput // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackSimplFracInput(input []byte) (SimplFracInput, error) { inputStruct := SimplFracInput{} err := CalculatorplusABI.UnpackInputIntoInterface(&inputStruct, "simplFrac", input) return inputStruct, err } // PackSimplFrac packs [inputStruct] of type SimplFracInput into the appropriate arguments for simplFrac. func PackSimplFrac(inputStruct SimplFracInput) ([]byte, error) { return CalculatorplusABI.Pack("simplFrac", inputStruct.Numerator, inputStruct.Denominator) } // PackSimplFracOutput attempts to pack given [outputStruct] of type SimplFracOutput // to conform the ABI outputs. func PackSimplFracOutput(outputStruct SimplFracOutput) ([]byte, error) { return CalculatorplusABI.PackOutput("simplFrac", outputStruct.SimplNum, outputStruct.SimplDenom, ) } // UnpackSimplFracOutput attempts to unpack [output] as SimplFracOutput // assumes that [output] does not include selector (omits first 4 func signature bytes) func UnpackSimplFracOutput(output []byte) (SimplFracOutput, error) { outputStruct := SimplFracOutput{} err := CalculatorplusABI.UnpackIntoInterface(&outputStruct, "simplFrac", output) return outputStruct, err } func simplFrac(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, SimplFracGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the SimplFracInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackSimplFracInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output SimplFracOutput // CUSTOM CODE FOR AN OUTPUT packedOutput, err := PackSimplFracOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } // createCalculatorplusPrecompile returns a StatefulPrecompiledContract with getters and setters for the precompile. func createCalculatorplusPrecompile() contract.StatefulPrecompiledContract { var functions []*contract.StatefulPrecompileFunction abiFunctionMap := map[string]contract.RunStatefulPrecompileFunc{ "moduloPlus": moduloPlus, "powOfThree": powOfThree, "simplFrac": simplFrac, } for name, function := range abiFunctionMap { method, ok := CalculatorplusABI.Methods[name] if !ok { panic(fmt.Errorf("given method (%s) does not exist in the ABI", name)) } functions = append(functions, contract.NewStatefulPrecompileFunction(method.ID, function)) } // Construct the contract with no fallback function. statefulContract, err := contract.NewStatefulPrecompileContract(nil, functions) if err != nil { panic(err) } return statefulContract } ``` # Unpacking Multiple Inputs & Packing Multiple Outputs (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/03-unpacking-and-packing) --- title: Unpacking Multiple Inputs & Packing Multiple Outputs description: Learn how to unpack multiple inputs and packing multiple outputs. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- ## Unpack/Pack Functions For Each Operation As with the MD5 precompile, the generator created the pack/unpack functions for each operation of our Calculator and CalculatorPlus precompiles. However, you might have noticed that the generator also created some struct in each respective `contract.go` file. In the case of CalculatorPrecompile, we have: ```go title="contract.go" type AddInput struct { Value1 *big.Int Value2 *big.Int } type NextTwoOutput struct { Result1 *big.Int Result2 *big.Int } type RepeatInput struct { Times *big.Int Text string } ``` The generator creates these structs whenever a function defined in the respective Solidity interface has more than one input or more than one output. These multiple values are now stored together via structs. ## Unpacking Multiple Inputs To understand how unpacking works when structs are introduced, let's take a look at the add function in the Calculator precompile, which takes in two inputs, and the nextTwo, which takes in only one input. ```go // UnpackAddInput attempts to unpack [input] as AddInput // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackAddInput(input []byte) (AddInput, error) { inputStruct := AddInput{} err := CalculatorABI.UnpackInputIntoInterface(&inputStruct, "add", input) return inputStruct, err } // UnpackNextTwoInput attempts to unpack [input] into the *big.Int type argument // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackNextTwoInput(input []byte) (*big.Int, error) { res, err := CalculatorABI.UnpackInput("nextTwo", input) if err != nil { return big.NewInt(0), err } unpacked := *abi.ConvertType(res[0], new(*big.Int)).(**big.Int) return unpacked, nil } ``` As you can see, both unpacker functions take a byte array as an input but the `UnpackAddInput` returns a value of the type `AddInput` (which contains two `big.Int` values) and `UnpackNextTwoInput` returns a value of the type `big.Int`. In each case, the respective unpacking function takes in a byte array as an input. However, `UnpackAddInput` returns a value of the type `AddInput`, which is a struct that contains two `big.Int` values. `UnpackNextTwo`, meanwhile, returns an value of type `big.Int`. To demonstrate how one could use the output of unpacking functions like `UnpackAddInput`, below is the implementation of the add function of the Calculator precompile: ```go func add(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, AddGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the AddInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackAddInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE var output *big.Int // CUSTOM CODE FOR AN OUTPUT output = big.NewInt(0).Add(inputStruct.Value1, inputStruct.Value2) packedOutput, err := PackAddOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` ## Packing Multiple Outputs To understand how structs affect the packing of outputs, lets refer to `PackNextTwoOutput` for the Calculator precompile: ```go // PackHashWithMd5Output attempts to pack given hash of type [16] // PackNextTwoOutput attempts to pack given [outputStruct] of type NextTwoOutput // to conform the ABI outputs. func PackNextTwoOutput(outputStruct NextTwoOutput) ([]byte, error) { return CalculatorABI.PackOutput("nextTwo", outputStruct.Result1, outputStruct.Result2, ) } ``` Notice here that even though we are no longer working with singular types, the generator still is able to pack our struct so that it is of the type bytes. As a result, we are able to return the packed version of any `NextTwoOutput` struct as bytes at the end of nextTwo. # Implementing Precompile (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/04-implementing-precompile) --- title: Implementing Precompile description: Learn how to implement the precompile in `contract.go` updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- In this section, we will go define the logic for our CalculatorPlus precompile; in particular, we want to add the logic for the following three functions: `powOfThree`, `moduloPlus`, and `simplFrac`. For those worried about this section - don't be! Our solution only added 12 lines of code to `contract.go`. ## Looking at Calculator Before we define the logic of CalculatorPlus, we first will examine the implementation of the Calculator precompile: ```go func add(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, AddGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the AddInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackAddInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output *big.Int // CUSTOM CODE FOR AN OUTPUT output = big.NewInt(0).Add(inputStruct.Value1, inputStruct.Value2) packedOutput, err := PackAddOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } // ... func repeat(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, RepeatGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the RepeatInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackRepeatInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output string // CUSTOM CODE FOR AN OUTPUT output = strings.Repeat(inputStruct.Text, int(inputStruct.Times.Int64())) packedOutput, err := PackRepeatOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } // ... func nextTwo(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, NextTwoGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the NextTwoInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackNextTwoInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output NextTwoOutput // CUSTOM CODE FOR AN OUTPUT output.Result1 = big.NewInt(0).Add(inputStruct, big.NewInt(1)) output.Result2 = big.NewInt(0).Add(inputStruct, big.NewInt(2)) packedOutput, err := PackNextTwoOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` Although the code snippet above may be long, you might notice that we added only four lines of code to the autogenerated code provided to us by Precompile-EVM! In particular, we only added lines 19, 48, 79, and 80. In general, note the following: - Structs vs Singular Values: make sure to keep track which inputs/outputs are structs and which one are values like big.Int. As an example, in `nextTwo`, we are dealing with a big.Int type input. However, in repeat, we are passed in a input of type struct RepeatInput. - Documentation: for both Calculator and CalculatorPlus, the big package documentation is of great reference: https://pkg.go.dev/math/big Now that we have looked at the implementation for the Calculator precompile, its time you define the CalculatorPlus precompile! ## Implementing moduloPlus We start by looking at the starter code for `moduloPlus`: ```go func moduloPlus(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, ModuloPlusGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the ModuloPlusInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackModuloPlusInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output ModuloPlusOutput // CUSTOM CODE FOR AN OUTPUT packedOutput, err := PackModuloPlusOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` We want to note the following: - `inputStruct` is the input that we want to work with (i.e. `inputStruct` contains the two numbers that we want to use for the modulo calculation) - All of our code will go after line 15 - We want the struct output to contain the result of our modulo operation (the struct will contain the multiple and remainder) With this in mind, try to implement `moduloPlus`. ```go func moduloPlus(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) {func moduloPlus(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, ModuloPlusGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the ModuloPlusInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackModuloPlusInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output ModuloPlusOutput // CUSTOM CODE FOR AN OUTPUT output.Multiple, output.Remainder = big.NewInt(0).DivMod(inputStruct.Dividend, inputStruct.Divisor, output.Remainder) packedOutput, err := PackModuloPlusOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` ## Implementing powOfThree Likewise, for `powOfThree`, we want to define the logic of the function in the custom code section. However, note that while we are working with an output struct, our input is a singular value. With this in mind, take a crack at implementing `powOfThree`: ```go func powOfThree(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) {func powOfThree(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, PowOfThreeGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the PowOfThreeInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackPowOfThreeInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output PowOfThreeOutput // CUSTOM CODE FOR AN OUTPUT output.SecondPow = big.NewInt(0).Exp(inputStruct, big.NewInt(2), nil) output.ThirdPow = big.NewInt(0).Exp(inputStruct, big.NewInt(3), nil) output.FourthPow = big.NewInt(0).Exp(inputStruct, big.NewInt(4), nil) packedOutput, err := PackPowOfThreeOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` ## Implementing simplFrac For implementing `simplFrac`, note the following: - The documentation for the big package will be of use here - Remember to take care of the case when the denominator is 0 ```go func simplFrac(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) {func simplFrac(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, SimplFracGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the SimplFracInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackSimplFracInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output SimplFracOutput // CUSTOM CODE FOR AN OUTPUT // If denominator is 0, return both 0 if inputStruct.Denominator.Cmp(big.NewInt(0)) == 0 { output.SimplDenom = big.NewInt(0) output.SimplNum = big.NewInt(0) } else { // First, find common denominator var gcd big.Int gcd.GCD(nil, nil, inputStruct.Numerator, inputStruct.Denominator) // Now, simplify fraction output.SimplNum = big.NewInt(0).Div(inputStruct.Numerator, &gcd) output.SimplDenom = big.NewInt(0).Div(inputStruct.Denominator, &gcd) } packedOutput, err := PackSimplFracOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` ## Final Solution Below is the final solution for the CalculatorPlus precompile: ```go // Code generated // This file is a generated precompile contract config with stubbed abstract functions. // The file is generated by a template. Please inspect every code and comment in this file before use. package calculatorplus import ( "errors" "fmt" "math/big" "github.com/ava-labs/subnet-evm/accounts/abi" "github.com/ava-labs/subnet-evm/precompile/contract" "github.com/ava-labs/subnet-evm/vmerrs" _ "embed" "github.com/ethereum/go-ethereum/common" ) const ( // Gas costs for each function. These are set to 1 by default. // You should set a gas cost for each function in your contract. // Generally, you should not set gas costs very low as this may cause your network to be vulnerable to DoS attacks. // There are some predefined gas costs in contract/utils.go that you can use. ModuloPlusGasCost uint64 = 1 /* SET A GAS COST HERE */ PowOfThreeGasCost uint64 = 1 /* SET A GAS COST HERE */ SimplFracGasCost uint64 = 1 /* SET A GAS COST HERE */ ) // CUSTOM CODE STARTS HERE // Reference imports to suppress errors from unused imports. This code and any unnecessary imports can be removed. var ( _ = abi.JSON _ = errors.New _ = big.NewInt _ = vmerrs.ErrOutOfGas _ = common.Big0 ) // Singleton StatefulPrecompiledContract and signatures. var ( // CalculatorplusRawABI contains the raw ABI of Calculatorplus contract. //go:embed contract.abi CalculatorplusRawABI string CalculatorplusABI = contract.ParseABI(CalculatorplusRawABI) CalculatorplusPrecompile = createCalculatorplusPrecompile() ) type ModuloPlusInput struct { Dividend *big.Int Divisor *big.Int } type ModuloPlusOutput struct { Multiple *big.Int Remainder *big.Int } type PowOfThreeOutput struct { SecondPow *big.Int ThirdPow *big.Int FourthPow *big.Int } type SimplFracInput struct { Numerator *big.Int Denominator *big.Int } type SimplFracOutput struct { SimplNum *big.Int SimplDenom *big.Int } // UnpackModuloPlusInput attempts to unpack [input] as ModuloPlusInput // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackModuloPlusInput(input []byte) (ModuloPlusInput, error) { inputStruct := ModuloPlusInput{} err := CalculatorplusABI.UnpackInputIntoInterface(&inputStruct, "moduloPlus", input) return inputStruct, err } // PackModuloPlus packs [inputStruct] of type ModuloPlusInput into the appropriate arguments for moduloPlus. func PackModuloPlus(inputStruct ModuloPlusInput) ([]byte, error) { return CalculatorplusABI.Pack("moduloPlus", inputStruct.Dividend, inputStruct.Divisor) } // PackModuloPlusOutput attempts to pack given [outputStruct] of type ModuloPlusOutput // to conform the ABI outputs. func PackModuloPlusOutput(outputStruct ModuloPlusOutput) ([]byte, error) { return CalculatorplusABI.PackOutput("moduloPlus", outputStruct.Multiple, outputStruct.Remainder, ) } // UnpackModuloPlusOutput attempts to unpack [output] as ModuloPlusOutput // assumes that [output] does not include selector (omits first 4 func signature bytes) func UnpackModuloPlusOutput(output []byte) (ModuloPlusOutput, error) { outputStruct := ModuloPlusOutput{} err := CalculatorplusABI.UnpackIntoInterface(&outputStruct, "moduloPlus", output) return outputStruct, err } func moduloPlus(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, ModuloPlusGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the ModuloPlusInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackModuloPlusInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output ModuloPlusOutput // CUSTOM CODE FOR AN OUTPUT output.Multiple, output.Remainder = big.NewInt(0).DivMod(inputStruct.Dividend, inputStruct.Divisor, output.Remainder) packedOutput, err := PackModuloPlusOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } // UnpackPowOfThreeInput attempts to unpack [input] into the *big.Int type argument // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackPowOfThreeInput(input []byte) (*big.Int, error) { res, err := CalculatorplusABI.UnpackInput("powOfThree", input) if err != nil { return new(big.Int), err } unpacked := *abi.ConvertType(res[0], new(*big.Int)).(**big.Int) return unpacked, nil } // PackPowOfThree packs [base] of type *big.Int into the appropriate arguments for powOfThree. // the packed bytes include selector (first 4 func signature bytes). // This function is mostly used for tests. func PackPowOfThree(base *big.Int) ([]byte, error) { return CalculatorplusABI.Pack("powOfThree", base) } // PackPowOfThreeOutput attempts to pack given [outputStruct] of type PowOfThreeOutput // to conform the ABI outputs. func PackPowOfThreeOutput(outputStruct PowOfThreeOutput) ([]byte, error) { return CalculatorplusABI.PackOutput("powOfThree", outputStruct.SecondPow, outputStruct.ThirdPow, outputStruct.FourthPow, ) } // UnpackPowOfThreeOutput attempts to unpack [output] as PowOfThreeOutput // assumes that [output] does not include selector (omits first 4 func signature bytes) func UnpackPowOfThreeOutput(output []byte) (PowOfThreeOutput, error) { outputStruct := PowOfThreeOutput{} err := CalculatorplusABI.UnpackIntoInterface(&outputStruct, "powOfThree", output) return outputStruct, err } func powOfThree(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, PowOfThreeGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the PowOfThreeInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackPowOfThreeInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output PowOfThreeOutput // CUSTOM CODE FOR AN OUTPUT output.SecondPow = big.NewInt(0).Exp(inputStruct, big.NewInt(2), nil) output.ThirdPow = big.NewInt(0).Exp(inputStruct, big.NewInt(3), nil) output.FourthPow = big.NewInt(0).Exp(inputStruct, big.NewInt(4), nil) packedOutput, err := PackPowOfThreeOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } // UnpackSimplFracInput attempts to unpack [input] as SimplFracInput // assumes that [input] does not include selector (omits first 4 func signature bytes) func UnpackSimplFracInput(input []byte) (SimplFracInput, error) { inputStruct := SimplFracInput{} err := CalculatorplusABI.UnpackInputIntoInterface(&inputStruct, "simplFrac", input) return inputStruct, err } // PackSimplFrac packs [inputStruct] of type SimplFracInput into the appropriate arguments for simplFrac. func PackSimplFrac(inputStruct SimplFracInput) ([]byte, error) { return CalculatorplusABI.Pack("simplFrac", inputStruct.Numerator, inputStruct.Denominator) } // PackSimplFracOutput attempts to pack given [outputStruct] of type SimplFracOutput // to conform the ABI outputs. func PackSimplFracOutput(outputStruct SimplFracOutput) ([]byte, error) { return CalculatorplusABI.PackOutput("simplFrac", outputStruct.SimplNum, outputStruct.SimplDenom, ) } // UnpackSimplFracOutput attempts to unpack [output] as SimplFracOutput // assumes that [output] does not include selector (omits first 4 func signature bytes) func UnpackSimplFracOutput(output []byte) (SimplFracOutput, error) { outputStruct := SimplFracOutput{} err := CalculatorplusABI.UnpackIntoInterface(&outputStruct, "simplFrac", output) return outputStruct, err } func simplFrac(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, SimplFracGasCost); err != nil { return nil, 0, err } // attempts to unpack [input] into the arguments to the SimplFracInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackSimplFracInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE _ = inputStruct // CUSTOM CODE OPERATES ON INPUT var output SimplFracOutput // CUSTOM CODE FOR AN OUTPUT // If denominator is 0, return both 0 if inputStruct.Denominator.Cmp(big.NewInt(0)) == 0 { output.SimplDenom = big.NewInt(0) output.SimplNum = big.NewInt(0) } else { // First, find common denominator var gcd big.Int gcd.GCD(nil, nil, inputStruct.Numerator, inputStruct.Denominator) // Now, simplify fraction output.SimplNum = big.NewInt(0).Div(inputStruct.Numerator, &gcd) output.SimplDenom = big.NewInt(0).Div(inputStruct.Denominator, &gcd) } packedOutput, err := PackSimplFracOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } // createCalculatorplusPrecompile returns a StatefulPrecompiledContract with getters and setters for the precompile. func createCalculatorplusPrecompile() contract.StatefulPrecompiledContract { var functions []*contract.StatefulPrecompileFunction abiFunctionMap := map[string]contract.RunStatefulPrecompileFunc{ "moduloPlus": moduloPlus, "powOfThree": powOfThree, "simplFrac": simplFrac, } for name, function := range abiFunctionMap { method, ok := CalculatorplusABI.Methods[name] if !ok { panic(fmt.Errorf("given method (%s) does not exist in the ABI", name)) } functions = append(functions, contract.NewStatefulPrecompileFunction(method.ID, function)) } // Construct the contract with no fallback function. statefulContract, err := contract.NewStatefulPrecompileContract(nil, functions) if err != nil { panic(err) } return statefulContract } ``` # Setting the ConfigKey & ContractAddress (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/05-set-configkey-contractaddr) --- title: Setting the ConfigKey & ContractAddress description: Learn how to set the ConfigKey, ContractAddress and register the Precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- ## ConfigKey Just as with the MD5 precompile in the previous section, go to the `module.go` file and set a `ConfigKey`. ## Contract Address In the same file, set a `ContractAddress`. Choose one that has not been used by other precompiles of earlier sections. ## Registration Go to the `plugin/main.go` file and register the new precompile. # Creating Genesis Block with precompileConfig (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/06-create-genesis-block) --- title: Creating Genesis Block with precompileConfig description: Learn how to create a genesis block with precompileConfig. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- In order to create a new Blockchain from our customized EVM, we have to define a Genesis block just as we did in out section earlier. To incorporate the CalculatorPlus precompile as part of the genesis block, we need to create a new genesis file and include a key for the CalculatorPlus precompile in the configuration JSON. This key, in particular, is the `configKey` that we specified in the `module.go` file of the Calculator precompile in the previous section. Copy over `Calculator.json` into a new file called `CalculatorPlus.json` and add the necessary key-pair value to the config. ```json title="CalculatorPlus.json" { "config": { "chainId": 99999, "homesteadBlock": 0, "eip150Block": 0, "eip150Hash": "0x2086799aeebeae135c246c65021c82b4e15a2c451340993aacfd2751886514f0", "eip155Block": 0, "eip158Block": 0, "byzantiumBlock": 0, "constantinopleBlock": 0, "petersburgBlock": 0, "istanbulBlock": 0, "muirGlacierBlock": 0, "subnetEVMTimestamp": 0, "feeConfig": { "gasLimit": 20000000, "minBaseFee": 1000000000, "targetGas": 100000000, "baseFeeChangeDenominator": 48, "minBlockGasCost": 0, "maxBlockGasCost": 10000000, "targetBlockRate": 2, "blockGasCostStep": 500000 }, "sha256Config": { "blockTimestamp": 0 }, "calculatorConfig": { "blockTimestamp": 0 }, "calculatorplusConfig" : { "blockTimestamp": 0 } }, "alloc": { "8db97C7cEcE249c2b98bDC0226Cc4C2A57BF52FC": { "balance": "0x52B7D2DCC80CD2E4000000" } }, "nonce": "0x0", "timestamp": "0x0", "extraData": "0x00", "gasLimit": "0x1312D00", "difficulty": "0x0", "mixHash": "0x0000000000000000000000000000000000000000000000000000000000000000", "coinbase": "0x0000000000000000000000000000000000000000", "number": "0x0", "gasUsed": "0x0", "parentHash": "0x0000000000000000000000000000000000000000000000000000000000000000" } ``` # Testing Precompiles via Go (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/07-testing-precompile) --- title: Testing Precompiles via Go description: Learn how to test your Precompiles using Golang. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- > Program testing can be used to show the presence of bugs, but never to show their absence. - Edsger W. Dijkstra Let's once again examine the functions of the Calculator precompile and what each one does (in layman terms): - `add`: computes the sum of two numbers - `nextTwo`: returns the next two numbers that come after the input given - `repeat`: repeats a string N number of times While we spent a good amount of time in the previous sections examining Calculator Solidity interface and the Go logic, we forgot to do one thing: *test the functionality of Calculator*. But why test? For some, it may seems pointless to test such basic functions. However, testing all functions is important because it helps validate our belief that the logic of our functions is what we intended them to be. In this section, we will focus on utilizing three types of tests for our Calculator precompile: 1. Autogenerated Tests 2. Unit Tests 3. Fuzz Tests # Modify Autogenerated Tests (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/08-autogenerated-tests) --- title: Modify Autogenerated Tests description: Learn how to modify autogenerated tests in Go. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- The autogenerated tests will help us making sure, that our precompile throw an error in case not enough gas is supplied. To start, go to calculator/contract_test.go, where you will see the following: ```go // Code generated // This file is a generated precompile contract test with the skeleton of test functions. // The file is generated by a template. Please inspect every code and comment in this file before use. package calculator import ( "testing" "github.com/ava-labs/subnet-evm/core/state" "github.com/ava-labs/subnet-evm/precompile/testutils" "github.com/ava-labs/subnet-evm/vmerrs" "github.com/ethereum/go-ethereum/common" "github.com/stretchr/testify/require" ) // These tests are run against the precompile contract directly with // the given input and expected output. They're just a guide to // help you write your own tests. These tests are for general cases like // allowlist, readOnly behaviour, and gas cost. You should write your own // tests for specific cases. var ( tests = map[string]testutils.PrecompileTest{ "insufficient gas for add should fail": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { // CUSTOM CODE STARTS HERE // populate test input here testInput := AddInput{} input, err := PackAdd(testInput) require.NoError(t, err) return input }, SuppliedGas: AddGasCost - 1, ReadOnly: false, ExpectedErr: vmerrs.ErrOutOfGas.Error(), }, "insufficient gas for nextTwo should fail": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { // CUSTOM CODE STARTS HERE // set test input to a value here var testInput *big.Int input, err := PackNextTwo(testInput) require.NoError(t, err) return input }, SuppliedGas: NextTwoGasCost - 1, ReadOnly: false, ExpectedErr: vmerrs.ErrOutOfGas.Error(), }, "insufficient gas for repeat should fail": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { // CUSTOM CODE STARTS HERE // populate test input here testInput := RepeatInput{} input, err := PackRepeat(testInput) require.NoError(t, err) return input }, SuppliedGas: RepeatGasCost - 1, ReadOnly: false, ExpectedErr: vmerrs.ErrOutOfGas.Error(), }, } ) // TestCalculatorEmptyRun tests the Run function of the precompile contract. func TestCalculatorEmptyRun(t *testing.T) { // Run tests. for name, test := range tests { t.Run(name, func(t *testing.T) { test.Run(t, Module, state.NewTestStateDB(t)) }) } } func BenchmarkCalculatorEmpty(b *testing.B) { // Benchmark tests. for name, test := range tests { b.Run(name, func(b *testing.B) { test.Bench(b, Module, state.NewTestStateDB(b)) }) } } ``` There is a lot to digest in `contract_test.go`, but the file can be divided into the following three sections: - Unit Tests - TestCalculatorEmptyRun - BenchmarkCalculator The autogenerated unit tests are stored in the variable var, which is a mapping from strings (the description of the tests cases) to individual unit tests (`testutils.PrecompileTest`). Upon inspecting the keys of each pair, you will see that all three autogenerated unit tests are checking the same thing that: `add`, `nextTwo`, and `repeat` fail if not enough gas is provided. Each test expects to fail when supplying too little gas: ```go { // ... SuppliedGas: RepeatGasCost - 1, ExpectedErr: vmerrs.ErrOutOfGas.Error(), } ``` As of currently, if you attempt to build and run the test cases, you will not get very far because there is one step we need to do to: pass in arguments for each autogenerated unit test. For each variable testInput defined in each unit test, add an argument. What argument to put down does not matter, it just needs to be a valid argument. An example of what arguments to put in can be found below: ```go var ( tests = map[string]testutils.PrecompileTest{ "insufficient gas for add should fail": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { // CUSTOM CODE STARTS HERE // populate test input here testInput := AddInput{big.NewInt(1), big.NewInt(1)} input, err := PackAdd(testInput) require.NoError(t, err) return input }, SuppliedGas: AddGasCost - 1, ReadOnly: false, ExpectedErr: vmerrs.ErrOutOfGas.Error(), }, "insufficient gas for nextTwo should fail": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { // CUSTOM CODE STARTS HERE // set test input to a value here // var testInput *big.Int testInput := big.NewInt(1) input, err := PackNextTwo(testInput) require.NoError(t, err) return input }, SuppliedGas: NextTwoGasCost - 1, ReadOnly: false, ExpectedErr: vmerrs.ErrOutOfGas.Error(), }, "insufficient gas for repeat should fail": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { // CUSTOM CODE STARTS HERE // populate test input here testInput := RepeatInput{big.NewInt(1), "EGS"} input, err := PackRepeat(testInput) require.NoError(t, err) return input }, SuppliedGas: RepeatGasCost - 1, ReadOnly: false, ExpectedErr: vmerrs.ErrOutOfGas.Error(), }, } ) ``` Now run the test by running the following command from the project root: ```bash ./scripts/build_test.sh ``` # Adding Unit Tests (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/09-unit-tests) --- title: Adding Unit Tests description: Learn how to add unit tests. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- Although the autogenerated units tests were useful in finding whether if the gas requirements of our functions were being fulfilled, we are yet to test the actual logic of our functions. We can add more unit tests by simply adding more mappings to the tests variable. To start, lets define the tests that we want to write for each function within our Calculator precompile: - `add`: check that **add(1, 2)** returns 3 - `nextTwo`: check that **nextTwo(1)** returns 2, 3 - `repeat`: check that **repeat(2, "EGS")** returns "EGSEGS" With this in mind, lets add the three units tests to the tests variable! Below is a code excerpt which shows the three unit tests incorporated: ```go var ( expectedNextTwoOutcome, _ = PackNextTwoOutput(NextTwoOutput{big.NewInt(2), big.NewInt(3)}) expectedRepeatOutcome, _ = PackRepeatOutput("EGSEGS") expectedAddOutcome = common.LeftPadBytes(big.NewInt(3).Bytes(), common.HashLength) tests = map[string]testutils.PrecompileTest{ "insufficient gas for add should fail": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { // CUSTOM CODE STARTS HERE // populate test input here testInput := AddInput{big.NewInt(1), big.NewInt(1)} input, err := PackAdd(testInput) require.NoError(t, err) return input }, SuppliedGas: AddGasCost - 1, ReadOnly: false, ExpectedErr: vmerrs.ErrOutOfGas.Error(), }, "insufficient gas for nextTwo should fail": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { // CUSTOM CODE STARTS HERE // set test input to a value here // var testInput *big.Int testInput := big.NewInt(1) input, err := PackNextTwo(testInput) require.NoError(t, err) return input }, SuppliedGas: NextTwoGasCost - 1, ReadOnly: false, ExpectedErr: vmerrs.ErrOutOfGas.Error(), }, "insufficient gas for repeat should fail": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { // CUSTOM CODE STARTS HERE // populate test input here testInput := RepeatInput{big.NewInt(1), "EGS"} input, err := PackRepeat(testInput) require.NoError(t, err) return input }, SuppliedGas: RepeatGasCost - 1, ReadOnly: false, ExpectedErr: vmerrs.ErrOutOfGas.Error(), }, "testing add": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { value1 := big.NewInt(1) value2 := big.NewInt(2) testInput := AddInput{value1, value2} input, err := PackAdd(testInput) require.NoError(t, err) return input }, SuppliedGas: AddGasCost, ReadOnly: true, ExpectedRes: expectedAddOutcome, }, "testing nextTwo": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { testInput := big.NewInt(1) input, err := PackNextTwo(testInput) require.NoError(t, err) return input }, SuppliedGas: NextTwoGasCost, ReadOnly: true, ExpectedRes: expectedNextTwoOutcome, }, "testing repeat": { Caller: common.Address{1}, InputFn: func(t testing.TB) []byte { baseString := "EGS" timesToRepeat := big.NewInt(2) input, err := PackRepeat(RepeatInput{timesToRepeat, baseString}) require.NoError(t, err) return input }, SuppliedGas: RepeatGasCost, ReadOnly: true, ExpectedRes: expectedRepeatOutcome, }, } ) ``` # Adding Fuzz Tests (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/10-fuzz-tests) --- title: Adding Fuzz Tests description: Learn how to add Fuzz tests. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- Units tests are useful when comparing the outcome of a predetermined input with the expected outcome. If we wanted to check that our function works as expected for all given inputs, the only way to show this would be to test every possible input. However, this is not possible for types such as uint256, as it would require us to test for 2^256 possible inputs. Even if we tested 1 input per second (or 2, 3, 4, 1000, etc.), this process would outlast the universe itself. Rather than testing every possible output, we can strengthen our confidence of the expected behavior of a function by testing a random sample of inputs. By testing randomly, we can test for inputs that we wouldn't have originally thought of and are able to see how our function behaves over a range of values. However, given that generating random inputs is not deterministic, we cannot use the tests variable itself. Rather, we will need to leverage the `TestCalculatorRun` function: ```go // TestCalculatorEmptyRun tests the Run function of the precompile contract. func TestCalculatorRun(t *testing.T) { // Run tests. for name, test := range tests { t.Run(name, func(t *testing.T) { test.Run(t, Module, state.NewTestStateDB(t)) }) } } ``` The `TestCalculatorRun` function, by default, iterates through each unit test defined in the tests variable on runs said tests. However, we are not limited to just using `TestCalculatorRun` for the unit tests in tests. We can expand the functionality of `TestCalculatorRun` by adding our fuzz tests. In particular, we can define the following logic for `TestCalculatorRun`: - Iterate N number of times - For each iteration, pick two numbers in the range from 0 to n - After picking two random numbers, create a unit test with the two random numbers as inputs and execute said unit test With this logic in mind, below is the code for how we would go about implementing fuzzing in `TestCalculatorRun`: ```go // TestCalculatorRun tests the Run function of the precompile contract. func TestCalculatorRun(t *testing.T) { // Run tests. for name, test := range tests { t.Run(name, func(t *testing.T) { test.Run(t, Module, state.NewTestStateDB(t)) }) } // Defining own test cases here N := 1_000 n := new(big.Int).Exp(big.NewInt(2), big.NewInt(int64(128)), nil) // Fuzzing N times for i := 0; i < N; i++ { // Adding randomization test here randomInt1, err := rand.Int(rand.Reader, n) randomInt2, err := rand.Int(rand.Reader, n) // Expected outcome expectedRandOutcome := common.LeftPadBytes(big.NewInt(0).Add(randomInt1, randomInt2).Bytes(), common.HashLength) // Pack add input randTestInput := AddInput{randomInt1, randomInt2} randInput, err := PackAdd(randTestInput) require.NoError(t, err) randTest := testutils.PrecompileTest{ Caller: common.Address{1}, Input: randInput, SuppliedGas: AddGasCost, ReadOnly: true, ExpectedRes: expectedRandOutcome, } t.Run("Testing random sum!", func(t *testing.T) { randTest.Run(t, Module, state.NewTestStateDB(t)) }) } } ``` # Testing CalculatorPlus (/academy/avalanche-l1/customizing-evm/08-calculator-precompile/11-test-calculatorplus) --- title: Testing CalculatorPlus description: Learn how to test CalculatorPlus precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Callout } from 'fumadocs-ui/components/callout'; Now that we have gone through an example of how to test the Calculator precompile, it is time that you develop your own tests for CalculatorPlus. Rather than explicitly tell you what test cases to write, we decided to leave that to you. After all, testing is a subjective profession - a test suite that fits one security needs might be inadequate for someone else. However, if you want an idea for what to test for, the following are some recommendations: - Unit Tests: create some unit tests involving values that you can come up with. Ideally, write 3-5 unit tests for each function. - Fuzz Tests: test more than 1000 random inputs for each function For both unit and fuzz tests, make sure to account for the case when the denominator is equal to 0 in `simplFrac`. # What are Stateful Precompiles? (/academy/avalanche-l1/customizing-evm/09-stateful-precompiles/00-intro) --- title: What are Stateful Precompiles? description: Learn about Stateful Precompiles in Avalanche L1 EVM. updated: 2024-05-31 authors: [ashucoder9] icon: Book --- When building the MD5 and Calculator precompiles, we emphasized their behavior. We focused on building precompiles that developers could call in Solidity to perform some algorithm and then simply return a result. However, one aspect that we have yet to explore is the statefulness of precompiles. Simply put, precompiles can store data which is persistent. To understand how this is possible, recall the interface that our precompile needed to implement: ```go // StatefulPrecompiledContract is the interface for executing a precompiled contract type StatefulPrecompiledContract interface { // Run executes the precompiled contract. Run(accessibleState AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) } ``` We also examined all parameters except for the `AccessibleState` parameter. As the name suggests, this parameter lets us access the blockchain's state. Looking at the interface of `AccessibleState`, we have the following: ```go // AccessibleState defines the interface exposed to stateful precompile contracts type AccessibleState interface { GetStateDB() StateDB GetBlockContext() BlockContext GetSnowContext() *snow.Context } ``` Looking closer, we see that `AccessibleState` gives us access to **StateDB**, which is used to store the state of the EVM. However, as we will see throughout this section, `AccessibleState` also gives us access to other useful parameters, such as `BlockContext` and `snow.Context`. ## StateDB The parameter we will use the most when it comes to stateful precompiles, StateDB, is a key-value mapping that maps: - **Key**: a tuple consisting of an address and the storage key of the type Hash - **Value**: any data encoded in a Hash, also called a word in the EVM A Hash in go-ethereum is a 32-byte array. In this context, we do not refer to hashing in the cryptographic sense. Rather, "hashing a value" means encoding it to a hash, a 32-byte array usually represented in hexadecimal digits in Ethereum. ```go const ( // HashLength is the expected length of the hash HashLength = 32 ) // Hash represents the 32 byte of arbitrary data. type Hash [HashLength]byte // Example of a data encoded in a Hash: // 0x00000000000000000000000000000000000000000048656c6c6f20576f726c64 Below is the interface of StateDB: // StateDB is the interface for accessing EVM state type StateDB interface { GetState(common.Address, common.Hash) common.Hash SetState(common.Address, common.Hash, common.Hash) SetNonce(common.Address, uint64) GetNonce(common.Address) uint64 GetBalance(common.Address) *big.Int AddBalance(common.Address, *big.Int) CreateAccount(common.Address) Exist(common.Address) bool AddLog(addr common.Address, topics []common.Hash, data []byte, blockNumber uint64) GetPredicateStorageSlots(address common.Address) ([]byte, bool) Suicide(common.Address) bool Finalise(deleteEmptyObjects bool) Snapshot() int RevertToSnapshot(int) } ``` As you can see in the interface of the **StateDB**, the two functions for writing to and reading from the EVM state all work with the Hash type. 1. The function **GetState** takes an address and a Hash (the storage key) as inputs and returns the Hash stored at that slot. 2. The function **SetState** takes an address, a Hash (the storage key), and another Hash (data to be stored) as inputs. We can also see that the **StateDB** interface allows us to read and write account balances of the native token (via GetBalance/SetBalance), check whether an account exists (via Exist), and some other methods. ## BlockContext `BlockContext` provides info about the current block. In particular, we can get the current block number and the current block timestamp. Below is the interface of `BlockContext`: ```go // BlockContext defines an interface that provides information to a stateful precompile about the current block. // The BlockContext may be provided during both precompile activation and execution. type BlockContext interface { Number() *big.Int Timestamp() *big.Int } ``` An example of how we could leverage `BlockContext` in precompiles: *building a voting precompile that only accepts votes within a certain time frame*. ## snow.Context `snow.Context` gives us info regarding the environment of the precompile. In particular, `snow.Context` tells us about the state of the network the precompile is hosted on. Below is the interface of `snow.Context`: ```go // Context is information about the current execution. // [NetworkID] is the ID of the network this context exists within. // [ChainID] is the ID of the chain this context exists within. // [NodeID] is the ID of this node type Context struct { NetworkID uint32 Avalanche L1ID ids.ID ChainID ids.ID NodeID ids.NodeID PublicKey *bls.PublicKey XChainID ids.ID CChainID ids.ID AVAXAssetID ids.ID Log logging.Logger Lock sync.RWMutex Keystore keystore.BlockchainKeystore SharedMemory atomic.SharedMemory BCLookup ids.AliaserReader Metrics metrics.OptionalGatherer WarpSigner warp.Signer // snowman++ attributes ValidatorState validators.State // interface for P-Chain validators // Chain-specific directory where arbitrary data can be written ChainDataDir string } ``` # Interacting with StringStore Precompile (/academy/avalanche-l1/customizing-evm/09-stateful-precompiles/01-interacting-with-precompile) --- title: Interacting with StringStore Precompile description: Learn how to interact with StringStore Stateful precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- Rather than understanding the statefulness of precompiles only in theory, we can also play around with an example of a stateful precompile to learn how they work in practice. In this section, we'll interact with the **StringStore** precompile, a precompiled smart contract that stores a string. ## Checking the Genesis JSON As part of all Avalanche Academy branches, your Precompile-EVM should include the **StringStore/** folder along with all other relevant files for StringStore to be recognized by Precompile-EVM. This includes a genesis JSON for StringStore. Go to `tests/precompile/genesis/` and double-check that you have a `StringStore.json` folder in said directory. This JSON files will instantiate both the **SHA256** precompile and **StringStore**. ```json title="StringStore.json" { "config": { "chainId": 99999, // ... "stringStoreConfig" : { "blockTimestamp": 0, "defaultString": "Cornell" } }, // ... } ``` ## Building the EVM with StringStore Precompile The **avalanche-academy-start** branch already contains the StringStore and SHA256 precompile. If you are working from that branch, you can simply use the built binary from your latest exercise without making any changes. To verify, check if the **stringstore** directory is in your workspace and if the precompile is noted in the `plugin/main.go` file. If not, switch to the **avalanche-academy-start** branch and build the VM there. ## Start the Avalanche Network Use the Avalanche-CLI to start the server and the network. Use the provided genesis file `stringstore.json` mentioned above when you start the network. If all goes well, you will have successfully deployed a blockchain containing both the StringStore and SHA256 precompile. ## Connecting Core Similar to previous chapters, navigate to the **Add Network** section in the Core Wallet. You can find the RPC URL in the Avalanche-CLI logs or by executing the command: `avalanche blockchain list --deployed` Note: Make sure the RPC URL ends with **/rpc**. The RPC URL should look something like this: http://127.0.0.1:9650/ext/bc/P9nKPGPoAfFGkdvD3Ac6YxZieaG8ahpbR9xZosrWNPbJCzByu/rpc Once you have added the blockchain network, switch Core Wallet to your blockchain. ## Interact through Remix We will now load in the Solidity interface letting us interact with the **StringStore** precompile. To do this, open the link below, which will open a Remix workspace containing the StringStore precompile: [Workspace](https://remix.ethereum.org/#url=https://github.com/ava-labs/precompile-evm/blob/avalanche-academy-start/contracts/contracts/interfaces/IStringStore.sol&lang=en&optimize=false&runs=200&evmVersion=null&version=soljson-v0.8.26+commit.8a97fa7a.js) As usual, we will need to compile our Solidity interface. 1. Click the **Solidity** logo on the left sidebar. 2. In the new page, you will see a **Compile IStringStore.sol** button. After clicking the button, a green checkmark should appear next to the Solidity logo. 3. Next, go to the **Environment** tab and select the **Injected Provider** option. If successful, a text saying **Custom [99999] Network** will appear below. If not, change your network. 4. Enter the precompile address (find it in `precompile/stringstore/module.go`) and click **At Address**. First, we will call the `getString` function. By default, `getString` will return whatever was specified in the genesis JSON. Since we set our StringStore precompile to store the string **Cornell**, it'll return this value. ![](https://qizat5l3bwvomkny.public.blob.vercel-storage.com/builders-hub/course-images/customizing-evm/48-THf1urUZpFdGgScCm6ZhNWVQITtsiq.png) As you might have noticed, we can also set the string that **StringStore** stores. For example, if we wanted to change the string to Avalanche, we would type Avalanche in the box next to `setString` method, press the `setString` button, and then you would see in the Remix terminal a message displaying the success of your transaction. If we call `getString` again, you will see that the string has been changed to Avalanche. Congrats, you've just interacted with the stateful **StringStore** precompile 🎉 In contrast to the precompiles we have built earlier, the StringStore precompile has access to the EVM state. This way we can utilize precompile not only to perform calculations, but also persist something to the EVM state. This allows us to move even larger portions of our dApp from the solidity smart contract layer to the precompile layer. # Creating Counter Precompile (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/00-intro) --- title: Creating Counter Precompile description: Learn how to create a Stateful Counter Precompiles in Avalanche L1 EVM. updated: 2024-05-31 authors: [ashucoder9] icon: Book --- ## What We Are Building It's time to build our first stateful precompile. In particular, we'll build a counter that keeps track of an integer. Our Counter precompile will have the following logic: - Users are able to get the current value of the counter - Users are able to set a new value to the counter - Users are able to increment the value of the counter To help you understand, we've provided a reference stateful precompile: **StringStore**. As the name suggests, StringStore stores a string that users can change. This string is stored in the EVM state. ## Overview of Steps Compared to the process before, we must also add tests for our precompile. Here's a quick overview of the steps we'll follow: 1. Create a Solidity interface for the precompile and generate the ABI 2. Generate the precompile Go boilerplate files 3. Write the precompile code in Go with access to the EVM state 4. Set the initial state in the configurator and register the precompile 5. Add and run tests 6. Build and run your customized EVM 7. Connect Remix to your customized EVM and interact with the counter This tutorial will help you create more complex precompiles. Let's begin! # Create Solidity Interface (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/01-create-solidity-interface) --- title: Create Solidity Interface description: Learn how to create a solidity interface for your counter precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- Now, we'll create a Solidity interface for our Stateful Precompile. ## StringStore Solidity Interface To start, let's look at the interface of the **StringStore** precompile: ```solidity title="contracts/contracts/interfaces/IStringStore.sol" // SPDX-License-Identifier: MIT pragma solidity >=0.8.0; interface IStringStore { function getString() external view returns (string memory value); function setString(string memory value) external; } ``` As seen above, we have the following two functions defined: 1. `getString`: retreives the string from the stateful precompile 2. `setString`: sets a string in the stateful precompile ## Create Solidity Interface for Counter Create an interface for the counter in the same directory called `ICounter.sol`. Your interface should have the following three functions declared: 1. `getCounter`: returns the counter value from the stateful precompile 2. `incrementCounter`: when called, this function increments the current counter 3. `setCounter`: takes in a value, and sets it as the counter of the stateful precompile For any argument/return value, make sure it is named as `value`. ```solidity // SPDX-License-Identifier: MIT pragma solidity >=0.8.0; interface ICounter { function getCounter() external view returns (uint value); function incrementCounter() external; function setCounter(uint value) external; } ``` ## Generate the ABI Now that we have an interface of our precompile, let's create an ABI of our Solidity interface. Open the terminal (control + \`), change to the `/contracts` directory, and run the command to compile the solidity interface to ABI: ```bash # Move to contracts directory cd contracts # Compile ICounter.sol to ABI npx solc@latest --abi ./contracts/interfaces/ICounter.sol -o ./abis --base-path . --include-path ./node_modules # Rename mv ./abis/contracts_interfaces_ICounter_sol_ICounter.abi ./abis/ICounter.abi ``` # Store Data in EVM State (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/02-store-data-in-evm) --- title: Store Data in EVM State description: Learn how to store data in the EVM state. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- Like all stateful machines, the EVM provides us with a way to save data. In particular, the EVM exposes a key-value mapping we can leverage to create stateful precompiles. The specifics of this mapping are as follows: - Key: a tuple consisting of an address and the storage key of the type Hash - Value: any data encoded in a Hash, also called a word in the EVM ## Storage Slots Each storage slot is uniquely identified by the combination of an address and a storage key. To keep things organized, smart contracts and precompiles use their own address and a storage key to store data related to them. Look at the reference implementation `StringStore`. The storage key is defined in the second variable group in `contract.go`: ```go // Singleton StatefulPrecompiledContract and signatures. var ( // StringStoreRawABI contains the raw ABI of StringStore contract. //go:embed contract.abi StringStoreRawABI string StringStoreABI = contract.ParseABI(StringStoreRawABI) StringStorePrecompile = createStringStorePrecompile() // Key that defines where our string will be stored storageKeyHash = common.BytesToHash([]byte("storageKey")) ) ``` We can use any string as our storage key. Then we convert it to a byte array and convert it to the hex representation. > The common.BytesToHash is not hashing the string, but converting it to a 32 byte array in hex representation. If we store multiple variables in the EVM state, we will define multiple keys here. Since we only use a single storage slot in this example, we can just call it `storageKey`. At this point, we are not restricted in what state we can access from the precompile. We have access to the entire `stateDB` and can modify the entire EVM state including data other precompiles saved to state or balances of accounts. **This is very powerful, but also potentially dangerous**. ## Converting the Value to Hash Type Since the StateDB only stores data of the type *Hash*, we need to convert all values to the type *Hash* before passing it to the **stateDB**. ### Converting Numbers To convert numbers of type `big.Int`, we can utilize a function from the common package: ```go valueHash := common.BigToHash(value) ``` Since the `big.Int` data structure already is 32-bytes long, the conversion is straightforward. ```go // BigToHash sets byte representation of b to hash. // If b is larger than len(h), b will be cropped from the left. func BigToHash(b *big.Int) Hash { return BytesToHash(b.Bytes()) } ``` ### Converting Strings Converting strings is more challenging, since they are variable in length. Let's see an example: ```go input := "Hello World" ``` To start, let's convert input into type bytes: ```go inputAsBytes := []byte(input) // [72 101 108 108 111 32 87 111 114 108 100] ``` This is how you would convert input to type bytes in Go. Notice that the comment in the code snippet is the byte-representation of input, where each integer represents a byte. Right now, inputAsBytes is of length 11. We want it to be of length 32. Therefore, we pad `inputAsBytes`, adding however many zeros to the front until `inputAsBytes` has 32 integers: ```go inputPadded := common.LeftPadBytes(inputAsBytes, common.HashLength) // [0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 72 101 108 108 111 32 87 111 114 108 100] ``` In Go, we would do that using the function common.LeftPadBytes, which takes the byte array to be padded and the desired length. The desired length is supplied with the common.HashLength variable, which has the value 32. As seen in the comment, inputPadded is now of length 32. In the next step, we convert the bytes to a Hash with the function `common.BytesToHash`: ```go inputHash := common.BytesToHash(inputPadded) // 0x00000000000000000000000000000000000000000048656c6c6f20576f726c64 ``` ## Helper Functions To make the code reusable and keep the precompile function clean, it makes sense to create helper functions for converting and storing the data. The first one we'll see is StoreString: ```go // StoreString sets the value of the storage key "storageKey" in the contract storage. func StoreString(stateDB contract.StateDB, newValue string) { newValuePadded := common.LeftPadBytes([]byte(newValue), common.HashLength) newValueHash := common.BytesToHash(newValuePadded) stateDB.SetState(ContractAddress, storageKeyHash, newValueHash) } ``` `StoreString` takes in the underlying key-value mapping, known as **StateDB**, and the new value, and updates the current string stored to be the new one. `StoreString` takes care of any type conversions and state management for us. Focusing now on `setString`, defining the logic is relatively easy. All we need to do is pass in **StateDB** and our string to `StoreString`. Thus, we have the following: ```go func setString(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, SetStringGasCost); err != nil { return nil, 0, err } if readOnly { return nil, remainingGas, vmerrs.ErrWriteProtection } // attempts to unpack [input] into the arguments to the SetStringInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackSetStringInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE // Get K-V Mapping currentState := accessibleState.GetStateDB() // Set the value StoreString(currentState, inputStruct) // this function does not return an output, leave this one as is packedOutput := []byte{} // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` # Implementing setCounter (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/03-implement-set-counter) --- title: Implementing setCounter description: Learn how to implement the setCounter method. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- Having seen how strings are stored in `StringStore`, its time for us to store integers with Counter. The thought process for this section can be defined as follows: - Define the storage hash for our counter - Implement `StoreCounterValue`, a helper function which acts like `StoreString` in the previous - Implement `setCounter` ```go title="contract.go" // storageKeyHash storageKeyHash = common.BytesToHash([]byte("counterValue")) // StoreGreeting sets the value of the storage key in the contract storage. func StoreCounterValue(stateDB contract.StateDB, value *big.Int) { // Convert uint to left padded bytes inputPadded := common.LeftPadBytes(value.Bytes(), 32) inputHash := common.BytesToHash(inputPadded) stateDB.SetState(ContractAddress, storageKeyHash, inputHash) } //setCounter sets the counter value in the contract storage. func setCounter(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, SetCounterGasCost); err != nil { return nil, 0, err } if readOnly { return nil, remainingGas, vmerrs.ErrWriteProtection } // attempts to unpack [input] into the arguments to the SetCounterInput. // Assumes that [input] does not include selector // You can use unpacked [inputStruct] variable in your code inputStruct, err := UnpackSetCounterInput(input) if err != nil { return nil, remainingGas, err } // CUSTOM CODE STARTS HERE // Get the current state currentState := accessibleState.GetStateDB() // Set the value StoreCounterValue(currentState, inputStruct) // this function does not return an output, leave this one as is packedOutput := []byte{} // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` # Read Data From EVM State (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/04-read-date-from-evm) --- title: Read Data From EVM State description: Learn how to read the data from EVM state. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- In the section about storing data in the EVM, we learned about how to store our string in the EVM State. An equally important skill is how to read data from the EVM state. In this section, we'll learn about how to retrieve our string from the EVM state. ## Defining Helper Function Just like with setting the string in the EVM state, there are some conversions we'll have to perform to our string. In particular, we'll need to unhash the value stored in StateDB to get our original string. Thus, our helper function can be defined as follows: ```go // GetString returns the value of the storage key "storageKey" in the contract storage, // with leading zeroes trimmed. func GetString(stateDB contract.StateDB) string { // Get the value set at recipient value := stateDB.GetState(ContractAddress, storageKeyHash) return string(common.TrimLeftZeroes(value.Bytes())) } ``` With our helper function defined, we can implement the logic for `getString`. This will consists of retrieving the underlying key-value mapping and then passing it to `GetString`. ```go func getString(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, GetStringGasCost); err != nil { return nil, 0, err } // no input provided for this function // CUSTOM CODE STARTS HERE var output string // CUSTOM CODE FOR AN OUTPUT currentState := accessibleState.GetStateDB() output = GetString(currentState) packedOutput, err := PackGetStringOutput(output) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` # Implementing getCounter & increment (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/05-implement-getcounter-increment) --- title: Implementing getCounter & increment description: Learn how to implement getCounter and increment. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- Having seen how to retrieve strings from the EVM state with the StoreString precompile, we are now ready to implement `getCounter`. Also, now that we are familiar with reading and writing to the EVM state, we can implement increment, which requires both read and write operations. ## Implementing getCounter For `getCounter`, the following thought process is helpful: - Create a helper function `GetCounterValue`, which takes in the current StateDB and returns the integer stored at the `storageKeyHash` - In `getCounter`, get the current StateDB and pass it to `GetCounterValue` ```go // GetCounterValue gets the value of the storage key in the contract storage. func GetCounterValue(stateDB contract.StateDB) *big.Int { // Get the value value := stateDB.GetState(ContractAddress, storageKeyHash) // Convert bytes to uint return new(big.Int).SetBytes(value.Bytes()) } func getCounter(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, GetCounterGasCost); err != nil { return nil, 0, err } // no input provided for this function // Get the current state currentState := accessibleState.GetStateDB() // Get the value set at recipient value := GetCounterValue(currentState) packedOutput, err := PackGetCounterOutput(value) if err != nil { return nil, remainingGas, err } // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` ## Implementing increment For increment, the following thought process is helpful: - Get the current StateDB and pass it to GetCounterValue - Once you have the current counter, increment it by one - Store the new counter with StoreCounterValue ```go func incrementCounter(accessibleState contract.AccessibleState, caller common.Address, addr common.Address, input []byte, suppliedGas uint64, readOnly bool) (ret []byte, remainingGas uint64, err error) { if remainingGas, err = contract.DeductGas(suppliedGas, IncrementCounterGasCost); err != nil { return nil, 0, err } if readOnly { return nil, remainingGas, vmerrs.ErrWriteProtection } // no input provided for this function // CUSTOM CODE STARTS HERE // Get the current state currentState := accessibleState.GetStateDB() // Get the value of the counter value := GetCounterValue(currentState) // Set the value StoreCounterValue(currentState, value.Add(value, big.NewInt(1))) // this function does not return an output, leave this one as is packedOutput := []byte{} // Return the packed output and the remaining gas return packedOutput, remainingGas, nil } ``` # Setting Base Gas Fees of Your Precompile (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/06-setting-base-gasfees) --- title: Setting Base Gas Fees of Your Precompile description: Learn how to set the base gas fees of your precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- Gas is used for spam prevention. If our precompile is accessible to everyone on our Avalanche L1, it is important to set the gas cost in a way that lets users economically utilize it in their apps, yet prevents spammers from spamming our blockchain with calls to the precompile. In this section, we'll modify the default values of the gas costs of our Calculator precompile. By default, all user-defined functions have a gas cost of 1. While this is good news for the average user, allowing users to call computationally expensive functions can leave our blockchain vulnerable to Denial-of-Service (DoS) attacks. We can find the default gas cost values for our functions in calculator/contract.go. Following the import statements, you should see: ```go title-"calculator/contract.go" const ( // Gas costs for each function. These are set to 1 by default. // You should set a gas cost for each function in your contract. // Generally, you should not set gas costs very low as this may cause your network to be vulnerable to DoS attacks. // There are some predefined gas costs in contract/utils.go that you can use. AddGasCost uint64 = 1 /* SET A GAS COST HERE */ NextTwoGasCost uint64 = 1 /* SET A GAS COST HERE */ RepeatGasCost uint64 = 1 /* SET A GAS COST HERE */ ) ``` The variables `AddGasCost`, `NextTwoGasCost`, and `RepeatGasCost` are the gas costs of the `add`, `nextTwo`, and `repeat` functions, respectively. As you can see, they are currently set to 1. However, changing the gas cost is as easy as changing the values themselves. As an example, change the gas costs to 7. # Setting ConfigKey and ContractAddress (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/07-set-configkey-contractaddr) --- title: Setting ConfigKey and ContractAddress description: Learn how to set the ConfigKey and ContractAddress, and Register the Precompile. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- ## ConfigKey Just as with the MD5 precompile in the previous section, go to the `module.go` file and set a ConfigKey. ## Contract Address In the same file, set a ContractAddress. Choose one that has not been used by other precompiles of earlier sections. # Initial State (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/08-initial-state) --- title: Initial State description: Setting the Initial State. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- Throughout this chapter, we've covered storing variables in the EVM state. However, all of this was through the use of StringStore/Counter Solidity interface. An important part of stateful precompiles is the ability to initialize values stored by our precompiled contracts. In the next few chapters, we'll see how to initialize the values of our precompiled contracts by manually setting the values or allowing for the values to be defined in the `genesis.json` file. # Defining Default Values via Golang (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/09-define-default-values-via-go) --- title: Defining Default Values via Golang description: Learn how to set the default values of precompiled contracts using Go. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- In this section, we'll cover defining default values of precompiled contracts using Go. We'll refer to StringStore for this section. ## Configure Function To start, go to `StringStore/module.go` and scroll to the end of the file. There, you will find the Configure function: ```go // Configure configures [state] with the given [cfg] precompileconfig. // This function is called by the EVM once per precompile contract activation. // You can use this function to set up your precompile contract's initial state, // by using the [cfg] config and [state] stateDB. func (*configurator) Configure(chainConfig precompileconfig.ChainConfig, cfg precompileconfig.Config, state contract.StateDB, blockContext contract.ConfigurationBlockContext) error { config, ok := cfg.(*Config) if !ok { return fmt.Errorf("incorrect config %T: %v", config, config) } // CUSTOM CODE STARTS HERE return nil } ``` Configure handles the initialization of a precompiled contract. We want to use Configure to define the default value for the string we are storing. But how? Configure gives us access to the StateDB (as one of the function parameters) and also lets us call any functions defined in `contract.go`. For example, if we wanted the default string to be "EGS," then we would just have to write one line of code: ```go // Configure configures [state] with the given [cfg] precompileconfig. // This function is called by the EVM once per precompile contract activation. // You can use this function to set up your precompile contract's initial state, // by using the [cfg] config and [state] stateDB. func (*configurator) Configure(chainConfig precompileconfig.ChainConfig, cfg precompileconfig.Config, state contract.StateDB, blockContext contract.ConfigurationBlockContext) error { config, ok := cfg.(*Config) if !ok { return fmt.Errorf("incorrect config %T: %v", config, config) } // CUSTOM CODE STARTS HERE StoreString(state, "EGS") return nil } ``` We have just set a default value for our precompiled contract. # Defining Default Values via Genesis (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/10-define-default-values-via-genesis) --- title: Defining Default Values via Genesis description: Learn how to set the default values of precompiled contracts using genesis JSON file. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- In the last section, we saw how to initialize the default values of our precompiled contracts via the Configure function. While straightforward, it would be ideal for us (and developers who don't write in Go) to initialize default values via the genesis JSON. Here's how to do just that. ## Modifying config.go The first step is to extract the value from the JSON file. Go to `config.go` and look at the Config struct: ```go // Config implements the precompileconfig.Config interface and // adds specific configuration for StringStore. type Config struct { precompileconfig.Upgrade // CUSTOM CODE STARTS HERE // Add your own custom fields for Config here } ``` Within the Config struct, we can find another struct: the Upgrade struct. It is not necessary to look at the definition of this struct. However, it is useful to know that this struct allows for the `blockTimestamp` key to be parsed in our `genesis.json` file. ```go "stringStoreConfig" : { "blockTimestamp": 0, } ``` To pass in default values via the genesis JSON, we must complete the following: - Define a key-value in the genesis JSON - Update our Config struct so it is able to parse our new key-value In the case of StringStore, after defining blockTimestamp, we will add another key-pair for our default string: ```go "stringStoreConfig" : { "blockTimestamp": 0, "defaultString": "EGS" } ``` Next, we will want to update our Config struct: ```go type Config struct { precompileconfig.Upgrade // CUSTOM CODE STARTS HERE // Add your own custom fields for Config here DefaultString string `json:"defaultString,omitempty"` } ``` In the above snippet, we are defining a new field of type string named `DefaultString`. With respect to its initialization, the value of `DefaultString` is derived from the JSON key `defaultString` from our genesis JSON (the value `json:"defaultString,omitempty"` tells Go to ignore the JSON field if we do not define it in our genesis JSON). At this point, we have defined our new key-value pair in the genesis JSON and incorporated the logic so that precompile-evm can parse the new key-value. However, one step remains. Although precompile-evm can parse the new key-value, we are not actually utilizing it anywhere. Our last-step is to update `Configure` method in `module.go` so it can read our new key-value pair. ```go func (*configurator) Configure(chainConfig contract.ChainConfig, cfg precompileconfig.Config, state contract.StateDB, _ contract.BlockContext) error { config, ok := cfg.(*Config) if !ok { return fmt.Errorf("incorrect config %T: %v", config, config) } // CUSTOM CODE STARTS HERE StoreString(state, config.DefaultString) return nil } ``` # Testing Your Precompile (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/11-testing-precompile-hardhat) --- title: Testing Your Precompile description: Learn how to test your precompile using Hardhat. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- Just like with the Calculator precompile, we want to test the functionality of our precompile to make sure it behaves as intended. Although we can write tests in Go, this is not the only way we can test our precompile. We can leverage Hardhat, a popular smart contract testing framework, for testing. In this section, we'll cover writing the smart contract component of our tests and setting up our testing environment so that precompile-evm can execute these tests for us. ## Structure of Testing with Hardhat For `StringStore`, we'll need to complete the following tasks in order to leverage Hardhat: 1. Define the Genesis JSON file we want to use for testing 2. Tell precompile-evm what Hardhat script to use to test `StringStore` 3. Write the smart contract that will hold the test cases for us 4. Write the actual script that will execute the Hardhat tests for us ## Defining the Genesis JSON The easiest part of this tutorial, we will need to define the genesis state of our testing environment. For all intents and purposes, you can copy the genesis JSON that you used in the Defining Default Values section and paste it in `precompile-evm/tests/precompile/genesis`, naming it `StringStore.json` (it is important that you name the genesis file the name of your precompile). ## Telling Precompile-EVM What To Test The next step is to modify `suites.go` and update the file so that precompile-evm can call the Hardhat tests for StringStore. Go to `precompile-evm/tests/precompile/solidity` and find `suites.go`. Currently, your file should look like the following: ```go title="suites.go" // Copyright (C) 2019-2023, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. // Implements solidity tests. package solidity import ( "context" "time" "github.com/ava-labs/subnet-evm/tests/utils" ginkgo "github.com/onsi/ginkgo/v2" ) var _ = ginkgo.Describe("[Precompiles]", ginkgo.Ordered, func() { utils.RegisterPingTest() // Each ginkgo It node specifies the name of the genesis file (in ./tests/precompile/genesis/) // to use to launch the subnet and the name of the TS test file to run on the subnet (in ./contract-examples/tests/) // ADD YOUR PRECOMPILE HERE /* ginkgo.It("your precompile", ginkgo.Label("Precompile"), ginkgo.Label("YourPrecompile"), func() { ctx, cancel := context.WithTimeout(context.Background(), time.Minute) defer cancel() ​ // Specify the name shared by the genesis file in ./tests/precompile/genesis/{your_precompile}.json // and the test file in ./contracts/tests/{your_precompile}.ts // If you want to use a different test command and genesis path than the defaults, you can // use the utils.RunTestCMD. See utils.RunDefaultHardhatTests for an example. utils.RunDefaultHardhatTests(ctx, "your_precompile") }) */ }) ``` If you view the comments generated, you will already see a general structure for how we can declare our tests for precompiles. Let's take this template and use it to declare the tests for StringStore! ```go title="suites.go" // Copyright (C) 2019-2023, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. // Implements solidity tests. package solidity import ( "context" "time" "github.com/ava-labs/subnet-evm/tests/utils" ginkgo "github.com/onsi/ginkgo/v2" ) var _ = ginkgo.Describe("[Precompiles]", ginkgo.Ordered, func() { utils.RegisterPingTest() // Each ginkgo It node specifies the name of the genesis file (in ./tests/precompile/genesis/) // to use to launch the subnet and the name of the TS test file to run on the subnet (in ./contract-examples/tests/) // ADD YOUR PRECOMPILE HERE /* ginkgo.It("your precompile", ginkgo.Label("Precompile"), ginkgo.Label("YourPrecompile"), func() { ctx, cancel := context.WithTimeout(context.Background(), time.Minute) defer cancel() ​ // Specify the name shared by the genesis file in ./tests/precompile/genesis/{your_precompile}.json // and the test file in ./contracts/tests/{your_precompile}.ts // If you want to use a different test command and genesis path than the defaults, you can // use the utils.RunTestCMD. See utils.RunDefaultHardhatTests for an example. utils.RunDefaultHardhatTests(ctx, "your_precompile") }) */ ginkgo.It("StringStore", ginkgo.Label("Precompile"), ginkgo.Label("StringStore"), func() { ctx, cancel := context.WithTimeout(context.Background(), time.Minute) defer cancel() utils.RunDefaultHardhatTests(ctx, "StringStore") }) }) ``` Again, the naming conventions are important. We recommend you use the same name as your precompile whenever possible. ## Defining Test Contract In contrast to using just Go, Hardhat allows us to test our precompiles using Solidity. To start, create a new file called `StringStoreTest.sol` in `precompile-evm/contract/contracts`. We can start defining our file by including the following: ```solidity title="StringStoreTest.sol" // SPDX-License-Identifier: MIT pragma solidity >= 0.8.0; import "ds-test/src/test.sol"; import {IStringStore} from "../contracts/interfaces/IStringStore.sol"; ``` As of right now, there are two important things to note. We are first importing `test.sol`, a testing file that includes a range of assertion functions to assert that our outputs are as expected. In particular, these assertion functions are methods of the DSTest contract. Next, we are importing the interface of the StringStore precompile that we want to test. With this in mind, let's fill in the rest of our test file: ```solidity title="StringStoreTest.sol" contract StringStoreTest is DSTest { IStringStore stringStore = IStringStore(0x0300000000000000000000000000000000000005); function step_getString() public { assertEq(stringStore.getString(), "Cornell"); } function step_getSet() public { string memory newStr = "Apple"; stringStore.setString(newStr); assertEq(stringStore.getString(), newStr); } } ``` In the contract `StringStoreTest`, we are inheriting the DSTest contract so that we can leverage the provided assertion functions. Afterward, we are declaring the variable stringStore so that we can directly call the StringStore precompile. Next, we have the two testing functions. Briefly looking at the logic of each test function: - `step_getString`: We are testing that the getString function returns the default string defined in the genesis JSON (in this example, the default string is set to "Cornell") - `step_getSet`: We are assigning a new string to our precompile and making sure that setString does so correctly We now want to note the following two details regarding Solidity test functions in Hardhat: - Any test functions that you want to be called must start with the prefix "step" - The assertion function you use to check your outputs is `assertEq` With our Solidity test contract defined, let's write actual Hardhat script! ## Writing Your Hardhat Script To start, go to `precompile-evm/contracts/test` and create a new file called `StringStore.ts`. It is important to name your TypeScript file the same name as your precompile. Here are the steps to take when defining our Hardhat script: 1. Specify the address at which our precompile is located 2. Deploy our testing contract so that we can call the test functions 3. Tell Hardhat to execute said test functions To make our lives even easier, Avalanche L1-EVM (a library that Precompile-EVM leverages) has helper functions to call our test functions simply by specifying the names of the test functions. You can find the helper functions here: https://github.com/ava-labs/subnet-evm/blob/master/contracts/test/utils.ts. In the end, our testing file will look as follows: ```ts title="StringStore.ts" // (c) 2019-2022, Ava Labs, Inc. All rights reserved. // See the file LICENSE for licensing terms. import { ethers } from "hardhat" import { test } from "@avalabs/subnet-evm-contracts" import { factory } from "typescript" const STRINGSTORE_ADDRESS = "0x0300000000000000000000000000000000000005" describe("StringStoreTest", function() { this.timeout("30s") beforeEach("Setup DS-Test", async function () { const stringStorePromise = ethers.getContractAt("IStringStore", STRINGSTORE_ADDRESS) return ethers.getContractFactory("StringStoreTest").then(factory => factory.deploy()) .then(contract => { this.testContract = contract return contract.deployed().then(() => contract) }) }) test("Testing get function", "step_getString") test("Testing get and set function", "step_getSet") }) ``` ## Running Your Hardhat Test To run your HardHat tests, first change to the root directory of precompile-evm and run the following command: ```bash ./scripts/build.sh ``` Afterward, run the following command: ```bash GINKGO_LABEL_FILTER=StringStore ./scripts/run_ginkgo.sh ``` The variable `GINKGO_LABEL_FILTER` simply tells precompile-evm which tests suite from `suites.go` to execute. Execute the `StringStore` test suite. However, if you have multiple precompiles to test, set `GINKGO_LABEL_FILTER` equal to "Precompile." You should see something like the following: ```bash title="Combined output" StringStoreTest ✓ Testing get function (4126ms) ✓ Testing get and set function (4070ms) 2 passing (12s) < Exit [It] StringStore - /Users/Rodrigo.Villar/go/src/github.com/ava-labs/precompile-evm/tests/precompile/solidity/suites.go:40 @ 07/19/23 15:37:03.574 (16.134s) • [16.134 seconds] ------------------------------ [AfterSuite] /Users/Rodrigo.Villar/go/pkg/mod/github.com/ava-labs/subnet-evm@v0.5.2/tests/utils/command.go:85 > Enter [AfterSuite] TOP-LEVEL - /Users/Rodrigo.Villar/go/pkg/mod/github.com/ava-labs/subnet-evm@v0.5.2/tests/utils/command.go:85 @ 07/19/23 15:37:03.575 < Exit [AfterSuite] TOP-LEVEL - /Users/Rodrigo.Villar/go/pkg/mod/github.com/ava-labs/subnet-evm@v0.5.2/tests/utils/command.go:85 @ 07/19/23 15:37:03.575 (0s) [AfterSuite] PASSED [0.000 seconds] ------------------------------ Ran 2 of 3 Specs in 50.822 seconds SUCCESS! -- 2 Passed | 0 Failed | 0 Pending | 1 Skipped PASS ``` Congrats, you can now write Hardhat tests for your stateful precompiles! # Build Your Precompile (/academy/avalanche-l1/customizing-evm/10-stateful-counter-precompile/12-build-your-precompile) --- title: Build Your Precompile description: Learn how to build and run your precompile as a custom EVM blockchain. updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- ## Build Your Custom VM There's a simple build script in the Precompile-EVM we can utilize to build. First, make sure you are in the root folder of you Precompile-EVM: ```bash cd $GOPATH/src/github.com/ava-labs/precompile-evm ``` Then run the command to initiate the build script: ```bash ./scripts/build.sh ``` If you do not see any error, the build was successful. ## Run a Local Network with Your Custom VM You can run you customized Precompile-EVM by using the Avalanche CLI. First, create the configuration for your blockchain with custom VM. ```bash avalanche blockchain create myblockchain --custom --vm $AVALANCHEGO_PLUGIN_PATH/srEXiWaHuhNyGwPUi444Tu47ZEDwxTWrbQiuD7FmgSAQ6X7Dy --genesis ./.devcontainer/genesis-example.json ``` Make sure you replace the binary name with the actual binary name of your Precompile-EVM, and genesis file with the actual path to your genesis file. Next, launch the Avalanche L1 with your custom VM: ```bash avalanche blockchain deploy myblockchain ``` After around 1 minute the blockchain should have been created and some more output should appear in the terminal. You'll also see the RPC URL of your blockchain in the terminal. # Token Bridging (/academy/avalanche-l1/erc20-bridge/01-token-bridging/01-token-bridging) --- title: Token Bridging description: Learn about asset transfer between chains updated: 2024-05-31 authors: [ashucoder9] icon: Book --- Asset bridging is a crucial concept in blockchain interoperability, enabling assets to be transferred across different blockchain networks. This process is essential for creating seamless experiences in multi-chain ecosystems. ## What You Will Learn In this section, you will go through the following topics: - **Bridging assets:** you will understand why bridging assets is important. - **Bridge safety:** learn about the most common hacks in bridges and how to prevent them. # Bridge Architecture (/academy/avalanche-l1/erc20-bridge/01-token-bridging/02-bridge-architecture) --- title: Bridge Architecture description: Get familiar with different bridge mechanisms updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- Asset bridging refers to the mechanism that allows assets, such as cryptocurrencies or tokens, to move from one blockchain to another. This is particularly important in ecosystems where multiple blockchains are used for different purposes, and users want to leverage assets across these chains. Bridging effectively extends the usability of assets beyond their native blockchain, facilitating greater liquidity and integration across various platforms. ## Bridge Mechanisms ### Lock & Mint Locking: The asset is locked in a smart contract on the source blockchain. For example, if you want to bridge AVAX from Avalanche's C-chain to Ethereum, you would lock your AVAX in a smart contract on Avalanche. Minting: Simultaneously, some event notifies Ethereum that an equivalent amount of a wrapped token (e.g., Wrapped AVAX) must be minted on the target blockchain and sent to the user’s address. ### Burn & Mint Burning: When transferring assets back to the source blockchain, the wrapped tokens are burned or destroyed on the target blockchain. Releasing: The original assets are then released from the smart contract on the source blockchain back to the user's address. ### Custodians Some bridges use a custodian or a centralized party to manage the assets. This party locks the asset on one blockchain and releases it on another, relying on trust and security measures. ### Cross-Chain Communication Advanced bridges such as Avalanche Interchain Token Transfer utilize native cross-chain communication protocols to facilitate transactions between blockchains without requiring intermediaries. These protocols ensure that the asset's state and ownership are synchronized across different chains. ## Why Bridging - Enhanced Liquidity: Bridging increases the liquidity of assets by allowing them to be used across different DeFi platforms and blockchain networks. This enhances trading opportunities and financial activities. - Interoperability: It fosters interoperability between different blockchains, enabling users to access a broader range of services and applications. - Flexibility: Users can move assets to chains with lower fees, faster transaction times, or better functionalities, optimizing their experience and strategies. # Use a Demo Bridge (/academy/avalanche-l1/erc20-bridge/01-token-bridging/03-use-a-demo-bridge) --- title: Use a Demo Bridge description: Interact with the ohmywarp bridge updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- This guide will walk you through the process of using a bridge between 2 Avalanche blockchains, providing a step-by-step approach to ensure a smooth and secure experience. Go to [ohmywarp.com](https://ohmywarp.com) and connect any web3 [wallet](https://core.app). Make sure your wallet has at least some AVAX on the Fuji Testnet. **Getting testnet AVAX:** - **Recommended:** Create a [Builder Hub account](https://build.avax.network/login) and connect your wallet to receive testnet AVAX automatically - **Alternative:** Use the [external faucet](https://core.app/tools/testnet-faucet/?subnet=c&token=c) with coupon code `avalanche-academy` Mint some `TLP` token on `C-Chain` in the Mint tab. This is an ERC20 deployed on Fuji's C-chain. Finally bridge some `TLP` to `Dispatch`. You can confirm the transfer in the Mint tab. # Bridge Hacks (/academy/avalanche-l1/erc20-bridge/01-token-bridging/04-bridge-hacks) --- title: Bridge Hacks description: Learn about the most common bridge hacks. updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- ## What are Bridge Hacks? Asset bridges are vital for blockchain interoperability but have been the target of significant security breaches. The complexities of bridging assets between different blockchains can create vulnerabilities that malicious actors exploit. Here’s an overview of some of the most common types of bridge hacks and security issues: ### Smart Contract Exploits Smart contract exploits involve vulnerabilities in the bridge's code that can be exploited by attackers to steal assets. Common issues include: **Reentrancy Attacks**: Exploiting a contract’s ability to call itself, allowing attackers to repeatedly withdraw funds before the contract’s state is updated. Example: The DAO hack in 2016 utilized reentrancy to drain millions of dollars of ETH from a smart contract. **Arithmetic Errors**: Bugs related to integer overflows or underflows that can lead to unintended behavior. Example: In 2020, the **Value DeFi** exploit used an arithmetic bug to drain $6 million from the protocol. **Logic Flaws**: Errors in the contract's logic that can be exploited to bypass security controls. Example: In the case of bZx exploit, an attacker exploited a logic flaw to manipulate the price of assets and steal funds. ### Centralized Bridge Attacks Centralized bridges rely on a single custodian or entity to manage the assets. If the custodian is compromised, it can lead to: 1. **Theft of Assets**: Direct theft from the custodian's reserves if their security is breached. Example: The Poly Network hack in 2021 involved a vulnerability that allowed attackers to exploit the bridge's central control mechanisms and steal over $600 million. Although much of the stolen funds were later returned, it highlighted significant risks in centralized bridges. 2. **Mismanagement or Fraud**: The custodian could mismanage funds or engage in fraudulent activities. Example: Various cases of mismanagement or fraud in smaller, less established bridges where the custodian's integrity is in question. ### Governance Attacks Governance attacks target the mechanisms by which decisions are made in decentralized bridges: **Vote Manipulation**: Attacking the governance process to make changes that benefit the attacker. Example: In some DeFi protocols, attackers have manipulated governance votes to gain control or access to assets. **51% Attacks**: Gaining control over a majority of the governance or network nodes to disrupt or exploit the bridge. Example: While more common in blockchains, similar attacks can occur in decentralized bridges with weak governance structures. ### Cross-Chain Communication Vulnerabilities Cross-chain communication vulnerabilities involve weaknesses in the protocols or mechanisms that facilitate communication between different blockchains: **Data Manipulation**: Exploiting the data transmitted between chains to falsify transactions or asset states. Example: In 2022, the Wormhole bridge was exploited due to a vulnerability in its data verification process, leading to a loss of over $320 million. **Consensus Issues**: Problems with how different chains agree on the state of assets or transactions can lead to discrepancies and exploitation. Example: Misalignment between chains can lead to double-spending or other issues if not properly managed. ### Phishing and Social Engineering Phishing and social engineering attacks target users or administrators rather than the bridge’s technical infrastructure: **Phishing**: Attacking users to steal their private keys or credentials to access funds. Example: Users may be tricked into entering their private keys on fraudulent websites pretending to be bridge interfaces. **Social Engineering**: Manipulating individuals involved in the bridge’s operations to gain unauthorized access or influence. Example: Administrators may be tricked into giving away critical access or credentials. ## Mitigation Strategies 1. **Audits and Code Reviews**: Regularly audit smart contracts and bridge code to identify and fix vulnerabilities before they can be exploited. 2. **Security Best Practices**: Implement security best practices, including proper error handling, using well-tested libraries, and following coding standards. 3. **Decentralization**: Where possible, use decentralized bridging solutions to reduce the risk associated with centralized custodians. 4. **Governance Safeguards**: Strengthen governance mechanisms and ensure a robust process for decision-making and voting. 5. **User Education**: Educate users about phishing and social engineering threats to reduce the risk of these types of attacks. 6. **Insurance and Compensation**: Use insurance mechanisms or compensation funds to mitigate the impact of potential losses from breaches. By understanding and addressing these common bridge hacks, developers and users can better protect their assets and improve the overall security of cross-chain bridging solutions. # Avalanche Interchain Token Transfer (/academy/avalanche-l1/erc20-bridge/02-avalanche-interchain-token-transfer/01-avalanche-interchain-token-transfer) --- title: Avalanche Interchain Token Transfer description: Learn how to transfer assets between Avalanche L1s updated: 2024-05-31 authors: [ashucoder9] icon: Book --- The Avalanche Interchain Token Transfer is an application that allows users to transfer tokens between Avalanche L1s. The bridge is a set of smart contracts that are deployed across multiple Avalanche L1s, and leverages [Interchain Messaging](https://github.com/ava-labs/teleporter) for cross-chain communication. # What you will learn In this chapter you will learn: - **Bridge Design:** How the bridge is designed on a high level. - **File Structure:** The structure of the bridge contracts and their dependencies. - **Token Home:** What the token home is and how it works. - **Token Remote:** What the token remote is and how it works. # Interchain Token Transfer Design (/academy/avalanche-l1/erc20-bridge/02-avalanche-interchain-token-transfer/02-bridge-design) --- title: Interchain Token Transfer Design description: Get familiar with the ICTT design updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- Each token transferrer instance consists of one "home" contract and at least one but possibly many "remote" contracts. Each home contract instance manages one asset to be transferred out to `TokenRemote` instances. The home contract lives on the Avalanche L1 where the asset to be transferred exists. A transfer involves locking the asset as collateral on the home Avalanche L1 and minting a representation of the asset on the remote Avalanche L1. The remote contracts, each with a single specified home contract, live on other Avalanche L1s that want to import the asset transferred by their specified home. The token transferrers are designed to be permissionless: anyone can register compatible `TokenRemote` instances to transfer tokens from the `TokenHome` instance to that new `TokenRemote` instance. The home contract keeps track of token balances transferred to each `TokenRemote` instance and handles returning the original tokens to the user when assets are transferred back to the `TokenHome` instance. `TokenRemote` instances are registered with their home contract via a Interchain Messaging message upon creation. Home contract instances specify the asset to be transferred as either an ERC20 token or the native token, and they allow for transferring the token to any registered `TokenRemote` instances. The token representation on the remote chain can also either be an ERC20 or native token, allowing users to have any combination of ERC20 and native tokens between home and remote chains: - `ERC20` -> `ERC20` - `ERC20` -> `Native` - `Native` -> `ERC20` - `Native` -> `Native` The remote tokens are designed to have compatibility with the token transferrer on the home chain by default, and they allow custom logic to be implemented in addition. For example, developers can inherit and extend the `ERC20TokenRemote` contract to add additional functionality, such as a custom minting, burning, or transfer logic. # File Structure (/academy/avalanche-l1/erc20-bridge/02-avalanche-interchain-token-transfer/03-file-structure) --- title: File Structure description: Understand the components of the ICTT structure updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- ## Contract Structure The ERC20 and native token transferrers built on top of Interchain Messaging are composed of interfaces and abstract contracts that make them extendable to new implementations in the future. ### `ITokenTransferrer` Interface that defines the events token transfer contract implementations must emit. Also defines the message types and formats of messages between all implementations. ### `IERC20TokenTransferrer` and `INativeTokenTransferrer` Interfaces that define the external functions for interacting with token transfer contract implementations of each type. ERC20 and native token transferrer interfaces vary from each other in that the native token transferrer functions are `payable` and do not take an explicit amount parameter (it is implied by `msg.value`), while the ERC20 token transferrer functions are not `payable` and require the explicit amount parameter. Otherwise, they include the same functions. # Token Home (/academy/avalanche-l1/erc20-bridge/02-avalanche-interchain-token-transfer/04-token-home) --- title: Token Home description: Learn about the Token Home, the asset origin component of the ICTT updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- ## `TokenHome` An abstract implementation of `ITokenTransferrer` for a token transfer contract on the "home" chain with the asset to be transferred. Each `TokenHome` instance supports transferring exactly one token type (ERC20 or native) on its chain to arbitrarily many "remote" instances on other chains. It handles locking tokens to be sent to `TokenRemote` instances, as well as receiving token transfer messages to either redeem tokens it holds as collateral (i.e. unlock) or route them to other `TokenRemote` instances (i.e. "multi-hop"). In the case of a multi-hop transfer, the `TokenHome` already has the collateral locked from when the tokens were originally transferred to the first `TokenRemote` instance, so it simply updates the accounting of the transferred balances to each respective `TokenRemote` instance. Remote contracts must first be registered with a `TokenHome` instance before the home contract will allow for sending tokens to them. This is to prevent tokens from being transferred to invalid remote addresses. Anyone is able to deploy and register remote contracts, which may have been modified from this repository. It is the responsibility of the users of the home contract to independently evaluate each remote for its security and correctness. ### `ERC20TokenHome` A concrete implementation of `TokenHome` and `IERC20TokenTransferrer` that handles the locking and releasing of an ERC20 token. ### `NativeTokenHome` A concrete implementation of `TokenHome` and `INativeTokenTransferrer` that handles the locking and release of the native EVM asset. # Token Remote (/academy/avalanche-l1/erc20-bridge/02-avalanche-interchain-token-transfer/05-token-remote) --- title: Token Remote description: Learn about the Token Remote, the asset destination component of the ICTT updated: 2024-05-31 authors: [ashucoder9] icon: BookOpen --- ## `TokenRemote` An abstract implementation of `ITokenTransferrer` for a token transfer contract on a "remote" chain that receives transferred assets from a specific `TokenHome` instance. Each `TokenRemote` instance has a single `TokenHome` instance that it receives token transfers from to mint tokens. It also handles sending messages (and correspondingly burning tokens) to route tokens back to other chains (either its `TokenHome`, or other `TokenRemote` instances). Once deployed, a `TokenRemote` instance must be registered with its specified `TokenHome` contract. This is done by calling `registerWithHome` on the remote contract, which will send a Interchain Messaging message to the home contract with the information to register. All messages sent by `TokenRemote` instances are sent to the specified `TokenHome` contract, whether they are to redeem the collateral from the `TokenHome` instance or route the tokens to another `TokenRemote` instance. Routing tokens from one `TokenRemote` instance to another is referred to as a "multi-hop", where the tokens are first sent back to their `TokenHome` contract to update its accounting, and then automatically routed on to their intended destination `TokenRemote` instance. TokenRemote contracts allow for scaling token amounts, which should be used when the remote asset has a higher or lower denomination than the home asset, such as allowing for a ERC20 home asset with a denomination of 6 to be used as the native EVM asset on a remote chain (with a denomination of 18). ### `ERC20TokenRemote` A concrete implementation of `TokenRemote`, `IERC20TokenTransferrer`, and `IERC20` that handles the minting and burning of an ERC20 asset. Note that the `ERC20TokenRemote` contract is an ERC20 implementation itself, which is why it takes the `tokenName`, `tokenSymbol`, and `tokenDecimals` in its constructor. All of the ERC20 interface implementations are inherited from the standard OpenZeppelin ERC20 implementation and can be overridden in other implementations if desired. ### `NativeTokenRemote` A concrete implementation of `TokenRemote`, `INativeTokenTransferrer`, and `IWrappedNativeToken` that handles the minting and burning of the native EVM asset on its chain using the native minter precompile. Deployments of this contract must be permitted to mint native coins in the chain's configuration. Note that the `NativeTokenRemote` is also an implementation of `IWrappedNativeToken` itself, which is why the `nativeAssetSymbol` must be provided in its constructor. `NativeTokenRemote` instances always have a denomination of 18, which is the denomination of the native asset of EVM chains. We will cover Native Token Remote in depth later in the course. # ERC-20 to ERC-20 Bridge (/academy/avalanche-l1/erc20-bridge/03-erc-20-to-erc-20-bridge/01-erc-20-to-erc-20-bridge) --- title: ERC-20 to ERC-20 Bridge description: Transfer ERC-20 tokens between Avalanche L1s updated: 2024-05-31 authors: [ashucoder9] icon: Book --- import { Step, Steps } from 'fumadocs-ui/components/steps'; import Link from 'next/link'; import { buttonVariants } from '@/components/ui/button.tsx' ## Transfer an ERC-20 Token → Echo as an ERC-20 Token This chapter will show you how to send an ERC-20 Token from C-Chain to Echo using Interchain Messaging and Toolbox. This guide is conducted on the Fuji testnet, where we'll bridge tokens from C-Chain to Echo. **All Avalanche Interchain Token Transfer contracts and interfaces implemented in this chapter implementation are maintained in the [`avalanche-interchain-token-transfer`](https://github.com/ava-labs/avalanche-interchain-token-transfer/tree/main/contracts/src) repository.** Deep dives on each template interface can be found [here](https://github.com/ava-labs/avalanche-interchain-token-transfer/blob/main/contracts/README.md). _Disclaimer: The avalanche-interchain-token-transfer contracts used in this tutorial are under active development and are not yet intended for production deployments. Use at your own risk._ ## What we will do 1. Deploy an ERC-20 Contract on C-Chain 2. Deploy the Interchain Token Transferer Contracts on C-Chain and Echo 3. Register Remote Token contract with the Home Transferer contract 4. Add Collateral and Start Sending Tokens # Deploy an ERC-20 (/academy/avalanche-l1/erc20-bridge/03-erc-20-to-erc-20-bridge/02-deploy-erc-20-token) --- title: Deploy an ERC-20 description: Deploy the asset to transfer updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; ### Deploy an ERC-20 Token We've already deployed an ERC-20 token in the [Transfer an ERC-20 Token](/academy/interchain-token-transfer/03-tokens/08-transfer-an-erc-20-token) section. If you've completed that step, you can use the same token for this bridge. If you haven't deployed a token yet, make sure you're connected to the Fuji testnet since we're covering this guide from Fuji to Echo. You can deploy the original ERC-20 token below: Make sure to save the deployed token address as you'll need it for the next steps. You can find it in the deployment confirmation or by checking your Core Wallet's token list. ### Add Token to Core Wallet If you haven't already added the token to your Core Wallet: 1. Go to the Tokens tab 2. Click "Manage" 3. Click "+ Add Custom Token" 4. Enter the token contract address 5. The token symbol and decimals should be automatically detected 6. Click "Add Token" Remember that you need to be connected to the Fuji testnet to see and interact with your token. ### Verify Token Balance To verify your token balance: 1. In Core Wallet, select your token from the token list 2. The balance should be displayed 3. You can also check the token balance on the [Fuji Explorer](https://testnet.snowtrace.io) by entering your address If you deployed the example token, you should see a balance of 10,000,000,000 tokens in your wallet. # Deploy a Home Contract (/academy/avalanche-l1/erc20-bridge/03-erc-20-to-erc-20-bridge/03-deploy-home) --- title: Deploy a Home Contract description: Deploy the Token Home on C-chain updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; We will deploy two Avalanche Interchain Token Transfer contracts. One on the source chain (which is C-chain in our case) and another on the destination chain (Echo in our case). ### Deploy ERC20Home Contract Since we're covering an ERC20 > ERC20 bridge, make sure to set the Transferrer type to "ERC20" and input the ERC20 token address you previously deployed in the token address field. Then deploy the ERC20Home contract on the Fuji testnet using our toolbox: Make sure you have: 1. Deployed your ERC-20 token (from [Deploy ERC-20 Token](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/02-deploy-erc-20-token)) 2. Have enough test AVAX for gas fees ### Save the ERC-20 Home Address After deployment, you'll need to save the contract address for future steps. You can find it in the deployment confirmation in the toolbox Keep this address handy as you'll need it for the next steps in the bridging process. # Deploy a Remote Contract (/academy/avalanche-l1/erc20-bridge/03-erc-20-to-erc-20-bridge/04-deploy-remote) --- title: Deploy a Remote Contract description: Deploy the Token Remote on your own blockchain updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; To ensure the wrapped token is bridged into the destination chain (in this case, C-Chain) you'll need to deploy a _remote_ contract that implements the `IERC20Bridge` interface, as well as inheriting the properties of `TeleporterTokenRemote`. In order for the bridged tokens to have all the normal functionality of a locally deployed ERC20 token, this remote contract must also inherit the properties of a standard `ERC20` contract. ### Get Test ECH Before deploying the remote contract, ensure you have some test tokens on Echo: - **Recommended:** Create a [Builder Hub account](https://build.avax.network/login) and connect your wallet to receive testnet tokens automatically on Echo - **Alternative:** Use the [external faucet](https://core.app/tools/testnet-faucet/?subnet=echo&token=echo) to claim tokens ### Deploy the Remote Contract Now we'll deploy the ERC20TokenRemote contract to the Echo chain. Use our toolbox: Make sure you have: 1. Deployed your ERC-20 token (from [Deploy ERC-20 Token](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/02-deploy-erc-20-token)) 2. Deployed your ERC20Home contract (from [Deploy Home](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/03-deploy-home)) 3. Have enough test ECH for gas fees ### Save the Remote Contract Address After deployment, you'll need to save the contract address for future steps. You can find it in the deployment confirmation in the toolbox. Keep this address handy as you'll need it for the next steps in the bridging process. # Register Remote Bridge (/academy/avalanche-l1/erc20-bridge/03-erc-20-to-erc-20-bridge/05-register-remote) --- title: Register Remote Bridge description: Register the remote bridge with the home bridge updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; After deploying both the home and remote bridge contracts, you need to register the remote bridge with the home bridge. This registration process informs the Home Bridge about your destination blockchain and bridge settings. ### Register Remote Bridge To register your remote bridge with the home bridge, use our toolbox: Make sure you have: 1. Deployed your ERC-20 token (from [Deploy ERC-20 Token](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/02-deploy-erc-20-token)) 2. Deployed your ERC20Home contract (from [Deploy Home](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/03-deploy-home)) 3. Deployed your ERC20TokenRemote contract (from [Deploy Remote](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/04-deploy-remote)) 4. Have enough test ECH for gas fees ### Verify Registration After registration, you can verify the process was successful by looking for the registration event in the transaction logs. You can find the registration confirmation in the toolbox. The registration process is a one-time setup that establishes the connection between your home and remote bridges. Once completed, you can proceed with token transfers. # Transfer Tokens (/academy/avalanche-l1/erc20-bridge/03-erc-20-to-erc-20-bridge/06-transfer-tokens) --- title: Transfer Tokens description: Transfer an ERC20 from C-chain to your own blockchain updated: 2024-05-31 authors: [ashucoder9] icon: Terminal --- import { Step, Steps } from 'fumadocs-ui/components/steps'; ### Transfer the Token Cross-chain Now that all the bridge contracts have been deployed and registered, you can transfer tokens between chains using our toolbox: Make sure you have: 1. Deployed your ERC-20 token (from [Deploy ERC-20 Token](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/02-deploy-erc-20-token)) 2. Deployed your ERC20Home contract (from [Deploy Home](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/03-deploy-home)) 3. Deployed your ERC20TokenRemote contract (from [Deploy Remote](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/04-deploy-remote)) 4. Registered your remote bridge with the home bridge (from [Register Remote](/academy/interchain-token-transfer/06-erc-20-to-erc-20-bridge/05-register-remote)) 5. Have enough test AVAX for gas fees ### Verify the Transfer After initiating the transfer, you can verify it was successful by: 1. Checking the transaction status in the toolbox 2. Checking the transaction status in Core Wallet 3. Viewing the transaction details on the [Fuji Explorer](https://testnet.snowtrace.io) 4. Checking your token balance in Core Wallet on the destination chain The transfer process may take a few moments to complete as it involves cross-chain communication. You can track the progress through the transaction hash. # Integrate ICTT with Core (/academy/avalanche-l1/erc20-bridge/03-erc-20-to-erc-20-bridge/07-avacloud-and-core-bridge) --- title: Integrate ICTT with Core description: Learn how to integrate ICTT bridges into the Core Bridge through AvaCloud. updated: 2024-05-31 icon: Book authors: [owenwahlgren] --- ## Integrate Interchain Token Transfers (ICTT) Into Core ICTT bridges deployed through [**AvaCloud**](https://avacloud.io/) will automatically integrate into the [**Core Bridge**](https://core.app/en/bridge). This ensures that any bridges created through AvaCloud are available immediately and do not need extra review. However, **ICTT bridges** deployed outside of AvaCloud (by third-party developers or other methods) will need to be submitted for manual review. Developers will need to provide: 1. **Token Bridge Contract Address(es)**: The bridge contract(s) on the L1. 2. **Layer 1 Information**: Name and other key details of the associated L1 blockchain. The Core team will review this info to ensure the bridge meets security and compliance standards. This guarantees network reliability while allowing more flexibility. ### [Community Submission Form](https://forms.gle/jdcKcYWu26CsY6jRA)
